Alpine County

State of California

Verified Aug. 4, 2026

Alpine County is a county authority in the State of California, covering 4 regions, serving 1,204 residents. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Approximately 3 business days for a complete, expedited small-residential-rooftop-solar submission Q18 Where you file — iWorq — 'Building Division Online Portal' at alpinecounty.portal.iworq.net Q20

Permit required
Yes95% source
What it costs
No dedicated PV/solar fee line was found; solar permits appear to fall under the general valuation-based Building Fee Table (New Construction) in the Building Permit Information Guide — e.g.65% source
Plan review turnaround
Approximately 3 business days for a complete, expedited small-residential-rooftop-solar submission90% source
Key document
published process document + ordinance cited by 9 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 95% · department page
    • What does this authority permit itself, and what does it delegate? Both 90% · ordinance
    • Is a permit required for a residential rooftop PV system? Yes 95% · published process document (PDF)
    • Is there a separate electrical permit, or is it combined? Combined 75% · published process document
    • Is a HOA or architectural approval required first? No (as a County permitting requirement) — though the County advises checking private CC&Rs where they exist 75% · ordinance
    • Is there a historic-district review? No 70% · fee schedule (absence checked against Planning fee schedule and Title 15)
    • Is a wind or windstorm certification required? No 55% · ordinance (absence checked)
    • Is there a system-size cap on residential generation? No hard cap on residential solar system size; the ordinance instead defines a 'small residential rooftop solar energy system' eligible for expedited/administrative approval as one no larger than 10 kW AC nameplate (or 30 kW thermal) — larger residential systems are permittable but fall outside the expedited/ministerial track defined by §15.04.070 85% · ordinance
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Cover page (owner name, project address, scope of work, designer/contractor name, applicable code); Site plan (array location, main/grid disconnect locations, north arrow; for roof-mount: roof pitch, 3-ft eave-to-ridge pathway, 3-ft eave/ridge clearances; for pole-mount: location and property-line setback); Electrical single-line drawing (AC/DC disconnects, OCPD, grounding, GFP, combiner/junction boxes, conductor/conduit type and size, inverters, any batteries/charge controllers/generator connections); Manufacturer spec sheets for all PV equipment/mounting (listed by an approved testing agency; pole-mount requires a CA-licensed engineer's design); Detail sheet for equipment marking/signage (UL 969, CEC Art. 690) 95% · published checklist (PDF)
    • How many copies, and in what format? Preferred: electronic submittal via the online portal (Building Division Online Portal / iWorq). If not submitted online, two (2) hard copies of the plan set are required. Electronic signatures are expressly allowed in lieu of wet signatures for small residential rooftop systems. 90% · published process document + ordinance
    • Is a site plan required, and what must it show? Yes — must show location of the array, a readily accessible main/array disconnect location, grid power main disconnect (if applicable), north arrow; for roof-mount, roof pitch plus a minimum 3-ft-wide pathway from eave to ridge and 3-ft clearances from eaves/ridges; for pole-mount, location and setback from property lines 95% · published checklist
    • Is a one-line / three-line diagram required? Yes 95% · published checklist
    • Is a structural PE stamp required, and at what threshold? Yes, for pole/ground-mounted arrays only — 'Pole-mounted arrays will require a California licensed engineer's design.' No PE-stamp threshold is stated for standard roof-mounted residential arrays on a conforming roof structure. 85% · published process document
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

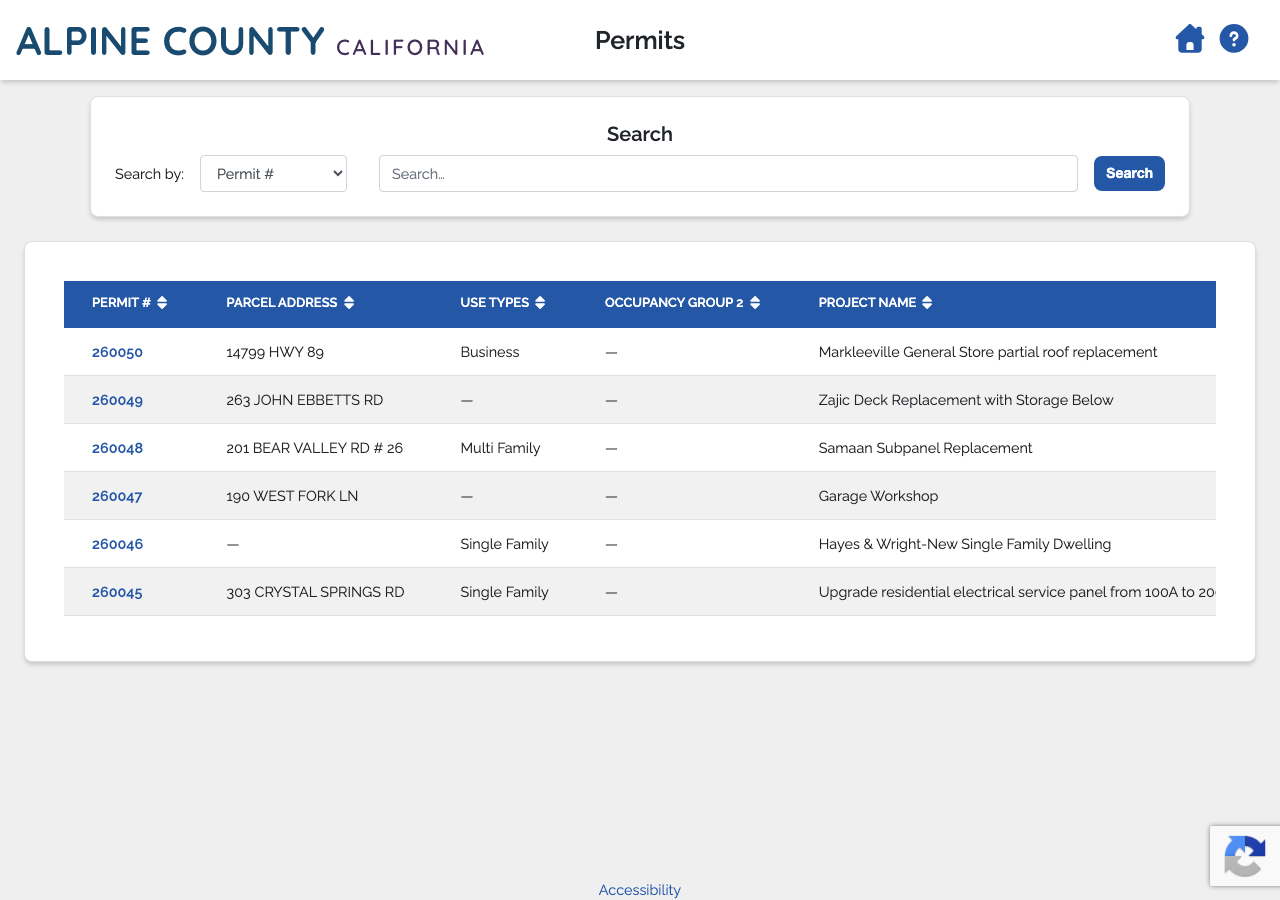

    • Which permit portal does this authority use? iWorq — 'Building Division Online Portal' at alpinecounty.portal.iworq.net 90% · department page
    • Can the whole application be completed online? Yes 85% · published process document + ordinance
    • What does a residential solar permit cost? No dedicated PV/solar fee line was found; solar permits appear to fall under the general valuation-based Building Fee Table (New Construction) in the Building Permit Information Guide — e.g. $226 for the first $2,500 of valuation, plus $36.13 per additional $1,000 up to $25,000, escalating through six valuation tiers to $9,513 + $6.78/$1,000 over $1,000,000 65% · published fee schedule (PDF)
    • How is the fee calculated? Valuation 65% · published fee schedule
    • Is there a separate plan-check fee? Yes 70% · published fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? Approximately 3 business days for a complete, expedited small-residential-rooftop-solar submission 90% · published process document
    • How long is an issued permit valid before it expires? 12 months from issuance to commence/continue work (or if work is suspended/abandoned for 12 months); Building Official may grant one or more 180-day extensions; maximum open-permit validity is 4 years unless specifically approved otherwise 90% · ordinance
    • Which utility handles interconnection here? Split by community: PG&E, Liberty Utilities (CalPeco), and Kirkwood Meadows Public Utility District (KMPUD) all serve different parts of the county — the County's own 2018 Multi-Jurisdictional Hazard Mitigation Plan lists 'Electricity: PG&E, Liberty Energy, & KMPUD' as the county's utility distributors, and its power-outage table separately shows outages recorded under 'Liberty' at Markleeville and near Woodfords (the county-seat area). KMPUD is a public utility district that generates/distributes its own electric service to the Kirkwood valley (drawing transmission via a PG&E-connected line), functioning as a municipally-owned utility rather than a CPUC-regulated IOU for that area. 70% · county hazard mitigation plan (PDF, dated Aug. 2018)
    • Where does the utility sit in the sequence? Parallel — the County's building-permit approval is expressly independent of, and does not authorize, utility interconnection 80% · ordinance

28 questions answered against Alpine County’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherAlpine County has zero incorporated cities (Wikipedia; also stated on multiple county documents), so the County Building Safety Division is AHJ for every address in the county by default; confirmed by the Building Safety Division's own page describing itself as issuer of building permits/plan checks/inspections countywide.

department page checked 2026-08-31 https://www.alpinecountyca.gov/157/Building-Safety-Division

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherThe County adopts and enforces both the building code (CBC/CRC) and the electrical code (CEC) itself via Alpine County Code §15.04.020 (adoption of the 2022 CBC/CRC/CEC/CFC/CMC/CPC by reference); no delegation to a private plan-check or inspection firm was found anywhere on the site (single named in-house Building Official, Tony Creter).

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherBuilding Safety Division page lists 'Roof and Ground Mount Solar Installation' under work requiring permits and inspections; the County's dedicated 'Expedited Permit Process for Small Solar Photovoltaic (PV) Systems' (2022) confirms a permit is required for all such systems.

published process document (PDF) checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherNo distinct 'electrical permit' application or fee line was found anywhere on the site or in the Building Permit Information Guide; the Solar Expedited Permit Process directs applicants to submit 'a completed Building Permit Application and Solar Expedited PV Permit or similar document' as a single package covering the electrical single-line as part of the same submittal.

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherBuilding Safety Division page: 'Only licensed contractors and property owners (Owner/Builder) may be issued building permits' — the County issues one combined permit (building+electrical) to either a licensed contractor or a qualifying owner-builder; no separate rule restricts the electrical scope specifically to a licensed electrician.

department page checked 2026-08-31 https://www.alpinecountyca.gov/157/Building-Safety-Division

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

No

Why the confidence is not higherNo county-specific contractor pre-registration/business-license step for building permits was found on the Building Safety Division page, the Building Permit Information Guide, or the Solar Expedited Permit Process — the checklist requires only a license number at submittal, consistent with routine CSLB-number verification rather than a separate registration.

department page (absence checked) checked 2026-08-31 https://www.alpinecountyca.gov/158/Building-Documents-References

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherBuilding Safety Division page states Owner/Builders may be issued permits and 'assume full responsibility for the work,' restricted to their 'principal place of residence that they have occupied for 12 months or more' — this applies to solar as one of the listed permit types (roof/ground mount solar) with no carve-out excluding electrical scope from owner-builder self-permitting.

department page checked 2026-08-31 https://www.alpinecountyca.gov/157/Building-Safety-Division

Q8 What documents make up a complete submittal? Core Submittal package

Cover page (owner name, project address, scope of work, designer/contractor name, applicable code); Site plan (array location, main/grid disconnect locations, north arrow; for roof-mount: roof pitch, 3-ft eave-to-ridge pathway, 3-ft eave/ridge clearances; for pole-mount: location and property-line setback); Electrical single-line drawing (AC/DC disconnects, OCPD, grounding, GFP, combiner/junction boxes, conductor/conduit type and size, inverters, any batteries/charge controllers/generator connections); Manufacturer spec sheets for all PV equipment/mounting (listed by an approved testing agency; pole-mount requires a CA-licensed engineer's design); Detail sheet for equipment marking/signage (UL 969, CEC Art. 690)

Why the confidence is not higherDirectly extracted (pdftotext) from the County's own current 'Expedited Permit Process for Small Solar Photovoltaic (PV) Systems,' dated 2022 (post-Jan-1-2023 code cycle), linked from the current Building Documents & References page.

published checklist (PDF) checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q9 How many copies, and in what format? Submittal package

Preferred: electronic submittal via the online portal (Building Division Online Portal / iWorq). If not submitted online, two (2) hard copies of the plan set are required. Electronic signatures are expressly allowed in lieu of wet signatures for small residential rooftop systems.

Why the confidence is not higherSolar Expedited Permit Process 2022: 'Projects must be submitted online using the Building Division Online Portal... If the project is not submitted online... provide two (2) copies.' Alpine County Code §15.04.070(C)(3) separately confirms electronic signatures are acceptable in lieu of a wet signature.

published process document + ordinance checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes — must show location of the array, a readily accessible main/array disconnect location, grid power main disconnect (if applicable), north arrow; for roof-mount, roof pitch plus a minimum 3-ft-wide pathway from eave to ridge and 3-ft clearances from eaves/ridges; for pole-mount, location and setback from property lines

Why the confidence is not higherExplicit line items in the County's own Solar Expedited Permit Process 2022.

published checklist checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes

Why the confidence is not higherSolar Expedited Permit Process 2022 requires an 'Electrical single-line drawing' itemizing disconnects, OCPD, grounding, GFP, combiner boxes, conductor/conduit sizing, inverters, and any storage/generator interconnections.

published checklist checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q12 Are string and conductor calculations required? Drawings & calculations

Nothing published by this authority.

Where we lookedFull text of the Solar Expedited Permit Process 2022 (DocumentCenter/View/6773) and Alpine County Code §15.04.070 — both require a single-line electrical diagram but neither itemizes a separate 'string and conductor calculations' document distinct from that diagram

https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Yes, for pole/ground-mounted arrays only — 'Pole-mounted arrays will require a California licensed engineer's design.' No PE-stamp threshold is stated for standard roof-mounted residential arrays on a conforming roof structure.

Why the confidence is not higherDirect text of the County's Solar Expedited Permit Process 2022, under Submission of Plans item 4.

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedSolar Expedited Permit Process 2022 and Alpine County Code §15.04.020/.030 (CEC amendments) — neither states an electrical-PE-stamp threshold for residential PV; only the structural/pole-mount PE requirement (Q13) is stated

https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q15 What does a residential solar permit cost? Core Fees

No dedicated PV/solar fee line was found; solar permits appear to fall under the general valuation-based Building Fee Table (New Construction) in the Building Permit Information Guide — e.g. $226 for the first $2,500 of valuation, plus $36.13 per additional $1,000 up to $25,000, escalating through six valuation tiers to $9,513 + $6.78/$1,000 over $1,000,000

Why the confidence is not higherThe Building Permit Information Guide's fee table is titled 'BUILDING VALUATION DETERMINATION' / 'BUILDING FEE TABLE (New Construction)' and is the only fee schedule the Building Safety Division publishes; it is not explicitly stated to apply to alteration/retrofit permits like solar, so this is an inference from the only published fee mechanism, not a confirmed solar-specific line — lower confidence reflects that ambiguity.

published fee schedule (PDF) checked 2026-08-31 https://www.alpinecountyca.gov/DocumentCenter/View/5082/Building-Permit-Information-Guide-202238_-Final

Q16 How is the fee calculated? Core Fees

Valuation

Why the confidence is not higherSame basis as Q15 — the only published building fee mechanism is the valuation-tiered table; no per-kW or per-panel solar-specific fee was found anywhere on the site.

published fee schedule checked 2026-08-31 https://www.alpinecountyca.gov/DocumentCenter/View/5082/Building-Permit-Information-Guide-202238_-Final

Q17 Is there a separate plan-check fee? Fees

Yes

Why the confidence is not higherThe Building Permit Information Guide separately lists a 'Plan Review Deposit' (based on valuation, distinct from the building-permit fee table) and a Miscellaneous Building Fees line for 'Additional plan review required by changes, additions or revisions to approved plans' ($151/hr) — evidence of plan-check being billed separately from the permit/inspection fee, though not broken out per-project-type as a solar-specific line.

published fee schedule checked 2026-08-31 https://www.alpinecountyca.gov/DocumentCenter/View/5082/Building-Permit-Information-Guide-202238_-Final

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Approximately 3 business days for a complete, expedited small-residential-rooftop-solar submission

Why the confidence is not higherSolar Expedited Permit Process 2022: 'The review process typically occurs within three days following complete submission of plan documents.' (General, non-solar plan review is stated elsewhere as 3 weeks, but the solar-specific expedited timeline governs qualifying systems.)

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q19 How long is an issued permit valid before it expires? Timeline & validity

12 months from issuance to commence/continue work (or if work is suspended/abandoned for 12 months); Building Official may grant one or more 180-day extensions; maximum open-permit validity is 4 years unless specifically approved otherwise

Why the confidence is not higherAlpine County Code §15.04.030 amends CBC §105.5/CRC §R105.5 (Expiration) with this exact language, applicable to all building permits including solar.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q20 Which permit portal does this authority use? Core Portal & process

iWorq — 'Building Division Online Portal' at alpinecounty.portal.iworq.net

Why the confidence is not higherNamed and linked directly from the Building Safety Division page and the Solar Expedited Permit Process document as the required online submittal route.

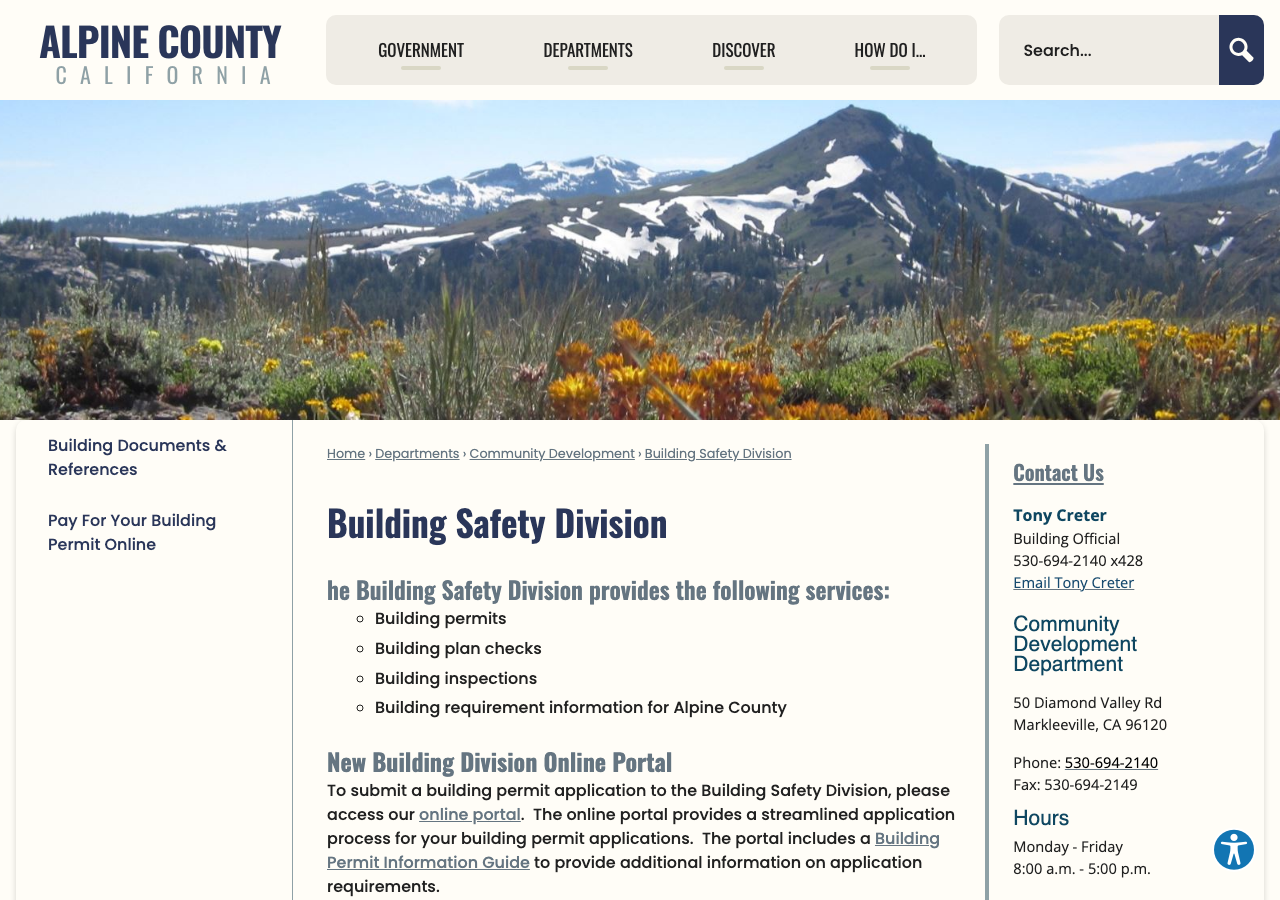

department page checked 2026-08-31 https://www.alpinecountyca.gov/157/Building-Safety-Division

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherSolar Expedited Permit Process 2022 requires online submission via the portal by default ('will not be reviewed... over-the-counter') and Alpine County Code §15.04.070(C)(3) expressly allows electronic signatures 'in lieu of a wet signature' for small residential rooftop systems, indicating a fully electronic path is supported (the portal itself returned HTTP 403 to both a plain fetch and a rendered-browser fetch, so its interior UI could not be independently verified).

published process document + ordinance checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q22 Which utility handles interconnection here? Core Utility interconnection

Split by community: PG&E, Liberty Utilities (CalPeco), and Kirkwood Meadows Public Utility District (KMPUD) all serve different parts of the county — the County's own 2018 Multi-Jurisdictional Hazard Mitigation Plan lists 'Electricity: PG&E, Liberty Energy, & KMPUD' as the county's utility distributors, and its power-outage table separately shows outages recorded under 'Liberty' at Markleeville and near Woodfords (the county-seat area). KMPUD is a public utility district that generates/distributes its own electric service to the Kirkwood valley (drawing transmission via a PG&E-connected line), functioning as a municipally-owned utility rather than a CPUC-regulated IOU for that area.

Why the confidence is not higherSourced from the County's own dated (Aug. 2018) Hazard Mitigation Plan Table 5-5 ('Utility Distributors') and Table 5-6 (outage log naming 'Liberty' as the utility of record for outages at Markleeville and Woodfords), corroborated by KMPUD's own site describing its Electrical Service department and its connection 'to the national grid via PG&E.' Confidence is not higher because the HMP is 8 years old and a newer county-wide utility map could not be located; PowerToChoose was deliberately not used per this survey's rule against relying on it.

county hazard mitigation plan (PDF, dated Aug. 2018) checked 2026-08-31 https://www.alpinecountyca.gov/DocumentCenter/View/4553/Hazard-Mitigation-Plan_Adopted-20180807

Q23 Where does the utility sit in the sequence? Core Utility interconnection

Parallel — the County's building-permit approval is expressly independent of, and does not authorize, utility interconnection

Why the confidence is not higherAlpine County Code §15.04.070(C)(7): 'Such approval does not authorize an applicant to connect the small residential rooftop energy system to the local utility provider's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility provider.' This places utility approval as a parallel, applicant-managed track rather than a formal predecessor/successor step defined by the County.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No (as a County permitting requirement) — though the County advises checking private CC&Rs where they exist

Why the confidence is not higherAlpine County Code §15.04.070(B)(2) cross-references Civil Code §714(c)(3) (the CA Solar Rights Act, which limits HOA authority to restrict solar), and §15.04.070(C)(7) has the building official 'administratively approve' qualifying applications with no HOA-approval step. Separately, the County's Building Permit Information Guide only advises (does not require) contacting an HOA where CC&Rs exist.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q25 Is there a historic-district review? Overlays & special cases

No

Why the confidence is not higherA historic-district ('DH' — downtown historic zone) exists only in Markleeville for the Planning Division's Sign Permit fee category; no historic-review trigger for residential rooftop/ground solar was found in Title 15 or the Solar Expedited Permit Process, consistent with the ordinance's administrative (non-discretionary) approval path for qualifying systems.

fee schedule (absence checked against Planning fee schedule and Title 15) checked 2026-08-31 https://www.alpinecountyca.gov/DocumentCenter/View/7419/Application-Fee-Schedule

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherNo windstorm-certification requirement analogous to a coastal-Texas TDI process was found; Alpine's own wind design is handled entirely through the CBC/CRC structural amendments (§15.04.030's Case-Study wind-speed table by region), not a separate certification instrument.

ordinance (absence checked) checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Nothing published by this authority.

Where we lookedAlpine County Code §15.04.070 (small residential rooftop systems) and the Planning Division's Application Fee Schedule (which lists Conditional Use Permit and Variance categories generally, without a solar-specific trigger) — no text states whether residential systems above the 10 kW AC expedited threshold require Planning Commission or Board of Supervisors approval

https://www.alpinecountyca.gov/DocumentCenter/View/7419/Application-Fee-Schedule

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No hard cap on residential solar system size; the ordinance instead defines a 'small residential rooftop solar energy system' eligible for expedited/administrative approval as one no larger than 10 kW AC nameplate (or 30 kW thermal) — larger residential systems are permittable but fall outside the expedited/ministerial track defined by §15.04.070

Why the confidence is not higherAlpine County Code §15.04.070(B) definition, read directly from the codified ordinance.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2020 90% · ordinance
    • Which building code edition is in force? 2022 California Building Code / 2022 California Residential Code (based on the 2021 IBC/IRC) 95% · ordinance
    • Which fire code edition is in force? 2022 California Fire Code (based on the 2021 International Fire Code) 95% · ordinance
    • Are there local amendments to any of the above? Yes 95% · ordinance
    • What is the installation judged against? The 2022 California Electrical Code (2020 NEC base, as locally amended), plus equipment listing by an approved testing agency (UL) and manufacturer's installation instructions 90% · ordinance + published process document
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Minimum 3-foot-wide pathway from eave to ridge, and 3-foot clearances from both eaves and ridges, for roof-mounted arrays 95% · published process document
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Yes, per NEC 690.12 (rapid shutdown) as incorporated via the 2022 CEC (2020 NEC base) — no local amendment to Article 690 or a distinct county rapid-shutdown rule was found 70% · ordinance (inference from adopted code edition)
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? Standard NEC Article 690 / UL 969 placards at the PV disconnect(s), inverter/AC-disconnect location, and main service (dual-power-source warning) — the County does not add placards beyond what CEC Article 690 requires 65% · published example diagram (image-only PDF, OCR'd)
    • Does the authority specify placard wording of its own? No 75% · published process document
    • Does it specify letter height, colour or material? Yes — 'Fade-resistant permanently affixed labels and signage with white lettering on a red background' 90% · published process document
    • Is a site plan / facility map placard required, and what must it show? The required site plan itself functions as the facility map — it must show array location, main/array disconnect, grid main disconnect, north arrow, and (roof-mount) pathway/clearance dimensions; no separate freestanding 'facility map placard' at the meter was found beyond the standard NEC 705.10 directory inherited via the adopted 2022 CEC 65% · published process document
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Must equipment be on a specific approved list? Yes 95% · published process document
    • Are batteries permitted, and under what conditions? Batteries are permitted as part of the same PV permit — the required electrical single-line drawing must show 'additional standby systems including batteries, charge controllers, and generator connections (if applicable)' — but no distinct battery/ESS-specific fire or installation standard beyond general listing/manufacturer-instruction compliance was found 60% · published process document
    • Is there a separate ESS permit or inspection? No 55% · ordinance (absence checked with controls)
    • Is a ground mount treated as a structure? Yes (implied) 65% · published process document (inference)
    • Is a specific mounting system or attachment spacing required? No solar-specific mounting/attachment-spacing rule was found; general structural design amendments in §15.04.030 (Case-Study wind-speed regions, elevation-based snow-load tables up to 488 psf, footing depth rules above 6,200 ft) apply to any roof or ground attachment, including PV racking, but are not solar-specific 60% · ordinance (absence checked with controls)

20 questions answered against Alpine County’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2020

Why the confidence is not higherAlpine County Code §15.04.020(D) adopts 'The National Electrical Code, 2020 Edition... (California Electrical Code, 2022 Edition)' as the base NFPA text underlying the 2022 CEC.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q30 Which building code edition is in force? Core Code editions in force

2022 California Building Code / 2022 California Residential Code (based on the 2021 IBC/IRC)

Why the confidence is not higherAlpine County Code §15.04.020(B),(C), adopted by reference with extensive local amendments in §15.04.030, effective for permits submitted after Jan. 1, 2023.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q31 Which fire code edition is in force? Code editions in force

2022 California Fire Code (based on the 2021 International Fire Code)

Why the confidence is not higherAlpine County Code §15.04.020(I), with local amendments to CFC §202, §901.4.7, §903.3.1.2, §903.4.1 and §6104 in §15.04.030.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherAlpine County Code §15.04.030 contains extensive local amendments — elevation-based snow-load tables by named community (up to 488 psf ground snow load above 8,000 ft), Case-Study wind-speed regions, Seismic Design Category D determination, deeper footing/frost-line depths above 6,200 ft, ice-barrier and roof-covering amendments, plus CFC amendments to the fire-code-official definition, sprinkler riser rooms, NFPA 13R systems, monitoring, and LP-gas container installation. None of these amendments specifically target solar/PV, but they govern the structural design any roof-mounted racking or ground-mount footing must meet.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q33 What is the installation judged against? Core Electrical

The 2022 California Electrical Code (2020 NEC base, as locally amended), plus equipment listing by an approved testing agency (UL) and manufacturer's installation instructions

Why the confidence is not higherCombines Alpine County Code §15.04.020(D) (adopted CEC edition) with the Solar Expedited Permit Process's item 4 ('All equipment shall be listed by an approved testing agency... installed in conformance with applicable codes and manufacturer's instructions').

ordinance + published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Nothing published by this authority.

Where we lookedFull codified text of Chapter 15.04 (Technical Building Codes), including §15.04.030's CEC/CMC/CPC amendments — searched with positive control 'electrical' (14 hits) and fabricated control 'zzqqx' (0 hits), confirming the search worked; no service-upgrade or busbar-sizing amendment (e.g. a 120%-rule modification) was found

https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

No solar-specific mounting/attachment-spacing rule was found; general structural design amendments in §15.04.030 (Case-Study wind-speed regions, elevation-based snow-load tables up to 488 psf, footing depth rules above 6,200 ft) apply to any roof or ground attachment, including PV racking, but are not solar-specific

Why the confidence is not higherFull-text search of the codified Chapter 15.04 (positive control 'electrical' = 14 hits, fabricated control 'zzqqx' = 0 hits, confirming the search was functioning) found no mounting-spacing clause; the structural amendments above are the only applicable design criteria identified.

ordinance (absence checked with controls) checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Minimum 3-foot-wide pathway from eave to ridge, and 3-foot clearances from both eaves and ridges, for roof-mounted arrays

Why the confidence is not higherDirect text of the County's Solar Expedited Permit Process 2022, site-plan requirements.

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Yes, per NEC 690.12 (rapid shutdown) as incorporated via the 2022 CEC (2020 NEC base) — no local amendment to Article 690 or a distinct county rapid-shutdown rule was found

Why the confidence is not higherInference from the code edition adopted (Q29/Q33); rapid shutdown is a mandatory NEC 690.12 requirement under the 2020 NEC, and no county text (checked with the same positive/fabricated controls as Q35) modifies or exempts it.

ordinance (inference from adopted code edition) checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

Standard NEC Article 690 / UL 969 placards at the PV disconnect(s), inverter/AC-disconnect location, and main service (dual-power-source warning) — the County does not add placards beyond what CEC Article 690 requires

Why the confidence is not higherSolar Expedited Permit Process 2022 requires a 'Detail sheet for marking or signage of installed equipment... pursuant to UL 969 and Article 690 of the California Electrical Code' and references a generic 'Solar PV Marking Diagram' example (OCR'd) showing standard NEC labels (main service dual-power warning, PV disconnect, inverter OCPD/AC-disconnect warnings) — this is the industry-standard Solar ABCs example the County links to, not a custom county-specific placard list.

published example diagram (image-only PDF, OCR'd) checked 2026-08-31 https://www.alpinecountyca.gov/DocumentCenter/View/1146

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

No

Why the confidence is not higherThe County requires labels 'pursuant to UL 969 and Article 690 of the California Electrical Code' and links a generic industry example (Solar ABCs 'Standard String System' marking diagram) rather than specifying its own custom wording.

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Yes — 'Fade-resistant permanently affixed labels and signage with white lettering on a red background'

Why the confidence is not higherDirect text of the County's Solar Expedited Permit Process 2022, item 5 of the submission requirements.

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

The required site plan itself functions as the facility map — it must show array location, main/array disconnect, grid main disconnect, north arrow, and (roof-mount) pathway/clearance dimensions; no separate freestanding 'facility map placard' at the meter was found beyond the standard NEC 705.10 directory inherited via the adopted 2022 CEC

Why the confidence is not higherDerived from the Solar Expedited Permit Process 2022 site-plan requirements; no distinct facility-map-placard clause was found in Title 15 (checked with the same controls as Q35).

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedAttempted to reach Liberty Utilities' (CalPeco) California interconnection/Rule 21/NEM pages (libertyutilities.com/california.html and california.libertyutilities.com, both plain-fetch and headless-Chrome-rendered — the domain resolves only to a generic corporate landing page with no state-specific solar/interconnection content), PG&E's interconnection page (404), and KMPUD's Electrical Service page (no NEM/solar content found) — none of the three utilities serving different parts of the county had a reachable DG-manual or placard-specification page

https://www.libertyutilities.com/california.html

Q43 Where must the labels be placed? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame sources as Q38/Q40/Q41 — the marking-diagram example (DocumentCenter/View/1146) shows label locations (main service, PV/DC disconnect, inverter OCPD/AC disconnect) generically but the County's own text does not add placement instructions beyond 'readily accessible location' for the main disconnect

https://www.alpinecountyca.gov/DocumentCenter/View/1146

Q44 Must equipment be on a specific approved list? Equipment listing

Yes

Why the confidence is not higherSolar Expedited Permit Process 2022: 'All equipment shall be listed by an approved testing agency.'

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Batteries are permitted as part of the same PV permit — the required electrical single-line drawing must show 'additional standby systems including batteries, charge controllers, and generator connections (if applicable)' — but no distinct battery/ESS-specific fire or installation standard beyond general listing/manufacturer-instruction compliance was found

Why the confidence is not higherOnly mention of batteries in the codified Title 15 text (1 hit on 'batter*', confirmed via the same controlled full-text search used for Q35) is this single-line-diagram line item; no dedicated ESS section exists.

published process document checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No

Why the confidence is not higherNo separate ESS permit or inspection type was found; batteries are folded into the same single-line-diagram submittal and the same one-inspection process as the PV system itself (see Q52/Q55), per full-text search of Title 15 (0 hits for 'ESS', positive control 'electrical' = 14 hits, fabricated control 'zzqqx' = 0 hits).

ordinance (absence checked with controls) checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q47 Is a ground mount treated as a structure? Core Ground mount

Yes (implied)

Why the confidence is not higherThe Solar Expedited Permit Process requires pole/ground-mounted arrays to show 'location and setback from property lines' on the site plan and to be designed by a California-licensed engineer — treatment consistent with a structure for setback/engineering purposes — but no ordinance text explicitly labels a ground-mount PV array as 'a structure' under the zoning code.

published process document (inference) checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedSame utility-DG-manual search as Q42 (Liberty Utilities/CalPeco, PG&E, and KMPUD sites) — none reachable with AC-disconnect/meter-clearance specifications; the County's own Solar Expedited Permit Process only requires the array/grid disconnects be shown on the site plan without specifying a distance from the meter

https://www.libertyutilities.com/california.html

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 90% · ordinance
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? One consolidated final inspection (potentially combining the building official and the local volunteer fire chief for the applicable response area) after plan-check approval and permit issuance; a follow-up inspection is authorized if the system fails the first one 80% · ordinance
    • Is a rough-in or mid-roof inspection required? No 90% · ordinance
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? No dedicated field-inspection checklist is published — the County publishes a submittal/plan checklist (the Solar Expedited Permit Process) but no separate document describing what the inspector checks in the field 60% · department page (absence checked)
    • Does the inspector verify labels and listings? Yes (inferred) 55% · published process document (inference)
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final (signed-off permit/inspection card) — no Certificate of Occupancy applies since a rooftop solar retrofit does not create a new occupancy 55% · ordinance (inference)
    • Who notifies the utility for PTO? Installer 85% · ordinance
    • Is there a re-inspection fee? $151.00 per hour (1-hour minimum, plus mileage) for a 2nd re-inspection; the same $151/hr rate applies to 'inspections for which no fee is specifically indicated or unpermitted work' 90% · published fee schedule (PDF)

14 questions answered against Alpine County’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Phone

Why the confidence is not higherNo dedicated online inspection-scheduling page was found; the only named contact for the Building Safety Division is the Building Official's direct phone/extension. The iWorq online portal (used for permit applications) may also support inspection requests, but its interior UI returned HTTP 403 to both a plain curl fetch and a headless-Chrome rendered fetch and could not be verified.

department page (contact info) checked 2026-08-31 https://www.alpinecountyca.gov/157/Building-Safety-Division

Q50 How much notice is required? Core Booking & scheduling

Nothing published by this authority.

Where we lookedBuilding Safety Division page, Building Permit Information Guide, and Solar Expedited Permit Process 2022 — none states a minimum advance-notice period for scheduling an inspection

https://www.alpinecountyca.gov/157/Building-Safety-Division

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Nothing published by this authority.

Where we lookedSame three documents as Q50 — none mentions same-day booking or AM/PM inspection windows

https://www.alpinecountyca.gov/157/Building-Safety-Division

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherAlpine County Code §15.04.070(C)(5): for an expedited-eligible small residential rooftop system, 'only one inspection shall be required... may include a consolidated inspection by the building official and fire chief' — performed in-house by the County, not delegated.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q53 If delegated, to whom? Core Who inspects

Nothing published by this authority.

Where we lookedAlpine County Code §15.04.070(C)(5) — the final inspection is performed by the County itself (building official, optionally jointly with the local volunteer fire chief for that response area), not delegated to an outside agency, so this question does not apply

https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q54 Which inspections are required, and in what order? Core Stages & sequence

One consolidated final inspection (potentially combining the building official and the local volunteer fire chief for the applicable response area) after plan-check approval and permit issuance; a follow-up inspection is authorized if the system fails the first one

Why the confidence is not higherAlpine County Code §15.04.070(C)(5): 'only one inspection shall be required, which shall be done in a timely manner and may include a consolidated inspection by the building official and fire chief... If a small residential rooftop solar energy system fails inspection, a subsequent inspection is authorized.'

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No

Why the confidence is not higherAlpine County Code §15.04.070(C)(5) expressly limits qualifying small residential rooftop systems to a single inspection, precluding a separate rough-in/mid-roof inspection stage for the expedited track.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q56 Does the inspector verify labels and listings? Core What is checked

Yes (inferred)

Why the confidence is not higherThe submittal checklist requires a marking/signage detail sheet per UL 969/Article 690 and equipment listed by an approved testing agency; standard building-inspector practice is to verify installed labels and listed equipment match the approved plans at final, though no document states this explicitly as an inspection-checklist item.

published process document (inference) checked 2026-08-31 https://alpinecountyca.gov/DocumentCenter/View/6773/Solar-Expedited-Permit-Process-2022

Q57 Is there a published inspection checklist? Core What is checked

No dedicated field-inspection checklist is published — the County publishes a submittal/plan checklist (the Solar Expedited Permit Process) but no separate document describing what the inspector checks in the field

Why the confidence is not higherChecked Building Documents & References page in full; only the submittal-side checklist and forms are listed (Solar Expedited Permit Process, Owner-Builder Package, Authorization of Agent, etc.) — no inspection-specific checklist document was found.

department page (absence checked) checked 2026-08-31 https://www.alpinecountyca.gov/158/Building-Documents-References

Q58 What must be on site at inspection? Core Documents on site

Nothing published by this authority.

Where we lookedBuilding Safety Division page, Building Permit Information Guide, and Solar Expedited Permit Process 2022 — none specifies a list of documents required to be physically present on-site at the time of inspection

https://www.alpinecountyca.gov/157/Building-Safety-Division

Q59 Is there a re-inspection fee? Corrections & re-inspection

$151.00 per hour (1-hour minimum, plus mileage) for a 2nd re-inspection; the same $151/hr rate applies to 'inspections for which no fee is specifically indicated or unpermitted work'

Why the confidence is not higherDirectly extracted (pdftotext) from the County's own current Building Permit Information Guide, Miscellaneous Building Fees table.

published fee schedule (PDF) checked 2026-08-31 https://www.alpinecountyca.gov/DocumentCenter/View/5082/Building-Permit-Information-Guide-202238_-Final

Q60 How are corrections issued and cleared? Corrections & re-inspection

Nothing published by this authority.

Where we lookedBuilding Permit Information Guide describes only the plan-check correction/resubmittal process ('Correction and resubmitted drawings are often necessary after the initial plan review... applicant, architect or engineer is notified'); no document describes how field-inspection corrections (as opposed to plan-review corrections) are issued or cleared

https://www.alpinecountyca.gov/DocumentCenter/View/5082/Building-Permit-Information-Guide-202238_-Final

Q61 What is issued on pass? Core Final sign-off & PTO

Final (signed-off permit/inspection card) — no Certificate of Occupancy applies since a rooftop solar retrofit does not create a new occupancy

Why the confidence is not higherInferred from the general permitting framework (no CO/TCO provision in §15.04.030 applies to alteration permits on an already-occupied dwelling) — no document explicitly states what document is issued on passing the solar final inspection.

ordinance (inference) checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer

Why the confidence is not higherAlpine County Code §15.04.070(C)(7): County approval 'does not authorize an applicant to connect the small residential rooftop energy system to the local utility provider's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility provider' — i.e., the applicant/installer, not the County, is responsible for securing PTO.

ordinance checked 2026-08-31 https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for Alpine County against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

Alpine County is the authority having jurisdiction 95% confidence
Holds
Building, electrical, mechanical, plumbing, and fire-code enforcement (as 'fire code official') for the entire county — Alpine has NO incorporated cities, so the county Building Safety Division is the sole AHJ for every address in the county, including Markleeville, Woodfords, Bear Valley/Mesa Vista and Kirkwood
Overridden by
For projects in the Kirkwood valley, the applicant must additionally submit to Kirkwood Meadows Public Utility District (KMPUD) 'for review and acceptance' — a utility/service-standards review layered on top of, not instead of, the County's building permit; KMPUD is also the electric and water utility of record for Kirkwood. The applicant must separately obtain utility interconnection approval (from PG&E, Liberty Utilities/CalPeco, or KMPUD depending on location) before energizing — County permit issuance does not authorize grid connection (Alpine County Code §15.04.070(C)(7)).
Why not higher
Alpine County has no incorporated cities (confirmed via Wikipedia's county article: 'All communities in Alpine County are unincorporated'; it is one of only three CA counties with none). Alpine County Code Title 15 (Buildings and Construction) and its Building Safety Division page state the County issues 'Building permits, Building plan checks, Building inspections' with no carve-out language needed since there is no other incorporated jurisdiction anywhere in the county to carve out. §15.04.070 (Small residential rooftop energy systems) is the County's own AB 2188/Gov. Code §65850.5 expedited-permitting ordinance, administered by 'the building official.'

https://www.codepublishing.com/CA/AlpineCounty/#!/AlpineCounty15/AlpineCounty15.html

Check the code edition before you build

This authority's published code edition does not match what the state has adopted. That usually means the authority's ordinance has not been updated for the current cycle — but a local amendment can also be lawful. Confirm with the building department before you submit.

Building code
This authority publishes 2022 2022 California Building Code / 2022 California Residential Code (based on the 2021 IBC/IRC) 95% · source
The state has adopted 2024/2025 2025 California Building Code (Title 24, Part 2, Volumes 1 & 2), based on the 2024 International Building Code, and 2025 California Residential Code (Title 24, Part 2.5), 92% · source
Fire code
This authority publishes 2021/2022 2022 California Fire Code (based on the 2021 International Fire Code) 95% · source
The state has adopted 2024/2025 2025 California Fire Code (Title 24, Part 9), based on the 2024 International Fire Code, adopted by the Office of the State Fire Marshal with BSC approval. 90% · source
Permit required
Yes95%
Permit cost
No dedicated PV/solar fee line was found; solar permits appear to fall under the general valuation-based Building Fee Table (New Construction) in the Building Permit Information Guide —…65%
Plan review
Approximately 3 business days for a complete, expedited small-residential-rooftop-solar submission90%
Portal
iWorq — 'Building Division Online Portal' at alpinecounty.portal.iworq.net90%
Electrical code
202090%
Own placard wording
No75%
Booking an inspection
Phone50%
Labels & placards for this authority

Wording 75%

No

Size, colour & material 90%

Yes — 'Fade-resistant permanently affixed labels and signage with white lettering on a red background'

Where they go None%

What the utility wants on top None%

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
County
County
Alpine County
Regions served
4
Regions covered
Alpine Village · county
Kirkwood · county
Markleeville · county
Mesa Vista · county
Solar Requirements
Separate roof inspection
PERMITS AND INSPECTIONS ARE REQUIRED FOR THE FOLLOWING: New Attached or Detached Buildings and Structures (Residential and Non-Residential) with a floor area greater than 120 square feet* Tenant Improvements Roof and Ground Mount Solar Installation Patio Covers (Solid and Lattice) Enclosed Patios El
Authority Contact
Address
50 Diamond Valley Rd, Markleeville, CA 96120
Main Phone
530-694-2140
Office Hours
8 a.m. – 5 p.m.
Building Department
Department
Building Safety Division
Direct Phone
530-694-2140
Dept Hours
8 a.m. – 5 p.m.
Portal Software
iWorQ
Booking & Scheduling
Preferred channel
online
Booking phone
Notes
Inspection requests are submitted through the iWorQ online portal. Search for an active permit by permit number, then use the contractor access code to access the record and submit an inspection request. The request form collects requester name, phone, email, and preferred inspection date/time. Building Safety Division hours: Monday–Friday 8:00 AM–5:00 PM. Building Official Tony Creter can be reached at ext. 428 or tcreter@alpinecountyca.gov for direct inquiries. No specific advance-notice or same-day cutoff requirements were published on the site. (collected Jul 24 2026)
