City of Avenal

Kings County

Verified Aug. 4, 2026

City of Avenal is a city authority in the State of California, serving 13,696 residents. 571 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Where you file — SolarAPP+ (automated design review/approval) feeding into OpenGov Citizen Services / ViewPointCloud (avenalca.viewpointcloud.com) for the City permit application… Q20

Permit required
Yes95% source
What it costs
No solar-specific flat fee line exists. General Building Fees (FY2021-2022): Building Permit 'Per CBC Valuation'; Electrical Permit 'Per CEC, CBC Valuation + Issuance Fee' (issuance fee $41.25);72% source
Key document
SolarApp+ instructions + fee schedule cited by 6 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 92% · department page
    • What does this authority permit itself, and what does it delegate? Both 85% · department page + job postings
    • Is a permit required for a residential rooftop PV system? Yes 95% · department page + zoning ordinance
    • Is there a separate electrical permit, or is it combined? Combined 62% · SolarApp+ instructions + fee schedule
    • Is a HOA or architectural approval required first? No (HOA/architectural approval cannot be required as a precondition) 72% · zoning ordinance, Ch. 9.66
    • Is there a historic-district review? No 75% · zoning ordinance (control-checked absence)
    • Is a wind or windstorm certification required? No 70% · codified ordinance (control-checked absence)
    • Is a Specific Use Permit or Council approval ever required? Only if the Building Official makes an affirmative finding, based on substantial evidence, that the proposed system would have a 'specific, adverse impact' on public health or safety -- otherwise no Conditional Use Permit or City Council approval is required; review is administrative/ministerial. 90% · zoning ordinance, Ch. 9.66
    • Is there a system-size cap on residential generation? No numeric kW/thermal cap is stated in Avenal's own code. Chapter 9.66 defines its scope entirely by cross-reference to the state statutory definition -- 'small residential rooftop solar energy system' has 'the same meaning set forth in Government Code section 65850.5(j)(3)' -- rather than restating a local kW figure. Systems outside that state definition are not barred, they simply fall outside this expedited chapter and would be permitted through the standard (non-expedited) building-permit process. 78% · zoning ordinance, Ch. 9.66
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? For the standard SolarAPP+ path: (1) an automated SolarAPP+ design submittal, resulting in a downloadable 'SolarAPP+ Approval Document'; (2) a City permit application completed through OpenGov Citizen Services ('Building Permit Inspectional Services') with the SolarAPP+ Approval Document attached. For a general (non-SolarAPP+-eligible) building permit, the City's Homeowner's Guide separately calls for at least two complete sets of plans including a site/plot plan. 75% · department page + department handout
    • How many copies, and in what format? General (non-solar) policy: at least two (2) complete sets of plans submitted for plan check; one set is returned to the applicant at permit issuance. The SolarAPP+ path is submitted electronically/online rather than as physical plan sets. 55% · department handout (general, not solar-specific)
    • Is a site plan required, and what must it show? Yes -- a site/plot plan showing all property lines, all structures on the property, the street, the driveway, and the location of the proposed work (a sample site plan is provided by the Building Division). 62% · department handout (general, not solar-specific)
    • Is a one-line / three-line diagram required? Likely yes, via the SolarAPP+ platform's own standard design-submittal requirements (one-line diagrams are part of SolarAPP+'s national design-entry process), but Avenal has published no separate local document stating this requirement for its own permit process. 55% · inference from platform adoption
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

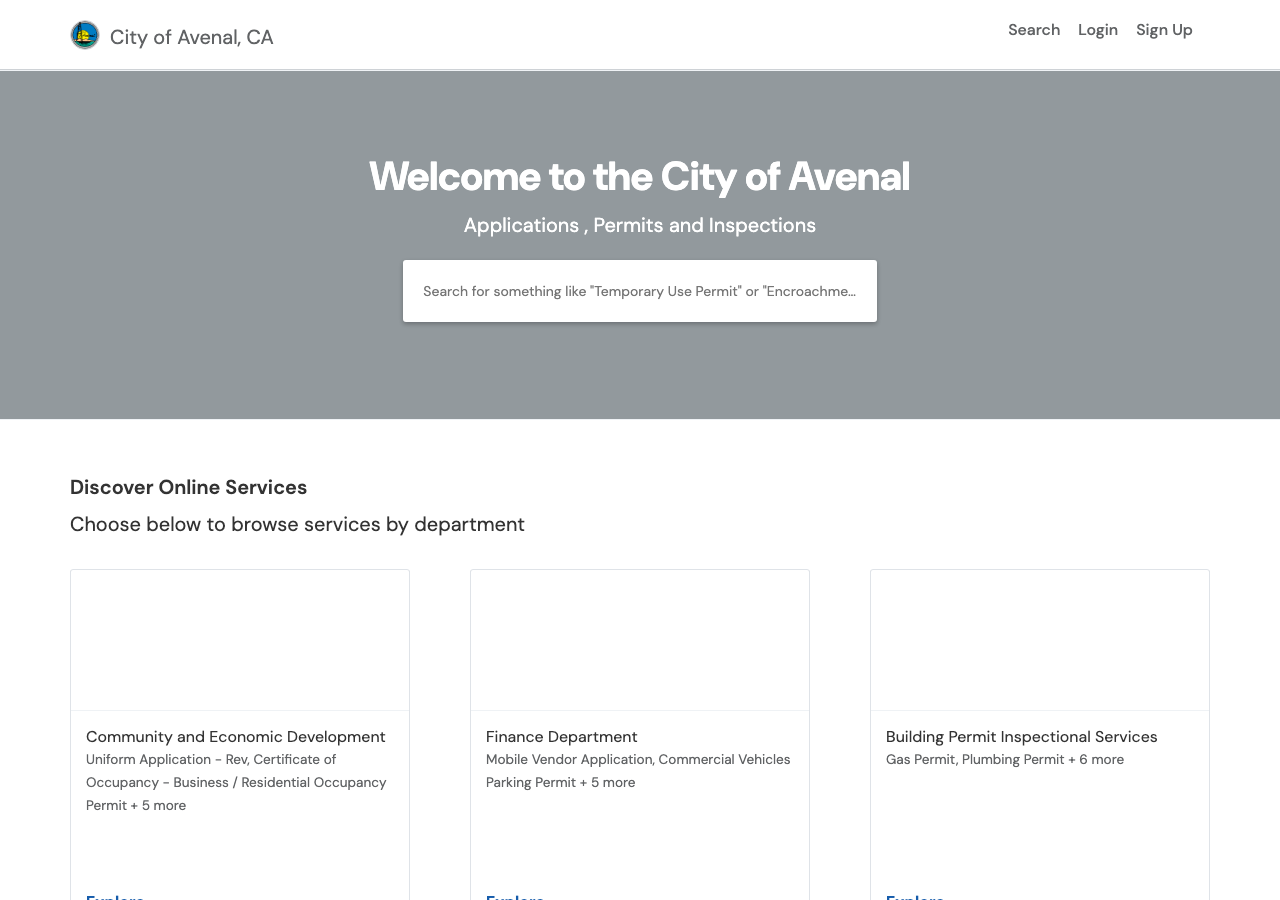

    • Which permit portal does this authority use? SolarAPP+ (automated design review/approval) feeding into OpenGov Citizen Services / ViewPointCloud (avenalca.viewpointcloud.com) for the City permit application itself; the City's public notice states ALL building, land-use/zoning and land-division permits must now be submitted online through this portal. 90% · department page
    • Can the whole application be completed online? Yes 75% · department page
    • What does a residential solar permit cost? No solar-specific flat fee line exists. General Building Fees (FY2021-2022): Building Permit 'Per CBC Valuation'; Electrical Permit 'Per CEC, CBC Valuation + Issuance Fee' (issuance fee $41.25); Building Plan Check 65% of Building Permit Fee. Separately, the SolarAPP+ platform itself charges a $35 administrative fee per project (paid directly to SolarAPP+, not the City). 72% · fee schedule + department page
    • How is the fee calculated? Valuation 78% · fee schedule
    • Is there a separate plan-check fee? Yes 85% · fee schedule + department handout
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

28 questions answered against City of Avenal’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

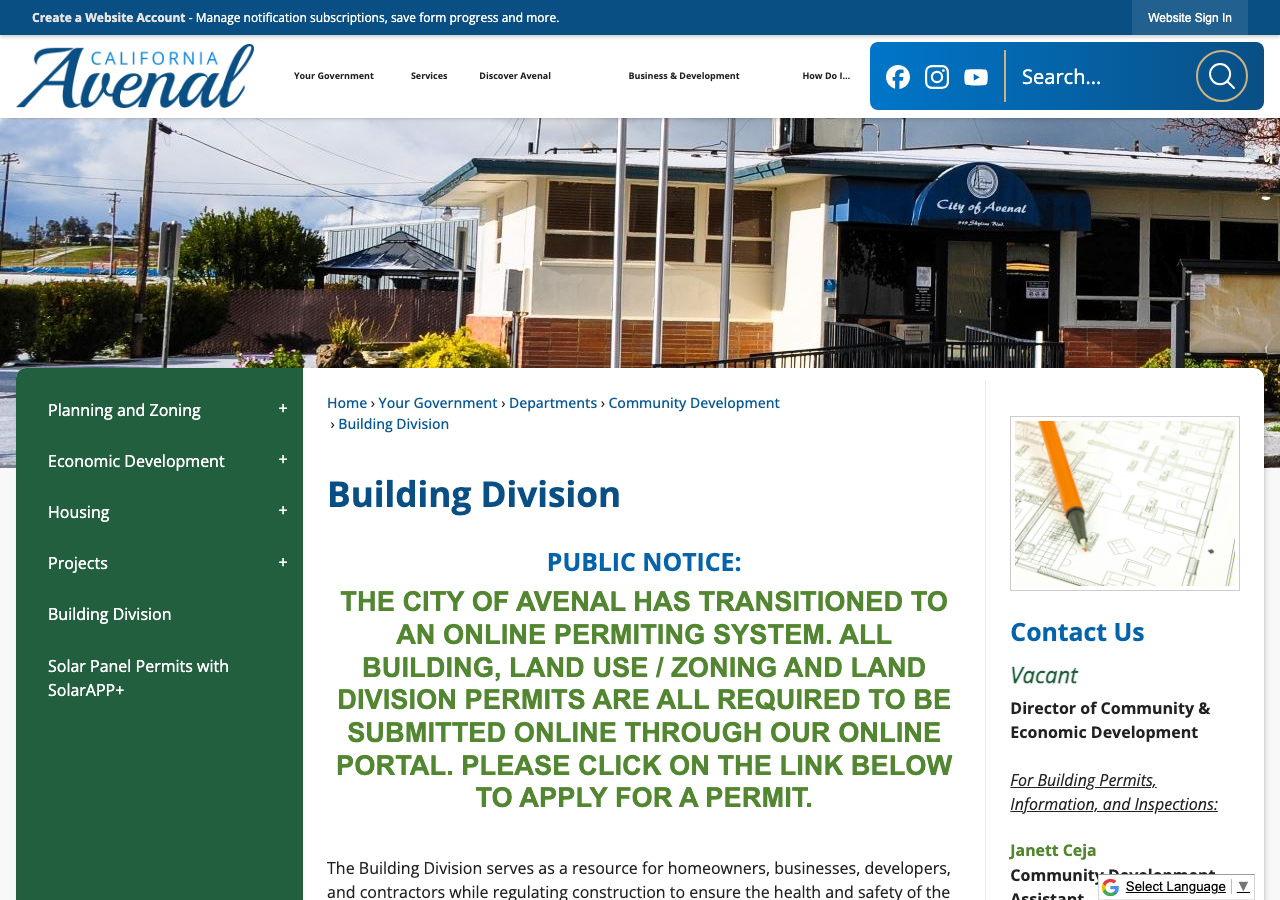

Why the confidence is not higherThe City of Avenal's own Community Development/Building Division page describes the full residential building/electrical permitting process (contracted to Willdan Engineering for building & inspection services), and the City's own Fire Department page confirms Avenal now operates its own municipal Fire Department (stood up 2025-2026, replacing the prior Kings County Fire Department service contract) which performs fire prevention, plan review, permits and inspections within city limits. Both departments are city-of-Avenal functions for property within the incorporated city limits.

department page checked 2026-08-31 https://www.cityofavenal.gov/459/Building-Division

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherBuilding AND Electrical are both handled through one Community Development Building Division / one permit process (Building Fees schedule prices Building, Electrical, Mechanical and Plumbing permits together under one department). Operationally, building plan review/inspection/code enforcement is CONTRACTED to Willdan Engineering per the city's own Building Division page ('The City of Avenal Currently contracts with Willdan Engineering for all Building and Inspection Services and well as Building Code Enforcement'), while a separate contract with A&M Engineering covers City/civil engineering services (named in Feb 2026 Planning Commission minutes, PE Alfonso Manrique). Fire is a THIRD, separately-organized city department (not delegated to Willdan) that independently performs fire prevention/plan review/permits per its own 'Inspections and Code Enforcement' page. NOTE beyond the brief: the City's own Building Inspector job postings (2023 and again Sep 2025) recruit an in-house Building Inspector even though the Division's own webpage names Willdan as the contracted provider — a genuine unresolved tension between the current job posting and the stated contract arrangement, reported rather than resolved.

department page + job postings checked 2026-08-31 https://www.cityofavenal.gov/459/Building-Division

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherThe City's own 'Solar Panel Permits with SolarAPP+' page describes SolarAPP+ automated permitting as the standard path for residential solar in Avenal, and Municipal Code Title 9 Chapter 9.66 ('Small Residential Rooftop Solar Energy Systems') governs the permitting of all such systems in the city.

department page + zoning ordinance checked 2026-08-31 https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherFor a qualifying small residential rooftop solar system, SolarAPP+ produces a single Approval Document that is attached to one City permit application in OpenGov Citizen Services ('Search for and select the Building Permit Inspectional Services link... Complete and submit your permit application') -- one permit, not a separate building and electrical permit. The general (non-solar) Building Fees schedule does list an 'Electrical Permit' fee line separately from the 'Building Permit' line, which is how non-solar electrical work is normally permitted, so this is recorded as a moderate-confidence inference for solar specifically rather than an explicit local statement.

SolarApp+ instructions + fee schedule checked 2026-08-31 https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe City's own Homeowner's Guide states plainly: 'The permit may ONLY be issued to a California licensed contractor or a homeowner,' i.e., either a licensed electrician/contractor or the homeowner (owner-builder) may pull the permit. This is a general Building Division statement, not solar-specific, but nothing in Chapter 9.66 or the SolarApp+ page narrows it for solar.

department handout (general, not solar-specific) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Yes

Why the confidence is not higherNo document states 'business-license required before permit issuance' outright, but the City's own Business License Fees page lists a specific 'Non-Fixed Place of Business' fee category -- 'General Contractor, Annual, $80.00' -- meaning an out-of-town contractor performing work inside city limits (the normal case for a solar installer) is required to hold an Avenal business license. Inferred from the fee schedule's own category, not an explicit permit-application rule.

fee schedule (inference) checked 2026-08-31 https://www.cityofavenal.gov/316/Business-License-Fees

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherThe City's own Homeowner's Guide is written specifically for owner-builders ('A Homeowner's Guide to Submitting Building Plans... and Building Inspections') and states the permit 'may ONLY be issued to a California licensed contractor OR a homeowner,' confirming self-install/self-permit is allowed. General document, not solar-specific, and Chapter 9.66 does not restrict this for solar.

department handout (general, not solar-specific) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q8 What documents make up a complete submittal? Core Submittal package

For the standard SolarAPP+ path: (1) an automated SolarAPP+ design submittal, resulting in a downloadable 'SolarAPP+ Approval Document'; (2) a City permit application completed through OpenGov Citizen Services ('Building Permit Inspectional Services') with the SolarAPP+ Approval Document attached. For a general (non-SolarAPP+-eligible) building permit, the City's Homeowner's Guide separately calls for at least two complete sets of plans including a site/plot plan.

Why the confidence is not higherCity's own 'Solar Panel Permits with SolarAPP+' page (step-by-step process) and Homeowner's Guide (general plan-submittal requirements); no Avenal-specific PV submittal checklist bulletin (of the kind other Kings-County-area cities publish) was found on the city's site despite AMC §9.66.050(A) requiring the building inspector to 'prepare and adopt a checklist' -- a real gap, reported rather than invented.

department page + department handout checked 2026-08-31 https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP

Q9 How many copies, and in what format? Submittal package

General (non-solar) policy: at least two (2) complete sets of plans submitted for plan check; one set is returned to the applicant at permit issuance. The SolarAPP+ path is submitted electronically/online rather than as physical plan sets.

Why the confidence is not higherHomeowner's Guide, 'Submittal for Plan Review': 'At least two (2) complete sets of plans must be submitted for plan check.' This is a general Building Division policy, not stated as solar-specific, and the SolarAPP+/OpenGov route described on the solar page is entirely electronic, so the two figures may not both apply to the same solar job.

department handout (general, not solar-specific) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes -- a site/plot plan showing all property lines, all structures on the property, the street, the driveway, and the location of the proposed work (a sample site plan is provided by the Building Division).

Why the confidence is not higherHomeowner's Guide, 'Plan Preparation' section. General Building Division requirement, not stated specifically for solar; no PV-specific site-plan content list (e.g., array layout, setbacks) was found on the SolarApp+ page or in Chapter 9.66.

department handout (general, not solar-specific) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Likely yes, via the SolarAPP+ platform's own standard design-submittal requirements (one-line diagrams are part of SolarAPP+'s national design-entry process), but Avenal has published no separate local document stating this requirement for its own permit process.

Why the confidence is not higherInferred from the City's adoption of SolarAPP+ as its residential solar review platform (SolarAPP+ page); no Avenal-specific submittal checklist was found that states a one-line-diagram requirement in the City's own words.

inference from platform adoption checked 2026-08-31 https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP

Q12 Are string and conductor calculations required? Drawings & calculations

Nothing published by this authority.

Where we lookedSearched the SolarApp+ Landing Page, Homeowner's Guide, and Municipal Code Ch. 9.66 for a local string/conductor calculation requirement; none of Avenal's own documents states this explicitly (would rely on the SolarAPP+ platform's own national design inputs, not a stated Avenal rule).

https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Nothing published by this authority.

Where we lookedSearched Homeowner's Guide ('additional plans prepared by a...civil/structural engineer may be required' -- no numeric threshold given), Chapter 9.66, and the Building Fees schedule; no stated structural PE-stamp kW/valuation threshold was found for solar specifically.

https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedSame documents as Q13; no electrical PE-stamp threshold stated anywhere in Avenal's own materials.

https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q15 What does a residential solar permit cost? Core Fees

No solar-specific flat fee line exists. General Building Fees (FY2021-2022): Building Permit 'Per CBC Valuation'; Electrical Permit 'Per CEC, CBC Valuation + Issuance Fee' (issuance fee $41.25); Building Plan Check 65% of Building Permit Fee. Separately, the SolarAPP+ platform itself charges a $35 administrative fee per project (paid directly to SolarAPP+, not the City).

Why the confidence is not higherCity of Avenal Building fees FY2021-2022 schedule has no PV/solar-specific line item (control-checked: schedule enumerates only generic Building/Electrical/Mechanical/Plumbing/Demolition/Relocation categories); solar therefore falls under the generic valuation-based Building + Electrical permit fees. The $35 SolarAPP+ fee is stated on the City's own SolarAPP+ page. Fee schedule is dated 'effective July 2021' per the Community Development page and no newer master fee schedule was found despite searching.

fee schedule + department page checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3063/Building-fees-2021-2022

Q16 How is the fee calculated? Core Fees

Valuation

Why the confidence is not higherBuilding Fees schedule: 'Building Permit -- Per CBC Valuation' and 'Electrical Permit -- Per CEC, CBC Valuation + Issuance Fee.' No flat, per-kW, or per-panel solar-specific fee line exists (control-checked).

fee schedule checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3063/Building-fees-2021-2022

Q17 Is there a separate plan-check fee? Fees

Yes

Why the confidence is not higherBuilding Fees schedule: 'Building Plan Check -- 65% of Building Permit Fee' and 'Electrical / Plumbing / Mechanical Plan Check -- 25% of Permit fee,' both distinct line items from the permit fee itself. The City's own Homeowner's Guide independently confirms: 'When plans are required...a plan check fee will be charged and paid prior to issuance of the Building permit.'

fee schedule + department handout checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3063/Building-fees-2021-2022

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Nothing published by this authority.

Where we lookedChecked the Building Division page, SolarAPP+ page, and Homeowner's Guide; none states a specific number of business days for plan review turnaround (SolarAPP+'s own automated review is near-instant upon a compliant submittal, but the City-side OpenGov permit-issuance step has no stated turnaround).

https://www.cityofavenal.gov/459/Building-Division

Q19 How long is an issued permit valid before it expires? Timeline & validity

180 days -- an issued permit expires if work is not commenced within 180 days of issuance, or if no inspection is obtained within 180 days; one 180-day extension may be granted on written request prior to expiration.

Why the confidence is not higherHomeowner's Guide, 'Avoiding Permit Expiration': 'Every permit issued by the building official under the provisions of the California Building Code, shall expire...if the building or work authorized by such permit is not commenced within 180 days...Your permit expires in 180 days if no inspections are made within 180 days...Prior to expiration and upon written request, only one 180-day extension may be granted.' General Building Division rule (this is the standard CBC administrative provision), not solar-specific, but nothing in Chapter 9.66 states a different figure for solar permits.

department handout (general, not solar-specific) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q20 Which permit portal does this authority use? Core Portal & process

SolarAPP+ (automated design review/approval) feeding into OpenGov Citizen Services / ViewPointCloud (avenalca.viewpointcloud.com) for the City permit application itself; the City's public notice states ALL building, land-use/zoning and land-division permits must now be submitted online through this portal.

Why the confidence is not higherCity's own 'Solar Panel Permits with SolarAPP+' page and the Community Development page's banner notice ('THE CITY OF AVENAL HAS TRANSITIONED TO AN ONLINE PERMITING SYSTEM...MUST BE SUBMITTED ONLINE THROUGH OUR ONLINE PORTAL').

department page checked 2026-08-31 https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherThe SolarAPP+ page describes a fully online sequence: automated review and $35 fee payment through SolarAPP+, then permit-application submission (with the SolarAPP+ Approval Document attached) through OpenGov Citizen Services, described as completing 'the online permitting process up to Step 7.' A separate City page links a 'Pay For A Building Permit, Classes and Other Fees' online payment portal (secure.cpteller.com), so City permit fees can also be paid online. No explicit statement of an in-person-only step (unlike some neighboring cities) was found.

department page checked 2026-08-31 https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas & Electric) -- no municipal electric utility; no CCA found

Why the confidence is not higherThe City's own 'Energy Efficiency Resources' page states: 'In collaboration with Pacific Gas and Electric Company (PG&E), Southern California Gas Company (SCG), and the VIEW Partnership...the City is making meaningful, cost-effective and lasting changes to the way the City uses energy.' Corroborated by an absence-based tell: the City's own Utility Billing page describes only water/sewer as City-billed services, with PG&E handled separately (the City also hosts a 'PG&E Community Wildfire Safety Program' fact sheet and a 'PG&E Streetlamp Outage Report' form, and PG&E notification/pothole requirements appear in the City's own public-works bid documents). No Community Choice Aggregation (CCA) program was found referenced anywhere on the city's site (Kings County has no known CCA); searched but this is a fuzzy-match search engine, so recorded at moderate rather than high confidence for the CCA negative specifically.

department page (city-side confirmation) checked 2026-08-31 https://www.cityofavenal.gov/427/Energy-Efficiency-Resources-

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit

Why the confidence is not higherPG&E's own current Electric Rule 21 tariff (effective 29 Aug 2025, downloaded and verified this run) states that Distribution Provider approval for Interconnection (Permission to Operate) for NEM/NBT facilities up to 1 MW requires, among other things, 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction over the Generating Facility' -- i.e., PTO is gated on the AHJ's (Avenal's) final building/electrical inspection having already been completed. This is a statewide PG&E tariff provision, not an Avenal-specific document, but it directly governs the utility/AHJ sequence for any Avenal address on PG&E's grid.

utility tariff (Electric Rule 21) checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No (HOA/architectural approval cannot be required as a precondition)

Why the confidence is not higherAMC §9.66.040/9.66.050(D) requires the Director to process a solar application 'in the same manner as an application for approval of an architectural modification to the property,' expressly citing Civil Code §714(e)(1) (the Solar Rights Act) and Gov. Code §65850.5(b), and specifies review 'shall be administrative, nondiscretionary and similar to approval of building permits.' No separate city-required HOA sign-off step exists in the ordinance; the Solar Rights Act independently bars an HOA from unreasonably restricting solar installations.

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q25 Is there a historic-district review? Overlays & special cases

No

Why the confidence is not higherThe current (2024) Zoning Ordinance (Exhibit A, 334 pages, full text extracted and searched) contains no Historic District or historic-preservation overlay zone -- only a 'Historic signs' provision in the sign code (§9.56.220) and a historic-structure definition inside the Flood Damage Prevention chapter (unrelated to solar). Positive control ('electrical'/'setback', 292 combined hits) and fabricated control ('zzqqx', 0 hits) both behaved as expected in the same extracted text, so the absence is not a search failure.

zoning ordinance (control-checked absence) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherSearched the codified Title 8 Building Regulations (text-extracted, 94 pages), the OCR'd 2012/2015 Building Regulations compilation, and the 2024 Zoning Ordinance (control-checked) for a wind/windstorm-certification clause; the only 'wind' hits are a generic 'necessary allowances for wind and vibration' clause in the base state-model building-code adoption chapter (not solar-specific) and unrelated sign/antenna provisions. No solar-specific wind-certification requirement was found.

codified ordinance (control-checked absence) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/754/Title-8-Building-Regulations

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Only if the Building Official makes an affirmative finding, based on substantial evidence, that the proposed system would have a 'specific, adverse impact' on public health or safety -- otherwise no Conditional Use Permit or City Council approval is required; review is administrative/ministerial.

Why the confidence is not higherAMC §9.66.060(A): 'a conditional use permit shall be required if the City's building official makes a finding, based upon substantial evidence, that the proposed solar energy system could have a specific, adverse impact upon the public health and safety.' Denials are appealable to the Planning Commission per §9.66.080, with a discretionary further appeal to City Council.

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No numeric kW/thermal cap is stated in Avenal's own code. Chapter 9.66 defines its scope entirely by cross-reference to the state statutory definition -- 'small residential rooftop solar energy system' has 'the same meaning set forth in Government Code section 65850.5(j)(3)' -- rather than restating a local kW figure. Systems outside that state definition are not barred, they simply fall outside this expedited chapter and would be permitted through the standard (non-expedited) building-permit process.

Why the confidence is not higherAMC §9.66.020(B), citing Gov. Code §65850.5(j)(3) by reference rather than stating a number. No separate zoning-code kW ceiling (of the kind some neighboring cities carry in a use table) was found elsewhere in the 334-page Zoning Ordinance (searched).

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? Other -- codified text still names the 2010 California Electrical Code 50% · codified ordinance (stale -- flagged)
    • Which building code edition is in force? Codified text names the 2010 California Building Code 50% · codified ordinance (stale -- flagged)
    • Which fire code edition is in force? Codified text names the 2013 California Fire Code (added by Ord. 2013-02, adopted 1/9/14), superseding the original 2010-cycle Fire Code adoption in the same chapter. 55% · ordinance list (city's own comprehensive index)
    • Are there local amendments to any of the above? Yes 70% · codified ordinance
    • What is the installation judged against? The installation must satisfy 'all applicable health and safety standards and requirements enacted by the State and the City' -- i.e., the codified (if stale) California Building/Electrical/Fire Codes plus Chapter 9.66's own procedural requirements; final inspection confirms code compliance and that installed equipment/wiring matches the approved plans. 75% · zoning ordinance, Ch. 9.66
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    Nothing recorded for City of Avenal on this step yet — 1 question checked and found unpublished. The guidance above is general.

  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Rapid shutdown is required as a matter of the currently-effective NEC/CEC (in force nationally since the 2014 NEC cycle and continuously since), but no Avenal document found this run cites '690.12' or 'rapid shutdown' by name, and Avenal's own codified electrical chapter still names the 2010 CEC -- an edition that PREDATES NEC/CEC 690.12 rapid-shutdown requirements entirely. 55% · codified ordinance (silent on 690.12; control-checked)
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Does the UTILITY specify placards beyond the AHJ's? Yes -- PG&E requires a visible, manually-operated interconnection disconnect near the Point of Interconnection that must 'include markings or signage that clearly indicates open and closed positions' and be capable of being locked in the open position. 75% · utility tariff (Electric Rule 21)
    • Where must the labels be placed? Near the Point of Interconnection, for the PG&E-required visible disconnect (per Rule 21); no Avenal-specific label-placement requirement was found for any other placard. 55% · utility tariff (Electric Rule 21)
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Is there a separate ESS permit or inspection? No 60% · fee schedule (control-checked absence)
    • Is a ground mount treated as a structure? Not addressed for solar specifically -- Chapter 9.66 is titled and scoped to 'Small Residential ROOFTOP Solar Energy Systems' only, with no ground-mount solar provision anywhere in the 334-page Zoning Ordinance (control-checked). By inference, a ground-mounted array would default to each zone's general 'Accessory structures' provisions (e.g., permitted within a required rear/side setback subject to a minimum 10-foot separation from other structures), the same treatment any other accessory structure receives, though this is not a stated PV-specific rule. 50% · zoning ordinance (inference from general accessory-structure rules)

20 questions answered against City of Avenal’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

Other -- codified text still names the 2010 California Electrical Code

Why the confidence is not higherCodified Title 8 Building Regulations, Ch. 1, adopts by reference 'California Electrical Code, 2010 edition, found in Part 3 of Title 24...' This is the same text found in the OCR'd 2012/2015 compilation of the same chapter. The City's own comprehensive 'Ordinance List and Disposition Table' (covering Ord. 79-01 through 2022-06) shows no subsequent Building/Electrical/Fire code-adoption ordinance after the 2011 (2010 codes) and 2013-14 (2013 CFC) entries, and repeated site searches for a 2016/2019/2022/2025-cycle adoption ordinance returned nothing. This is a genuine, dated internal code-cycle lag (the City's Zoning Ordinance was separately and thoroughly modernized in Dec. 2024, but Title 8 was not touched in the same reform), flagged rather than resolved; day-to-day practice on SolarAPP+ presumably tracks the state's actually-current Title 24 cycle regardless of what remains codified.

codified ordinance (stale -- flagged) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/754/Title-8-Building-Regulations

Q30 Which building code edition is in force? Core Code editions in force

Codified text names the 2010 California Building Code

Why the confidence is not higherSame Title 8, Ch.1 adoption-by-reference list: 'California Building Code, including the Appendix Chapters thereto, 2010 edition...' Same staleness caveat as Q29 -- confirmed via the City's own Ordinance List (through 2022-06) and repeated searches finding no later code-adoption ordinance.

codified ordinance (stale -- flagged) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/754/Title-8-Building-Regulations

Q31 Which fire code edition is in force? Code editions in force

Codified text names the 2013 California Fire Code (added by Ord. 2013-02, adopted 1/9/14), superseding the original 2010-cycle Fire Code adoption in the same chapter.

Why the confidence is not higherCity of Avenal Ordinance List: 'ORD. 2013-02 12/12/13 ENACTING SECTION 8-1.04(i) THAT ADOPTS THE 2013 CA FIRE CODE & ITS APPENDICES & SECTIONS OF THE INTERNATIONAL FIRE CODE' / '2013-02 1/9/14 ADOPTION OF 2013 CA FIRE CODE.' No later Fire Code adoption ordinance was found. IMPORTANT CONTEXT: this codified edition predates Avenal's own new municipal Fire Department (stood up 2025-2026) -- Ordinance 2025-03 (introduced Sept. 2025) establishes the Department and gives its Fire Chief authority to enforce 'the Fire Code' and issue citations for violations, but the underlying Fire Code edition being enforced still appears to be this stale 2013 CFC absent a further amendment not found this run.

ordinance list (city's own comprehensive index) checked 2026-08-31 https://www.cityofavenal.gov/documentcenter/view/3605

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherTitle 8 contains several local chapters/amendments layered on the adopted state model codes: Chapter 2 (Radio and Television Antennas), Chapter 3 (Unsafe Buildings), Chapter 4 (Sign Code, adopting the 1991 Uniform Sign Code by reference), and Chapter 5 (Flood Damage Prevention, a detailed locally-adopted floodplain ordinance). None of these amendments addresses solar/PV specifically.

codified ordinance checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/754/Title-8-Building-Regulations

Q33 What is the installation judged against? Core Electrical

The installation must satisfy 'all applicable health and safety standards and requirements enacted by the State and the City' -- i.e., the codified (if stale) California Building/Electrical/Fire Codes plus Chapter 9.66's own procedural requirements; final inspection confirms code compliance and that installed equipment/wiring matches the approved plans.

Why the confidence is not higherAMC §9.66.040 ('Compliance with state and local requirements'). No separate solar-specific technical standard (e.g., a named CEC article) is stated by Avenal beyond this general compliance clause.

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Nothing published by this authority.

Where we lookedSearched Title 8's local amendment chapters and the SolarAPP+ page for a busbar-sizing or service-upgrade rule; none of Avenal's own documents states one (SolarAPP+'s own national eligibility gate around 200-225A busbars would apply as the platform's rule, not a stated Avenal ordinance).

https://www.cityofavenal.gov/DocumentCenter/View/754/Title-8-Building-Regulations

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Nothing published by this authority.

Where we lookedSearched Chapter 9.66, the Homeowner's Guide, and Title 8; no mounting-system, attachment-spacing, or standoff-height standard specific to solar racking was found anywhere in Avenal's own documents.

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Nothing published by this authority.

Where we lookedSearched Chapter 9.66, Title 8 (incl. the 2013 CFC adoption clause), the Fire Department's 'Inspections and Code Enforcement' page, and the SolarAPP+ page for a ridge-setback/pathway figure; none was found. The Fire Department is newly stood up (2025-2026) and has not yet published PV-specific fire-code guidance.

https://www.cityofavenal.gov/519/Inspections-and-Code-Enforcement

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Rapid shutdown is required as a matter of the currently-effective NEC/CEC (in force nationally since the 2014 NEC cycle and continuously since), but no Avenal document found this run cites '690.12' or 'rapid shutdown' by name, and Avenal's own codified electrical chapter still names the 2010 CEC -- an edition that PREDATES NEC/CEC 690.12 rapid-shutdown requirements entirely.

Why the confidence is not higherGrepped the extracted text of Title 8 (both the searchable and the OCR'd version), the 2024 Zoning Ordinance, the SolarAPP+ page, and the Building Division page for 'rapid shutdown', '690.12', '705.10' and '705.12' -- zero hits across every document. The real-world outcome is not in doubt (SolarAPP+ enforces current NEC rapid-shutdown rules nationally regardless of what a given city has codified), but the absence of any local citation, layered on a codified 2010 CEC, is itself recorded per this survey's methodology.

codified ordinance (silent on 690.12; control-checked) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/754/Title-8-Building-Regulations

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSearched Chapter 9.66, Title 8, the SolarAPP+ page, and the Building Division page for a placard/signage specification at the service equipment; unlike some neighboring Kings-County-area cities (which publish a dedicated PV submittal/inspection-checklist bulletin), Avenal has published no such document, so no Avenal-specific placard list was found.

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame search as Q38; no placard-wording specification found.

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame search as Q38; no letter-height/colour/material specification found.

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame search as Q38; no site-plan/facility-map placard requirement (beyond the general CEC §705.10 state baseline) was found in any Avenal document.

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes -- PG&E requires a visible, manually-operated interconnection disconnect near the Point of Interconnection that must 'include markings or signage that clearly indicates open and closed positions' and be capable of being locked in the open position.

Why the confidence is not higherPG&E's current Electric Rule 21 tariff (effective 29 Aug 2025), Section H.1.d 'Visible Disconnect Required' -- downloaded and read directly this run. This is a utility-level (statewide PG&E), not an Avenal-specific, requirement, and it applies in addition to whatever the AHJ requires (which, per Q38-41, is not separately documented by Avenal itself).

utility tariff (Electric Rule 21) checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

Near the Point of Interconnection, for the PG&E-required visible disconnect (per Rule 21); no Avenal-specific label-placement requirement was found for any other placard.

Why the confidence is not higherPG&E Electric Rule 21, Section H.1.d: the isolating switch must be installed 'near the Point of Interconnection.' No corresponding Avenal document was found addressing placard placement at all.

utility tariff (Electric Rule 21) checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Q44 Must equipment be on a specific approved list? Equipment listing

Nothing published by this authority.

Where we lookedSearched Chapter 9.66, Title 8, and the SolarAPP+/Homeowner's Guide pages; no Avenal-specific 'approved equipment list' requirement was found (equipment listing would default to the standard state/NEC UL-listing requirement, not a stated local list).

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Nothing published by this authority.

Where we lookedSearched Chapter 9.66 (scoped only to 'solar energy system' per Civil Code §801.5, with no battery/ESS text), the codified Fire Code adoption clause (2013 CFC, which predates modern residential ESS fire-code chapters), the Building Fees schedule (no battery/ESS line, control-checked), and the new Fire Department's pages; no Avenal-specific battery/ESS permitting condition was found.

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No

Why the confidence is not higherThe Building Fees schedule has no battery/ESS/energy-storage fee line at all (control-checked: schedule enumerates only Building/Electrical/Mechanical/Plumbing/Demolition/Relocation/Compliance-Inspection categories, with no ESS-specific entry), and no ESS-specific permit process is described anywhere in Chapter 9.66 or on the Building Division/SolarAPP+ pages.

fee schedule (control-checked absence) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3063/Building-fees-2021-2022

Q47 Is a ground mount treated as a structure? Core Ground mount

Not addressed for solar specifically -- Chapter 9.66 is titled and scoped to 'Small Residential ROOFTOP Solar Energy Systems' only, with no ground-mount solar provision anywhere in the 334-page Zoning Ordinance (control-checked). By inference, a ground-mounted array would default to each zone's general 'Accessory structures' provisions (e.g., permitted within a required rear/side setback subject to a minimum 10-foot separation from other structures), the same treatment any other accessory structure receives, though this is not a stated PV-specific rule.

Why the confidence is not higherFull-text search of the Zoning Ordinance for 'ground-mounted'/'ground mount' returned zero results specific to solar; the 'Accessory structures' sections appearing in each residential zone chapter (e.g., §9.14.110, §9.16.110, §9.18.120, §9.20.110) are the only structural-setback mechanism that would apply by default.

zoning ordinance (inference from general accessory-structure rules) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedSearched Avenal's own documents and PG&E's Electric Rule 21 (Section H.1.d) for an exact AC-disconnect-to-meter distance; Rule 21 only requires the disconnect be 'near the Point of Interconnection' without a stated distance, and the more specific meter-proximity spec is understood to sit in PG&E's gated 'Greenbook' DG documents (e.g., TD-2306M), which are not publicly accessible ('See your PG&E Job Owner for access').

https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Written request, by phone ((559) 386-5766), in person at the Building counter, or online via the City's Inspection Request Page / OpenGov Citizen Services portal. 75% · department handout (general) + zoning ordinance
    • How much notice is required? For a qualifying small residential rooftop solar system: the inspection will be scheduled within five (5) business days after the City receives a written request, absent extraordinary circumstances. 88% · zoning ordinance, Ch. 9.66
    • Are same-day or AM/PM windows offered? No same-day guarantee; the City instead guarantees a three-hour inspection window once scheduled. 85% · zoning ordinance, Ch. 9.66
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 60% · zoning ordinance, Ch. 9.66 (ambiguous post-transition)
    • If delegated, to whom? Building inspection: performed by the City's Building Division (day-to-day staffing/inspection currently contracted to Willdan Engineering per the Building Division page). Fire-safety inspection (if triggered): performed by the City's own, newly-established Avenal Fire Department / Fire Prevention Bureau -- NOT Kings County Fire Department, which is no longer the city's fire-service provider as of the 2025-2026 transition. 70% · department pages
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? For a qualifying expedited residential rooftop solar system: a single consolidated inspection performed by the Building Official (with a separate fire-safety inspection layered in only if no fire-authority consolidation arrangement exists), scheduled within 5 business days of a written request, in a 3-hour window; the Building Official must issue or deny the permit within 2 business days of completing the (later of the building or fire) inspection. 85% · zoning ordinance, Ch. 9.66
    • Is a rough-in or mid-roof inspection required? No 75% · zoning ordinance, Ch. 9.66
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

14 questions answered against City of Avenal’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Written request, by phone ((559) 386-5766), in person at the Building counter, or online via the City's Inspection Request Page / OpenGov Citizen Services portal.

Why the confidence is not higherHomeowner's Guide, 'Requesting Inspections': 'Inspections may be scheduled in person at the Building counter, by phone at (559) 386-5766. Alternatively, submit a request online for inspection by visiting the Inspection Request Page.' General Building Division policy, not solar-specific, but AMC §9.66.070(B) separately confirms solar inspections are booked via 'a written request... received by the City.'

department handout (general) + zoning ordinance checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q50 How much notice is required? Core Booking & scheduling

For a qualifying small residential rooftop solar system: the inspection will be scheduled within five (5) business days after the City receives a written request, absent extraordinary circumstances.

Why the confidence is not higherAMC §9.66.070(B): 'Unless extraordinary circumstances exist, an inspection will be scheduled within five business days after a written request is received by the City and the applicant must be provided with a three-hour inspection window.'

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

No same-day guarantee; the City instead guarantees a three-hour inspection window once scheduled.

Why the confidence is not higherAMC §9.66.070(B), same clause as Q50: '...the applicant must be provided with a three-hour inspection window.'

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherAMC §9.66.070(A): 'only one inspection shall be required and performed by the building official, except that a separate fire safety inspection may be performed whenever the City does not have an agreement with a local fire authority to conduct a fire safety inspection on behalf of the fire authority.' This clause was drafted (2024) when the City still had a Kings County Fire Department service agreement. IMPORTANT FINDING: as of 2025-2026 the City has stood up its OWN municipal Fire Department (see jurisdiction note) rather than continuing that county agreement -- it is genuinely unclear from the ordinance text alone whether the now in-house Fire Prevention Bureau's involvement counts as 'the City' performing the single required inspection, or whether it now triggers the separate-fire-inspection clause because there is no longer 'an agreement with a local fire authority.' Reported as an open ambiguity rather than resolved.

zoning ordinance, Ch. 9.66 (ambiguous post-transition) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q53 If delegated, to whom? Core Who inspects

Building inspection: performed by the City's Building Division (day-to-day staffing/inspection currently contracted to Willdan Engineering per the Building Division page). Fire-safety inspection (if triggered): performed by the City's own, newly-established Avenal Fire Department / Fire Prevention Bureau -- NOT Kings County Fire Department, which is no longer the city's fire-service provider as of the 2025-2026 transition.

Why the confidence is not higherBuilding Division page (Willdan contract) + Fire Department page ('The Avenal Fire Department is organized into...Fire Prevention -- Fire inspections, code enforcement, plan review, permits...').

department pages checked 2026-08-31 https://www.cityofavenal.gov/182/Fire

Q54 Which inspections are required, and in what order? Core Stages & sequence

For a qualifying expedited residential rooftop solar system: a single consolidated inspection performed by the Building Official (with a separate fire-safety inspection layered in only if no fire-authority consolidation arrangement exists), scheduled within 5 business days of a written request, in a 3-hour window; the Building Official must issue or deny the permit within 2 business days of completing the (later of the building or fire) inspection.

Why the confidence is not higherAMC §9.66.070(A)-(C) in full.

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No

Why the confidence is not higherAMC §9.66.070(A) limits a qualifying expedited residential rooftop solar system to a single inspection performed by the building official (plus a possible separate fire-safety inspection); no rough-in or mid-roof stage is described for solar. (The City's general, non-solar Homeowner's Guide does describe a full multi-stage sequence -- foundation, slab, roof sheathing, framing, insulation, lath, final -- for ordinary construction, but Chapter 9.66 expressly limits solar to one inspection.)

zoning ordinance, Ch. 9.66 checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q56 Does the inspector verify labels and listings? Core What is checked

Nothing published by this authority.

Where we lookedSearched Chapter 9.66, the Building Division page, and the SolarAPP+ page for a stated inspection-checklist item confirming label/listing verification; none of Avenal's own documents describes what the single solar inspection actually checks.

https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q57 Is there a published inspection checklist? Core What is checked

No

Why the confidence is not higherAMC §9.66.050(A) requires the building inspector to 'prepare and adopt a checklist of all requirements with which small residential rooftop solar energy systems must comply,' consistent with Gov. Code §65850.5(g)(1) -- but no such published checklist document was found on the Building Division page, the SolarAPP+ page, or via site search, despite that statutory duty existing since the chapter's 2024 enactment. Recorded as a real, dated gap (the duty exists in the City's own code; the document implementing it does not appear to be published) rather than a search failure.

zoning ordinance duty vs. absent implementing document checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q58 What must be on site at inspection? Core Documents on site

The approved plans and the inspection 'Job card' must be kept at the job site and available for the inspector at every inspection.

Why the confidence is not higherHomeowner's Guide: 'When your building permit is issued, a copy of the approved plans will be returned to you and an inspection Job card. The plans and card are to be kept at the job location and must be available for the inspector's use whenever they visit your property for inspections.' General Building Division policy, not solar-specific.

department handout (general, not solar-specific) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q59 Is there a re-inspection fee? Corrections & re-inspection

$90.00 per hour of inspection

Why the confidence is not higherBuilding Fees schedule (FY2021-2022): 'Re-Inspection (2nd Inspection) -- $90 per hour of inspection.' No solar-specific re-inspection line exists (control-checked), so this general rate is the applicable figure.

fee schedule checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3063/Building-fees-2021-2022

Q60 How are corrections issued and cleared? Corrections & re-inspection

The inspector leaves a written 'correction notice' briefly outlining what must be completed before that portion of the project is approved; the applicant corrects the work and requests a re-inspection.

Why the confidence is not higherHomeowner's Guide, 'The Inspection Process': 'If there are corrections to be made before approval, the inspector will leave a 'correction notice' briefly outlining the things required to be completed prior to approval of that portion of the project.' General Building Division policy, not solar-specific.

department handout (general, not solar-specific) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Q61 What is issued on pass? Core Final sign-off & PTO

Final (inferred label) -- the ordinance and handout both describe 'final approval'/permit issuance/denial after the passing inspection, but no Avenal document names the specific document type (CO / Final / Green Tag / Letter) issued.

Why the confidence is not higherAMC §9.66.070(C): 'The building official shall issue or deny a building permit within two business days after completing the inspection...' and Homeowner's Guide: 'After the building inspector makes his inspection, and all requirements have been satisfied, your project will be approved.' 'Final' recorded as the closest match to this language, not a term Avenal itself uses as a formal label.

zoning ordinance + department handout (inferred label) checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3940/PDF-Exhibit-A---Zoning-Ordinance

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

AHJ (with a follow-up step for the applicant/utility)

Why the confidence is not higherHomeowner's Guide, 'Final Approval': 'If a new electric or gas service has been installed as a part of your project and approved by the inspector, they will see that the utility company is notified. Note: you must also call and arrange for installation of the electrical meters from the utility company.' So the City's inspector notifies the utility of inspection completion, but the applicant must separately contact PG&E to arrange meter work/PTO. General Building Division policy, not solar-specific, but directly on point for the AHJ-to-utility handoff. PG&E's own Rule 21 (Q23) confirms PTO itself is contingent on the AHJ's final-inspection clearance being evidenced to PG&E.

department handout (general, not solar-specific) + utility tariff checked 2026-08-31 https://www.cityofavenal.gov/DocumentCenter/View/3164/Homeowners-Guide---Do-you-Need-a-Building-Permit-English

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Avenal against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Avenal is the authority having jurisdiction 88% confidence
Holds
building and electrical (Community Development Building Division, operationally contracted to Willdan Engineering); fire (a newly-established, self-performed City of Avenal Fire Department, NOT delegated to Kings County Fire Department as of the 2025-2026 transition)
Delegated to
Willdan Engineering (building & inspection services / building code enforcement, per the City's own Building Division page); A&M Engineering (separately, for City/civil engineering services)
Overridden by
California Gov. Code §65850.5 (AB 2188 expedited/ministerial residential solar permitting, implemented locally as AMC Ch. 9.66); Civil Code §714 (Solar Rights Act) preempts HOA/CC&R disapproval; PG&E's own Electric Rule 21 tariff controls the utility-side interconnection/PTO sequence and gates PTO on the AHJ's final inspection.
Why not higher
The City of Avenal is an incorporated city and is the AHJ for building and electrical permitting within its city limits: its Community Development Building Division issues and processes residential PV permits (SolarAPP+ / OpenGov Citizen Services), with day-to-day building/inspection services and code enforcement contracted to Willdan Engineering per the Building Division's own page. MAJOR FINDING/CORRECTION TO THE BRIEF: the brief's lead, carried over from the City of Corcoran's run, states that Kings County Fire Department 'provides contractual services to the Cities of Avenal and Corcoran' -- and this WAS true historically (Avenal's own 'Ordinance 25-03' public notice states outright: 'For many years, Avenal has relied on Kings County for fire protection services'). But that arrangement has since changed: on 4 Aug 2025 the City Council approved a new (steeply higher, $1,096,310/yr) Kings County fire-services agreement, which prompted the Council to instead introduce Ordinance 2025-03 on 11 Sept 2025 'Establishing a Municipal Fire Department' and to build the department out. As of this run (checked 31 Aug 2026), the City's own website shows a fully operational, self-performed 'City of Avenal Fire Department' -- an active Fire Chief (McAfee, employment agreement on file), an Assistant Fire Chief, Fire Captains, an Operations/Training/Fire-Prevention divisional structure, and its own 'Inspections and Code Enforcement' page describing the department's own Fire Prevention Bureau conducting plan review, permits and inspections under the California Fire Code. Kings County Fire Department is therefore NO LONGER the fire AHJ for Avenal -- do not carry Corcoran's finding forward for this city. A residual textual wrinkle: Municipal Code §9.66.070(A) (enacted Dec. 2024, before the Fire Department stand-up) still frames the solar-inspection rule around whether the City 'has an agreement with a local fire authority to conduct a fire safety inspection on behalf of the fire authority' -- language written for the old county-contract arrangement, now potentially stale or ambiguous now that Fire is in-house (see Q52). Utility interconnection sits with PG&E (confirmed from the City's own 'Energy Efficiency Resources' page and the Utility Billing page's water/sewer-only scope), whose own Rule 21 tariff gates Permission-to-Operate on the AHJ's completed final inspection.

https://www.cityofavenal.gov/515/Ordinance-25-03

Check the code edition before you build

This authority's published code edition does not match what the state has adopted. That usually means the authority's ordinance has not been updated for the current cycle — but a local amendment can also be lawful. Confirm with the building department before you submit.

Building code
This authority publishes 2010 Codified text names the 2010 California Building Code 50% · source
The state has adopted 2024/2025 2025 California Building Code (Title 24, Part 2, Volumes 1 & 2), based on the 2024 International Building Code, and 2025 California Residential Code (Title 24, Part 2.5), 92% · source
Fire code
This authority publishes 2013 Codified text names the 2013 California Fire Code (added by Ord. 2013-02, adopted 1/9/14), superseding the original 2010-cycle Fire Code adoption in the same chapter. 55% · source
The state has adopted 2024/2025 2025 California Fire Code (Title 24, Part 9), based on the 2024 International Fire Code, adopted by the Office of the State Fire Marshal with BSC approval. 90% · source
Permit required
Yes95%
Permit cost
No solar-specific flat fee line exists. General Building Fees (FY2021-2022): Building Permit 'Per CBC Valuation';72%
Portal
SolarAPP+ (automated design review/approval) feeding into OpenGov Citizen Services / ViewPointCloud (avenalca.viewpointcloud.com) for the City permit application itself;90%
Electrical code
Other -- codified text still names the 2010 California Electrical Code50%
Booking an inspection
Written request, by phone ((559) 386-5766), in person at the Building counter, or online via the City's Inspection Request Page / OpenGov Citizen Services portal.75%
Labels & placards for this authority

Wording None%

Size, colour & material None%

Where they go 55%

Near the Point of Interconnection, for the PG&E-required visible disconnect (per Rule 21); no Avenal-specific label-placement requirement was found for any other placard.

What the utility wants on top 75%

Yes -- PG&E requires a visible, manually-operated interconnection disconnect near the Point of Interconnection that must 'include markings or signage that clearly indicates open and closed positions' and be capable of being locked in the open position.

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Kings County
Regions served
1
Regions covered
City of Avenal · city
Solar Requirements
Required placards
Building Division | Avenal, CA - Official Website Skip to Main Content Create a Website Account - Manage notification subscriptions, save form progress and more. Website Sign In Home Your Government Departments Community Development Building Division Building Division PUBLIC NOTICE: THE CITY OF AVENAL HAS TRANSITIONED TO AN ONLINE PERMITING SYSTEM. ALL BUILDING, LAND USE / ZONING AND LAND DIVISION
Authority Contact
Address
919 Skyline Blvd., Avenal, CA 93204
Main Phone
(559) 386-5766
Office Hours
8 a.m. – 4:30 p.m.
Building Department
Department
Building Division
Direct Phone
(559) 401-9854
Dept Hours
8 a.m. – 4:30 p.m.
Portal Software
OpenGov
Booking & Scheduling
Preferred channel
online_portal
Notes
Solar permits use a two-step process: (1) SolarAPP+ at solarapp.nrel.gov for automated plan review — create account, submit design, pay $35 admin fee, download approval document; (2) Submit permit via OpenGov/ViewPoint Cloud portal at avenalca.viewpointcloud.com — select 'Building Permit Inspectional Services', complete form through Step 7, upload SolarAPP+ approval. Inspections scheduled through the same ViewPoint Cloud portal. Building and inspection services contracted to A&M Engineering. Staff: Janett Ceja (Community Development Assistant, building@cityofavenal.gov); Maria 'Angie' Ortiz (City Clerk/Permit Technician, cityclerk@cityofavenal.gov). Office hours Mon-Fri 8:00 AM-4:30 PM. SolarAPP+ info page: https://www.cityofavenal.gov/485/Solar-Panel-Permits-with-SolarAPP
