City of Berkeley

Alameda County

Verified Aug. 4, 2026

City of Berkeley is a city authority in the State of California, serving 124,321 residents. 5,741 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Residential Solar PV is listed among the Permit Service Center's over-the-counter projects with a plan check of about 30 minutes; Q18 Where you file — Permits Online (Berkeley's permit portal) for standard/streamlined applications and record tracking/inspections; Q20

Permit required
Yes95% source
What it costs
SolarAPP+: $100 flat/system. Standard electrical permit — Residential ≤15kW: $200 (includes plan check). Residential >15kW: $250 plus $15/kW above 15kW (includes plan check).95% source
Plan review turnaround
Residential Solar PV is listed among the Permit Service Center's over-the-counter projects with a plan check of about 30 minutes;90% source
Key document
checklist / department bulletin cited by 6 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 95% · authority's own page
    • What does this authority permit itself, and what does it delegate? Both 90% · department page
    • Is a permit required for a residential rooftop PV system? Yes 95% · department bulletin
    • Is there a separate electrical permit, or is it combined? Combined 75% · checklist / fee schedule
    • Is a HOA or architectural approval required first? No 80% · department bulletin
    • Is there a historic-district review? No for a typical residential rooftop system (Gov. Code §65850.5 preempts local design review); however, exterior alterations to a designated City Landmark, Structure of Merit, or property within a Historic District can trigger a Landmarks Preservation Commission structural-alteration-permit review, which is not solar-specific but could apply if panels/mounts change a protected building's exterior. 60% · authority's own search results / department page
    • Is a wind or windstorm certification required? No 65% · checklist
    • Is a Specific Use Permit or Council approval ever required? No — not required for a qualifying residential rooftop system 60% · department bulletin (inference)
    • Is there a system-size cap on residential generation? No hard cap found on residential system size; the streamlined/SolarAPP+ track is limited to 10kW AC on a single-family or duplex roof, but larger systems remain eligible for the standard permit process. 70% · checklist
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Who is allowed to pull the electrical permit? Either 70% · checklist
    • Must the contractor be registered with this authority before applying? Yes 85% · department page
    • Is a homeowner permitted to self-install and self-permit? Yes 65% · checklist
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Code Compliance Checklist (Solar PV, form #166) plus: Schematic Site Plan; Structural Plan (or Structural Criteria worksheet for flush-mount); Electrical Plan / single-line diagram (or a Standard Plan worksheet for central/string or microinverter systems); manufacturer spec sheets; Permit Application (Building/Electrical/Mechanical/Plumbing). Streamlined/SolarAPP+ track first requires passing the Eligibility Checklist. 95% · authority's own page
    • How many copies, and in what format? Electronic PDF only — unsecured/flattened, embedded fonts, minimum 11x17 sheet size (per the Code Compliance Checklist header); standard walk-in submittals are brought on a USB flash drive at 300 dpi minimum, max attachment size ~100-195MB depending on the page cited; no paper plans accepted at the Permit Service Center. 85% · checklist / department bulletin
    • Is a site plan required, and what must it show? Yes — Schematic Site Plan showing building footprint with distances to property lines, PV system location(s), main electrical service panel and subpanel location(s), all exterior/interior equipment and disconnect locations with working clearances, and clear roof access pathways from eave to ridge; must include project info, scope of work, and a legend. 95% · checklist
    • Is a one-line / three-line diagram required? Yes 95% · checklist
    • Are string and conductor calculations required? Yes 85% · standard plan worksheet
    • Is a structural PE stamp required, and at what threshold? Required only if the array does not qualify under the Structural Criteria for Residential Flush-Mounted Solar Arrays worksheet (roof condition, slope, rafter span/spacing, anchor spacing and wind-uplift fastener checks all pass); if any item fails, 'project-specific drawings and calculations stamped and signed by a California-licensed civil or structural engineer' are required. Non-flush-mounted arrays (>10in gap) always require an engineer per the CCC. 90% · checklist
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

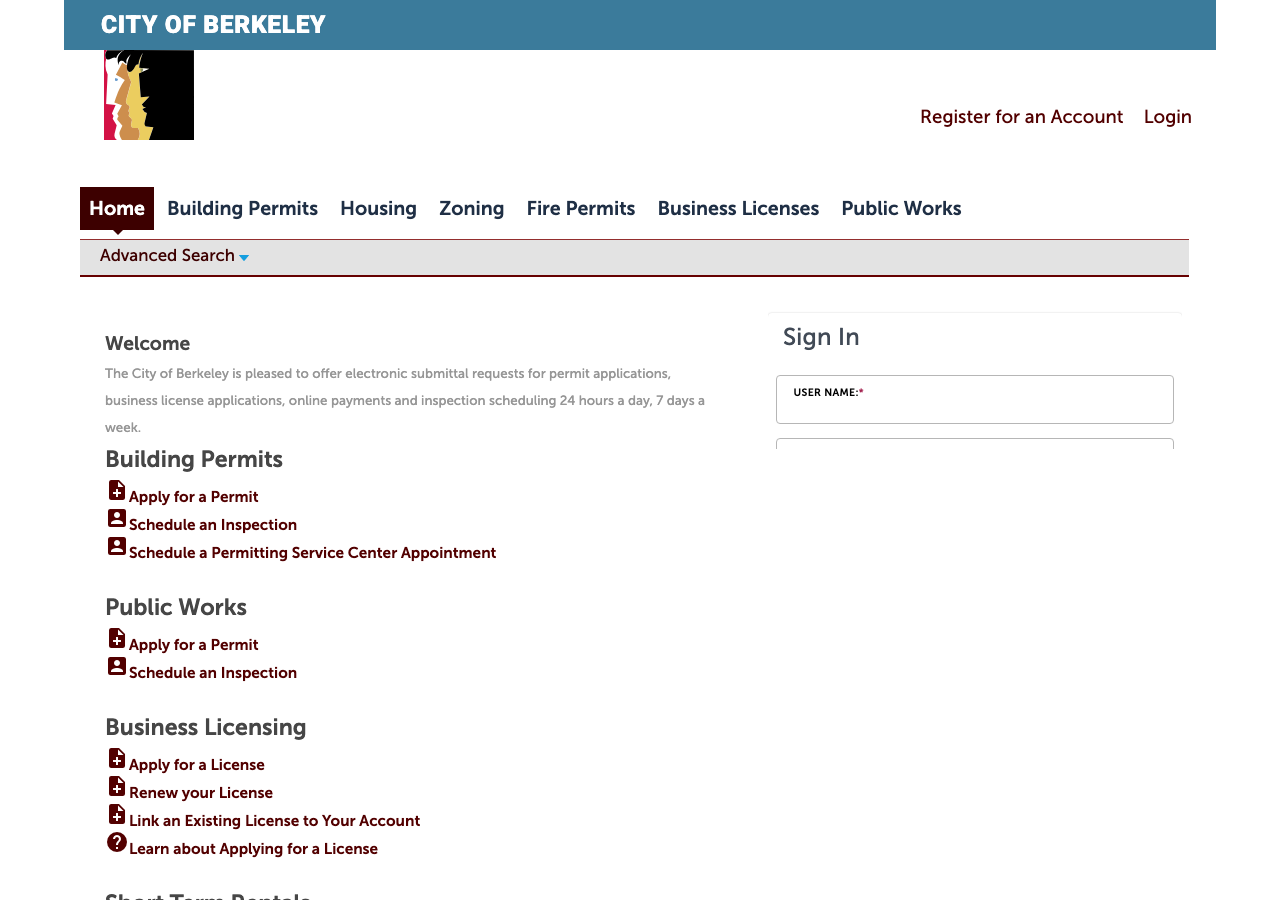

    • Which permit portal does this authority use? Permits Online (Berkeley's permit portal) for standard/streamlined applications and record tracking/inspections; SolarAPP+ for real-time automated review/issuance of eligible residential PV/ESS systems. 95% · authority's own page
    • Can the whole application be completed online? Yes 90% · authority's own page
    • What does a residential solar permit cost? SolarAPP+: $100 flat/system. Standard electrical permit — Residential ≤15kW: $200 (includes plan check). Residential >15kW: $250 plus $15/kW above 15kW (includes plan check). Energy Storage System (residential, ≤50kW aggregate): $150; >50kW aggregate: $275. 95% · fee schedule
    • How is the fee calculated? Tiered 95% · fee schedule
    • Is there a separate plan-check fee? No 85% · fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? Residential Solar PV is listed among the Permit Service Center's over-the-counter projects with a plan check of about 30 minutes; the Solar Permits page states standard-process solar applications are 'reviewed within one working day,' and streamlined/SolarAPP+ applications submitted electronically are issued in 1-3 business days (SolarAPP+ can be real-time). 90% · department page
    • Which utility handles interconnection here? PG&E (Pacific Gas & Electric) 95% · authority's own page
    • Where does the utility sit in the sequence? Parallel 55% · utility manual (inference)

28 questions answered against City of Berkeley’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherBerkeley is a charter city with its own Building & Safety Division and Fire Department; Solar Permits page and BMC Title 19 (Buildings and Construction) show the City issues its own building, electrical, mechanical and plumbing permits and performs its own plan review/inspection for residential solar within city limits. Alameda County (a separate AHJ record) has no role here since Berkeley is incorporated.

authority's own page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-types/solar-permits

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherBerkeley's Building & Safety Division (Planning and Development dept) issues Building, Electrical, Mechanical and Plumbing permits itself; nothing is delegated to Alameda County. Fire plan review/inspection is a separate in-house division (Berkeley Fire Dept), not delegated outside the City.

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-types/solar-permits

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherSolar PV System Submittal Requirements states 'All solar PV installations need an electrical permit'; building permit also required only if structural work is needed.

department bulletin checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Solar-PV-System-Submittal-Requirements.pdf

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherBerkeley's solar submittal is filed as one combined 'Permit Application (Building, Electrical, Mechanical, Plumbing, Sign)' referenced by both the Solar Photovoltaic Code Compliance Checklist and the streamlined-review requirements, though the fee schedule still itemizes electrical vs. building fees separately by trade.

checklist / fee schedule checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe Code Compliance Checklist signature block offers 'Contractor / Owner / Owner's Agent' as who may certify and submit, and the Standard Plan worksheets have a 'Contractor/Engineer' field with license # and class, indicating either a licensed contractor or the owner may apply; actual installation must be by a 'qualified person' trained per NFPA 70E under CEC 690.4(C).

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Yes

Why the confidence is not higherLicensed Contractors and Design Professionals page: 'Contractors will also need a Berkeley Business License' in addition to their CSLB license.

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/licensed-contractors-and-design

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherThe Code Compliance Checklist and Structural Criteria worksheet both list 'Owner' as a valid signer/applicant alongside Contractor and Owner's Agent, implying homeowner self-permit is accepted; Berkeley does not publish an explicit owner-builder prohibition for solar (site search for 'owner-builder' returned no dedicated policy page).

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q8 What documents make up a complete submittal? Core Submittal package

Code Compliance Checklist (Solar PV, form #166) plus: Schematic Site Plan; Structural Plan (or Structural Criteria worksheet for flush-mount); Electrical Plan / single-line diagram (or a Standard Plan worksheet for central/string or microinverter systems); manufacturer spec sheets; Permit Application (Building/Electrical/Mechanical/Plumbing). Streamlined/SolarAPP+ track first requires passing the Eligibility Checklist.

Why the confidence is not higherSolar Permits page lists the required-document sets for SolarAPP+, streamlined, and standard tracks; Solar PV System Submittal Requirements bulletin gives the full list for the standard track (cover sheet, site plan, electrical plan, roof plan/cross-section, spec sheets).

authority's own page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-types/solar-permits

Q9 How many copies, and in what format? Submittal package

Electronic PDF only — unsecured/flattened, embedded fonts, minimum 11x17 sheet size (per the Code Compliance Checklist header); standard walk-in submittals are brought on a USB flash drive at 300 dpi minimum, max attachment size ~100-195MB depending on the page cited; no paper plans accepted at the Permit Service Center.

Why the confidence is not higherHeader of the Solar CCC (rev. 04/27/26) specifies PDF format/size rules; Solar PV System Submittal Requirements (rev. 8/1/2018) and the Plan Check page both describe USB/PDF submittal with slightly different max-size figures (100MB vs 195MB), suggesting the number has changed between document revisions.

checklist / department bulletin checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes — Schematic Site Plan showing building footprint with distances to property lines, PV system location(s), main electrical service panel and subpanel location(s), all exterior/interior equipment and disconnect locations with working clearances, and clear roof access pathways from eave to ridge; must include project info, scope of work, and a legend.

Why the confidence is not higherSolar Photovoltaic Code Compliance Checklist, 'Permit Submittal Requirements' section.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes

Why the confidence is not higherCCC requires an 'Electrical Plan showing: (a) complete single line diagram of the PV and utility interconnect...'

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q12 Are string and conductor calculations required? Drawings & calculations

Yes

Why the confidence is not higherThe Standard Plan worksheets (Central/String Inverter and Microinverter/ACM) require module Voc/Isc, DC module/string layout per MPPT input, and conductor/inverter output ratings to be calculated and recorded as part of the submittal.

standard plan worksheet checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Standard-Plan-Inverter-Systems.pdf

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Required only if the array does not qualify under the Structural Criteria for Residential Flush-Mounted Solar Arrays worksheet (roof condition, slope, rafter span/spacing, anchor spacing and wind-uplift fastener checks all pass); if any item fails, 'project-specific drawings and calculations stamped and signed by a California-licensed civil or structural engineer' are required. Non-flush-mounted arrays (>10in gap) always require an engineer per the CCC.

Why the confidence is not higherStructural Criteria worksheet, Section 3 'Summary'; CCC Structural Plan section.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Structural-Criteria-for-Residential-Flush-Mounted-Solar-Arrays.pdf

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedSolar CCC, ESS CCC, Solar PV Submittal Requirements, and both Standard Plan worksheets — none states a valuation, ampacity, or voltage threshold at which an electrical (as opposed to structural) PE stamp is separately required beyond the standard Standard-Plan/engineer sign-off path for non-conforming structural configurations.

https://www.berkeleyca.gov/sites/default/files/2022-03/Solar-PV-System-Submittal-Requirements.pdf

Q15 What does a residential solar permit cost? Core Fees

SolarAPP+: $100 flat/system. Standard electrical permit — Residential ≤15kW: $200 (includes plan check). Residential >15kW: $250 plus $15/kW above 15kW (includes plan check). Energy Storage System (residential, ≤50kW aggregate): $150; >50kW aggregate: $275.

Why the confidence is not higherPlanning & Development Fee Schedule effective 7/1/2026 (PDF stamped 08/05/2026), Section V 'Electrical Permits'.

fee schedule checked 2026-08-30 https://berkeleyca.gov/sites/default/files/Berkeley%20Fee%20Schedule%2008052026.pdf

Q16 How is the fee calculated? Core Fees

Tiered

Why the confidence is not higherFee schedule sets flat tiers by system size with a per-kW add-on above the 15kW (residential) / 50kW (commercial) breakpoints; a flat $100 applies instead when filed through SolarAPP+.

fee schedule checked 2026-08-30 https://berkeleyca.gov/sites/default/files/Berkeley%20Fee%20Schedule%2008052026.pdf

Q17 Is there a separate plan-check fee? Fees

No

Why the confidence is not higherFee schedule marks both the ≤15kW and >15kW residential solar fee lines 'Includes Plan Check' — no separate plan-check line item for solar/PV permits.

fee schedule checked 2026-08-30 https://berkeleyca.gov/sites/default/files/Berkeley%20Fee%20Schedule%2008052026.pdf

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Residential Solar PV is listed among the Permit Service Center's over-the-counter projects with a plan check of about 30 minutes; the Solar Permits page states standard-process solar applications are 'reviewed within one working day,' and streamlined/SolarAPP+ applications submitted electronically are issued in 1-3 business days (SolarAPP+ can be real-time).

Why the confidence is not higherPlan Check page ('Plan checks may take from 30 minutes to several weeks' — lists Residential Solar PV as an over-the-counter item) and Solar Permits page.

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/plan-check

Q19 How long is an issued permit valid before it expires? Timeline & validity

Nothing published by this authority.

Where we lookedEstimate Permit Fees page, Plan Check page, and the Fee Schedule — permit extension fees are listed (implying permits do expire) but no specific validity period in days was published on any page checked.

https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/planning-and-development-fees

Q20 Which permit portal does this authority use? Core Portal & process

Permits Online (Berkeley's permit portal) for standard/streamlined applications and record tracking/inspections; SolarAPP+ for real-time automated review/issuance of eligible residential PV/ESS systems.

Why the confidence is not higherSolar Permits page describes both routes explicitly.

authority's own page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-types/solar-permits

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherSolarAPP+ provides real-time automated plan review and permit issuance entirely online for eligible residential systems; Permits Online also supports full electronic submittal, tracking, document upload and inspection scheduling for the streamlined/standard tracks.

authority's own page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-types/solar-permits

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas & Electric)

Why the confidence is not higherBerkeley's own Clean Energy page states Ava Community Energy (the local CCA, formerly East Bay Community Energy) 'partners with PG&E, which delivers electricity...maintains the power lines, responds to outages' — i.e., PG&E remains the interconnecting utility of record; Ava/CCA only supplies generation, and sets no interconnection rules. Confirmed independently by PG&E's own Greenbook (TD-7001M-06) territory scope.

authority's own page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/green-building/clean-energy

Q23 Where does the utility sit in the sequence? Core Utility interconnection

Parallel

Why the confidence is not higherPG&E's Rule 21/NEM interconnection application is typically processed on a track parallel to the city permit, but Permission to Operate is withheld until proof of the city's final inspection is submitted; this sequencing is standard PG&E/NEM practice inferred from the Greenbook's interconnection chapter (Ch. 6) rather than a single explicit Berkeley- or PG&E-stated sequence diagram found this run.

utility manual (inference) checked 2026-08-30 https://www.pge.com/assets/pge/docs/account/service-requests/greenbook-manual-full.pdf

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No

Why the confidence is not higherSolar PV System Submittal Requirements: 'Solar PV installations do not require zoning permits or design review (California State Code, Section 65850.5)'; a new structure like a canopy that incorporates PV would still need zoning review.

department bulletin checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Solar-PV-System-Submittal-Requirements.pdf

Q25 Is there a historic-district review? Overlays & special cases

No for a typical residential rooftop system (Gov. Code §65850.5 preempts local design review); however, exterior alterations to a designated City Landmark, Structure of Merit, or property within a Historic District can trigger a Landmarks Preservation Commission structural-alteration-permit review, which is not solar-specific but could apply if panels/mounts change a protected building's exterior.

Why the confidence is not higherSolar PV Submittal Requirements bulletin (preemption) plus Berkeley site-search results describing Landmark Alteration Permits and the Landmarks Preservation Commission's review of 'construction, alteration, and demolition permit applications' — no Berkeley document found this run resolving the two for solar specifically.

authority's own search results / department page checked 2026-08-30 https://www.berkeleyca.gov/search?search=landmark%20solar

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherNo wind/windstorm certification (TDI-style) requirement found; wind uplift for rooftop PV is instead addressed through the Structural Criteria worksheet's anchor-fastener and wind-exposure assumptions (Table 1), or a stamped engineering calculation when those assumptions aren't met — not a separate certificate.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Structural-Criteria-for-Residential-Flush-Mounted-Solar-Arrays.pdf

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

No — not required for a qualifying residential rooftop system

Why the confidence is not higherNo SUP/Council-approval requirement found for rooftop residential solar; Gov. Code §65850.5 routes it through ministerial building/electrical permitting instead of a use-permit/Council process. Not confirmed for non-qualifying or ground-mount configurations.

department bulletin (inference) checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Solar-PV-System-Submittal-Requirements.pdf

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No hard cap found on residential system size; the streamlined/SolarAPP+ track is limited to 10kW AC on a single-family or duplex roof, but larger systems remain eligible for the standard permit process.

Why the confidence is not higherSolar Permits page and Eligibility Checklist both cap the streamlined track at '10kW AC or less'; no separate size cap for the standard-process track was found.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Eligibility-Checklist-for-Solar-Streamlining.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2023 80% · checklist (current, dated)
    • Which building code edition is in force? 2025 California Residential Code / California Building Code (California's 2025 Building Standards Code cycle, effective 1/1/2026) 80% · checklist (current, dated)
    • Which fire code edition is in force? 2025 California Fire Code (by inference from the same statewide code cycle); BMC Ch. 19.48 is titled 'Berkeley Fire Code' with §19.48.010 'Adoption of California Fire Code.' 55% · municipal code TOC (archived, text unconfirmed)
    • Are there local amendments to any of the above? Yes 75% · municipal code TOC (archived)
    • What is the installation judged against? The 2025 CRC/CEC/CMC/CPC/CEnC/CGBSC as locally amended by BMC Title 19 (Chs. 19.28-19.37), plus Berkeley's own Code Compliance Checklists (Solar PV, ESS) which restate and supplement the applicable code sections for plan review. 80% · checklist
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Two minimum-36in-wide clear pathways from lowest roof edge to ridge (at least one on the street/driveway side); ridge setback of 18in on both sides of the ridge if the array covers ≤33% of plan-view roof area, or 36in if it covers >33% [CRC R329.6.1/R329.6.2]; a 36in pathway must also be kept to any emergency escape/rescue opening. 90% · checklist
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Yes, required to CEC 690.12 (module-level rapid shutdown under the 2025 CEC, which follows 2023 NEC Art. 690.12): ≤80V inside the array boundary and ≤30V outside/beyond 3ft from point of entry, both within 30 seconds of initiation; initiation device located outside the building. 90% · checklist
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? A permanent plaque/directory identifying all power sources at the service equipment location (CEC 705.10); a rapid-shutdown label at the service equipment indicating initiation-device location; a DC-voltage disclosure label at the DC disconnect/inverter/distribution equipment (CEC 690.7(D)); 'WARNING: PHOTOVOLTAIC POWER SOURCE' labels on exposed raceways, pull/junction box covers and unused conduit-body openings (CEC 690.31(D)(2)); plus, from PG&E, an engraved line/supply-side-connection placard on the metering equipment when applicable. 90% · checklist / utility manual
    • Does the authority specify placard wording of its own? Yes 90% · checklist
    • Does it specify letter height, colour or material? Reflective labels, capital letters, minimum 3/8in letter height, white lettering on a red background; spacing between labels not more than 10ft; suitable for the installation environment. 90% · checklist
    • Is a site plan / facility map placard required, and what must it show? A Schematic Site Plan and Roof Plan are required at submittal, showing building footprint, PV location, equipment/disconnect locations, and the two required 36in clear access pathways to the ridge; a permanent plaque/directory (not a full facility map) is what's actually required to be posted at the service equipment. 75% · checklist
    • Does the UTILITY specify placards beyond the AHJ's? Yes 90% · utility manual
    • Where must the labels be placed? AHJ-required labels: at the service equipment/directory location, at the DC disconnect or inverter, and on any raceway/enclosure/junction box carrying PV source conductors (spaced ≤10ft apart, visible after install). Utility-required label: PG&E's engraved line/supply-side-connection placard is installed on the metering equipment itself. 90% · checklist / utility manual
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Where must the AC disconnect be, relative to the meter? Required for all self-contained/transformer-rated meter panels EXCEPT single-phase, socket-based, self-contained panels rated ≤320A continuous, which are exempt unless a K-base meter panel (always requires one). Where required, the AC disconnect must be PG&E-approved and located per PG&E Electric Design Standard 060559, generally at/adjacent to the meter/service equipment; line-side (supply-side) connections additionally require a fusible disconnect plus an engraved placard on the metering equipment. 85% · utility manual
    • Must equipment be on a specific approved list? Yes 90% · checklist
    • Are batteries permitted, and under what conditions? Yes, with conditions: UL 9540-listed, max 20kWh per unit / 600kWh aggregate on the property (CRC Table R330.5); not in habitable rooms, sleeping rooms, or closets opening onto them; only in detached garages/accessory structures, separated attached garages, protected exterior locations ≥3ft from doors/windows, or fire-rated interior utility rooms/closets with 20-min-rated self-closing doors; ESS units separated ≥3ft from each other unless UL 9540A large-scale fire testing supports less; protected from vehicle impact where applicable. 95% · checklist
    • Is there a separate ESS permit or inspection? No — issued under the same electrical permit process as the PV system, not as a standalone permit type 70% · fee schedule / checklist
    • Is there a local rule on service upgrades or busbar sizing? For the streamlined track, the PV system must interconnect to a single-phase 120/240V service panel with a busbar rating of 225A or less (larger services route to the standard/engineered review track); no separate local busbar-sizing amendment to CEC 705.12 beyond that eligibility threshold was found. 75% · checklist
    • Is a specific mounting system or attachment spacing required? Yes 90% · checklist

20 questions answered against City of Berkeley’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2023

Why the confidence is not higherBerkeley's Solar Photovoltaic Code Compliance Checklist (revised 04/27/26) states its code section references are keyed to 'the 2025 edition of the...California Electrical Code (CEC)' — California's 2025 Building Standards Code cycle (effective 1/1/2026) is based on the 2023 NEC. Not independently corroborated against BMC 19.30 text, which is Cloudflare-blocked live.

checklist (current, dated) checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q30 Which building code edition is in force? Core Code editions in force

2025 California Residential Code / California Building Code (California's 2025 Building Standards Code cycle, effective 1/1/2026)

Why the confidence is not higherSame CCC document: 'Numbers in parenthesis refer to code sections of the 2025 edition of the California Residential Code (CRC), California Electrical Code (CEC), California Mechanical Code (CMC), California Plumbing Code (CPC), California Energy Code (CEnC) and California Green Building Standards Code (CGBSC).' BMC 19.28/19.29 (Berkeley Building/Residential Code) adopt the state code by reference but their live text is Cloudflare-blocked.

checklist (current, dated) checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code (by inference from the same statewide code cycle); BMC Ch. 19.48 is titled 'Berkeley Fire Code' with §19.48.010 'Adoption of California Fire Code.'

Why the confidence is not higherBMC Title 19 table of contents (archived) confirms Ch. 19.48 adopts the CFC by reference; the specific edition year was not independently confirmed in extractable text this run — berkeley.municipal.codes 403s live (Cloudflare) and the archived captures only show chapter/section titles, not body text.

municipal code TOC (archived, text unconfirmed) checked 2026-08-30 https://web.archive.org/web/20221014025844id_/https://berkeley.municipal.codes/BMC/19.48

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherBMC Title 19 contains dedicated local-amendment chapters/sections for each state code: e.g. §19.48.020 'Amendments to the California Fire Code,' plus Chs. 19.28 (Building), 19.29 (Residential), 19.30 (Electrical), 19.36 (Energy/solar mandate), 19.37 (Green) — each an adopting-and-amending ordinance. Full amendment text is Cloudflare-blocked on the live code site; existence of amendments is established from chapter/section titles only.

municipal code TOC (archived) checked 2026-08-30 https://web.archive.org/web/20220119025317id_/https://berkeley.municipal.codes/BMC/19

Q33 What is the installation judged against? Core Electrical

The 2025 CRC/CEC/CMC/CPC/CEnC/CGBSC as locally amended by BMC Title 19 (Chs. 19.28-19.37), plus Berkeley's own Code Compliance Checklists (Solar PV, ESS) which restate and supplement the applicable code sections for plan review.

Why the confidence is not higherSolar and ESS CCCs both open with 'Numbers in parenthesis refer to code sections of the 2025 edition of the [state codes]... as they may apply to this project.'

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

For the streamlined track, the PV system must interconnect to a single-phase 120/240V service panel with a busbar rating of 225A or less (larger services route to the standard/engineered review track); no separate local busbar-sizing amendment to CEC 705.12 beyond that eligibility threshold was found.

Why the confidence is not higherEligibility Checklist for Solar Streamlining, Electrical Requirements item C.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Eligibility-Checklist-for-Solar-Streamlining.pdf

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Yes

Why the confidence is not higherStructural Criteria for Residential Flush-Mounted Solar Arrays worksheet mandates specific anchor horizontal spacing (Table 1, by roof slope and rafter spacing), fastener size/embedment (5/16in lag screw, 2.5in embedment or manufacturer's listing), and a 2-10in flush-mount gap; non-conforming designs require a stamped engineer.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Structural-Criteria-for-Residential-Flush-Mounted-Solar-Arrays.pdf

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Two minimum-36in-wide clear pathways from lowest roof edge to ridge (at least one on the street/driveway side); ridge setback of 18in on both sides of the ridge if the array covers ≤33% of plan-view roof area, or 36in if it covers >33% [CRC R329.6.1/R329.6.2]; a 36in pathway must also be kept to any emergency escape/rescue opening.

Why the confidence is not higherSolar Photovoltaic Code Compliance Checklist, 'Fire Department Requirements' section, citing CRC R329.6.1-R329.6.3 directly (dimensions quoted verbatim, not paraphrased from the ICC-copyrighted code text itself).

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Yes, required to CEC 690.12 (module-level rapid shutdown under the 2025 CEC, which follows 2023 NEC Art. 690.12): ≤80V inside the array boundary and ≤30V outside/beyond 3ft from point of entry, both within 30 seconds of initiation; initiation device located outside the building.

Why the confidence is not higherSolar CCC, 'Rapid Shutdown' section.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

A permanent plaque/directory identifying all power sources at the service equipment location (CEC 705.10); a rapid-shutdown label at the service equipment indicating initiation-device location; a DC-voltage disclosure label at the DC disconnect/inverter/distribution equipment (CEC 690.7(D)); 'WARNING: PHOTOVOLTAIC POWER SOURCE' labels on exposed raceways, pull/junction box covers and unused conduit-body openings (CEC 690.31(D)(2)); plus, from PG&E, an engraved line/supply-side-connection placard on the metering equipment when applicable.

Why the confidence is not higherSolar CCC 'Electrical Code Requirements' section; PG&E Greenbook TD-7001M-06 §6.3.

checklist / utility manual checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Yes

Why the confidence is not higherCCC specifies exact required wording: 'WARNING: PHOTOVOLTAIC POWER SOURCE' for PV wiring methods; ESS CCC requires the disconnect be 'permanently marked ENERGY STORAGE SYSTEM DISCONNECT.'

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Reflective labels, capital letters, minimum 3/8in letter height, white lettering on a red background; spacing between labels not more than 10ft; suitable for the installation environment.

Why the confidence is not higherSolar CCC, 'Marking Locations' paragraph under Electrical Code Requirements.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

A Schematic Site Plan and Roof Plan are required at submittal, showing building footprint, PV location, equipment/disconnect locations, and the two required 36in clear access pathways to the ridge; a permanent plaque/directory (not a full facility map) is what's actually required to be posted at the service equipment.

Why the confidence is not higherSolar CCC 'Permit Submittal Requirements' + 'Identification of Power Sources' sections.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes

Why the confidence is not higherPG&E's Greenbook (TD-7001M-06, publication 4/22/2026, effective 6/22/2026) requires an engraved placard/signage on the metering equipment for any line/supply-side generator connection, independent of any AHJ placard requirement.

utility manual checked 2026-08-30 https://www.pge.com/assets/pge/docs/account/service-requests/greenbook-manual-full.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

AHJ-required labels: at the service equipment/directory location, at the DC disconnect or inverter, and on any raceway/enclosure/junction box carrying PV source conductors (spaced ≤10ft apart, visible after install). Utility-required label: PG&E's engraved line/supply-side-connection placard is installed on the metering equipment itself.

Why the confidence is not higherSolar CCC 'Marking Locations'; PG&E Greenbook §6.3.3(a).

checklist / utility manual checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q44 Must equipment be on a specific approved list? Equipment listing

Yes

Why the confidence is not higherCCC requires PV modules listed to UL 1703 or UL 61730-1/-2; inverters listed to UL 1741 (utility-interactive listing for grid-tied units); mounting systems listed to UL 2703; BIPV roofing to UL 7103; ESS listed to UL 9540 (UL 9540A for reduced separation).

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Yes, with conditions: UL 9540-listed, max 20kWh per unit / 600kWh aggregate on the property (CRC Table R330.5); not in habitable rooms, sleeping rooms, or closets opening onto them; only in detached garages/accessory structures, separated attached garages, protected exterior locations ≥3ft from doors/windows, or fire-rated interior utility rooms/closets with 20-min-rated self-closing doors; ESS units separated ≥3ft from each other unless UL 9540A large-scale fire testing supports less; protected from vehicle impact where applicable.

Why the confidence is not higherEnergy Storage System Code Compliance Checklist (form #168, rev. 04/27/26), 'Residential Code Requirements' section.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/168%20CCC%20-%20Energy%20Storage%20System_2.pdf

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No — issued under the same electrical permit process as the PV system, not as a standalone permit type

Why the confidence is not higherBerkeley's fee schedule lists ESS as separate fee line items from Solar/PV (distinct dollar amounts) and there's a dedicated ESS Code Compliance Checklist (form #168), but 'Solar Permits' is the only permit-type page covering both PV and ESS — no separate 'ESS Permit' type appears in the Permit Types list.

fee schedule / checklist checked 2026-08-30 https://berkeleyca.gov/sites/default/files/Berkeley%20Fee%20Schedule%2008052026.pdf

Q47 Is a ground mount treated as a structure? Core Ground mount

Nothing published by this authority.

Where we lookedBerkeley zoning/building permit pages for ground-mount solar (Solar Permits page, Solar PV Submittal Requirements, Zoning Permits/Use Permit pages) — no page found stating whether a ground-mounted array is treated as an accessory structure for setback/permit purposes.

https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-types/solar-permits

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Required for all self-contained/transformer-rated meter panels EXCEPT single-phase, socket-based, self-contained panels rated ≤320A continuous, which are exempt unless a K-base meter panel (always requires one). Where required, the AC disconnect must be PG&E-approved and located per PG&E Electric Design Standard 060559, generally at/adjacent to the meter/service equipment; line-side (supply-side) connections additionally require a fusible disconnect plus an engraved placard on the metering equipment.

Why the confidence is not higherPG&E Greenbook TD-7001M-06 (eff. 6/22/2026), Table 6-3 'Requirements for AC Disconnect Switches' and §6.3.3.

utility manual checked 2026-08-30 https://www.pge.com/assets/pge/docs/account/service-requests/greenbook-manual-full.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Portal (Permits Online) or Phone (automated scheduling line) 90% · department page
    • Are same-day or AM/PM windows offered? No guaranteed AM/PM window is published; inspections run Mon-Fri 9am-4pm and an estimated time is posted online the morning of the scheduled day. 75% · department page
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 90% · department page
    • If delegated, to whom? N/A — not delegated; performed by the City of Berkeley Building & Safety Division's own area-assigned inspectors (and, for fire/life-safety items, the Berkeley Fire Department's own Fire Prevention Division). 85% · department page
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? Streamlined/SolarAPP+ track: one consolidated final inspection once installation is complete. Standard track: may include an electrical rough/underground inspection plus a final, depending on scope; all required finals for a permit (Building/Electrical/Mechanical/Plumbing) must be scheduled together on the same day. 75% · department bulletin
    • Is a rough-in or mid-roof inspection required? No, not for the streamlined track 75% · department bulletin
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? Yes 80% · checklist
    • What must be on site at inspection? Printed copies of the permit, the approved plans, and the job card; per the CCC, manufacturer's specification sheets and grounding/installation instructions should also be available for the inspector. 90% · department page
    • Does the inspector verify labels and listings? Yes 75% · checklist / department page
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final 55% · department page (inference)
    • Who notifies the utility for PTO? Installer 45% · utility manual (inference, low confidence)
    • Is there a re-inspection fee? $250/hour, one-hour minimum 80% · fee schedule
    • How are corrections issued and cleared? Inspector issues an Inspection Report listing items to correct; once all items are addressed, the applicant/contractor schedules a re-inspection (same portal/phone channels as the original inspection) to clear them. 85% · department page

14 questions answered against City of Berkeley’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Portal (Permits Online) or Phone (automated scheduling line)

Why the confidence is not higherBuilding Inspections page: schedule via Permits Online, or via the automated phone system.

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q50 How much notice is required? Core Booking & scheduling

Nothing published by this authority.

Where we lookedBuilding Inspections page, Plan Check page, and Solar Permits page — none states a specific business-day advance-notice requirement for booking an inspection; only scheduling mechanics and hours are given.

https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

No guaranteed AM/PM window is published; inspections run Mon-Fri 9am-4pm and an estimated time is posted online the morning of the scheduled day.

Why the confidence is not higherBuilding Inspections page: 'Inspections generally take place Monday through Friday between 9 am and 4 pm...you will be able to check the estimated time of your inspection online.'

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherBuilding Inspections page describes the City's own area-assigned inspectors ('The City assigns inspectors by area') performing all building-permit inspections; Fire plan review/inspection is likewise in-house (Berkeley Fire Dept), not delegated outside the City.

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q53 If delegated, to whom? Core Who inspects

N/A — not delegated; performed by the City of Berkeley Building & Safety Division's own area-assigned inspectors (and, for fire/life-safety items, the Berkeley Fire Department's own Fire Prevention Division).

Why the confidence is not higherBuilding Inspections page + Fire Department Plan Review page.

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q54 Which inspections are required, and in what order? Core Stages & sequence

Streamlined/SolarAPP+ track: one consolidated final inspection once installation is complete. Standard track: may include an electrical rough/underground inspection plus a final, depending on scope; all required finals for a permit (Building/Electrical/Mechanical/Plumbing) must be scheduled together on the same day.

Why the confidence is not higherSolar PV Residential Requirements for Streamlined Review: 'One consolidated inspection will be performed when installation is complete'; Building Inspections page: 'You must schedule all final inspections for the same day.'

department bulletin checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Requirements-for-Streamlined-Review.pdf

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No, not for the streamlined track

Why the confidence is not higherRequirements for Streamlined Review states only 'One consolidated inspection will be performed when installation is complete' — no separate rough-in/mid-roof inspection is described for eligible small residential systems.

department bulletin checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/2022-03/Requirements-for-Streamlined-Review.pdf

Q56 Does the inspector verify labels and listings? Core What is checked

Yes

Why the confidence is not higherThe Solar/ESS Code Compliance Checklists that the applicant signs (and which the inspector references) explicitly cover 'Equipment Listings,' 'Listing of Existing Equipment,' and 'All required markings and labels are provided' as fire-safety eligibility items; the applicant 'certifies' compliance with these at permit issuance, and 'documentation on-site' items on the Building Inspections page (job card, approved plans) support field verification.

checklist / department page checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q57 Is there a published inspection checklist? Core What is checked

Yes

Why the confidence is not higherBerkeley publishes the Code Compliance Checklists (Solar PV #166, ESS #168), the Structural Criteria worksheet, and a 'New Construction Inspection Checklist' from the Fire Department — all function as published pre-inspection/compliance checklists.

checklist checked 2026-08-30 https://www.berkeleyca.gov/sites/default/files/documents/166%20CCC%20-%20Solar%20Photovoltaic_2.pdf

Q58 What must be on site at inspection? Core Documents on site

Printed copies of the permit, the approved plans, and the job card; per the CCC, manufacturer's specification sheets and grounding/installation instructions should also be available for the inspector.

Why the confidence is not higherBuilding Inspections page: 'Be sure to have your printed copies of your permit, approved plans, and job card on site during your inspection.'

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q59 Is there a re-inspection fee? Corrections & re-inspection

$250/hour, one-hour minimum

Why the confidence is not higherPlanning & Development Fee Schedule (eff. 7/1/2026), Building & Safety section: 'Re-Inspections $250.00 per hour with minimum of one hour.' (General Building & Safety re-inspection line; no solar-specific re-inspection fee found.)

fee schedule checked 2026-08-30 https://berkeleyca.gov/sites/default/files/Berkeley%20Fee%20Schedule%2008052026.pdf

Q60 How are corrections issued and cleared? Corrections & re-inspection

Inspector issues an Inspection Report listing items to correct; once all items are addressed, the applicant/contractor schedules a re-inspection (same portal/phone channels as the original inspection) to clear them.

Why the confidence is not higherBuilding Inspections page: 'If you do not pass your inspection, you will receive an Inspection Report that lists items for you to correct...you will need to schedule a re-inspection.'

department page checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q61 What is issued on pass? Core Final sign-off & PTO

Final

Why the confidence is not higherNo solar-specific document states what is literally issued; residential retrofit permits (not new construction/occupancy changes) in Berkeley are closed out with a passed 'Final' inspection recorded on the permit/job card via Permits Online rather than a Certificate of Occupancy — inferred from the general building-inspection process description, not an explicit statement.

department page (inference) checked 2026-08-30 https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-process/building-inspections

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer

Why the confidence is not higherStandard PG&E NEM/Rule 21 practice has the installer/applicant submit the Permission-to-Operate request to PG&E (with proof of the city's final inspection); this was not confirmed by an explicit PTO-process statement in the Greenbook chapter extracted this run (no 'Permission to Operate'/'PTO' text was found in the extracted sections), nor on a Berkeley city page.

utility manual (inference, low confidence) checked 2026-08-30 https://www.pge.com/assets/pge/docs/account/service-requests/greenbook-manual-full.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Berkeley against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Berkeley is the authority having jurisdiction 90% confidence
Holds
building, electrical, mechanical, plumbing and fire
Overridden by
CA Gov. Code §65850.5 preempts local zoning/design-review restrictions on qualifying residential rooftop solar; PG&E (not the Ava Community Energy CCA) controls interconnection, AC-disconnect and placard requirements independent of the City; and BMC local amendments adopted before AB 130's 1 Oct 2025 freeze on more-restrictive residential amendments remain in force, but any new local residential-code amendment attempted before 1 Jun 2031 would itself be preempted by AB 130 (Stats. 2025, Ch. 22).
Why not higher
Berkeley is an incorporated charter city with its own Planning & Development / Building & Safety Division (permits, plan check, inspection) and its own Fire Department (fire plan review/inspection) — confirmed on the Solar Permits, Plan Check and Fire Department Plan Review pages. It is NOT part of Alameda County's unincorporated-area AHJ (that is a separate GovBot record). Utility interconnection sits with PG&E, not the City and not Ava Community Energy (a CCA that only supplies generation).

https://www.berkeleyca.gov/construction-development/permits-design-parameters/permit-types/solar-permits

Permit required
Yes95%
Permit cost
SolarAPP+: $100 flat/system. Standard electrical permit — Residential ≤15kW: $200 (includes plan check). Residential >15kW: $250 plus $15/kW above 15kW (includes plan check).95%
Plan review
Residential Solar PV is listed among the Permit Service Center's over-the-counter projects with a plan check of about 30 minutes;90%
Portal
Permits Online (Berkeley's permit portal) for standard/streamlined applications and record tracking/inspections;95%
Electrical code
202380%
Own placard wording
Yes90%
Booking an inspection
Portal (Permits Online) or Phone (automated scheduling line)90%
Labels & placards for this authority

City of Berkeley writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.

Wording 90%

Yes

Size, colour & material 90%

Reflective labels, capital letters, minimum 3/8in letter height, white lettering on a red background; spacing between labels not more than 10ft; suitable for the installation environment.

Where they go 90%

AHJ-required labels: at the service equipment/directory location, at the DC disconnect or inverter, and on any raceway/enclosure/junction box carrying PV source conductors (spaced ≤10ft apart, visible after install). Utility-required label: PG&E's engraved line/supply-side-connection placard is installed on the metering equipment itself.

What the utility wants on top 90%

Yes

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Alameda County
Regions served
1
Regions covered
City of Berkeley · city
Solar Requirements
Authority Contact
Address
1947 Center Street, 3rd Floor, Berkeley, CA 94704
Main Phone
(510) 981-2489
Office Hours
8:30 a.m. – 4 p.m.
Building Department
Department
Building & Safety Division — Construction & Development
Direct Phone
(510) 981-7440
Dept Hours
8:30 a.m. – 4 p.m.
Portal Software
Accela
Booking & Scheduling
Preferred channel
online_portal
Booking phone
Notes
City uses Accela Citizen Access portal (aca-prod.accela.com/BERKELEY) for permit applications and inspection scheduling. To schedule an inspection: log in, enter permit number (format B20XX-XXXXX), go to Record Info > Inspections > Schedule or Request an Inspection. Inspections run Mon-Fri 9am-4pm; estimated time window viewable the morning of inspection day. For final solar inspections all trades must be scheduled the same day. After-hours inspections available for extra fee — request form emailed to buildingandsafety@berkeleyca.gov. Solar PV permits under 10kW AC on single-family/duplex qualify for SolarAPP+ (solarapp.nrel.gov) instant approval or streamlined online process. Permit Service Center (permits@berkeleyca.gov, (510) 981-7500) handles permit submissions; Permit Service Center at 2180 Milvia St, hours Mon-Thu 8:30am-2:30pm, closed Fri.
