City of Chula Vista
San Diego County
City of Chula Vista is a busy jurisdiction for residential solar — 9th in California by installs on record — 275,487 residents, with 22,684 residential solar installs on record. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes - a building permit is required for a residential rooftop PV system Q3 Electrical and building permits — Combined - one permit. The City issues a single Residential Solar permit (Form 4562C / Accela record type 'Residential Solar Energy' or 'Solar Permit with Solar App… Q4 Plan review — 10 business days for the first review of a Residential Solar Energy project; 5 business days for a recheck; 10 business days for a plan change. Q18 Where you file — Accela Citizen Access at permits.chulavistaca.gov/citizenaccess/chulavista.aspx (older City documents give the same portal as pip.chulavistaca.gov) for application, Q20
- Permit required
- Yes - a building permit is required for a residential rooftop PV system95% source
- What it costs
- $453 total on the SolarAPP+ expedited path ($30 intake + $0 plan check + $423 inspection); $722 total on the standard path ($70 intake + $158 plan check + $494 inspection).92% source
- Plan review turnaround
- 10 business days for the first review of a Residential Solar Energy project; 5 business days for a recheck; 10 business days for a plan change.90% source
- Key document
- master fee schedule bulletin 10-400 (Sep 2024) cited by 5 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes - the City of Chula Vista Development Services Department (Building Division) is the AHJ for residential solar inside the city limits 95% · department permit page
- What does this authority permit itself, and what does it delegate? Both - Development Services permits, plan-checks and field-inspects the building/structural and the electrical work itself. Nothing is delegated to San Diego County. Fire code administration sits with the Chula Vista Fire Department (CVMC 15.36), but no separate residential-solar fire permit or fire fee is published. 88% · master fee schedule bulletin 10-400 (Sep 2024)
- Is a permit required for a residential rooftop PV system? Yes - a building permit is required for a residential rooftop PV system 95% · municipal code (CVMC 15.06.080)
- Is there a separate electrical permit, or is it combined? Combined - one permit. The City issues a single Residential Solar permit (Form 4562C / Accela record type 'Residential Solar Energy' or 'Solar Permit with Solar App Plus') covering the electrical work; there is no separate electrical permit for the PV system. A main-panel upgrade taken with the PV work is a separate fee line ($203) on the same job, and requires an SDG&E work order. 85% · master fee schedule bulletin 10-400 (Sep 2024)
- Is a HOA or architectural approval required first? No. No City document conditions a solar permit on HOA or architectural approval, and CVMC 15.29 makes the expedited path administrative and non-discretionary. 85% · municipal code (absence)
- Is there a historic-district review? Yes, conditionally - and it is a gate that runs BEFORE the solar permit application. The applicant must check whether the structure is a designated or eligible historic resource using the City's Historic Home Finder GIS (gis.chulavistaca.gov/histhomefinder) by APN or address. If it is designated or eligible for designation, Historic Eligibility Clearance must be obtained before applying, and the work must conform to the Secretary of the Interior's Standards for Rehabilitation, 'Incorporating Solar Panels in a Rehabilitation Project'. Form 4562C asks up front 'Is building greater than 45 years old?' and 'Historic Yes/No', and lists 'Historic Eligibility clearance, if required' as a submittal item. 90% · department permit page + application form
- Is a wind or windstorm certification required? No. Chula Vista publishes no wind or windstorm certification requirement - that is a Gulf-coast construct with no California analogue. Wind is handled as ordinary structural design under the 2025 CBC/CRC (ASCE 7). 80% · municipal code (absence)
- Is a Specific Use Permit or Council approval ever required? Only in the exception case, and never by Council. Under CVMC 15.29.050 the Building Official may require a use permit if he makes a finding based on substantial evidence that the project could have a specific, adverse impact on public health and safety; under 15.29.060 the City may deny on written findings of an unmitigable specific adverse impact. Decisions of the Building Official are appealable to the Planning Commission. Zoning does not add a step: CVMC 19.58.142(F) provides that a 'residential-level facility' - an electrical generating facility serving an individual private dwelling - is 'subject to and governed by CVMC Title 15', i.e. the building code, while the CUP requirement in 19.58.142 applies to the other electrical-generating-facility sub-types. 90% · municipal code (CVMC 15.29.050 / 19.58.142(F))
- Is there a system-size cap on residential generation? No cap on residential generation. The only kW figure in the code is an ELIGIBILITY threshold, not a limit: CVMC 15.29.010 defines a 'small residential rooftop solar energy system' as no larger than 10 kW AC nameplate (or 30 kW thermal), on a single- or duplex-family dwelling, not exceeding the maximum legal building height. Above 10 kW AC the system is simply permitted on the standard path at the higher fee, not refused. The zoning definition of 'residential-level facility' (CVMC 19.04.002) carries no size figure. 90% · municipal code (CVMC 15.29.010)
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either - a California state-licensed contractor (who must also hold a valid City of Chula Vista business licence) or the property owner as owner-builder 92% · department process page
- Must the contractor be registered with this authority before applying? Yes - a valid City of Chula Vista business licence is required to perform work in the city, and contractors using the online path must also be registered in the Accela Citizen Access portal 90% · department process page
- Is a homeowner permitted to self-install and self-permit? Yes - owner-builder self-permit is expressly allowed; the owner must sign an owner-builder disclaimer certificate before issuance, and the solar page gives a property-owner submittal route (Building Permit Application + 2 sets of plans) 90% · department process page
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Per Form 4562C (Residential Solar Application, Rev 10.23): (1) the completed signed application with site address, APN, building age / historic flag, owner, contractor, State licence and Chula Vista business licence; (2) two complete sets of fully dimensioned scaled plans; (3) one site/plot plan (NOT required for roof-mount residential); (4) a roof plan showing roof layout, PV panels, approximate roof access point location, code-compliant access pathways, PV system fire classification and the locations of all required labels and markings per the current California Residential and Fire Codes; (5) Historic Eligibility clearance if required; (6) SDG&E work order for an electric panel upgrade, if applicable; (7) manufacturer's specification sheets for system components and for roof-penetration waterproofing method and material; (8) project valuation. On the expedited path, instead: the SolarAPP+ unique ID plus the SolarAPP+ forms/plans packet, uploaded to Citizen Access. 90% · published application/checklist (Form 4562C, Rev 10.23)
- How many copies, and in what format? Two complete sets of plans plus one plot plan and supporting documents - but submitted electronically. Since 13 December 2024 all new submittals go through Citizen Access / e-PlanSoft Electronic Plan Review as PDFs; plan-set sheet numbering must be bottom-right, 2-12 characters, and each file under 400MB. 80% · published application/checklist + EPR page
- Is a site plan required, and what must it show? A site/plot plan is required EXCEPT for roof-mount residential, where Form 4562C expressly waives it. What is always required instead is a roof plan showing roof layout, PV panel layout, approximate location of the roof access point, location of code-compliant access pathways, PV system fire classification, and the locations of all required labels and markings per the current California Residential and Fire Codes. For a ground mount the plot plan is required and, per the older Form 4613, should show site address, responsible parties, scope, property lines and dimensions, adjacent streets, existing buildings, setback distances, location of existing electrical services and panels, and the location of all solar equipment. 85% · published application/checklist (Form 4562C, Rev 10.23)
- Is a one-line / three-line diagram required? Yes - an electrical single-line diagram is required on the standard (non-SolarAPP+) path 70% · published checklist (Form 4613 - stale, cites 2001 CBC / 2004 CEC)
- Are string and conductor calculations required? Yes in substance - conductor sizing and overcurrent data must appear on the plans. Form 4613 requires conductor size and insulation type, grounding, ground-fault protection, disconnect location, amperage loading and a voltage description of all circuits, plus system ratings (operating current, voltage, maximum voltage, short-circuit current) and the number of modules in series and groups in parallel. On the SolarAPP+ path the string and conductor sizing is computed inside SolarAPP+ and printed on the approval/inspection checklist rather than submitted by the applicant. 70% · published checklist (Form 4613 - stale) + SolarAPP+ example checklist
- Is a structural PE stamp required, and at what threshold? Not routinely. No stamp is called for on a flush, roof-plane-parallel residential array. Form 4613 requires structural calculations/analysis only where the modules are installed at an angle to the roof (the plane of the modules not parallel to the plane of the roof), and then 'Calculations must be stamped and signed by a California licensed engineer or architect.' Application General Information adds the general rule that 'A licensed California architect or engineer may be required to prepare plans.' No kW or square-foot threshold is published. 75% · published checklist (Form 4613 - stale, cites 2001 CBC)
- Is an electrical PE stamp required, and at what threshold? None published. No City document requires an electrical PE stamp for a residential PV system at any threshold. 70% · department forms index + checklists (absence)
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? Accela Citizen Access at permits.chulavistaca.gov/citizenaccess/chulavista.aspx (older City documents give the same portal as pip.chulavistaca.gov) for application, fees, inspection booking and results; e-PlanSoft Electronic Plan Review behind it for plan review and corrections since 13 Dec 2024; and NREL SolarAPP+ (gosolarapp.org) as the mandatory front end for expedited solar permits since 28 June 2023. 92% · department permit page + portal landing
- Can the whole application be completed online? Yes. Application, fee payment, plan upload, corrections and resubmittal, inspection booking and results are all online; SolarAPP+ permits are issued instantly on submission of the SolarAPP+ ID and packet. In-person submittal at the Development Services counter, 276 Fourth Avenue Building B, remains available as an alternative. 90% · department permit page
- What does a residential solar permit cost? $453 total on the SolarAPP+ expedited path ($30 intake + $0 plan check + $423 inspection); $722 total on the standard path ($70 intake + $158 plan check + $494 inspection). A main-panel upgrade taken with the PV is a further $203 ($0 + $62 + $141). Commercial or multifamily is $1,683 for the first 500 panels. 92% · master fee schedule bulletin 10-400 (Sep 2024)
- How is the fee calculated? Flat per system, in two tiers by processing path (expedited vs traditional), built up from three flat components: intake fee + plan check fee + inspection fee. Not valuation-based and not per-kW for residential. Commercial/multifamily is tiered per 500 panels. 92% · master fee schedule bulletin 10-400 (Sep 2024)
- Is there a separate plan-check fee? Yes on the standard path ($158), no on the SolarAPP+ path ($0) 92% · master fee schedule bulletin 10-400 (Sep 2024)
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 10 business days for the first review of a Residential Solar Energy project; 5 business days for a recheck; 10 business days for a plan change. On the SolarAPP+ path review is instant - the approval is generated by SolarAPP+ and the Citizen Access submittal returns an approved permit number. 90% · department process page (plan check goals table)
- How long is an issued permit valid before it expires? 365 days to start work: a permit expires if work is not commenced within 12 months of issue, or if work is suspended or abandoned for 180 days after commencement. Extensions of up to 180 days each may be granted by the Building Official on written request. Separately, an application on which no permit issues within 12 months expires. 92% · municipal code (CVMC 15.06.090(D))
- Which utility handles interconnection here? San Diego Gas & Electric (SDG&E). San Diego Community Power is the Community Choice Aggregator serving Chula Vista, but it supplies generation and billing only and does NOT run interconnection. 95% · utility interconnection page + CCA page + city application form
- Where does the utility sit in the sequence? Parallel, with a hard dependency at the end. The SDG&E interconnection application is filed by the contractor separately from and alongside the City permit; the City permit does not authorise energisation; SDG&E issues Permission to Operate after the installation is complete and the AHJ inspection has passed. One SDG&E step can precede the permit: a work order is needed for an electric panel upgrade and must be submitted with Form 4562C. 85% · municipal code (CVMC 15.29.020(F)) + CCA process page
28 questions answered against City of Chula Vista’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes - the City of Chula Vista Development Services Department (Building Division) is the AHJ for residential solar inside the city limits
Why the confidence is not higherThe City publishes its own Residential Solar Energy Permits page, its own Residential Solar Photovoltaic Systems Application (Form 4562C), its own PV inspection list and its own solar placard specification, and CVMC 15.06.080 requires a permit from the Building Official. San Diego County is a separate AHJ and only for the unincorporated area - none of its answers carry over. Held at 95 rather than 100 because energisation authority is SDG&E's, not the City's: CVMC 15.29.020(F) says City approval 'does not authorize an applicant to connect ... to the local utility provider's electricity grid'.
department permit page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/build-green/residential-solar-energy
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both - Development Services permits, plan-checks and field-inspects the building/structural and the electrical work itself. Nothing is delegated to San Diego County. Fire code administration sits with the Chula Vista Fire Department (CVMC 15.36), but no separate residential-solar fire permit or fire fee is published.
Why the confidence is not higherThe Misc Item Permit Fee bulletin charges one 'Photovoltaic System' fee with intake + plan check + inspection components, all City; the PV Solar Permit Inspection Request lists only City ELEC inspections; the Fire Safety Engineering fee bulletin 15-200 contains no solar or ESS line item and the Fire Prevention page describes plan check for new construction and fire/life-safety systems. Held at 88 because the absence of a fire-side residential solar step is inferred from the fee bulletin and the Fire Prevention page rather than stated.
master fee schedule bulletin 10-400 (Sep 2024) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/2416/638638971096170000
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes - a building permit is required for a residential rooftop PV system
Why the confidence is not higherCVMC 15.06.080(A) requires a separate permit for building service equipment, and the PV exemption list in 15.06.080(B) does not include solar. Form 4613 states plainly 'If you install a photovoltaic power system, you must first obtain a building permit', and the solar page sets out two mandatory paths (SolarAPP+ expedited, or standard).
municipal code (CVMC 15.06.080) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.06
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined - one permit. The City issues a single Residential Solar permit (Form 4562C / Accela record type 'Residential Solar Energy' or 'Solar Permit with Solar App Plus') covering the electrical work; there is no separate electrical permit for the PV system. A main-panel upgrade taken with the PV work is a separate fee line ($203) on the same job, and requires an SDG&E work order.
Why the confidence is not higherFee bulletin 10-400 lists 'Photovoltaic System - Residential (SFD/Duplex)' as one line with its own intake/plan check/inspection fees plus a separate 'panel upgrade' line 'in conjunction with installation of new residential photovoltaic systems only'; Form 4562C is one application with Solar PV / +Battery / +Panel Upgrade checkboxes. Held at 85 because the City nowhere states in words that the electrical permit is subsumed - it is read off the fee structure and the single application form.
master fee schedule bulletin 10-400 (Sep 2024) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/2416/638638971096170000
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either - a California state-licensed contractor (who must also hold a valid City of Chula Vista business licence) or the property owner as owner-builder
Why the confidence is not higherApplication General Information: 'Property owners may obtain building permits and complete the work without need for a contractor ... A general contractor may also apply for and obtain a building permit on behalf of a property owner. All contractors must have a valid City of Chula Vista business license in order to perform work in the city.' Form 4562C has fields for both State Contractor's Licence and Chula Vista Business Licence #. No provision restricts the PV electrical permit to a C-10 electrician specifically.
department process page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/permit-information/permit-process/project-submittal-process/application-general-information
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes - a valid City of Chula Vista business licence is required to perform work in the city, and contractors using the online path must also be registered in the Accela Citizen Access portal
Why the confidence is not higherApplication General Information states the business licence requirement in terms ('All contractors must have a valid City of Chula Vista business license in order to perform work in the city') and, for the minor-permit self-issue path, 'Licensed contractors registered with Accela and the City of Chula Vista may pull a Minor Residential Permit'. Form 4562C has a mandatory 'Chula Vista Business License#' field. Held at 90 because the Accela registration wording is written about minor residential permits, not solar specifically.
department process page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/permit-information/permit-process/project-submittal-process/application-general-information
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes - owner-builder self-permit is expressly allowed; the owner must sign an owner-builder disclaimer certificate before issuance, and the solar page gives a property-owner submittal route (Building Permit Application + 2 sets of plans)
Why the confidence is not higherApplication General Information: owner-builder permits allowed where the improvement is not offered for sale within one year; 'the property owner must still sign an owner-builder disclaimer certificate before the permit is issued'. Form 4613 also requires an owner/builder verification form. The solar page splits its standard-permit instructions into 'If you are a property owner' and 'If you are a contractor'.
department process page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/permit-information/permit-process/project-submittal-process/application-general-information
Q8 What documents make up a complete submittal? Core Submittal package
Per Form 4562C (Residential Solar Application, Rev 10.23): (1) the completed signed application with site address, APN, building age / historic flag, owner, contractor, State licence and Chula Vista business licence; (2) two complete sets of fully dimensioned scaled plans; (3) one site/plot plan (NOT required for roof-mount residential); (4) a roof plan showing roof layout, PV panels, approximate roof access point location, code-compliant access pathways, PV system fire classification and the locations of all required labels and markings per the current California Residential and Fire Codes; (5) Historic Eligibility clearance if required; (6) SDG&E work order for an electric panel upgrade, if applicable; (7) manufacturer's specification sheets for system components and for roof-penetration waterproofing method and material; (8) project valuation. On the expedited path, instead: the SolarAPP+ unique ID plus the SolarAPP+ forms/plans packet, uploaded to Citizen Access.
Why the confidence is not higherRead directly off Form 4562C, which is the current form (Rev 10.23) linked from the solar page as 'Building Permit Application' and listed on the DSD Forms & Specifications page. The expedited list is from the solar page's SolarAPP+ steps. Note on staleness: the guide the City still links from its own solar page as 'Solar PV Systems' (Form 4613) tells applicants the current codes are the '2001 CBC and 2004 CEC', cites 'Article 690 of the 2004 California Electrical Code' and is issued by a 'Department of Planning & Building' that no longer exists; the Inspection Guide and Comprehensive Inspection Reference are Rev 05.15 and cite CRC R331 and CFC 605.11, numbering superseded twice over (R324/R327, now R329) . The adopting ordinances, by contrast, are current.
published application/checklist (Form 4562C, Rev 10.23) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10629/638330532029770000
Q9 How many copies, and in what format? Submittal package
Two complete sets of plans plus one plot plan and supporting documents - but submitted electronically. Since 13 December 2024 all new submittals go through Citizen Access / e-PlanSoft Electronic Plan Review as PDFs; plan-set sheet numbering must be bottom-right, 2-12 characters, and each file under 400MB.
Why the confidence is not higherForm 4562C (Rev 10.23) says 'Two complete sets of fully dimensioned and drawn to scale plans'. The EPR page states electronic acceptance began 13 Dec 2024 and gives the file/numbering rules. FLAG: the older Form 4613 still linked from the solar page as the 'Solar PV Systems' guide says 'You must submit three identical sets of plans' and 'provide three copies' - the two documents contradict each other and 4613 is the 2014 one.
published application/checklist + EPR page checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10629/638330532029770000
Q10 Is a site plan required, and what must it show? Core Submittal package
A site/plot plan is required EXCEPT for roof-mount residential, where Form 4562C expressly waives it. What is always required instead is a roof plan showing roof layout, PV panel layout, approximate location of the roof access point, location of code-compliant access pathways, PV system fire classification, and the locations of all required labels and markings per the current California Residential and Fire Codes. For a ground mount the plot plan is required and, per the older Form 4613, should show site address, responsible parties, scope, property lines and dimensions, adjacent streets, existing buildings, setback distances, location of existing electrical services and panels, and the location of all solar equipment.
Why the confidence is not higherForm 4562C submittal list, verbatim on the roof-mount exemption ('One Site plan / plot plan (Not required for roof-mount residential)'). The detailed plot-plan content list is from Form 4613 section IV.A, which is stale on codes but is the only published plot-plan content specification for solar. Note on staleness: the guide the City still links from its own solar page as 'Solar PV Systems' (Form 4613) tells applicants the current codes are the '2001 CBC and 2004 CEC', cites 'Article 690 of the 2004 California Electrical Code' and is issued by a 'Department of Planning & Building' that no longer exists; the Inspection Guide and Comprehensive Inspection Reference are Rev 05.15 and cite CRC R331 and CFC 605.11, numbering superseded twice over (R324/R327, now R329) . The adopting ordinances, by contrast, are current.
published application/checklist (Form 4562C, Rev 10.23) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10629/638330532029770000
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes - an electrical single-line diagram is required on the standard (non-SolarAPP+) path
Why the confidence is not higherForm 4613 section IV.E.3: 'Provide an electrical single line diagram showing the existing electrical service(s) and panels and any upgrades to the panel(s) ... Specify conductor size and insulation type, grounding, Ground-Fault Protection ..., disconnect location, amperage loading and a voltage description of all circuits.' Held at 70 because the CURRENT application form 4562C does not itself list a one-line, and the SolarAPP+ path substitutes the SolarAPP+ generated packet; and because the 4613 citation is to 'Sect. 690-5' of the 2004 CEC.
published checklist (Form 4613 - stale, cites 2001 CBC / 2004 CEC) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/942/635402010150330000
Q12 Are string and conductor calculations required? Drawings & calculations
Yes in substance - conductor sizing and overcurrent data must appear on the plans. Form 4613 requires conductor size and insulation type, grounding, ground-fault protection, disconnect location, amperage loading and a voltage description of all circuits, plus system ratings (operating current, voltage, maximum voltage, short-circuit current) and the number of modules in series and groups in parallel. On the SolarAPP+ path the string and conductor sizing is computed inside SolarAPP+ and printed on the approval/inspection checklist rather than submitted by the applicant.
Why the confidence is not higherForm 4613 sections IV.A.10 and IV.E; the Example SolarAPP+ Inspection Checklist prints minimum DC wire gauge, EGC size, OCPD rating, conduit-fill wire counts, so the calculation is embedded rather than submitted. Held at 70 because no document uses the phrase 'string calculations' and 4613 is a 2014 document.
published checklist (Form 4613 - stale) + SolarAPP+ example checklist checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/942/635402010150330000
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Not routinely. No stamp is called for on a flush, roof-plane-parallel residential array. Form 4613 requires structural calculations/analysis only where the modules are installed at an angle to the roof (the plane of the modules not parallel to the plane of the roof), and then 'Calculations must be stamped and signed by a California licensed engineer or architect.' Application General Information adds the general rule that 'A licensed California architect or engineer may be required to prepare plans.' No kW or square-foot threshold is published.
Why the confidence is not higherForm 4613 section IV.B.4 is the only published threshold and it is a geometry test, not a size test. FLAG: the same clause requires the attachment to resist '70 MPH wind speed per 2001 CBC chapter 16, Division III' - two code cycles of wind provisions out of date; the governing document is now ASCE 7-22 via the 2025 CBC/CRC. Held at 75 because the SolarAPP+ path applies its own structural screen instead.
published checklist (Form 4613 - stale, cites 2001 CBC) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/942/635402010150330000
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
None published. No City document requires an electrical PE stamp for a residential PV system at any threshold.
Why the confidence is not higherLooked in Form 4562C, Form 4613, the solar page, Application General Information ('A licensed California architect or engineer may be required to prepare plans' - generic, not electrical-specific), CVMC 15.06.085, 15.24 and 15.29 in full. The Form 4610 'Who May Prepare Plans & Incomplete Plans' that Form 4613 cites as its authority no longer exists on the DSD Forms & Specifications page (147 forms listed, no 4610) - a dead cross-reference. Recorded as an absence with the places looked, not as 'did not look'.
department forms index + checklists (absence) checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/resources/dsdformsspecifications
Q15 What does a residential solar permit cost? Core Fees
$453 total on the SolarAPP+ expedited path ($30 intake + $0 plan check + $423 inspection); $722 total on the standard path ($70 intake + $158 plan check + $494 inspection). A main-panel upgrade taken with the PV is a further $203 ($0 + $62 + $141). Commercial or multifamily is $1,683 for the first 500 panels.
Why the confidence is not higherMaster Fee Schedule Fee Bulletin 10-400 'Miscellaneous Item Permit Fees', September 2024, 'Photovoltaic System' section, with footnotes tying 'expedited' and 'traditional' to CVMC 15.29.020. WORTH FLAGGING: Gov. Code 66015 caps a residential PV permit fee at $450 plus $15/kW above 15 kW absent a written finding. The expedited fee is $3 over that cap and the standard fee is $272 over it; the City publishes no supporting written cost finding alongside the bulletin.
master fee schedule bulletin 10-400 (Sep 2024) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/2416/638638971096170000
Q16 How is the fee calculated? Core Fees
Flat per system, in two tiers by processing path (expedited vs traditional), built up from three flat components: intake fee + plan check fee + inspection fee. Not valuation-based and not per-kW for residential. Commercial/multifamily is tiered per 500 panels.
Why the confidence is not higherFee bulletin 10-400 presents each PV line as a fixed dollar amount in Intake / Plan Check / Inspection / Total columns, per 'each'. Form 4562C asks for a Project Valuation Cost, but the misc-item fee is not derived from it; the valuation drives only the State SMIP and SB 1473 surcharges per bulletin 10-100 'Determination of Value'. FLAG: Form 4613 still tells applicants 'The plan check fees you must pay are based on the construction valuation established by the Building Division', which for solar is wrong now and would be unlawful under Gov. Code 65850.55.
master fee schedule bulletin 10-400 (Sep 2024) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/2416/638638971096170000
Q17 Is there a separate plan-check fee? Fees
Yes on the standard path ($158), no on the SolarAPP+ path ($0)
Why the confidence is not higherFee bulletin 10-400 shows a separate Plan Check Fee column: $158 for 'Residential (SFD/Duplex), traditional' and $0 for 'Residential (SFD/Duplex), expedited'. CVMC 15.06.095(C) confirms plan review fees are separate from and in addition to permit fees.
master fee schedule bulletin 10-400 (Sep 2024) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/2416/638638971096170000
Q18 What is the stated plan-review turnaround? Core Timeline & validity
10 business days for the first review of a Residential Solar Energy project; 5 business days for a recheck; 10 business days for a plan change. On the SolarAPP+ path review is instant - the approval is generated by SolarAPP+ and the Citizen Access submittal returns an approved permit number.
Why the confidence is not higherThe Plan Check Goals table on Application General Information, expressed in business days excluding weekends and City holidays, with 'Residential Solar Energy' on the 10/5/10 row. The page calls them 'general timeframes', not a guarantee, and California sets no statutory review deadline for solar. The instant path is from the solar page: 'Once you submit you will receive an approved permit number for your project.'
department process page (plan check goals table) checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/permit-information/permit-process/project-submittal-process/application-general-information
Q19 How long is an issued permit valid before it expires? Timeline & validity
365 days to start work: a permit expires if work is not commenced within 12 months of issue, or if work is suspended or abandoned for 180 days after commencement. Extensions of up to 180 days each may be granted by the Building Official on written request. Separately, an application on which no permit issues within 12 months expires.
Why the confidence is not higherCVMC 15.06.090(D) verbatim, as amended by Ord. 3603 (2025); plan-review expiry is CVMC 15.06.085(C).
municipal code (CVMC 15.06.090(D)) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.06

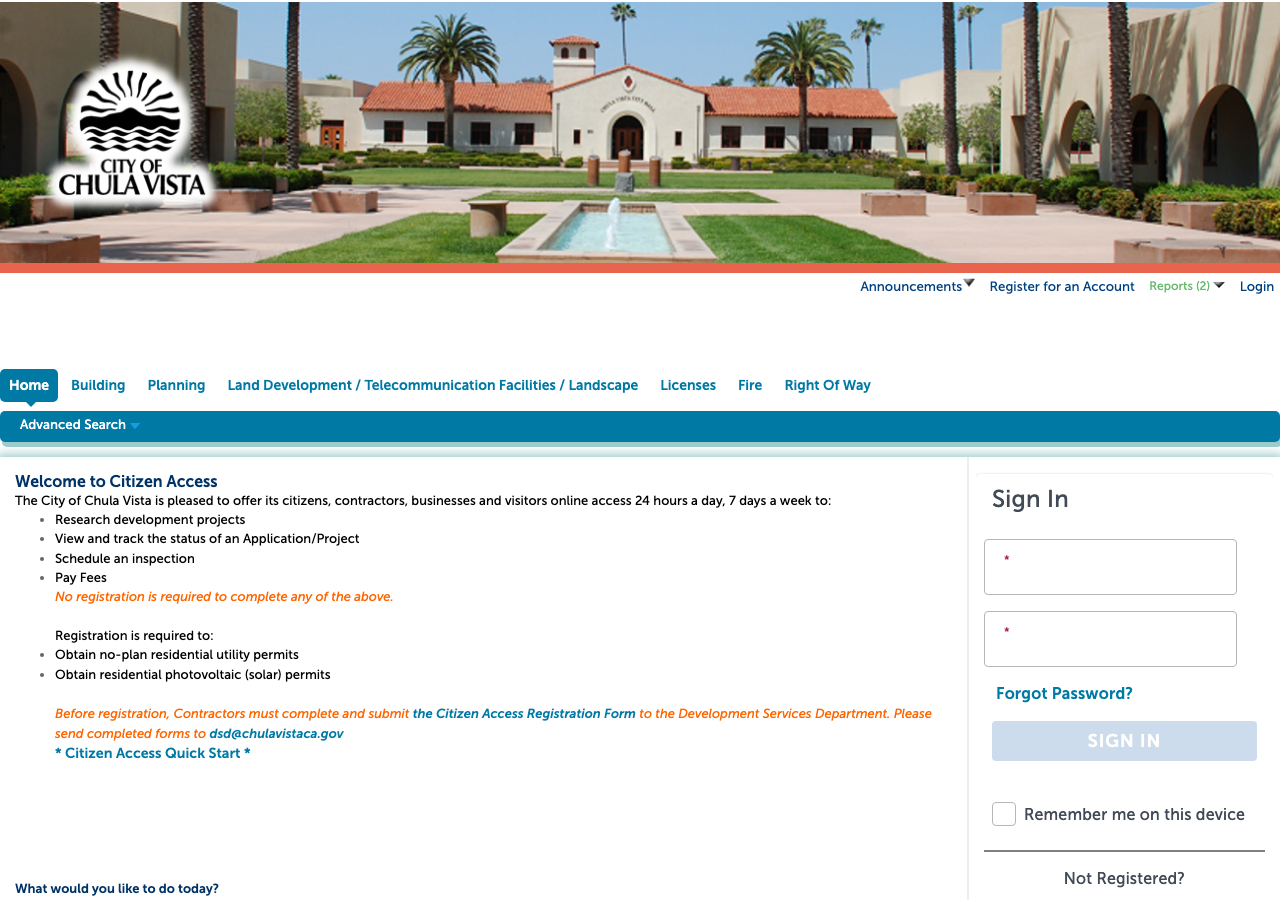

Q20 Which permit portal does this authority use? Core Portal & process
Accela Citizen Access at permits.chulavistaca.gov/citizenaccess/chulavista.aspx (older City documents give the same portal as pip.chulavistaca.gov) for application, fees, inspection booking and results; e-PlanSoft Electronic Plan Review behind it for plan review and corrections since 13 Dec 2024; and NREL SolarAPP+ (gosolarapp.org) as the mandatory front end for expedited solar permits since 28 June 2023.
Why the confidence is not higherThe solar page names all three and gives the Citizen Access click path ('Building' tab > Create an Application > 'Solar Permit with Solar App Plus' or 'Residential Solar Energy - Citizen Access'); the EPR page names e-PlanSoft and the 13 Dec 2024 cutover. Note the two portal hostnames appear across City documents - the 2025 Inspection Card says permits.chulavistaca.gov while the 2015 PV inspection sheet and 2015 inspection card say pip.chulavistaca.gov.
department permit page + portal landing checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/build-green/residential-solar-energy
Q21 Can the whole application be completed online? Core Portal & process
Yes. Application, fee payment, plan upload, corrections and resubmittal, inspection booking and results are all online; SolarAPP+ permits are issued instantly on submission of the SolarAPP+ ID and packet. In-person submittal at the Development Services counter, 276 Fourth Avenue Building B, remains available as an alternative.
Why the confidence is not higherSolar page (both online paths, plus 'In-person submittals may be made at the Development Services Permit Counter'); Project Submittal Process page directs all submittals on or after 13 Dec 2024 to the electronic process; Permit Fee Costs page describes online credit-card payment; Schedule an Inspection page covers online booking and results.
department permit page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/build-green/residential-solar-energy
Q22 Which utility handles interconnection here? Core Utility interconnection
San Diego Gas & Electric (SDG&E). San Diego Community Power is the Community Choice Aggregator serving Chula Vista, but it supplies generation and billing only and does NOT run interconnection.
Why the confidence is not higherSDG&E's Customer Generation page states that residential rooftop solar, solar+storage and stand-alone storage under the Solar Billing Plan 'interconnection is made to SDG&E using the online interconnection portal', and that SDG&E issues PTO. San Diego Community Power's own Solar & Storage 101 page says 'SDG&E will provide “Permission to Operate,” or PTO' and 'After your solar system is installed and your interconnection application is approved, SDG&E will interconnect your system'; its Who We Serve page lists Chula Vista among its member communities. City-side, Form 4562C and Application General Information both require an SDG&E work order / disconnect letter, naming no other utility.
utility interconnection page + CCA page + city application form checked 2026-08-28 https://www.sdge.com/more-information/customer-generation
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel, with a hard dependency at the end. The SDG&E interconnection application is filed by the contractor separately from and alongside the City permit; the City permit does not authorise energisation; SDG&E issues Permission to Operate after the installation is complete and the AHJ inspection has passed. One SDG&E step can precede the permit: a work order is needed for an electric panel upgrade and must be submitted with Form 4562C.
Why the confidence is not higherCVMC 15.29.020(F): City approval 'does not authorize an applicant to connect the small residential rooftop energy system to the local utility provider's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility provider.' SDCP's Solar & Storage 101 sequences it: contractor submits permit and interconnection application, city/county inspects and permits, then SDG&E provides PTO. Form 4562C requires the SDG&E work order at submittal for panel upgrades, and the solar page requires the SDG&E work order on site at inspection. Held at 85 because no single City or SDG&E document draws the whole sequence in one place.
municipal code (CVMC 15.29.020(F)) + CCA process page checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.29
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No. No City document conditions a solar permit on HOA or architectural approval, and CVMC 15.29 makes the expedited path administrative and non-discretionary.
Why the confidence is not higherCVMC 15.29.020(C)-(F) gives the Building Official administrative approval authority with no third-party approval step; Civil Code 714, referenced in the CVMC 15.29.010 definitions, restricts HOA restrictions on solar. Searched the Municipal Code for 'homeowners association' and reviewed CVMC 15.29 and Form 4562C in full - no HOA condition appears. Recorded as a proved absence.
municipal code (absence) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.29
Q25 Is there a historic-district review? Overlays & special cases
Yes, conditionally - and it is a gate that runs BEFORE the solar permit application. The applicant must check whether the structure is a designated or eligible historic resource using the City's Historic Home Finder GIS (gis.chulavistaca.gov/histhomefinder) by APN or address. If it is designated or eligible for designation, Historic Eligibility Clearance must be obtained before applying, and the work must conform to the Secretary of the Interior's Standards for Rehabilitation, 'Incorporating Solar Panels in a Rehabilitation Project'. Form 4562C asks up front 'Is building greater than 45 years old?' and 'Historic Yes/No', and lists 'Historic Eligibility clearance, if required' as a submittal item.
Why the confidence is not higherThe 'Determining Historic Significance' section of the City's Residential Solar Energy Permits page, plus the historic fields and submittal line on Form 4562C. The City also runs 'a design and historic preservation review, depending on where the project is located' per Application General Information.
department permit page + application form checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/build-green/residential-solar-energy
Q26 Is a wind or windstorm certification required? Overlays & special cases
No. Chula Vista publishes no wind or windstorm certification requirement - that is a Gulf-coast construct with no California analogue. Wind is handled as ordinary structural design under the 2025 CBC/CRC (ASCE 7).
Why the confidence is not higherSearched CVMC Title 15 chapters 15.06, 15.08, 15.09, 15.24, 15.36 and the Municipal Code search index; the only wind provisions found are in Form 4613's stale attachment clause ('must resist 70 MPH wind speed per 2001 CBC chapter 16, Division III'), which is a design criterion on the plans, not a third-party certification. Recorded as a proved absence.
municipal code (absence) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.08
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Only in the exception case, and never by Council. Under CVMC 15.29.050 the Building Official may require a use permit if he makes a finding based on substantial evidence that the project could have a specific, adverse impact on public health and safety; under 15.29.060 the City may deny on written findings of an unmitigable specific adverse impact. Decisions of the Building Official are appealable to the Planning Commission. Zoning does not add a step: CVMC 19.58.142(F) provides that a 'residential-level facility' - an electrical generating facility serving an individual private dwelling - is 'subject to and governed by CVMC Title 15', i.e. the building code, while the CUP requirement in 19.58.142 applies to the other electrical-generating-facility sub-types.
Why the confidence is not higherCVMC 15.29.050, 15.29.060 and 15.29.020(C); CVMC 19.58.142 opening paragraph and subsection (F) (Ord. 3544, 2023); definition of 'residential-level facility' at CVMC 19.04.002.
municipal code (CVMC 15.29.050 / 19.58.142(F)) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.29
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No cap on residential generation. The only kW figure in the code is an ELIGIBILITY threshold, not a limit: CVMC 15.29.010 defines a 'small residential rooftop solar energy system' as no larger than 10 kW AC nameplate (or 30 kW thermal), on a single- or duplex-family dwelling, not exceeding the maximum legal building height. Above 10 kW AC the system is simply permitted on the standard path at the higher fee, not refused. The zoning definition of 'residential-level facility' (CVMC 19.04.002) carries no size figure.
Why the confidence is not higherCVMC 15.29.010 verbatim; fee bulletin 10-400 footnotes 4 and 5 confirm the 10 kW test only selects between the 'expedited' and 'traditional' fee lines. CVMC 19.04.002 definition 5 read in full - function-based, no kW.
municipal code (CVMC 15.29.010) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.29
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 95% · adopting ordinance (CVMC 15.24.010, Ord. 3610, 2025)
- Which building code edition is in force? 2025 California Building Code (Title 24 Part 2, including Appendices I and Q) and 2025 California Residential Code (Title 24 Part 2.5, including Appendices BB, BF, BJ, CI and CJ), both excluding Chapter 1 Division II 95% · adopting ordinance (CVMC 15.08.010 / 15.09.010, Ords. 3604 & 3605, 2025)
- Which fire code edition is in force? 2025 California Fire Code, including Appendix Chapters 4, B, BB, C, CC, H and P and the California Standards, with local amendments 95% · adopting ordinance (CVMC 15.36.005/.065, Ord. 3613, 2025)
- Are there local amendments to any of the above? Yes, but none of them bite on residential rooftop PV. Building: CVMC 15.08.020 adds Exception 7 to CBC 705.12 (R-to-office conversions) and 15.08.030 adds CBC 1511.6.4 requiring rooftop equipment to be screened from view - with an express 'Exception: Solar collectors.' Electrical: CVMC 15.24.035 (no reuse of previously used materials without Building Official approval), 15.24.045 (separate distribution panels per dwelling), 15.24.050 (circuit card posted before rough inspection), 15.24.055 (electric fences prohibited), 15.24.060 (amends CEC 408.3(E)(1) phase arrangement). Residential Code: no amendments at all. Fire: amendments to CFC Chapters 1, 2, 5, 9, 56 and the appendices - none to Chapter 12 Energy Systems. Separately, CVMC 20.04.040 requires PV pre-wiring conduit in all NEW residential units and 20.04.030 solar water-heater pre-plumbing, both gates on issuing the building permit for the new dwelling, not on a retrofit PV permit. Note also that the two former solar-specific electrical amendments are gone: CVMC 15.24.065 (PV pre-wiring) was repealed by Ord. 3473 in 2019 and 15.24.070 (small residential rooftop solar) by Ord. 3373 in 2016. 90% · municipal code (multiple chapters)
- What is the installation judged against? The 2025 California Electrical Code (Title 24 Part 3 = 2023 NEC), including Articles 690 and 705 unamended by the State, plus the five Chula Vista electrical amendments at CVMC 15.24.035, .045, .050, .055 and .060, and the administrative provisions of CVMC 15.06. In the field the inspector works to the approved plans plus, on the expedited path, the SolarAPP+ approval/inspection checklist. 88% · adopting ordinance + inspection references
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? State code as written, unamended: 2025 CFC Chapter 12 (CFC 1205) and 2025 CRC R329 govern ridge setbacks and access pathways, because CVMC 15.36.065 adopts CFC Chapter 12 with no amendment and CVMC 15.09 adopts the CRC with no amendments at all. The City's own compliance mechanism is on the plans: Form 4562C requires the roof plan to show 'approximate location of roof access point, location of code-compliant access pathways, PV system fire classification and the locations of all required labels and markings as required by the current California Residential and Fire Codes'. FLAG: the City's Comprehensive Inspection Reference still tells inspectors to check pathways against 'CFC 605.11.3.1 - 605.11.3.3.3, CRC R331.4.1 through R331.4.2.4' and the SolarAPP+ example checklist against '2018 International Residential Code [IRC 324.6]' - all dead numbering. An installer following the City's PDFs would be building to the wrong edition of the pathway rules. 85% · adopting ordinance + application form
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes - rapid shutdown to NEC 690.12 as adopted in the 2025 CEC (2023 NEC), with no California or Chula Vista amendment. In the field the City checks for a rapid shutdown initiation device at a readily accessible location outside the building, its labelling, and the service-disconnect rapid shutdown placard. FLAG: the City's Example SolarAPP+ Inspection Checklist is a 2023 document generated against NEC 2017 and cites 690.12(C) and 690.56(C); the live SolarAPP+ output for a permit pulled today will be against the currently adopted edition. 85% · adopting ordinance + SolarAPP+ example checklist (2023, NEC 2017)
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Three groups. (1) The City's OWN 'Solar Placard' form - a directional site-plan placard at the service equipment showing the building, the PV array on roof, inverter location, PV system disconnect, service point and utility metering, storage batteries in garage (or identified room), stationary engine generator, and any remote wind/PV array, headed 'CAUTION - Power to this building is also supplied from the following sources with disconnects located as shown'. (2) The 'WARNING: PHOTOVOLTAIC POWER SOURCE' marking adjacent to the main service disconnect and repeated on all DC conduit, raceways, cable assemblies, junction/combiner boxes and disconnects. (3) On the SolarAPP+ path, the SolarAPP+ Fire Bulletin set: the rapid-shutdown placard at the service disconnect ('SOLAR PV SYSTEM IS EQUIPPED WITH RAPID SHUTDOWN / TURN RAPID SHUTDOWN SWITCH TO THE "OFF" POSITION TO SHUT DOWN CONDUCTORS OUTSIDE THE ARRAY. CONDUCTORS IN ARRAY REMAIN ENERGIZED IN SUNLIGHT.') with a simple diagram, 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM' at the initiation device, and at the point of interconnection 'WARNING: EQUIPMENT FED BY MULTIPLE SOURCES LOCATION OF DISCONNECTING MEANS' and 'WARNING: DUAL POWER SOURCE SECOND SOURCE IS PV SYSTEM'. Plus the module/system rating labels of CEC 690.51/690.53. 88% · city placard form + inspection reference
- Does the authority specify placard wording of its own? Yes - twice over. The City's Solar Placard form fixes its own heading wording, 'CAUTION - Power to this building is also supplied from the following sources with disconnects located as shown', and its own note text 'PV disconnecting means shall be installed at a readily accessible location either outside of a building or structure or inside nearest the point of entrance of the system conductors per the requirements of article 690.14(c)'. The older Form 4613 additionally prescribes three exact legends: adjacent to the main electrical service, 'This electrical service is also served by a photovoltaic (solar) power system, 1 of 2 Disconnects'; at the main electrical service photovoltaic disconnect, 'Photovoltaic Disconnect Means, 2 of 2 Disconnects'; and where terminals may be energised in the open position, 'Warning-Electrical shock hazard - Terminals on both lines and load sides may be energized in the open position. Dual Power Supply-Photovoltaic System.' 85% · city placard form (2017) + Form 4613 (2014)
- Does it specify letter height, colour or material? Yes, on both. The City's Solar Placard form dimensions its own artwork: 3/4 inch minimum for the 'CAUTION' header, 1/4 inch minimum for the body text, 1/8 inch minimum for the equipment call-out labels. For the photovoltaic warning marking the Comprehensive Inspection Reference specifies 3/8 inch (9.5 mm) minimum white letters on a red background, on reflective weather-resistant material, and requires that 'Required labels shall be permanent and suitable for the environment.' 88% · city placard form + inspection reference
- Is a site plan / facility map placard required, and what must it show? Yes - and this is the strongest single artefact Chula Vista publishes. The 'Solar Placard' form IS a site-plan / facility-map placard template. It must show, in plan and oriented to the viewer: the building outline, the solar photovoltaic array on roof, the inverter location, the PV system disconnect, the service point and utility metering, storage batteries in garage (or the identified room), any stationary engine generator, any wind turbine or remote solar PV array 'per zoning requirements', and the site fences. The note is explicit on orientation: 'Directional Placard shall be oriented relative to where an individual will be standing looking at the placard. Meter panel to be at the bottom of placard when oriented correctly. Also identify any associated equipment.' 90% · city placard form
- Does the UTILITY specify placards beyond the AHJ's? Nothing extra for a normal residential rooftop system. SDG&E's published Electric Distribution System Interconnection Handbook requires, where an isolating device is required by SDG&E's operating practices, that the device 'include markings or signage that clearly indicates open and closed positions', that it be 'clearly marked on the submitted single line diagram', and that 'if the device is not adjacent to the PCC, permanent signage must be installed at an SDG&E approved location providing a clear description of the location of the device'. That handbook expressly exempts generating facilities with non-islanding inverters totalling 1 kVA or less, and is written for Rule 21 generating facilities generally rather than for residential Solar Billing Plan rooftops. No SDG&E residential-specific placard set beyond the AHJ's was found. 60% · utility interconnection handbook (2015)
- Where must the labels be placed? Per the City's own documents: the CAUTION site-plan placard goes at the service equipment (oriented with the meter panel at the bottom); the 'WARNING: PHOTOVOLTAIC POWER SOURCE' marking goes adjacent to the main service disconnect, in a location clearly visible from where the disconnect is operated; conduit, raceway and cable-assembly markings go every 10 feet, within one foot of all turns or bends, and within one foot above and below all penetrations of roof/ceiling assemblies, walls and barriers; all interior and exterior DC conduit, enclosures, raceways, cable assemblies, junction boxes, combiner boxes and disconnects must be marked; where PV circuits are embedded in built-up, laminate or membrane roofing in areas not covered by modules, the circuit location must be clearly marked. On the SolarAPP+ path: the rapid-shutdown placard no more than 3 ft (1 m) from the service disconnecting means, and the 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM' label at the initiation device and no more than 3 ft from the switch. 88% · inspection reference + placard form + SolarAPP+ checklist
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? No published distance from the meter, by either party. SDG&E's Interconnection Handbook requires, where its operating practices call for one, a ganged manually-operated isolating switch 'near the Point of Interconnection', capable of visible verification of separation, lockable in the open position, marked for open/closed, reachable quickly and conveniently 24 hours a day by SDG&E personnel without obstacles, keys, special permission or security clearances, and with its type and location approved by SDG&E prior to installation - with permanent signage giving its location if it is not adjacent to the PCC. Facilities with non-islanding inverters totalling 1 kVA or less are exempt. Chula Vista adds nothing: its Comprehensive Inspection Reference simply says DC disconnects are 'located as allowed by the AHJ' and that disconnects must be 'according to the approved plan and properly located as required by the CEC', and the City's Solar Placard note repeats CEC 690.14(C) - readily accessible, outside the building or inside nearest the point of entrance of the system conductors. 55% · utility interconnection handbook (2015) + city inspection reference
- Must equipment be on a specific approved list? No specific City approved list. Equipment must be listed and labelled to the standards the code names and installed per the listing: modules to UL 1703 (and, current-code, UL 61730), inverters to UL 1741 and marked 'utility interactive', combiner boxes to UL 1741, DC-rated overcurrent devices, hazard control systems to UL 3741. Form 4562C requires manufacturer's specification sheets for all proposed components; Form 4613 requires the spec sheets to 'indicate the listing agency'. CVMC 15.06.015 defines 'listed' by reference to an approved testing laboratory, and CVMC 15.24.035 bars reuse of previously used materials without the Building Official's approval. 85% · inspection reference + application form + municipal code
- Are batteries permitted, and under what conditions? Yes, permitted, on the same residential solar permit. Form 4562C offers 'Solar Photovoltaic + Battery Storage System' and 'Solar Photovoltaic + Electric Panel Upgrade + Battery Storage System' as system types. The technical conditions are the State's, unamended: CVMC 15.36.065 adopts CFC Chapter 12 'Energy Systems' with no local amendment, so CFC 1207 governs, and CVMC 15.09 adopts the 2025 CRC with no amendments, so CRC R330 governs a one- or two-family dwelling. The City's Solar Placard form expects the placard to identify 'Storage batteries in garage (or identify room)', which is how location is recorded. 85% · application form + adopting ordinances
- Is there a separate ESS permit or inspection? No. Battery storage installed with PV is a system-type checkbox on the same Residential Solar Application (Form 4562C), the fee schedule has no ESS line, and the Chula Vista Fire Department publishes no residential ESS permit or fee - Fee Bulletin 15-200 (Fire Safety Engineering) contains no solar, photovoltaic, energy-storage or battery item. Inspection is folded into the same PV inspection. 75% · fee schedule bulletins + application form (absence)
- Is a ground mount treated as a structure? Yes, in effect. A ground mount is one of the two 'Type of Installation' options on Form 4562C and takes the same City building permit, but it loses the roof-mount exemption from the site/plot plan requirement, so a scaled plot plan showing property lines, setbacks, adjacent streets and equipment locations must be submitted and the structure is sited against the zone's development standards. Zoning does not add a discretionary layer: CVMC 19.58.142(F) makes a residential-level electrical generating facility 'subject to and governed by CVMC Title 15'. 60% · application form + municipal code (inferred)
- Is there a local rule on service upgrades or busbar sizing? No local busbar rule. Interconnection sizing is plain CEC 705.12 (the SolarAPP+ checklist applies the 120% rule and the centre-fed-panel rule, and requires backfed breakers at the opposite end of the bus). What IS local: CVMC 15.24.045 requires each dwelling to have its own lighting and power distribution panels not serving other portions of the building; CVMC 15.24.050 requires a completed circuit card posted at the service equipment before rough inspection; and a service/panel upgrade taken with the PV needs an SDG&E work order submitted with Form 4562C and is charged as a separate $203 fee line (other panel upgrades go to fee bulletin 10-200, 'Upgrade Existing Electrical Service'). 85% · municipal code + fee bulletin + application form
- Is a specific mounting system or attachment spacing required? No City-specified mounting system or attachment spacing. Attachment is by manufacturer's listed instructions and the approved plans. The only published City text is Form 4613, which requires the plans to show 'Details for the assembly of the modules and for the connection of the modules to roof members. Indicate type, size and spacing of fasteners' and weather sealing of roof penetrations - but it sets the design criterion as resisting '70 MPH wind speed per 2001 CBC chapter 16, Division III', which is superseded. Form 4562C requires manufacturer's spec sheets for roof-penetration waterproofing method and material. 75% · published checklist (Form 4613 - stale) + application form
20 questions answered against City of Chula Vista’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023
Why the confidence is not higherCVMC 15.24.010 adopts the California Electrical Code, 2025 Edition (Title 24 Part 3) by reference, per Ord. 3610 (2025). The 2025 CEC is the 2023 NEC with California amendments, and NEC Article 690 is adopted with no California amendment. This is a CURRENT adoption - contrast the City's own handouts, which still cite the 2004 CEC (Form 4613) and 2011/2013-era CEC section numbers (Comprehensive Inspection Reference, Rev 05.15).
adopting ordinance (CVMC 15.24.010, Ord. 3610, 2025) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.24
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (Title 24 Part 2, including Appendices I and Q) and 2025 California Residential Code (Title 24 Part 2.5, including Appendices BB, BF, BJ, CI and CJ), both excluding Chapter 1 Division II
Why the confidence is not higherCVMC 15.08.010 (Ord. 3604, 2025) and CVMC 15.09.010 (Ord. 3605, 2025). For a one- or two-family dwelling the CRC governs, so rooftop PV falls under CRC R329 and ESS under CRC R330 in the 2025 renumbering - not the R324/R328 that the City's own handouts and the SolarAPP+ example checklist still cite.
adopting ordinance (CVMC 15.08.010 / 15.09.010, Ords. 3604 & 3605, 2025) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.08
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code, including Appendix Chapters 4, B, BB, C, CC, H and P and the California Standards, with local amendments
Why the confidence is not higherCVMC 15.36.005 (Ord. 3613, 2025). Crucially for solar, CVMC 15.36.065 adopts CFC Chapter 12 'Energy Systems' with NO amendment, so CFC 1205 (solar photovoltaic) and CFC 1207 (ESS) apply exactly as the State wrote them. Handouts still cite CFC 605.11 (two cycles dead) and the SolarAPP+ example checklist cites the 2018 IRC.
adopting ordinance (CVMC 15.36.005/.065, Ord. 3613, 2025) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.36
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes, but none of them bite on residential rooftop PV. Building: CVMC 15.08.020 adds Exception 7 to CBC 705.12 (R-to-office conversions) and 15.08.030 adds CBC 1511.6.4 requiring rooftop equipment to be screened from view - with an express 'Exception: Solar collectors.' Electrical: CVMC 15.24.035 (no reuse of previously used materials without Building Official approval), 15.24.045 (separate distribution panels per dwelling), 15.24.050 (circuit card posted before rough inspection), 15.24.055 (electric fences prohibited), 15.24.060 (amends CEC 408.3(E)(1) phase arrangement). Residential Code: no amendments at all. Fire: amendments to CFC Chapters 1, 2, 5, 9, 56 and the appendices - none to Chapter 12 Energy Systems. Separately, CVMC 20.04.040 requires PV pre-wiring conduit in all NEW residential units and 20.04.030 solar water-heater pre-plumbing, both gates on issuing the building permit for the new dwelling, not on a retrofit PV permit. Note also that the two former solar-specific electrical amendments are gone: CVMC 15.24.065 (PV pre-wiring) was repealed by Ord. 3473 in 2019 and 15.24.070 (small residential rooftop solar) by Ord. 3373 in 2016.
Why the confidence is not higherRead CVMC 15.08, 15.09, 15.24, 15.26 and 15.36 in full and searched the Municipal Code for 'solar' (27 hits, all reviewed), 'photovoltaic' (5 hits) and 'energy storage'; control searches passed in the same session - 'zzqqx' returned 'did not match anything' and 'solar' returned 27 real hits. Also consistent with AB 130 (Stats. 2025 Ch. 22), which bars new more-restrictive residential local standards from 1 Oct 2025.
municipal code (multiple chapters) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.24
Q33 What is the installation judged against? Core Electrical
The 2025 California Electrical Code (Title 24 Part 3 = 2023 NEC), including Articles 690 and 705 unamended by the State, plus the five Chula Vista electrical amendments at CVMC 15.24.035, .045, .050, .055 and .060, and the administrative provisions of CVMC 15.06. In the field the inspector works to the approved plans plus, on the expedited path, the SolarAPP+ approval/inspection checklist.
Why the confidence is not higherCVMC 15.24.010 and the amendment sections; the City's Inspection Guide and Comprehensive Inspection Reference show the item-by-item field method ('according to the approved plan' repeatedly), and the solar page says the inspector 'will verify that the installation is in substantial conformance with applicable code requirements and with the approved plans'. Held at 88 because the two inspection references are Rev 05.15 and their CEC/CFC/CRC citations are superseded even though the substance largely survives.
adopting ordinance + inspection references checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.24
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No local busbar rule. Interconnection sizing is plain CEC 705.12 (the SolarAPP+ checklist applies the 120% rule and the centre-fed-panel rule, and requires backfed breakers at the opposite end of the bus). What IS local: CVMC 15.24.045 requires each dwelling to have its own lighting and power distribution panels not serving other portions of the building; CVMC 15.24.050 requires a completed circuit card posted at the service equipment before rough inspection; and a service/panel upgrade taken with the PV needs an SDG&E work order submitted with Form 4562C and is charged as a separate $203 fee line (other panel upgrades go to fee bulletin 10-200, 'Upgrade Existing Electrical Service').
Why the confidence is not higherCVMC 15.24.045 and .050; fee bulletin 10-400 footnote 6; Form 4562C submittal item 'SDG&E Work Order for electric panel upgrade, if applicable'; SolarAPP+ example checklist 'Interconnection at Main Service Panel' section. The Comprehensive Inspection Reference item 41 restates the opposite-end-of-bus rule.
municipal code + fee bulletin + application form checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.24
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
No City-specified mounting system or attachment spacing. Attachment is by manufacturer's listed instructions and the approved plans. The only published City text is Form 4613, which requires the plans to show 'Details for the assembly of the modules and for the connection of the modules to roof members. Indicate type, size and spacing of fasteners' and weather sealing of roof penetrations - but it sets the design criterion as resisting '70 MPH wind speed per 2001 CBC chapter 16, Division III', which is superseded. Form 4562C requires manufacturer's spec sheets for roof-penetration waterproofing method and material.
Why the confidence is not higherForm 4613 section IV.B; Form 4562C submittal list; Comprehensive Inspection Reference items 3 and 4 ('Modules are attached to the mounting structure according to the manufacturer's instructions and the approved plans'). Searched CVMC 15.08 and 15.09 for mounting amendments - none. Note on staleness: the guide the City still links from its own solar page as 'Solar PV Systems' (Form 4613) tells applicants the current codes are the '2001 CBC and 2004 CEC', cites 'Article 690 of the 2004 California Electrical Code' and is issued by a 'Department of Planning & Building' that no longer exists; the Inspection Guide and Comprehensive Inspection Reference are Rev 05.15 and cite CRC R331 and CFC 605.11, numbering superseded twice over (R324/R327, now R329) . The adopting ordinances, by contrast, are current.
published checklist (Form 4613 - stale) + application form checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/942/635402010150330000
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
State code as written, unamended: 2025 CFC Chapter 12 (CFC 1205) and 2025 CRC R329 govern ridge setbacks and access pathways, because CVMC 15.36.065 adopts CFC Chapter 12 with no amendment and CVMC 15.09 adopts the CRC with no amendments at all. The City's own compliance mechanism is on the plans: Form 4562C requires the roof plan to show 'approximate location of roof access point, location of code-compliant access pathways, PV system fire classification and the locations of all required labels and markings as required by the current California Residential and Fire Codes'. FLAG: the City's Comprehensive Inspection Reference still tells inspectors to check pathways against 'CFC 605.11.3.1 - 605.11.3.3.3, CRC R331.4.1 through R331.4.2.4' and the SolarAPP+ example checklist against '2018 International Residential Code [IRC 324.6]' - all dead numbering. An installer following the City's PDFs would be building to the wrong edition of the pathway rules.
Why the confidence is not higherCVMC 15.36.065 and 15.09.010; Form 4562C roof-plan requirement; Comprehensive Inspection Reference item 6; SolarAPP+ example checklist 'Roof Access, Egress, and Ventilation'. Held at 85 because the City publishes no setback dimensions of its own - the answer is the state numbers, which this survey's California baseline already establishes.
adopting ordinance + application form checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.36
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes - rapid shutdown to NEC 690.12 as adopted in the 2025 CEC (2023 NEC), with no California or Chula Vista amendment. In the field the City checks for a rapid shutdown initiation device at a readily accessible location outside the building, its labelling, and the service-disconnect rapid shutdown placard. FLAG: the City's Example SolarAPP+ Inspection Checklist is a 2023 document generated against NEC 2017 and cites 690.12(C) and 690.56(C); the live SolarAPP+ output for a permit pulled today will be against the currently adopted edition.
Why the confidence is not higherCVMC 15.24.010 (2025 CEC adopted, Ord. 3610, 2025); the Example SolarAPP+ Inspection Checklist items 'Presence of Rapid Shutdown switch label per Fire Bulletin', 'Method of rapid shutdown compliance', and 'A Rapid Shutdown switch shall be provided at a readily accessible location outside the building in accordance with the 2017 National Electrical Code [690.12(C)]'.
adopting ordinance + SolarAPP+ example checklist (2023, NEC 2017) checked 2026-08-28 https://chulavista.municipal.codes/CVMC/15.24
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Three groups. (1) The City's OWN 'Solar Placard' form - a directional site-plan placard at the service equipment showing the building, the PV array on roof, inverter location, PV system disconnect, service point and utility metering, storage batteries in garage (or identified room), stationary engine generator, and any remote wind/PV array, headed 'CAUTION - Power to this building is also supplied from the following sources with disconnects located as shown'. (2) The 'WARNING: PHOTOVOLTAIC POWER SOURCE' marking adjacent to the main service disconnect and repeated on all DC conduit, raceways, cable assemblies, junction/combiner boxes and disconnects. (3) On the SolarAPP+ path, the SolarAPP+ Fire Bulletin set: the rapid-shutdown placard at the service disconnect ('SOLAR PV SYSTEM IS EQUIPPED WITH RAPID SHUTDOWN / TURN RAPID SHUTDOWN SWITCH TO THE "OFF" POSITION TO SHUT DOWN CONDUCTORS OUTSIDE THE ARRAY. CONDUCTORS IN ARRAY REMAIN ENERGIZED IN SUNLIGHT.') with a simple diagram, 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM' at the initiation device, and at the point of interconnection 'WARNING: EQUIPMENT FED BY MULTIPLE SOURCES LOCATION OF DISCONNECTING MEANS' and 'WARNING: DUAL POWER SOURCE SECOND SOURCE IS PV SYSTEM'. Plus the module/system rating labels of CEC 690.51/690.53.
Why the confidence is not higherThe City's 'Solar Placard' form on the DSD Forms & Specifications page (single page, 2017); Comprehensive Inspection Reference items 63-67; Example SolarAPP+ Inspection Checklist 'Signs, Placards, Directories, and Markings' pages. Held at 88 because the two City documents are 2015/2017 vintage and their CFC/CRC/CEC citations are dead even though the sign text they specify is still the standard wording.
city placard form + inspection reference checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/23919/637837313234470000
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes - twice over. The City's Solar Placard form fixes its own heading wording, 'CAUTION - Power to this building is also supplied from the following sources with disconnects located as shown', and its own note text 'PV disconnecting means shall be installed at a readily accessible location either outside of a building or structure or inside nearest the point of entrance of the system conductors per the requirements of article 690.14(c)'. The older Form 4613 additionally prescribes three exact legends: adjacent to the main electrical service, 'This electrical service is also served by a photovoltaic (solar) power system, 1 of 2 Disconnects'; at the main electrical service photovoltaic disconnect, 'Photovoltaic Disconnect Means, 2 of 2 Disconnects'; and where terminals may be energised in the open position, 'Warning-Electrical shock hazard - Terminals on both lines and load sides may be energized in the open position. Dual Power Supply-Photovoltaic System.'
Why the confidence is not higherSolar Placard form and Form 4613 section IV.E.5, both currently published by the City. FLAG: the Solar Placard's authority, 'article 690.14(c)', was deleted from the NEC in the 2017 cycle (the disconnect location rule now sits at 690.13 / 705.20), and Form 4613's 'x of 2 Disconnects' legends are 2005-NEC-era wording; neither matches the 2023 NEC now adopted by CVMC 15.24.010.
city placard form (2017) + Form 4613 (2014) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/23919/637837313234470000
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Yes, on both. The City's Solar Placard form dimensions its own artwork: 3/4 inch minimum for the 'CAUTION' header, 1/4 inch minimum for the body text, 1/8 inch minimum for the equipment call-out labels. For the photovoltaic warning marking the Comprehensive Inspection Reference specifies 3/8 inch (9.5 mm) minimum white letters on a red background, on reflective weather-resistant material, and requires that 'Required labels shall be permanent and suitable for the environment.'
Why the confidence is not higherSolar Placard form (dimension callouts on the drawing); Comprehensive Inspection Reference item 66 and item 68. The Comprehensive Inspection Reference attributes the 3/8-inch red/white spec to CFC 605.11.1.1-605.11.1.2 and CRC R331.2.1-R331.2.2, numbering superseded twice; the dimensional requirement itself is unchanged in substance in current code.
city placard form + inspection reference checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/23919/637837313234470000
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes - and this is the strongest single artefact Chula Vista publishes. The 'Solar Placard' form IS a site-plan / facility-map placard template. It must show, in plan and oriented to the viewer: the building outline, the solar photovoltaic array on roof, the inverter location, the PV system disconnect, the service point and utility metering, storage batteries in garage (or the identified room), any stationary engine generator, any wind turbine or remote solar PV array 'per zoning requirements', and the site fences. The note is explicit on orientation: 'Directional Placard shall be oriented relative to where an individual will be standing looking at the placard. Meter panel to be at the bottom of placard when oriented correctly. Also identify any associated equipment.'
Why the confidence is not higherThe City's 'Solar Placard' form, published on the DSD Forms & Specifications page, read in full (one page, created June 2017). This is the local implementation of what NEC 705.10 now requires as a permanent plaque or directory.
city placard form checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/23919/637837313234470000
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing extra for a normal residential rooftop system. SDG&E's published Electric Distribution System Interconnection Handbook requires, where an isolating device is required by SDG&E's operating practices, that the device 'include markings or signage that clearly indicates open and closed positions', that it be 'clearly marked on the submitted single line diagram', and that 'if the device is not adjacent to the PCC, permanent signage must be installed at an SDG&E approved location providing a clear description of the location of the device'. That handbook expressly exempts generating facilities with non-islanding inverters totalling 1 kVA or less, and is written for Rule 21 generating facilities generally rather than for residential Solar Billing Plan rooftops. No SDG&E residential-specific placard set beyond the AHJ's was found.
Why the confidence is not higherSDG&E Electric Distribution System Interconnection Handbook (revised 10/21/2015), Section 3, 'Visible Disconnect Required', items 2 and 5. Confidence held low: this handbook is a decade old and aimed at larger Rule 21 facilities; SDG&E's live residential Solar Contractor Support Center 'Documents & Forms' and 'Process Overview' panels are JavaScript accordions whose contents would not render for extraction, and SDG&E's Rule 21 tariff PDF could not be located at any of the tariff URL patterns tried. Treat as the best sourced position, not a settled one.
utility interconnection handbook (2015) checked 2026-08-28 https://www.sdge.com/sites/default/files/documents/DistributionInterconnectionHandbook.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
Per the City's own documents: the CAUTION site-plan placard goes at the service equipment (oriented with the meter panel at the bottom); the 'WARNING: PHOTOVOLTAIC POWER SOURCE' marking goes adjacent to the main service disconnect, in a location clearly visible from where the disconnect is operated; conduit, raceway and cable-assembly markings go every 10 feet, within one foot of all turns or bends, and within one foot above and below all penetrations of roof/ceiling assemblies, walls and barriers; all interior and exterior DC conduit, enclosures, raceways, cable assemblies, junction boxes, combiner boxes and disconnects must be marked; where PV circuits are embedded in built-up, laminate or membrane roofing in areas not covered by modules, the circuit location must be clearly marked. On the SolarAPP+ path: the rapid-shutdown placard no more than 3 ft (1 m) from the service disconnecting means, and the 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM' label at the initiation device and no more than 3 ft from the switch.
Why the confidence is not higherComprehensive Inspection Reference items 63-67; Solar Placard form orientation note; Example SolarAPP+ Inspection Checklist location lines. Same staleness caveat: the City documents attribute these to CFC 605.11.1.3/605.11.1.4 and CRC R331.2.3/R331.2.4.
inspection reference + placard form + SolarAPP+ checklist checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10605/635780121785870000
Q44 Must equipment be on a specific approved list? Equipment listing
No specific City approved list. Equipment must be listed and labelled to the standards the code names and installed per the listing: modules to UL 1703 (and, current-code, UL 61730), inverters to UL 1741 and marked 'utility interactive', combiner boxes to UL 1741, DC-rated overcurrent devices, hazard control systems to UL 3741. Form 4562C requires manufacturer's specification sheets for all proposed components; Form 4613 requires the spec sheets to 'indicate the listing agency'. CVMC 15.06.015 defines 'listed' by reference to an approved testing laboratory, and CVMC 15.24.035 bars reuse of previously used materials without the Building Official's approval.
Why the confidence is not higherComprehensive Inspection Reference items 2, 40, 57; Example SolarAPP+ Inspection Checklist equipment listing items; Form 4562C submittal list; CVMC 15.06.015 and 15.24.035. Searched the code and the DSD forms index for any City-maintained equipment list - none exists. Recorded as a proved absence of a list, not an absence of a listing requirement.
inspection reference + application form + municipal code checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10605/635780121785870000
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, permitted, on the same residential solar permit. Form 4562C offers 'Solar Photovoltaic + Battery Storage System' and 'Solar Photovoltaic + Electric Panel Upgrade + Battery Storage System' as system types. The technical conditions are the State's, unamended: CVMC 15.36.065 adopts CFC Chapter 12 'Energy Systems' with no local amendment, so CFC 1207 governs, and CVMC 15.09 adopts the 2025 CRC with no amendments, so CRC R330 governs a one- or two-family dwelling. The City's Solar Placard form expects the placard to identify 'Storage batteries in garage (or identify room)', which is how location is recorded.
Why the confidence is not higherForm 4562C system-type checkboxes; CVMC 15.36.065 and 15.09.010; Solar Placard form. Held at 85 because the City publishes no ESS-specific handout of its own - no siting table, no separation distances, no listing-to-UL-9540 statement - so the conditions are entirely by reference to the adopted codes.
application form + adopting ordinances checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10629/638330532029770000
Q46 Is there a separate ESS permit or inspection? Battery / ESS
No. Battery storage installed with PV is a system-type checkbox on the same Residential Solar Application (Form 4562C), the fee schedule has no ESS line, and the Chula Vista Fire Department publishes no residential ESS permit or fee - Fee Bulletin 15-200 (Fire Safety Engineering) contains no solar, photovoltaic, energy-storage or battery item. Inspection is folded into the same PV inspection.
Why the confidence is not higherForm 4562C; Master Fee Schedule bulletins 10-400 and 15-200 read in full; Fire Prevention page (which lists fire plan check for new construction and fire/life-safety systems, and gives an email address for fire inspection scheduling, with no ESS item). Held at 75 because this is an absence argued from three documents rather than a City statement that no separate ESS permit is needed; a stand-alone ESS retrofit with no PV may well be handled differently.
fee schedule bulletins + application form (absence) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/2416/638638971096170000
Q47 Is a ground mount treated as a structure? Core Ground mount
Yes, in effect. A ground mount is one of the two 'Type of Installation' options on Form 4562C and takes the same City building permit, but it loses the roof-mount exemption from the site/plot plan requirement, so a scaled plot plan showing property lines, setbacks, adjacent streets and equipment locations must be submitted and the structure is sited against the zone's development standards. Zoning does not add a discretionary layer: CVMC 19.58.142(F) makes a residential-level electrical generating facility 'subject to and governed by CVMC Title 15'.
Why the confidence is not higherForm 4562C 'Type of Installation: Roof Mount / Ground Mount' plus its plot-plan line 'One Site plan / plot plan (Not required for roof-mount residential)'; CVMC 19.58.142(F) and the CVMC 19.04.002 definition. Confidence deliberately low: no Chula Vista document says in words that a ground mount is 'a structure', and the City publishes no ground-mount handout, setback table or height limit for solar arrays. The answer is inferred from the plot-plan trigger and the Title 15 routing.
application form + municipal code (inferred) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10629/638330532029770000
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
No published distance from the meter, by either party. SDG&E's Interconnection Handbook requires, where its operating practices call for one, a ganged manually-operated isolating switch 'near the Point of Interconnection', capable of visible verification of separation, lockable in the open position, marked for open/closed, reachable quickly and conveniently 24 hours a day by SDG&E personnel without obstacles, keys, special permission or security clearances, and with its type and location approved by SDG&E prior to installation - with permanent signage giving its location if it is not adjacent to the PCC. Facilities with non-islanding inverters totalling 1 kVA or less are exempt. Chula Vista adds nothing: its Comprehensive Inspection Reference simply says DC disconnects are 'located as allowed by the AHJ' and that disconnects must be 'according to the approved plan and properly located as required by the CEC', and the City's Solar Placard note repeats CEC 690.14(C) - readily accessible, outside the building or inside nearest the point of entrance of the system conductors.
Why the confidence is not higherSDG&E Electric Distribution System Interconnection Handbook (rev. 10/21/2015) Section 3; Comprehensive Inspection Reference items 52 and 54; Solar Placard form note. Confidence low for the same reason as Q42: the SDG&E handbook is a decade old and scoped to Rule 21 generating facilities, and SDG&E's current residential Solar Contractor Support Center panels would not render for extraction. Anyone relying on a fixed '10 feet from the meter' rule should confirm with SDG&E directly - it is not in any document reachable here.
utility interconnection handbook (2015) + city inspection reference checked 2026-08-28 https://www.sdge.com/sites/default/files/documents/DistributionInterconnectionHandbook.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal or Phone. Online through Accela Citizen Access (permits.chulavistaca.gov/citizenaccess/chulavista.aspx) to schedule, cancel, reschedule and check results; or by the automated Permit Inspection Line on (619) 409-5434 using the permit number and an inspection code. Assistance on (619) 409-5868. 92% · department page
- How much notice is required? No fixed minimum notice is published. The instruction is 'Please request the inspection as soon as possible, as inspections are limited each day' - a daily cap, not a lead time. Requests received after the daily limit has been reached are booked for the next available business day. The City's stated service goal has been next-day inspection from the day requested, with a caveat that it is 'experiencing high volumes and are transitioning to a new permitting software system'. 85% · department page
- Are same-day or AM/PM windows offered? No. Neither same-day booking nor AM/PM windows are offered: 'We can't give you a specific time of day for your inspection because inspection times vary from one inspection to the next.' The published workaround is to phone the inspector on the morning of the inspection between 7:30 and 8:30 a.m. on (619) 409-5868 - 'Your inspector may be able to give you a time window or make other arrangements.' 90% · department page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes - the City performs its own inspections. Nothing is delegated. 92% · department page
- If delegated, to whom? N/A - not delegated. Chula Vista Development Services Building Division inspects. The only outside sign-off in the chain is SDG&E's Permission to Operate, which is an energisation approval and not a delegated inspection; the City requires the SDG&E work order to be on site at the time of its own inspection where a panel upgrade is involved. 90% · department page
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? Two City inspection events at most, both electrical codes, both booked by the applicant: (1) 'ELEC-Meter Clearance' as an Electric Meter Upgrade Inspection, if applicable; then (2) the Final Inspection, requested as 'ELEC-Meter Clearance' plus 'ELEC-Final Approval'. The PV inspection sheet warns 'Please DO NOT use inspection code “Final Activity” for any inspection request' and adds the rule 'Thou shall not cover unless inspected'. On the expedited path CVMC 15.29.020(G) requires 'one consolidated building inspection ... done in a timely manner', with re-inspections required if it fails. 90% · department inspection list + municipal code
- Is a rough-in or mid-roof inspection required? No. The published PV inspection list contains no rough-in or mid-roof stage - only the optional meter-upgrade clearance and the final. For the expedited path CVMC 15.29.020(G) mandates a single consolidated inspection, which forecloses a separate mid-roof. (CVMC 15.24.050 speaks of a 'rough inspection' for circuit cards generally, but no rough-in inspection code appears on the PV list.) 85% · department inspection list (absence)
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes - three of them, all linked from the solar page: the one-page 'Inspection Guide for Streamlined Small Residential Rooftop Solar Permitting' (about 20 field items), the four-page 'Comprehensive Inspection Reference for Streamlined Residential Solar Permitting' (68 numbered items with code citations, derived from the California Solar Permitting Guidebook), and an 'Example SolarAPP+ Inspection Checklist' (21 pages, the SolarAPP+ approval document format). Plus the generic Inspection Record card and the PV Solar Permit Inspection Request sheet. 92% · published inspection checklists
- What must be on site at inspection? The approved plans ('The approved plans shall be made available on site to the inspector at time of inspection'), a completed Circuit Card, and - if applicable - the SDG&E Work Order. In practice also the City Inspection Record card, on which the inspector signs off each inspection type. The Circuit Card requirement is local law, not just practice: CVMC 15.24.050 provides that when requested by the Building Official a complete schedule of circuits showing the number, kind and capacity of each outlet on each circuit shall be posted on each job prior to rough inspection, and the City publishes Form 4537 'Circuit Card and Load Summary', headed 'This card must be filled out and available at the Service Equipment for the Rough Inspection'. 90% · department permit page + municipal code + city form
- Does the inspector verify labels and listings? Yes, explicitly and in detail. The Inspection Guide requires the inspector to verify 'PV system markings, labels and signs according to the approved plan' and 'Equipment installed, listed and labeled according to the approved plan (e.g., PV modules, DC/DC converters, combiners, inverters, disconnects, load centers and electrical service equipment)', that the inverter is marked 'utility interactive', and that modules carry the required fire classification. The Comprehensive Inspection Reference devotes items 63-68 to signs and labels and items 2, 10, 11, 40 and 57 to listings. 92% · published inspection guide
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final. The Building Division signs 'FINAL APPROVAL' in the electrical Final Inspections column of the Inspection Record card, and the PV inspection code to request is 'ELEC-Final Approval'. No certificate of occupancy is issued for a solar retrofit. The City calls this 'final approval ... granted for the solar system'; the separate Permission to Operate comes from SDG&E afterwards. 85% · department inspection list + inspection card
- Who notifies the utility for PTO? Installer. The contractor files the interconnection application with SDG&E - 'Your contractor will submit a permit and interconnection application on your behalf' - and SDG&E issues Permission to Operate once the installation is complete and the AHJ has permitted and inspected it. The City does not notify SDG&E: CVMC 15.29.020(F) puts the obligation on the applicant, 'The applicant is responsible for obtaining such approval or permission from the local utility provider.' SDG&E's own material tells customers to 'consult with your local Authority Having Jurisdiction (AHJ) regarding any permitting requirements' - it does not undertake to collect the final from the City. 85% · CCA process page + municipal code + utility material
- Is there a re-inspection fee? No flat dollar amount is published for a building re-inspection. The City confirms the charge exists - 'Any changes in plans or additional inspections are subject to additional hourly review fees and a reinspection fee' - and Master Fee Schedule Bulletin 1-200 'Cost Recovery' (October 2025) supplies the mechanism: full cost recovery at fully burdened hourly rates, currently $109.09/hr for a Building Inspector I, $127.10/hr for a Building Inspector II, $151.33/hr for a Building Inspector III, $153.41/hr for a Senior Building Inspector and $249.59/hr for the Building Official. The only flat 'Reinspection Fee' in Bulletin 10-100 is a Code Enforcement item ('As required to obtain code compliance, no fee charged for 1st inspection ... Full cost recovery'), not a building re-inspection. 70% · master fee schedule bulletin 1-200 (Oct 2025) + department page
- How are corrections issued and cleared? By email, with the detail in the portal. 'We will email all comments/corrections for your project to you.' Under the electronic process, when all reviewers have finished you receive an e-mail telling you to look at the Corrections Required Report and the marked-up Plan Set file in Citizen Access; you clear them by uploading corrected plans with the 'Resubmit' button paired to the original file (and 'Add' for newly requested documents or extra plan volumes). Deleted pages must be replaced with a blank page bearing the original sheet number; files over 400MB must be split. Recheck goal is 5 business days for residential solar. Additional plan review is chargeable at hourly rates. For the expedited path CVMC 15.29.020(E) requires the Building Official to issue 'a written correction notice detailing all deficiencies in the application'. 88% · department pages + municipal code
14 questions answered against City of Chula Vista’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal or Phone. Online through Accela Citizen Access (permits.chulavistaca.gov/citizenaccess/chulavista.aspx) to schedule, cancel, reschedule and check results; or by the automated Permit Inspection Line on (619) 409-5434 using the permit number and an inspection code. Assistance on (619) 409-5868.
Why the confidence is not higherSchedule an Inspection page and Building Inspection page, both explicit on the two channels; the PV Solar Permit Inspection Request sheet and the Inspection Record card both print the portal URL.
department page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/schedule-an-inspection
Q50 How much notice is required? Core Booking & scheduling
No fixed minimum notice is published. The instruction is 'Please request the inspection as soon as possible, as inspections are limited each day' - a daily cap, not a lead time. Requests received after the daily limit has been reached are booked for the next available business day. The City's stated service goal has been next-day inspection from the day requested, with a caveat that it is 'experiencing high volumes and are transitioning to a new permitting software system'.
Why the confidence is not higherBuilding Inspection page, quoted. Held at 85 because the page states a goal and a queue mechanism rather than a notice requirement, so 'one business day' is the working answer but is not written as a rule.
department page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/building/building-inspection
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
No. Neither same-day booking nor AM/PM windows are offered: 'We can't give you a specific time of day for your inspection because inspection times vary from one inspection to the next.' The published workaround is to phone the inspector on the morning of the inspection between 7:30 and 8:30 a.m. on (619) 409-5868 - 'Your inspector may be able to give you a time window or make other arrangements.'
Why the confidence is not higherBuilding Inspection page, quoted verbatim.
department page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/building/building-inspection
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes - the City performs its own inspections. Nothing is delegated.
Why the confidence is not higherSchedule an Inspection page: 'All work performed under a permit issued by the City of Chula Vista is subject to inspection by City staff ... Inspections are carried out by staff from the department or division responsible for issuing the respective permit.' The Building Division inspects 'photovoltaic permits' by name on the Building Inspection page, and the solar page says workmanship and adherence to the approved design 'are then verified by the City of Chula Vista through the inspection process'.
department page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/schedule-an-inspection
Q53 If delegated, to whom? Core Who inspects
N/A - not delegated. Chula Vista Development Services Building Division inspects. The only outside sign-off in the chain is SDG&E's Permission to Operate, which is an energisation approval and not a delegated inspection; the City requires the SDG&E work order to be on site at the time of its own inspection where a panel upgrade is involved.
Why the confidence is not higherSchedule an Inspection and Building Inspection pages; solar page inspection paragraph; CVMC 15.29.020(F) on the utility's separate role.
department page checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/building/building-inspection
Q54 Which inspections are required, and in what order? Core Stages & sequence
Two City inspection events at most, both electrical codes, both booked by the applicant: (1) 'ELEC-Meter Clearance' as an Electric Meter Upgrade Inspection, if applicable; then (2) the Final Inspection, requested as 'ELEC-Meter Clearance' plus 'ELEC-Final Approval'. The PV inspection sheet warns 'Please DO NOT use inspection code “Final Activity” for any inspection request' and adds the rule 'Thou shall not cover unless inspected'. On the expedited path CVMC 15.29.020(G) requires 'one consolidated building inspection ... done in a timely manner', with re-inspections required if it fails.
Why the confidence is not higherPV Solar Permit Inspection Request (Form linked from the Building Inspection page) read in full; CVMC 15.29.020(G).
department inspection list + municipal code checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10052/635705904779930000
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No. The published PV inspection list contains no rough-in or mid-roof stage - only the optional meter-upgrade clearance and the final. For the expedited path CVMC 15.29.020(G) mandates a single consolidated inspection, which forecloses a separate mid-roof. (CVMC 15.24.050 speaks of a 'rough inspection' for circuit cards generally, but no rough-in inspection code appears on the PV list.)
Why the confidence is not higherPV Solar Permit Inspection Request; CVMC 15.29.020(G); the Inspection Record card's rough-in column has no PV entry. Recorded as a proved absence, with the place looked named.
department inspection list (absence) checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10052/635705904779930000
Q56 Does the inspector verify labels and listings? Core What is checked
Yes, explicitly and in detail. The Inspection Guide requires the inspector to verify 'PV system markings, labels and signs according to the approved plan' and 'Equipment installed, listed and labeled according to the approved plan (e.g., PV modules, DC/DC converters, combiners, inverters, disconnects, load centers and electrical service equipment)', that the inverter is marked 'utility interactive', and that modules carry the required fire classification. The Comprehensive Inspection Reference devotes items 63-68 to signs and labels and items 2, 10, 11, 40 and 57 to listings.
Why the confidence is not higherInspection Guide for Streamlined Small Residential Rooftop Solar Permitting (Rev 05.15) and Comprehensive Inspection Reference (Rev 05.15), both linked from the solar page and read in full.
published inspection guide checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10607/635780121789570000
Q57 Is there a published inspection checklist? Core What is checked
Yes - three of them, all linked from the solar page: the one-page 'Inspection Guide for Streamlined Small Residential Rooftop Solar Permitting' (about 20 field items), the four-page 'Comprehensive Inspection Reference for Streamlined Residential Solar Permitting' (68 numbered items with code citations, derived from the California Solar Permitting Guidebook), and an 'Example SolarAPP+ Inspection Checklist' (21 pages, the SolarAPP+ approval document format). Plus the generic Inspection Record card and the PV Solar Permit Inspection Request sheet.
Why the confidence is not higherAll three fetched and read in full. Staleness worth knowing: the two City-written references are Rev 05.15 and cite CEC 690.35/690.31(E), CFC 605.11 and CRC R331; the SolarAPP+ example is a May 2023 document generated against NEC 2017 and the 2018 IRC. They remain the only published solar inspection checklists.
published inspection checklists checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10605/635780121785870000
Q58 What must be on site at inspection? Core Documents on site
The approved plans ('The approved plans shall be made available on site to the inspector at time of inspection'), a completed Circuit Card, and - if applicable - the SDG&E Work Order. In practice also the City Inspection Record card, on which the inspector signs off each inspection type. The Circuit Card requirement is local law, not just practice: CVMC 15.24.050 provides that when requested by the Building Official a complete schedule of circuits showing the number, kind and capacity of each outlet on each circuit shall be posted on each job prior to rough inspection, and the City publishes Form 4537 'Circuit Card and Load Summary', headed 'This card must be filled out and available at the Service Equipment for the Rough Inspection'.
Why the confidence is not higherSolar page inspection paragraph, quoted; CVMC 15.24.050; Form 4537 Circuit Card (rev. via the DSD Forms page, doc version stamp Feb 2025); Inspection Record card. Also 'Permit holders must be prepared to show conformance with all technical requirements in the field at the time of inspection.'
department permit page + municipal code + city form checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/build-green/residential-solar-energy
Q59 Is there a re-inspection fee? Corrections & re-inspection
No flat dollar amount is published for a building re-inspection. The City confirms the charge exists - 'Any changes in plans or additional inspections are subject to additional hourly review fees and a reinspection fee' - and Master Fee Schedule Bulletin 1-200 'Cost Recovery' (October 2025) supplies the mechanism: full cost recovery at fully burdened hourly rates, currently $109.09/hr for a Building Inspector I, $127.10/hr for a Building Inspector II, $151.33/hr for a Building Inspector III, $153.41/hr for a Senior Building Inspector and $249.59/hr for the Building Official. The only flat 'Reinspection Fee' in Bulletin 10-100 is a Code Enforcement item ('As required to obtain code compliance, no fee charged for 1st inspection ... Full cost recovery'), not a building re-inspection.
Why the confidence is not higherPermit Fee Costs page (quoted); Master Fee Schedule bulletins 10-100 (Jul 2017), 10-200, 10-300, 10-400 (Sep 2024) and 10-500 all read for a re-inspection line; Bulletin 1-200 Cost Recovery, October 2025 edition, hourly rate table. Held at 70 because the City never joins the two statements - it does not say in writing that the building re-inspection fee IS the hourly rate. Note the current live 1-200 (February 2026 version stamp) was not extractable; the October 2025 edition was used.
master fee schedule bulletin 1-200 (Oct 2025) + department page checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/2426/638979472429670000
Q60 How are corrections issued and cleared? Corrections & re-inspection
By email, with the detail in the portal. 'We will email all comments/corrections for your project to you.' Under the electronic process, when all reviewers have finished you receive an e-mail telling you to look at the Corrections Required Report and the marked-up Plan Set file in Citizen Access; you clear them by uploading corrected plans with the 'Resubmit' button paired to the original file (and 'Add' for newly requested documents or extra plan volumes). Deleted pages must be replaced with a blank page bearing the original sheet number; files over 400MB must be split. Recheck goal is 5 business days for residential solar. Additional plan review is chargeable at hourly rates. For the expedited path CVMC 15.29.020(E) requires the Building Official to issue 'a written correction notice detailing all deficiencies in the application'.
Why the confidence is not higherProject Submittal Process page; Electronic Plan Review (EPR) page, read in full; plan check goals table; CVMC 15.29.020(E). Held at 88 because the field-correction (failed inspection) route is not separately described anywhere the City publishes - what is documented is the plan-check correction cycle.
department pages + municipal code checked 2026-08-28 https://www.chulavistaca.gov/departments/development-services/permit-information/online-electronic-permit-services/epr-electronic-plan-review
Q61 What is issued on pass? Core Final sign-off & PTO
Final. The Building Division signs 'FINAL APPROVAL' in the electrical Final Inspections column of the Inspection Record card, and the PV inspection code to request is 'ELEC-Final Approval'. No certificate of occupancy is issued for a solar retrofit. The City calls this 'final approval ... granted for the solar system'; the separate Permission to Operate comes from SDG&E afterwards.
Why the confidence is not higherInspection Record card (electrical row, 'FINAL APPROVAL'); PV Solar Permit Inspection Request ('Final Inspection: ELEC-Meter Clearance, ELEC-Final Approval'); solar page ('the system must be inspected before final approval is granted for the solar system'). Held at 85 because 'green tag' vs 'final' is a labelling question the City never addresses directly - what is documented is a signed-off inspection record.
department inspection list + inspection card checked 2026-08-28 https://www.chulavistaca.gov/home/showpublisheddocument/10052/635705904779930000
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer. The contractor files the interconnection application with SDG&E - 'Your contractor will submit a permit and interconnection application on your behalf' - and SDG&E issues Permission to Operate once the installation is complete and the AHJ has permitted and inspected it. The City does not notify SDG&E: CVMC 15.29.020(F) puts the obligation on the applicant, 'The applicant is responsible for obtaining such approval or permission from the local utility provider.' SDG&E's own material tells customers to 'consult with your local Authority Having Jurisdiction (AHJ) regarding any permitting requirements' - it does not undertake to collect the final from the City.
Why the confidence is not higherSan Diego Community Power, Solar & Storage 101, 'Steps to Installing Solar & Battery Storage'; CVMC 15.29.020(F); SDG&E Generation Interconnection 101 (October 2024) on PTO issuance and on AHJ permitting being the customer's business. Held at 85 because no document states the mechanism by which SDG&E learns the City final has passed - only that the applicant is responsible for obtaining utility permission.
CCA process page + municipal code + utility material checked 2026-08-28 https://sdcommunitypower.org/solar-storage-101/
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Chula Vista against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Chula Vista is the authority having jurisdiction 92% confidence
- Holds
- Building and electrical permitting, plan review and its own field inspections for residential solar PV and PV+battery inside the city limits, through the Development Services Department, Building Division, 276 Fourth Avenue Building B. It issues one Residential Solar permit (Form 4562C) on either an expedited SolarAPP+ path or a standard plan-check path, and performs the ELEC-Meter Clearance and ELEC-Final Approval inspections itself.
- Overridden by
- The California Building Standards Code sets the substance: CVMC 15.08/15.09/15.24/15.26/15.36 adopt the 2025 CBC, 2025 CRC, 2025 CEC (2023 NEC), 2025 California Energy Code and 2025 CFC, all by Ordinances 3603-3613 of 2025, with CFC Chapter 12 (Energy Systems) and the entire Residential Code adopted with no local amendment. Gov. Code 65850.5 drives CVMC 15.29's expedited, administrative, non-discretionary path and its one-consolidated-inspection rule. SDG&E holds interconnection and Permission to Operate; CVMC 15.29.020(F) states City approval 'does not authorize an applicant to connect ... to the local utility provider's electricity grid'. San Diego Community Power is the CCA for Chula Vista and supplies generation only - it plays no part in permitting or interconnection. The Chula Vista Fire Department administers the Fire Code (CVMC 15.36) but publishes no residential solar or ESS permit or fee.
- Why not higher
- The City publishes its own solar permit page, its own current application form (4562C Rev 10.23), its own solar placard specification, its own PV inspection code list and its own solar inspection checklists, and CVMC 15.06.080 and 15.29 place the authority with the Building Official - that part is near-certain. The brief's framing was correct on both utility points: SDG&E is the interconnecting utility and San Diego Community Power does not run interconnection, confirmed from SDCP's own Solar & Storage 101 page. Held below 95 because the AHJ/utility split at the AC disconnect and the utility placard set could not be pinned to a current SDG&E residential document - the only reachable SDG&E interconnection handbook is a 2015 Rule 21 document.
- Permit required
- Yes - a building permit is required for a residential rooftop PV system95%
- Permit cost
- $453 total on the SolarAPP+ expedited path ($30 intake + $0 plan check + $423 inspection); $722 total on the standard path ($70 intake + $158 plan check + $494 inspection).92%
- Plan review
- 10 business days for the first review of a Residential Solar Energy project; 5 business days for a recheck; 10 business days for a plan change.90%
- Portal
- Accela Citizen Access at permits.chulavistaca.gov/citizenaccess/chulavista.aspx (older City documents give the same portal as pip.chulavistaca.gov) for application, fees,92%
- Electrical code
- 202395%
- Own placard wording
- Yes - twice over. The City's Solar Placard form fixes its own heading wording, 'CAUTION - Power to this building is also supplied from the following sources with disconnects located as…85%
- Booking an inspection
- Portal or Phone. Online through Accela Citizen Access (permits.chulavistaca.gov/citizenaccess/chulavista.aspx) to schedule, cancel, reschedule and check results;92%
Labels & placards for this authority
City of Chula Vista writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 85%
Yes - twice over. The City's Solar Placard form fixes its own heading wording, 'CAUTION - Power to this building is also supplied from the following sources with disconnects located as shown', and its own note text 'PV disconnecting means shall be installed at a readily accessible location either outside of a building or structure or inside nearest the point of entrance of the system conductors per the requirements of article 690.14(c)'. The older Form 4613 additionally prescribes three exact legends: adjacent to the main electrical service, 'This electrical service is also served by a photovoltaic (solar) power system, 1 of 2 Disconnects'; at the main electrical service photovoltaic disconnect, 'Photovoltaic Disconnect Means, 2 of 2 Disconnects'; and where terminals may be energised in the open position, 'Warning-Electrical shock hazard - Terminals on both lines and load sides may be energized in the open position. Dual Power Supply-Photovoltaic System.'
Size, colour & material 88%
Yes, on both. The City's Solar Placard form dimensions its own artwork: 3/4 inch minimum for the 'CAUTION' header, 1/4 inch minimum for the body text, 1/8 inch minimum for the equipment call-out labels. For the photovoltaic warning marking the Comprehensive Inspection Reference specifies 3/8 inch (9.5 mm) minimum white letters on a red background, on reflective weather-resistant material, and requires that 'Required labels shall be permanent and suitable for the environment.'
Where they go 88%
Per the City's own documents: the CAUTION site-plan placard goes at the service equipment (oriented with the meter panel at the bottom); the 'WARNING: PHOTOVOLTAIC POWER SOURCE' marking goes adjacent to the main service disconnect, in a location clearly visible from where the disconnect is operated; conduit, raceway and cable-assembly markings go every 10 feet, within one foot of all turns or bends, and within one foot above and below all penetrations of roof/ceiling assemblies, walls and barriers; all interior and exterior DC conduit, enclosures, raceways, cable assemblies, junction boxes, combiner boxes and disconnects must be marked; where PV circuits are embedded in built-up, laminate or membrane roofing in areas not covered by modules, the circuit location must be clearly marked. On the SolarAPP+ path: the rapid-shutdown placard no more than 3 ft (1 m) from the service disconnecting means, and the 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM' label at the initiation device and no more than 3 ft from the switch.
What the utility wants on top 60%
Nothing extra for a normal residential rooftop system. SDG&E's published Electric Distribution System Interconnection Handbook requires, where an isolating device is required by SDG&E's operating practices, that the device 'include markings or signage that clearly indicates open and closed positions', that it be 'clearly marked on the submitted single line diagram', and that 'if the device is not adjacent to the PCC, permanent signage must be installed at an SDG&E approved location providing a clear description of the location of the device'. That handbook expressly exempts generating facilities with non-islanding inverters totalling 1 kVA or less, and is written for Rule 21 generating facilities generally rather than for residential Solar Billing Plan rooftops. No SDG&E residential-specific placard set beyond the AHJ's was found.
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
