City of Crescent City
Del Norte County
City of Crescent City is a city authority in the State of California, serving 6,673 residents. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

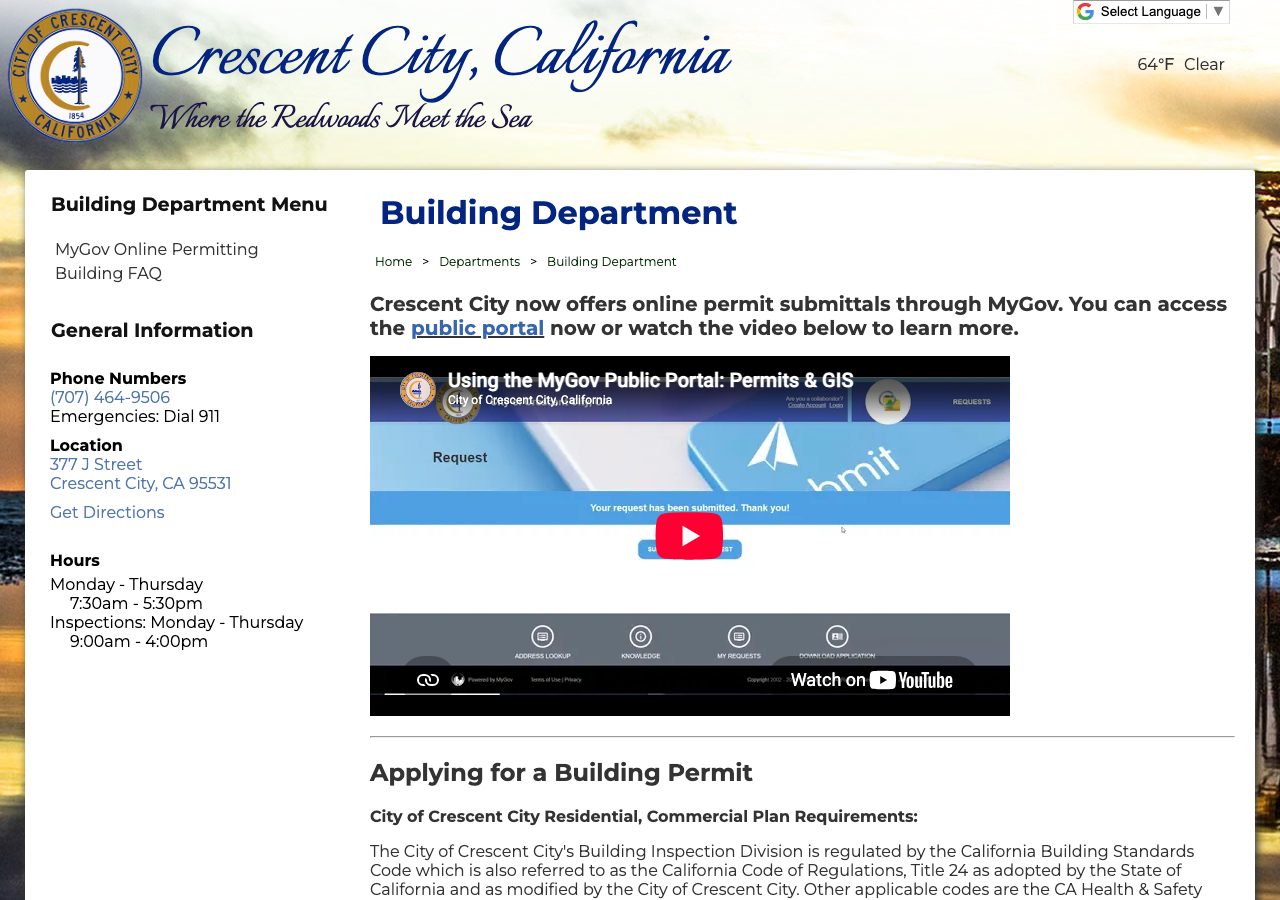

Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Either Q4 Where you file — MyGov (public.mygov.us/crescent_city_ca) Q20
- Permit required
- Yes90% source
- What it costs
- $95.50 flat (electrical permit fee for a photovoltaic system)88% source
- Key document
- inference from state building-code framework cited by 6 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 90% · authority's own page
- What does this authority permit itself, and what does it delegate? Both 85% · fee schedule
- Is a permit required for a residential rooftop PV system? Yes 90% · fee schedule
- Is there a separate electrical permit, or is it combined? Either 65% · permit application form
- Is there a historic-district review? Only conditionally: search-indexed zoning text (Crescent City Municipal Code ch. on Site Plan & Architectural Review) states review applies to uses in the CZ-C2, CZ-HS, CZ-CW, CZ-O, CZ-NR and CZ-HD (Historic District) zones, and separately triggers historic-register review for structures 45+ years old undergoing remodel or demolition. A rooftop PV retrofit on an existing single-family home outside the CZ-HD zone would not typically trigger this. 55% · municipal code (indirect/cached)
- Is a wind or windstorm certification required? No 65% · inference from state building-code framework
- Is a Specific Use Permit or Council approval ever required? Not typically for a standard residential rooftop PV retrofit; Council/Site Plan & Architectural Review approval applies only in certain commercial/overlay zones (see q25), and CA's Solar Rights Act (Civil Code §714) limits an AHJ's ability to require discretionary approval for small residential systems 55% · municipal code (indirect/cached) + state law inference
- Is there a system-size cap on residential generation? No hard cap on residential system size; systems no larger than 10 kW AC (or 30 kW thermal) qualify for the city's expedited administrative review under Gov. Code §65850.5 (AB 2188) - larger systems go through standard plan review rather than being barred 65% · municipal code (indirect/cached) citing state law
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 80% · department FAQ
- Must the contractor be registered with this authority before applying? Yes 65% · department page
- Is a homeowner permitted to self-install and self-permit? Yes 85% · department FAQ
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Proof of ownership (recorded Grant Deed copy), current Assessor's Parcel Map, Plot Plan, Construction Plans, Title 24 energy compliance documentation, and a Certificate of Compliance/Mandatory Measures 65% · authority's own page
- How many copies, and in what format? 4 copies of plot plan, 4 complete sets of construction plans, and 4 copies of Title 24 documentation (paper submittal) 70% · authority's own page
- Is a site plan required, and what must it show? Yes - a Plot Plan is required 65% · authority's own page
- Is a one-line / three-line diagram required? Yes, inferred 60% · utility DG manual
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? MyGov (public.mygov.us/crescent_city_ca) 90% · portal landing page
- What does a residential solar permit cost? $95.50 flat (electrical permit fee for a photovoltaic system) 88% · fee schedule
- How is the fee calculated? Flat 85% · fee schedule
- Is there a separate plan-check fee? Possibly - the schedule lists a generic 'Plan check fee: 65% of building permit costs,' but it is unclear whether this applies to a PV job billed only under the Electrical Permits Schedule (the PV line item carries no separate plan-check figure) 55% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- How long is an issued permit valid before it expires? 180 days from issuance (and expires if work is suspended/abandoned for 180 days after starting) 90% · permit application form
- Which utility handles interconnection here? Pacific Power (PacifiCorp) 90% · utility source
- Where does the utility sit in the sequence? Parallel, with a hard dependency at the end 75% · utility DG manual
28 questions answered against City of Crescent City’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity publishes its own Building Department, fee schedule and permit application independent of Del Norte County; incorporated cities are the default AHJ under CA law and no interagency delegation to the county was found.
authority's own page checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherThe FY2024-25 Master Fee Schedule lists a separate 'Building Permit Fees' schedule and a separate 'Electrical Permits Schedule' both issued by the City of Crescent City Building Department; nothing is delegated to the county.
fee schedule checked 2026-08-30 https://www.crescentcity.org/media/PublicDocuments/Finance/Fee%20Schedule/FY%202024-25%20Fee%20Schedule.pdf
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherThe fee schedule has a specific 'Photovoltaic system' line item under the Electrical Permits Schedule, and the city's AB 2188 solar ordinance (indexed by eCode360 as 'Small Residential Rooftop Solar Energy Systems', direct fetch blocked - see not_found) presumes a permit is required and streamlines its review.
fee schedule checked 2026-08-30 https://www.crescentcity.org/media/PublicDocuments/Finance/Fee%20Schedule/FY%202024-25%20Fee%20Schedule.pdf
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Either
Why the confidence is not higherThe single Building Permit Application form has checkboxes for Building, Electrical, Mechanical and Plumbing that can be marked together on one submittal, but the fee schedule prices Building and Electrical as separate line-item schedules; a PV-only retrofit's fee appears solely under the Electrical schedule ($95.50), suggesting a simple PV job needs only the electrical permit while roof-structural work would add a building permit.
permit application form checked 2026-08-30 https://www.crescentcity.org/media/Building/B_Permit_Application.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either

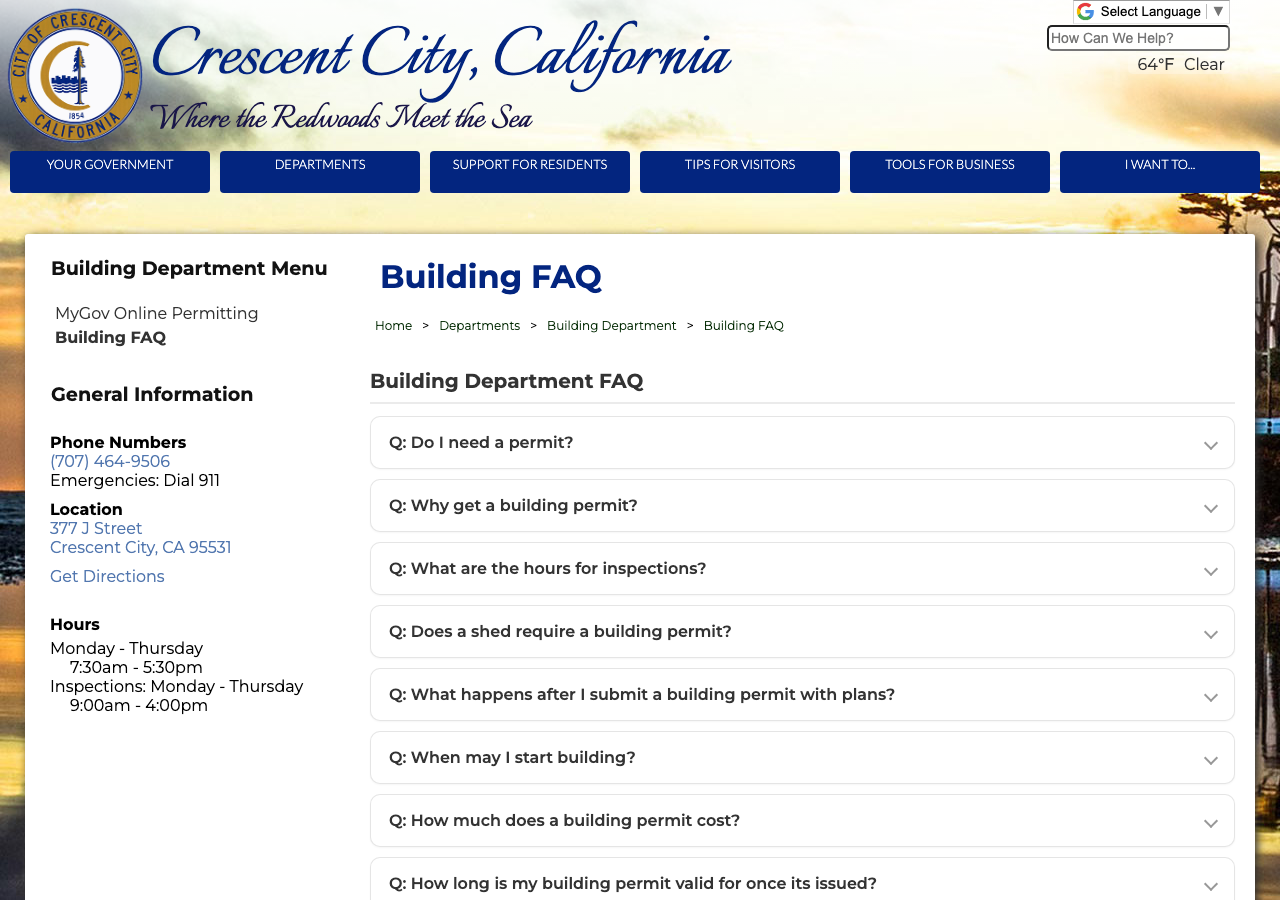

Why the confidence is not higherBuilding FAQ states 'Only licensed contractors, property owners (Owner/Builder) and authorized agents may be issued building permits,' and the permit application has a dedicated owner/builder signature line, so a licensed electrician or the homeowner may pull the permit.
department FAQ checked 2026-08-30 https://www.crescentcity.org/departments/Building/BuildingFAQ
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherThe city requires a City of Crescent City business license for any contractor doing business/work within city limits, in addition to the CSLB state license; this is a general municipal business-license requirement rather than a solar-specific registry, and I could not confirm it is checked at the moment of permit application rather than separately.
department page checked 2026-08-30 https://www.crescentcity.org/BusinessLicenses
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherBuilding FAQ explicitly names 'property owners (Owner/Builder)' as eligible permittees, and the permit application form has a dedicated 'Signature of Owner (if Owner/Builder)' line.
department FAQ checked 2026-08-30 https://www.crescentcity.org/departments/Building/BuildingFAQ
Q8 What documents make up a complete submittal? Core Submittal package
Proof of ownership (recorded Grant Deed copy), current Assessor's Parcel Map, Plot Plan, Construction Plans, Title 24 energy compliance documentation, and a Certificate of Compliance/Mandatory Measures
Why the confidence is not higherThis is the general submittal list published on the city's Building Department page; it is not solar-specific, and the AB 2188-mandated solar checklist the ordinance requires the city to publish was not found on the site (see not_found) - a PV-only electrical permit may not need the full list.
authority's own page checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q9 How many copies, and in what format? Submittal package
4 copies of plot plan, 4 complete sets of construction plans, and 4 copies of Title 24 documentation (paper submittal)
Why the confidence is not higherDirectly stated on the Building Department page's list of required submittal items; not confirmed whether MyGov's online portal has changed this to a digital-copy requirement.
authority's own page checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes - a Plot Plan is required
Why the confidence is not higherBuilding Department page lists 'Plot Plan (4 copies)' as a standard submittal item, and the Building FAQ repeatedly requires a plot plan to verify setback compliance for accessory work; exact required PV-specific content (array location, setbacks, access pathways) was not separately specified.
authority's own page checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes, inferred
Why the confidence is not higherNot independently confirmed on a Crescent City document; inferred because the state's Solar Permitting Guidebook checklist (which Gov. Code §65850.5 requires the local checklist to substantially conform to) requires a one-line diagram, and Pacific Power's own generation-system guide separately requires a one-line drawing with every interconnection application for the same project.
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Key_Components_Solar_Generation_System.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedCrescent City Building Department page, Building FAQ, and Building Permit Application PDF - none mention string/conductor calculations; the city's AB 2188 solar checklist (which would specify this) is required by ordinance to be published on the city website but was not locatable via site search
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedBuilding Department page and FAQ - no structural PE stamp threshold stated; eCode360 (where a local amendment might set one) is 403-blocked to direct fetch by every method tried
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedSame as q13 - no electrical PE stamp threshold found on any Crescent City page or reachable code source
Q15 What does a residential solar permit cost? Core Fees
$95.50 flat (electrical permit fee for a photovoltaic system)
Why the confidence is not higherFY2024-25 Master Fee Schedule (effective 2 Jul 2024, Resolution 2024-52) lists 'Photovoltaic system... $95.50' under the Electrical Permits Schedule, with the same figure shown as both 'Current Fee' and 'Proposed Fee' (no change planned). Does not include any separate building-permit valuation fee that would apply if roof/structural work is also permitted.
fee schedule checked 2026-08-30 https://www.crescentcity.org/media/PublicDocuments/Finance/Fee%20Schedule/FY%202024-25%20Fee%20Schedule.pdf
Q16 How is the fee calculated? Core Fees
Flat
Why the confidence is not higherThe $95.50 photovoltaic-system fee is a single flat figure in the Electrical Permits Schedule, not tied to valuation, kW, or panel count.
fee schedule checked 2026-08-30 https://www.crescentcity.org/media/PublicDocuments/Finance/Fee%20Schedule/FY%202024-25%20Fee%20Schedule.pdf
Q17 Is there a separate plan-check fee? Fees
Possibly - the schedule lists a generic 'Plan check fee: 65% of building permit costs,' but it is unclear whether this applies to a PV job billed only under the Electrical Permits Schedule (the PV line item carries no separate plan-check figure)
Why the confidence is not higherThe 65% plan-check rule sits under the 'Building Permit Fees' heading, which is ambiguous as to whether it is triggered only when a building-permit valuation fee is also charged.
fee schedule checked 2026-08-30 https://www.crescentcity.org/media/PublicDocuments/Finance/Fee%20Schedule/FY%202024-25%20Fee%20Schedule.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Nothing published by this authority.
Where we lookedBuilding Department page and FAQ - hours and contact info given, but no stated plan-review turnaround time (business days) found anywhere on crescentcity.org
Q19 How long is an issued permit valid before it expires? Timeline & validity
180 days from issuance (and expires if work is suspended/abandoned for 180 days after starting)
Why the confidence is not higherBuilding Permit Application form quotes 'CBC 105.5 - EXPIRATION: EVERY PERMIT ISSUED SHALL BECOME INVALID UNLESS THE WORK ON THE SITE...IS COMMENCED WITHIN 180 DAYS...' printed on the form itself.
permit application form checked 2026-08-30 https://www.crescentcity.org/media/Building/B_Permit_Application.pdf
Q20 Which permit portal does this authority use? Core Portal & process
MyGov (public.mygov.us/crescent_city_ca)
Why the confidence is not higherThe Building Department page states 'Crescent City now offers on-line permitting' and links directly to the MyGov portal.
portal landing page checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q21 Can the whole application be completed online? Core Portal & process
Nothing published by this authority.
Where we lookedMyGov portal landing page (public.mygov.us/crescent_city_ca) - confirms online permitting exists but the fetched page did not expose whether a full building/electrical application (vs. document upload only) can be completed end-to-end online, and the city's own submittal list still calls for 4 paper copies of plans
Q22 Which utility handles interconnection here? Core Utility interconnection
Pacific Power (PacifiCorp)
Why the confidence is not higherConfirmed from utility-side and city-area news sources (Pacific Power's own newsroom press releases specifically about Crescent City/Del Norte County outage restoration), not from a ZIP-code lookup tool; PG&E does not serve this far-northern coastal area.
utility source checked 2026-08-30 https://www.pacificpower.net/about/newsroom/news-releases/pacific-power-restores-electricity.html
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel, with a hard dependency at the end
Why the confidence is not higherPacific Power's own interconnection guide lists the sequence as: (1) select installer, (2) complete Net Metering Application, (3) submit application/fee (15-30 business day review), (4) receive Pacific Power approval, (5) install project and have it inspected by the local AHJ, (6) submit the AHJ's approved electrical inspection to Pacific Power, (7) Pacific Power installs the net meter within 10 days. So utility approval is typically sought in parallel with/ahead of the local permit and install, but final utility sign-off (net meter/PTO) strictly follows the AHJ's final inspection.
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Interconnection_Net_Meter_Brochure.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
Nothing published by this authority.
Where we lookedCrescent City zoning code (Site Plan & Architectural Review chapter) accessible only via blocked eCode360 and via search-engine cached snippets; those snippets describe review applying to specific commercial/overlay zones and CEQA-scale projects, not clearly to a single-family PV retrofit, so I could not confirm a Yes/No for standard R-zone homes with adequate confidence
Q25 Is there a historic-district review? Overlays & special cases
Only conditionally: search-indexed zoning text (Crescent City Municipal Code ch. on Site Plan & Architectural Review) states review applies to uses in the CZ-C2, CZ-HS, CZ-CW, CZ-O, CZ-NR and CZ-HD (Historic District) zones, and separately triggers historic-register review for structures 45+ years old undergoing remodel or demolition. A rooftop PV retrofit on an existing single-family home outside the CZ-HD zone would not typically trigger this.
Why the confidence is not higherSourced only from search-engine cached snippets of the eCode360 page - direct fetch of Crescent City's eCode360 code is blocked (403) by every method tried (Referer header, Googlebot UA, API route, r.jina.ai proxy), so this could not be independently verified or control-tested; capped confidence accordingly.
municipal code (indirect/cached) checked 2026-08-30 https://ecode360.com/44244330
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherCalifornia does not use a Texas-style windstorm/TDI certification regime; wind loading for PV racking is addressed through the California Building Code's structural provisions (engineering, not a separate wind certificate). No Crescent City document mentions a standalone wind certification requirement.
inference from state building-code framework checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Not typically for a standard residential rooftop PV retrofit; Council/Site Plan & Architectural Review approval applies only in certain commercial/overlay zones (see q25), and CA's Solar Rights Act (Civil Code §714) limits an AHJ's ability to require discretionary approval for small residential systems
Why the confidence is not higherNo Crescent City document specifically addresses solar in this context; inferred from the general zoning-review scope found via search (eCode360, blocked to direct fetch) plus statewide Solar Rights Act protections.
municipal code (indirect/cached) + state law inference checked 2026-08-30 https://ecode360.com/44244330
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No hard cap on residential system size; systems no larger than 10 kW AC (or 30 kW thermal) qualify for the city's expedited administrative review under Gov. Code §65850.5 (AB 2188) - larger systems go through standard plan review rather than being barred
Why the confidence is not higherThis 10kW AC / 30kW thermal threshold is the statutory AB 2188 eligibility line for expedited review, reproduced in the Crescent City ordinance summary found via search; it is an eligibility cutoff for the fast-track process, not a prohibition on larger systems.
municipal code (indirect/cached) citing state law checked 2026-08-30 https://ecode360.com/44240761
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which building code edition is in force? California Building Code, 2022 Edition (Part 2 of Title 24) and California Residential Code, 2022 Edition (Part 2.5), per Crescent City Municipal Code Title 15, Article 15.100 55% · municipal code (indirect/cached)
- Are there local amendments to any of the above? Yes - the city selects specific CBC/CRC appendices (see q30) rather than adopting the state code as-is, which constitutes a local amendment/selection 55% · municipal code (indirect/cached)
- What is the installation judged against? The California Building Code/Residential Code/Electrical Code as adopted and locally amended by the City of Crescent City (Title 15), i.e., Title 24 as modified by the city 55% · authority's own page
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
Nothing recorded for City of Crescent City on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
Nothing recorded for City of Crescent City on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? A sign at the meter base reading 'Parallel Generation On Site', a sign at the AC disconnect switch reading 'Manual Disconnect for Parallel Generation' (numbered if multiple switches), and a director placard on the meter base if the disconnect is located away from the meter 85% · utility DG manual
- Does it specify letter height, colour or material? Signs/placards must have a red background with white engraving; lettering on the director placard must be at least 1/4 inch tall (comparable to 25-point Arial), sized to a map-style layout; signs must be permanent metal or hard plastic 88% · utility DG manual
- Is a site plan / facility map placard required, and what must it show? Yes, but only when the AC disconnect is located away from the meter: a permanent 'director placard' is required on the meter base, red background/white engraving, map-style layout showing the precise disconnect location, at least 1/4 inch lettering, and the design must be pre-approved by Pacific Power before installation 85% · utility DG manual
- Does the UTILITY specify placards beyond the AHJ's? Yes - Pacific Power's own signage requirements (exact wording, colors, letter height, and a director placard) go well beyond anything found in Crescent City's own published materials, which have no city-specific placard ordinance located 85% · utility DG manual
- Where must the labels be placed? On the meter base ('Parallel Generation On Site'), on the AC disconnect switch ('Manual Disconnect for Parallel Generation'), and, if the disconnect is remote from the meter, a director placard on the meter base pointing to it 88% · utility DG manual
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? Within 3 feet of the meter (California is 'always required' and 3 feet, versus Oregon's 10 feet or Washington's 3 feet) unless Pacific Power gives written permission for a more distant location plus a director placard 90% · utility DG manual
20 questions answered against City of Crescent City’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
Nothing published by this authority.
Where we lookedeCode360 Crescent City code (electrical code chapter) - 403-blocked on direct fetch (tried: iccsafe.org Referer header, Googlebot user-agent, ecode360 API route, r.jina.ai proxy - all blocked or returned Cloudflare 403/401). A WebSearch summary claimed a specific NEC edition and ordinance number, but cross-checking showed that result had conflated Crescent City with a different city's electrical code page (ecode360.com/45837388 is actually Carrollton's electrical code, not Crescent City's) - so that claim is discarded as unreliable rather than recorded
Q30 Which building code edition is in force? Core Code editions in force
California Building Code, 2022 Edition (Part 2 of Title 24) and California Residential Code, 2022 Edition (Part 2.5), per Crescent City Municipal Code Title 15, Article 15.100
Why the confidence is not higherSourced only from search-engine cached snippets of eCode360 (direct fetch 403-blocked by every method tried); the specific appendix letters quoted (G, I, P for CBC; AH, AJ, AO, AQ, AX, AW, AZ for CRC) match the real 2022-cycle appendix lettering, which supports authenticity, but this could not be independently verified, and it may lag the 2025 statewide cycle (based on the 2024 IBC family) that took effect statewide 1 Jan 2026 - I found no Crescent City-specific ordinance updating to the 2025 cycle.
municipal code (indirect/cached) checked 2026-08-30 https://ecode360.com/47272637
Q31 Which fire code edition is in force? Code editions in force
Nothing published by this authority.
Where we lookedeCode360 Crescent City fire code chapter - same 403 block as q29; WebSearch summaries gave contradictory fire-code-edition claims (2007 vs. current) with the AI itself flagging insufficient support, so none was recorded
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes - the city selects specific CBC/CRC appendices (see q30) rather than adopting the state code as-is, which constitutes a local amendment/selection
Why the confidence is not higherSame sourcing limitation as q30 - cached eCode360 snippet only, direct fetch blocked.
municipal code (indirect/cached) checked 2026-08-30 https://ecode360.com/47272637
Q33 What is the installation judged against? Core Electrical
The California Building Code/Residential Code/Electrical Code as adopted and locally amended by the City of Crescent City (Title 15), i.e., Title 24 as modified by the city
Why the confidence is not higherBuilding Department page states installations are judged against 'the California Building Standards Code...as modified by the City of Crescent City'; specific amendment text not independently verified due to eCode360 block.
authority's own page checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedBuilding Department page, FAQ, and Building Permit Application - no rule on service upgrades or busbar sizing found; likely resides in the electrical code chapter on eCode360, which is 403-blocked
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedSame as q34 - no mounting-system or attachment-spacing rule found on any reachable Crescent City page
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Nothing published by this authority.
Where we lookedBuilding Department/FAQ and fire code page (blocked) - no ridge setback or fire-access-pathway specification found for Crescent City specifically
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Nothing published by this authority.
Where we lookedCould not confirm which NEC edition is in force (q29 not_found), so the tied rapid-shutdown-edition answer cannot be sourced with confidence; no Crescent City page independently states a rapid-shutdown requirement
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
A sign at the meter base reading 'Parallel Generation On Site', a sign at the AC disconnect switch reading 'Manual Disconnect for Parallel Generation' (numbered if multiple switches), and a director placard on the meter base if the disconnect is located away from the meter
Why the confidence is not higherThis is the UTILITY's (Pacific Power/PacifiCorp) requirement, not a Crescent City ordinance requirement - no city-published placard spec was found (see not_found, q39). Pacific Power's own current 'Key Components of a Solar Generation System' guide states these signs are required by both Pacific Power and the NEC.
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Key_Components_Solar_Generation_System.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedeCode360 Crescent City code (403-blocked on every method tried) is the only place a city-authored placard-wording provision would sit; no city-hosted PDF, ordinance excerpt, or department page with placard wording was found via direct site search either, but because eCode360 itself could not be searched (no positive or fabricated control could be run against a 403 response), this is recorded as an unproven gap rather than a confirmed absence
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Signs/placards must have a red background with white engraving; lettering on the director placard must be at least 1/4 inch tall (comparable to 25-point Arial), sized to a map-style layout; signs must be permanent metal or hard plastic
Why the confidence is not higherThis is the utility's spec, not the AHJ's - stated verbatim in Pacific Power's own solar-components guide.
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Key_Components_Solar_Generation_System.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes, but only when the AC disconnect is located away from the meter: a permanent 'director placard' is required on the meter base, red background/white engraving, map-style layout showing the precise disconnect location, at least 1/4 inch lettering, and the design must be pre-approved by Pacific Power before installation
Why the confidence is not higherUtility requirement, not found in any Crescent City-specific facility-map ordinance (city site has no placard spec of its own - see not_found q39).
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Key_Components_Solar_Generation_System.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes - Pacific Power's own signage requirements (exact wording, colors, letter height, and a director placard) go well beyond anything found in Crescent City's own published materials, which have no city-specific placard ordinance located
Why the confidence is not higherDirect comparison: utility document is detailed and current; a search for a Crescent City signage ordinance found nothing, and eCode360 (where any such provision would sit) is blocked to direct verification.
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Key_Components_Solar_Generation_System.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
On the meter base ('Parallel Generation On Site'), on the AC disconnect switch ('Manual Disconnect for Parallel Generation'), and, if the disconnect is remote from the meter, a director placard on the meter base pointing to it
Why the confidence is not higherVerbatim from Pacific Power's current solar-components guide.
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Key_Components_Solar_Generation_System.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Nothing published by this authority.
Where we lookedBuilding Department/FAQ and eCode360 (blocked) - no city-specific approved-equipment list found; Pacific Power requires UL 1741/IEEE 1547-listed inverters, but that is a utility interconnection standard, not confirmed as an AHJ-level 'approved list'
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Nothing published by this authority.
Where we lookedBuilding Department/FAQ and fire code (blocked) - no battery/ESS-specific provision found for Crescent City
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Nothing published by this authority.
Where we lookedSame as q45 - no separate ESS permit/inspection requirement found
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedZoning/building code sources (eCode360 blocked) - no statement found on whether a ground-mounted array is treated as an accessory structure for Crescent City specifically
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Within 3 feet of the meter (California is 'always required' and 3 feet, versus Oregon's 10 feet or Washington's 3 feet) unless Pacific Power gives written permission for a more distant location plus a director placard
Why the confidence is not higherPacific Power's Key Components guide gives a state-by-state distance table explicitly listing California at 3 feet, and states the AC disconnect switch is always required in California (unlike Oregon/Washington's kW-based thresholds).
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Key_Components_Solar_Generation_System.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone 60% · authority's own page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 80% · authority's own job posting
- If delegated, to whom? N/A - not delegated; the city performs its own final solar inspections (see q52) 80% · authority's own job posting
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
Nothing recorded for City of Crescent City on this step yet — 2 questions checked and found unpublished. The guidance above is general.
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Does the inspector verify labels and listings? Likely yes, as part of general code-compliance verification 55% · inference from job description
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (a final inspection sign-off, not a new Certificate of Occupancy, since this is a retrofit to an existing single-family dwelling) 50% · inference from permit application form
- Who notifies the utility for PTO? Installer 85% · utility DG manual
- Is there a re-inspection fee? $45 85% · fee schedule
14 questions answered against City of Crescent City’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone
Why the confidence is not higherThe Building Department page lists inspection hours (Mon-Thu 9am-4pm) and the department's main phone number, with no separate online inspection-request tool called out; the MyGov portal's inspection-scheduling capability specifically for Crescent City was not confirmed either way.
authority's own page checked 2026-08-30 https://www.crescentcity.org/departments/Building
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedBuilding Department page and FAQ - inspection hours given, but no stated advance-notice requirement (business days) for scheduling
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedSame as q50 - no mention of same-day or AM/PM inspection windows
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherThe city's own Building Inspector/Code Enforcement Official job description states the position 'inspects structural, electrical, plumbing and mechanical installations...for compliance with approved plans and applicable codes' and 'issues building permits' - the city performs its own inspections in-house (currently via a part-time position, per jurisdiction note), not delegated to the county or a third party.
authority's own job posting checked 2026-08-30 https://www.crescentcity.org/jobs/2508/
Q53 If delegated, to whom? Core Who inspects
N/A - not delegated; the city performs its own final solar inspections (see q52)
Why the confidence is not higherSame source as q52 shows in-house inspection duties; the city did discuss possibly using a third-party contractor for capacity reasons in 2024, but as a staffing measure for the same city-held authority, not a formal delegation to another AHJ.
authority's own job posting checked 2026-08-30 https://www.crescentcity.org/jobs/2508/
Q54 Which inspections are required, and in what order? Core Stages & sequence
Nothing published by this authority.
Where we lookedBuilding Department/FAQ and Building Permit Application - general 'Special Approvals' sign-off blocks exist (Building, Public Works, Fire, Health) but no PV-specific inspection sequence (rough-in, final, etc.) is published
https://www.crescentcity.org/media/Building/B_Permit_Application.pdf
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedSame as q54 - no statement on whether a rough-in/mid-roof inspection is required for PV
https://www.crescentcity.org/media/Building/B_Permit_Application.pdf
Q56 Does the inspector verify labels and listings? Core What is checked
Likely yes, as part of general code-compliance verification
Why the confidence is not higherInferred, not solar-specific: the Building Inspector job description says the inspector checks installations 'for compliance with approved plans and applicable codes,' which by NEC/UL practice includes verifying equipment listing and required labels, but no Crescent City document specifically calls out label/listing verification for PV.
inference from job description checked 2026-08-30 https://www.crescentcity.org/jobs/2508/
Q57 Is there a published inspection checklist? Core What is checked
Nothing published by this authority.
Where we lookedBuilding Department page and site search for a published inspection checklist - none found (the AB 2188 solar checklist the city is required to publish was also not locatable, compounding this gap)
Q58 What must be on site at inspection? Core Documents on site
Nothing published by this authority.
Where we lookedBuilding Department/FAQ - no list of documents required on-site at inspection was found
Q59 Is there a re-inspection fee? Corrections & re-inspection
$45
Why the confidence is not higherFY2024-25 Master Fee Schedule lists 'Reinspection fee...$45' under the Building Permits Schedule (applies city-wide across permit types, not solar-specific).
fee schedule checked 2026-08-30 https://www.crescentcity.org/media/PublicDocuments/Finance/Fee%20Schedule/FY%202024-25%20Fee%20Schedule.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Nothing published by this authority.
Where we lookedBuilding Department/FAQ - general code-violation/citation language exists (two-times-fee penalty for unpermitted work) but no description of a routine correction-notice-and-clearance process for a failed inspection
https://www.crescentcity.org/departments/Building/BuildingFAQ
Q61 What is issued on pass? Core Final sign-off & PTO
Final (a final inspection sign-off, not a new Certificate of Occupancy, since this is a retrofit to an existing single-family dwelling)
Why the confidence is not higherInferred from standard CA practice for an existing-home PV retrofit and the generic permit/inspection structure on the city's Building Permit Application form (Building/Public Works/Fire/Health 'Special Approvals' sign-off blocks); no PV-specific final-document name was found on a Crescent City page.
inference from permit application form checked 2026-08-30 https://www.crescentcity.org/media/Building/B_Permit_Application.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer
Why the confidence is not higherPacific Power's interconnection guide, Step 6: 'Submit your approved electrical inspection form from the local authority to Pacific Power' - this is the customer/installer's action, after which Pacific Power installs the net meter (Step 7) as the PTO event.
utility DG manual checked 2026-08-30 https://www.pacificpower.net/content/dam/pcorp/documents/en/pacificpower/savings-energy-choices/customer-generation/PP_Interconnection_Net_Meter_Brochure.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Crescent City against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Crescent City is the authority having jurisdiction 85% confidence
- Holds
- Building and Electrical
- Overridden by
- CA Gov. Code §65850.5 (AB 2188) requires the city's expedited administrative permit process for small residential rooftop PV (≤10kW AC); AB 130 (Stats. 2025, Ch. 22) bars any more-restrictive local residential-code amendment through 1 Jun 2031
- Why not higher
- The city issues its own building and electrical permits with its own fee schedule and application form (both departments' work products are on crescentcity.org, not Del Norte County's site), so Crescent City is a separate incorporated AHJ, not covered by the county. IMPORTANT correction to the brief: the person who actually performs plan review and inspection - the 'Building Inspector/Code Enforcement Official' - is organizationally a position in the PUBLIC WORKS department per the city's own job posting, even though the public-facing web page is branded 'Building Department' (Community Development handles planning only, via a contracted planner from SHN Inc., Ethan Lawton). This is a staffing/org-chart fact, not a delegation of authority - the city itself remains the AHJ for both trades. The position has historically been filled part-time by a retired CalPERS annuitant (capped at 960 hrs/yr per state law), and in June 2024 the city discussed converting to full-time and/or hiring a third-party contractor because of a housing-development surge - a staffing arrangement, not a jurisdictional delegation.
- Permit required
- Yes90%
- Permit cost
- $95.50 flat (electrical permit fee for a photovoltaic system)88%
- Portal
- MyGov (public.mygov.us/crescent_city_ca)90%
- Booking an inspection
- Phone60%
Labels & placards for this authority
Wording None%
Size, colour & material 88%
Signs/placards must have a red background with white engraving; lettering on the director placard must be at least 1/4 inch tall (comparable to 25-point Arial), sized to a map-style layout; signs must be permanent metal or hard plastic
Where they go 88%
On the meter base ('Parallel Generation On Site'), on the AC disconnect switch ('Manual Disconnect for Parallel Generation'), and, if the disconnect is remote from the meter, a director placard on the meter base pointing to it
What the utility wants on top 85%
Yes - Pacific Power's own signage requirements (exact wording, colors, letter height, and a director placard) go well beyond anything found in Crescent City's own published materials, which have no city-specific placard ordinance located
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
