City of Dorris
Siskiyou County
City of Dorris is a city authority in the State of California, serving 860 residents. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Where you file — None — no online permit portal exists. Applications and plans are submitted on paper by mail (P.O. Box 768) or in person at 307 S. Main St. Q20
- Permit required
- Yes92% source
- What it costs
- $400.00 flat (system 10 kW or less); $500.00 flat (system greater than 10 kW) — both under Electrical Fees.85% source
- Key document
- department checklist (general residential — no PV-specific document found) cited by 5 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · department page
- What does this authority permit itself, and what does it delegate? Both (Building and Electrical), administered under one contracted Building Department 88% · general plan (current, dated) + permit form
- Is a permit required for a residential rooftop PV system? Yes 92% · fee schedule
- Is there a separate electrical permit, or is it combined? Combined 85% · permit application form (OCR)
- Is a HOA or architectural approval required first? No 82% · checklist comparison + zoning code
- Is there a historic-district review? No 82% · zoning code (full-text, control-checked)
- Is a wind or windstorm certification required? No 70% · code of ordinances + checklists (absence)
- Is a Specific Use Permit or Council approval ever required? Not required for a qualifying residential PV system on this record — nothing in the zoning code or checklists names solar as a CUP/Council-approval trigger. DMC §18.84.190 requires a Use Permit only if a structure exceeds the district's established height limit by more than 10 feet, which a roof-mounted PV array would not ordinarily do. 60% · zoning code (inference)
- Is there a system-size cap on residential generation? No codified system-size cap on residential solar generation was found. The only size-linked provision anywhere is the fee schedule's own 10 kW break point between its two flat PV fee tiers ($400 at ≤10 kW, $500 at >10 kW), which is a fee tier, not a permitting cap or gate — there is no evidence a system over 10 kW is barred, requires different review, or routes to a different permitting track. 75% · zoning + building code (full-text, control-checked absence)
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 88% · permit application form (OCR)
- Must the contractor be registered with this authority before applying? Yes (general business license, not a solar-specific trade registration) 55% · code of ordinances
- Is a homeowner permitted to self-install and self-permit? Yes 90% · permit application form (OCR)
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? No PV-specific checklist is published; residential PV would use the general 'Residential Construction Plans Submission Checklist and Routing Sheet': zoning-district determination, 1 completed Building Permit Application, Plan Check Deposit (~65% of building permit fee), 2 sets building/architectural/structural plans incl. site plan, 2 sets electrical/plumbing/mechanical plans, 2 sets structural calculations sealed by a CA-licensed PE, 2 sets truss package w/PE seal (snow load 40 psf), 2 sets Title 24 energy calculations; prior to issuance: Tree Cutting Permit if applicable, Soils Report if applicable, Public Works review/approval, Fire Department plan approval for NFPA sprinkler/alarm, and school-fee certificate (currently waived). 70% · department checklist (general residential — no PV-specific document found)
- How many copies, and in what format? 2 sets minimum, no stated paper size; no online submission (no portal found anywhere on the city's site). 70% · department checklist
- Is a site plan required, and what must it show? Yes — a site plan is required as part of the 2 sets of building/architectural/structural plans; the checklist requires area(s) of the dwelling/garage/decks/porches to be shown on the cover sheet, but does not itemize a PV-specific site-plan content list (equipment locations, setbacks, etc.). 65% · department checklist
- Is a structural PE stamp required, and at what threshold? Yes, unconditionally for any residential submittal — no valuation/size threshold stated. The Residential checklist requires '2 sets structural calculations, sealed and signed by a CA licensed professional engineer' and '2 sets truss package w/engineering. Requires PE seal and signature. Snow load – 40 psf' for every project using this checklist, with no minimum-size carve-out for a small PV retrofit. 65% · department checklist
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? None — no online permit portal exists. Applications and plans are submitted on paper by mail (P.O. Box 768) or in person at 307 S. Main St. 88% · department page (absence, checked across all department pages)
- Can the whole application be completed online? No 85% · department page (absence)
- What does a residential solar permit cost? $400.00 flat (system 10 kW or less); $500.00 flat (system greater than 10 kW) — both under Electrical Fees. A separate Building Plan Check Fee (65% of the general Building Permit Fee) and $23.50 Issuance Fee may also apply depending on how the permit is structured (see Q16/Q17). 85% · fee schedule (dated 2019)
- How is the fee calculated? Tiered flat fee by system size: $400 flat at ≤10 kW, $500 flat at >10 kW (not valuation- or per-kW-based within each tier). 82% · fee schedule (dated 2019)
- Is there a separate plan-check fee? Yes — a general Building Plan Check Fee of 65% of the Building Permit Fee is listed as a separate 'Construction Permit Fees' line, and the Residential checklist separately states a 'Plan Check Deposit... approximately 65% of the building permit fee' is required at submittal for any residential project including presumably PV. 70% · fee schedule + checklist
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- How long is an issued permit valid before it expires? 180 days (permit expires if work is not commenced within that period). 85% · permit application form (OCR)
- Which utility handles interconnection here? Pacific Power (PacifiCorp) — not PG&E 92% · general plan (current, dated, first-party)
- Where does the utility sit in the sequence? Before permit AND after permit (a dual gate) — plus a pre-interconnection tariff requirement. 78% · utility process page + CA tariff (re-fetched this run)
28 questions answered against City of Dorris’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes

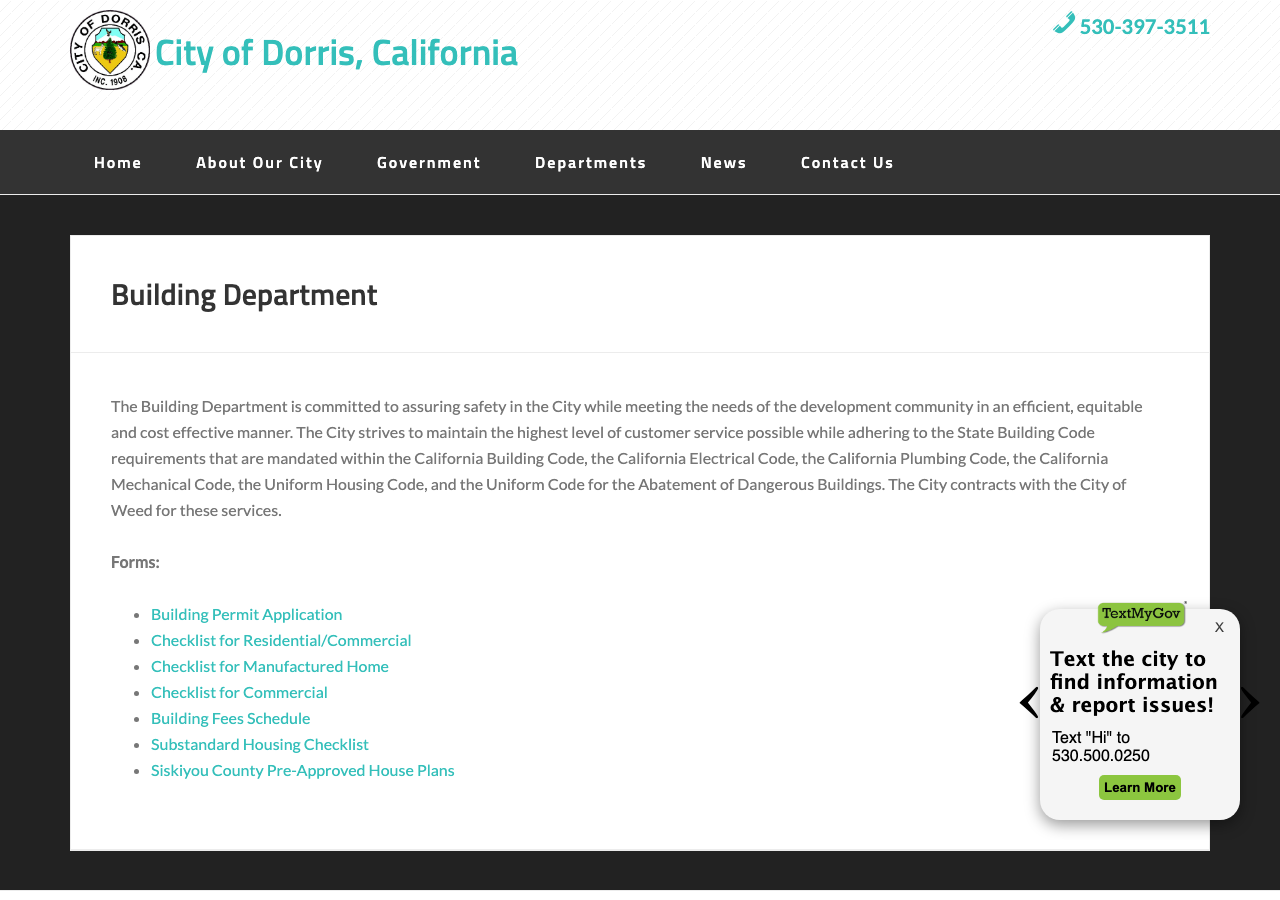

Why the confidence is not higherThe city's own Building Department page states it enforces the California Building Code, Electrical Code, Plumbing Code, Mechanical Code, Uniform Housing Code and Uniform Code for the Abatement of Dangerous Buildings within Dorris, and issues its own residential permit application/fee schedule; the city is the AHJ of record even though it CONTRACTS plan check and inspection to the City of Weed (see jurisdiction block).
department page checked 2026-08-31 https://www.dorrisca.us/departments/building/
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both (Building and Electrical), administered under one contracted Building Department
Why the confidence is not higherDorris's own permit form and fee schedule combine BLDG/ELEC/PLUMB/HEAT/PLAN CK line items under one permit number; the city's own General Plan Open Space & Conservation Element (5.7 Energy, Sept 2025 revision) states outright: 'The City of Weed Building Department, which the City contracts with for plan check and building inspection services, ensures that all new construction complies with the standards in effect on the date a building permit application is made.' Building AND electrical are both delegated to the same contracted department, not split.
general plan (current, dated) + permit form checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/5.0-Dorris-Open-Space-and-Conservation-Element.pdf
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherDorris's own Building Fees schedule lists dedicated line items 'Photovoltaic System 10 Kw or Less $400.00' and 'Photovoltaic System Greater than 10 Kw $500.00' under Electrical Fees, i.e. a permit product exists and is billed; the general Construction Permit Application form and Residential Plans Submission Checklist govern the process (no PV-specific exemption from permitting was found).
fee schedule checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/11/2019-Bld-FEES-Proposed.pdf
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe City of Dorris Permit Application is a single 'Construction Permit' form with BLDG / ELEC / PLUMB / HEAT / PLAN CK sub-total boxes under one permit number and one signature block (OCR-read in full; no text layer in the original scan) — there is no separate stand-alone electrical-permit application published.
permit application form (OCR) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/10/Building-Permit-Form.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherThe Permit Application form's Section 2 requires either a '2a — CALIFORNIA LICENSED CONTRACTOR'S DECLARATION' or a '2b — OWNER-BUILDER'S DECLARATION' (citing B&P Code §7044/§7031.5) — either may sign as the responsible applicant for the electrical/building work.
permit application form (OCR) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/10/Building-Permit-Form.pdf
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes (general business license, not a solar-specific trade registration)
Why the confidence is not higherDMC Title 5 (Business Licenses and Regulations), §5.04.030: 'It is unlawful for any person to be engaged in business in the city without having an unrevoked license from the city.' This is a 1967-era, generally worded business-license ordinance with no solar- or contractor-specific registration step called out, and no document states it must be obtained before permit application specifically (only before performing work) — a functional inference, not an explicit permit-gate statement.
code of ordinances checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2023/12/Dorrisfull-municipalcode0123-2.pdf
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherPermit Application Section 2b is an explicit Owner-Builder's Declaration ('I, as owner of the property... will do all of or portions of the work') citing B&P Code §7044/§7031.5, with a signature line for the property owner or authorized agent.
permit application form (OCR) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/10/Building-Permit-Form.pdf
Q8 What documents make up a complete submittal? Core Submittal package
No PV-specific checklist is published; residential PV would use the general 'Residential Construction Plans Submission Checklist and Routing Sheet': zoning-district determination, 1 completed Building Permit Application, Plan Check Deposit (~65% of building permit fee), 2 sets building/architectural/structural plans incl. site plan, 2 sets electrical/plumbing/mechanical plans, 2 sets structural calculations sealed by a CA-licensed PE, 2 sets truss package w/PE seal (snow load 40 psf), 2 sets Title 24 energy calculations; prior to issuance: Tree Cutting Permit if applicable, Soils Report if applicable, Public Works review/approval, Fire Department plan approval for NFPA sprinkler/alarm, and school-fee certificate (currently waived).
Why the confidence is not higherRead in full from the city's own Residential checklist; no separate solar/PV eligibility checklist (of the kind Weed, Montclair, Danville, etc. publish) exists anywhere on the city's Building or Planning pages — confirmed by listing every linked form on both department pages. Confidence is not higher because it is an inference that a PV project follows this general residential path rather than a PV-tailored subset of it (e.g. truss/structural-calc requirements may be waived in practice for a flush roof-mount retrofit, but no document says so).
department checklist (general residential — no PV-specific document found) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q9 How many copies, and in what format? Submittal package
2 sets minimum, no stated paper size; no online submission (no portal found anywhere on the city's site).
Why the confidence is not higherThe Residential checklist calls for '2 sets' of every plan type repeatedly; the city publishes no online application system on any department page (Building, Public Works, Planning, Finance) and the intake form/checklists are all print/PDF documents with a mailing address (P.O. Box 768) and phone/fax listed.
department checklist checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — a site plan is required as part of the 2 sets of building/architectural/structural plans; the checklist requires area(s) of the dwelling/garage/decks/porches to be shown on the cover sheet, but does not itemize a PV-specific site-plan content list (equipment locations, setbacks, etc.).
Why the confidence is not higherResidential checklist item: '2 sets of building, architectural and structural plans including a site plan. Include the area(s) of the dwelling per floor, garage, decks, porches, etc. on the cover sheet.' No PV-specific site-plan content (module layout, disconnect location, fire pathways) is specified anywhere in Dorris's own documents.
department checklist checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Nothing published by this authority.
Where we lookedthe general Residential checklist and the Commercial/Manufactured Home checklists, and the full-text-checked municipal code, for a stated one-line/three-line diagram requirement specific to PV — none of Dorris's own documents mention electrical one-line/three-line drawings at all (they require 'electrical plans' generically, bound with the building plans, with no diagram-type specification).
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedthe same three checklists and the fee schedule, for a stated string/conductor calculation requirement — not mentioned anywhere; only general 'structural calculations' (unrelated to PV stringing) are required.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Yes, unconditionally for any residential submittal — no valuation/size threshold stated. The Residential checklist requires '2 sets structural calculations, sealed and signed by a CA licensed professional engineer' and '2 sets truss package w/engineering. Requires PE seal and signature. Snow load – 40 psf' for every project using this checklist, with no minimum-size carve-out for a small PV retrofit.
Why the confidence is not higherRead directly from the Residential Construction checklist's 'Required at submittal' section; the document sets no dollar or kW threshold — it applies to all residential submittals, which is a stricter default than jurisdictions with a PV-specific expedited path (e.g. Weed's checklist only requires this for non-qualifying systems). No PV-specific carve-out was found.
department checklist checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedthe Residential checklist and Title 15.04 (Building Code) for an electrical-PE-stamp threshold distinct from the general structural-PE requirement at Q13 — none stated.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q15 What does a residential solar permit cost? Core Fees
$400.00 flat (system 10 kW or less); $500.00 flat (system greater than 10 kW) — both under Electrical Fees. A separate Building Plan Check Fee (65% of the general Building Permit Fee) and $23.50 Issuance Fee may also apply depending on how the permit is structured (see Q16/Q17).
Why the confidence is not higherQuoted verbatim from the city's own 2019 Building Fees schedule: 'Photovoltaic System 10 Kw or Less $400.00' / 'Photovoltaic System Greater than 10 Kw $500.00' under '3. Electrical Fees'. Confidence is not higher because the document is dated 2019 ('2019-Bld-FEES-Proposed.pdf') with no confirmation it has been superseded, and it is unclear from the document whether the flat PV fee stacks with the general valuation-based Building Permit Fee or replaces it for a PV-only job.
fee schedule (dated 2019) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/11/2019-Bld-FEES-Proposed.pdf
Q16 How is the fee calculated? Core Fees
Tiered flat fee by system size: $400 flat at ≤10 kW, $500 flat at >10 kW (not valuation- or per-kW-based within each tier).
Why the confidence is not higherSame 2019 Building Fees schedule — two flat-dollar PV line items keyed to a single 10 kW breakpoint, distinct from the general valuation-based 'Construction Permit Fees' table used for other building work.
fee schedule (dated 2019) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/11/2019-Bld-FEES-Proposed.pdf
Q17 Is there a separate plan-check fee? Fees
Yes — a general Building Plan Check Fee of 65% of the Building Permit Fee is listed as a separate 'Construction Permit Fees' line, and the Residential checklist separately states a 'Plan Check Deposit... approximately 65% of the building permit fee' is required at submittal for any residential project including presumably PV.
Why the confidence is not higherFee schedule: 'Building Plan Check Fee — 65% of Building Permit Fee'; Residential checklist: 'Plan Check Deposit: required when plans are submitted. The deposit is approximately 65% of the building permit fee.' Neither document states whether this plan-check fee is charged in addition to, or instead of, the flat PV electrical fee.
fee schedule + checklist checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/11/2019-Bld-FEES-Proposed.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Nothing published by this authority.
Where we lookedthe Building Department page, the Permit Application form, and the full-text-checked municipal code, for a stated plan-review turnaround time for building or solar permits — none found; only the EVCS chapter (DMC 15.24, unrelated to solar) carries AB-1236-style deemed-approved timelines (10/20/40 business days), which sharpens that the silence for building/solar generally is real rather than a search failure.
Q19 How long is an issued permit valid before it expires? Timeline & validity
180 days (permit expires if work is not commenced within that period).
Why the confidence is not higherPrinted on the city's own Permit Application form (OCR-read): 'PERMIT EXPIRES IN 180 DAYS IF WORK IS NOT COMMENCED.'
permit application form (OCR) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/10/Building-Permit-Form.pdf
Q20 Which permit portal does this authority use? Core Portal & process
None — no online permit portal exists. Applications and plans are submitted on paper by mail (P.O. Box 768) or in person at 307 S. Main St.
Why the confidence is not higherNo portal, Accela/SolarAPP+/eTRAKiT/OpenGov link, or 'apply online' language appears anywhere on the Building, Public Works, Planning, or Finance department pages, nor in the municipal code; every form found (permit application, all three plan-submission checklists, utility application) is a static print-fillable PDF with a mailing address for submission.
department page (absence, checked across all department pages) checked 2026-08-31 https://www.dorrisca.us/departments/building/
Q21 Can the whole application be completed online? Core Portal & process
No
Why the confidence is not higherSame basis as Q20 — no online application system was found on any city page; all intake is by mail or in person.
department page (absence) checked 2026-08-31 https://www.dorrisca.us/departments/building/
Q22 Which utility handles interconnection here? Core Utility interconnection
Pacific Power (PacifiCorp) — not PG&E
Why the confidence is not higherThe city's own current General Plan Open Space & Conservation Element (5.7 Energy, uploaded Sept 2025) states outright: 'there are no electrical energy production facilities in Dorris. Pacific Power provides electrical service to the City and surrounding area.' First-party, dated, and re-fetched directly for this run (not carried over from another Siskiyou file, and not from a ZIP-lookup tool).
general plan (current, dated, first-party) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/5.0-Dorris-Open-Space-and-Conservation-Element.pdf
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Before permit AND after permit (a dual gate) — plus a pre-interconnection tariff requirement.
Why the confidence is not higherPacific Power's own customer-generation process page lists: apply via its PowerClerk portal → receive interconnection authorization from Pacific Power → THEN 'get permits and install your system, but don't turn it on yet' → have the system inspected, upload inspection + safety-sign photos → THEN Pacific Power installs the meter (7–10 business days) and grants Permission to Operate. California Schedule NB-136 (Net Billing) separately states: 'Customer must complete an interconnection agreement with the Utility prior to interconnecting a generation facility.'
utility process page + CA tariff (re-fetched this run) checked 2026-08-31 https://www.pacificpower.net/savings-energy-choices/customer-generation.html
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherDorris's own Manufactured Home and Commercial plan-submission checklists each state 'Architectural Review is required prior to submitting for a building permit,' but the Residential (site-built single-family) checklist does NOT include that line — confirmed by comparing all three checklists side by side. Separately, DMC Ch. 18.120 'Objective Design Standards' is expressly scoped to multifamily (2+ unit) and mixed-use residential development in R-1/R-2/R-3/M-U districts under Gov. Code §65913.4, not single-family rooftop solar. No HOA-approval requirement was found anywhere in Title 18.
checklist comparison + zoning code checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q25 Is there a historic-district review? Overlays & special cases
No
Why the confidence is not higherA full-text, control-checked search of the current Title 18 Zoning code (20 hits for the positive control 'electrical', 0 hits for the fabricated control 'zzqqx') found no historic-district chapter or overlay anywhere; the only 'historic district' language in the whole municipal code is generic boilerplate in the ADU parking-exemption and SB 35 streamlining sections describing a hypothetical condition, not an actual designated district in Dorris.
zoning code (full-text, control-checked) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/Title-18-Zoning.pdf
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherNo wind/windstorm certification process was found in the Building Code chapter (Title 15.04) or any of the three plan-submission checklists; wind loading is handled generically through the adopted state building code (ASCE 7 provisions), not a separate local certification. The Residential checklist does specify a local snow-load figure (40 psf) for truss packages but nothing on wind.
code of ordinances + checklists (absence) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2023/12/Dorrisfull-municipalcode0123-2.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Not required for a qualifying residential PV system on this record — nothing in the zoning code or checklists names solar as a CUP/Council-approval trigger. DMC §18.84.190 requires a Use Permit only if a structure exceeds the district's established height limit by more than 10 feet, which a roof-mounted PV array would not ordinarily do.
Why the confidence is not higherInferred from §18.84.190 (Height limits) and the absence of any solar-specific CUP/Council-approval clause anywhere in Title 18 or Title 15 (control-checked, see Q25). No document addresses a large or ground-mounted residential system specifically.
zoning code (inference) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/Title-18-Zoning.pdf
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No codified system-size cap on residential solar generation was found. The only size-linked provision anywhere is the fee schedule's own 10 kW break point between its two flat PV fee tiers ($400 at ≤10 kW, $500 at >10 kW), which is a fee tier, not a permitting cap or gate — there is no evidence a system over 10 kW is barred, requires different review, or routes to a different permitting track.
Why the confidence is not higherFull-text, control-checked search of Title 15 and Title 18 (zero hits for 'solar'/'photovoltaic' apart from the fee schedule and the unrelated 'Solar Shade Control Act' cross-reference) found no size cap, no AB 2188-style expedited-permitting ordinance, and no ministerial-review-eligibility chapter of the kind many CA cities publish. This absence is itself a finding — Dorris has not codified the Gov. Code §65850.5 expedited/ministerial process that state law requires jurisdictions to adopt.
zoning + building code (full-text, control-checked absence) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/Title-18-Zoning.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which building code edition is in force? Not stated with a specific current edition in the codified municipal code — Title 15.04 ('Building Code') is unrevised text tracing to Ord. 150 (1964) and still uses pre-1970s 'Uniform Building Code' terminology, never recodified to name the California Building Standards Code by cycle year. However, the city's own current (Sept 2025) General Plan states plainly that the City of Weed Building Department, under contract, 'ensures that all new construction complies with the standards in effect on the date a building permit application is made... in Title 24 of the California Code of Regulations' — i.e. a rolling reference to whichever triennial CBSC cycle is currently in force (2025 CBSC, effective 1 Jan 2026, at the time of this survey). 62% · general plan (current) vs. stale codified chapter — both read
- Which fire code edition is in force? Not stated with a current edition. Title 15.12 'Uniform Fire Code Adopted' is unrevised text tracing to Ord. 166 (1980) and never renamed to the California Fire Code. As with Q30, the city's current General Plan's 'standards in effect on the date a building permit application is made' language implies the current statewide CFC cycle applies in practice via the Weed-contracted Building Department, but no document names a specific CFC edition for Dorris. 55% · code of ordinances (stale) + general plan (rolling reference, inference)
- Are there local amendments to any of the above? Yes locally-amended in general, but NOT for solar — the only identified solar-adjacent local text anywhere in the code is a single incidental cross-reference to the state 'Solar Shade Control Act' inside a fence/setback-exception section (DMC §18.84.200(G)), which governs shading of a NEIGHBOR's collector, not permitting of the applicant's own system. A full-text, control-checked search of Title 15 (Buildings) and Title 18 (Zoning) found zero hits for 'solar' or 'photovoltaic' as a permitting/technical amendment (positive control 'electrical': 32 hits in the full code, 20 in Title 18 alone; fabricated control 'zzqqx': 0 hits in both). 85% · code of ordinances (full-text, control-checked)
- What is the installation judged against? Whatever the currently-effective California Building Standards Code cycle is (per the city's own 'standards in effect on the date a building permit application is made' commitment), administered by the City of Weed Building Department under contract, plus Dorris's own general Residential Construction checklist requirements (structural PE calcs, truss engineering, Title 24 energy calcs) for every residential submittal including PV. 65% · general plan + checklist (synthesis)
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
Nothing recorded for City of Dorris on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Not addressed in any Dorris-published document. No checklist, fee schedule, or code chapter reviewed mentions rapid shutdown or NEC/CEC §690.12 by name. Because the operative electrical code is inferred (Q29 not_found / Q30-Q33 moderate confidence) to be the current statewide CEC (built on the 2023 NEC as of this survey), rapid shutdown legally applies via that state-level adoption even though the city's own paperwork is silent on it. 55% · checklist + code (absence, dated 2019)
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Does the authority specify placard wording of its own? No 75% · checklist (absence)
- Does it specify letter height, colour or material? No 75% · checklist (absence)
- Does the UTILITY specify placards beyond the AHJ's? Yes — extensively, by the utility. Pacific Power's own 'Engraved Placard Examples' document (current, ModDate 22 Oct 2025) specifies: 3/8-inch lettering on all placards; red background with white lettering, sized to fit the meter base and AC disconnect switch; a placard on/next to the utility meter base; a placard on/next to the AC knife-blade disconnect for the solar system; a placard on the Battery Disconnect if present (may combine with the manual/DC disconnect label if systems share one disconnect); and, if a 'director' placard is required, lettering at least 9mm (1/4') tall (≈25pt Arial), sized roughly 5x5 inches for readability. Effective 11/1/2025 the utility also requires close-up AND distant photos of the meter/disconnect (with the meter number visible) uploaded with the application. Battery E-stop/manual disconnects must be lockable, accessible, clearly indicate open/closed position, and (per Pacific Power's DER Interconnection Policy, Rev. 12, 5/26/2026) be located within sight and within 10 feet of the utility meter. 92% · utility spec document (re-fetched, current)
- Where must the labels be placed? Dorris's own documents are silent on placement. Pacific Power (the utility) requires: a placard on/next to the utility meter base; a placard on/next to the AC knife-blade disconnect; a placard on the battery disconnect if present; and the customer-side visible disconnect switch itself must be 'located within sight and within 10 feet of the utility meter,' accessible to PacifiCorp personnel and capable of being locked open. 88% · utility interconnection policy (re-fetched, current — Rev. 12, 5/26/2026)
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? Within sight and within 10 feet of the utility meter — a utility (Pacific Power), not city, requirement. No Dorris document independently states an AC-disconnect-to-meter distance. 90% · utility interconnection policy (re-fetched, current)
- Must equipment be on a specific approved list? Not stated by name as an 'approved list' in Dorris's own documents; the general Residential checklist requires PE-sealed structural/truss calculations rather than naming a specific product list. Pacific Power's own interconnection policy requires UL-1741-listed inverters meeting IEEE-1547-2018 (see its Figure C1 'Typical Configuration' notes). 70% · checklist (absence) + utility policy
- Are batteries permitted, and under what conditions? No dedicated city ESS/battery ordinance or permit distinction was found (control-checked — zero 'battery'/'energy storage' hits across the full code). Batteries would follow the same general Residential/Commercial building-permit path as any other electrical addition. Pacific Power's own interconnection policy requires any solar+battery (or standalone battery) disconnect to isolate generation from the customer's load while keeping the customer's utility service energized — via either its preferred rapid-shutdown/EPO design (Fig. H1) or a standard AC knife-blade disconnect design (Fig. H2) — and the battery disconnect/E-stop switch must be lockable and clearly placarded with the battery's physical location and how to visually confirm it is shut down. 72% · code (control-checked absence) + utility policy
20 questions answered against City of Dorris’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
Nothing published by this authority.
Where we lookedthe compiled municipal code's stale Title 15.04 chapter, the General Plan Energy section (which names Title 24/CBSC generally but never names the California Electrical Code or an NEC year specifically), and all checklists/fee schedule/permit form, for a stated NEC/CEC edition — none names a specific edition or year; Q30/31/33 record the best available inference from the General Plan's rolling 'standards in effect' language, but no Dorris document states an NEC edition outright.
Q30 Which building code edition is in force? Core Code editions in force
Not stated with a specific current edition in the codified municipal code — Title 15.04 ('Building Code') is unrevised text tracing to Ord. 150 (1964) and still uses pre-1970s 'Uniform Building Code' terminology, never recodified to name the California Building Standards Code by cycle year. However, the city's own current (Sept 2025) General Plan states plainly that the City of Weed Building Department, under contract, 'ensures that all new construction complies with the standards in effect on the date a building permit application is made... in Title 24 of the California Code of Regulations' — i.e. a rolling reference to whichever triennial CBSC cycle is currently in force (2025 CBSC, effective 1 Jan 2026, at the time of this survey).
Why the confidence is not higherCombines two of the city's own documents that point in different directions: the codified chapter is decades stale and names no edition, while the current General Plan commits to 'standards in effect' at time of application. Confidence is capped at moderate because the operative edition is inferred from a rolling-reference sentence rather than a section that names '2025 CBSC' outright, and because the contracted administrator's own adoption ordinance (City of Weed's Ord. 491-2026) is technically Weed's local law, not Dorris's own codified ordinance.
general plan (current) vs. stale codified chapter — both read checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/5.0-Dorris-Open-Space-and-Conservation-Element.pdf
Q31 Which fire code edition is in force? Code editions in force
Not stated with a current edition. Title 15.12 'Uniform Fire Code Adopted' is unrevised text tracing to Ord. 166 (1980) and never renamed to the California Fire Code. As with Q30, the city's current General Plan's 'standards in effect on the date a building permit application is made' language implies the current statewide CFC cycle applies in practice via the Weed-contracted Building Department, but no document names a specific CFC edition for Dorris.
Why the confidence is not higherSame dual-document basis as Q30; fire-code confidence is lower because, unlike CBC/CEC, the General Plan's Energy section discusses only Title 24 energy/green-building standards and does not explicitly mention the Fire Code by name.
code of ordinances (stale) + general plan (rolling reference, inference) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2023/12/Dorrisfull-municipalcode0123-2.pdf
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes locally-amended in general, but NOT for solar — the only identified solar-adjacent local text anywhere in the code is a single incidental cross-reference to the state 'Solar Shade Control Act' inside a fence/setback-exception section (DMC §18.84.200(G)), which governs shading of a NEIGHBOR's collector, not permitting of the applicant's own system. A full-text, control-checked search of Title 15 (Buildings) and Title 18 (Zoning) found zero hits for 'solar' or 'photovoltaic' as a permitting/technical amendment (positive control 'electrical': 32 hits in the full code, 20 in Title 18 alone; fabricated control 'zzqqx': 0 hits in both).
Why the confidence is not higherConfirmed by direct pdftotext extraction and grep of both the full compiled municipal code and the separately-hosted current Title 18 Zoning PDF, with controls run in this session.
code of ordinances (full-text, control-checked) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2023/12/Dorrisfull-municipalcode0123-2.pdf
Q33 What is the installation judged against? Core Electrical
Whatever the currently-effective California Building Standards Code cycle is (per the city's own 'standards in effect on the date a building permit application is made' commitment), administered by the City of Weed Building Department under contract, plus Dorris's own general Residential Construction checklist requirements (structural PE calcs, truss engineering, Title 24 energy calcs) for every residential submittal including PV.
Why the confidence is not higherSynthesis of the General Plan Energy section and the Residential checklist; no PV-specific technical standard (e.g. rapid shutdown, conductor sizing) is stated anywhere in Dorris's own documents.
general plan + checklist (synthesis) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/5.0-Dorris-Open-Space-and-Conservation-Element.pdf
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedTitle 15.04 (Building Code), the fee schedule, and all three plan-submission checklists, for a local rule on service upgrades or busbar sizing specific to PV interconnection — none found; the fee schedule prices generic electrical service upgrades (100A/200A/over 200A) but nothing PV-specific.
https://www.dorrisca.us/wp-content/uploads/2023/12/Dorrisfull-municipalcode0123-2.pdf
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedthe Residential checklist's structural-calculation and truss-package requirements (Q13), which are generic to all residential construction, for any PV-specific mounting-system or attachment-spacing standard (e.g. rail spacing, lag spacing) — none stated; the checklist requires PE-sealed calculations generally but prescribes no specific attachment spec of its own.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Nothing published by this authority.
Where we lookedthe Residential checklist's 'FIRE DEPARTMENT: Plan approval... for the NFPA fire sprinkler and/or alarm system' line, and the stale, control-checked Title 15.12 fire chapter (Ord. 166, 1980, never renamed from 'Uniform Fire Code'), for a stated PV ridge setback or access-pathway rule — none found in either; Dorris's own Fire Department page was not separately available to check for a solar-specific handout.
https://www.dorrisca.us/wp-content/uploads/2023/12/Dorrisfull-municipalcode0123-2.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Not addressed in any Dorris-published document. No checklist, fee schedule, or code chapter reviewed mentions rapid shutdown or NEC/CEC §690.12 by name. Because the operative electrical code is inferred (Q29 not_found / Q30-Q33 moderate confidence) to be the current statewide CEC (built on the 2023 NEC as of this survey), rapid shutdown legally applies via that state-level adoption even though the city's own paperwork is silent on it.
Why the confidence is not higherFull-text search of the compiled municipal code and all downloaded checklists/fee schedule/permit form for '690.12' and 'rapid shutdown' returned zero hits; the general Residential checklist is dated 2019 (unrevised since) and does not address any post-2017-NEC electrical requirement by name.
checklist + code (absence, dated 2019) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedthe full-text-checked municipal code and all three plan-submission checklists, for an authority-specified (not merely state-code-required) placard list at the service equipment — none found beyond the generic equipment-location callout on the cover sheet; contrast with Pacific Power's own extensive spec at Q42.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No
Why the confidence is not higherNothing in the city's own checklists, permit form, or fee schedule specifies placard wording; the only city-side equipment-location instruction is the general checklist's cover-sheet requirement to show dwelling areas, not a disconnect/PV-specific placard. (Pacific Power, the utility, DOES specify exact placard wording — see Q42/Q43.)
checklist (absence) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
No
Why the confidence is not higherNo authority-specified letter height, colour, or material was found in any Dorris document (contrast with Pacific Power's detailed spec at Q42).
checklist (absence) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedthe same documents, for a site-plan/facility-map placard requirement beyond the generic NEC 705.10 disconnect-directory requirement that would apply by reference through whichever state electrical code is in force — no authority-specific facility-map placard spec was found in any Dorris document.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes — extensively, by the utility. Pacific Power's own 'Engraved Placard Examples' document (current, ModDate 22 Oct 2025) specifies: 3/8-inch lettering on all placards; red background with white lettering, sized to fit the meter base and AC disconnect switch; a placard on/next to the utility meter base; a placard on/next to the AC knife-blade disconnect for the solar system; a placard on the Battery Disconnect if present (may combine with the manual/DC disconnect label if systems share one disconnect); and, if a 'director' placard is required, lettering at least 9mm (1/4') tall (≈25pt Arial), sized roughly 5x5 inches for readability. Effective 11/1/2025 the utility also requires close-up AND distant photos of the meter/disconnect (with the meter number visible) uploaded with the application. Battery E-stop/manual disconnects must be lockable, accessible, clearly indicate open/closed position, and (per Pacific Power's DER Interconnection Policy, Rev. 12, 5/26/2026) be located within sight and within 10 feet of the utility meter.
Why the confidence is not higherRead in full from Pacific Power's own current Engraved Placard Examples PDF and Facility Interconnection Requirements for Distribution (Policy 138, DER Interconnection Policy, Rev. 12 dated 5/26/2026), both fetched directly for this run.
utility spec document (re-fetched, current) checked 2026-08-31 https://www.pacificpower.net/content/dam/pcorp/documents/en/pp-rmp/customer-generation/Engraved_Placard_Examples.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
Dorris's own documents are silent on placement. Pacific Power (the utility) requires: a placard on/next to the utility meter base; a placard on/next to the AC knife-blade disconnect; a placard on the battery disconnect if present; and the customer-side visible disconnect switch itself must be 'located within sight and within 10 feet of the utility meter,' accessible to PacifiCorp personnel and capable of being locked open.
Why the confidence is not higherPacific Power's Engraved Placard Examples PDF plus its Facility Interconnection Requirements for Distribution (Policy 138) 'Visible Disconnect' section, quoted verbatim: 'located within sight and within 10 feet of the utility meter or at a PacifiCorp-approved location with acceptable signage... capable of being locked in the open position... accessible to PacifiCorp personnel.'
utility interconnection policy (re-fetched, current — Rev. 12, 5/26/2026) checked 2026-08-31 https://www.pacificpower.net/content/dam/pcorp/documents/en/pp-rmp/customer-generation/Facility_Interconnection_Requirements_for_Distribution.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Not stated by name as an 'approved list' in Dorris's own documents; the general Residential checklist requires PE-sealed structural/truss calculations rather than naming a specific product list. Pacific Power's own interconnection policy requires UL-1741-listed inverters meeting IEEE-1547-2018 (see its Figure C1 'Typical Configuration' notes).
Why the confidence is not higherResidential checklist (silent on equipment listing) plus Pacific Power's Facility Interconnection Requirements for Distribution, Appendix C, Figure C1 note 3: 'UL-1741 listed inverter meeting IEEE-1547-2018 requirements.'
checklist (absence) + utility policy checked 2026-08-31 https://www.pacificpower.net/content/dam/pcorp/documents/en/pp-rmp/customer-generation/Facility_Interconnection_Requirements_for_Distribution.pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
No dedicated city ESS/battery ordinance or permit distinction was found (control-checked — zero 'battery'/'energy storage' hits across the full code). Batteries would follow the same general Residential/Commercial building-permit path as any other electrical addition. Pacific Power's own interconnection policy requires any solar+battery (or standalone battery) disconnect to isolate generation from the customer's load while keeping the customer's utility service energized — via either its preferred rapid-shutdown/EPO design (Fig. H1) or a standard AC knife-blade disconnect design (Fig. H2) — and the battery disconnect/E-stop switch must be lockable and clearly placarded with the battery's physical location and how to visually confirm it is shut down.
Why the confidence is not higherFull-text, control-checked search of the compiled municipal code (0 hits for 'battery'/'energy storage'; 32 hits for the positive control 'electrical'; 0 for the fabricated control 'zzqqx') plus Pacific Power's own Facility Interconnection Requirements for Distribution, Appendix H (Net Metering Solar and ESS Disconnect Requirements).
code (control-checked absence) + utility policy checked 2026-08-31 https://www.pacificpower.net/content/dam/pcorp/documents/en/pp-rmp/customer-generation/Facility_Interconnection_Requirements_for_Distribution.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Nothing published by this authority.
Where we lookedthe Building Department page's full list of published forms (Building Permit Application, three plan-submission checklists, Building Fees Schedule, Substandard Housing Checklist) and the control-checked full municipal code (0 hits for 'battery'/'energy storage'), for a dedicated ESS-specific permit or inspection requirement — none found; see Q45 for the utility-side ESS disconnect requirement instead.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedthe three plan-submission checklists (all silent on mounting type beyond 'roof' vs. 'manufactured home' vs. 'commercial') and the control-checked Title 18 zoning code (0 hits for 'ground mount'), for any ground-mount-specific provision — none found.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Within sight and within 10 feet of the utility meter — a utility (Pacific Power), not city, requirement. No Dorris document independently states an AC-disconnect-to-meter distance.
Why the confidence is not higherPacific Power's Facility Interconnection Requirements for Distribution (Policy 138, DER Interconnection Policy, Rev. 12, 5/26/2026), 'Visible Disconnect' section: the customer-side switch must be 'located within sight and within 10 feet of the utility meter or at a PacifiCorp-approved location with acceptable signage at the utility meter indicating the location of the disconnect,' 'capable of being locked in the open position,' and 'accessible to PacifiCorp personnel.'
utility interconnection policy (re-fetched, current) checked 2026-08-31 https://www.pacificpower.net/content/dam/pcorp/documents/en/pp-rmp/customer-generation/Facility_Interconnection_Requirements_for_Distribution.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone (and/or mail/in-person, consistent with the city's paper-only intake) — the city's single published number, 530-397-3511, is used for all department contact including Building; no online booking tool exists. 60% · department page (inference from paper-based intake)
- How much notice is required? 24 hours in advance. 85% · permit application form (OCR)
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Delegated 85% · general plan (current, first-party statement)
- If delegated, to whom? City of Weed Building Department 85% · general plan (current, first-party statement)
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
Nothing recorded for City of Dorris on this step yet — 2 questions checked and found unpublished. The guidance above is general.
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
Nothing recorded for City of Dorris on this step yet — 3 questions checked and found unpublished. The guidance above is general.
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
Nothing recorded for City of Dorris on this step yet — 4 questions checked and found unpublished. The guidance above is general.
14 questions answered against City of Dorris’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone (and/or mail/in-person, consistent with the city's paper-only intake) — the city's single published number, 530-397-3511, is used for all department contact including Building; no online booking tool exists.
Why the confidence is not higherThe Building Department page lists only the general city phone line and P.O. Box address; the Permit Application form directs inspection requests generically without naming a portal. Because building services are contracted to the City of Weed, it is possible inspection requests are ultimately routed to Weed staff, but no separate public booking channel for Weed's Dorris work was found — this is the best-evidenced answer, not a certainty.
department page (inference from paper-based intake) checked 2026-08-31 https://www.dorrisca.us/departments/building/
Q50 How much notice is required? Core Booking & scheduling
24 hours in advance.
Why the confidence is not higherPrinted on the city's own Permit Application form (OCR-read): 'INSPECTION MUST BE REQUESTED 24 HOURS IN ADVANCE.'
permit application form (OCR) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/10/Building-Permit-Form.pdf
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedthe Building Department page and the OCR-read Permit Application form, for any mention of same-day service or AM/PM inspection windows — neither addresses scheduling granularity beyond the 24-hour-notice rule at Q50.
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Delegated
Why the confidence is not higherThe city's own current General Plan (Sept 2025) states outright: 'The City of Weed Building Department, which the City contracts with for plan check and building inspection services, ensures that all new construction complies with the standards in effect...' — Dorris does not perform its own inspection in-house; it is contracted to a neighbouring city's Building Department (the Oakdale/Modesto shape, not the LACoFD-retained-scope shape).
general plan (current, first-party statement) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/5.0-Dorris-Open-Space-and-Conservation-Element.pdf
Q53 If delegated, to whom? Core Who inspects
City of Weed Building Department
Why the confidence is not higherSame General Plan citation as Q52, naming 'The City of Weed Building Department' explicitly as the contracted plan-check and inspection provider for the City of Dorris.
general plan (current, first-party statement) checked 2026-08-31 https://www.dorrisca.us/wp-content/uploads/2025/09/5.0-Dorris-Open-Space-and-Conservation-Element.pdf
Q54 Which inspections are required, and in what order? Core Stages & sequence
Nothing published by this authority.
Where we lookedthe fee schedule (which lists BLDG/ELEC/PLUMB/HEAT/PLAN CK sub-fee categories but no staged inspection sequence) and the Residential checklist (silent on inspection stages), for a published PV-specific inspection sequence — none found.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedthe same fee schedule and checklist, for a stated rough-in or mid-roof inspection requirement — neither mentions one.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q56 Does the inspector verify labels and listings? Core What is checked
Nothing published by this authority.
Where we lookedthe Building Department page and all checklists, for an explicit statement that the field inspector verifies labels and equipment listings — not stated (though the operative state electrical code's own labeling requirements would apply as a matter of code, no Dorris document says the inspector specifically checks for them).
Q57 Is there a published inspection checklist? Core What is checked
Nothing published by this authority.
Where we lookedthe Building Department page's full list of published forms — the only checklists found are pre-permit submittal/routing sheets (Residential, Manufactured Home, Commercial), not a field-inspection checklist for solar or for building permits generally.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q58 What must be on site at inspection? Core Documents on site
Nothing published by this authority.
Where we lookedthe Permit Application form and Residential checklist, for a stated list of documents required to be on site at time of inspection — not found; neither document addresses this.
https://www.dorrisca.us/wp-content/uploads/2019/10/Checklist_for_Residential_Plan_Submission.pdf
Q59 Is there a re-inspection fee? Corrections & re-inspection
Nothing published by this authority.
Where we lookedthe full 2019 Building Fees schedule (both pages, OCR/pdftotext-read in full) for a stated re-inspection fee line — none found; the schedule prices 'Inspections outside of normal business hours' at $90.00/hour but has no distinct 're-inspection' line item, unlike Weed's schedule which does.
https://www.dorrisca.us/wp-content/uploads/2019/11/2019-Bld-FEES-Proposed.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Nothing published by this authority.
Where we lookedthe Building Department page, Permit Application form, and fee schedule, for a stated corrections/re-inspection process — not described in any of them.
https://www.dorrisca.us/wp-content/uploads/2019/11/2019-Bld-FEES-Proposed.pdf
Q61 What is issued on pass? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedthe Building Department page, Permit Application form, and fee schedule, for what is issued on passing a residential solar inspection (CO / Final / Green tag / Letter) — none of Dorris's own documents name a specific sign-off document or use 'green tag' terminology (unlike Weed's fee schedule, which does).
https://www.dorrisca.us/wp-content/uploads/2019/11/2019-Bld-FEES-Proposed.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedPacific Power's own customer-generation process page and Dorris's own documents, for who notifies the utility for PTO on a Dorris address specifically — Pacific Power's general California process (uploading inspection approval + safety-sign photos via its PowerClerk portal) is confirmed at Q23, but no Dorris-specific statement of who performs this step (installer vs. AHJ) was found; recorded here rather than assumed to be identical to the generic utility-side process.
https://www.pacificpower.net/savings-energy-choices/customer-generation.html
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Dorris against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Dorris is the authority having jurisdiction 88% confidence
- Holds
- Building and Electrical, both administered on the city's behalf under a services CONTRACT with the City of Weed Building Department (plan check and inspection); Dorris remains the legal permit-issuing AHJ of record — this is a city-to-neighbouring-city delegation, not a county or firm delegation.
- Delegated to
- City of Weed Building Department (plan check + building inspection, by contract)
- Overridden by
- CA Gov. Code §65850.5 (AB 2188) requires an expedited/ministerial small-residential-solar process, which Dorris does NOT appear to have codified (control-checked absence, see Q28); AB 130 (Stats. 2025 Ch. 22) bars the city from adopting any MORE-restrictive residential amendment through 1 Jun 2031; Pacific Power's own NB-136 tariff separately requires a completed interconnection agreement before energization, and its own visible-disconnect/placard rules (Policy 138, DER Interconnection Policy) apply in addition to whatever the city requires.
- Why not higher
- The city's own Building Department page states it enforces the California Building/Electrical/Plumbing/Mechanical Code, Uniform Housing Code and Uniform Code for the Abatement of Dangerous Buildings within city limits, and issues its own permit application, checklists and fee schedule under its own name/address (307 S Main St, Dorris) — establishing Dorris, not Siskiyou County, as the AHJ. But the SAME page states plainly: 'The City contracts with the City of Weed for these services' (confirmed by direct HTML fetch of the live page, not a WebFetch summary), and the city's own current (Sept 2025) General Plan Open Space & Conservation Element independently confirms: 'The City of Weed Building Department, which the City contracts with for plan check and building inspection services, ensures that all new construction complies with the standards in effect on the date a building permit application is made.' This is the Oakdale/Modesto shape from the survey playbook — a city retains legal AHJ status and its own fee schedule while a neighbouring city's department performs the actual plan check and inspection. Siskiyou County's own permit page (checked in the county's separate file) says incorporated cities perform their own permit review, consistent with Dorris being a distinct AHJ from the county.
- Permit required
- Yes92%
- Permit cost
- $400.00 flat (system 10 kW or less); $500.00 flat (system greater than 10 kW) — both under Electrical Fees.85%
- Portal
- None — no online permit portal exists. Applications and plans are submitted on paper by mail (P.O. Box 768) or in person at 307 S. Main St.88%
- Own placard wording
- No75%
- Booking an inspection
- Phone (and/or mail/in-person, consistent with the city's paper-only intake) — the city's single published number, 530-397-3511, is used for all department contact including Building;60%
Labels & placards for this authority
Wording 75%
No
Size, colour & material 75%
No
Where they go 88%
Dorris's own documents are silent on placement. Pacific Power (the utility) requires: a placard on/next to the utility meter base; a placard on/next to the AC knife-blade disconnect; a placard on the battery disconnect if present; and the customer-side visible disconnect switch itself must be 'located within sight and within 10 feet of the utility meter,' accessible to PacifiCorp personnel and capable of being locked open.
What the utility wants on top 92%
Yes — extensively, by the utility. Pacific Power's own 'Engraved Placard Examples' document (current, ModDate 22 Oct 2025) specifies: 3/8-inch lettering on all placards; red background with white lettering, sized to fit the meter base and AC disconnect switch; a placard on/next to the utility meter base; a placard on/next to the AC knife-blade disconnect for the solar system; a placard on the Battery Disconnect if present (may combine with the manual/DC disconnect label if systems share one disconnect); and, if a 'director' placard is required, lettering at least 9mm (1/4') tall (≈25pt Arial), sized roughly 5x5 inches for readability. Effective 11/1/2025 the utility also requires close-up AND distant photos of the meter/disconnect (with the meter number visible) uploaded with the application. Battery E-stop/manual disconnects must be lockable, accessible, clearly indicate open/closed position, and (per Pacific Power's DER Interconnection Policy, Rev. 12, 5/26/2026) be located within sight and within 10 feet of the utility meter.
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
