City of Dos Palos

Merced County

Verified Aug. 4, 2026

City of Dos Palos is a city authority in the State of California, serving 5,798 residents. 705 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

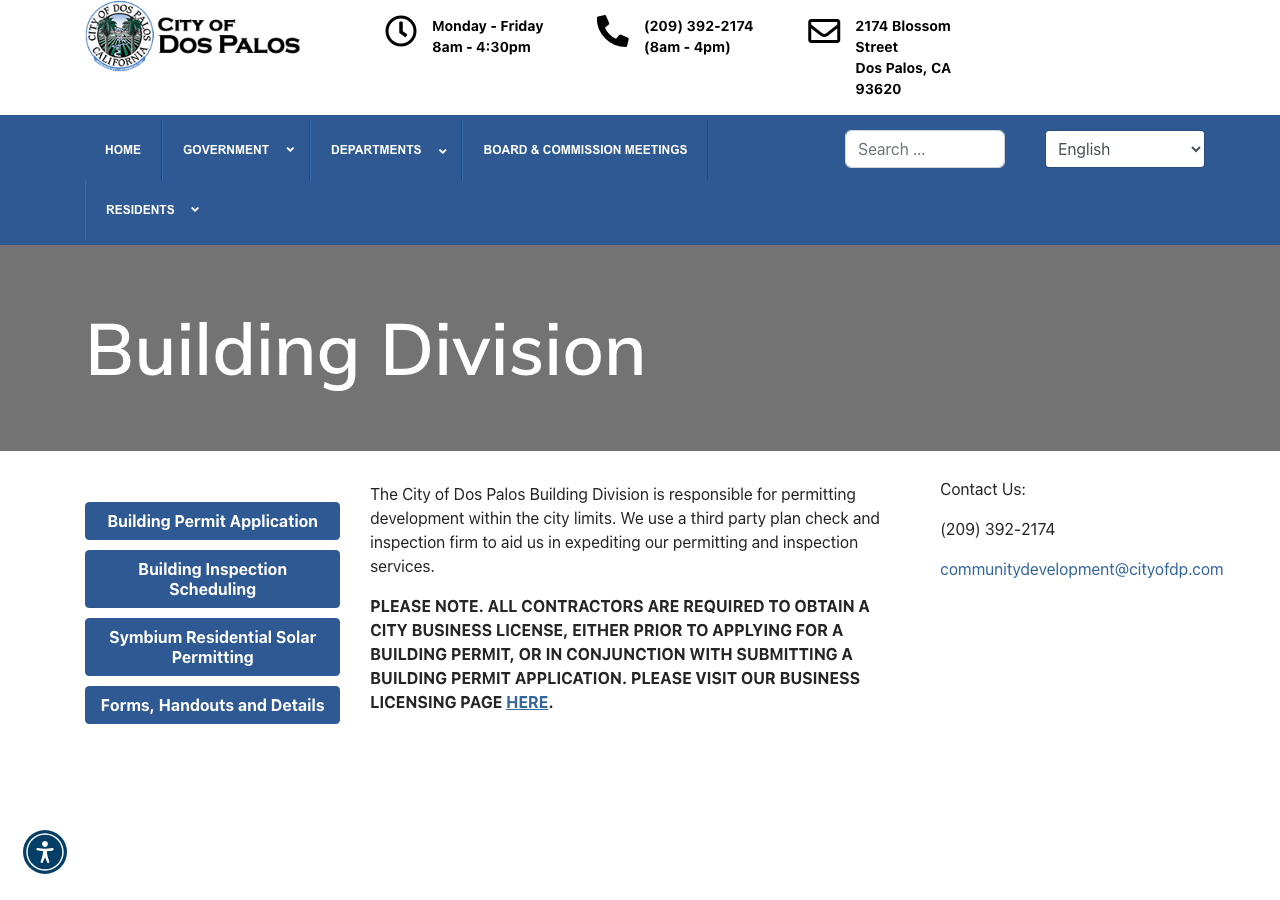

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Instantaneous/same-day for systems that qualify and are submitted through the Symbium SB 379 automated portal; Q18 Where you file — Symbium (for qualifying residential rooftop solar); paper/in-person application at City Hall for everything else, including non-qualifying solar Q20

Permit required
Yes90% source
Plan review turnaround
Instantaneous/same-day for systems that qualify and are submitted through the Symbium SB 379 automated portal; no published turnaround for the in-person/manual pathway75% source
Key document
permit application form / municipal code cited by 8 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? No separate published checklist exists; the only published submittal requirement is the one-page 'Application for Building Permit' itself, which collects: project description; owner name/address/phone; contractor name/license#/class/expiration; job address, APN, lot #, use, occupancy, project sq. ft. and valuation; a dedicated Photovoltaic block (new/revision/panel upgrade, module count, kW); Planning Dept. fields (subdivision, zone, setbacks, flood zone); and licensed-contractor/owner-builder/workers'-comp declarations. 58% · permit application form
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

28 questions answered against City of Dos Palos’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherThe city's own 'Application for Building Permit' includes a mandatory dedicated Photovoltaic section (New/Revision/Panel Upgrade, Modules, kW) and the city's Community Development page runs a Symbium SB 379 automated solar-permitting portal for 'residential roof mount solar application submittals.'

permit application form checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherThe single Building Permit Application carries both a 'Project Type: Electrical' checkbox and a 'PME' (Plumbing/Mechanical/Electrical) fee line alongside the base 'Building Permit' fee — one permit, both trades — issued directly by named in-house Community Development/Building staff. No staffing-firm domain, contract-firm name, or county cross-reference found anywhere searched (code, fee clauses, department page, portal domain).

permit application form checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherThe dedicated Photovoltaic block on the mandatory Building Permit Application, plus MC §15.04.020(A): 'A building permit must be obtained from the city building department prior to the commencement of construction.'

permit application form / municipal code checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherOne application form carries one 'Building Permit Number' field and lists 'Building Permit' and 'PME' (which bundles electrical) as line items on the SAME fee block, rather than a separate electrical-only application. No standalone electrical-permit application was found anywhere on the city's site.

permit application form checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe permit application provides both a 'Licensed Contractor Declaration' (license #, class, expiration) block AND a separate 'Owner-Builder Declaration' block citing the Contractor's License Law exemption (Bus. & Prof. Code Ch. 9, Div. 3) for an owner performing or contracting the work themselves.

permit application form checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Yes

Why the confidence is not higherMC §5.04.160 ('Rate — Contractors'), Title 5 Business Licenses, requires every general, electrical, plumbing, and specialty contractor doing work in the city to hold a city business license before working ('...or electrical contractor... who holds a valid state contractor's license, shall pay an annual license fee...'), and the Building Permit Application itself has a 'CITY BUSINESS LICENSE' field for the contractor. Confidence is capped because the codified dollar figures date to 1978 and no current fee resolution was found online — the registration REQUIREMENT itself, however, is unambiguous and reflected on the current-use application form.

municipal code (MC §5.04.160) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherThe permit application's 'Owner-Builder Declaration' lets an owner self-certify exemption from the Contractor's License Law and perform (or personally contract) all the work themselves, with an accompanying Workers' Compensation exemption certificate block — standard California owner-builder self-permit provision, present on the city's own form.

permit application form checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q8 What documents make up a complete submittal? Core Submittal package

No separate published checklist exists; the only published submittal requirement is the one-page 'Application for Building Permit' itself, which collects: project description; owner name/address/phone; contractor name/license#/class/expiration; job address, APN, lot #, use, occupancy, project sq. ft. and valuation; a dedicated Photovoltaic block (new/revision/panel upgrade, module count, kW); Planning Dept. fields (subdivision, zone, setbacks, flood zone); and licensed-contractor/owner-builder/workers'-comp declarations.

Why the confidence is not higherChecked the Community Development page, the 'Applications' page, and the Symbium solar-permitting page — none link a separate PV submittal checklist or list of required drawings beyond this one application form. A two-person Community Development office (per its own staff listing) is consistent with no separate checklist having been produced.

permit application form checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q9 How many copies, and in what format? Submittal package

Nothing published by this authority.

Where we lookedThe one-page 'Application for Building Permit' form itself (no copy-count/format instruction on it), the Community Development page, and the Applications page — none state how many copies or in what format (paper vs. digital) a submittal must be made.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q10 Is a site plan required, and what must it show? Core Submittal package

Nothing published by this authority.

Where we lookedBuilding Permit Application (has Planning-review fields — subdivision, lot, zone, setbacks, flood zone — implying a site plan is used, but never states 'a site plan is required' or what it must show); Community Development page; no separate checklist found.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Nothing published by this authority.

Where we lookedFull-text search of the 578-page codified municipal code (0 'solar'/'photovoltaic' hits) plus the Building Permit Application and the Symbium solar page — none mention a one-line/three-line diagram requirement.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q12 Are string and conductor calculations required? Drawings & calculations

Nothing published by this authority.

Where we lookedSame full-text search as Q11 — no mention of string or conductor calculation requirements anywhere in the available code or forms.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Nothing published by this authority.

Where we lookedFull-text search of Title 15 (Buildings and Construction) and the Building Permit Application — no structural PE-stamp threshold stated; the code delegates structural review generically to whichever model code is adopted by resolution, which is not published online.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedSame search as Q13 — no electrical PE-stamp threshold found anywhere in the available code or forms.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q15 What does a residential solar permit cost? Core Fees

Nothing published by this authority.

Where we lookedBuilding Permit Application's fee block (Building Permit, City Impact, PME, County Impact, Plan Check, Planning, SMI, Deposit, Green Fee SB1473 — all dollar fields left blank/case-specific); Community Development page; Applications page; no Master Fee Schedule PDF was found anywhere on the city's site, so no flat or per-kW dollar figure exists to record.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q16 How is the fee calculated? Core Fees

Valuation

Why the confidence is not higherMC §15.04.020(C): 'The determination of value or valuation under any provisions of these codes shall be made by the building official. The value to be used in computing the building permit and building plan review fees shall be as set forth in the building valuation data as published by the International Conference of Building Officials (ICBO) quarterly.' The Building Permit Application itself has a 'VALUATION: $______' field feeding the fee block. Confidence capped because the cited source (ICBO) merged into the ICC in 2003 and the clause has not been updated in the online text — a live/current valuation table was not independently located, and no flat/per-kW schedule was found anywhere to contradict a valuation basis.

municipal code (MC §15.04.020) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q17 Is there a separate plan-check fee? Fees

Yes

Why the confidence is not higherMC §15.04.020(B): 'When building plans or other data are required to be submitted, a plan review fee shall be paid at the time of submitting plans and specifications for review. Said plan review fee shall be sixty-five percent of the building fee.' Also reflected as a separate 'Plan Check' line on the Building Permit Application fee block.

municipal code (MC §15.04.020) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Instantaneous/same-day for systems that qualify and are submitted through the Symbium SB 379 automated portal; no published turnaround for the in-person/manual pathway

Why the confidence is not higherCity's solar page: 'Contractors and homeowners seeking to pull permits under SB 379 will be able to apply for instantaneous plan review approval via this Symbium portal.' Non-qualifying systems or those submitted in person at City Hall have no stated turnaround anywhere on the site.

department page checked 2026-08-31 https://dospaloscity.wixsite.com/dospalos/general-5-1

Q19 How long is an issued permit valid before it expires? Timeline & validity

Nothing published by this authority.

Where we lookedFull-text search of Title 15 (Buildings and Construction), including MC §15.04 in full — no permit-expiration/validity clause found for building permits specifically (the few 'expire' hits found concern business-license and other unrelated permits).

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q20 Which permit portal does this authority use? Core Portal & process

Symbium (for qualifying residential rooftop solar); paper/in-person application at City Hall for everything else, including non-qualifying solar

Why the confidence is not higherCity's own page: 'The City is proud to offer online residential roof mount solar application submittals powered by Symbium... applicants seeking to apply for residential roof top systems or energy storage systems outside of the platform, or for those that are disqualified from utilizing the system, can still submit applications in person at City Hall.' No other online permit portal (e.g. Accela/eTRAKiT/OpenGov) was found for general building permits — the Building Permit Application is a static Word document, and the city's own SB 272 disclosure page lists Accela/Springbrook only for utility billing, finance, and business licensing, not building permits.

portal landing page checked 2026-08-31 https://dospaloscity.wixsite.com/dospalos/general-5-1

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherFor a qualifying system, the Symbium flow is described as fully online ('apply for instantaneous plan review approval via this Symbium portal... begin your application below by first verifying the address is within our city limits'). Non-qualifying systems require an in-person application, so 'Yes' applies to the qualifying pathway only.

portal landing page checked 2026-08-31 https://dospaloscity.wixsite.com/dospalos/general-5-1

Q22 Which utility handles interconnection here? Core Utility interconnection

Pacific Gas & Electric (PG&E)

Why the confidence is not higherDos Palos is on the west side of Merced County, outside the two publicly owned utilities in the county — Merced Irrigation District (serves Merced, Livingston, Winton, Atwater and the Castle Airport area, per MID's own 2023-2025 Wildfire Mitigation Plan) and Turlock Irrigation District (serves Delhi, Hilmar, Ballico). The City's own 'Pay Your Utility Bill' page is water/sewer billing only — there is no city-operated electric utility — consistent with the area being served by the investor-owned PG&E rather than a municipal utility. No Dos Palos-specific document naming PG&E was found in this run, so confidence is capped rather than treated as confirmed; this is cross-boundary inference, not a city-side or utility-side statement naming Dos Palos.

inference from adjacent public-utility service-territory documents + absence of a city electric utility checked 2026-08-31 https://mercedid.org/wp-content/uploads/2024/07/Master-Final_MEID-2023-2025-WMP_2024.pdf

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit (parallel submission allowed, but Permission to Operate is conditioned on the AHJ's final inspection sign-off)

Why the confidence is not higherPG&E Electric Rule 21, Section D.13.b (Advice 7692-E, effective 29 Aug 2025), extracted directly from the current tariff PDF: PTO 'shall normally be processed not later than thirty (30) Business Days' after PG&E receives the completed interconnection request, the signed interconnection agreement, AND 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction over the Generating Facility.' This is a statewide PG&E tariff provision, not a Dos Palos-specific document, and rests on Q22's PG&E determination being correct.

utility tariff (Electric Rule 21) checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No

Why the confidence is not higherNo HOA/architectural-approval requirement appears anywhere in the Building Permit Application (which has a dedicated Planning Department approval block listing subdivision, zone, setbacks and flood-zone fields, but nothing about HOA sign-off) or in the codified zoning title. Absence, not an explicit exemption statement.

permit application form checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q25 Is there a historic-district review? Overlays & special cases

No

Why the confidence is not higherFull-text search of the codified Title 17 Zoning (and the whole 578-page code) found no historic-district overlay zone; every 'historic' hit (searched and read individually) concerns exemptions for 'historical signs' in the sign-code chapter, not a building/site review district. Controls: 'building' 756 hits, 'zzqqx' (fabricated) 0 hits — search apparatus proven functional.

municipal code (full-text search) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherNo windstorm/wind-load certification requirement (the Texas-TDI-style concept) appears anywhere in the codified building title; the only 'wind' hits found concern earthquake/wind damage thresholds for condemning a dangerous building (MC Ch. 15.12), unrelated to a solar-specific certification.

municipal code (full-text search) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

No — state law (Gov. Code §65850.5(b)) bars requiring discretionary review/CUP/Council approval for a qualifying small residential rooftop system, and the city's own zoning title (Title 17) contains no solar-specific use-permit trigger

Why the confidence is not higherFull-text search of the codified zoning title returned zero 'solar'/'photovoltaic' hits (control-checked: 'building' 756, fabricated 'zzqqx' 0), so there is no local CUP/SUP trigger written for solar; state law separately forecloses one for qualifying systems.

municipal code (full-text search) + state law checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No local system-size cap is codified. (State law separately defines a 'small residential rooftop solar energy system' for ministerial/expedited treatment purposes under Gov. Code §65850.5(j), but Dos Palos has no additional local kW ceiling of its own.)

Why the confidence is not higherFull-text search of the entire codified municipal code (Title 15 Buildings, Title 17 Zoning) returned zero 'solar'/'photovoltaic' hits. Controls: positive control 'electrical' 27 hits, 'building' 756 hits; fabricated control 'zzqqx' 0 hits — proves the search worked rather than the document being unreadable.

municipal code (full-text search) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Are there local amendments to any of the above? No PV/solar-specific local amendments found (0 hits, control-checked). The city's Ch. 15.04 does contain limited local administrative/fee amendments to whatever model codes are adopted (e.g. the 65%-of-building-fee plan-review formula), but nothing technical or solar-specific. 58% · municipal code (full-text search)
    • What is the installation judged against? Whichever current editions of the state-mandated Title 24 California Building Standards Code (CBC/CRC/CEC/CFC/CPC/CMC) the City Council has most recently adopted by resolution under MC §15.04.010 50% · municipal code (MC §15.04.010)
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    Nothing recorded for City of Dos Palos on this step yet — 1 question checked and found unpublished. The guidance above is general.

  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    Nothing recorded for City of Dos Palos on this step yet — 1 question checked and found unpublished. The guidance above is general.

  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? None specified — no placard/label content of any kind is codified or published by the city for PV/solar service equipment 75% · municipal code (full-text search)
    • Does the authority specify placard wording of its own? No 78% · municipal code (full-text search)
    • Does it specify letter height, colour or material? No — no letter height, colour, or material spec exists locally 76% · municipal code (full-text search)
    • Does the UTILITY specify placards beyond the AHJ's? Yes — PG&E requires an engraved placard on the metering equipment wherever a line/supply-side connection is used 55% · utility DG manual (PG&E Greenbook)
    • Where must the labels be placed? On the metering equipment, for a line/supply-side tap connection (PG&E) 55% · utility DG manual (PG&E Greenbook)
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Where must the AC disconnect be, relative to the meter? PG&E sets no fixed distance for the typical residential case. For a single-phase, self-contained, socket-based meter panel rated 320A or less, PG&E does not require an AC disconnect at all; where one IS required (all other panel types), it must be PG&E-approved per Electric Design Standard 060559. 58% · utility DG manual (PG&E Greenbook)
    • Is a ground mount treated as a structure? Yes (by inference from the general zoning definition) 58% · municipal code (MC §17.08.050)

20 questions answered against City of Dos Palos’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

Nothing published by this authority.

Where we lookedMC §15.04.010 provides that adopted code editions are set 'by resolution' and kept on file 'in the office of the building inspector for public record' — not published online. The codified text itself only carries historical adoption entries ('National Electrical Code, 1962') that are 60+ years stale. No current adoption ordinance/resolution naming a specific NEC/CEC edition was found on the city's website.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q30 Which building code edition is in force? Core Code editions in force

Nothing published by this authority.

Where we lookedSame as Q29 — no current building-code edition number found online; §15.04.010's mechanism defers to a resolution on file at the building department that is not published on the city's website.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q31 Which fire code edition is in force? Code editions in force

Nothing published by this authority.

Where we lookedSame as Q29/Q30. The codified text's only fire-code references are to the defunct 'Uniform Fire Code' nomenclature from 1990s amendment entries in the ordinance-history table; no current California Fire Code edition/cycle is named anywhere on the city's website.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q32 Are there local amendments to any of the above? Core Code editions in force

No PV/solar-specific local amendments found (0 hits, control-checked). The city's Ch. 15.04 does contain limited local administrative/fee amendments to whatever model codes are adopted (e.g. the 65%-of-building-fee plan-review formula), but nothing technical or solar-specific.

Why the confidence is not higherZero 'solar'/'photovoltaic' hits across the full 578-page codified text (controls: 'electrical' 27, 'building' 756, fabricated 'zzqqx' 0). Cannot be fully verified against the CURRENT adopted code cycle because the current adoption resolution referenced in §15.04.010 is kept on file at the building department and is not published online.

municipal code (full-text search) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q33 What is the installation judged against? Core Electrical

Whichever current editions of the state-mandated Title 24 California Building Standards Code (CBC/CRC/CEC/CFC/CPC/CMC) the City Council has most recently adopted by resolution under MC §15.04.010

Why the confidence is not higherMC §15.04.010: 'The city council... shall have the power to designate, adopt... any uniform codes by resolution. A copy of each code adopted is on file in the office of the building inspector for public record and inspection.' This confirms the MECHANISM but the specific current edition numbers are not published online — the file that would name them (the adopting resolution) could not be located on the city's website.

municipal code (MC §15.04.010) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Nothing published by this authority.

Where we lookedFull-text search of Title 15 for service-upgrade/busbar local amendments — 0 'solar'/'photovoltaic' hits and no general electrical-amendment chapter found beyond the bare adoption-by-resolution clause (§15.04.010).

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Nothing published by this authority.

Where we lookedSame full-text search as Q34 — no mounting-system/attachment-spacing requirement found anywhere in the code or on the city's published pages.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Nothing published by this authority.

Where we lookedFull-text search of the Fire Zone chapter (MC Ch. 15.08, a 1958 geographic-boundary ordinance unrelated to PV) and the whole code for 'setback'/'pathway' in a fire-code-PV context — 0 'solar'/'photovoltaic' hits.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Nothing published by this authority.

Where we lookedFull-text search of the entire 578-page codified code for 'rapid shutdown' and '690.12' — 0 hits for both (control-checked against 'electrical' 27 hits and fabricated 'zzqqx' 0 hits). No separate PV/electrical bulletin publishes this either.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

None specified — no placard/label content of any kind is codified or published by the city for PV/solar service equipment

Why the confidence is not higherFull-text search of the entire 578-page codified code for 'solar,' 'photovoltaic,' 'placard,' and PV-relevant 'disconnect' language returned zero on-topic hits; the 10 generic 'disconnect' hits found are all about cable-franchise, water-service, or property-tax disconnection, unrelated to electrical/PV signage. Controls: 'electrical' 27, 'building' 756, fabricated 'zzqqx' 0.

municipal code (full-text search) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

No

Why the confidence is not higherSame absence proven for Q38 — zero codified or published placard wording of any kind, control-checked (fabricated 'zzqqx' 0 hits, positive controls 'electrical'/'building' both hit as expected).

municipal code (full-text search) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

No — no letter height, colour, or material spec exists locally

Why the confidence is not higherSame absence as Q38/Q39; there is no placard requirement of any kind to attach such a specification to.

municipal code (full-text search) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedFull-text search of the code and the Building Permit Application for a facility-map/site-plan placard requirement (NEC/CEC §705.10 territory) — no local elaboration found, and since the currently-adopted electrical code edition itself could not be confirmed (see Q29), the parameters of any default §705.10 requirement cannot be stated with confidence.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes — PG&E requires an engraved placard on the metering equipment wherever a line/supply-side connection is used

Why the confidence is not higherPG&E's current Electric & Gas Service Requirements manual (TD-7001M-06, 'Greenbook', Rev. 2026-04, effective 22 Jun 2026), Section 6.3, Table 6-3 note (a), extracted directly: 'A fusible AC disconnect switch is required for generator interconnections ahead of the main breaker (line/supply side connection) and after the meter. Also required is an engraved placard (signage), indicating there is a line/supply side connection, installed on the metering equipment.' This is a statewide PG&E requirement, not Dos Palos-specific, and depends on the Q22 utility determination.

utility DG manual (PG&E Greenbook) checked 2026-08-31 https://www.pge.com/assets/pge/docs/account/service-requests/greenbook-manual-full.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

On the metering equipment, for a line/supply-side tap connection (PG&E)

Why the confidence is not higherSame PG&E Greenbook Table 6-3 note (a) as Q42: the engraved line/supply-side placard is required 'installed on the metering equipment.' Utility-level, not Dos Palos-specific.

utility DG manual (PG&E Greenbook) checked 2026-08-31 https://www.pge.com/assets/pge/docs/account/service-requests/greenbook-manual-full.pdf

Q44 Must equipment be on a specific approved list? Equipment listing

Nothing published by this authority.

Where we lookedFull-text search of the code and the Building Permit Application — no equipment-listing requirement (e.g. UL-listing reference) stated anywhere locally.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Nothing published by this authority.

Where we lookedFull-text search of the entire code for 'battery'/'energy storage' — 3 hits total, all unrelated (a rate-schedule 'battery' typo referencing car batteries, a criminal 'assault, battery' cross-reference, and a zoning use-list 'battery service, charging and replacement' entry for auto-service uses) — no PV/ESS-specific provision exists.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q46 Is there a separate ESS permit or inspection? Battery / ESS

Nothing published by this authority.

Where we lookedSame search as Q45 — no separate ESS permit or inspection requirement found anywhere in the available code or forms.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q47 Is a ground mount treated as a structure? Core Ground mount

Yes (by inference from the general zoning definition)

Why the confidence is not higherMC §17.08.050 defines 'Accessory building' broadly as 'a building, part of a building, OR STRUCTURE which is subordinate to, and the use of which is incidental to that of the main building, structure or use on the same lot' — a ground-mount PV array would fall under this definition and be subject to the accessory-structure setback rules in Title 17 (e.g. §17.30 property development standards). No PV-specific exemption or clarification was found anywhere in the code (0 'solar'/'photovoltaic' hits), so this is inference from the general definition, not an explicit statement.

municipal code (MC §17.08.050) checked 2026-08-31 https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_05993cb48232484cbab6aadc06f20877.pdf

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

PG&E sets no fixed distance for the typical residential case. For a single-phase, self-contained, socket-based meter panel rated 320A or less, PG&E does not require an AC disconnect at all; where one IS required (all other panel types), it must be PG&E-approved per Electric Design Standard 060559.

Why the confidence is not higherPG&E Greenbook (TD-7001M-06, Rev. 2026-04, eff. 22 Jun 2026) Section 6.3, Table 6-3 'Requirements for AC Disconnect Switches,' extracted directly: 'Self-Contained Meter Panel, Socket-Based, 320 Amps or Less (Continuous Current Rating) — Single — No[2]... All Other Self-Contained or Transformer-Rated Meter Panels — All — Yes... 2 If an ac-disconnect switch is installed, it must be PG&E approved.' Utility-level, not Dos Palos-specific, and depends on the Q22 utility determination.

utility DG manual (PG&E Greenbook) checked 2026-08-31 https://www.pge.com/assets/pge/docs/account/service-requests/greenbook-manual-full.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    Nothing recorded for City of Dos Palos on this step yet — 3 questions checked and found unpublished. The guidance above is general.

  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 62% · department page
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    Nothing recorded for City of Dos Palos on this step yet — 2 questions checked and found unpublished. The guidance above is general.

  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

14 questions answered against City of Dos Palos’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Nothing published by this authority.

Where we lookedCommunity Development page and Applications page — both give only the general office phone/email (209-392-2174, cityofdp@cityofdp.com) with no explicit statement that this is how inspections specifically are booked, and no online booking portal was found for inspections.

https://dospaloscity.wixsite.com/dospalos/services-7

Q50 How much notice is required? Core Booking & scheduling

Nothing published by this authority.

Where we lookedSame pages as Q49 — no stated notice period for scheduling an inspection.

https://dospaloscity.wixsite.com/dospalos/services-7

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Nothing published by this authority.

Where we lookedSame pages as Q49 — no mention of same-day or AM/PM inspection windows.

https://dospaloscity.wixsite.com/dospalos/services-7

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherNo delegation evidence found anywhere (no staffing-firm email domain, no contract-firm name, no county cross-reference); the Community Development page names in-house city staff running 'Building Permits' as one of its four functions, and the city itself (not Merced County) operates the SB 379 solar portal. No explicit statement that the city 'performs its own final solar inspection' was found — this is inference from the absence of any delegation evidence.

department page checked 2026-08-31 https://dospaloscity.wixsite.com/dospalos/services-7

Q53 If delegated, to whom? Core Who inspects

Nothing published by this authority.

Where we lookedCommunity Development staff/department page, Building Permit Application, and the whole site's department listings — no delegation to any other agency or firm was found anywhere (see Q52).

https://dospaloscity.wixsite.com/dospalos/services-7

Q54 Which inspections are required, and in what order? Core Stages & sequence

Nothing published by this authority.

Where we lookedCommunity Development page and Building Permit Application — neither publishes a sequence of required inspections (rough, mid-roof, final, etc.) for any permit type, PV or otherwise.

https://dospaloscity.wixsite.com/dospalos/services-7

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

Nothing published by this authority.

Where we lookedSame sources as Q54 — no statement on whether a rough-in or mid-roof inspection is required.

https://dospaloscity.wixsite.com/dospalos/services-7

Q56 Does the inspector verify labels and listings? Core What is checked

Nothing published by this authority.

Where we lookedSame sources as Q54 — no published statement on what an inspector checks (labels/listings) at final.

https://dospaloscity.wixsite.com/dospalos/services-7

Q57 Is there a published inspection checklist? Core What is checked

No

Why the confidence is not higherChecked the Community Development page, the Applications page, and the Symbium solar page — none link a published inspection checklist. The only itemized document found anywhere is the one-page Building Permit Application, which is a submittal form, not an inspection checklist.

department page (absence) checked 2026-08-31 https://dospaloscity.wixsite.com/dospalos/services-7

Q58 What must be on site at inspection? Core Documents on site

Nothing published by this authority.

Where we lookedSame sources as Q54 — no published list of documents required to be on site at inspection.

https://dospaloscity.wixsite.com/dospalos/services-7

Q59 Is there a re-inspection fee? Corrections & re-inspection

Nothing published by this authority.

Where we lookedBuilding Permit Application fee block (no re-inspection line item) and the absence of any published Master Fee Schedule anywhere on the city's site (see Q15).

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Q60 How are corrections issued and cleared? Corrections & re-inspection

Nothing published by this authority.

Where we lookedCommunity Development page and Building Permit Application — neither describes a corrections/re-inspection process.

https://dospaloscity.wixsite.com/dospalos/services-7

Q61 What is issued on pass? Core Final sign-off & PTO

Nothing published by this authority.

Where we lookedCommunity Development page and Building Permit Application — neither states what document (CO, Final, green tag, letter) is issued on a passed inspection.

https://dospaloscity.wixsite.com/dospalos/services-7

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer

Why the confidence is not higherPG&E Electric Rule 21 §D.13.b requires the 'Applicant' to supply evidence of final AHJ inspection clearance and the signed interconnection agreement to trigger PTO; nothing in the Dos Palos municipal code assigns this task to the city. Utility-level inference (PG&E), not a Dos Palos-specific statement, and depends on the Q22 utility determination.

utility tariff (Electric Rule 21) checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Dos Palos against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Dos Palos is the authority having jurisdiction 82% confidence
Holds
Building and Electrical (self-performed, one combined City Building Permit)
Overridden by
CA Gov. Code §65850.5 (Solar Rights Act, as amended) bars discretionary review/CUP requirements and mandates streamlined ministerial review for a 'small residential rooftop solar energy system'; Gov. Code §65850.52 (SB 379, 2022) requires automated online permitting, implemented here through the city's own Symbium portal; AB 130 (Stats. 2025, Ch. 22) freezes the city from adopting any residential building-standard amendment more restrictive than the state model code from 1 Oct 2025 to 1 Jun 2031.
Why not higher
The City's own mandatory 'Application for Building Permit' (Building Department, 2174 Blossom St.) has a dedicated Photovoltaic block (New/Revision/Panel Upgrade, module count, kW) alongside a 'Project Type: Electrical' checkbox on the SAME permit/fee form, and the city's own Community Development page (services-7) lists 'Building Permits' as an in-house function of two named city staff (Brian Guerrero, Director of Community Development; Debanni Aguayo, Building Permit Specialist), both on @cityofdp.com. MC §15.04.010 vests the City Council with the power to designate/adopt all uniform codes for the city, and a copy is kept on file 'in the office of the building inspector.' No staffing-firm email domain, no contract-firm name, and no county cross-reference were found anywhere (fee provisions, application form, department page, code). The city's own solar-permitting page confirms the CITY (not Merced County) partnered directly with Symbium to run its SB 379 automated portal. Confidence is not higher because (1) no current 'Building Official' title was found anywhere — only the generic 'Director of Community Development' and 'Building Permit Specialist' — so the CBC-defined role rests on inference, and (2) the city's only online codification is a stale 1999 recodification (last supplement Sept. 1998) that does not name current code editions; those are set 'by resolution' per §15.04.010 and are not published online, so the operative current adoption instrument could not be independently verified.

https://f5ca0191-561c-4909-b699-1919f897a4f9.filesusr.com/ugd/bd5ac3_efbe3a50ee27470285162150d75eec9a.doc

Permit required
Yes90%
Plan review
Instantaneous/same-day for systems that qualify and are submitted through the Symbium SB 379 automated portal; no published turnaround for the in-person/manual pathway75%
Portal
Symbium (for qualifying residential rooftop solar); paper/in-person application at City Hall for everything else, including non-qualifying solar88%
Own placard wording
No78%
Labels & placards for this authority

Wording 78%

No

Size, colour & material 76%

No — no letter height, colour, or material spec exists locally

Where they go 55%

On the metering equipment, for a line/supply-side tap connection (PG&E)

What the utility wants on top 55%

Yes — PG&E requires an engraved placard on the metering equipment wherever a line/supply-side connection is used

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Merced County
Regions served
1
Regions covered
City of Dos Palos · city
Solar Requirements
Separate roof inspection
Dos Palos California - Building Division Monday - Friday 8am - 4:30pm (209) 392-2174 (8am - 4pm) 2174 Blossom Street Dos Palos, CA 93620 Hours, Location, & Contact Monday - Friday 8am - 4:30pm (209) 392-2174 (8am - 4pm) 2174 Blossom Street Dos Palos, CA 93620 Home Government City Business City Counc
Authority Contact
Address
2174 Blossom Street, Dos Palos, CA 93620
Main Phone
(209) 392-2174
Building Department
Department
Building Division
Direct Phone
(209) 392-2174
Booking & Scheduling
Preferred channel
phone
Request an inspection
Notes
Call (209) 392-2174 to schedule final solar inspection. Building Division uses a third-party plan check and inspection firm. Hours: M–F 8am–4:30pm. Residential solar permits (plan approval only, not inspection scheduling) available via Symbium online portal at https://dospaloscity.wixsite.com/dospalos/general-5-1. Building Permit Technician: Debanni Aguayo (daguayo@cityofdp.com). Director of Community Development: Brian Guerrero (bguerrero@cityofdp.com). The city's primary website is dospalos.gov; legacy Wix site at dospaloscity.wixsite.com/dospalos still active. (collected Jul 2026)
