City of Downey

Los Angeles County

Verified Aug. 5, 2026

City of Downey is a city authority in the State of California, serving 114,355 residents. 2,835 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined into a single 'Photovoltaic Systems Permit' — the fee schedule lists one PV permit (with an 'Electrical Solar Issuance' component) plus one PV plan-check… Q4 Where you file — Accela Citizen Access (ACA) — https://aca-prod.accela.com/downey (also reached via https://permits.downeyca.org/CitizenAccess/Default.aspx) Q20

Permit required
Yes95% source
What it costs
≈$539.69 total for a residential system 15kW or under: $331.66 (Photovoltaic Systems Permit, residential ≤15kW) + $54.04 (Electrical Solar Issuance) + $153.99 (Photovoltaic Systems Plan Check,92% source
Key document
fee schedule cited by 4 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes — City of Downey Community Development Dept, Building & Safety Division is the AHJ for building/electrical; Downey Fire Department (own municipal dept) for fire. 95% · department page
    • What does this authority permit itself, and what does it delegate? Both — the city issues both building and electrical permits itself through the Building & Safety Division; fire plan review/inspection is handled by Downey's own Fire Department, not delegated to LA County. 90% · department page
    • Is a permit required for a residential rooftop PV system? Yes 95% · fee schedule
    • Is there a separate electrical permit, or is it combined? Combined into a single 'Photovoltaic Systems Permit' — the fee schedule lists one PV permit (with an 'Electrical Solar Issuance' component) plus one PV plan-check fee, issued separately from the base building permit for the house (the R-3 correction list explicitly says PV requires a separate permit from the main building permit). 75% · fee schedule / checklist
    • Is a wind or windstorm certification required? No — no windstorm/wind-load certification program (TDI-style) applies in this California jurisdiction; wind loading is addressed through CBC/ASCE 7 structural design, not a separate certification. 55% · inference from comparable CA practice
    • Is a Specific Use Permit or Council approval ever required? No CUP/Council approval required for a standard residential rooftop PV installation — Downey Municipal Code §9504 (Air Conditioning, Mechanical Roof, and Utility Equipment) explicitly exempts 'small wind energy systems, solar water heaters, solar power, or other passive solar energy systems' from the R-1/R-2 roof-mounted-equipment restrictions that would otherwise require screening/review. 65% · municipal code (zoning)
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Who is allowed to pull the electrical permit? Either — a CA-licensed contractor (typically C-46 Solar or C-10 Electrical), or the homeowner as an owner-builder after completing the owner-builder verification form. 75% · department page
    • Is a homeowner permitted to self-install and self-permit? Yes 90% · department page
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Permit application (with Preliminary Planning review); 4 sets of plans on 24x36" sheets; soils report (2 copies, if required); structural calculations (2 copies, wet-stamped and signed, if required); Title 24 energy analysis (2 sets of 8.5x11" with CF-1R/MF-1R forms); complete solar PV plans or documentation of an applicable code exception; site plan, floor plan, and structural plans per the Minimum Submittal Requirements checklist. 90% · published checklist
    • How many copies, and in what format? 4 complete sets of plans printed on 24"x36" sheets; 2 copies of structural calculations (wet-stamped/signed); 2 sets of 8.5"x11" Title 24 energy calculations; 2 copies of soils report if required. 90% · published checklist
    • Is a site plan required, and what must it show? Yes. Must show: existing site conditions (trees, fences, utility poles), all property lines with dimensions, setbacks from property lines/easements, adjacent street or alley, vicinity map and north arrow, building/structure location(s) and orientation, driveways/paved areas/walkways/landscaping, location and height of retaining walls and fences, plus an NPDES stormwater-discharge note. 90% · published checklist
    • Is a one-line / three-line diagram required? Yes (inferred) — the R-3 Standard Plan Check Correction List requires 'complete solar photovoltaic plans,' and the city's general electrical submittal rule requires 'a single-line diagram' whenever a service/system triggers full electrical plan review; SCE's Rule 21 also requires a submitted single-line diagram for the interconnection application. 65% · checklist / utility tariff
    • Are string and conductor calculations required? Likely yes, as part of 'complete solar photovoltaic plans' required by the R-3 correction list, but no Downey document explicitly names string/conductor sizing calculations for PV. 55% · checklist
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

    • Which permit portal does this authority use? Accela Citizen Access (ACA) — https://aca-prod.accela.com/downey (also reached via https://permits.downeyca.org/CitizenAccess/Default.aspx) 95% · portal landing page
    • Can the whole application be completed online? Yes (inferred) — the city has made online scheduling mandatory ('EFFECTIVE MAY 1st, 2025 All inspections must be scheduled through the online Accela Citizen Access Portal') and the same Accela instance is the destination for the permit-application link, consistent with full online application/ePlan capability. 70% · portal landing page
    • What does a residential solar permit cost? ≈$539.69 total for a residential system 15kW or under: $331.66 (Photovoltaic Systems Permit, residential ≤15kW) + $54.04 (Electrical Solar Issuance) + $153.99 (Photovoltaic Systems Plan Check, residential ≤15kW). Above 15kW, add $11.85/kW (permit) and $5.92/kW (plan check) for each kW over 15. 92% · fee schedule
    • How is the fee calculated? Tiered / Per kW 95% · fee schedule
    • Is there a separate plan-check fee? Yes — $153.99 for residential systems 15kW and under (plus per-kW increment above that). 95% · fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • How long is an issued permit valid before it expires? Plan-check application deemed abandoned 180 days after filing if not pursued/permitted (one 180-day extension available). Once issued, a permit becomes invalid unless work commences within 12 months of issuance, or if commenced work is abandoned for 180 days (one 180-day extension available, in writing, with cause). 95% · department page / ordinance citation
    • Which utility handles interconnection here? Southern California Edison (SCE) 88% · city page (utility confirmation)
    • Where does the utility sit in the sequence? After permit — SCE will not issue Permission to Operate for a NEM-1/NEM-2 facility ≤1MW until it has received 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction over the Generating Facility.' 90% · utility tariff (Rule 21)

28 questions answered against City of Downey’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes — City of Downey Community Development Dept, Building & Safety Division is the AHJ for building/electrical; Downey Fire Department (own municipal dept) for fire.

Why the confidence is not higherCity's own Building & Safety Division page states it 'provides plan checking, permitting, and inspection services... to assure all structures meet the minimum life safety standards of State and local building codes adopted by the City of Downey.'

department page checked 2026-08-30 https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both — the city issues both building and electrical permits itself through the Building & Safety Division; fire plan review/inspection is handled by Downey's own Fire Department, not delegated to LA County.

Why the confidence is not higherConfirmed across Building & Safety Division page, fee schedule (single combined city fee schedule covering building+electrical+PV), and DFD's own fee schedule/permit application pages — no county delegation found anywhere.

department page checked 2026-08-30 https://web.archive.org/web/20260417120004/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/fee-schedule

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherFee schedule lists a distinct 'Photovoltaic Systems Permit' fee category (residential and commercial tiers) and the Residential Submittal Requirements / R-3 Standard Plan Check Correction List both treat solar PV as a required, separately-permitted scope item.

fee schedule checked 2026-08-30 https://web.archive.org/web/20251017114815/https://www.downeyca.org/home/showpublisheddocument/9803/638914789142670000

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined into a single 'Photovoltaic Systems Permit' — the fee schedule lists one PV permit (with an 'Electrical Solar Issuance' component) plus one PV plan-check fee, issued separately from the base building permit for the house (the R-3 correction list explicitly says PV requires a separate permit from the main building permit).

Why the confidence is not higherInferred from the fee schedule structure (single 'Photovoltaic Systems Permit' + 'Photovoltaic Systems Plan Check' line items, both split only by residential/commercial and kW, not by trade) and the R-3 Standard Plan Check Correction List item 9 ('Separate permits are required for grading, photovoltaic systems...'). No document explicitly uses the words 'combined' or 'separate electrical permit'.

fee schedule / checklist checked 2026-08-30 https://web.archive.org/web/20251017100138/https://www.downeyca.org/home/showpublisheddocument/8915/638623357228130000

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either — a CA-licensed contractor (typically C-46 Solar or C-10 Electrical), or the homeowner as an owner-builder after completing the owner-builder verification form.

Why the confidence is not higherBuilding & Safety Division page states an 'Owner Builder' permit is available after completing the owner-builder verification form, or a 'California Licensed Contractor' can obtain the permit; general CSLB classification convention (not Downey-specific text) fills in C-46/C-10.

department page checked 2026-08-30 https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Nothing published by this authority.

Where we lookedBuilding & Safety Division page, Business License 'I Want To' page, Design Professional Licensing Requirements handout, Residential Submittal Requirements — none describe a city contractor-registration/prequalification step beyond standard CSLB license verification at permit issuance

https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherBuilding & Safety Division page states explicitly: 'you can obtain an "Owner Builder" permit after completing the owner builder verification form' if doing the improvements yourself.

department page checked 2026-08-30 https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Q8 What documents make up a complete submittal? Core Submittal package

Permit application (with Preliminary Planning review); 4 sets of plans on 24x36" sheets; soils report (2 copies, if required); structural calculations (2 copies, wet-stamped and signed, if required); Title 24 energy analysis (2 sets of 8.5x11" with CF-1R/MF-1R forms); complete solar PV plans or documentation of an applicable code exception; site plan, floor plan, and structural plans per the Minimum Submittal Requirements checklist.

Why the confidence is not higherDirectly enumerated in the city's 'Residential Submittal Requirements' and 'Residential (R-3) Standard Plan Check Correction List' handouts, both current per Wayback captures dated Oct 2025.

published checklist checked 2026-08-30 https://web.archive.org/web/20251017111755/https://www.downeyca.org/home/showpublisheddocument/8964/638633853045270000

Q9 How many copies, and in what format? Submittal package

4 complete sets of plans printed on 24"x36" sheets; 2 copies of structural calculations (wet-stamped/signed); 2 sets of 8.5"x11" Title 24 energy calculations; 2 copies of soils report if required.

Why the confidence is not higherStated verbatim in 'Residential Submittal Requirements' handout under 'Supporting Documents'.

published checklist checked 2026-08-30 https://web.archive.org/web/20251017111755/https://www.downeyca.org/home/showpublisheddocument/8964/638633853045270000

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes. Must show: existing site conditions (trees, fences, utility poles), all property lines with dimensions, setbacks from property lines/easements, adjacent street or alley, vicinity map and north arrow, building/structure location(s) and orientation, driveways/paved areas/walkways/landscaping, location and height of retaining walls and fences, plus an NPDES stormwater-discharge note.

Why the confidence is not higherEnumerated in 'Residential Submittal Requirements' under 'Site Plan shall include'.

published checklist checked 2026-08-30 https://web.archive.org/web/20251017111755/https://www.downeyca.org/home/showpublisheddocument/8964/638633853045270000

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes (inferred) — the R-3 Standard Plan Check Correction List requires 'complete solar photovoltaic plans,' and the city's general electrical submittal rule requires 'a single-line diagram' whenever a service/system triggers full electrical plan review; SCE's Rule 21 also requires a submitted single-line diagram for the interconnection application.

Why the confidence is not higherNo single Downey document says 'one-line diagram required for all residential PV' in so many words — this is stitched from the R-3 correction list's 'complete solar photovoltaic plans' requirement, the general electrical-plan single-line-diagram rule in Residential Submittal Requirements, and SCE Rule 21 Section H.1.d(v) (single line diagram submitted to utility). Confidence capped for that reason.

checklist / utility tariff checked 2026-08-30 https://web.archive.org/web/20251017100138/https://www.downeyca.org/home/showpublisheddocument/8915/638623357228130000

Q12 Are string and conductor calculations required? Drawings & calculations

Likely yes, as part of 'complete solar photovoltaic plans' required by the R-3 correction list, but no Downey document explicitly names string/conductor sizing calculations for PV.

Why the confidence is not higherInferred from the general requirement for 'complete solar photovoltaic plans' plus standard CA plan-check practice; not explicitly itemized in any Downey handout retrieved.

checklist checked 2026-08-30 https://web.archive.org/web/20251017100138/https://www.downeyca.org/home/showpublisheddocument/8915/638623357228130000

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Nothing published by this authority.

Where we lookedDesign Professional Licensing Requirements handout (general B&P Code stamping thresholds — roof equipment >400lbs/4ft, structural alterations, etc.) — no PV-specific structural-PE-stamp threshold stated; Residential Submittal Requirements and R-3 Correction List also silent on a PV-specific number

https://web.archive.org/web/20251017103136/https://www.downeyca.org/home/showpublisheddocument/8875/638620777687600000

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedSame Design Professional Licensing Requirements handout and Residential Submittal Requirements — no electrical-PE-stamp threshold specific to PV found

https://web.archive.org/web/20251017103136/https://www.downeyca.org/home/showpublisheddocument/8875/638620777687600000

Q15 What does a residential solar permit cost? Core Fees

≈$539.69 total for a residential system 15kW or under: $331.66 (Photovoltaic Systems Permit, residential ≤15kW) + $54.04 (Electrical Solar Issuance) + $153.99 (Photovoltaic Systems Plan Check, residential ≤15kW). Above 15kW, add $11.85/kW (permit) and $5.92/kW (plan check) for each kW over 15.

Why the confidence is not higherFee schedule PDF is dated 08/22/2025 (revised) / effective 08/23/2025 — current as of this run — and itemizes these exact PV line items.

fee schedule checked 2026-08-30 https://web.archive.org/web/20251017114815/https://www.downeyca.org/home/showpublisheddocument/9803/638914789142670000

Q16 How is the fee calculated? Core Fees

Tiered / Per kW

Why the confidence is not higherFee schedule sets a flat base fee for systems ≤15kW residential (≤50kW commercial) then adds a per-kW rate above that threshold, for both the permit and plan-check fees.

fee schedule checked 2026-08-30 https://web.archive.org/web/20251017114815/https://www.downeyca.org/home/showpublisheddocument/9803/638914789142670000

Q17 Is there a separate plan-check fee? Fees

Yes — $153.99 for residential systems 15kW and under (plus per-kW increment above that).

Why the confidence is not higherFee schedule lists 'Photovoltaic Systems Plan Check' as a distinct line item separate from the permit issuance fee.

fee schedule checked 2026-08-30 https://web.archive.org/web/20251017114815/https://www.downeyca.org/home/showpublisheddocument/9803/638914789142670000

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Nothing published by this authority.

Where we lookedBuilding & Safety Division page, Building Permit Information/Handouts pages, Fee Schedule — none publish a stated plan-review turnaround (business days)

https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Q19 How long is an issued permit valid before it expires? Timeline & validity

Plan-check application deemed abandoned 180 days after filing if not pursued/permitted (one 180-day extension available). Once issued, a permit becomes invalid unless work commences within 12 months of issuance, or if commenced work is abandoned for 180 days (one 180-day extension available, in writing, with cause).

Why the confidence is not higherStated verbatim, with municipal code citation, in the city's 'Permit Application / Building Permit Expiration' handout: 'City of Downey municipal code; section 8999.28(C)(ii)'.

department page / ordinance citation checked 2026-08-30 https://web.archive.org/web/20251017110307/https://www.downeyca.org/home/showpublisheddocument/9193/638714033785130000

Q20 Which permit portal does this authority use? Core Portal & process

Accela Citizen Access (ACA) — https://aca-prod.accela.com/downey (also reached via https://permits.downeyca.org/CitizenAccess/Default.aspx)

Why the confidence is not higherCity's own inspections page and 'Apply for Building Permit' page both point directly to this Accela instance as the mandatory portal for permitting and inspection scheduling since 1 May 2025.

portal landing page checked 2026-08-30 https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q21 Can the whole application be completed online? Core Portal & process

Yes (inferred) — the city has made online scheduling mandatory ('EFFECTIVE MAY 1st, 2025 All inspections must be scheduled through the online Accela Citizen Access Portal') and the same Accela instance is the destination for the permit-application link, consistent with full online application/ePlan capability.

Why the confidence is not higherNo single page explicitly states the entire application (incl. plan upload) can be completed online end-to-end without any counter/in-person step; inferred from the mandatory-online-inspection policy and standard Accela Citizen Access functionality.

portal landing page checked 2026-08-30 https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q22 Which utility handles interconnection here? Core Utility interconnection

Southern California Edison (SCE)

Why the confidence is not higherConfirmed from a city-side source, not a ZIP lookup: Downey's own 'Clean Power Alliance / Green Projects' page references 'Southern California Edison Energy Savings Rebates' and the SCE Gateway Partnership directly, and Downey's CCA (Clean Power Alliance) rides on SCE's distribution grid.

city page (utility confirmation) checked 2026-08-30 https://web.archive.org/web/20260417114804/https://www.downeyca.org/our-city/clean-power-alliance-green-projects

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit — SCE will not issue Permission to Operate for a NEM-1/NEM-2 facility ≤1MW until it has received 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction over the Generating Facility.'

Why the confidence is not higherSCE Rule 21 tariff, Section D.13.b, states PTO is normally processed within 30 business days of receiving (among other things) the AHJ final-inspection clearance — i.e., the city's process must complete (or at least reach final inspection) before SCE finalizes interconnection.

utility tariff (Rule 21) checked 2026-08-30 https://www.sce.com/sites/default/files/inline-files/Rule21_1_1.pdf

Q24 Is a HOA or architectural approval required first? Overlays & special cases

Nothing published by this authority.

Where we lookedDowney Municipal Code Article IX (Land Use), §9504 equipment provisions and §9534 setback provisions, via eCode360 Wayback captures — no HOA/architectural-review requirement found for solar in the sections retrieved; full zoning code not fully searchable (only these two nodes had Wayback captures)

https://web.archive.org/web/20260720202823/https://ecode360.com/44402617

Q25 Is there a historic-district review? Overlays & special cases

Nothing published by this authority.

Where we lookedSame eCode360 captures as q24 — no historic-district review provision found in the Land Use sections retrieved

https://web.archive.org/web/20260720202823/https://ecode360.com/44402617

Q26 Is a wind or windstorm certification required? Overlays & special cases

No — no windstorm/wind-load certification program (TDI-style) applies in this California jurisdiction; wind loading is addressed through CBC/ASCE 7 structural design, not a separate certification.

Why the confidence is not higherInference from general California building-code practice and the absence of any wind-certification reference in the Downey documents reviewed (fee schedule, submittal requirements, design-professional licensing handout); not a Downey-specific statement.

inference from comparable CA practice checked 2026-08-30 https://web.archive.org/web/20251017103136/https://www.downeyca.org/home/showpublisheddocument/8875/638620777687600000

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

No CUP/Council approval required for a standard residential rooftop PV installation — Downey Municipal Code §9504 (Air Conditioning, Mechanical Roof, and Utility Equipment) explicitly exempts 'small wind energy systems, solar water heaters, solar power, or other passive solar energy systems' from the R-1/R-2 roof-mounted-equipment restrictions that would otherwise require screening/review.

Why the confidence is not higherRetrieved directly from Downey Municipal Code Article IX §9504 via an eCode360 Wayback capture (live eCode360 403s even with the iccsafe.org Referer). Does not address ground-mount or large commercial systems, which may require different review.

municipal code (zoning) checked 2026-08-30 https://web.archive.org/web/20260517232523/https://ecode360.com/44400355

Q28 Is there a system-size cap on residential generation? Overlays & special cases

Nothing published by this authority.

Where we lookedSame eCode360 Land Use captures (§9504, §9534) — no city-specific residential generation size cap found; sizing appears governed entirely by CPUC/SCE NEM tariff (utility-level), not city zoning

https://web.archive.org/web/20260517232523/https://ecode360.com/44400355

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2020 NEC, as adopted via the 2022 California Electrical Code (Title 24 Part 3) — per the city's own current Building & Safety Division page. NOTE: California's 2025 code cycle (based on the 2023 NEC) took effect statewide 1 Jan 2026; the city's page was captured twice in 2026 (9 Mar and 18 May) and both times still listed the 2022-cycle codes, so this may reflect a webpage that has not yet been updated rather than the code actually in force — treat with caution and verify with the Building & Safety Division directly. 60% · department page (dated by Wayback capture, not a code-adoption ordinance)
    • Which building code edition is in force? 2022 California Building Code (per city's current page; see caveat on q29 re: possible lag behind the 2025 statewide cycle). 65% · department page
    • Which fire code edition is in force? 2022 California Fire Code (per city's current page; see caveat on q29 re: possible lag behind the 2025 statewide cycle). 65% · department page
    • Are there local amendments to any of the above? Yes 85% · department page
    • What is the installation judged against? The 2022 California Building/Residential/Electrical/Fire Codes (Title 24) as locally amended per Downey Municipal Code Article VIII — subject to the q29/q30/q31 dating caveat. 65% · department page
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    Nothing recorded for City of Downey on this step yet — 1 question checked and found unpublished. The guidance above is general.

  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Yes, rapid shutdown is required under NEC 690.12 as incorporated by the California Electrical Code edition currently referenced on the city's page (2020 NEC, per 2022 CEC) — subject to the same q29 dating caveat regarding a possible undocumented shift to the 2023 NEC as of 1 Jan 2026. 60% · inference from adopted code edition
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Does the UTILITY specify placards beyond the AHJ's? Yes — SCE's Rule 21 tariff requires the required visible/manual disconnect switch to carry markings clearly indicating open and closed positions, and if that switch is not located adjacent to the Point of Common Coupling, requires additional permanent signage identifying its location (or, if inside a locked premises, signage with contact information). 75% · utility tariff (Rule 21)
    • Where must the labels be placed? SCE Rule 21 requires the visible-disconnect signage to be at or adjacent to the Point of Common Coupling, or (if the disconnect is elsewhere) accompanied by permanent signage at an approved location describing where it is. This only covers the utility-required disconnect marking — no Downey-specific document was found specifying placement for other required labels (main panel, rapid-shutdown, etc.). 55% · utility tariff (Rule 21)
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Must equipment be on a specific approved list? Yes — 'All electrical equipment shall be listed' is a standing requirement in the city's electrical-submittal guidance. 80% · handout

20 questions answered against City of Downey’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2020 NEC, as adopted via the 2022 California Electrical Code (Title 24 Part 3) — per the city's own current Building & Safety Division page. NOTE: California's 2025 code cycle (based on the 2023 NEC) took effect statewide 1 Jan 2026; the city's page was captured twice in 2026 (9 Mar and 18 May) and both times still listed the 2022-cycle codes, so this may reflect a webpage that has not yet been updated rather than the code actually in force — treat with caution and verify with the Building & Safety Division directly.

Why the confidence is not higherConfidence capped because the source is dated ambiguously relative to the mandatory 1 Jan 2026 statewide 2025-cycle/NEC-2023 switchover, and the page shows no revision stamp of its own — only the capture date proves it was still saying '2022' as late as May 2026.

department page (dated by Wayback capture, not a code-adoption ordinance) checked 2026-08-30 https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Q30 Which building code edition is in force? Core Code editions in force

2022 California Building Code (per city's current page; see caveat on q29 re: possible lag behind the 2025 statewide cycle).

Why the confidence is not higherSame source and same dating caveat as q29.

department page checked 2026-08-30 https://web.archive.org/web/20260309151746/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-code

Q31 Which fire code edition is in force? Code editions in force

2022 California Fire Code (per city's current page; see caveat on q29 re: possible lag behind the 2025 statewide cycle).

Why the confidence is not higherSame source and same dating caveat as q29.

department page checked 2026-08-30 https://web.archive.org/web/20260309151746/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-code

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherThe city's own Building Code page states: 'Please refer to the link below for the additional local amendments that are to be utilized with the 2022 Codes,' linking to 'Downey Municipal Code - Building.' The linked amendment text itself (Municipal Code Article VIII) could not be retrieved (Municode client-ID wall; no Wayback capture found for that eCode360 node), so the specific amendments are not confirmed, only their existence.

department page checked 2026-08-30 https://web.archive.org/web/20260309151746/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-code

Q33 What is the installation judged against? Core Electrical

The 2022 California Building/Residential/Electrical/Fire Codes (Title 24) as locally amended per Downey Municipal Code Article VIII — subject to the q29/q30/q31 dating caveat.

Why the confidence is not higherCombines the code-edition list on the city's Building Code page with its statement that local amendments apply; underlying amendment text not independently verified (see q32).

department page checked 2026-08-30 https://web.archive.org/web/20260309151746/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-code

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Nothing published by this authority.

Where we lookedResidential Service Panel Upgrade handout (general CEC service/grounding/AFCI/SPD rules) and Residential Submittal Requirements — no PV-specific busbar-sizing/backfeed (e.g. '120% rule') amendment found; Municipal Code Article VIII (Building Regulations, node 44398751 on eCode360), where such an amendment would most likely sit, has no Wayback capture and live eCode360 403s even with the iccsafe.org Referer

https://web.archive.org/web/20251017105351/https://www.downeyca.org/home/showpublisheddocument/8937/638627657832670000

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Nothing published by this authority.

Where we lookedResidential Submittal Requirements, R-3 Standard Plan Check Correction List, Fee Schedule — none specify a mounting-system or attachment-spacing standard for PV; Municipal Code Article VIII inaccessible (see q34)

https://web.archive.org/web/20251017111755/https://www.downeyca.org/home/showpublisheddocument/8964/638633853045270000

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Nothing published by this authority.

Where we lookedMunicipal Code Article VIII (Building Regulations)/Fire Code amendments node (eCode360 id 44398751) — no Wayback capture exists and live site 403s; CFC ridge-setback dimensions are ICC-copyrighted and were not independently located elsewhere

https://ecode360.com/44398751

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Yes, rapid shutdown is required under NEC 690.12 as incorporated by the California Electrical Code edition currently referenced on the city's page (2020 NEC, per 2022 CEC) — subject to the same q29 dating caveat regarding a possible undocumented shift to the 2023 NEC as of 1 Jan 2026.

Why the confidence is not higherNo Downey-specific document independently restates the rapid-shutdown requirement; this is inherited entirely from the NEC edition question (q29), whose own confidence is capped at 60 for the reasons given there.

inference from adopted code edition checked 2026-08-30 https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedFull Building Handouts/Forms index (138KB page, all listed PDFs by title), Residential Submittal Requirements, R-3 Correction List, Fee Schedule — no dedicated PV/service-equipment placard specification found; Article VIII (where such a local amendment would sit) inaccessible

https://web.archive.org/web/20260518002903/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-handouts-forms

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame Building Handouts/Forms index and submittal checklists as q38 — no city-specific placard wording found; Article VIII inaccessible

https://web.archive.org/web/20260518002903/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-handouts-forms

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame as q38/q39 — no letter-height/colour/material spec found; Article VIII inaccessible

https://web.archive.org/web/20260518002903/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-handouts-forms

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame Building Handouts/Forms index — no facility-map/site-plan placard requirement beyond the generic site-plan content already captured in q10; Article VIII inaccessible

https://web.archive.org/web/20260518002903/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-handouts-forms

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes — SCE's Rule 21 tariff requires the required visible/manual disconnect switch to carry markings clearly indicating open and closed positions, and if that switch is not located adjacent to the Point of Common Coupling, requires additional permanent signage identifying its location (or, if inside a locked premises, signage with contact information).

Why the confidence is not higherDirectly from the live SCE Rule 21 tariff PDF (fetched successfully at its live URL, per the run's guidance that Rule 21 — unlike the Interconnection Handbook — is reachable), Section H.1.d(ii) and (v).

utility tariff (Rule 21) checked 2026-08-30 https://www.sce.com/sites/default/files/inline-files/Rule21_1_1.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

SCE Rule 21 requires the visible-disconnect signage to be at or adjacent to the Point of Common Coupling, or (if the disconnect is elsewhere) accompanied by permanent signage at an approved location describing where it is. This only covers the utility-required disconnect marking — no Downey-specific document was found specifying placement for other required labels (main panel, rapid-shutdown, etc.).

Why the confidence is not higherPartial answer — sourced only from SCE Rule 21 (utility side); the AHJ-side labeling-location rules would normally live in the city's adopted/amended NEC text (Municipal Code Article VIII), which was not retrievable.

utility tariff (Rule 21) checked 2026-08-30 https://www.sce.com/sites/default/files/inline-files/Rule21_1_1.pdf

Q44 Must equipment be on a specific approved list? Equipment listing

Yes — 'All electrical equipment shall be listed' is a standing requirement in the city's electrical-submittal guidance.

Why the confidence is not higherStated in the 'Residential Service Panel Upgrade' handout (general electrical requirements, not PV-exclusive, but stated as a blanket rule for all electrical equipment).

handout checked 2026-08-30 https://web.archive.org/web/20251017105351/https://www.downeyca.org/home/showpublisheddocument/8937/638627657832670000

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Nothing published by this authority.

Where we lookedFire Department Forms/Fees/Permits page (listed 2025-2026 Fire Fee Schedule and 2025 Fire Permit Application by title) — both linked documents 404 on direct fetch and have no Wayback capture; Municipal Code Article VIII inaccessible

https://web.archive.org/web/20260123223102/https://www.downeyca.org/our-city/departments/fire/forms-fees-permits

Q46 Is there a separate ESS permit or inspection? Battery / ESS

Nothing published by this authority.

Where we lookedSame Fire Forms/Fees/Permits page — same retrieval failure as q45

https://web.archive.org/web/20260123223102/https://www.downeyca.org/our-city/departments/fire/forms-fees-permits

Q47 Is a ground mount treated as a structure? Core Ground mount

Nothing published by this authority.

Where we lookedDowney Municipal Code §9534.22 (Detached Accessory Buildings in Setback Areas) via eCode360 Wayback capture — covers accessory buildings generally but does not name ground-mounted solar specifically, so cannot confirm it is treated as a 'structure' under this section

https://web.archive.org/web/20260720202823/https://ecode360.com/44402617

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedSCE Rule 21 tariff (live PDF), searched all 'meter' and 'disconnect' proximity language — Rule 21 specifies disconnect accessibility/marking but never ties its location to the utility meter; the SCE Interconnection Handbook (which would normally state this) is unreachable per this run's known blocker (SharePoint redirect; Wayback captures truncated at 1,048,576 bytes)

https://www.sce.com/sites/default/files/inline-files/Rule21_1_1.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Portal (Accela Citizen Access) — phone is available only to cancel/reschedule an existing inspection, not to book one. 90% · department page
    • How much notice is required? Effectively 1 business day — inspections requested by 3:00 p.m. are scheduled for the next business day; requests after 3:00 p.m. move to the second business day. 85% · department page
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes — the city performs its own final electrical/PV inspection (Building & Safety Division); Downey Fire Department (own municipal department, not LACoFD) separately performs any required fire final. 85% · department page
    • If delegated, to whom? N/A — not delegated. Both the Building & Safety Division (electrical/PV) and Downey Fire Department (fire-related items) are in-house city departments; no LA County Fire or LA County Building & Safety involvement was found. 85% · department page
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? Not fully published for PV specifically. General pattern from city handouts: rough inspections (framing/plumbing/electrical/mechanical) as applicable, then a final inspection once installation is complete; a Downey Fire Department final is also required if the project triggers fire-sprinkler or related fire-code work. The city references an 'Inspection Job Card' that lists specific inspection types/sequence, but that card itself could not be retrieved (not linked as a document on the pages found). 55% · department page (partial)
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    Nothing recorded for City of Downey on this step yet — 3 questions checked and found unpublished. The guidance above is general.

  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final (permit finaled/closed) — no separate Certificate of Occupancy is issued for an existing single-family residence gaining PV; a CofO applies mainly to new construction/occupancy changes per the city's own 'Certificate of Occupancy Requirements and Process' handout. 60% · department page (inference)
    • Who notifies the utility for PTO? Installer/Applicant — the entity that submitted the SCE Net Energy Metering Interconnection Request is responsible for supplying SCE with 'evidence of Applicant's final electric inspection clearance' to trigger Permission to Operate. 80% · utility tariff (Rule 21)
    • Is there a re-inspection fee? $209.70 (half-hour minimum) 95% · fee schedule

14 questions answered against City of Downey’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Portal (Accela Citizen Access) — phone is available only to cancel/reschedule an existing inspection, not to book one.

Why the confidence is not higherBuilding Inspections page: 'All inspections must be scheduled through the online Accela Citizen Access Portal' (effective 1 May 2025); 'To cancel or reschedule an inspection, please call (562) 904-7142.'

department page checked 2026-08-30 https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q50 How much notice is required? Core Booking & scheduling

Effectively 1 business day — inspections requested by 3:00 p.m. are scheduled for the next business day; requests after 3:00 p.m. move to the second business day.

Why the confidence is not higherStated directly on the Building Inspections page.

department page checked 2026-08-30 https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Nothing published by this authority.

Where we lookedBuilding Inspections page — states next-business-day scheduling logic but does not mention AM/PM windows or same-day service

https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes — the city performs its own final electrical/PV inspection (Building & Safety Division); Downey Fire Department (own municipal department, not LACoFD) separately performs any required fire final.

Why the confidence is not higherNo delegation to LA County Fire found anywhere in city sources (see jurisdiction.why); 'Steps to Prepare for Final Inspection' lists 'Obtain Downey Fire Department (DFD) Final' as an in-house step alongside Building Division sign-off.

department page checked 2026-08-30 https://web.archive.org/web/20251017102351/https://www.downeyca.org/home/showpublisheddocument/9020/638646620815370000

Q53 If delegated, to whom? Core Who inspects

N/A — not delegated. Both the Building & Safety Division (electrical/PV) and Downey Fire Department (fire-related items) are in-house city departments; no LA County Fire or LA County Building & Safety involvement was found.

Why the confidence is not higherSame evidentiary basis as q52 and the jurisdiction block.

department page checked 2026-08-30 https://web.archive.org/web/20251017102351/https://www.downeyca.org/home/showpublisheddocument/9020/638646620815370000

Q54 Which inspections are required, and in what order? Core Stages & sequence

Not fully published for PV specifically. General pattern from city handouts: rough inspections (framing/plumbing/electrical/mechanical) as applicable, then a final inspection once installation is complete; a Downey Fire Department final is also required if the project triggers fire-sprinkler or related fire-code work. The city references an 'Inspection Job Card' that lists specific inspection types/sequence, but that card itself could not be retrieved (not linked as a document on the pages found).

Why the confidence is not higherAssembled from the 'Permit Application/Building Permit Expiration' handout (which lists rough inspection types) and 'Steps to Prepare for Final Inspection'; the PV-specific 'Inspection Job Card' referenced by name on the Building Inspections page was not found as a downloadable document.

department page (partial) checked 2026-08-30 https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

Nothing published by this authority.

Where we lookedBuilding Inspections page and Permit Application/Building Permit Expiration handout — describe generic rough inspections (framing/plumbing/electrical/mechanical) but do not call out a PV-specific rough-in or mid-roof inspection

https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q56 Does the inspector verify labels and listings? Core What is checked

Nothing published by this authority.

Where we lookedBuilding Inspections page and Residential Service Panel Upgrade handout ('All electrical equipment shall be listed' as a submittal/design rule, not stated as an inspection-checklist item) — no explicit statement that the field inspector verifies labels/listings at PV final

https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q57 Is there a published inspection checklist? Core What is checked

Nothing published by this authority.

Where we lookedBuilding Inspections page references an 'Inspection Job Card' by name as the source of inspection types, but no downloadable/public checklist document was found linked from that page or the Handouts/Forms index

https://web.archive.org/web/20260518003737/https://www.downeyca.org/our-city/departments/community-development/building-safety-division/building-inspections

Q58 What must be on site at inspection? Core Documents on site

Nothing published by this authority.

Where we lookedBuilding Inspections page, 'Steps to Prepare for Final Inspection' handout — neither lists specific documents required to be on-site at a PV inspection

https://web.archive.org/web/20251017102351/https://www.downeyca.org/home/showpublisheddocument/9020/638646620815370000

Q59 Is there a re-inspection fee? Corrections & re-inspection

$209.70 (half-hour minimum)

Why the confidence is not higherFee schedule: 'Re-Inspection Fee (1/2 Hour Minimum) — $209.70 each.'

fee schedule checked 2026-08-30 https://web.archive.org/web/20251017114815/https://www.downeyca.org/home/showpublisheddocument/9803/638914789142670000

Q60 How are corrections issued and cleared? Corrections & re-inspection

Nothing published by this authority.

Where we lookedBuilding Inspections page, Permit Application/Building Permit Expiration handout, Steps to Prepare for Final Inspection handout — all reference 'corrections' generically ('all pending corrections addressed and cleared') without describing the issuance/clearance mechanism

https://web.archive.org/web/20251017102351/https://www.downeyca.org/home/showpublisheddocument/9020/638646620815370000

Q61 What is issued on pass? Core Final sign-off & PTO

Final (permit finaled/closed) — no separate Certificate of Occupancy is issued for an existing single-family residence gaining PV; a CofO applies mainly to new construction/occupancy changes per the city's own 'Certificate of Occupancy Requirements and Process' handout.

Why the confidence is not higherInferred: Downey's materials never use the terms 'green tag' or a PV-specific pass document; 'building final' is the term used throughout the 'Steps to Prepare for Final Inspection' handout, and CofO is described elsewhere as tied to new construction/occupancy change, not routine PV addition.

department page (inference) checked 2026-08-30 https://web.archive.org/web/20251017102351/https://www.downeyca.org/home/showpublisheddocument/9020/638646620815370000

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer/Applicant — the entity that submitted the SCE Net Energy Metering Interconnection Request is responsible for supplying SCE with 'evidence of Applicant's final electric inspection clearance' to trigger Permission to Operate.

Why the confidence is not higherSCE Rule 21, Section D.13.b, places this responsibility on the 'Applicant' (typically the installer acting as the interconnection customer), not the AHJ or a utility-initiated pull.

utility tariff (Rule 21) checked 2026-08-30 https://www.sce.com/sites/default/files/inline-files/Rule21_1_1.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Downey against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Downey is the authority having jurisdiction 92% confidence
Holds
Building and Electrical (Community Development Dept — Building & Safety Division) AND Fire (Downey Fire Department, a municipal department — NOT LA County Fire/LACoFD)
Overridden by
SCE Rule 21 tariff governs utility interconnection/Permission-to-Operate sequencing (requires the city's final electrical inspection clearance before PTO is issued) but does not override the city's permitting/inspection authority itself; California Title 24 statewide code-adoption cycle sets the base code editions the city must adopt.
Why not higher
Downey runs its own Community Development Building & Safety Division, which issues both building and electrical permits directly (confirmed via the Division's own current page, the Accela portal, and the fee schedule). Downey also runs its OWN municipal Fire Department, not LA County Fire — confirmed by extensive DFD-specific city pages, a '2025-2026 Fire Department Fee Schedule', a '2025 Fire Permit Application', and the city's 'Steps to Prepare for Final Inspection' handout, which lists 'Obtain Downey Fire Department (DFD) Final' as an in-house step alongside the Building Division sign-off. No LA County Fire District involvement appears anywhere in city sources, so the LACoFD delegation pattern seen on other cities this run (independent ESS/BIPV plan review, disconnect-placarding field check) does NOT apply here — Downey Fire Department itself would hold any such role, but no city document was found specifying ESS/PV-specific DFD plan-review or field-check requirements (see not_found).

https://web.archive.org/web/20260518002450/https://www.downeyca.org/our-city/departments/community-development/building-safety-division

Check the code edition before you build

This authority's published code edition does not match what the state has adopted. That usually means the authority's ordinance has not been updated for the current cycle — but a local amendment can also be lawful. Confirm with the building department before you submit.

Building code
This authority publishes 2022 2022 California Building Code (per city's current page; see caveat on q29 re: possible lag behind the 2025 statewide cycle). 65% · source
The state has adopted 2024/2025 2025 California Building Code (Title 24, Part 2, Volumes 1 & 2), based on the 2024 International Building Code, and 2025 California Residential Code (Title 24, Part 2.5), 92% · source
Fire code
This authority publishes 2022 2022 California Fire Code (per city's current page; see caveat on q29 re: possible lag behind the 2025 statewide cycle). 65% · source
The state has adopted 2024/2025 2025 California Fire Code (Title 24, Part 9), based on the 2024 International Fire Code, adopted by the Office of the State Fire Marshal with BSC approval. 90% · source
Permit required
Yes95%
Permit cost
≈$539.69 total for a residential system 15kW or under: $331.66 (Photovoltaic Systems Permit, residential ≤15kW) + $54.04 (Electrical Solar Issuance) + $153.99 (Photovoltaic Systems Plan…92%
Portal

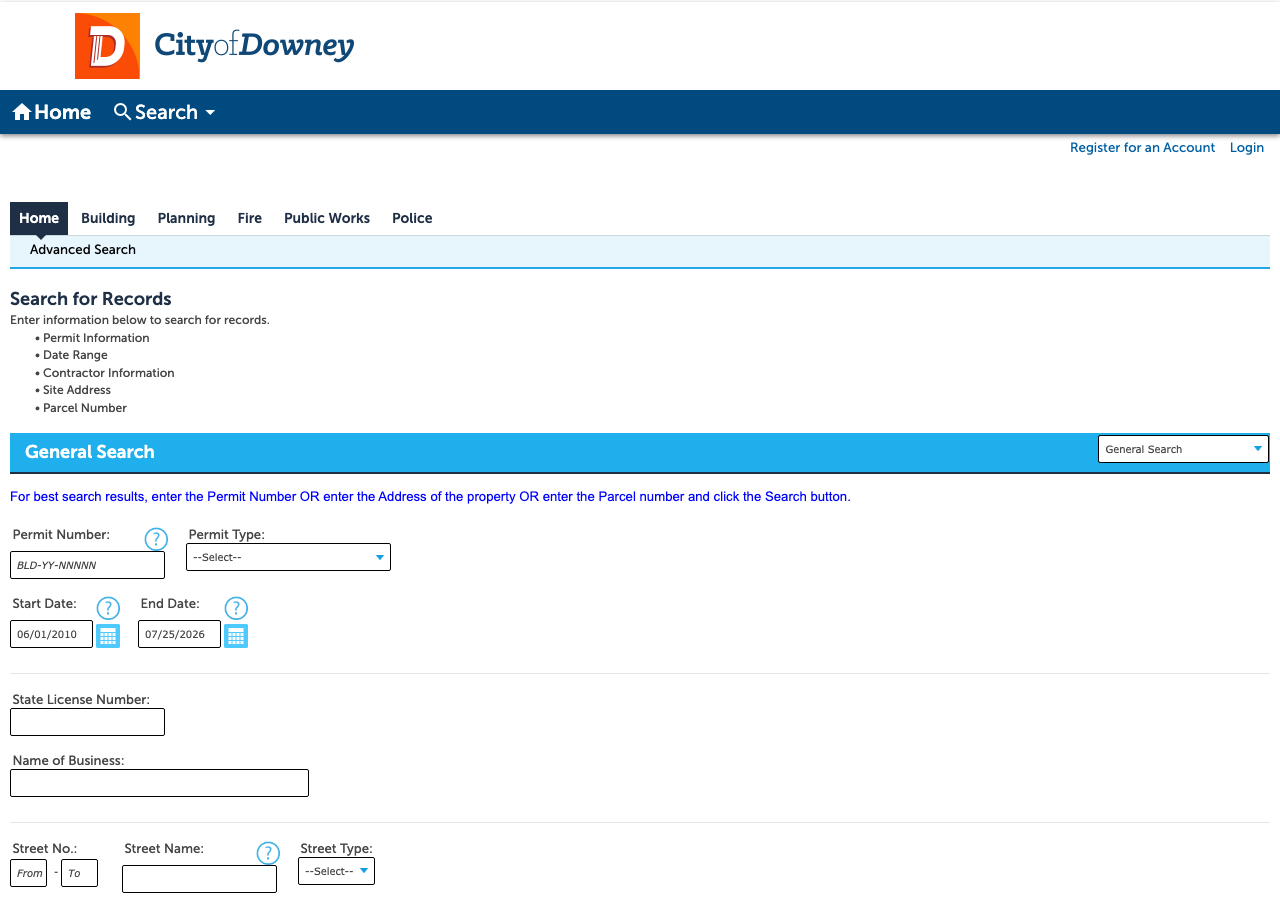

Accela Citizen Access (ACA) — https://aca-prod.accela.com/downey (also reached via https://permits.downeyca.org/CitizenAccess/Default.aspx)95%
Electrical code
2020 NEC, as adopted via the 2022 California Electrical Code (Title 24 Part 3) — per the city's own current Building & Safety Division page.60%
Booking an inspection
Portal (Accela Citizen Access) — phone is available only to cancel/reschedule an existing inspection, not to book one.90%
Labels & placards for this authority

Wording None%

Size, colour & material None%

Where they go 55%

SCE Rule 21 requires the visible-disconnect signage to be at or adjacent to the Point of Common Coupling, or (if the disconnect is elsewhere) accompanied by permanent signage at an approved location describing where it is. This only covers the utility-required disconnect marking — no Downey-specific document was found specifying placement for other required labels (main panel, rapid-shutdown, etc.).

What the utility wants on top 75%

Yes — SCE's Rule 21 tariff requires the required visible/manual disconnect switch to carry markings clearly indicating open and closed positions, and if that switch is not located adjacent to the Point of Common Coupling, requires additional permanent signage identifying its location (or, if inside a locked premises, signage with contact information).

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Los Angeles County
Regions served
1
Regions covered
City of Downey · city
Solar Requirements
Notes
Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.downeyca.org/our-city/departments/community-development/building-safety-division
Authority Contact
Address
11111 Brookshire Avenue, 1st Floor, Downey, CA 90241
Main Phone
Office Hours
7:30 a.m. – 5:30 p.m.
Building Department
Department
Building & Safety Division
Direct Phone
(562) 904-7141
Dept Hours
7:30 a.m. – 5:30 p.m.
Portal Software
Accela
Booking & Scheduling
Preferred channel
online_portal
Book in advance
1
Booking phone
Getting the earliest slot
You can call from 7:30 AM to confirm that you are on the list for the day. The inspector will call us on the number provided to give us the time slot. If they dont call, call them at 8:30 AM.
Notes
City of Downey uses Accela Citizen Access (ACA) portal for online permitting and inspection scheduling (registration required). Building inspections can be requested online 24/7 via the Accela portal, or by phone at the inspection request line (562) 904-7141 Mon-Fri 7:30am-3:00pm for next-day inspections; requests after 3:00pm go to the second business day. Inspector calls morning of inspection with a 3-hour arrival window. Building inspectors available by phone Mon-Fri 7:30-8:30am. General Building & Safety Division phone: (562) 904-7142. City Hall hours (effective July 6, 2026): Mon-Thu 7:00am-6:00pm. City uses SolarAPP+ for automated residential solar PV plan review. Both Residential Solar and Commercial Solar permit types are available in the Accela portal. Address: 11111 Brookshire Avenue, 1st Floor, Downey, CA 90241.
