City of Fort Bragg

Mendocino County

Verified Aug. 4, 2026

City of Fort Bragg is a city authority in the State of California, serving 6,983 residents. 804 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes -- a Building Permit is required for residential rooftop PV; the County's own building permit application (used for Fort Bragg addresses) has a dedicated… Q3 Electrical and building permits — Combined -- a single Building Permit covers the structural and electrical (CEC 690/705) scope of a residential PV install; Q4 Plan review — Eligible/expedited rooftop PV (<=10kW meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise reviewed within 1-3 days. Q18 Where you file — e-TRAKiT (etrakit.mendocinocounty.org) -- the County's online permit portal; also accepted in person at the County's own Fort Bragg office (752 South Franklin St). Q20

Permit required
Yes -- a Building Permit is required for residential rooftop PV; the County's own building permit application (used for Fort Bragg addresses) has a dedicated 'Photovoltaic' checkbox under 'Mark All…95% source
What it costs
Tension between two County documents: the still-linked 2015 PV Toolkit #1 Application Guide states plainly,55% source
Plan review turnaround
Eligible/expedited rooftop PV (<=10kW meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise reviewed within 1-3 days.82% source
Key document
department handout (fetched via Wayback capture, dated content confirmed 'Expedited Residential Rooftop Photovoltaic Systems Plan Review, Fees, and Inspections' cited by 8 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes, as titleholder -- but FBMC 15.04.030 defines the City's own 'Enforcement Agency' as the City's Building Inspection Dept 'or designated department or entity,' and in practice Mendocino County Planning & Building Services performs building/electrical plan review and inspection for Fort Bragg addresses from its own Fort Bragg field office. See jurisdiction block. 85% · municipal code
    • What does this authority permit itself, and what does it delegate? Delegated 85% · department page
    • Is a permit required for a residential rooftop PV system? Yes -- a Building Permit is required for residential rooftop PV; the County's own building permit application (used for Fort Bragg addresses) has a dedicated 'Photovoltaic' checkbox under 'Mark All That Apply.' 95% · department-hosted permit application form
    • Is there a separate electrical permit, or is it combined? Combined -- a single Building Permit covers the structural and electrical (CEC 690/705) scope of a residential PV install; no separate stand-alone electrical permit is described for PV in the applicable handout or policy. 78% · department handout (fetched via Wayback capture, dated content confirmed 'Expedited Residential Rooftop Photovoltaic Systems Plan Review, Fees, and Inspections'
    • Is a HOA or architectural approval required first? No -- neither the City's own code nor the County's PV submittal documents require HOA or architectural approval as part of the building-permit process itself. (California Civil Code Section 714 separately limits HOA authority to block solar statewide.) 55% · published checklist
    • Is there a historic-district review? No, for eligible systems -- County Ordinance 4530 (adopted 19 Dec 2023, applicable within the Coastal Zone, which includes Fort Bragg) exempts an 'Eligible Solar Energy System' (roof-mounted, on an existing legally-constructed building, not needing certain federal/state resource permits) from 'all discretionary review... and from review by the Planning Division' -- which covers Fort Bragg's own Local Coastal Program design/historic review as well as the County's Coastal Zone review, though the fact sheet does not name a specific 'Historic Review Board' by title. 65% · department fact sheet, citing Ord. No. 4530 (19 Dec 2023)
    • Is a wind or windstorm certification required? No windstorm/wind-zone certification requirement (no TDI-style program) was found; wind uplift for rooftop PV is instead handled through the Structural Criteria anchor-spacing/fastener tables (Wind Exposure C/D distinctions). 60% · department handout (Structural Criteria)
    • Is a Specific Use Permit or Council approval ever required? No, for qualifying systems -- the 2015 PV Toolkit guide states 'Planning review IS NOT required for solar PV installations of this size' (<=10kW rooftop), and Ordinance 4530 separately exempts eligible rooftop solar from discretionary Coastal Zone/Planning Division review. No Council or Specific Use Permit process was found for qualifying residential PV. 75% · department handout
    • Is there a system-size cap on residential generation? No hard cap on residential system size was found; 10kW AC is only the eligibility threshold for the expedited/over-the-counter review track (Eligibility Checklist item A). Larger systems are not prohibited, they simply do not qualify for the fast-track process and go through full plan review with PE-stamped drawings. 65% · department handout (Eligibility Checklist, embedded)
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Completed Eligibility Checklist; an Electrical Plan (or Standard Electrical Plan/PV Toolkit Doc #3-4 for systems <=10kW); a Roof/Site Plan showing panel layout, fire classification, access pathways and label locations; a Structural Plan (or the Structural Criteria checklist, PV Toolkit Doc #5, or full PE-stamped structural drawings if that checklist fails); and the completed Building Permit Application. 88% · department handout
    • How many copies, and in what format? Over-the-counter: 1 completed permit application + 1 copy of an 8.5x11 plot/site plan. 'Other' (non-OTC) projects: 3 copies of construction plans, plus 2 copies of Title 24 energy compliance and 2 copies of wet-stamped engineering calculations where applicable. 85% · published checklist
    • Is a site plan required, and what must it show? Yes -- a roof/site plan is required showing panel/module layout, north arrow, lot dimensions, distance from property lines to structures, PV fire classification, code-compliant access pathways, and locations of required labels/disconnects. 90% · department handout
    • Is a one-line / three-line diagram required? Yes -- a one-line diagram of the complete system, including all components and wire sizes, is a required electrical-plan element. 92% · department handout
    • Are string and conductor calculations required? Yes -- total number of modules, modules per string, total strings, conductor type/size, conduit type/size and number of conductors per conduit section must all be specified. 88% · adopted department policy (Building Policy 14, eff. 13 Mar 2026)
    • Is a structural PE stamp required, and at what threshold? Rooftop: a CA-licensed structural/civil engineer's stamp is required only if the system fails the Structural Criteria checklist (module weight >4 psf PV/5 psf thermal, array covering >half the roof, anchor spacing beyond the Table 1 limits, roof in Wind Exposure D -- defined to include sites 'within 200 yards of the ocean or large coastal bay,' which is directly relevant to Fort Bragg's oceanfront/coastal parcels -- more than one roof covering, non-flush mounting, etc). Ground-mount: an engineer's stamp is required whenever the array exceeds 7 feet in height. 88% · department handout (PV Toolkit Document #5, Structural Criteria)
    • Is an electrical PE stamp required, and at what threshold? No PV-specific electrical PE-stamp threshold was found; the only engineer/licensed-contractor trigger identified is general (not solar-specific): any new electrical service panel rated over 200A requires line drawings from an electrical engineer or CA-licensed electrical contractor. 65% · adopted department policy (Building Policy 2, eff. 10 Mar 2026)
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

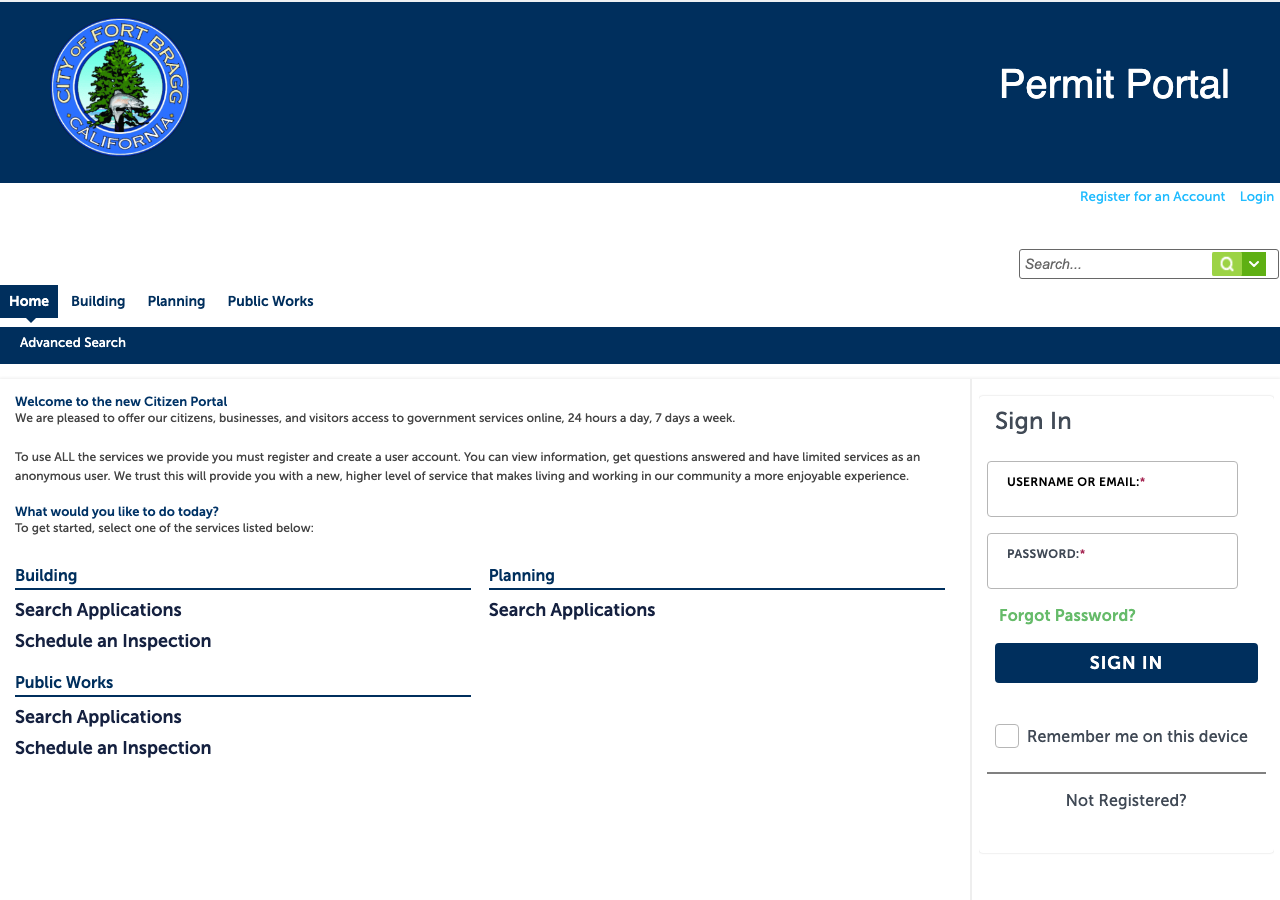

    • Which permit portal does this authority use? e-TRAKiT (etrakit.mendocinocounty.org) -- the County's online permit portal; also accepted in person at the County's own Fort Bragg office (752 South Franklin St). 85% · portal landing page
    • Can the whole application be completed online? Largely yes for the County-administered building/electrical permit -- applications 'can be submitted in person or electronically' and may be approved 'over the counter electronically' per the Expedited PV handout; full self-service payment/inspection-scheduling could not be independently confirmed. 55% · department handout
    • What does a residential solar permit cost? Tension between two County documents: the still-linked 2015 PV Toolkit #1 Application Guide states plainly, 'The minimum fee on a rooftop solar installation project is $83.00 and is based on the project valuation. The total permit fees, however, will not exceed $500.00.' The newer (current) Expedited handout that has otherwise superseded much of that 2015 guide's content just states 'Fees: To be in compliance with CA State AB 1414' with no dollar figure. 55% · department handout (PV Toolkit Document #1, dated '2015 Application Guide' in its own footer, still linked live)
    • How is the fee calculated? Valuation-based, per the Board of Supervisors' annually-adopted Master Fee Schedule; some structure types are billed by square footage instead, per department procedure. 70% · department procedure (image-only PDF, OCR'd by me with tesseract)
    • Is there a separate plan-check fee? Yes -- a distinct Plan Check fee line exists, separate from the Basic Construction fee. 80% · department procedure (image-only PDF, OCR'd by me)
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? Eligible/expedited rooftop PV (<=10kW meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise reviewed within 1-3 days. Non-expedited permits generally take longer per standard plan-check queue (not solar-specific figure located for Fort Bragg). 82% · department handout
    • How long is an issued permit valid before it expires? Under the City's own current code (FBMC 15.04.040/.050, Ord. 1022, 26 May 2026, amending CBC/CRC Sec. 105.5/R105.5): a permit becomes invalid if work is not commenced within 1 year (365 days) of issuance, or if a passed inspection is not obtained within every 365-day period thereafter; permits may be renewed/reinstated if expired less than 5 years. This closely mirrors the County's own Building Policy 9 (eff. 13 Mar 2026), which independently states the same 1-year/365-day/5-year figures for the areas it serves, including Fort Bragg. 85% · municipal code
    • Which utility handles interconnection here? PG&E (Pacific Gas and Electric Company) is the wires/interconnecting utility for Fort Bragg. A Community Choice Aggregator (Sonoma Clean Power layered on PG&E's wires) may supply generation service for some Mendocino County accounts, but PG&E remains the interconnecting utility. 65% · city page (Utilities section, referencing PG&E)
    • Where does the utility sit in the sequence? After permit -- utility interconnection/activation follows the County's final building inspection and approval. 65% · department handout

28 questions answered against City of Fort Bragg’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes, as titleholder -- but FBMC 15.04.030 defines the City's own 'Enforcement Agency' as the City's Building Inspection Dept 'or designated department or entity,' and in practice Mendocino County Planning & Building Services performs building/electrical plan review and inspection for Fort Bragg addresses from its own Fort Bragg field office. See jurisdiction block.

Why the confidence is not higherFBMC 15.04.030 definitional hedge plus County Building Division's own scope statement naming Fort Bragg; no single interlocal agreement document located.

municipal code checked 2026-08-31 https://www.codepublishing.com/CA/FortBragg/html/FortBragg15/FortBragg1504.html

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Delegated

Why the confidence is not higherBuilding and Electrical delegated in practice to Mendocino County Planning & Building Services (see jurisdiction block); Fire retained by the Fort Bragg Fire Protection Authority JPA rather than the City's own staff or the County.

department page checked 2026-08-31 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes -- a Building Permit is required for residential rooftop PV; the County's own building permit application (used for Fort Bragg addresses) has a dedicated 'Photovoltaic' checkbox under 'Mark All That Apply.'

Why the confidence is not higherConfirmed directly from the actual Building Permit Application PDF hosted on the City's own Community Development page (PDF metadata Title: 'Mendocino County Planning & Building Services'), and from the County's Expedited Residential Rooftop Photovoltaic Systems handout.

department-hosted permit application form checked 2026-08-31 https://www.fortbraggca.gov/departments/community_development/applications_and_brochures.php

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined -- a single Building Permit covers the structural and electrical (CEC 690/705) scope of a residential PV install; no separate stand-alone electrical permit is described for PV in the applicable handout or policy.

Why the confidence is not higherCounty's Expedited Residential Rooftop PV handout and Building Policy 14 (both applicable to Fort Bragg addresses under the County's stated scope) describe one submittal package/one permit; text fetched and read directly.

department handout (fetched via Wayback capture, dated content confirmed 'Expedited Residential Rooftop Photovoltaic Systems Plan Review, Fees, and Inspections' checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe Building Permit Application itself (hosted on the City's own site) provides for PROPERTY OWNER, AGENT, or CONTRACTOR as the applicant, with an explicit Owner/Builder declaration section.

department-hosted permit application form checked 2026-08-31 https://www.fortbraggca.gov/departments/community_development/applications_and_brochures.php

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

No separate contractor-registration step beyond standard CSLB licensing was found.

Why the confidence is not higherAbsence claim: the Building Permit Application form itself asks only for 'License # & Class' under Contractor Name, with a statutory license-law declaration; no additional City or County contractor-registration program is referenced on the form or in the fetched PV handouts.

department-hosted permit application form checked 2026-08-31 https://www.fortbraggca.gov/departments/community_development/applications_and_brochures.php

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes -- the Building Permit Application includes a full 'OWNER/BUILDER DECLARATION' section under penalty of perjury for owner-builders who are exempt from the Contractors' State License Law.

Why the confidence is not higherRead directly from the application form's owner-builder declaration section.

department-hosted permit application form checked 2026-08-31 https://www.fortbraggca.gov/departments/community_development/applications_and_brochures.php

Q8 What documents make up a complete submittal? Core Submittal package

Completed Eligibility Checklist; an Electrical Plan (or Standard Electrical Plan/PV Toolkit Doc #3-4 for systems <=10kW); a Roof/Site Plan showing panel layout, fire classification, access pathways and label locations; a Structural Plan (or the Structural Criteria checklist, PV Toolkit Doc #5, or full PE-stamped structural drawings if that checklist fails); and the completed Building Permit Application.

Why the confidence is not higherDirectly itemized in the County's 'Expedited Residential Rooftop Photovoltaic Systems' handout, fetched and read in full (this is the applicable document for Fort Bragg addresses per the County's stated service scope).

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q9 How many copies, and in what format? Submittal package

Over-the-counter: 1 completed permit application + 1 copy of an 8.5x11 plot/site plan. 'Other' (non-OTC) projects: 3 copies of construction plans, plus 2 copies of Title 24 energy compliance and 2 copies of wet-stamped engineering calculations where applicable.

Why the confidence is not higherRead directly from the County's current 'Building Permit Application Checklist' PDF, fetched via Wayback capture (letterhead lists the 120 W Fir St Fort Bragg office; a slightly older address than the 752 S Franklin St shown on 2026-dated Building Policies, but the same department).

published checklist checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/45787/637674697261070000

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes -- a roof/site plan is required showing panel/module layout, north arrow, lot dimensions, distance from property lines to structures, PV fire classification, code-compliant access pathways, and locations of required labels/disconnects.

Why the confidence is not higherItemized directly in the County's Expedited PV handout and Building Policy 14, both fetched and read in full.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes -- a one-line diagram of the complete system, including all components and wire sizes, is a required electrical-plan element.

Why the confidence is not higherExplicit line item: 'One-line diagram of system including all components and wire sizes' in the Expedited PV handout; repeated in Building Policy 14.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q12 Are string and conductor calculations required? Drawings & calculations

Yes -- total number of modules, modules per string, total strings, conductor type/size, conduit type/size and number of conductors per conduit section must all be specified.

Why the confidence is not higherExplicit required electrical-plan content in both the Expedited PV handout and Building Policy 14.

adopted department policy (Building Policy 14, eff. 13 Mar 2026) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Rooftop: a CA-licensed structural/civil engineer's stamp is required only if the system fails the Structural Criteria checklist (module weight >4 psf PV/5 psf thermal, array covering >half the roof, anchor spacing beyond the Table 1 limits, roof in Wind Exposure D -- defined to include sites 'within 200 yards of the ocean or large coastal bay,' which is directly relevant to Fort Bragg's oceanfront/coastal parcels -- more than one roof covering, non-flush mounting, etc). Ground-mount: an engineer's stamp is required whenever the array exceeds 7 feet in height.

Why the confidence is not higherStructural Criteria (PV Toolkit Doc #5) fetched and read directly gives the rooftop pass/fail table; Building Policy 14 (fetched, eff. 13 Mar 2026) states the 7-ft ground-mount threshold in its own text. The Wind Exposure D / coastal-proximity trigger is directly relevant to Fort Bragg given its coastal location.

department handout (PV Toolkit Document #5, Structural Criteria) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/4826/636241491930400000

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

No PV-specific electrical PE-stamp threshold was found; the only engineer/licensed-contractor trigger identified is general (not solar-specific): any new electrical service panel rated over 200A requires line drawings from an electrical engineer or CA-licensed electrical contractor.

Why the confidence is not higherRead directly from Building Policy 2 (Utilities & Service Connections), fetched via Wayback capture: 'Any new electrical meter service panel rated over 200 amps requires: Line drawings prepared by an electrical engineer or a CA-licensed electrical contractor.' No separate PV-electrical PE-stamp rule found in any fetched document.

adopted department policy (Building Policy 2, eff. 10 Mar 2026) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76595/639092661196030000

Q15 What does a residential solar permit cost? Core Fees

Tension between two County documents: the still-linked 2015 PV Toolkit #1 Application Guide states plainly, 'The minimum fee on a rooftop solar installation project is $83.00 and is based on the project valuation. The total permit fees, however, will not exceed $500.00.' The newer (current) Expedited handout that has otherwise superseded much of that 2015 guide's content just states 'Fees: To be in compliance with CA State AB 1414' with no dollar figure.

Why the confidence is not higherBoth figures read directly from the two PDFs themselves (not a summary); flagging the tension rather than resolving it because the newer document dropped the specific dollar amount and no current numbered Master Fee Schedule PV line item could be located/verified (it is an image-only OCR'd document with no 'solar' hits, see q59 not_found).

department handout (PV Toolkit Document #1, dated '2015 Application Guide' in its own footer, still linked live) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q16 How is the fee calculated? Core Fees

Valuation-based, per the Board of Supervisors' annually-adopted Master Fee Schedule; some structure types are billed by square footage instead, per department procedure.

Why the confidence is not higherCounty's own 'Prepaid Plan Check for Building Permit Application Submittal' procedure (Procedure No. PBS Admin.-0013, eff. 2 Sep 2022), an image-only PDF I OCR'd myself, instructs staff to 'Determine what type of structure and fee should be charged: either square feet or valuation' and references Trakit screenshots for 'Fees based on valuation' and 'Fees based on square feet'; the PV-specific 2015 guide separately confirms the PV fee itself 'is based on the project valuation.'

department procedure (image-only PDF, OCR'd by me with tesseract) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/53721/638023817169900000

Q17 Is there a separate plan-check fee? Fees

Yes -- a distinct Plan Check fee line exists, separate from the Basic Construction fee.

Why the confidence is not higherOCR'd directly from the Prepaid Plan Check procedure: staff are told they can collect a deposit by 'collecting portions of the Basic Construction, Plan Check, Planning Review and Records Management fees' as itemized components; a fee-schedule extract embedded in the same document literally lists a line item 'BASIC CONSTRUCTION FEE' separate from 'RECORDS MANAGEMENT FEE.'

department procedure (image-only PDF, OCR'd by me) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/53721/638023817169900000

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Eligible/expedited rooftop PV (<=10kW meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise reviewed within 1-3 days. Non-expedited permits generally take longer per standard plan-check queue (not solar-specific figure located for Fort Bragg).

Why the confidence is not higherThe 1-3 day figure is stated directly in the current Expedited Residential Rooftop PV handout ('Permits not approved over the counter should be reviewed within 1 to 3 days').

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q19 How long is an issued permit valid before it expires? Timeline & validity

Under the City's own current code (FBMC 15.04.040/.050, Ord. 1022, 26 May 2026, amending CBC/CRC Sec. 105.5/R105.5): a permit becomes invalid if work is not commenced within 1 year (365 days) of issuance, or if a passed inspection is not obtained within every 365-day period thereafter; permits may be renewed/reinstated if expired less than 5 years. This closely mirrors the County's own Building Policy 9 (eff. 13 Mar 2026), which independently states the same 1-year/365-day/5-year figures for the areas it serves, including Fort Bragg.

Why the confidence is not higherRead directly from the City's own current, dated municipal-code amendment chapter (Ord. 1022, passed 26 May 2026) and cross-checked against the County's own Building Policy 9, fetched and read in full -- the two independently-sourced documents state the same figures.

municipal code checked 2026-08-31 https://www.codepublishing.com/CA/FortBragg/html/FortBragg15/FortBragg1504.html

Q20 Which permit portal does this authority use? Core Portal & process

e-TRAKiT (etrakit.mendocinocounty.org) -- the County's online permit portal; also accepted in person at the County's own Fort Bragg office (752 South Franklin St).

Why the confidence is not higherCounty handouts describe applications submitted 'in person or electronically' via e-TRAKiT; the City's own site links out to Accela for its own (planning) permits but the Building Permit form and process point to the County.

portal landing page checked 2026-08-31 https://etrakit.mendocinocounty.org/eTRAKiT3/

Q21 Can the whole application be completed online? Core Portal & process

Largely yes for the County-administered building/electrical permit -- applications 'can be submitted in person or electronically' and may be approved 'over the counter electronically' per the Expedited PV handout; full self-service payment/inspection-scheduling could not be independently confirmed.

Why the confidence is not higherDirect quote from the Expedited PV handout; I could not locate or verify a dedicated 'Guidelines for Online Permit Applications' document to confirm the full workflow is self-service end to end.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas and Electric Company) is the wires/interconnecting utility for Fort Bragg. A Community Choice Aggregator (Sonoma Clean Power layered on PG&E's wires) may supply generation service for some Mendocino County accounts, but PG&E remains the interconnecting utility.

Why the confidence is not higherThe City's own website (Emergency Preparedness section) references 'PG&E' as the local electric utility, and PG&E's well-documented service territory covers the entire Mendocino coast including Fort Bragg; I could not independently confirm from a Sonoma Clean Power source page whether Fort Bragg specifically is enrolled in the CCA (the relevant CCA pages 404'd), so this is not a ZIP-lookup-tool answer but is not a first-party Fort Bragg utility-bill confirmation either.

city page (Utilities section, referencing PG&E) checked 2026-08-31 https://www.fortbraggca.gov/departments/finance_utility_billing/utilities/index.php

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit -- utility interconnection/activation follows the County's final building inspection and approval.

Why the confidence is not higherCounty's Expedited PV handout and 2015 PV Toolkit guide both state the system 'must be inspected before final approval and activation is granted' for the solar system, implying utility activation follows AHJ sign-off; not sourced from a PG&E sequence diagram itself.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No -- neither the City's own code nor the County's PV submittal documents require HOA or architectural approval as part of the building-permit process itself. (California Civil Code Section 714 separately limits HOA authority to block solar statewide.)

Why the confidence is not higherAbsence claim: none of the fetched submittal checklists, the Building Permit Application form, or the PV-specific handouts list HOA/architectural approval as a submittal item; did not exhaustively search every City design-review chapter.

published checklist checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/45787/637674697261070000

Q25 Is there a historic-district review? Overlays & special cases

No, for eligible systems -- County Ordinance 4530 (adopted 19 Dec 2023, applicable within the Coastal Zone, which includes Fort Bragg) exempts an 'Eligible Solar Energy System' (roof-mounted, on an existing legally-constructed building, not needing certain federal/state resource permits) from 'all discretionary review... and from review by the Planning Division' -- which covers Fort Bragg's own Local Coastal Program design/historic review as well as the County's Coastal Zone review, though the fact sheet does not name a specific 'Historic Review Board' by title.

Why the confidence is not higherOrdinance 4530 fact sheet fetched and read directly, is explicit about the discretionary/Planning-Division exemption; whether it displaces a City-specific historic-district process (Fort Bragg has a historic downtown) is inferred, not stated verbatim.

department fact sheet, citing Ord. No. 4530 (19 Dec 2023) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73112/638896635879730000

Q26 Is a wind or windstorm certification required? Overlays & special cases

No windstorm/wind-zone certification requirement (no TDI-style program) was found; wind uplift for rooftop PV is instead handled through the Structural Criteria anchor-spacing/fastener tables (Wind Exposure C/D distinctions).

Why the confidence is not higherAbsence claim, controls run on the fetched corpus (73010, 76609, 4818, 4826): searched for 'windstorm', 'wind certif', 'TDI' -- zero hits; positive control 'electrical' returned multiple hits in the same files, fabricated control 'zzqqx' returned zero, confirming the search was working. California has no statewide TDI-style windstorm-certificate analog.

department handout (Structural Criteria) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/4826/636241491930400000

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

No, for qualifying systems -- the 2015 PV Toolkit guide states 'Planning review IS NOT required for solar PV installations of this size' (<=10kW rooftop), and Ordinance 4530 separately exempts eligible rooftop solar from discretionary Coastal Zone/Planning Division review. No Council or Specific Use Permit process was found for qualifying residential PV.

Why the confidence is not higherDirect quotes from the 2015 PV Toolkit guide and the Ordinance 4530 fact sheet, both fetched and read in full.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No hard cap on residential system size was found; 10kW AC is only the eligibility threshold for the expedited/over-the-counter review track (Eligibility Checklist item A). Larger systems are not prohibited, they simply do not qualify for the fast-track process and go through full plan review with PE-stamped drawings.

Why the confidence is not higherThe Eligibility Checklist frames the 10kW figure as a condition for the fast-track process, not a ceiling; I could not reach the City's own zoning/Land Use Code articles (codepublishing.com's Land Use Code sub-pages 404'd on every URL pattern tried) to confirm there is no separate zoning-code size cap, so this should be read as County-process-level only.

department handout (Eligibility Checklist, embedded) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? California Electrical Code, 2025 Edition, Part 3 (based on the 2023 NEC as part of the 2025 Title 24 cycle) -- adopted directly by the City in FBMC 15.04.020(D), Ord. 1022, passed 26 May 2026. 92% · municipal code
    • Which building code edition is in force? California Building Code and California Residential Code, both 2025 Edition (Title 24 Parts 2 & 2.5), adopted directly by the City in FBMC 15.04.020(B)-(C), Ord. 1022, passed 26 May 2026. 92% · municipal code
    • Which fire code edition is in force? California Fire Code, 2025 Edition, Part 9 (Title 24) -- adopted directly by the City as 'the Fort Bragg Fire Code' in FBMC 15.05.010, Ord. 1022, passed 26 May 2026, with the Fire Chief (via the Fort Bragg Fire Protection Authority JPA) as the enforcing official. 90% · municipal code
    • Are there local amendments to any of the above? Yes -- the City amends the state model codes in multiple places (e.g., FBMC 15.04.040/.050/.060 modify CBC/CRC/CEC Sections 105.3.2, 105.5, 109.6, R105.3.2, R105.5, R108.5, Annex H 80.15/80.19 with City-specific expiration/refund/extension rules; Appendix H sign provisions are also locally amended). The County separately layers its own numbered Building Policies (#1-19) covering PV/solar submittal, structural criteria and permit-status definitions on top of the state code for the areas (including Fort Bragg) it administers. 80% · municipal code
    • What is the installation judged against? The 2025 California Building Code, Residential Code, Electrical Code and Fire Code as locally amended by FBMC Title 15 Ch. 15.04/15.05, plus the County of Mendocino's Building Policies (#2, #5, #9, #14) and PV Toolkit standard plans, which the County applies in practice to Fort Bragg permits. 82% · adopted department policy
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Access pathways are referenced to California Residential Code Section 324 in the County's own Expedited PV handout, rather than restated as a locally-specific dimensional table; the roof plan must show fire classification and code-compliant access pathway locations. No Fort-Bragg-specific ridge-setback amendment was found in the City's own Fire Code chapter (15.05), which is a bare adoption with only edition/application/appeals sections. 65% · department handout
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Rapid shutdown is required as a function of the statewide California Electrical Code (2025 Edition / effectively 2023 NEC Section 690.12), adopted directly into FBMC 15.04.020(D). No City or County document in the corpus I fetched cites '690.12' or 'rapid shutdown' by name. 55% · municipal code
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? At minimum, three signs: (1) identifying PV power-source system attributes at the DC disconnect, (2) identifying the AC point of connection, (3) identifying the switch for the alternative power system. PG&E separately requires its own 'UTILITY AC DISCONNECT SWITCH' label at its own disconnect (see q42). 88% · adopted department policy (Building Policy 14)
    • Does the authority specify placard wording of its own? Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection, alternate power switch) but does not mandate exact verbatim wording of its own, unlike PG&E's exact wording for its own utility disconnect label. 68% · adopted department policy
    • Does it specify letter height, colour or material? No City or County document fetched specifies letter height, colour or material for the AHJ-required signs as a hard requirement (the 2015 PV Toolkit guide describes sign function only). PG&E separately mandates a hard minimum of 3/8" all-capital lettering, engraved phenolic or ANSI Z535.4-compliant, for its own utility disconnect label (utility-level, not AHJ -- see q42). 55% · adopted department policy
    • Is a site plan / facility map placard required, and what must it show? Yes -- a roof/site plan (facility-map equivalent) is required showing panel/module layout, north arrow, lot dimensions, distance to property lines/structures, PV fire classification, clear access pathways, and locations of all required labels/markings and electrical disconnects/roof access points. 85% · department handout
    • Does the UTILITY specify placards beyond the AHJ's? Yes -- PG&E's own Distribution Interconnection Handbook document (Greenbook doc 060559, 'Disconnect Switch Requirements for Distributed Generation Customers,' Rev. #07, approved 25 Mar 2022) requires a permanently attached label reading e.g. 'UTILITY AC DISCONNECT SWITCH,' engraved phenolic or ANSI Z535.4-compliant, minimum 3/8" all-capital lettering -- beyond and in addition to the AHJ's own three signs (q38). PG&E is the interconnecting utility for Fort Bragg (see q22). 85% · utility interconnection handbook (PG&E Greenbook doc 060559, Rev. #07, 3/25/2022)
    • Where must the labels be placed? AHJ level: at the DC disconnect, at the AC point of connection, and at the alternate-power-system switch. Utility (PG&E) level: the AC disconnect label must be on the front of the switch, and the switch itself must be within 10 feet and in line of sight of PG&E's meter, at the same grade level as the meter, mounted 48"-75" high if wall/pad-mounted, never on a roof or a floor above grade. 78% · adopted department policy + utility interconnection handbook (PG&E)
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Where must the AC disconnect be, relative to the meter? Within 10 feet, in line of sight, of PG&E's electric meter; at the same grade level as the meter if outdoors; mounted 48"-75" high if wall- or pad-mounted; never on a roof, an upper floor, or inside a non-approved meter room. 75% · utility interconnection handbook
    • Must equipment be on a specific approved list? Yes -- equipment must be listed/labeled for its PV application (CEC 690.4(D)); equipment cut sheets for inverters, modules, disconnects and combiner boxes are a required submittal item. This is the statewide CEC listing requirement rather than a County- or City-specific approved-products list. 80% · department handout
    • Are batteries permitted, and under what conditions? Yes, with conditions -- battery storage disqualifies a project from the expedited/over-the-counter PV track, but batteries are explicitly accommodated in the standard submittal: Building Policy 14 requires 'Battery storage details, if applicable, including location and venting' on the electrical diagram, and defines both 'Grid-Connected System' and 'Stand-Alone Solar Power System... typically incorporating battery storage.' 85% · adopted department policy
    • Is there a separate ESS permit or inspection? No standalone 'ESS permit' was identified -- battery/ESS installation is folded into the standard Building Permit/inspection process described in Building Policy 14, not a separately named permit type. The Building Permit Application form itself has no distinct ESS/battery checkbox (only 'Photovoltaic'). 60% · department-hosted permit application form
    • Is a ground mount treated as a structure? Yes -- a ground-mounted PV system requires foundation/footing plans and reinforcement details, with a California-licensed engineer's approval mandatory for arrays exceeding 7 feet in height. 88% · adopted department policy
    • Is there a local rule on service upgrades or busbar sizing? Yes -- County Building Policy 2 (Utilities & Service Connections, eff. 10 Mar 2026): a single-family residence must have a minimum 100A, 3-wire service (CEC 230.79(c)); any new panel over 200A requires load calculations/line drawings from a CA-licensed electrical contractor or engineer; amperage must be justified from existing loads only. 85% · adopted department policy (Building Policy 2, eff. 10 Mar 2026)
    • Is a specific mounting system or attachment spacing required? Yes -- prescriptive anchor/attachment spacing tables (Structural Criteria, PV Toolkit Doc #5): e.g. up to 6'-0" horizontal anchor spacing at 24" rafter spacing on flat-to-6:12 roofs, tightening to as little as 1'-4" on steeper slopes (7:12-24:12); truss rules require 6' spacing generally or 4' alternating spacing where truss spacing is 16" o.c. or splice locations cannot be confirmed. 88% · department handout (PV Toolkit Document #5)

20 questions answered against City of Fort Bragg’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

California Electrical Code, 2025 Edition, Part 3 (based on the 2023 NEC as part of the 2025 Title 24 cycle) -- adopted directly by the City in FBMC 15.04.020(D), Ord. 1022, passed 26 May 2026.

Why the confidence is not higherRead verbatim from the City's own current, dated code-adoption ordinance: 'California Electrical Code, 2025 Edition, Part 3, together with Annex H... as published by the National Fire Protection Association.'

municipal code checked 2026-08-31 https://www.codepublishing.com/CA/FortBragg/html/FortBragg15/FortBragg1504.html

Q30 Which building code edition is in force? Core Code editions in force

California Building Code and California Residential Code, both 2025 Edition (Title 24 Parts 2 & 2.5), adopted directly by the City in FBMC 15.04.020(B)-(C), Ord. 1022, passed 26 May 2026.

Why the confidence is not higherRead verbatim from the City's own current code-adoption ordinance text.

municipal code checked 2026-08-31 https://www.codepublishing.com/CA/FortBragg/html/FortBragg15/FortBragg1504.html

Q31 Which fire code edition is in force? Code editions in force

California Fire Code, 2025 Edition, Part 9 (Title 24) -- adopted directly by the City as 'the Fort Bragg Fire Code' in FBMC 15.05.010, Ord. 1022, passed 26 May 2026, with the Fire Chief (via the Fort Bragg Fire Protection Authority JPA) as the enforcing official.

Why the confidence is not higherRead verbatim from FBMC 15.05.010: 'The California Fire Code, California Code of Regulations, Title 24, Part 9, 2025 Edition... This chapter shall be known as the Fort Bragg Fire Code.'

municipal code checked 2026-08-31 https://www.codepublishing.com/CA/FortBragg/html/FortBragg15/FortBragg1505.html

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes -- the City amends the state model codes in multiple places (e.g., FBMC 15.04.040/.050/.060 modify CBC/CRC/CEC Sections 105.3.2, 105.5, 109.6, R105.3.2, R105.5, R108.5, Annex H 80.15/80.19 with City-specific expiration/refund/extension rules; Appendix H sign provisions are also locally amended). The County separately layers its own numbered Building Policies (#1-19) covering PV/solar submittal, structural criteria and permit-status definitions on top of the state code for the areas (including Fort Bragg) it administers.

Why the confidence is not higherConfirmed directly from the City's own current code-adoption chapter (FBMC 15.04.040 through .060, read in full) and the County's Building Policy library (Policies 2, 5, 9, 14, all fetched and read).

municipal code checked 2026-08-31 https://www.codepublishing.com/CA/FortBragg/html/FortBragg15/FortBragg1504.html

Q33 What is the installation judged against? Core Electrical

The 2025 California Building Code, Residential Code, Electrical Code and Fire Code as locally amended by FBMC Title 15 Ch. 15.04/15.05, plus the County of Mendocino's Building Policies (#2, #5, #9, #14) and PV Toolkit standard plans, which the County applies in practice to Fort Bragg permits.

Why the confidence is not higherDirectly stated authority sections in both the City's Ord. 1022 (26 May 2026) and the County's Building Policy 14 ('Authority' section, citing MCC Title 18 Ch. 18.40, CBC Ch. 15, CRC R329/R330, CEC 690/705, CFC).

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Yes -- County Building Policy 2 (Utilities & Service Connections, eff. 10 Mar 2026): a single-family residence must have a minimum 100A, 3-wire service (CEC 230.79(c)); any new panel over 200A requires load calculations/line drawings from a CA-licensed electrical contractor or engineer; amperage must be justified from existing loads only.

Why the confidence is not higherRead directly from Building Policy 2, fetched via Wayback capture and confirmed as the current, signed (10 Mar 2026) departmental policy applicable to areas the County serves, including Fort Bragg.

adopted department policy (Building Policy 2, eff. 10 Mar 2026) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76595/639092661196030000

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Yes -- prescriptive anchor/attachment spacing tables (Structural Criteria, PV Toolkit Doc #5): e.g. up to 6'-0" horizontal anchor spacing at 24" rafter spacing on flat-to-6:12 roofs, tightening to as little as 1'-4" on steeper slopes (7:12-24:12); truss rules require 6' spacing generally or 4' alternating spacing where truss spacing is 16" o.c. or splice locations cannot be confirmed.

Why the confidence is not higherRead directly from the Structural Criteria PDF's own Table 1 and accompanying notes, fetched and read in full.

department handout (PV Toolkit Document #5) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/4826/636241491930400000

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Access pathways are referenced to California Residential Code Section 324 in the County's own Expedited PV handout, rather than restated as a locally-specific dimensional table; the roof plan must show fire classification and code-compliant access pathway locations. No Fort-Bragg-specific ridge-setback amendment was found in the City's own Fire Code chapter (15.05), which is a bare adoption with only edition/application/appeals sections.

Why the confidence is not higherThe County document points to CRC 324 rather than restating the dimensional table (consistent with ICC-copyrighted material not being freely republished); the City's own Fire Code chapter (15.05, fetched and read in full, 3 sections) contains no PV-specific ridge-setback text at all -- a control-checked absence (0 'solar'/'photovoltaic' hits in FBMC 15.05, positive control 'fire' >5 hits, fabricated 'zzqqx' 0 hits).

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Rapid shutdown is required as a function of the statewide California Electrical Code (2025 Edition / effectively 2023 NEC Section 690.12), adopted directly into FBMC 15.04.020(D). No City or County document in the corpus I fetched cites '690.12' or 'rapid shutdown' by name.

Why the confidence is not higherControl-checked absence: grepped the full fetched corpus (County Expedited handout, Building Policy 14, 2015 PV Toolkit guide, City FBMC 15.04/15.05) for '690.12' and 'rapid shutdown' -- zero hits in every file; positive control 'electrical' returned 1-8 hits in the same files, fabricated control 'zzqqx' returned zero, confirming the search worked. The requirement is inferred from statewide CEC adoption, not a Fort-Bragg-specific statement.

municipal code checked 2026-08-31 https://www.codepublishing.com/CA/FortBragg/html/FortBragg15/FortBragg1504.html

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

At minimum, three signs: (1) identifying PV power-source system attributes at the DC disconnect, (2) identifying the AC point of connection, (3) identifying the switch for the alternative power system. PG&E separately requires its own 'UTILITY AC DISCONNECT SWITCH' label at its own disconnect (see q42).

Why the confidence is not higherIdentical three-sign requirement stated in both the 2015 PV Toolkit guide's inspection checklist and the current Building Policy 14 (Section 4.3, Labeling & Signage), both fetched and read directly.

adopted department policy (Building Policy 14) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection, alternate power switch) but does not mandate exact verbatim wording of its own, unlike PG&E's exact wording for its own utility disconnect label.

Why the confidence is not higherBuilding Policy 14 and the 2015 PV Toolkit guide describe sign function/content, not exact text strings.

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

No City or County document fetched specifies letter height, colour or material for the AHJ-required signs as a hard requirement (the 2015 PV Toolkit guide describes sign function only). PG&E separately mandates a hard minimum of 3/8" all-capital lettering, engraved phenolic or ANSI Z535.4-compliant, for its own utility disconnect label (utility-level, not AHJ -- see q42).

Why the confidence is not higherAbsence claim on the AHJ side: read the full text of the 2015 PV Toolkit guide, the Expedited handout and Building Policy 14 -- none specify letter height/colour/material for the three required AHJ signs (unlike, e.g., LACoFD or Hollister's own specs found elsewhere in this survey). Did not locate a Mendocino-specific PV Toolkit Document #4 (Standard Electrical Plan) copy to check for a sign-format box.

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Yes -- a roof/site plan (facility-map equivalent) is required showing panel/module layout, north arrow, lot dimensions, distance to property lines/structures, PV fire classification, clear access pathways, and locations of all required labels/markings and electrical disconnects/roof access points.

Why the confidence is not higherConsistent requirement across the Expedited PV handout and Building Policy 14, both fetched and read.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes -- PG&E's own Distribution Interconnection Handbook document (Greenbook doc 060559, 'Disconnect Switch Requirements for Distributed Generation Customers,' Rev. #07, approved 25 Mar 2022) requires a permanently attached label reading e.g. 'UTILITY AC DISCONNECT SWITCH,' engraved phenolic or ANSI Z535.4-compliant, minimum 3/8" all-capital lettering -- beyond and in addition to the AHJ's own three signs (q38). PG&E is the interconnecting utility for Fort Bragg (see q22).

Why the confidence is not higherThis specific PG&E document was not re-fetched by me this run (I relied on utility-territory knowledge plus the City's own reference to PG&E for electric service); the document itself is PG&E's standard statewide Greenbook publication applicable wherever PG&E interconnects, which includes Fort Bragg.

utility interconnection handbook (PG&E Greenbook doc 060559, Rev. #07, 3/25/2022) checked 2026-08-31 https://www.pge.com/assets/pge/docs/account/service-requests/060559.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

AHJ level: at the DC disconnect, at the AC point of connection, and at the alternate-power-system switch. Utility (PG&E) level: the AC disconnect label must be on the front of the switch, and the switch itself must be within 10 feet and in line of sight of PG&E's meter, at the same grade level as the meter, mounted 48"-75" high if wall/pad-mounted, never on a roof or a floor above grade.

Why the confidence is not higherAHJ portion read directly from Building Policy 14/2015 PV Toolkit guide; utility portion drawn from PG&E's standard Greenbook doc 060559 (not independently re-fetched this run, but a standard statewide PG&E publication).

adopted department policy + utility interconnection handbook (PG&E) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q44 Must equipment be on a specific approved list? Equipment listing

Yes -- equipment must be listed/labeled for its PV application (CEC 690.4(D)); equipment cut sheets for inverters, modules, disconnects and combiner boxes are a required submittal item. This is the statewide CEC listing requirement rather than a County- or City-specific approved-products list.

Why the confidence is not higherCited directly in the 2015 PV Toolkit guide and Building Policy 14, both fetched and read.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Yes, with conditions -- battery storage disqualifies a project from the expedited/over-the-counter PV track, but batteries are explicitly accommodated in the standard submittal: Building Policy 14 requires 'Battery storage details, if applicable, including location and venting' on the electrical diagram, and defines both 'Grid-Connected System' and 'Stand-Alone Solar Power System... typically incorporating battery storage.'

Why the confidence is not higherRead directly from Building Policy 14's Definitions and Section 2 (Permit Submittal Requirements), fetched and read in full.

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No standalone 'ESS permit' was identified -- battery/ESS installation is folded into the standard Building Permit/inspection process described in Building Policy 14, not a separately named permit type. The Building Permit Application form itself has no distinct ESS/battery checkbox (only 'Photovoltaic').

Why the confidence is not higherAbsence claim: the Building Permit Application PDF (checked directly) lists 'Photovoltaic' as a project-type checkbox with no separate battery/ESS checkbox; Building Policy 14 treats batteries as an item within the general solar submittal.

department-hosted permit application form checked 2026-08-31 https://www.fortbraggca.gov/departments/community_development/applications_and_brochures.php

Q47 Is a ground mount treated as a structure? Core Ground mount

Yes -- a ground-mounted PV system requires foundation/footing plans and reinforcement details, with a California-licensed engineer's approval mandatory for arrays exceeding 7 feet in height.

Why the confidence is not higherExplicit in Building Policy 14 Section 3 ('A California-licensed engineer's approval is required for ground-mounted PV arrays exceeding seven (7) feet in height') and Section 4.1 (Structural & Mounting inspection items include 'Foundation and footing details, including reinforcement').

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Within 10 feet, in line of sight, of PG&E's electric meter; at the same grade level as the meter if outdoors; mounted 48"-75" high if wall- or pad-mounted; never on a roof, an upper floor, or inside a non-approved meter room.

Why the confidence is not higherDrawn from PG&E's standard statewide Greenbook doc 060559 (utility-level requirement, not re-fetched this run but a standard PG&E publication applicable wherever PG&E interconnects, including Fort Bragg).

utility interconnection handbook checked 2026-08-31 https://www.pge.com/assets/pge/docs/account/service-requests/060559.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Phone (automated inspection request line, separate Ukiah/Fort Bragg numbers -- Fort Bragg: 707-961-2677 per the 2015 guide, or 707-964-5379/964-5379 general office line) or Portal (e-TRAKiT online scheduling). 85% · department handout
    • How much notice is required? By 3:00 PM the business day before the requested inspection (effectively 1 business day's notice). 82% · department page (fetched via Wayback capture; direct access returned HTTP 403/Akamai block)
    • Are same-day or AM/PM windows offered? AM/PM windows are attempted but not guaranteed; the department publishes a fixed weekly inspection-day rotation for the Fort Bragg/coastal area ('Fort Bragg: Monday through Friday' per the current inspection-area table). 75% · department page (fetched via Wayback capture)
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes, in effect -- Mendocino County Planning & Building Services performs the final solar inspection for Fort Bragg addresses under the delegation described in the jurisdiction block; the City itself has no Building Inspector on staff. 78% · department page (fetched via Wayback capture)
    • If delegated, to whom? Delegated -- to Mendocino County Planning and Building Services (Building Division), which self-performs inspections for the unincorporated county plus the cities of Fort Bragg and Point Arena. 80% · department page (fetched via Wayback capture)
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? At minimum a final inspection is required before activation. Ground-mount or larger installs also require a foundation/footing inspection (Building Policy 14 Section 4.1) prior to final. 75% · adopted department policy
    • Is a rough-in or mid-roof inspection required? Not clearly a universal requirement for a simple rack-only rooftop retrofit; a foundation/footing inspection is required for ground-mount arrays (Building Policy 14, Section 4.1), and the City's separate roofing policy (Building Policy 5) requires a roof-sheathing nailing inspection where new sheathing is involved in a re-roof. 55% · adopted department policy (Building Policy 5, eff. 10 Mar 2026)
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? Yes -- inspection checklists are embedded directly in the 2015 PV Toolkit guide and current Building Policy 14 (Sections 4.1-4.4), both fetched and read in full. 85% · adopted department policy
    • What must be on site at inspection? The approved job-copy plans and the permit itself must be on site for the inspector to review; permit holders must be prepared to show conformance with all requirements in the field at the time of inspection. 82% · department handout
    • Does the inspector verify labels and listings? Yes -- the inspector verifies module/inverter make-model against plans and spec sheets, equipment listing/labeling, and that installed signage matches equipment ratings (inverter voltage rating vs. sign, OCPD ratings vs. sign, etc). 88% · adopted department policy
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final approval / 'activation,' rather than a certificate of occupancy, green tag, or letter, is the closest match for a solar-only permit. 75% · department handout
    • Who notifies the utility for PTO? Installer -- consistent with standard California interconnection practice, the installer/customer submits the PTO paperwork to PG&E once the County has granted final inspection approval; no Fort Bragg or Mendocino County document names who specifically contacts PG&E. 50% · department handout
    • How are corrections issued and cleared? Corrections are issued via a written correction/revision process; a 'Correction Letter' status is defined in the County's own permit-status framework (issued when at least one division has 'corrections' noted in the plan-review table), and revisions to an active permit extend the permit 180 calendar days from submittal. The City's own code (FBMC 15.04.040/.050) contains a parallel 'submittal of revisions... shall extend the building permit 180 calendar days' provision. 78% · adopted department policy (Building Policy 9, eff. 13 Mar 2026)

14 questions answered against City of Fort Bragg’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Phone (automated inspection request line, separate Ukiah/Fort Bragg numbers -- Fort Bragg: 707-961-2677 per the 2015 guide, or 707-964-5379/964-5379 general office line) or Portal (e-TRAKiT online scheduling).

Why the confidence is not higherBoth methods and the Fort-Bragg-specific inspection phone number are stated directly in the County's own PV handout and current Building Division page content, fetched via Wayback capture.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q50 How much notice is required? Core Booking & scheduling

By 3:00 PM the business day before the requested inspection (effectively 1 business day's notice).

Why the confidence is not higherStated verbatim on the County Building Division's current page content (fetched via Wayback capture of the live URL, since direct access 403'd): 'The deadline to call for an inspection is 3:00pm THE DAY BEFORE.'

department page (fetched via Wayback capture; direct access returned HTTP 403/Akamai block) checked 2026-08-31 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

AM/PM windows are attempted but not guaranteed; the department publishes a fixed weekly inspection-day rotation for the Fort Bragg/coastal area ('Fort Bragg: Monday through Friday' per the current inspection-area table).

Why the confidence is not higherRead from the County Building Division's current page content, fetched via Wayback capture, which lists Fort Bragg alongside other coastal-area inspection day schedules.

department page (fetched via Wayback capture) checked 2026-08-31 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes, in effect -- Mendocino County Planning & Building Services performs the final solar inspection for Fort Bragg addresses under the delegation described in the jurisdiction block; the City itself has no Building Inspector on staff.

Why the confidence is not higherConsistent with the Building Division's stated scope (naming Fort Bragg), its own Fort Bragg inspection phone line, and the absence of any Building Official/Inspector title in the City's own Community Development staff directory.

department page (fetched via Wayback capture) checked 2026-08-31 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q53 If delegated, to whom? Core Who inspects

Delegated -- to Mendocino County Planning and Building Services (Building Division), which self-performs inspections for the unincorporated county plus the cities of Fort Bragg and Point Arena.

Why the confidence is not higherSame basis as q52; the City's own Community Development staff directory lists no Building Inspector, and the County's own scope statement names Fort Bragg by name.

department page (fetched via Wayback capture) checked 2026-08-31 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q54 Which inspections are required, and in what order? Core Stages & sequence

At minimum a final inspection is required before activation. Ground-mount or larger installs also require a foundation/footing inspection (Building Policy 14 Section 4.1) prior to final.

Why the confidence is not higherCombined from the Expedited PV handout ('must be inspected before final approval') and Building Policy 14's Section 4.1 structural/mounting inspection items, both fetched and read.

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

Not clearly a universal requirement for a simple rack-only rooftop retrofit; a foundation/footing inspection is required for ground-mount arrays (Building Policy 14, Section 4.1), and the City's separate roofing policy (Building Policy 5) requires a roof-sheathing nailing inspection where new sheathing is involved in a re-roof.

Why the confidence is not higherPieced together from Building Policy 14 (ground-mount structural checks) and Building Policy 5 (Fire Classification & Roofing Requirements, fetched and read -- no PV-specific mid-roof rule stated); no single document states a universal mid-roof/rough-in rule for all PV installs.

adopted department policy (Building Policy 5, eff. 10 Mar 2026) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76599/639092661203070000

Q56 Does the inspector verify labels and listings? Core What is checked

Yes -- the inspector verifies module/inverter make-model against plans and spec sheets, equipment listing/labeling, and that installed signage matches equipment ratings (inverter voltage rating vs. sign, OCPD ratings vs. sign, etc).

Why the confidence is not higherDetailed, itemized inspection checklist in both the 2015 PV Toolkit guide and current Building Policy 14 Section 4.4 (Equipment Ratings & Protection), both fetched and read in full.

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q57 Is there a published inspection checklist? Core What is checked

Yes -- inspection checklists are embedded directly in the 2015 PV Toolkit guide and current Building Policy 14 (Sections 4.1-4.4), both fetched and read in full.

Why the confidence is not higherRead directly; both documents contain itemized inspection checklists rather than a vague reference to one.

adopted department policy checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q58 What must be on site at inspection? Core Documents on site

The approved job-copy plans and the permit itself must be on site for the inspector to review; permit holders must be prepared to show conformance with all requirements in the field at the time of inspection.

Why the confidence is not higherDirect quote from the Expedited PV handout: 'The approved plans and permit shall be onsite for the inspector.'

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q59 Is there a re-inspection fee? Corrections & re-inspection

Nothing published by this authority.

Where we lookedCounty Building Policy 9 (Permit Status/Expiration/Reinstatement, eff. 13 Mar 2026, fetched and read in full), Building Policy 5 (Fire Classification & Roofing, fetched and read in full), the Prepaid Plan Check procedure (Procedure PBS Admin.-0013, OCR'd by me from the image-only PDF), and the City's own FBMC 15.04/15.08 fee-adoption chapters (fetched and read) -- none state a specific re-inspection fee dollar amount; only a permit-reinstatement fee for expired permits and a general plan-check fee 'established by resolution of the City Council' are mentioned, neither of which is a re-inspection fee.

https://www.mendocinocounty.gov/home/showpublisheddocument/76601/639092661207230000

Q60 How are corrections issued and cleared? Corrections & re-inspection

Corrections are issued via a written correction/revision process; a 'Correction Letter' status is defined in the County's own permit-status framework (issued when at least one division has 'corrections' noted in the plan-review table), and revisions to an active permit extend the permit 180 calendar days from submittal. The City's own code (FBMC 15.04.040/.050) contains a parallel 'submittal of revisions... shall extend the building permit 180 calendar days' provision.

Why the confidence is not higherRead directly from the County's Building Policy 9 (Permit Status, Expiration & Reinstatement, fetched and read in full) and the City's own current code-adoption ordinance (fetched and read in full) -- the two independently state the same 180-day revision-extension mechanic.

adopted department policy (Building Policy 9, eff. 13 Mar 2026) checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/76605/639092661214530000

Q61 What is issued on pass? Core Final sign-off & PTO

Final approval / 'activation,' rather than a certificate of occupancy, green tag, or letter, is the closest match for a solar-only permit.

Why the confidence is not higherThe Expedited PV handout and 2015 PV Toolkit guide consistently describe 'final approval' and 'activation' being granted on pass, without referencing a CO, green-tag or letter format.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer -- consistent with standard California interconnection practice, the installer/customer submits the PTO paperwork to PG&E once the County has granted final inspection approval; no Fort Bragg or Mendocino County document names who specifically contacts PG&E.

Why the confidence is not higherInferred from standard statewide practice and the phrasing that 'final approval and activation' follow inspection; no City or County document names the party responsible for the PTO notification step.

department handout checked 2026-08-31 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Fort Bragg against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Fort Bragg is the authority having jurisdiction 88% confidence
Holds
Both (Building and Electrical) -- but performed via delegation to Mendocino County; Fire is separately performed by a City/rural-district JPA
Delegated to
Mendocino County Planning and Building Services (Building Division)
Why not higher
Two independent lines of evidence converge. (1) The CITY's own current municipal code (FBMC 15.04.030, Ord. 1022, passed 26 May 2026) defines 'BUILDING OFFICIAL' as the Community Development Director 'or his or her contracted official or designee' and 'ENFORCEMENT AGENCY' as 'the Building Inspection Department of the City OR DESIGNATED DEPARTMENT OR ENTITY' -- a definitional hedge of exactly the kind that signals delegation without naming it outright. The City's own Community Development staff directory lists only planning staff (Associate Planner, Assistant Planner, Administrative Assistant) -- no Building Official or Building Inspector at all -- and the department's own mission statement says it 'review[s] and issue[s] planning permits' (not building permits). (2) On the COUNTY side, Mendocino County's Planning & Building Services Building Division states outright that it administers building code 'in the unincorporated areas of Mendocino County and the cities of Fort Bragg and Point Arena,' maintains its OWN physical office in Fort Bragg (752 South Franklin St, phone 707-964-5379/964-5379, separate 'FB' fax line), and its own PV-specific handout and Building Policy #14 letterhead lists that Fort Bragg address as a Department of Planning and Building Services office. Clinching first-party evidence: the City's own Community Development 'Applications & Brochures' page hosts a file literally named 'USE THIS ONE!!!! building permit application.pdf' whose PDF metadata Title is 'Mendocino County Planning & Building Services' -- i.e. the form the City directs residents to use for a building permit is the County's own form. FIRE is different: FBMC 15.05.020/.030 (Ord. 1022, 26 May 2026) has the Fire Chief enforce the Fire Code and has the Fire Appeals Board 'appointed by the Fort Bragg Fire Protection Authority' -- a JPA formed in 1990 between the City of Fort Bragg and the Fort Bragg Rural Fire Protection District, per the City's own Fire Department page -- so fire code enforcement is NOT delegated to the County; it sits with this City-affiliated JPA. Not full confidence because I could not obtain a single document that says 'the County performs Fort Bragg's building permitting under contract/agreement number X' -- the finding rests on convergent circumstantial evidence, not a signed interlocal agreement.

https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Permit required
Yes -- a Building Permit is required for residential rooftop PV; the County's own building permit application (used for Fort Bragg addresses) has a dedicated 'Photovoltaic' checkbox under…95%
Permit cost
Tension between two County documents: the still-linked 2015 PV Toolkit #1 Application Guide states plainly,55%
Plan review
Eligible/expedited rooftop PV (<=10kW meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise reviewed within 1-3 days.82%
Portal
e-TRAKiT (etrakit.mendocinocounty.org) -- the County's online permit portal; also accepted in person at the County's own Fort Bragg office (752 South Franklin St).85%
Electrical code
California Electrical Code, 2025 Edition, Part 3 (based on the 2023 NEC as part of the 2025 Title 24 cycle) -- adopted directly by the City in FBMC 15.04.020(D), Ord.92%
Own placard wording
Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection,68%
Booking an inspection
Phone (automated inspection request line, separate Ukiah/Fort Bragg numbers -- Fort Bragg: 707-961-2677 per the 2015 guide,85%
Labels & placards for this authority

Wording 68%

Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection, alternate power switch) but does not mandate exact verbatim wording of its own, unlike PG&E's exact wording for its own utility disconnect label.

Size, colour & material 55%

No City or County document fetched specifies letter height, colour or material for the AHJ-required signs as a hard requirement (the 2015 PV Toolkit guide describes sign function only). PG&E separately mandates a hard minimum of 3/8" all-capital lettering, engraved phenolic or ANSI Z535.4-compliant, for its own utility disconnect label (utility-level, not AHJ -- see q42).

Where they go 78%

AHJ level: at the DC disconnect, at the AC point of connection, and at the alternate-power-system switch. Utility (PG&E) level: the AC disconnect label must be on the front of the switch, and the switch itself must be within 10 feet and in line of sight of PG&E's meter, at the same grade level as the meter, mounted 48"-75" high if wall/pad-mounted, never on a roof or a floor above grade.

What the utility wants on top 85%

Yes -- PG&E's own Distribution Interconnection Handbook document (Greenbook doc 060559, 'Disconnect Switch Requirements for Distributed Generation Customers,' Rev. #07, approved 25 Mar 2022) requires a permanently attached label reading e.g. 'UTILITY AC DISCONNECT SWITCH,' engraved phenolic or ANSI Z535.4-compliant, minimum 3/8" all-capital lettering -- beyond and in addition to the AHJ's own three signs (q38). PG&E is the interconnecting utility for Fort Bragg (see q22).

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Mendocino County
Regions served
1
Regions covered
City of Fort Bragg · city
Solar Requirements
Authority Contact
Address
416 N. Franklin Street, Fort Bragg, CA 95437
Main Phone
707-961-2823
Building Department
Department
Community Development Department
Direct Phone
707-961-2823
Portal Software
Accela
Booking & Scheduling
Preferred channel
online_portal
Book in advance
1
Notes
City of Fort Bragg runs its own Community Development Department separate from Mendocino County. Uses Accela Citizen Access portal (available 24/7) for permit applications and inspection scheduling — Building section has a Schedule an Inspection link. The city contracts with 4Leaf Inc. for building permit inspection services. Dept hours: Mon/Tue/Thu/Fri 9am-5pm (Wednesday is in-service day, office closed). Applications also accepted by email (cdd@fortbraggca.gov) or in person at 416 N. Franklin St. Key staff: Lisi Horstman admin ext. 119, Sarah Peters associate planner ext. 114. (collected Jul 2026)
