City of Fortuna
Humboldt County
City of Fortuna is a city authority in the State of California, serving 12,516 residents. 429 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 1 to 3 business days after a complete application Q18 Where you file — OpenGov Permitting & Licensing at fortunaca.portal.opengov.com (the city's former 'ViewPoint Cloud' portal, fortunaca.viewpointcloud.com, Q20
- Permit required
- Yes95% source
- What it costs
- $400 flat for residential systems up to 15kW; $15 per kW for capacity above 15kW. Battery backup add-on: $53.85 per pack.95% source
- Plan review turnaround
- 1 to 3 business days after a complete application92% source
- Key document
- municipal code cited by 6 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · municipal code
- What does this authority permit itself, and what does it delegate? Both 82% · fee schedule
- Is a permit required for a residential rooftop PV system? Yes 95% · municipal code
- Is there a separate electrical permit, or is it combined? Combined 80% · fee schedule
- Is a HOA or architectural approval required first? No 92% · municipal code
- Is a wind or windstorm certification required? No 60% · adopting ordinance (absence inferred from full code-adoption text)
- Is a Specific Use Permit or Council approval ever required? Yes, conditionally 88% · municipal code
- Is there a system-size cap on residential generation? No hard citywide cap on residential PV size; 10kW AC / 30kW thermal is only the ceiling that defines a 'small residential rooftop solar energy system' eligible for the EXPEDITED 1–3-day review under Ch. 15.67 – larger residential systems are still permitted, just via the standard valuation-based Building Permit path (fee schedule's >15kW-per-kW tier proves larger systems are routinely permitted). 85% · municipal code
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 85% · department page
- Must the contractor be registered with this authority before applying? Yes, generally (not solar-specific) 55% · municipal code
- Is a homeowner permitted to self-install and self-permit? Yes 85% · department page + published form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Two tracks. (1) SolarAPP+-eligible: a SolarAPP+ pre-approval ID plus a Fortuna Fire Protection District plan-approval form, uploaded through the city's OpenGov permit portal – no paper plan set. (2) Standard/non-eligible systems: the city's general 'Residential Plans Submittal Checklist' applies – permit request form, plans stamped/signed by a registered design professional, site plan with survey/topo, structural/framing details, and electrical plans. 78% · department page + published checklist
- How many copies, and in what format? SolarAPP+ path: fully electronic, no paper copies. Standard path: 'four (4) complete sets of plans' per the Residential Plans Submittal Checklist (2 sets to Building stamped/signed, 1 to Planning, 1 to Engineering), standard paper size (approval needed over 24"x36"). 70% · published checklist
- Is a site plan required, and what must it show? Yes – for the standard (non-SolarAPP+) path, a site plan is required showing project name/address/APN, a stamped boundary+topographic survey with property corners marked, existing/finished grades, setback dimensions from property lines (incl. 100-yr floodplain), and a north-arrow vicinity map. 72% · published checklist
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? OpenGov Permitting & Licensing at fortunaca.portal.opengov.com (the city's former 'ViewPoint Cloud' portal, fortunaca.viewpointcloud.com, now 301-redirects to this same OpenGov portal – they are one system, not two). 90% · department page + redirect verified directly
- Can the whole application be completed online? Yes 85% · department page
- What does a residential solar permit cost? $400 flat for residential systems up to 15kW; $15 per kW for capacity above 15kW. Battery backup add-on: $53.85 per pack. 95% · published fee schedule
- How is the fee calculated? Tiered 90% · published fee schedule
- Is there a separate plan-check fee? No 72% · published fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 1 to 3 business days after a complete application 92% · municipal code
- How long is an issued permit valid before it expires? 2 years from date of issuance (work must commence within 180 days, or be suspended >180 days, or it lapses; one or more 180-day extensions available in writing) 85% · adopting ordinance
- Which utility handles interconnection here? PG&E (Pacific Gas & Electric) is the wires/interconnection utility; Redwood Coast Energy Authority (RCEA) is the Community Choice Aggregator supplying generation/billing for roughly 90% of Humboldt County accounts, Fortuna included, but does not perform interconnection. 70% · secondary source (CCA's own site, utility not independently confirmed via PG&E's own territory map)
28 questions answered against City of Fortuna’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherFMC §15.67.030(A): chapter 'applies to the permitting of all small residential rooftop solar energy systems in the city of Fortuna'; city's Building Division issues the permit.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherFY26-27 Building Fee Schedule Section 2.F 'Solar Permit Fees' is a single line item (flat + per-kW) with no separate electrical-permit line for solar, distinct from the general Section 3 'Electrical Permit Fees' for non-solar work – the city bundles building+electrical review into one Solar Permit.
fee schedule checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherFMC §15.67.030(A)/(B) treats residential solar as permitted activity; only routine O&M/like-kind replacement is exempt.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherSingle 'Solar Permit' fee line (Section 2.F of the fee schedule) and a single 'SolarAPP+ Solar Permit' record type in the permit portal; no separate solar-electrical fee line exists alongside it.
fee schedule checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either

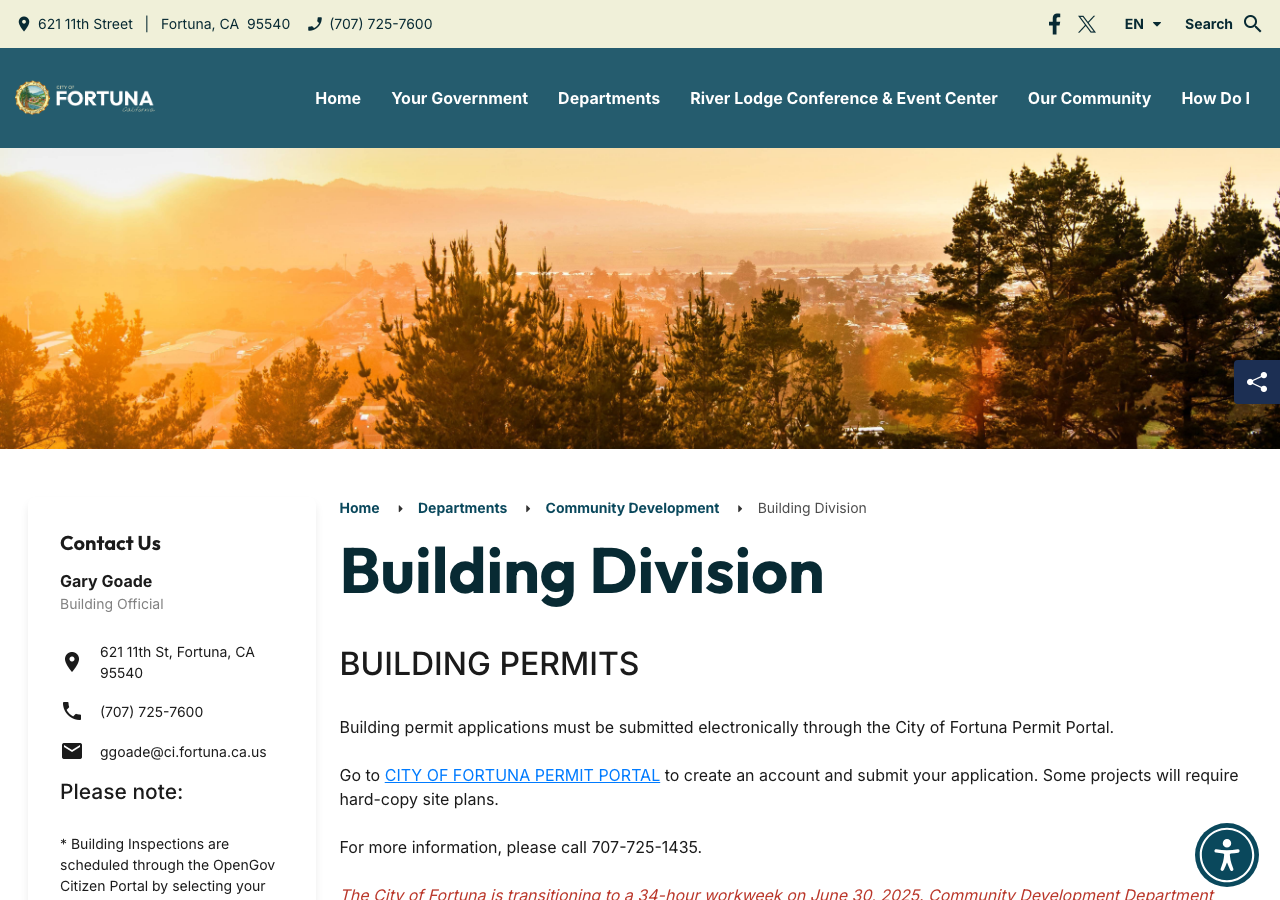

Why the confidence is not higherCity's own Building Division page: 'If you are a licensed contractor or installer you may register for a new SolarAPP+ account. (Non-licensed/owner-builders must apply for a regular Solar Permit through the Permit Portal.)' – both paths exist.
department page checked 2026-08-31 https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes, generally (not solar-specific)
Why the confidence is not higherFMC §5.04.020: 'It is unlawful for any person to transact and carry on any business in the city without first having procured a license from the city.' This is the city's general business-license-tax ordinance; I found no document stating it is checked as a gate at building-permit intake for out-of-town contractors.
municipal code checked 2026-08-31 https://ecode360.com/50099683
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherBuilding Division page explicitly names 'owner-builders' as an alternate applicant path for solar, and the Resources & Forms page publishes a 'COF Owner-Builder Acknowledgement' form.
department page + published form checked 2026-08-31 https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q8 What documents make up a complete submittal? Core Submittal package
Two tracks. (1) SolarAPP+-eligible: a SolarAPP+ pre-approval ID plus a Fortuna Fire Protection District plan-approval form, uploaded through the city's OpenGov permit portal – no paper plan set. (2) Standard/non-eligible systems: the city's general 'Residential Plans Submittal Checklist' applies – permit request form, plans stamped/signed by a registered design professional, site plan with survey/topo, structural/framing details, and electrical plans.
Why the confidence is not higherCombined from the city's own Building Division page (SolarAPP+ steps) and its own general Residential Plans Submittal Checklist PDF (extracted via pdftotext, not summarized); the checklist itself is generic new-construction and does not mention solar by name, so its applicability to a simple rooftop retrofit is an inference, not a stated rule.
department page + published checklist checked 2026-08-31 https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q9 How many copies, and in what format? Submittal package
SolarAPP+ path: fully electronic, no paper copies. Standard path: 'four (4) complete sets of plans' per the Residential Plans Submittal Checklist (2 sets to Building stamped/signed, 1 to Planning, 1 to Engineering), standard paper size (approval needed over 24"x36").
Why the confidence is not higherChecklist item 1(b)-(c), extracted directly via pdftotext; this is the city's general residential submittal rule, not solar-specific.
published checklist checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Community%20Development/Resources%20Applications%20%26%20Handouts/Residential/Forms/RESIDENTIAL%20PLANS%20SUBMITTAL%20CHECK%20LIST.pdf
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes – for the standard (non-SolarAPP+) path, a site plan is required showing project name/address/APN, a stamped boundary+topographic survey with property corners marked, existing/finished grades, setback dimensions from property lines (incl. 100-yr floodplain), and a north-arrow vicinity map.
Why the confidence is not higherResidential Plans Submittal Checklist item 3, extracted directly; this is the general residential rule, applicability to a simple rooftop PV retrofit under SolarAPP+ is not confirmed – SolarAPP+'s own online workflow (not a city document) governs site-plan content for that path.
published checklist checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Community%20Development/Resources%20Applications%20%26%20Handouts/Residential/Forms/RESIDENTIAL%20PLANS%20SUBMITTAL%20CHECK%20LIST.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Nothing published by this authority.
Where we lookedCity's Building Division page, general Residential Plans Submittal Checklist (item 12 'Electrical Plans' covers only panel/outlet layout, no PV-specific one-line/three-line diagram language), and full-text search of eCode360 for the whole code – no city-authored document explicitly requires a PV one-line diagram. The national NREL SolarAPP+ eligibility PDF linked from the city's page does require one, but that is NREL's document, not Fortuna's own, so I am not attributing it to the city.
https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedSame documents as q11 – no city-specific requirement for string/conductor calculations found outside the generic national SolarAPP+ template.
https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedFMC §15.10.015(B) (added via Ord. 2026-787) requires occupancy groups A,B,E,F,H,I,M,R,S,U to be 'designed by an architect or civil/structural engineer, licensed/registered in the State of California' with a GC self-certification waiver exception – this is a broad, non-solar-specific rule and it is unclear whether/how it is applied to a standard rooftop PV retrofit under the state Solar Permitting Guidebook standard plans (which FMC §15.67.060(C) says control over conflicting CBSC provisions). No solar-specific structural-stamp threshold was stated anywhere.
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedOrd. 2026-787 full text, FMC Ch. 15.67, and the general Residential Plans Submittal Checklist – none states a valuation/size threshold triggering a separate electrical PE stamp.
Q15 What does a residential solar permit cost? Core Fees
$400 flat for residential systems up to 15kW; $15 per kW for capacity above 15kW. Battery backup add-on: $53.85 per pack.
Why the confidence is not higherFY26-27 Building Fee Schedule (effective 7-1-26, Resolution 2026-18), Section 2.F 'Solar Permit Fees', read directly from the PDF via pdftotext -layout.
published fee schedule checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q16 How is the fee calculated? Core Fees
Tiered
Why the confidence is not higherFlat $400 up to 15kW, then $15/kW above that threshold – a flat-then-per-kW tiered structure, not pure flat or pure per-kW.
published fee schedule checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q17 Is there a separate plan-check fee? Fees
No
Why the confidence is not higherSolar sits under fee-schedule Section 2 'OVER THE COUNTER PERMITS', which carries no plan-review add-on line, unlike Section 1 'BUILDING PERMITS' (valuation-based), which explicitly adds a 'Plan Review Fee – collected at time of application, based on Building Permit Fee: 65%'. The OTC placement implies the flat solar fee is all-inclusive; not stated in so many words.
published fee schedule checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
1 to 3 business days after a complete application
Why the confidence is not higherFMC §15.67.060(A): 'The building division shall issue a building permit or other nondiscretionary permit within one to three business days of receipt of a complete application that meets the requirements of the approved checklist and standard plan.'
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q19 How long is an issued permit valid before it expires? Timeline & validity
2 years from date of issuance (work must commence within 180 days, or be suspended >180 days, or it lapses; one or more 180-day extensions available in writing)
Why the confidence is not higherFMC §15.10.015(A), amending CBC/CRC §105.5/R105.5 – this is the general building-permit expiration rule; no solar-specific override was found. Confirmed current via the newly-adopted Ord. 2026-787 (3 Aug 2026), which re-enacts identical wording under the 2025 code cycle.
adopting ordinance checked 2026-08-31 https://ecode360.com/FO4448/laws/LF2783668.pdf
Q20 Which permit portal does this authority use? Core Portal & process
OpenGov Permitting & Licensing at fortunaca.portal.opengov.com (the city's former 'ViewPoint Cloud' portal, fortunaca.viewpointcloud.com, now 301-redirects to this same OpenGov portal – they are one system, not two).
Why the confidence is not higherConfirmed both by the city's Building Division page linking both URLs for different steps, and directly by curl -I showing fortunaca.viewpointcloud.com 301-redirecting to fortunaca.portal.opengov.com.
department page + redirect verified directly checked 2026-08-31 https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higherBuilding Division page: 'Building permit applications must be submitted electronically through the City of Fortuna Permit Portal' generally, and for SolarAPP+-eligible systems the entire review is automated online once the pre-approval ID and Fire District approval form are uploaded.
department page checked 2026-08-31 https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q22 Which utility handles interconnection here? Core Utility interconnection
PG&E (Pacific Gas & Electric) is the wires/interconnection utility; Redwood Coast Energy Authority (RCEA) is the Community Choice Aggregator supplying generation/billing for roughly 90% of Humboldt County accounts, Fortuna included, but does not perform interconnection.
Why the confidence is not higherRCEA's own site states it 'administer[s] Humboldt County's Community Choice Energy program' and that '90% of Humboldt County residents receive electricity from RCEA' as generation provider; it does not name Fortuna specifically nor state PG&E is the wires utility outright – this is inference from the standard CCA/IOU split used throughout PG&E's northern-California territory, not a Fortuna-specific PG&E territory-map citation. Per the brief's own caution against trusting utility lookups uncritically, flagging this as utility-level and not independently confirmed against PG&E's own territory map this run.
secondary source (CCA's own site, utility not independently confirmed via PG&E's own territory map) checked 2026-08-31 https://redwoodenergy.org/
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedCity's Building Division page and FMC Ch. 15.67 – neither states where PG&E/utility interconnection sits in the permit sequence; did not fetch PG&E's own Rule 21/DG interconnection handbook this run.
https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherFMC §15.67.060(G): 'The city of Fortuna shall not condition approval of an application on the approval of an association, as defined in Section 4080 of the Civil Code.'
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q25 Is there a historic-district review? Overlays & special cases
Nothing published by this authority.
Where we lookedFMC Ch. 2.24 (Historical Commission, purely advisory, Title 2) and Title 17 Zoning §17.04.030 (Design Review combining zone 'D') – full-text searched the whole code for 'historic' (17 hits); the only substantive 'historic structure' definition sits inside the floodplain-management chapter (§15.52.270), unrelated to solar. No provision ties historic-district/design review to solar permitting specifically.
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherNo standalone windstorm-certification program was found; wind is handled as a design parameter under the adopted 2025 CBC/CRC (basic wind speed by climate/exposure), not a separate certificate – California does not run a TDI-style windstorm certification program the way some Gulf-state jurisdictions do.
adopting ordinance (absence inferred from full code-adoption text) checked 2026-08-31 https://ecode360.com/FO4448/laws/LF2783668.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Yes, conditionally
Why the confidence is not higherFMC §15.67.060(A): 'A building official may require an applicant to apply for a use permit if the official finds, based on substantial evidence, that the solar energy system could have a specific, adverse impact upon the public health and safety, ... Such decisions may be appealed to the city of Fortuna planning commission.' Subsection (D) sets the findings standard for denying that use permit.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No hard citywide cap on residential PV size; 10kW AC / 30kW thermal is only the ceiling that defines a 'small residential rooftop solar energy system' eligible for the EXPEDITED 1–3-day review under Ch. 15.67 – larger residential systems are still permitted, just via the standard valuation-based Building Permit path (fee schedule's >15kW-per-kW tier proves larger systems are routinely permitted).
Why the confidence is not higherFMC §15.67.020(B)(1) defines the expedited-chapter size threshold; the Building Fee Schedule's 'Over 15 Kw, per Kw: $15.00' tier for the Solar Permit shows larger systems are a normal, priced case rather than prohibited.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 95% · adopting ordinance
- Which building code edition is in force? 2025 California Building Code / California Residential Code (based on the 2024 IBC/IRC) 95% · adopting ordinance
- Which fire code edition is in force? 2025 California Fire Code (based on the 2024 IFC), adopted by the City as part of Title 15; the Fortuna Fire Protection District (a separate special district) performs day-to-day plan review/inspection. 90% · adopting ordinance
- Are there local amendments to any of the above? Yes 95% · adopting ordinance
- What is the installation judged against? The 2025 CEC (2023 NEC) as adopted, plus IEEE and accredited-testing-lab standards (e.g. UL) and, where applicable, CPUC safety/reliability rules 90% · municipal code
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
Nothing recorded for City of Fortuna on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
Nothing recorded for City of Fortuna on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
Nothing recorded for City of Fortuna on this step yet — 6 questions checked and found unpublished. The guidance above is general.
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes 88% · municipal code
- Are batteries permitted, and under what conditions? Permitted, but with no local ordinance conditions found – governed by the state-adopted 2025 CFC/CRC alone. The city's own fee schedule prices a 'Battery Backup, per Pack' add-on ($53.85), proving the city treats batteries as a distinct, priced item, but I found no local text on clearances, listing, or placement. 60% · fee schedule (absence proven against full code text by search, control-checked)
- Is there a separate ESS permit or inspection? A separate fee line exists ('Battery Backup, per Pack' – $53.85, 30 min. est. time), distinct from the base Solar Permit fee, implying at minimum a separate inspection/fee event, though not marketed anywhere as a wholly separate permit type. 60% · fee schedule
20 questions answered against City of Fortuna’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023
Why the confidence is not higherOrd. 2026-787 (adopted 3 Aug 2026), amending FMC §15.10.010(D): 'CALIFORNIA ELECTRICAL CODE. 2025 California Electrical Code (Part 3 of Title 24), based on the 2023 National Electrical Code (NEC).' Note: eCode360's codified text of §15.10.010 still displays the SUPERSEDED 2022/2020-NEC cycle as of this check – the 3 Aug 2026 ordinance is current law but had not yet been folded into the codified section text; I sourced the operative figure from the ordinance PDF itself, not the stale codified page.
adopting ordinance checked 2026-08-31 https://ecode360.com/FO4448/laws/LF2783668.pdf
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code / California Residential Code (based on the 2024 IBC/IRC)
Why the confidence is not higherOrd. 2026-787 §§A-C, adopted 3 Aug 2026, superseding the still-codified 2022-cycle text at FMC §15.10.010 on eCode360 (which had not yet been updated by the codifier as of this check).
adopting ordinance checked 2026-08-31 https://ecode360.com/FO4448/laws/LF2783668.pdf
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (based on the 2024 IFC), adopted by the City as part of Title 15; the Fortuna Fire Protection District (a separate special district) performs day-to-day plan review/inspection.
Why the confidence is not higherOrd. 2026-787 §I, adopted 3 Aug 2026 (FMC §15.10.010(I)); functional split with FFPD confirmed via the Building Division's SolarAPP+ page and FMC §15.67.060(I).
adopting ordinance checked 2026-08-31 https://ecode360.com/FO4448/laws/LF2783668.pdf
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherFMC §15.10.015(A)-(G): local amendments to permit expiration, an added architect/engineer design requirement for most occupancy groups, topo/boundary survey requirements, work-without-a-permit fines, and a stop-work-order fee – all read directly from the current Ord. 2026-787 text.
adopting ordinance checked 2026-08-31 https://ecode360.com/FO4448/laws/LF2783668.pdf
Q33 What is the installation judged against? Core Electrical
The 2025 CEC (2023 NEC) as adopted, plus IEEE and accredited-testing-lab standards (e.g. UL) and, where applicable, CPUC safety/reliability rules
Why the confidence is not higherFMC §15.67.040(C): systems 'for producing electricity shall meet all applicable safety and performance standards established by the California Electrical Code, the Institute of Electrical and Electronics Engineers, and accredited testing laboratories such as Underwriters Laboratories and, where applicable, rules of the Public Utilities Commission.'
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedOrd. 2026-787's full §15.10.015 amendment text (permit expiration, engineering, surveys, unpermitted work, fees, penalties, stop-work) – no service-upgrade-sizing or busbar rule appears; only a generic 'Service (up to 200 amps)/$161.48' and 'Service (200 up amps)/$215.29' fee line exists with no accompanying technical rule.
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedFull-text searched eCode360 for 'ground mounted' and reviewed the general Residential Plans Submittal Checklist – no city-specified mounting system, attachment spacing, or racking standard was found; this is left to the manufacturer's engineering under the state Solar Permitting Guidebook standard plans referenced in FMC §15.67.050(D)-(E).
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Nothing published by this authority.
Where we lookedFull-text searched eCode360 for 'setback', 'ridge', 'pathway' in relation to fire access – no Fortuna-specific ridge-setback or access-pathway dimension was found; this is governed entirely by the state-adopted 2025 CFC/CRC fire-access-pathway sections by reference (no local amendment), and Fortuna Fire Protection District's own site (fortunafire.com) publishes no PV-specific standard either.
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Nothing published by this authority.
Where we lookedFull-text searched eCode360 for 'rapid shutdown' (2 hits, both off-topic – 'sudden and severe energy shortage' and flood-water 'rapid... accumulation') and FMC Ch. 15.67 – no city document states rapid shutdown in its own words. It applies by reference because the 2025 CEC (based on the 2023 NEC, Art. 690.12) is adopted wholesale via Ord. 2026-787, but the city never says so itself.
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedFull-text searched eCode360 for 'placard' (3 hits: park-sign prohibition, disabled-parking placards, park-notice prohibition – all off-topic) and 'disconnect' (17 hits, all water/sewer service disconnection – off-topic). Controls run same session: 'electrical' = 47 hits, 'zzqqx' = 0 hits, confirming the search engine works. No city-specific placard requirement exists beyond whatever the adopted 2025 CFC/2023 NEC itself requires by reference.
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSame search as q38 – no city-authored placard wording found anywhere in the code, ordinances, checklist, or fee schedule.
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSame search as q38 – no letter-height/colour/material specification found in any Fortuna-authored document.
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSame search as q38, plus the general Residential/Site Plan Checklists – no dedicated facility-map/705.10-style placard requirement named anywhere in city documents.
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedDid not fetch PG&E's own DG interconnection/Greenbook manual this run – utility-level document, out of scope of what the city itself publishes.
Q43 Where must the labels be placed? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSame search as q38 – no city-specified label-placement location found beyond generic 'location of all electrical equipment' language in the general Residential Plans Submittal Checklist.
Q44 Must equipment be on a specific approved list? Equipment listing
Yes
Why the confidence is not higherFMC §15.67.040(C) requires solar-electric equipment to meet standards set by 'accredited testing laboratories such as Underwriters Laboratories' – a listing requirement, though not phrased as a single 'approved equipment list.'
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Permitted, but with no local ordinance conditions found – governed by the state-adopted 2025 CFC/CRC alone. The city's own fee schedule prices a 'Battery Backup, per Pack' add-on ($53.85), proving the city treats batteries as a distinct, priced item, but I found no local text on clearances, listing, or placement.
Why the confidence is not higherFull-text search of the entire eCode360 library for the exact phrase 'energy storage' returned 0 hits, and for 'battery' returned only 3 off-topic hits (organics recycling, public-nuisance abatement) – controls run in the same session: 'electrical' (positive) = 47 hits, 'zzqqx' (fabricated) = 0 hits, confirming the search engine works. The fee-schedule battery line is the only Fortuna-specific ESS evidence found.
fee schedule (absence proven against full code text by search, control-checked) checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
A separate fee line exists ('Battery Backup, per Pack' – $53.85, 30 min. est. time), distinct from the base Solar Permit fee, implying at minimum a separate inspection/fee event, though not marketed anywhere as a wholly separate permit type.
Why the confidence is not higherBuilding Fee Schedule Section 2.F, read directly; no ordinance text describing a distinct 'ESS permit' process was found (see q45 control search).
fee schedule checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedZoning Title 17 definitions (§17.08.020 'Accessory building', §17.08.500 'Structure', §17.06.001 'Accessory buildings') – none names ground-mounted solar arrays specifically as a 'structure' or 'accessory building'; full-text search for 'ground mounted' across the whole code returned no on-topic PV-specific hit.
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedCity's Building Division page, FMC Ch. 15.67, and the general checklist – none states an AC-disconnect-to-meter placement rule; this is a PG&E service-equipment/Rule 21 requirement I did not fetch this run.
https://www.friendlyfortuna.com/departments/community_development/building_division.php
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal 90% · department page
- How much notice is required? For the expedited small-residential solar path: 2 business days. FMC §15.67.060(J): 'An inspection will be scheduled within two business days of a request.' (General building-permit practice per the department page separately says next-day notification 'is preferred' and calls before 8 a.m. get same-day service, but that is the general, non-solar-specific practice.) 82% · municipal code
- Are same-day or AM/PM windows offered? A 2-hour inspection window (solar-specific, FMC §15.67.060(J)); no final inspections are done after 1 p.m. citywide per the general Building Division page. 80% · municipal code + department page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 95% · municipal code
- If delegated, to whom? Not delegated for the building final (self-performed by the city Building Division). A separate, additional fire inspection MAY be performed by the Fortuna Fire Protection District, a distinct special district (not the city). 80% · municipal code
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? For eligible small residential rooftop solar: a single final inspection performed by the Building Division, with an optional separate fire inspection by FFPD. No multi-stage sequence (rough-in, mid-roof, etc.) is used for the eligible expedited path. 85% · municipal code
- Is a rough-in or mid-roof inspection required? No 88% · municipal code
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
Nothing recorded for City of Fortuna on this step yet — 3 questions checked and found unpublished. The guidance above is general.
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- Is there a re-inspection fee? $107.67 per hour (minimum charge 1 hour) 82% · published fee schedule
- How are corrections issued and cleared? Application-stage: FMC §15.67.060(H) requires 'a written correction notice detailing all deficiencies in the application' be sent for resubmission if incomplete. Post-inspection: §15.67.060(K) – 'If a small residential rooftop solar energy system fails inspection, a subsequent inspection is authorized but need not conform to the requirements of this chapter' (i.e. the 2-day/2-hour expedited guarantees no longer apply to the re-inspection). 80% · municipal code
14 questions answered against City of Fortuna’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal
Why the confidence is not higherBuilding Division page: 'Building Inspections are scheduled through the OpenGov Citizen Portal by selecting your Building Permit record number.'
department page checked 2026-08-31 https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q50 How much notice is required? Core Booking & scheduling
For the expedited small-residential solar path: 2 business days. FMC §15.67.060(J): 'An inspection will be scheduled within two business days of a request.' (General building-permit practice per the department page separately says next-day notification 'is preferred' and calls before 8 a.m. get same-day service, but that is the general, non-solar-specific practice.)
Why the confidence is not higherOrdinance text is solar-specific and controlling for the eligible expedited path; the department page's day-before preference is the general fallback for standard permits.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
A 2-hour inspection window (solar-specific, FMC §15.67.060(J)); no final inspections are done after 1 p.m. citywide per the general Building Division page.
Why the confidence is not higherFMC §15.67.060(J): '...provide a two-hour inspection window.' Combined with the general department-page note on the 1 p.m. cutoff for finals.
municipal code + department page checked 2026-08-31 https://ecode360.com/50106485
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherFMC §15.67.060(I): 'Only one inspection shall be required and performed by the building division for small residential rooftop solar energy systems eligible for expedited review.'
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q53 If delegated, to whom? Core Who inspects
Not delegated for the building final (self-performed by the city Building Division). A separate, additional fire inspection MAY be performed by the Fortuna Fire Protection District, a distinct special district (not the city).
Why the confidence is not higherFMC §15.67.060(I): '...performed by the building division... A separate fire inspection may be performed by the Fortuna fire protection district.'
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q54 Which inspections are required, and in what order? Core Stages & sequence
For eligible small residential rooftop solar: a single final inspection performed by the Building Division, with an optional separate fire inspection by FFPD. No multi-stage sequence (rough-in, mid-roof, etc.) is used for the eligible expedited path.
Why the confidence is not higherFMC §15.67.060(I)-(J); I found no published general residential inspection-stage sequence (footing/frame/final, etc.) on the city's own site to compare against for non-solar work.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherFMC §15.67.060(I): 'Only one inspection shall be required' for the eligible expedited path – no separate rough-in/mid-roof stage.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q56 Does the inspector verify labels and listings? Core What is checked
Nothing published by this authority.
Where we lookedFMC Ch. 15.67 and the Building Division page describe the review/single-inspection process but never explicitly state that the inspector checks equipment labels/listings as a discrete step, even though it is implied by the UL/IEEE listing requirement in §15.67.040(C).
Q57 Is there a published inspection checklist? Core What is checked
Nothing published by this authority.
Where we lookedResources & Forms page (WebFetch-confirmed link list) publishes a plan-SUBMITTAL checklist (Residential Plans Submittal Check List) but no distinct solar INSPECTION checklist; the SolarAPP+ national eligibility PDF linked from the city's page is a submittal/eligibility document, not an inspection checklist, and is NREL's, not Fortuna's own.
https://www.friendlyfortuna.com/departments/community_development/resources_forms.php
Q58 What must be on site at inspection? Core Documents on site
Nothing published by this authority.
Where we lookedBuilding Division page's 'Inspections' note (portal booking, notice preference, 1 p.m. final cutoff) and FMC Ch. 15.67 – neither lists specific documents/equipment required to be on-site at the time of inspection.
https://www.friendlyfortuna.com/departments/community_development/building_division.php
Q59 Is there a re-inspection fee? Corrections & re-inspection
$107.67 per hour (minimum charge 1 hour)
Why the confidence is not higherBuilding Fee Schedule Section 1.C 'Other Inspection and Fees': 'Code Compliance / re-inspection fee, per hour* (Min. Charge - 1 Hr.) $107.67'. This is the general re-inspection fee; no solar-specific re-inspection line exists separately.
published fee schedule checked 2026-08-31 https://www.friendlyfortuna.com/Documents/Departments/Finance/Annual%20Fee%20Schedule/FY26-27%20Adopted%20Fee%20Schedule%207-1-26_FINAL.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Application-stage: FMC §15.67.060(H) requires 'a written correction notice detailing all deficiencies in the application' be sent for resubmission if incomplete. Post-inspection: §15.67.060(K) – 'If a small residential rooftop solar energy system fails inspection, a subsequent inspection is authorized but need not conform to the requirements of this chapter' (i.e. the 2-day/2-hour expedited guarantees no longer apply to the re-inspection).
Why the confidence is not higherBoth subsections read directly from the current municipal code text.
municipal code checked 2026-08-31 https://ecode360.com/50106485
Q61 What is issued on pass? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedFMC §15.67.060(I)-(K) describes pass/fail of the single solar inspection but never names the specific document issued on pass (Final vs. CO vs. Green Tag vs. Letter); fee schedule has only a generic new-unit 'Certificate of Occupancy' concept, not clearly applicable to an existing-home solar retrofit.
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedCity's Building Division and SolarAPP+ pages never state who submits interconnection-completion/PTO paperwork to PG&E (installer vs. AHJ vs. homeowner); this is typically a utility-side process I did not verify this run.
https://www.friendlyfortuna.com/departments/community_development/building_division.php
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Fortuna against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Fortuna is the authority having jurisdiction 92% confidence
- Holds
- Building and Electrical, combined into one 'Solar Permit' issued by the city's Community Development Department / Building Division (Building Official: Gary Goade, ggoade@ci.fortuna.ca.us). Fire is split off to a separate legal agency: the Fortuna Fire Protection District (FFPD, a special district, not a city department – fortunafire.com states it serves 'the City of Fortuna and the outlying communities of Alton, Hydesville, Metropolitan, Fernbridge and Palmer Creek'). The city's own SolarAPP+ process page makes FFPD plan-review approval a mandatory pre-step ('Submit your solar plans to the Fortuna Fire Protection District for approval') before the city portal will issue the permit, and FMC §15.67.060(I) states a separate fire inspection 'may be performed by the Fortuna fire protection district' in addition to the single building-division final. The city's own Municipal Code (FMC §15.10.010(I)) nonetheless adopts the California Fire Code itself as part of Title 15, so code ADOPTION is the city's while plan review/inspection in practice is FFPD's – the county is not involved for this parcel (city is incorporated and self-performs building/electrical).
- Overridden by
- CA Gov. Code §65850.5 (Solar Rights Act/AB 2188, 2014) mandates the expedited nondiscretionary 1–3 business day review for 'small residential rooftop solar energy systems' (≤10kW AC/30kW thermal), codified verbatim in FMC Ch. 15.67 (Ord. 2024-768); Gov. Code §65850.52 (SB 379) automated-permitting mandate is implemented via SolarAPP+ (gosolarapp.org) integrated with the city's OpenGov permit portal; AB 130 (Stats. 2025, Ch. 22) freezes the city from adopting any MORE restrictive residential building-code amendment 1 Oct 2025–1 Jun 2031.
- Why not higher
- FMC §15.67.030(A) ('This chapter applies to the permitting of all small residential rooftop solar energy systems in the city of Fortuna') and the city's own Building Division page both confirm the city issues the permit directly; FFPD's separate legal identity and its mandatory role in the SolarAPP+ workflow are stated on the city's own page and FFPD's own site. eCode360 (the code host) sits behind a Cloudflare bot-challenge that blocks a plain fetch/WebFetch and even a Referer-header curl – it was only readable via a scripted TLS-impersonation client (cloudscraper); flagging this because a plain-fetch run on this authority would wrongly conclude the code is unreachable.
https://www.friendlyfortuna.com/departments/community_development/building_division.php
- Permit required
- Yes95%
- Permit cost
- $400 flat for residential systems up to 15kW; $15 per kW for capacity above 15kW. Battery backup add-on: $53.85 per pack.95%
- Plan review
- 1 to 3 business days after a complete application92%
- Portal
- OpenGov Permitting & Licensing at fortunaca.portal.opengov.com (the city's former 'ViewPoint Cloud' portal, fortunaca.viewpointcloud.com,90%
- Electrical code
- 202395%
- Booking an inspection
- Portal90%
Labels & placards for this authority
Wording None%
Size, colour & material None%
Where they go None%
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
