City of Gonzales

Monterey County

Verified Aug. 4, 2026

City of Gonzales is a city authority in the State of California, serving 8,647 residents. 512 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Up to 30 business days for standard residential review (per the city's own general statement); Q18 Where you file — SmartGov Community Development (ci-gonzales-ca.smartgovcommunity.com) Q20

Permit required
Yes90% source
What it costs
$125 minimum, based on verified construction valuation, plus a 7% Systems Automation Fee (SAF) surcharge,70% source
Plan review turnaround
Up to 30 business days for standard residential review (per the city's own general statement); GMC §11.04.130 separately requires an 'expedited' process for small residential rooftop solar under Gov.55% source
Key document
municipal code (control-checked absence) cited by 6 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 95% · municipal code
    • What does this authority permit itself, and what does it delegate? Both 82% · department page
    • Is a permit required for a residential rooftop PV system? Yes 90% · permit application
    • Is there a separate electrical permit, or is it combined? Combined 80% · permit application
    • Is a HOA or architectural approval required first? No 65% · municipal code (TOC)
    • Is there a historic-district review? Yes, but only within the Historic District Overlay — not citywide 60% · municipal code (TOC)
    • Is a wind or windstorm certification required? No 65% · municipal code (control-checked absence)
    • Is a Specific Use Permit or Council approval ever required? Not required for a standard rooftop residential PV system meeting the small-residential-solar definition in GMC §11.04.130 (no Council/CUP/SUP step is described in that chapter). A related zoning trigger exists only for oversized accessory structures: GMC §12.112.030(B)(4) requires Planning Director (not Council/SUP) approval for any accessory structure exceeding 450 sq. ft., which could apply to a large ground-mount array footprint. 60% · municipal code
    • Is there a system-size cap on residential generation? 10 kW AC nameplate rating or 30 kW thermal, and only for systems on a single- or duplex-family dwelling that do not exceed the maximum legal building height. 95% · municipal code
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Who is allowed to pull the electrical permit? Either 80% · permit application
    • Must the contractor be registered with this authority before applying? Yes 90% · department page
    • Is a homeowner permitted to self-install and self-permit? Yes 80% · permit application
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? No solar-specific checklist exists; the only published submittal checklist is a generic, statewide 'CALBO Day 2 Checklist' template for single-family/duplex plans (new home, addition, or remodel), calling generically for a cover sheet, site/civil plan, architectural plans, structural plans, detail sheets, electrical plans, energy (Title 24) documents, and (if applicable) structural calculations. It never mentions solar, PV, or GMC §11.04.130's own required checklist. 60% · published checklist
    • Is a site plan required, and what must it show? Yes — a site/civil plan is required, drawn to scale, showing: north arrow, aerial view, building footprint and roofline with all projections and dimensions to property lines, dimensions between buildings, full parcel/lot dimensions and property lines, street names, setbacks, recorded easements and visible utilities (electric/gas/water meters), and existing/proposed grading. 65% · published checklist
    • Is a one-line / three-line diagram required? Yes (inferred) 50% · inference from adopted code
    • Are string and conductor calculations required? Yes (inferred) 50% · inference from adopted code
    • Is a structural PE stamp required, and at what threshold? No solar-specific threshold found; the only stated trigger is generic: the submittal checklist says plans 'drawn to scale' are acceptable from anyone, but 'If any portion of a structure deviates from conventional framing, the Building Department may require that the plans, drawings, specifications and/or calculations for that portion of work be prepared by or under the direct supervision of a registered engineer or architect,' who must then stamp/sign the relevant sheets. 55% · published checklist
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

    • Which permit portal does this authority use? SmartGov Community Development (ci-gonzales-ca.smartgovcommunity.com) 95% · portal landing page
    • Can the whole application be completed online? Yes 60% · portal landing page
    • What does a residential solar permit cost? $125 minimum, based on verified construction valuation, plus a 7% Systems Automation Fee (SAF) surcharge, under the general 'Building Permit' fee line — there is no PV-specific dollar figure or kW-based fee line. 70% · fee schedule
    • How is the fee calculated? Valuation 80% · fee schedule
    • Is there a separate plan-check fee? Yes 85% · fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? Up to 30 business days for standard residential review (per the city's own general statement); GMC §11.04.130 separately requires an 'expedited' process for small residential rooftop solar under Gov. Code §65850.5 but does not itself state a specific day count. 55% · department page
    • Which utility handles interconnection here? Pacific Gas & Electric (PG&E) 65% · fee schedule (inference)

28 questions answered against City of Gonzales’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherGMC §11.04.130 (Ord. 2025-154, eff. 1/12/2026) codifies the city's expedited small-residential-rooftop-solar permitting process under Gov. Code §65850.5, and the city's own Building Permit Application lists 'Solar PV' as a permit type issued by the city's Building Services Department.

municipal code checked 2026-08-31 https://ecode360.com/49207600

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherGMC §11.04.020 (Building Code) and §11.04.040 (Electrical Code) are both adopted and enforced by the City's own Building Division; the Fire Code (§11.04.080) is enforced by the in-house Fire Chief. Not full self-performance, however: the city's own Building Department Staff page names 4LEAF, Inc. as an external building-plan-review provider, and the FY24-25 fee schedule bills the 'Building Official' at 'Actual Costs plus 10%' (a consultant rate, unlike other city staff's flat hourly rates) — the Building Official position is listed as 'interim.' So building/electrical/fire are the city's own titles, but plan review is partially delegated.

department page checked 2026-08-31 https://gonzalesca.gov/services/building-services/building-department-staff

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherThe city's own current Building Permit Application form (BldgApp.2022) lists 'Solar PV' as a checked permit-type box with a dedicated 'Solar PV Kilowatts' field, confirming a permit is required and processed through the standard Building Division application.

permit application checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2023-02/2023%20EDITABLE%20BUILDING%20PERMIT%20APPLICATION.pdf

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherThe city's own Building Permit Application treats 'Solar PV' as one checkbox permit-type on a single unified 'Building Permit Application' (alongside, but distinct from, a separate 'Electrical' checkbox used for non-solar electrical work) — i.e. one application/permit process covers a residential PV job rather than a standalone electrical permit application. Fee-schedule line items for Building Permit and Plan Check are still calculated together under this one process.

permit application checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2023-02/2023%20EDITABLE%20BUILDING%20PERMIT%20APPLICATION.pdf

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe city's own Building Permit Application form provides parallel 'PROPERTY OWNER' and 'CONTRACTOR' application paths (property owner may self-perform, subcontract to licensed contractors, or use an agent; a contractor's agent may also apply) with no restriction naming only a licensed electrician.

permit application checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2023-02/2023%20EDITABLE%20BUILDING%20PERMIT%20APPLICATION.pdf

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Yes

Why the confidence is not higherThe city's own Building Services page states plainly: 'All contractors must hold a current City Business License before starting work,' and the Building Permit Application footnote reiterates '*All contractors/subcontractors will need a city Business License prior to starting the work.'

department page checked 2026-08-31 https://gonzalesca.gov/services/building-services

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherThe city's own Building Permit Application includes a 'PROPERTY OWNER... Check here if -- Property owner will complete the work' option (requiring a completed Owner-Builder Disclosure form), and the Building Services page separately publishes an 'Owner Builder Form (English & Spanish)' and a CSLB Owner-Builder pamphlet.

permit application checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2023-02/2023%20EDITABLE%20BUILDING%20PERMIT%20APPLICATION.pdf

Q8 What documents make up a complete submittal? Core Submittal package

No solar-specific checklist exists; the only published submittal checklist is a generic, statewide 'CALBO Day 2 Checklist' template for single-family/duplex plans (new home, addition, or remodel), calling generically for a cover sheet, site/civil plan, architectural plans, structural plans, detail sheets, electrical plans, energy (Title 24) documents, and (if applicable) structural calculations. It never mentions solar, PV, or GMC §11.04.130's own required checklist.

Why the confidence is not higherExtracted the full 4-page 'Detailed Submittal Checklist' PDF myself with pdftotext -layout; its title metadata reads 'CALBO Day 2 Checklist FINAL' (a California Building Officials statewide template) and it contains zero occurrences of 'solar' or 'photovoltaic' (control term 'panel' appears only re: electrical panel schedules). This is notable because GMC §11.04.130(C)(1)-(2) itself REQUIRES the building department to 'develop a checklist of all requirements' for expedited solar review and publish it online — no such solar-specific document appears to exist on the Building Services documents page.

published checklist checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2023-09/Detailed%20Submittal%20Checklist_0.pdf

Q9 How many copies, and in what format? Submittal package

Nothing published by this authority.

Where we lookedDetailed Submittal Checklist PDF (pdftotext -layout extraction): the 'PLAN SET REQUIREMENTS' box literally reads 'Submit # sets of plans' with the number left blank/unfilled in the published template; the Building Permit Application PDF and the SmartGov portal landing page (WebFetch) state no copy count or file-format requirement either.

https://gonzalesca.gov/sites/default/files/2023-09/Detailed%20Submittal%20Checklist_0.pdf

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes — a site/civil plan is required, drawn to scale, showing: north arrow, aerial view, building footprint and roofline with all projections and dimensions to property lines, dimensions between buildings, full parcel/lot dimensions and property lines, street names, setbacks, recorded easements and visible utilities (electric/gas/water meters), and existing/proposed grading.

Why the confidence is not higherFrom the same generic 'Detailed Submittal Checklist' PDF (CIVIL PLANS section) — this is the city's only published site-plan requirement list and is not solar-specific, so it is being applied by inference to a PV site plan rather than confirmed as the solar site-plan standard.

published checklist checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2023-09/Detailed%20Submittal%20Checklist_0.pdf

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes (inferred)

Why the confidence is not higherNot stated in any Gonzales-specific document I could find — the generic submittal checklist's 'ELECTRICAL PLANS' section calls for 'Power,' 'Panel schedule,' and equipment locations but never uses the phrase 'one-line diagram.' A one-line/three-line diagram is a standard requirement under NEC Article 690 as incorporated by the city's own adoption of the 2025 California Electrical Code (GMC §11.04.040), so I am inferring 'Yes' from that adoption rather than from an explicit local statement.

inference from adopted code checked 2026-08-31 https://ecode360.com/49207600

Q12 Are string and conductor calculations required? Drawings & calculations

Yes (inferred)

Why the confidence is not higherSame basis as Q11 — string/conductor calculations are a standard NEC Article 690 requirement under the adopted 2025 California Electrical Code (GMC §11.04.040); no Gonzales-specific document explicitly requires them for solar submittals.

inference from adopted code checked 2026-08-31 https://ecode360.com/49207600

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

No solar-specific threshold found; the only stated trigger is generic: the submittal checklist says plans 'drawn to scale' are acceptable from anyone, but 'If any portion of a structure deviates from conventional framing, the Building Department may require that the plans, drawings, specifications and/or calculations for that portion of work be prepared by or under the direct supervision of a registered engineer or architect,' who must then stamp/sign the relevant sheets.

Why the confidence is not higherFrom the generic Detailed Submittal Checklist PDF's 'GENERAL INSTRUCTIONS' section — a citywide, non-solar-specific structural-stamp trigger with no numeric valuation or size threshold given.

published checklist checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2023-09/Detailed%20Submittal%20Checklist_0.pdf

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedGMC §11.04.040 (Electrical Code adoption) — adopted the 2025 CEC by reference with no local additions/deletions/amendments listed (unlike the Building and Fire Code sections in the same chapter); the generic Detailed Submittal Checklist PDF also states no electrical-PE-stamp threshold.

https://ecode360.com/49207600

Q15 What does a residential solar permit cost? Core Fees

$125 minimum, based on verified construction valuation, plus a 7% Systems Automation Fee (SAF) surcharge, under the general 'Building Permit' fee line — there is no PV-specific dollar figure or kW-based fee line.

Why the confidence is not higherFY2024-25 Cost for Services Fee Schedule (Resolution 2024-27), Building Division section — this is the most current fee schedule published on the city's Building Services page (a newer FY2025-26 schedule was not found on the site as of this run); the schedule contains zero PV/solar-specific fee lines (control-checked: 'Electrical Permit' and other Building Division lines are present and readable, so the search worked), so the PV fee is calculated under the generic valuation-based 'Building Permit' fee.

fee schedule checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2024-07/Resol%2024-27%20FY%2024-25%20Cost%20for%20Services%20Fee%20Schedule.pdf

Q16 How is the fee calculated? Core Fees

Valuation

Why the confidence is not higherThe Building Division's 'Building Permit' fee line reads '$125 minimum fee based on verified construction valuation, plus 7% Systems Automation Fee (SAF)' — a valuation-based fee with a flat percentage surcharge, not a per-kW or per-panel schedule.

fee schedule checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2024-07/Resol%2024-27%20FY%2024-25%20Cost%20for%20Services%20Fee%20Schedule.pdf

Q17 Is there a separate plan-check fee? Fees

Yes

Why the confidence is not higherThe FY24-25 fee schedule's Building Division section lists 'Plan Check — 75% of Building Fee, plus 7% SAF' as its own line item, separate from the Building Permit fee itself.

fee schedule checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2024-07/Resol%2024-27%20FY%2024-25%20Cost%20for%20Services%20Fee%20Schedule.pdf

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Up to 30 business days for standard residential review (per the city's own general statement); GMC §11.04.130 separately requires an 'expedited' process for small residential rooftop solar under Gov. Code §65850.5 but does not itself state a specific day count.

Why the confidence is not higherThe Building Services page (WebFetch, live HTML) states generically: 'All new residential construction projects such as; additions, remodels, ADUs and garage conversions, can take up to 30 days to complete the review' — this is not solar-specific, and the solar chapter itself only cross-references the state-mandated expedited process without giving its own turnaround figure, so this answer combines two partial sources rather than one direct statement.

department page checked 2026-08-31 https://gonzalesca.gov/services/building-services

Q19 How long is an issued permit valid before it expires? Timeline & validity

Nothing published by this authority.

Where we lookedGMC §11.04.020 (Building Code adoption, listing the city's local amendments A-G) — no local amendment addresses permit validity/expiration; the FY24-25 fee schedule and Building Services page also do not state a permit-expiration period.

https://ecode360.com/49207600

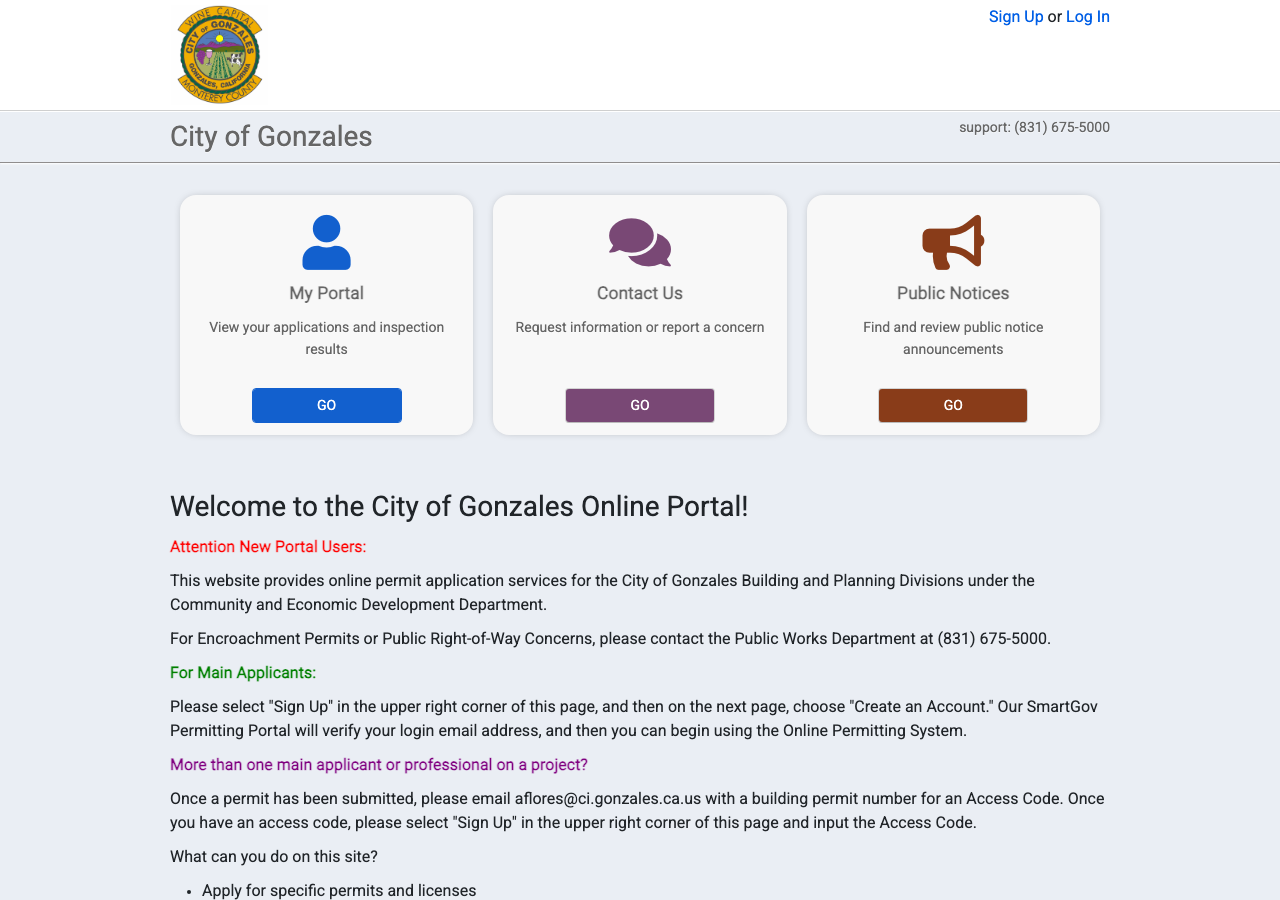

Q20 Which permit portal does this authority use? Core Portal & process

SmartGov Community Development (ci-gonzales-ca.smartgovcommunity.com)

Why the confidence is not higherThe city's own Building Services page links its 'Online Permitting Portal' directly to this SmartGov instance.

portal landing page checked 2026-08-31 https://ci-gonzales-ca.smartgovcommunity.com/Public/Home

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherWebFetch of the portal landing page describes the ability to 'submit drawings and documents for review, request inspections, and access application status,' suggesting a largely paperless workflow for applicable permit types, though the page does not explicitly state that a Solar PV application specifically can be completed end-to-end online without any in-person step.

portal landing page checked 2026-08-31 https://ci-gonzales-ca.smartgovcommunity.com/Public/Home

Q22 Which utility handles interconnection here? Core Utility interconnection

Pacific Gas & Electric (PG&E)

Why the confidence is not higherInferred, not directly confirmed by a Gonzales-specific interconnection document: the FY24-25 fee schedule's own 'UTILITIES' billing section lists only Garbage, Water and Waste Water as city-billed utilities (no Electric line), proving the City does not operate its own electric utility; the Building Services page's own external-resources list links to 'PG&E Energy Training' as the relevant energy-efficiency partner; and Gonzales sits within Monterey County, which has no other electric utility of record. No PG&E service-territory map or Gonzales-specific interconnection page was independently pulled this run.

fee schedule (inference) checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2024-07/Resol%2024-27%20FY%2024-25%20Cost%20for%20Services%20Fee%20Schedule.pdf

Q23 Where does the utility sit in the sequence? Core Utility interconnection

Nothing published by this authority.

Where we lookedCity's Building Services and Permit Center pages (no utility-sequencing statement found); PG&E's own Rule 21 / Distributed Generation interconnection handbook was not fetched this run, so this is a genuine gap rather than a proven absence at the utility level.

https://gonzalesca.gov/services/building-services

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No

Why the confidence is not higherGMC Title 12 (Zoning Regulations) has no Architectural Review Board, Design Review, or HOA-approval chapter anywhere in its table of contents (confirmed by reading the full Title 12 TOC: Parts 1-5, Chapters 12.04-12.160) — a control-proven absence, not an inference from silence in one section.

municipal code (TOC) checked 2026-08-31 https://ecode360.com/46750189

Q25 Is there a historic-district review? Overlays & special cases

Yes, but only within the Historic District Overlay — not citywide

Why the confidence is not higherGMC Ch. 12.108 'H Historic District Overlay' (§§12.108.010-.030) exists as a Part 4 overlay district; a residential parcel outside that overlay would not trigger historic review. I did not pull the overlay's own boundary map to confirm whether it covers residential parcels or only the downtown core.

municipal code (TOC) checked 2026-08-31 https://ecode360.com/46750189

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherNo windstorm/wind-load certification analogous to a TDI-style requirement appears anywhere in GMC Title 11 (Building Regulations) — confirmed by a full-text search of the extracted Chapter 11.04 text (adoption of the 2025 CBC/CRC/CEC/CFC plus all local amendments) returning zero hits for 'wind' or 'windstorm.' California uses seismic (not windstorm) engineering criteria under the CBC/CRC, and Gonzales adopts those without a local wind-certification addition.

municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/49207600

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Not required for a standard rooftop residential PV system meeting the small-residential-solar definition in GMC §11.04.130 (no Council/CUP/SUP step is described in that chapter). A related zoning trigger exists only for oversized accessory structures: GMC §12.112.030(B)(4) requires Planning Director (not Council/SUP) approval for any accessory structure exceeding 450 sq. ft., which could apply to a large ground-mount array footprint.

Why the confidence is not higherGMC §11.04.130 describes only a building-department expedited-approval process, no zoning entitlement step, for qualifying systems; §12.112.030(B)(4) is the closest analogous size-triggered approval found in Title 12, and it routes to the Planning Director, not the City Council or a Specific Use Permit.

municipal code checked 2026-08-31 https://ecode360.com/49207600

Q28 Is there a system-size cap on residential generation? Overlays & special cases

10 kW AC nameplate rating or 30 kW thermal, and only for systems on a single- or duplex-family dwelling that do not exceed the maximum legal building height.

Why the confidence is not higherGMC §11.04.130(B)(2): 'Small residential rooftop solar energy system' is defined with this exact cap, verbatim from Gov. Code §65850.5.

municipal code checked 2026-08-31 https://ecode360.com/49207600

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2023 85% · adopting ordinance
    • Which building code edition is in force? 2025 California Building Code (and 2025 California Residential Code for one- and two-family dwellings) 95% · adopting ordinance
    • Which fire code edition is in force? 2025 California Fire Code, extensively locally amended (54+ numbered local amendments) 95% · adopting ordinance
    • Are there local amendments to any of the above? Yes 95% · adopting ordinance
    • What is the installation judged against? The 2025 California Building, Residential, Electrical, Mechanical, Plumbing, Energy, Green Building, WUI and Fire Codes as locally amended (GMC Title 11, Ch. 11.04), plus Gov. Code §65850.5's small-residential-rooftop-solar standard as codified at GMC §11.04.130. 90% · adopting ordinance
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Locally amended, not locally specified in full: Amendment No. 47 deletes Exceptions 1 and 2 of CFC §1205.2.1 ('Solar Photovoltaic (PV) Systems for Group R-3 Buildings') in their entirety, meaning the base 2025 CFC §1205.2 pathway/setback requirements apply to Gonzales R-3 solar installs without the carve-outs those exceptions would otherwise provide; Amendment No. 48 additionally adds the 1½ ft hip/valley module-spacing rule (Q35). 70% · adopting ordinance (local amendment)
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? Placards/labels required at: (1) main service disconnect panel exterior — 'SOLAR DISCONNECT INSIDE PANEL'; (2) circuit breaker controlling the inverter/PV electrical controller — 'SOLAR DISCONNECT'; (3) secondary power source shutoff switch (where PV is interconnected to battery/generator/other backup) — location signage; (4) adjacent to the main disconnect — installer name and 24-hr emergency phone number; (5) where a BESS is installed inside a structure — 'BESS' placard; (6) where a stationary fuel cell system is installed inside a structure — 'FUEL CELL' placard; (7) energy storage system (ESS) disconnects — location/shutdown placarding at or adjacent to the main electrical panel. 95% · adopting ordinance (local amendment)
    • Does the authority specify placard wording of its own? Yes 95% · adopting ordinance (local amendment)
    • Does it specify letter height, colour or material? Yes. Main panel exterior placard: red background, white capital letters, non-serif font, minimum 1/2" letter height, weather-resistant durable plastic with engraved letters (or other approved material). Circuit-disconnect label: contrasting-color capital letters, non-serif font, minimum 3/8" letter height, durable adhesive material (or other approved material). BESS and Fuel Cell placards: block letters 6" high with a 3/4" stroke, on a contrasting background. 95% · adopting ordinance (local amendment)
    • Where must the labels be placed? Main-panel placard: permanently affixed to the exterior of the main service disconnect panel. Circuit-disconnect label: adjacent to the circuit breaker controlling the inverter/PV electrical controller. Secondary-power-source signage: at the secondary power source shutoff switch. Installer-information signage: adjacent to the main disconnect. BESS/Fuel Cell placards: at the location of the equipment, when installed inside a structure. ESS disconnects: located at or adjacent to the main electrical panel, with placarding showing the location of equipment and all shutdowns. 90% · adopting ordinance (local amendment)
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Must equipment be on a specific approved list? No 55% · adopting ordinance (control-checked absence)
    • Are batteries permitted, and under what conditions? Yes. Batteries/BESS are permitted; local Fire Code amendments require: energy storage system (ESS) disconnects located at or adjacent to the main electrical panel with placarding showing equipment location and all shutdowns (Amendment 50, CFC §1207.4.1.1); a 'BESS' placard (6" block letters, 3/4" stroke, contrasting background) where a battery energy storage system is installed inside any structure (Amendment 51, CFC §1207.4.8(6)); and additional Fire-Chief-approved signage indicating the secondary power source shutoff switch where PV is interconnected to a battery system (Amendment 46, CFC §1205.1.1.3). 85% · adopting ordinance (local amendment)
    • Is there a separate ESS permit or inspection? Not explicitly separate — no dedicated 'ESS permit' or 'ESS inspection' line was found. A generic 'Fire Permit' fee line (minimum $158 + 7% SAF) exists in the Building Division fee schedule and would plausibly cover an ESS operational permit under the adopted Fire Code, but this is inferred rather than stated. 55% · fee schedule (inference)
    • Is a ground mount treated as a structure? Likely yes, by default — no solar-specific ground-mount exemption or definition exists anywhere in GMC Title 11 or Title 12, so a ground-mounted PV array would presumably be evaluated under the general 'accessory structures and uses' standards (GMC §12.112.030): height ≤15 ft, setback from yards, ≥5 ft from other structures, ≤15% lot coverage, and Planning Director approval required if it exceeds 450 sq. ft. 55% · municipal code (inference)
    • Is there a local rule on service upgrades or busbar sizing? No local rule found 85% · adopting ordinance (control-checked absence)
    • Is a specific mounting system or attachment spacing required? Yes — a hip/valley module-spacing rule: 'Modules shall be located no closer than one and one-half feet (1½') to a hip or valley if modules are to be placed on both sides of a hip or valley. Where modules are located on only one side of a hip or valley that is of equal length, the modules shall be permitted to be placed directly adjacent to the hip or valley.' 85% · adopting ordinance (local amendment)

20 questions answered against City of Gonzales’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2023

Why the confidence is not higherGMC §11.04.040 adopts 'the 2025 edition of the California Electrical Code... as compiled and published by the National Fire Protection Association' (Ord. 2025-154, eff. 1/12/2026). The 2025 California code cycle (effective statewide 1 Jan 2026) is based on NFPA 70-2023 as its NEC edition; the city's own code text names the 2025 CEC but does not itself spell out '2023 NEC' in so many words, hence not 95.

adopting ordinance checked 2026-08-31 https://ecode360.com/49207600

Q30 Which building code edition is in force? Core Code editions in force

2025 California Building Code (and 2025 California Residential Code for one- and two-family dwellings)

Why the confidence is not higherGMC §§11.04.020 and 11.04.030, Ord. 2025-154, eff. 1/12/2026.

adopting ordinance checked 2026-08-31 https://ecode360.com/49207600

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code, extensively locally amended (54+ numbered local amendments)

Why the confidence is not higherGMC §11.04.080, Ord. 2025-154, eff. 1/12/2026.

adopting ordinance checked 2026-08-31 https://ecode360.com/49207600

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherGMC §11.04.020 (Building Code) carries local Amendments A-G (construction hours, geotechnical reports, plan-modification approval process, dangerous-building nuisance abatement, dwelling-unit definition, sprinkler exemption) and §11.04.080 (Fire Code) carries at least 54 numbered local amendments including PV/ESS-specific signage and hip/valley layout rules. By contrast §11.04.040 (Electrical Code) carries none — see Q34.

adopting ordinance checked 2026-08-31 https://ecode360.com/49207600

Q33 What is the installation judged against? Core Electrical

The 2025 California Building, Residential, Electrical, Mechanical, Plumbing, Energy, Green Building, WUI and Fire Codes as locally amended (GMC Title 11, Ch. 11.04), plus Gov. Code §65850.5's small-residential-rooftop-solar standard as codified at GMC §11.04.130.

Why the confidence is not higherGMC Ch. 11.04 in full.

adopting ordinance checked 2026-08-31 https://ecode360.com/49207600

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

No local rule found

Why the confidence is not higherGMC §11.04.040 (Electrical Code) adopts the 2025 CEC by reference with no 'except for the following additions, deletions, and amendments' clause at all — unlike §11.04.020 (Building) and §11.04.080 (Fire), which both carry explicit local-amendment lists. This is a control-proven absence: the same chapter's drafting convention makes the presence/absence of that clause reliable evidence.

adopting ordinance (control-checked absence) checked 2026-08-31 https://ecode360.com/49207600

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Yes — a hip/valley module-spacing rule: 'Modules shall be located no closer than one and one-half feet (1½') to a hip or valley if modules are to be placed on both sides of a hip or valley. Where modules are located on only one side of a hip or valley that is of equal length, the modules shall be permitted to be placed directly adjacent to the hip or valley.'

Why the confidence is not higherLocal Fire Code Amendment No. 48, adding CFC §1205.2.1.4 'Hip and Valley Layout' (GMC §11.04.080).

adopting ordinance (local amendment) checked 2026-08-31 https://ecode360.com/49207600

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Locally amended, not locally specified in full: Amendment No. 47 deletes Exceptions 1 and 2 of CFC §1205.2.1 ('Solar Photovoltaic (PV) Systems for Group R-3 Buildings') in their entirety, meaning the base 2025 CFC §1205.2 pathway/setback requirements apply to Gonzales R-3 solar installs without the carve-outs those exceptions would otherwise provide; Amendment No. 48 additionally adds the 1½ ft hip/valley module-spacing rule (Q35).

Why the confidence is not higherLocal Fire Code Amendments 47-48 (GMC §11.04.080). I did not independently pull the base, un-amended 2025 CFC §1205.2 text itself this run, so I cannot quote Gonzales' resulting numeric ridge-setback/pathway-width figures directly — only the fact and content of the local amendment to it.

adopting ordinance (local amendment) checked 2026-08-31 https://ecode360.com/49207600

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Required, under NEC Article 690.12 as incorporated by the city's adoption of the 2025 California Electrical Code (= 2023 NEC base) at GMC §11.04.040; not locally modified.

Why the confidence is not higherNo local amendment to the Electrical Code exists at all (Q34), and the extensive 54+-item local Fire Code amendment list (which does address other PV/ESS topics in detail) contains zero occurrences of 'rapid shutdown' or '690.12' — a control-checked absence showing the city relies on the base code's rapid-shutdown mandate rather than restating or modifying it.

inference from adopted code + control-checked absence of local amendment checked 2026-08-31 https://ecode360.com/49207600

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

Placards/labels required at: (1) main service disconnect panel exterior — 'SOLAR DISCONNECT INSIDE PANEL'; (2) circuit breaker controlling the inverter/PV electrical controller — 'SOLAR DISCONNECT'; (3) secondary power source shutoff switch (where PV is interconnected to battery/generator/other backup) — location signage; (4) adjacent to the main disconnect — installer name and 24-hr emergency phone number; (5) where a BESS is installed inside a structure — 'BESS' placard; (6) where a stationary fuel cell system is installed inside a structure — 'FUEL CELL' placard; (7) energy storage system (ESS) disconnects — location/shutdown placarding at or adjacent to the main electrical panel.

Why the confidence is not higherLocal Fire Code Amendments 46, 49, 50 and 51, adding CFC §§1205.1.1-1205.1.1.4, 1206.14, 1207.4.1.1 and 1207.4.8(6) (GMC §11.04.080).

adopting ordinance (local amendment) checked 2026-08-31 https://ecode360.com/49207600

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Yes

Why the confidence is not higherSame amendments as Q38 specify the exact wording verbatim: 'SOLAR DISCONNECT INSIDE PANEL,' 'SOLAR DISCONNECT,' 'BESS,' and 'FUEL CELL.'

adopting ordinance (local amendment) checked 2026-08-31 https://ecode360.com/49207600

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Yes. Main panel exterior placard: red background, white capital letters, non-serif font, minimum 1/2" letter height, weather-resistant durable plastic with engraved letters (or other approved material). Circuit-disconnect label: contrasting-color capital letters, non-serif font, minimum 3/8" letter height, durable adhesive material (or other approved material). BESS and Fuel Cell placards: block letters 6" high with a 3/4" stroke, on a contrasting background.

Why the confidence is not higherLocal Fire Code Amendments 46, 49 and 51 (CFC §§1205.1.1.1, 1205.1.1.2, 1206.14, 1207.4.8(6)), GMC §11.04.080.

adopting ordinance (local amendment) checked 2026-08-31 https://ecode360.com/49207600

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedLocal Fire Code Amendments 46-51 (signage/placarding) and GMC §11.04.020 (Building Code local amendments A-G) — neither contains a facility/site-plan placard requirement analogous to NEC 705.10; no such requirement was located in any Gonzales-specific document this run.

https://ecode360.com/49207600

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedCity's Building Services, Fire Department and Permit Center pages were checked for a cross-reference to a utility-specific labeling requirement and none was found; PG&E's own Distributed Generation interconnection handbook / Electric Rule 21 was not fetched this run, so this is an access gap rather than a proven absence.

https://gonzalesca.gov/services/building-services

Q43 Where must the labels be placed? Core Labels Signage & labelling

Main-panel placard: permanently affixed to the exterior of the main service disconnect panel. Circuit-disconnect label: adjacent to the circuit breaker controlling the inverter/PV electrical controller. Secondary-power-source signage: at the secondary power source shutoff switch. Installer-information signage: adjacent to the main disconnect. BESS/Fuel Cell placards: at the location of the equipment, when installed inside a structure. ESS disconnects: located at or adjacent to the main electrical panel, with placarding showing the location of equipment and all shutdowns.

Why the confidence is not higherLocal Fire Code Amendments 46, 49, 50 and 51 (GMC §11.04.080).

adopting ordinance (local amendment) checked 2026-08-31 https://ecode360.com/49207600

Q44 Must equipment be on a specific approved list? Equipment listing

No

Why the confidence is not higherNo Gonzales-specific 'approved equipment list' requirement was found in the Building or Fire Code local amendments or in any published Building Services document (control-checked: the same documents do specify placard wording, material and letter-height in detail, so the absence of an equipment-list clause is unlikely to be a search failure). NEC/CEC-listed-equipment requirements apply generically but are not a city-specific approved list.

adopting ordinance (control-checked absence) checked 2026-08-31 https://ecode360.com/49207600

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Yes. Batteries/BESS are permitted; local Fire Code amendments require: energy storage system (ESS) disconnects located at or adjacent to the main electrical panel with placarding showing equipment location and all shutdowns (Amendment 50, CFC §1207.4.1.1); a 'BESS' placard (6" block letters, 3/4" stroke, contrasting background) where a battery energy storage system is installed inside any structure (Amendment 51, CFC §1207.4.8(6)); and additional Fire-Chief-approved signage indicating the secondary power source shutoff switch where PV is interconnected to a battery system (Amendment 46, CFC §1205.1.1.3).

Why the confidence is not higherLocal Fire Code Amendments 46, 50 and 51 (GMC §11.04.080).

adopting ordinance (local amendment) checked 2026-08-31 https://ecode360.com/49207600

Q46 Is there a separate ESS permit or inspection? Battery / ESS

Not explicitly separate — no dedicated 'ESS permit' or 'ESS inspection' line was found. A generic 'Fire Permit' fee line (minimum $158 + 7% SAF) exists in the Building Division fee schedule and would plausibly cover an ESS operational permit under the adopted Fire Code, but this is inferred rather than stated.

Why the confidence is not higherFY24-25 fee schedule, Building Division section ('Fire Permit — Minimum $158 + 7% SAF'); no ESS-specific fee line or inspection-stage description was found in the Fire Code local amendments or on the Fire Department page.

fee schedule (inference) checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2024-07/Resol%2024-27%20FY%2024-25%20Cost%20for%20Services%20Fee%20Schedule.pdf

Q47 Is a ground mount treated as a structure? Core Ground mount

Likely yes, by default — no solar-specific ground-mount exemption or definition exists anywhere in GMC Title 11 or Title 12, so a ground-mounted PV array would presumably be evaluated under the general 'accessory structures and uses' standards (GMC §12.112.030): height ≤15 ft, setback from yards, ≥5 ft from other structures, ≤15% lot coverage, and Planning Director approval required if it exceeds 450 sq. ft.

Why the confidence is not higherGMC §12.112.030 (Accessory Structures and Uses) is the only structure-classification standard in Title 12 that would plausibly apply, in the confirmed absence (control-checked, zero 'solar'/'photovoltaic' hits in the full text of Ch. 12.112) of any solar-specific carve-out.

municipal code (inference) checked 2026-08-31 https://ecode360.com/46750889

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedLocal Fire Code amendments (GMC §11.04.080) and Building Code local amendments (GMC §11.04.020) were checked and contain no rule on AC-disconnect placement relative to the utility meter; PG&E's own Electric Service Requirements Manual (ESRM), which is the document that would normally set this, was not fetched this run.

https://ecode360.com/49207600

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Portal or Phone 85% · department page
    • Are same-day or AM/PM windows offered? No same-day or AM/PM-choice windows — inspections are offered only on a fixed Tuesday/Thursday, 1:00-4:00 PM schedule. 75% · department page
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 85% · municipal code
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? Only ONE inspection is required for a qualifying small residential rooftop solar system, 'unless the installation is found to be out of compliance with the California building standards codes,' in which case additional inspection(s) follow correction. 85% · municipal code
    • Is a rough-in or mid-roof inspection required? No 80% · municipal code
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? No 60% · department page (control-checked absence)
    • What must be on site at inspection? Building permit card, official stamped/approved plans, and a person 18 years or older or a responsible contractor present on site. 85% · department page
    • Does the inspector verify labels and listings? Presumed yes, though not explicitly stated as an inspector duty — the extensive local Fire Code amendments (Q38-40) require specific placards/labels to exist at final, which a final inspection would need to confirm are present and correctly worded/sized to pass. 55% · inference from adopted code
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final (signed-off building permit card) — no evidence a standalone Certificate of Occupancy is issued for a PV-only permit; the fee schedule's 'Certificate of Occupancy (COO) $188.00' line reads as a new-construction/occupancy-change item, not a routine PV add-on outcome. 50% · inference
    • Who notifies the utility for PTO? Installer 50% · inference
    • Is there a re-inspection fee? Actual Cost, plus 10% (1-hour minimum) — the Code Enforcement Division's general 'Re-Inspection Fees' line. A separate flat '$62.50 Reinspection Fee' also appears at the end of the Planning Department fee section; it is unclear which (if either) is the figure that would actually apply to a Building-Division solar re-inspection, since no PV-specific or Building-Division-specific re-inspection line exists. 55% · fee schedule

14 questions answered against City of Gonzales’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Portal or Phone

Why the confidence is not higherBuilding Services page: 'Inspections occur Tuesdays and Thursdays, 1:00-4:00 PM (schedule through portal or call 831-675-5000).'

department page checked 2026-08-31 https://gonzalesca.gov/services/building-services

Q50 How much notice is required? Core Booking & scheduling

Nothing published by this authority.

Where we lookedBuilding Services page and SmartGov portal landing page were both checked; neither states a required advance-notice period for scheduling an inspection.

https://gonzalesca.gov/services/building-services

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

No same-day or AM/PM-choice windows — inspections are offered only on a fixed Tuesday/Thursday, 1:00-4:00 PM schedule.

Why the confidence is not higherBuilding Services page, same inspection-scheduling statement as Q49.

department page checked 2026-08-31 https://gonzalesca.gov/services/building-services

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherGMC §11.04.130(D): small residential rooftop solar systems 'shall only require one inspection... Inspection requests shall be made in compliance with this title, Building Regulations' — i.e. performed by the city's own Building Division, not a delegated agency. The city's own Building Department Staff page also names an in-house Building Inspector (Gabriel Martinez).

municipal code checked 2026-08-31 https://ecode360.com/49207600

Q53 If delegated, to whom? Core Who inspects

Nothing published by this authority.

Where we lookedNot applicable — GMC §11.04.130(D) and the Building Department Staff page (in-house Building Inspector) both show the city performs its own final solar inspection rather than delegating it.

https://gonzalesca.gov/services/building-services/building-department-staff

Q54 Which inspections are required, and in what order? Core Stages & sequence

Only ONE inspection is required for a qualifying small residential rooftop solar system, 'unless the installation is found to be out of compliance with the California building standards codes,' in which case additional inspection(s) follow correction.

Why the confidence is not higherGMC §11.04.130(D).

municipal code checked 2026-08-31 https://ecode360.com/49207600

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No

Why the confidence is not higherGMC §11.04.130(D) explicitly limits qualifying systems to a single inspection; no separate rough-in or mid-roof inspection is described for compliant installations.

municipal code checked 2026-08-31 https://ecode360.com/49207600

Q56 Does the inspector verify labels and listings? Core What is checked

Presumed yes, though not explicitly stated as an inspector duty — the extensive local Fire Code amendments (Q38-40) require specific placards/labels to exist at final, which a final inspection would need to confirm are present and correctly worded/sized to pass.

Why the confidence is not higherInference from GMC §11.04.080 local Fire Code Amendments 46/49/50/51 combined with the single-inspection rule at §11.04.130(D); no document explicitly states the inspector's checklist duties.

inference from adopted code checked 2026-08-31 https://ecode360.com/49207600

Q57 Is there a published inspection checklist? Core What is checked

No

Why the confidence is not higherThe Building Services 'Key Documents' list (Building Permit Application, Owner-Builder Form, Smoke/CO Affidavit, Construction Waste Management Form, Special Inspection Form/Agencies list, Residential Remodel Requirements, Aging-in-Place requirements, Detailed Submittal Checklist, Stormwater checklists, Owner-Builder CSLB pamphlet, EVSE checklist, Building Permit Application Declaration) contains no inspection checklist of any kind, solar or otherwise.

department page (control-checked absence) checked 2026-08-31 https://gonzalesca.gov/services/building-services

Q58 What must be on site at inspection? Core Documents on site

Building permit card, official stamped/approved plans, and a person 18 years or older or a responsible contractor present on site.

Why the confidence is not higherBuilding Services page: 'Required onsite: building permit card, official stamped approved plans, and a person 18+ or responsible contractor.'

department page checked 2026-08-31 https://gonzalesca.gov/services/building-services

Q59 Is there a re-inspection fee? Corrections & re-inspection

Actual Cost, plus 10% (1-hour minimum) — the Code Enforcement Division's general 'Re-Inspection Fees' line. A separate flat '$62.50 Reinspection Fee' also appears at the end of the Planning Department fee section; it is unclear which (if either) is the figure that would actually apply to a Building-Division solar re-inspection, since no PV-specific or Building-Division-specific re-inspection line exists.

Why the confidence is not higherFY24-25 fee schedule, Code Enforcement Division and Planning Department sections.

fee schedule checked 2026-08-31 https://gonzalesca.gov/sites/default/files/2024-07/Resol%2024-27%20FY%2024-25%20Cost%20for%20Services%20Fee%20Schedule.pdf

Q60 How are corrections issued and cleared? Corrections & re-inspection

Nothing published by this authority.

Where we lookedBuilding Services page and SmartGov portal landing page were both checked; neither describes how corrections are issued to an applicant or how they are cleared/re-verified.

https://gonzalesca.gov/services/building-services

Q61 What is issued on pass? Core Final sign-off & PTO

Final (signed-off building permit card) — no evidence a standalone Certificate of Occupancy is issued for a PV-only permit; the fee schedule's 'Certificate of Occupancy (COO) $188.00' line reads as a new-construction/occupancy-change item, not a routine PV add-on outcome.

Why the confidence is not higherInferred from the Building Services page's onsite-inspection requirements (permit card must be present and gets signed off) and the FY24-25 fee schedule's COO line; no document states explicitly what document/tag is issued specifically for a passed solar inspection.

inference checked 2026-08-31 https://gonzalesca.gov/services/building-services

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer

Why the confidence is not higherNot confirmed by a Gonzales- or PG&E-specific document this run; based on standard California PG&E Net Energy Metering practice, in which the installer submits proof of final permit sign-off to PG&E to trigger Permission to Operate. No Gonzales interconnection page or PG&E DG manual was pulled to verify this directly.

inference checked 2026-08-31 https://gonzalesca.gov/services/building-services

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Gonzales against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Gonzales is the authority having jurisdiction 88% confidence
Holds
Building, Electrical, Mechanical, Plumbing and Fire — all adopted and enforced in-house by the City under GMC Title 11, Ch. 11.04 (Ord. 2025-154, eff. 1/12/2026). Plan review is partially delegated to a named contractor (4LEAF, Inc.), and the Building Official position is currently interim, billed to the city as a consultant.
Delegated to
4LEAF, Inc. (building plan review contractor, named on the city's own Building Department Staff page)
Overridden by
CA Gov. Code §65850.5 (small residential rooftop solar expedited-permitting mandate, 10 kW AC / 30 kW thermal cap), codified verbatim at GMC §11.04.130
Why not higher
GMC Title 11 is the city's own current code (confirmed live on eCode360, custId GO4462, legislation through 02-02-2026); the city's own Building Permit Application lists 'Solar PV' as a permit type processed by its Building Services Department, and its Fire Department page names an in-house Fire Chief who enforces an extensively locally-amended Fire Code. Not full 100 because the city's own Building Department Staff page lists the Building Official as 'interim' and names 4LEAF, Inc. as an outside plan-review provider — genuine partial delegation within an otherwise self-performing jurisdiction, not full in-house self-performance.

https://ecode360.com/49207600

Permit required
Yes90%
Permit cost
$125 minimum, based on verified construction valuation, plus a 7% Systems Automation Fee (SAF) surcharge,70%
Plan review
Up to 30 business days for standard residential review (per the city's own general statement); GMC §11.04.130 separately requires an 'expedited' process for small residential rooftop solar…55%
Portal
SmartGov Community Development (ci-gonzales-ca.smartgovcommunity.com)95%
Electrical code
202385%
Own placard wording
Yes95%
Booking an inspection
Portal or Phone85%
Labels & placards for this authority

City of Gonzales writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.

Wording 95%

Yes

Size, colour & material 95%

Yes. Main panel exterior placard: red background, white capital letters, non-serif font, minimum 1/2" letter height, weather-resistant durable plastic with engraved letters (or other approved material). Circuit-disconnect label: contrasting-color capital letters, non-serif font, minimum 3/8" letter height, durable adhesive material (or other approved material). BESS and Fuel Cell placards: block letters 6" high with a 3/4" stroke, on a contrasting background.

Where they go 90%

Main-panel placard: permanently affixed to the exterior of the main service disconnect panel. Circuit-disconnect label: adjacent to the circuit breaker controlling the inverter/PV electrical controller. Secondary-power-source signage: at the secondary power source shutoff switch. Installer-information signage: adjacent to the main disconnect. BESS/Fuel Cell placards: at the location of the equipment, when installed inside a structure. ESS disconnects: located at or adjacent to the main electrical panel, with placarding showing the location of equipment and all shutdowns.

What the utility wants on top None%

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Monterey County
Regions served
1
Regions covered
City of Gonzales · city
Solar Requirements
Separate roof inspection
Building Services | City of Gonzales Skip to main content Building Services Home Services Building Services Carousel content A carousel is a rotating set of images, rotation stops on keyboard focus on carousel tab controls or hovering the mouse pointer over images. Use the tabs or the previous and n
Separate fire inspection
A contractor’s license is issued by the State of California, and anyone who contracts to perform work on a project that is valued at $500 or more (for combined labor and materials costs) must hold a current, valid license from the California State License Board . To verify a license, click here ; an
Authority Contact
Address
147 Fourth St., Gonzales, CA 93926
Main Phone
(831) 675-5000
Building Department
Department
Building Services Department
Direct Phone
(831) 675-5000
Portal Software
SmartGov
Booking & Scheduling
Preferred channel
online_portal
Notes
Uses SmartGov Community online portal (ci-gonzales-ca.smartgovcommunity.com) for permit applications, document submission, and inspection scheduling. Inspections conducted Tuesdays and Thursdays 1:00 PM–4:00 PM only. Building Official: Minerva Arredondo (buildingofficial@ci.gonzales.ca.us). Building Inspector: Gabriel Martinez. Development Services Technician: Alejandra Flores (aflores@ci.gonzales.ca.us). Solar permits are expedited/streamlined per CA law and require only one inspection. Office at 147 Fourth St, Gonzales CA 93926; hours Mon–Fri 8:00 AM–5:00 PM (closed 12:30–1:30 PM). Permit submittals accepted until 4:30 PM. Plan review contracted to 4LEAF, INC.
