City of La Verne
Los Angeles County
City of La Verne is a city authority in the State of California, serving 31,334 residents. 2,135 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 3 business days Q18 Where you file — City's own 'Permit Portal' at laverne.geoviewer.io (internally titled 'Permitting App'), integrated with SolarAPP+ (gosolarapp.org) for plan review Q20
- Permit required
- Yes95% source
- What it costs
- No flat fee published for residential PV building/electrical permits — valuation-based per LVMC §15.04.070 ('two times the prevailing Los Angeles County fee... for buildings and structures').70% source
- Plan review turnaround
- 3 business days90% source
- Key document
- ordinance + department handout cited by 5 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · authority's own page
- What does this authority permit itself, and what does it delegate? Both 88% · ordinance
- Is a permit required for a residential rooftop PV system? Yes 95% · ordinance
- Is there a separate electrical permit, or is it combined? Combined 72% · authority's own page
- Is a HOA or architectural approval required first? No formal HOA/architectural board approval required by the City; a Planning Department staff sign-off (stamp on site plan) is required before Building submittal, and HOA restrictions are separately preempted by the Solar Rights Act 68% · ordinance + department handout
- Is there a historic-district review? No dedicated historic-district/Certificate-of-Appropriateness ordinance was found that reaches rooftop PV 68% · zoning code (full-text search, control-proven)
- Is a Specific Use Permit or Council approval ever required? Yes, but rare — CUP only if the Building Official finds a specific, adverse health/safety impact 85% · ordinance
- Is there a system-size cap on residential generation? 10 kW AC / 30 kW thermal is a GATE, not a hard cap — it defines the 'small residential rooftop solar energy system' eligible for the 3-business-day ministerial path; larger, ground-mounted, multi-family, commercial, industrial and institutional systems are simply routed to Precise Plan Review (LVMC Ch. 18.16) instead of being forbidden 90% · ordinance
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Any contractor 75% · department handout (dated 08/22)
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- How many copies, and in what format? Minimum 3 sets of plans, 11"x17" or larger, plus manufacturer specification sheets, installation instructions and listings 80% · department handout (dated 08/22)
- Is a site plan required, and what must it show? Yes — must show property lines, lot dimensions, side yards, existing buildings, distances between adjacent buildings, public right-of-way, and location of PV panels/equipment; requires a Planning Department approval stamp before Building submittal 85% · department handout (dated 08/22)
- Is a one-line / three-line diagram required? Yes 88% · department handout (dated 08/22)
- Is a structural PE stamp required, and at what threshold? Yes — structural PE/architect stamp required when the system exceeds 5 pounds per square foot roof load 85% · department handout (dated 08/22)
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? City's own 'Permit Portal' at laverne.geoviewer.io (internally titled 'Permitting App'), integrated with SolarAPP+ (gosolarapp.org) for plan review 85% · authority's own page
- Can the whole application be completed online? Yes 82% · authority's own page
- What does a residential solar permit cost? No flat fee published for residential PV building/electrical permits — valuation-based per LVMC §15.04.070 ('two times the prevailing Los Angeles County fee... for buildings and structures'). A separate Planning-level 'Solar Collector Review' fee of $150 applies when a system is routed to Precise Plan Review (ground-mounted, multi-family, commercial/industrial systems per §18.106.030); the FY2026-27 Comprehensive Fee Schedule labels this line 'Non-residential' even though the PPR guide's own fee table lists it as a general 'Solar Collector Review' line. 70% · fee schedule (FY2026-27, ModDate 18 Aug 2026)
- How is the fee calculated? Valuation 80% · ordinance
- Is there a separate plan-check fee? No — combined 65% · ordinance
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 3 business days 90% · ordinance
- How long is an issued permit valid before it expires? 180 days (default), no local amendment found 50% · inference from absence in ordinance text
- Which utility handles interconnection here? Southern California Edison (SCE) 75% · adopted city planning document (draft)
28 questions answered against City of La Verne’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherLVMC Title 15 (adopted county/state building codes) and Ch. 18.106 (Small Residential Solar Energy System Permits) both vest permitting in the City's own building official; confirmed operationally by the City's live 'Residential Solar Building Permit' page routing applicants to the City's SolarAPP+-integrated portal.
authority's own page checked 2026-08-31 https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherSelf-performed in-house: LVMC §15.04.030 names the Community Development Director as Building Official; the City's 2022 PV instructions handout is issued on 'City of La Verne, Department of Building & Safety' letterhead with a @laverneca.gov-domain contact. No named individual or outside-firm domain was found to confirm delegation is absent beyond doubt, so this is not set to 95.
ordinance checked 2026-08-31 https://ecode360.com/44522986
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherLVMC §18.106.030: 'This chapter applies to the permitting of all small residential rooftop solar energy systems in the city.'
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe City's SolarAPP+ workflow issues a single 'Solar Permit' through the Permit Portal (select 'Start My Permit' > 'Solar Permit'); no separate electrical-permit step is described. Not higher confidence because no ordinance text says 'combined' in so many words.
authority's own page checked 2026-08-31 https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Any contractor
Why the confidence is not higherCity's 2022 PV instructions require plans to be 'signed by a California licensed contractor classification C-46 or C-10... Contractor who signs the document must be the one doing the work (B&P Code §7031.5)' — i.e. a licensed C-46 (solar) or C-10 (electrical) contractor, not restricted to a single trade class. Handout is dated Aug 2022 and cites 2019 codes, so treated as practice evidence rather than current code text.
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Nothing published by this authority.
Where we lookedResidential Solar Building Permit page, Regulatory Permits page (/366), business-license fee pages, and site search for 'contractor registration' — no city-specific pre-registration requirement for solar contractors (beyond standard CSLB licensure) was found
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Nothing published by this authority.
Where we lookedResidential Solar Building Permit page (states SolarAPP+ is 'For Licensed Contractors Only' but does not address the non-SolarAPP+/owner-builder route), and site search for 'owner builder' — no explicit City statement on homeowner self-install/self-permit for PV was found

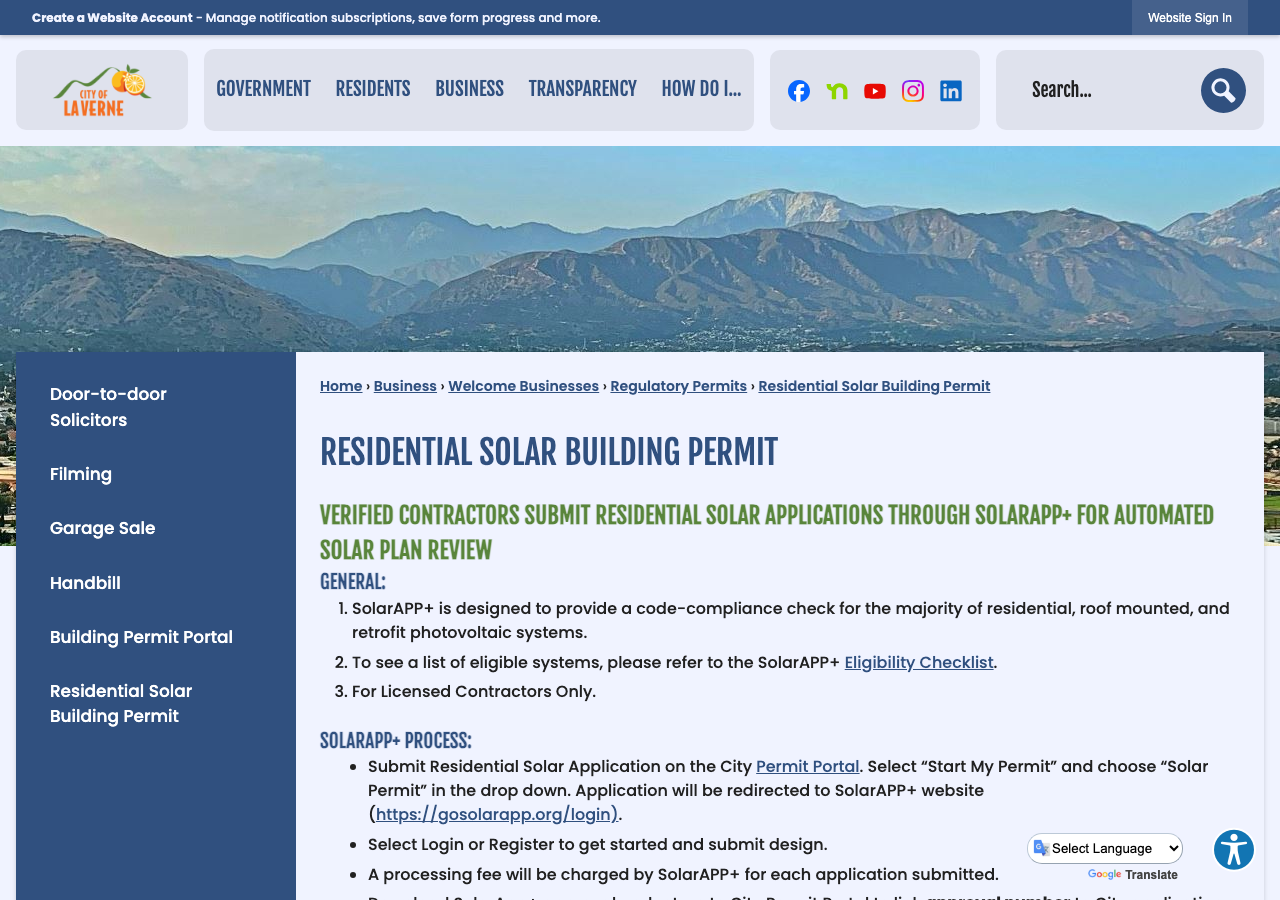

https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q8 What documents make up a complete submittal? Core Submittal package
Nothing published by this authority.
Where we lookedCity's 2022 PV instructions PDF gives item-by-item submittal content but is not labeled as a formal 'complete submittal checklist,' and no separate current checklist document was found linked from the Residential Solar or Regulatory Permits pages
Q9 How many copies, and in what format? Submittal package
Minimum 3 sets of plans, 11"x17" or larger, plus manufacturer specification sheets, installation instructions and listings
Why the confidence is not higherCity's PV instructions handout item 3. Same code-lag caveat as Q5 (cites 2019 CBC/CEC).
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — must show property lines, lot dimensions, side yards, existing buildings, distances between adjacent buildings, public right-of-way, and location of PV panels/equipment; requires a Planning Department approval stamp before Building submittal
Why the confidence is not higherCity's PV instructions handout, items 1-2.
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherHandout item 4: 'provide electrical single-line diagram clearly identifying all devices installed in the PV system and indicating total kVA rating of system.'
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedCity's 2022 PV instructions PDF (requires a single-line diagram with total kVA rating but does not separately itemize string/conductor sizing calculations) and LVMC Ch. 18.106 (silent on drawing content)
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Yes — structural PE/architect stamp required when the system exceeds 5 pounds per square foot roof load
Why the confidence is not higherHandout item 8: 'Structural plans and calculations shall be stamped and signed by state licensed engineer or architect when system exceeds 5 pounds per square foot.' This is a specific, quantified local threshold.
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedCity's 2022 PV instructions PDF (gives a structural-stamp threshold at item 8 but no electrical-PE threshold) and LVMC Ch. 18.106/Title 15 full text
Q15 What does a residential solar permit cost? Core Fees
No flat fee published for residential PV building/electrical permits — valuation-based per LVMC §15.04.070 ('two times the prevailing Los Angeles County fee... for buildings and structures'). A separate Planning-level 'Solar Collector Review' fee of $150 applies when a system is routed to Precise Plan Review (ground-mounted, multi-family, commercial/industrial systems per §18.106.030); the FY2026-27 Comprehensive Fee Schedule labels this line 'Non-residential' even though the PPR guide's own fee table lists it as a general 'Solar Collector Review' line.
Why the confidence is not higherComprehensive Fee Schedule item 7 under Community Development Dept Applications and PPR Guide fee table both show the same $150 figure; no flat number exists for the small-residential SolarAPP+ track, which is priced under the general valuation-based building-permit formula instead. Full-text search of the 41-page current fee schedule found zero 'photovoltaic'/'solar' hits under the Building Permits section itself.
fee schedule (FY2026-27, ModDate 18 Aug 2026) checked 2026-08-31 https://www.laverneca.gov/DocumentCenter/View/3611
Q16 How is the fee calculated? Core Fees
Valuation
Why the confidence is not higherLVMC §15.04.070: building/plumbing/electrical/mechanical permit and plan-check fees are set at 'two times the prevailing Los Angeles County fee... of permit and plan checking fees for buildings and structures set forth in the Los Angeles County Building, Electrical, Plumbing and Mechanical Codes' — i.e. the County's valuation-based Title 26 §107 table, doubled.
ordinance checked 2026-08-31 https://ecode360.com/44522986
Q17 Is there a separate plan-check fee? Fees
No — combined
Why the confidence is not higher§15.04.070 sets 'permit... and plan checking fees' together as a single two-times-county formula; the Comprehensive Fee Schedule does not list a separate stand-alone plan-check line for residential PV.
ordinance checked 2026-08-31 https://ecode360.com/44522986
Q18 What is the stated plan-review turnaround? Core Timeline & validity
3 business days
Why the confidence is not higherLVMC §18.106.060(A): for a small residential rooftop solar application meeting the approved checklist/standard plan, 'the building official shall issue a building permit or other non-discretionary permit within three business days.'
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q19 How long is an issued permit valid before it expires? Timeline & validity
180 days (default), no local amendment found
Why the confidence is not higherFull-text search of Title 15 (adopting chapter + fire chapter) found zero hits for 'expire'/'expiration' — no La Verne-specific permit-validity rule exists, so the generic adopted LA County/CBC §105.5 180-day default is inferred, not locally confirmed.
inference from absence in ordinance text checked 2026-08-31 https://ecode360.com/print/LA6633?guid=44522986
Q20 Which permit portal does this authority use? Core Portal & process
City's own 'Permit Portal' at laverne.geoviewer.io (internally titled 'Permitting App'), integrated with SolarAPP+ (gosolarapp.org) for plan review
Why the confidence is not higherNav link text 'Building Permit Portal'/'Permit Portal' on the Residential Solar page resolves to laverne.geoviewer.io, whose page title is 'Permitting App'.
authority's own page checked 2026-08-31 https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higherFull workflow described on the solar page: start permit on City portal, redirected to SolarAPP+ for design submittal and approval, return to City portal to link the approval and schedule inspections online — no in-person step is described for an eligible system.
authority's own page checked 2026-08-31 https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q22 Which utility handles interconnection here? Core Utility interconnection
Southern California Edison (SCE)
Why the confidence is not higherCity's own 2025 Urban Water Management Plan (Part 2, Ch. 3: City of La Verne, April 2026 public-review draft) states: 'The City works in coordination with MWD, TVMWD, Southern California Edison, and Southern California Gas Company...' No dedicated city energy-utility page was found; La Verne was checked against Clean Power Alliance's homepage member list (Claremont used as a positive control and found; La Verne absent) confirming La Verne has no CCA and remains on SCE bundled/NEM service, not PowerToChoose-sourced.
adopted city planning document (draft) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/4929
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedResidential Solar Building Permit page and City PV handout — neither states where SCE interconnection sits relative to permit issuance; SCE's own DG/interconnection pages soft-404 (checked live)
https://www.sce.com/business/generating-your-own-power/interconnections
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No formal HOA/architectural board approval required by the City; a Planning Department staff sign-off (stamp on site plan) is required before Building submittal, and HOA restrictions are separately preempted by the Solar Rights Act
Why the confidence is not higherLVMC §18.106.060(B) limits review to health/safety compliance only; City's PV handout item 1 requires 'Planning Department approval for the location of the equipment... stamp on the site plan' — a staff-level check, not a board/HOA hearing.
ordinance + department handout checked 2026-08-31 https://ecode360.com/44526020
Q25 Is there a historic-district review? Overlays & special cases
No dedicated historic-district/Certificate-of-Appropriateness ordinance was found that reaches rooftop PV
Why the confidence is not higherFull chapter-by-chapter listing of Title 18 (Zoning) contains no Historic Preservation/Landmark/Certificate-of-Appropriateness chapter (checked all 45 chapter headings). 'Historic, cultural and environmental resources' appear only as one of several general findings criteria for Precise Plan/Development Review approval (§18.16.100), with no PV-specific trigger, and small rooftop PV (Ch. 18.106) is routed around Precise Plan Review entirely for eligible systems. Positive control ('electrical', 10 hits) and fabricated control ('zzqqx', 0 hits) both passed on the same full-text extract.
zoning code (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/print/LA6633?guid=44524035
Q26 Is a wind or windstorm certification required? Overlays & special cases
Nothing published by this authority.
Where we lookedFull-text search of Title 15 and Title 18 for 'windstorm'/'wind load' — zero hits; this is a Texas-insurance-inspection concept largely absent from California building regulation, but no La Verne-specific statement either way was found
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Yes, but rare — CUP only if the Building Official finds a specific, adverse health/safety impact
Why the confidence is not higherLVMC §18.106.060(A): 'The building official may require an applicant to apply for a conditional use permit if the official finds, based on substantial evidence, that the solar energy system could have a specific, adverse impact upon the public health and safety,' appealable to the Planning Commission within 10 days.
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC / 30 kW thermal is a GATE, not a hard cap — it defines the 'small residential rooftop solar energy system' eligible for the 3-business-day ministerial path; larger, ground-mounted, multi-family, commercial, industrial and institutional systems are simply routed to Precise Plan Review (LVMC Ch. 18.16) instead of being forbidden
Why the confidence is not higherLVMC §18.106.020 definition and §18.106.030 applicability clause, read together.
ordinance checked 2026-08-31 https://ecode360.com/44526020
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC, embodied in the 2025 California Electrical Code (CEC), effective 1 Jan 2026 92% · ordinance
- Which building code edition is in force? 2025 California Building Code and 2025 California Residential Code, each via LA County Code Titles 26/30 (2026 County edition), effective 1 Jan 2026 92% · ordinance
- Which fire code edition is in force? 2025 California Fire Code (Title 24 Part 9, incorporating the 2024 IFC) plus Appendices 4, B, C, D, I; the 2025 California Wildland-Urban Interface Code is separately adopted 92% · ordinance
- Are there local amendments to any of the above? Yes 88% · ordinance
- What is the installation judged against? The 2025 CEC/CBC/CRC as adopted via LA County Code Titles 26/27/30, plus LVMC Ch. 18.106's health-and-safety-only review standard 85% · ordinance
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? No local ridge-setback or fire-access-pathway amendment found — reverts to the generic adopted 2025 CFC/CRC fire-pathway provisions 62% · ordinance (full-text search, control-proven)
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Not locally specified beyond the state code; the 2025 CEC (2023 NEC basis) applies, which requires rapid shutdown under NEC 690.12 statewide — no local La Verne amendment or restatement of 690.12 was found 55% · ordinance (full-text search, control-proven)
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Not locally specified — no City-published placard list beyond the state code default (CEC Art. 690/705 marking requirements) 58% · ordinance + handout (full-text search, control-proven)
- Does the authority specify placard wording of its own? No 62% · ordinance (full-text search, control-proven)
- Does it specify letter height, colour or material? No 62% · ordinance (full-text search, control-proven)
- Is a site plan / facility map placard required, and what must it show? A submittal site plan showing panel/equipment locations is required pre-permit (handout item 2), but no dedicated posted facility-map placard requirement beyond the state code's default was found 55% · department handout (dated 08/22)
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes 80% · department handout (dated 08/22)
- Are batteries permitted, and under what conditions? Not locally addressed — batteries/ESS would follow the adopted 2025 CFC by reference; La Verne has no local ESS ordinance or ESS-specific fee 58% · ordinance (full-text search, control-proven)
- Is there a separate ESS permit or inspection? No — no separate local ESS permit or fee line found 58% · fee schedule (full-text search, control-proven)
- Is a ground mount treated as a structure? Effectively yes — ground-mounted systems are excluded from the small-residential ministerial path and routed to Precise Plan Review (LVMC Ch. 18.16) alongside other structures, though no ordinance sentence explicitly labels a ground mount a 'structure' 68% · ordinance
- Is there a local rule on service upgrades or busbar sizing? No local rule found on service upgrades or busbar sizing 68% · ordinance (full-text search, control-proven)
- Is a specific mounting system or attachment spacing required? No specific attachment-spacing standard published; City's PV handout requires a dedicated inspection of the 'roof connection mounting assemblies' before module installation, and bars panels 'over any ventilation venting' 65% · department handout (dated 08/22)
20 questions answered against City of La Verne’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC, embodied in the 2025 California Electrical Code (CEC), effective 1 Jan 2026
Why the confidence is not higherLVMC §15.04.010(A) adopts 'the 2025 California Electrical Code (Title 27 Electrical Code of the Los Angeles County Code, 2026 Edition)... take effect on January 1, 2026'. The 2025 CEC is based on the 2023 NFPA NEC (no separate '2025 NEC' exists).
ordinance checked 2026-08-31 https://ecode360.com/44522986
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code and 2025 California Residential Code, each via LA County Code Titles 26/30 (2026 County edition), effective 1 Jan 2026
Why the confidence is not higherLVMC §15.04.010(A).
ordinance checked 2026-08-31 https://ecode360.com/44522986
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (Title 24 Part 9, incorporating the 2024 IFC) plus Appendices 4, B, C, D, I; the 2025 California Wildland-Urban Interface Code is separately adopted
Why the confidence is not higherLVMC §15.32.010 (self-adopted by the City, not by county reference) and §15.37.050.
ordinance checked 2026-08-31 https://ecode360.com/44523077
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherLVMC §15.04.030 substitutes local titles (e.g. 'Building official' = Community Development Director) throughout the adopted county codes; §15.37 (VHFHSZ) amends the WUI Code with a local §106.13 plan-submittal requirement and local roof/wall/underfloor construction standards for hillside areas.
ordinance checked 2026-08-31 https://ecode360.com/44522986
Q33 What is the installation judged against? Core Electrical
The 2025 CEC/CBC/CRC as adopted via LA County Code Titles 26/27/30, plus LVMC Ch. 18.106's health-and-safety-only review standard
Why the confidence is not higherLVMC §18.106.040(C): PV systems 'shall meet all applicable safety and performance standards established by the California Electrical Code, the Institute of Electrical and Electronics Engineers, and accredited testing laboratories such as Underwriters Laboratories.'
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No local rule found on service upgrades or busbar sizing
Why the confidence is not higherFull-text search of Title 15 for 'busbar', 'service upgrade', '200 amp', '225 amp', 'ampacity' returned zero hits; La Verne relies on the generic adopted CEC without a local electrical amendment chapter of its own.
ordinance (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/print/LA6633?guid=44522986
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
No specific attachment-spacing standard published; City's PV handout requires a dedicated inspection of the 'roof connection mounting assemblies' before module installation, and bars panels 'over any ventilation venting'
Why the confidence is not higherCity's PV instructions handout, item 6(b) and 6(d). No spacing/attachment table is given — the requirement defers to manufacturer's listed installation instructions (item 3).
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
No local ridge-setback or fire-access-pathway amendment found — reverts to the generic adopted 2025 CFC/CRC fire-pathway provisions
Why the confidence is not higherFull-text search of the entire Fire Code chapter (LVMC Ch. 15.32) and the whole of Title 15 for 'ridge' returned no PV-related hits (only unrelated 'bridge' matches). No local amendment analogous to Manhattan Beach's 18-inch ridge rule exists in La Verne's code.
ordinance (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/44523077
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Not locally specified beyond the state code; the 2025 CEC (2023 NEC basis) applies, which requires rapid shutdown under NEC 690.12 statewide — no local La Verne amendment or restatement of 690.12 was found
Why the confidence is not higherFull-text search of the entire adopted-codes chapter and Fire Code chapter for '690.12'/'rapid shutdown' returned zero hits — a control-proven absence of local elaboration, not evidence the state requirement doesn't apply.
ordinance (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/print/LA6633?guid=44522986
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Not locally specified — no City-published placard list beyond the state code default (CEC Art. 690/705 marking requirements)
Why the confidence is not higherFull-text search of the Fire Code chapter (Ch. 15.32), the whole of Title 15, and the City's 2022 PV instructions handout for 'placard' returned zero hits.
ordinance + handout (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/44523077
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No
Why the confidence is not higherSame control-proven absence as Q38 — no wording of its own is specified anywhere in the searched corpus.
ordinance (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/44523077
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
No
Why the confidence is not higherSame control-proven absence as Q38/Q39 — no letter-height, colour or material spec found.
ordinance (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/44523077
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
A submittal site plan showing panel/equipment locations is required pre-permit (handout item 2), but no dedicated posted facility-map placard requirement beyond the state code's default was found
Why the confidence is not higherCity's PV instructions handout item 2; no reference to a posted 705.10-style facility map placard anywhere in the searched Title 15/18 text or the handout.
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSCE's own DG interconnection and generating-your-own-power pages (soft-404 on live fetch) — per the known pattern of SCE pages returning content-free 404s, no utility-specific placard requirement was retrievable, and no other utility's document was substituted
https://www.sce.com/business/generating-your-own-power/interconnections
Q43 Where must the labels be placed? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedCity's 2022 PV instructions PDF and Title 15/18 full text — no city-specific label-placement rule found beyond the generic adopted CEC
Q44 Must equipment be on a specific approved list? Equipment listing
Yes
Why the confidence is not higherCity's PV instructions handout item 3: submittal must 'attach all manufacturer's specification sheets, installation instructions, and listings.'
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Not locally addressed — batteries/ESS would follow the adopted 2025 CFC by reference; La Verne has no local ESS ordinance or ESS-specific fee
Why the confidence is not higherFull-text search of the entire Fire Code chapter and Title 15 for 'battery'/'energy storage' returned zero hits (positive control 'electrical' = 1 hit passed on the same extract).
ordinance (full-text search, control-proven) checked 2026-08-31 https://ecode360.com/44523077
Q46 Is there a separate ESS permit or inspection? Battery / ESS
No — no separate local ESS permit or fee line found
Why the confidence is not higherSame control-proven absence as Q45; the FY2026-27 Comprehensive Fee Schedule also has zero hits for 'battery'/'energy storage' across all 41 pages.
fee schedule (full-text search, control-proven) checked 2026-08-31 https://www.laverneca.gov/DocumentCenter/View/3611
Q47 Is a ground mount treated as a structure? Core Ground mount
Effectively yes — ground-mounted systems are excluded from the small-residential ministerial path and routed to Precise Plan Review (LVMC Ch. 18.16) alongside other structures, though no ordinance sentence explicitly labels a ground mount a 'structure'
Why the confidence is not higherLVMC §18.106.030: 'All other, non-small residential rooftop solar energy systems, including ground-mounted... systems, shall be subject to the precise plan review process as stated in Chapter 18.16.' No dedicated ground-mount setback/height chapter (comparable to San Dimas's SDMC §18.168.070(D)) was found in Title 18 — searched 'ground-mount'/'ground mounted', all 8 hits were about antennas, not solar.
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedCity's 2022 PV instructions PDF and Regulatory Permits page — no AC-disconnect-to-meter distance/location rule found; SCE's own interconnection pages soft-404 on live fetch, so no utility-side figure was substituted from another utility's manual
https://www.sce.com/business/generating-your-own-power/interconnections
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal or Phone 85% · authority's own page
- Are same-day or AM/PM windows offered? No AM/PM window info published; inspections are only available Monday–Thursday, City Hall/Building Dept observes a 4-day work week and is closed Fridays 70% · authority's own page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? CONFLICTING SOURCES, both reported: (1) current codified LVMC §18.106.060(F) says 'Only one inspection shall be required' for expedited-eligible systems; (2) the City's 2022-dated PV instructions handout (citing 2019 CBC/CEC) separately requires 'Inspection required for roof connection mounting assemblies prior to installation of solar module' as its own listed inspection stage. These do not obviously reconcile — the handout may predate or sit outside the 2015-enacted single-inspection ordinance, or 'one inspection' may mean one FINAL inspection with the mounting check folded into it. 60% · ordinance vs. department handout (conflict)
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Partial — a dated (2022) PV plan-note/instructions sheet exists that doubles as an inspection-requirements notice; no distinct, current, stand-alone 'solar final inspection checklist' was found 55% · department handout (dated 08/22)
- What must be on site at inspection? Roof access (contractor must provide a ladder for the inspector) and the approved plans/permit 62% · department handout (dated 08/22)
- Does the inspector verify labels and listings? Likely yes, inferred 55% · department handout (dated 08/22), inference
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- How are corrections issued and cleared? For an incomplete APPLICATION (pre-permit), LVMC §18.106.060(E) requires 'a written correction notice detailing all deficiencies... provided to the applicant for resubmission.' No separate field-inspection correction/red-tag process specific to PV was found; §18.106.060(G) allows a subsequent inspection after a failed inspection without further specified process. 58% · ordinance
14 questions answered against City of La Verne’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal or Phone
Why the confidence is not higherSolar page: 'View solar application and schedule inspections online or contact us at 909-596-8706 to schedule.'
authority's own page checked 2026-08-31 https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedResidential Solar Building Permit page — states how to book (portal/phone) but not a minimum notice period in business days
https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
No AM/PM window info published; inspections are only available Monday–Thursday, City Hall/Building Dept observes a 4-day work week and is closed Fridays
Why the confidence is not higherSolar page: 'Inspections are available Monday-Thursday, closed every Friday.' City Hall hours confirmed elsewhere as Mon–Thu 7:30am–5:30pm.
authority's own page checked 2026-08-31 https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherLVMC §18.106.060(F): 'Only one inspection shall be required and performed by the building department for small residential rooftop solar energy systems eligible for expedited review' — near-identical wording to Claremont's CMC §15.50.060.E, confirming self-performance rather than delegation to LACoFD or a contract inspector.
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q53 If delegated, to whom? Core Who inspects
N/A — not delegated; performed by the City's own Building & Safety Division
Why the confidence is not higherSame as Q52.
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q54 Which inspections are required, and in what order? Core Stages & sequence
CONFLICTING SOURCES, both reported: (1) current codified LVMC §18.106.060(F) says 'Only one inspection shall be required' for expedited-eligible systems; (2) the City's 2022-dated PV instructions handout (citing 2019 CBC/CEC) separately requires 'Inspection required for roof connection mounting assemblies prior to installation of solar module' as its own listed inspection stage. These do not obviously reconcile — the handout may predate or sit outside the 2015-enacted single-inspection ordinance, or 'one inspection' may mean one FINAL inspection with the mounting check folded into it.
Why the confidence is not higherDirect text comparison of the two City sources; flagging as a conflict rather than resolving it, per the code-cycle-lag pattern seen elsewhere (handout still cites 2019 codes while the City's adoption ordinance is on the 2025 cycle effective 1/1/2026).
ordinance vs. department handout (conflict) checked 2026-08-31 https://ecode360.com/44526020
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedLVMC §18.106.060(F) (one inspection for expedited path) vs. City's 2022 PV handout (a distinct roof-mounting-assembly inspection stage) — see Q54 conflict; whether this constitutes a formal separate 'rough-in/mid-roof' inspection under the current ordinance could not be resolved from available documents
Q56 Does the inspector verify labels and listings? Core What is checked
Likely yes, inferred
Why the confidence is not higherSubmittal requires 'manufacturer's specification sheets, installation instructions, and listings' (handout item 3) and 690.4/CEC listing compliance (§18.106.040(C)), but no document explicitly states the field inspector checks labels/listings at inspection.
department handout (dated 08/22), inference checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q57 Is there a published inspection checklist? Core What is checked
Partial — a dated (2022) PV plan-note/instructions sheet exists that doubles as an inspection-requirements notice; no distinct, current, stand-alone 'solar final inspection checklist' was found
Why the confidence is not higherSee doc 1232 content: it lists required plan notes and one inspection stage but is framed as submittal instructions, not a checklist to be used at the inspection itself.
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q58 What must be on site at inspection? Core Documents on site
Roof access (contractor must provide a ladder for the inspector) and the approved plans/permit
Why the confidence is not higherHandout item 6(c): 'Contractor to provide ladder for access for inspection roof-mounted system. Note that crack or broken roof tiles will cause failed final inspection.'
department handout (dated 08/22) checked 2026-08-31 https://www.laverneca.gov/documentcenter/view/1232
Q59 Is there a re-inspection fee? Corrections & re-inspection
Nothing published by this authority.
Where we lookedFY2026-27 Comprehensive Fee Schedule (41 pages, full text searched for 're-inspection'/'reinspection') — hits exist only for Public-Works right-of-way work and the annual Fire operational-permit program, none scoped to Building & Safety residential PV re-inspection
Q60 How are corrections issued and cleared? Corrections & re-inspection
For an incomplete APPLICATION (pre-permit), LVMC §18.106.060(E) requires 'a written correction notice detailing all deficiencies... provided to the applicant for resubmission.' No separate field-inspection correction/red-tag process specific to PV was found; §18.106.060(G) allows a subsequent inspection after a failed inspection without further specified process.
Why the confidence is not higher§18.106.060(E) and (G) — the ordinance conflates application-completeness corrections with post-inspection re-inspection in one short subsection.
ordinance checked 2026-08-31 https://ecode360.com/44526020
Q61 What is issued on pass? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedResidential Solar Building Permit page, City PV handout, and LVMC Ch. 18.106 — none names the specific document/tag issued on a passed final inspection (CO / Final / Green tag / Letter)
https://www.laverneca.gov/557/Residential-Solar-Building-Permit
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedResidential Solar Building Permit page and City PV handout — neither states who notifies SCE for Permission to Operate; SCE's own interconnection pages soft-404 on live fetch
https://www.sce.com/business/generating-your-own-power/interconnections
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of La Verne against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of La Verne is the authority having jurisdiction 92% confidence
- Holds
- Building and Electrical (self-performed by the Community Development Department's Building & Safety Division); Fire is also self-performed by the City's own La Verne Fire Department, not delegated to LACoFD
- Overridden by
- State law only — CA Solar Rights Act (Civil Code §714/§4600) preempts HOA restrictions; Gov. Code §65850.52/§65850.5 and AB 130 (Gov. Code / H&SC freeze on more-restrictive residential amendments, 1 Oct 2025–1 Jun 2031) bound the City's own Ch. 18.106 ordinance. LA County has no jurisdiction inside the incorporated City — La Verne is not unincorporated territory.
- Why not higher
- LVMC §15.04.030 defines 'Building official' as the City's own Community Development Director (not a county or contract-firm title); LVMC Ch. 18.106 vests permit review and issuance in the City's 'building department'/'building official'; the City's own Fire Department site (lavernefire.org/overview) states 'The City of La Verne maintains its own fire protection services, operated from three fire stations' with mutual-aid (not contract) agreements to LACoFD and USFS. No delegation to a plan-check firm (Willdan/Transtech/CSG/etc.) or to LA County was found in any document.
- Permit required
- Yes95%
- Permit cost
- No flat fee published for residential PV building/electrical permits — valuation-based per LVMC §15.04.070 ('two times the prevailing Los Angeles County fee...70%
- Plan review
- 3 business days90%
- Portal
- City's own 'Permit Portal' at laverne.geoviewer.io (internally titled 'Permitting App'), integrated with SolarAPP+ (gosolarapp.org) for plan review85%
- Electrical code
- 2023 NEC, embodied in the 2025 California Electrical Code (CEC), effective 1 Jan 202692%
- Own placard wording
- No62%
- Booking an inspection
- Portal or Phone85%
Labels & placards for this authority
Wording 62%
No
Size, colour & material 62%
No
Where they go None%
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
