City of Manteca

San Joaquin County

Verified Aug. 5, 2026

City of Manteca is a busy jurisdiction for residential solar — 23rd in California by installs on record — 83,498 residents, with 14,656 residential solar installs on record. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 5 business days (first submittal), 5 business days (subsequent submittal) Q18 Where you file — Symbium (instant/automated permitting for eligible residential rooftop solar & battery storage); Q20

Permit required
Yes95% source
What it costs
$409 flat95% source
Plan review turnaround
5 business days (first submittal), 5 business days (subsequent submittal)92% source
Key document
published checklist cited by 9 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 92% · ordinance
    • What does this authority permit itself, and what does it delegate? Both 90% · ordinance
    • Is a permit required for a residential rooftop PV system? Yes 95% · ordinance
    • Is there a separate electrical permit, or is it combined? Combined 80% · published checklist
    • Is a HOA or architectural approval required first? No 78% · ordinance
    • Is there a historic-district review? No 78% · municipal code (full-text search)
    • Is a wind or windstorm certification required? No 65% · department page
    • Is a Specific Use Permit or Council approval ever required? Not required for a compliant small residential rooftop system, which is approved administratively under Ch 15.60; no solar-specific Council/SUP approval requirement was found in Title 17 Zoning or Ch 15.60. 55% · ordinance
    • Is there a system-size cap on residential generation? 10 kW AC nameplate (or 30 kW thermal) is the cap for a system to qualify as a 'small residential rooftop solar energy system' eligible for the city's expedited/administrative permit process; this is an eligibility threshold for expedited review, not an absolute ceiling on residential system size. 85% · ordinance
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Building permit application + Owner/Builder form (if applicable); manufacturer spec sheets, installation instructions, and UL listings; site plan + roof plan showing PV equipment/arrays and fire setbacks/egress; partial roof framing plan; equipment-to-roof connection/flashing details; structural (gravity + lateral) calculations or a qualifying alternate; electrical drawings incl. single-line diagram, inverter/module/array data, wiring & OCPD sizing, system labels/warnings, grounding, disconnects, and rapid-shutdown method; plans signed/stamped by a CA-licensed engineer or A/B/C-46/C-10 contractor. 78% · published checklist
    • How many copies, and in what format? Three sets of plans, minimum 11"x17" 78% · published checklist
    • Is a site plan required, and what must it show? Yes — must show location/dimensions of all PV equipment and arrays, plus fire setbacks and emergency egress pathways per CEC 690 and city amendments; a roof plan is required projected onto the site plan. 80% · published checklist
    • Is a one-line / three-line diagram required? Yes 85% · published checklist
    • Are string and conductor calculations required? Yes 85% · published checklist
    • Is a structural PE stamp required, and at what threshold? Required unless the installation qualifies for a prescriptive exemption: PE/architect gravity calcs are waived only if arrays are supported at ≤4 ft spacing and impose <5 psf; PE/architect lateral calcs are waived only if the system is shown to be <5 psf. Otherwise a licensed PE or architect must stamp both. 80% · published checklist
    • Is an electrical PE stamp required, and at what threshold? No separate electrical PE stamp threshold found — the checklist accepts a signature/license number from a CA-licensed engineer OR an A/B/C-46/C-10 licensed contractor on every sheet; there is no electrical-specific PE trigger distinct from the structural one in Q13. 65% · published checklist
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

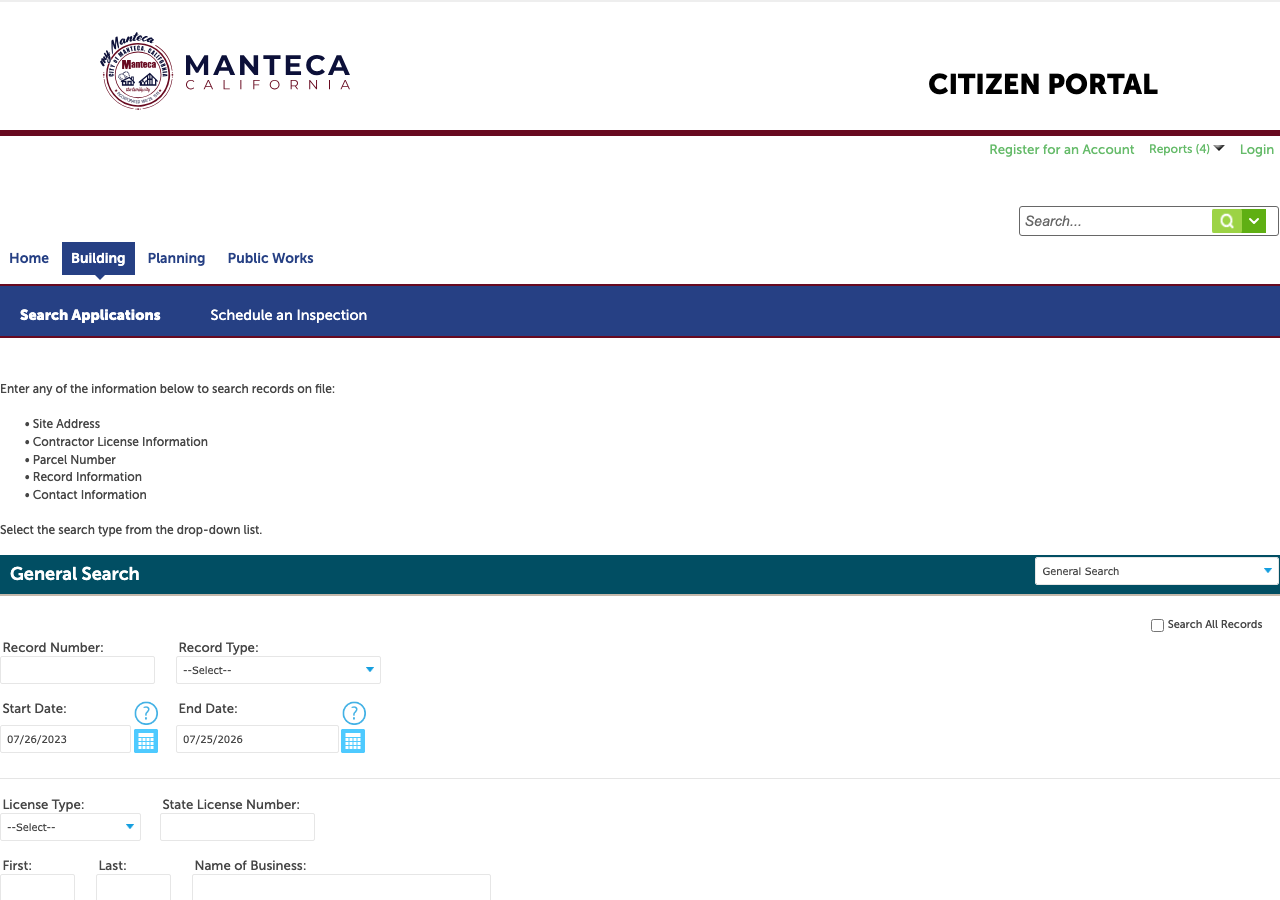

    • Which permit portal does this authority use? Symbium (instant/automated permitting for eligible residential rooftop solar & battery storage); Citizen Access / Accela ('aca-prod.accela.com/MANTECA') for all other permits, revisions, and inspection scheduling 92% · portal landing page
    • Can the whole application be completed online? Yes 88% · portal landing page
    • What does a residential solar permit cost? $409 flat 95% · fee schedule
    • How is the fee calculated? Flat 95% · fee schedule
    • Is there a separate plan-check fee? No 78% · fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? 5 business days (first submittal), 5 business days (subsequent submittal) 92% · department page
    • How long is an issued permit valid before it expires? An issued permit is valid 12 months from issuance unless work is suspended/abandoned for 180 days without a substantial inspection approval; the building official may grant written extensions of up to 180 days each. (Separately, an application itself expires 180 days after filing if no permit is issued, extendable 90 days on written request.) 92% · ordinance
    • Which utility handles interconnection here? PG&E (Pacific Gas & Electric) 70% · city department page
    • Where does the utility sit in the sequence? After permit 90% · ordinance

28 questions answered against City of Manteca’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherCity's own Ch. 15.60 ordinance and Building Safety Division directly administer residential solar permitting.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherCity adopts and enforces both the 2025 CBC/CRC and 2025 CEC itself (Ord. O2025-18) and issues both building and electrical permits through its own Building Safety Division; nothing is delegated to the county.

ordinance checked 2026-08-30 https://ecode360.com/44089437

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherCh 15.60.030 Applicability: 'This chapter applies to the permitting of all small residential rooftop solar energy systems in the city,' and the Development Fee Schedule lists a residential rooftop solar permit fee.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherThe solar submittal checklist calls for 'one building permit application' covering the electrical scope; Ch 15.60.060 refers throughout to a single 'permit application,' not separate building/electrical applications.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherSubmittal checklist requires plans signed by a CA-licensed engineer or a contractor holding an A, B, C-46, or C-10 classification, OR the general permit application allows an Owner-Builder declaration in lieu of a licensed contractor.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

No

Why the confidence is not higherNo city-specific pre-registration requirement for contractors was found on the permit application, agent-authorization form, or Ch 15.60; state CSLB licensure is referenced but not a separate city registration step. Absence not exhaustively proven — a business-license/registration step could exist outside the documents reviewed.

permit application checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1193/Building-Permit-Issuance-Application-PDF

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherThe standard Building Permit Issuance Application includes a full Owner-Builder Declaration section (B&P Code §7044/§7031.5) alongside the licensed-contractor declaration.

permit application checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1193/Building-Permit-Issuance-Application-PDF

Q8 What documents make up a complete submittal? Core Submittal package

Building permit application + Owner/Builder form (if applicable); manufacturer spec sheets, installation instructions, and UL listings; site plan + roof plan showing PV equipment/arrays and fire setbacks/egress; partial roof framing plan; equipment-to-roof connection/flashing details; structural (gravity + lateral) calculations or a qualifying alternate; electrical drawings incl. single-line diagram, inverter/module/array data, wiring & OCPD sizing, system labels/warnings, grounding, disconnects, and rapid-shutdown method; plans signed/stamped by a CA-licensed engineer or A/B/C-46/C-10 contractor.

Why the confidence is not higherSourced from the city's own 'Solar (Photovoltaic) System - Residential' submittal checklist, which is the operative document Ch 15.60.050(D) requires the city to publish, but the PDF's embedded creation/modification metadata is dated 2017 — it may not reflect the current 2025 code cycle in every detail even though it remains the live linked document today.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q9 How many copies, and in what format? Submittal package

Three sets of plans, minimum 11"x17"

Why the confidence is not higherStated in the submittal checklist's 'Administrative' section; same 2017-metadata caveat as Q8 applies.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes — must show location/dimensions of all PV equipment and arrays, plus fire setbacks and emergency egress pathways per CEC 690 and city amendments; a roof plan is required projected onto the site plan.

Why the confidence is not higherDirectly stated in the submittal checklist 'Drawings' section.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes

Why the confidence is not higherChecklist requires a 'Single Line Diagram: show array configuration, conduit and conductors, sizes with derating calculations.'

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q12 Are string and conductor calculations required? Drawings & calculations

Yes

Why the confidence is not higherChecklist requires conductor ampacities with derating, OCPD ratings/locations, and array/module series-parallel configuration data.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Required unless the installation qualifies for a prescriptive exemption: PE/architect gravity calcs are waived only if arrays are supported at ≤4 ft spacing and impose <5 psf; PE/architect lateral calcs are waived only if the system is shown to be <5 psf. Otherwise a licensed PE or architect must stamp both.

Why the confidence is not higherDirectly stated with numeric thresholds in the submittal checklist's 'Drawings' section.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

No separate electrical PE stamp threshold found — the checklist accepts a signature/license number from a CA-licensed engineer OR an A/B/C-46/C-10 licensed contractor on every sheet; there is no electrical-specific PE trigger distinct from the structural one in Q13.

Why the confidence is not higherInferred from the checklist's single combined signature requirement; no separate electrical PE clause was found.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q15 What does a residential solar permit cost? Core Fees

$409 flat

Why the confidence is not higher'Solar Photovoltaic - Residential (Rooftop)' line item, current published fee schedule effective 8/15/2026.

fee schedule checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/2782/Development-Fee-Schedule-8-15-2026-PDF

Q16 How is the fee calculated? Core Fees

Flat

Why the confidence is not higherFee schedule lists it as 'Per app' at a fixed dollar amount, not tied to valuation, kW, or panel count (unlike the commercial PV tier which is per-kW).

fee schedule checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/2782/Development-Fee-Schedule-8-15-2026-PDF

Q17 Is there a separate plan-check fee? Fees

No

Why the confidence is not higherThe residential solar line is a single flat 'per app' fee; separate plan-review-fee lines in the schedule only appear for the percent-of-valuation categories (new construction, remodels), not for the flat-fee residential items including solar.

fee schedule checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/2782/Development-Fee-Schedule-8-15-2026-PDF

Q18 What is the stated plan-review turnaround? Core Timeline & validity

5 business days (first submittal), 5 business days (subsequent submittal)

Why the confidence is not higherListed explicitly by project type on the city's 'Expected Plan Review Times' page, which lines up 'Solar Photovoltaic' under the Residential column.

department page checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1213/Expected-Plan-Review-Times-PDF

Q19 How long is an issued permit valid before it expires? Timeline & validity

An issued permit is valid 12 months from issuance unless work is suspended/abandoned for 180 days without a substantial inspection approval; the building official may grant written extensions of up to 180 days each. (Separately, an application itself expires 180 days after filing if no permit is issued, extendable 90 days on written request.)

Why the confidence is not higherCity's own amendment to CBC §105.5, adopted by Ord. O2025-18 (11/4/2025), read directly from the code — not a summary.

ordinance checked 2026-08-30 https://ecode360.com/44089437

Q20 Which permit portal does this authority use? Core Portal & process

Symbium (instant/automated permitting for eligible residential rooftop solar & battery storage); Citizen Access / Accela ('aca-prod.accela.com/MANTECA') for all other permits, revisions, and inspection scheduling

Why the confidence is not higherBoth portals are named and linked directly from the city's own Building Permits and 'Instant Residential Solar & Energy Storage System Permits' pages.

portal landing page checked 2026-08-30 https://www.manteca.gov/230/Instant-Residential-Solar-Energy-Storage

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherCity page states Symbium 'automatically checks for code compliance and issues permits in real time' for eligible rooftop solar/battery projects — address entry, questionnaire, compliance check, fee payment, and permit issuance all occur online.

portal landing page checked 2026-08-30 https://www.manteca.gov/230/Instant-Residential-Solar-Energy-Storage

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas & Electric)

Why the confidence is not higherThe city's own Utilities Department and Utility Information pages confirm the city provides only water, sewer, and storm drainage — no municipal electric utility exists — which is consistent with San Joaquin County/Manteca being PG&E territory. Could not independently pull a PG&E-side territory-map confirmation this session (WebSearch budget was exhausted), so this is inference from a proven absence rather than a direct utility-side citation.

city department page checked 2026-08-30 https://www.manteca.gov/415/Utilities-Department

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit

Why the confidence is not higherCh 15.60.060(D): city approval/permit issuance 'does not authorize an applicant to connect... to the local utility provider's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility provider after requesting and obtaining a final inspection.'

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No

Why the confidence is not higherNot listed as a submittal requirement in Ch 15.60 or the solar checklist; consistent with CA Civil Code §714/714.1 (Solar Rights Act) limiting HOA authority to block solar. Absence checked directly in the ordinance and checklist, not assumed.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q25 Is there a historic-district review? Overlays & special cases

No

Why the confidence is not higherFull-code search of Manteca's municipal code (positive control 'battery' returned results; fabricated control 'zzqqx' returned none, confirming the search index works) found no designated historic-preservation overlay zoning district — only generic 'historic structure' definitions tied to floodplain/post-disaster provisions, none of which impose a solar-specific design review.

municipal code (full-text search) checked 2026-08-30 https://ecode360.com/MA4966/search?query=historic+district&scope=all&sortOrder=relevance

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherNo wind/windstorm certification process (of the Texas-Gulf-Coast TDI type) found in the ordinance, checklist, or fee schedule; the Building Safety page cites a 100 mph basic wind speed design criterion handled through ordinary structural review, not a separate certification program.

department page checked 2026-08-30 https://www.manteca.gov/225/Building-Safety

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Not required for a compliant small residential rooftop system, which is approved administratively under Ch 15.60; no solar-specific Council/SUP approval requirement was found in Title 17 Zoning or Ch 15.60.

Why the confidence is not higherInference from the administrative-approval structure of Ch 15.60.060(D); did not exhaustively review every Title 17 discretionary-entitlement trigger (e.g., for oversized or non-conforming installations).

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q28 Is there a system-size cap on residential generation? Overlays & special cases

10 kW AC nameplate (or 30 kW thermal) is the cap for a system to qualify as a 'small residential rooftop solar energy system' eligible for the city's expedited/administrative permit process; this is an eligibility threshold for expedited review, not an absolute ceiling on residential system size.

Why the confidence is not higherDefined explicitly in Ch 15.60.010.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2023 92% · adopting ordinance
    • Which building code edition is in force? 2025 California Building Code (Title 24, Part 2) 95% · adopting ordinance
    • Which fire code edition is in force? 2025 California Fire Code, incorporating the 2021 International Fire Code 95% · adopting ordinance
    • Are there local amendments to any of the above? Yes 95% · ordinance
    • What is the installation judged against? The 2025 CRC/CBC/CEC as locally amended, plus CEC Article 690 (solar-specific electrical requirements) and Ch 15.60's own permit/inspection conditions. 85% · ordinance
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? CRC Appendix R324.7 series as locally amended: roof access points avoiding ground-ladder conflicts (R324.7.1); hip-roof layouts need one 3-ft clear pathway eave-to-ridge per slope (R324.7.2.2); single-ridge roofs need two 3-ft pathways (R324.7.2.3); panels must be ≥18 in. from a hip/valley when placed on both sides (R324.7.2.4); panels must stay ≥3 ft below the ridge for smoke-ventilation (R324.7.2.5); and a city-amended emergency-egress rule (R324.7.2.8) requiring a straight, ≥3-ft-wide firefighter-capable pathway from any emergency escape/egress opening, which also applies around roof chimneys/HVAC equipment. 75% · published checklist
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Yes, rapid shutdown is required per CEC 690.12, under the 2025 CEC (2023 NEC base). 82% · published checklist
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? Required signage/warning labels per CEC Article 690 (system labels and warnings at service equipment); no additional city-specific placard beyond the adopted electrical code was found. 60% · published checklist
    • Does the authority specify placard wording of its own? No 60% · ordinance
    • Does it specify letter height, colour or material? No 55% · published checklist
    • Is a site plan / facility map placard required, and what must it show? A site plan/roof plan showing the location and dimensions of all PV equipment and arrays is required as part of the permit submittal (see Q10); this satisfies NEC/CEC 705.10-type directory/placard intent but flows from the adopted CEC rather than a distinct city-authored facility-map placard spec. 65% · published checklist
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Must equipment be on a specific approved list? No dedicated city-approved-equipment list; the checklist requires UL listings on all equipment cut sheets generically (PV modules, inverter, combiner box, disconnects, rapid shutdown, racking) rather than referencing a specific approved-products list. 68% · published checklist
    • Are batteries permitted, and under what conditions? Yes — batteries/ESS are permitted; the fee schedule carries a dedicated residential 'ESS' (Energy Storage System) flat fee ($329/app), and the city's Symbium instant-permit portal explicitly lists 'Battery Storage' as an eligible project type alongside rooftop solar. 88% · fee schedule
    • Is there a separate ESS permit or inspection? Yes — ESS has its own distinct fee line item ('Energy Storage System,' $329/app) separate from the residential solar PV line ($409/app), indicating a separate permit/application track. 78% · fee schedule
    • Is a ground mount treated as a structure? Not directly addressed for solar specifically — Ch 15.60's expedited process applies only to ROOFTOP systems (defined in §15.60.010), so a ground-mounted array falls outside that chapter and would default to standard accessory-structure review under Title 17 Ch 17.40, likely making it subject to standard setback/height rules as a structure. 60% · municipal code (full-text search)
    • Is there a local rule on service upgrades or busbar sizing? No numeric city-specific busbar/service-upgrade rule found; the checklist requires the applicant, at their own cost, to verify (using standard electrical inspection techniques) that the existing service — line, load, ground/bonding wiring, and main/subpanel sizing — is adequately sized to carry the new PV electrical load. 65% · ordinance
    • Is a specific mounting system or attachment spacing required? No fixed mandated spacing, but the structural-calculation exemption in the checklist implies a prescriptive ceiling of 4 ft maximum support spacing (and <5 psf loading) to avoid requiring PE-stamped calcs. 70% · published checklist

20 questions answered against City of Manteca’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2023

Why the confidence is not higherCity adopted the '2025 California Electrical Code, California Code of Regulations, Title 24, Part 3... as published by BNi Publications' via Ord. O2025-18 (11/4/2025); the 2025 CEC cycle is based on the 2023 NEC.

adopting ordinance checked 2026-08-30 https://ecode360.com/44089517

Q30 Which building code edition is in force? Core Code editions in force

2025 California Building Code (Title 24, Part 2)

Why the confidence is not higherAdopted directly by the city, most recently amended by Ord. O2025-18, 11/4/2025.

adopting ordinance checked 2026-08-30 https://ecode360.com/44089437

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code, incorporating the 2021 International Fire Code

Why the confidence is not higherCh 15.24.010 Adoption, adopted by Ord. O2025-20, 12/16/2025, which also repealed the prior fire-code ordinances (O2019-15, O2023-03).

adopting ordinance checked 2026-08-30 https://ecode360.com/44089565

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherExtensive local amendments exist across every adopted code: Building (§§15.04.035–.150), Electrical (§§15.20.020–.100), Fire (§15.24.040), Residential (§§15.10.040–.050).

ordinance checked 2026-08-30 https://ecode360.com/44089437

Q33 What is the installation judged against? Core Electrical

The 2025 CRC/CBC/CEC as locally amended, plus CEC Article 690 (solar-specific electrical requirements) and Ch 15.60's own permit/inspection conditions.

Why the confidence is not higherSynthesized directly from the adoption sections of Ch 15.04, 15.10, 15.20 and the solar checklist's repeated references to 'CEC 690' and 'as amended by the City of Manteca.'

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

No numeric city-specific busbar/service-upgrade rule found; the checklist requires the applicant, at their own cost, to verify (using standard electrical inspection techniques) that the existing service — line, load, ground/bonding wiring, and main/subpanel sizing — is adequately sized to carry the new PV electrical load.

Why the confidence is not higherDirectly stated in Ch 15.60.060(A)(2), but this is a verification duty, not a distinct numeric busbar-sizing rule (e.g., no local 120%/100% rule beyond standard NEC 705.12 practice was found).

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

No fixed mandated spacing, but the structural-calculation exemption in the checklist implies a prescriptive ceiling of 4 ft maximum support spacing (and <5 psf loading) to avoid requiring PE-stamped calcs.

Why the confidence is not higherSame source as Q13; framed there as a calculation exemption rather than an affirmative mounting-spec.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

CRC Appendix R324.7 series as locally amended: roof access points avoiding ground-ladder conflicts (R324.7.1); hip-roof layouts need one 3-ft clear pathway eave-to-ridge per slope (R324.7.2.2); single-ridge roofs need two 3-ft pathways (R324.7.2.3); panels must be ≥18 in. from a hip/valley when placed on both sides (R324.7.2.4); panels must stay ≥3 ft below the ridge for smoke-ventilation (R324.7.2.5); and a city-amended emergency-egress rule (R324.7.2.8) requiring a straight, ≥3-ft-wide firefighter-capable pathway from any emergency escape/egress opening, which also applies around roof chimneys/HVAC equipment.

Why the confidence is not higherRead directly from the city's own submittal checklist including the 'Amended' local-amendment flag on R324.7.2.8, but the PDF's embedded metadata dates to 2017, so it may not have been refreshed for the current 2025 code cycle even though it is still the live linked document.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Yes, rapid shutdown is required per CEC 690.12, under the 2025 CEC (2023 NEC base).

Why the confidence is not higherChecklist explicitly requires drawings to 'show method utilized to comply with CEC 690.12 for rapid shutdown'; edition confirmed via Ch 15.20 adoption.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

Required signage/warning labels per CEC Article 690 (system labels and warnings at service equipment); no additional city-specific placard beyond the adopted electrical code was found.

Why the confidence is not higherChecklist item just says 'show required signage on the plans per CEC Article 690' without listing distinct city placards.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

No

Why the confidence is not higherNo city-authored placard wording was found in Ch 15.60, the checklist, or the electrical code amendments (§§15.20.020–.100); the checklist defers to CEC Article 690's own labeling language.

ordinance checked 2026-08-30 https://ecode360.com/44089517

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

No

Why the confidence is not higherNo letter-height/color/material spec found in any city solar document reviewed; this is a genuine gap in the published materials rather than a confirmed 'not required.'

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

A site plan/roof plan showing the location and dimensions of all PV equipment and arrays is required as part of the permit submittal (see Q10); this satisfies NEC/CEC 705.10-type directory/placard intent but flows from the adopted CEC rather than a distinct city-authored facility-map placard spec.

Why the confidence is not higherDirectly required by the checklist's Drawings section; no separate 'facility map placard' document distinct from the submitted site plan was found.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedCh 15.60 ordinance, solar submittal checklist, Development Fee Schedule PDF — none reference PG&E's own Rule 21/DG interconnection handbook placard requirements; PG&E's interconnection manual itself was not consulted this session

https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q43 Where must the labels be placed? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSolar submittal checklist and Ch 15.60 ordinance — disconnect locations are described relative to the inverter/roof plan, but no distinct 'where must labels be placed' spec beyond CEC Article 690 signage location rules was found

https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q44 Must equipment be on a specific approved list? Equipment listing

No dedicated city-approved-equipment list; the checklist requires UL listings on all equipment cut sheets generically (PV modules, inverter, combiner box, disconnects, rapid shutdown, racking) rather than referencing a specific approved-products list.

Why the confidence is not higherChecklist requires 'U.L. listings' attached to plans but does not reference a city equipment list.

published checklist checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/1230/Residential-Solar-Photovoltaic-System-PDF

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Yes — batteries/ESS are permitted; the fee schedule carries a dedicated residential 'ESS' (Energy Storage System) flat fee ($329/app), and the city's Symbium instant-permit portal explicitly lists 'Battery Storage' as an eligible project type alongside rooftop solar.

Why the confidence is not higherBoth the fee schedule and the Instant Residential Solar & Energy Storage page independently confirm batteries are a permitted, actively processed category.

fee schedule checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/2782/Development-Fee-Schedule-8-15-2026-PDF

Q46 Is there a separate ESS permit or inspection? Battery / ESS

Yes — ESS has its own distinct fee line item ('Energy Storage System,' $329/app) separate from the residential solar PV line ($409/app), indicating a separate permit/application track.

Why the confidence is not higherInferred from the fee schedule listing them as separate SKUs; did not find explicit ordinance text describing a standalone ESS inspection sequence.

fee schedule checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/2782/Development-Fee-Schedule-8-15-2026-PDF

Q47 Is a ground mount treated as a structure? Core Ground mount

Not directly addressed for solar specifically — Ch 15.60's expedited process applies only to ROOFTOP systems (defined in §15.60.010), so a ground-mounted array falls outside that chapter and would default to standard accessory-structure review under Title 17 Ch 17.40, likely making it subject to standard setback/height rules as a structure.

Why the confidence is not higherInference: no explicit code section stating 'ground-mounted solar = accessory structure' was found despite a full-code search for 'ground mounted solar.'

municipal code (full-text search) checked 2026-08-30 https://ecode360.com/MA4966/search?query=ground+mounted+solar&scope=all&sortOrder=relevance

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedCh 15.60 ordinance, solar submittal checklist, Development Fee Schedule PDF — AC-disconnect-to-meter placement is governed by PG&E's own DG interconnection/Greenbook rules, which were not consulted this session (WebSearch budget was exhausted before this could be retrieved)

https://ecode360.com/44089942

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 88% · ordinance
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? For a system eligible for expedited review, only one (final) inspection is required. 82% · ordinance
    • Is a rough-in or mid-roof inspection required? No 82% · ordinance
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • What must be on site at inspection? Approved plans and all permit documents must be printed and physically available on-site; the inspector cannot complete the inspection without them. 85% · department page
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final (final inspection approval/'final approval on the inspection record') 65% · ordinance
    • Who notifies the utility for PTO? Installer 88% · ordinance
    • Is there a re-inspection fee? $128 per unit 92% · fee schedule
    • How are corrections issued and cleared? For an incomplete application: the building official issues a written correction notice detailing deficiencies. For a failed inspection: a subsequent inspection is authorized (it need not follow the one-inspection expedited rule), and every re-inspection after the first is charged 'a reasonable inspection fee... in accordance with the currently adopted fee schedule' ($128, per Q59). 85% · ordinance

14 questions answered against City of Manteca’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Portal

Why the confidence is not higherCity states plainly: 'All inspections must be scheduled through the Citizen Access Portal' (Accela).

portal landing page checked 2026-08-30 https://www.manteca.gov/230/Instant-Residential-Solar-Energy-Storage

Q50 How much notice is required? Core Booking & scheduling

Nothing published by this authority.

Where we lookedBuilding Safety Division page, Instant Residential Solar & Energy Storage page, Expected Plan Review Times PDF, Building Permits page — none state a required advance-notice period (e.g., '24/48 business hours') for booking an inspection

https://www.manteca.gov/225/Building-Safety

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Nothing published by this authority.

Where we lookedBuilding Safety Division page (states inspector phone/counter availability M–Th 7:30–8:00am and 4:00–4:30pm, which is a staff-availability window, not a same-day/AM-PM appointment-window policy) and the Instant Solar Permits page

https://www.manteca.gov/225/Building-Safety

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherCh 15.60.060(E) ties inspection directly to 'the building official'/building division performing it in-house; no delegation to a third party is mentioned anywhere in the solar ordinance or department pages.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q53 If delegated, to whom? Core Who inspects

Nothing published by this authority.

Where we lookedN/A — Q52 establishes the city performs its own final solar inspection; no delegation language found, so this question does not apply

Q54 Which inspections are required, and in what order? Core Stages & sequence

For a system eligible for expedited review, only one (final) inspection is required.

Why the confidence is not higherCh 15.60.060(E): 'For a small residential rooftop solar energy system eligible for expedited review, only one inspection shall be required, which shall be done in a timely manner.'

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No

Why the confidence is not higherSame Ch 15.60.060(E) language — the one-inspection rule for expedited systems implies no separate rough-in/mid-roof inspection for a compliant small residential rooftop system.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q56 Does the inspector verify labels and listings? Core What is checked

Nothing published by this authority.

Where we lookedCh 15.60 ordinance and solar submittal checklist — neither explicitly states that the field inspector checks labels/listings during the inspection itself (only that labels/UL listings must appear on submitted plans)

https://ecode360.com/44089942

Q57 Is there a published inspection checklist? Core What is checked

Nothing published by this authority.

Where we lookedBuilding Safety Division page, Documents page (/227/Documents), Instant Solar Permits page — a submittal checklist exists and was used for Q8, but no separate published field-inspection checklist was found

https://www.manteca.gov/227/Documents

Q58 What must be on site at inspection? Core Documents on site

Approved plans and all permit documents must be printed and physically available on-site; the inspector cannot complete the inspection without them.

Why the confidence is not higherStated on the city's own Building Permits page: 'Without these plans and documents being onsite our inspector will be unable to complete the inspection.'

department page checked 2026-08-30 https://www.manteca.gov/226/Building-Permits

Q59 Is there a re-inspection fee? Corrections & re-inspection

$128 per unit

Why the confidence is not higher'Reinspection Fee' line item, current published fee schedule effective 8/15/2026.

fee schedule checked 2026-08-30 https://www.manteca.gov/DocumentCenter/View/2782/Development-Fee-Schedule-8-15-2026-PDF

Q60 How are corrections issued and cleared? Corrections & re-inspection

For an incomplete application: the building official issues a written correction notice detailing deficiencies. For a failed inspection: a subsequent inspection is authorized (it need not follow the one-inspection expedited rule), and every re-inspection after the first is charged 'a reasonable inspection fee... in accordance with the currently adopted fee schedule' ($128, per Q59).

Why the confidence is not higherDirectly from Ch 15.60.060(C) and (E).

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q61 What is issued on pass? Core Final sign-off & PTO

Final (final inspection approval/'final approval on the inspection record')

Why the confidence is not higherCh 15.60.060(D) references 'a final inspection and receiving final approval on the inspection record' as the pass condition, without naming a specific document like a CO or green tag for this category.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer

Why the confidence is not higherCh 15.60.060(D): 'The applicant is responsible for obtaining such approval or permission from the local utility provider after requesting and obtaining a final inspection' — the city does not notify the utility itself.

ordinance checked 2026-08-30 https://ecode360.com/44089942

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Manteca against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Manteca is the authority having jurisdiction 92% confidence
Holds
Both (building and electrical, issued directly by the city; not delegated to the county)
Overridden by
CA Gov Code §65850.5(g) and AB 2188 mandate an expedited/streamlined permitting process, which the city implements via Manteca Municipal Code Ch. 15.60 and its Symbium instant-permitting portal; electric utility interconnection sits with PG&E, not the city, since Manteca has no municipal electric utility (city utilities are limited to water, sewer, and storm drainage)
Why not higher
Manteca Municipal Code Ch. 15.60 (Small Residential Rooftop Solar Energy Systems, Ord. 1567, 2015) is the city's own ordinance establishing its Building Safety Division as the permitting authority for residential rooftop solar, expressly adopted 'to comply with the Solar Rights Act and AB 2188.' The city's building/electrical/residential/fire codes (Ch. 15.04, 15.10, 15.20, 15.24) are each independently adopted by the city, confirming the city itself (not San Joaquin County) is the AHJ inside city limits. One naming quirk worth flagging: the Building Safety Division's own code text (§15.60.010) says the Building Official acts 'under the direction of the community development director,' but the department is publicly branded 'Development Services Department' on permit forms/fee schedules and 'Community Development Department' on the solar submittal checklist — same division, inconsistent public labeling, not a jurisdiction split.

https://ecode360.com/44089942

Permit required
Yes95%
Permit cost
$409 flat95%
Plan review
5 business days (first submittal), 5 business days (subsequent submittal)92%
Portal
Symbium (instant/automated permitting for eligible residential rooftop solar & battery storage); Citizen Access / Accela ('aca-prod.accela.com/MANTECA') for all other permits, revisions,92%
Electrical code
202392%
Own placard wording
No60%
Booking an inspection
Portal88%
Labels & placards for this authority

Wording 60%

No

Size, colour & material 55%

No

Where they go None%

What the utility wants on top None%

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
San Joaquin County
Regions served
1
Regions covered
City of Manteca · city
Solar Requirements
Notes
Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.manteca.gov/departments/development-services/building-safety
Authority Contact
Address
1215 W. Center St., Suite 201, Manteca, CA 95337
Main Phone
(209) 456-8000
Building Department
Department
Building Safety Division (Development Services)
Direct Phone
(209) 456-8550
Portal Software
Accela
Booking & Scheduling
Preferred channel
online_portal
Book in advance
1
Notes
City uses Accela Citizen Access portal (aca-prod.accela.com/MANTECA) for all inspection scheduling. A newer portal also exists at permits.manteca.city. Inspection requests must be submitted by 3:30 PM on the business day preceding the desired inspection date; requests after 3:30 PM are scheduled for the second city working day. Inspection hours: 8:00 AM-4:00 PM, Monday-Friday (closed alternating Fridays). Instant automated solar permits available for eligible small residential rooftop systems. All plans/documents must be on-site for inspector. Address: 1215 W. Center St., Suite 201, Manteca, CA 95337.
