City of Martinez
Contra Costa County
City of Martinez is a city authority in the State of California, serving 37,287 residents. 3,518 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — SolarAPP+ path: within 72 hours, 'generally less than 24 hours' (City's own words). Non-SolarAPP+/manual path: same-day for over-the-counter applications, Q18 Where you file — Accela Citizen Access (aca-prod.accela.com/martinez) for general building permits; SolarAPP+ (solarapp.nrel.gov-based portal) for SolarAPP+-eligible residential PV… Q20
- Permit required
- Yes97% source
- Plan review turnaround
- SolarAPP+ path: within 72 hours, 'generally less than 24 hours' (City's own words). Non-SolarAPP+/manual path: same-day for over-the-counter applications,90% source
- Key document
- adopting ordinance + permit application form cited by 6 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 90% · adopting ordinance
- What does this authority permit itself, and what does it delegate? Both 82% · authority's own page + adopting ordinance
- Is a permit required for a residential rooftop PV system? Yes 97% · adopting ordinance
- Is there a separate electrical permit, or is it combined? Combined 65% · permit application form
- Is a HOA or architectural approval required first? No 90% · adopting ordinance
- Is there a historic-district review? Yes, conditionally. The City's Downtown Historic Overlay District (MMC Ch. 22.27) requires the City's standard Design Review process (MMC Ch. 22.34) plus referral to the Martinez Historic Society for 'substantial modification' or demolition of buildings individually listed on the National/State Register, and for 'substantial modification or demolition of other structures, or new construction' generally within the Downtown Core and Civic Districts. Outside that overlay, no historic-review trigger was found for rooftop PV. 78% · codified ordinance
- Is a Specific Use Permit or Council approval ever required? Yes, conditionally. MMC 15.09.060(B)-(D): the Building Official may require a use permit if there is 'substantial evidence' the system 'could have a specific, adverse impact upon the public health and safety'; a denial must be in writing with findings, and decisions are appealable to the Planning Commission. Separately, Downtown Historic Overlay projects go through the City's standard Design Review process (Ch. 22.34). 85% · adopting ordinance
- Is there a system-size cap on residential generation? 10 kW AC nameplate (or 30 kW thermal) is the threshold defining a 'small residential rooftop solar energy system' eligible for the City's ministerial/expedited permitting track (MMC 15.09.010.B.1). This is the 2014 AB 2188 threshold; it has not been updated to SB 379's 38.4 kW AC ceiling under Gov. Code §65850.52. Systems above this size are not barred outright but fall outside the streamlined ordinance's guaranteed same-day/expedited process. 88% · adopting ordinance
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 60% · adopting ordinance + permit application form
- Must the contractor be registered with this authority before applying? Yes 65% · authority's own page
- Is a homeowner permitted to self-install and self-permit? Yes 55% · permit application form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Two tracks: (1) SolarAPP+ electronic design submission for eligible single/duplex-family roof-mounted retrofit PV (auto-reviewed, plans downloaded from the portal); (2) over-the-counter/email submittal for ineligible or non-SolarAPP+ projects, governed by a City-published 'Checklist for Applications not using Solar APP+' (linked from the Solar Permits page). The checklist's own itemized document list could not be retrieved (see not_found). 55% · authority's own page
- Is a site plan required, and what must it show? A site plan/description of system placement is required: Con Fire's own PV plan-review intake ('Photovoltaic Notification Form', ENG 026) asks applicants to describe 'Placement of system on structure/property (i.e. West roof, on carport, alongside rear fence...) be as specific as possible.' The City-side checklist that would define the building-permit site-plan content specifically (doc 5335) was unreachable. 55% · AHJ intake form
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? Accela Citizen Access (aca-prod.accela.com/martinez) for general building permits; SolarAPP+ (solarapp.nrel.gov-based portal) for SolarAPP+-eligible residential PV specifically. 92% · authority's own page
- Can the whole application be completed online? Yes, for SolarAPP+-eligible residential PV (single/duplex-family, roof-mounted, meets Eligibility Checklist). Other permit types, including non-eligible solar, must be submitted in person to avoid delay. 92% · authority's own page
- How is the fee calculated? Likely valuation-based for the City building-permit component (the generic Building Permit Application has a 'PROJECT VALUATION' field feeding the fee grid) plus a separate flat SolarAPP+ processing fee for SolarAPP+ submissions ('A processing fee from SolarAPP+ and City of Martinez permit fees will be charged'). The underlying Fee Schedule PDF could not be retrieved to confirm. 45% · authority's own page + permit application form
- Is there a separate plan-check fee? Yes 65% · permit application form
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? SolarAPP+ path: within 72 hours, 'generally less than 24 hours' (City's own words). Non-SolarAPP+/manual path: same-day for over-the-counter applications, or within 3 business days for electronic applications, per MMC 15.09.060(B). 90% · authority's own page + adopting ordinance
- How long is an issued permit valid before it expires? 180 days 80% · permit application form
- Which utility handles interconnection here? PG&E (Pacific Gas & Electric) -- owns the wires, handles interconnection, PTO and billing infrastructure. MCE (Marin Clean Energy) is the default CCA electricity provider/generation-cost supplier for Martinez customers since April 2018; MCE does not perform interconnection. 95% · authority's own page
- Where does the utility sit in the sequence? Parallel/after permit -- City final building/electrical inspection is required before utility Permission to Operate (PTO) is granted, per PG&E's own interconnection tariff (Rule 21, §D.13.b conditions PTO on the AHJ's final-inspection clearance). 70% · utility DG manual / tariff
28 questions answered against City of Martinez’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity's own Building/Permit Center and Solar Permits pages describe the City issuing residential solar permits directly; MMC Ch. 15.09 (Ord. 1386, 2015) is the City's own codified solar-permitting ordinance. Fire-code enforcement is separately delegated to Contra Costa County FPD by MMC 15.28.010/15.29.010 under Health & Safety Code §13869.7 -- so the City is AHJ for building/electrical/structural, Con Fire is AHJ for fire-code compliance.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherCity self-performs Building and Electrical permitting and inspection (named Chief Building Official Mike Leontiades, named Building Inspectors Dennis Williams and Jeff Taylor, on the City's own Permit Center page). Fire-code enforcement (not building/electrical) is delegated by ordinance to Contra Costa County FPD per MMC 15.28.010 and 15.29.010, citing Health & Safety Code §13869.7. Building Official title is legally vested in the Public Works Director or designee per MMC 15.02.010, though the live site organizes 'Building' as its own department page -- a code-vs-org-chart discrepancy worth noting.
authority's own page + adopting ordinance checked 2026-08-31 https://web.archive.org/web/20260517090342/https://www.cityofmartinez.org/departments/building/permit-center
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherEntire MMC Ch. 15.09 (Permitting Process for Small Residential Rooftop Solar Systems) and the City's SolarAPP+ / Solar Permits page presuppose a required permit; the City issues a numbered permit (e.g. '24BLD-XXXX').
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe City's generic Building Permit Application (Permit Type checkboxes include BUILDING, ELECTRICAL, MECHANICAL, PLUMBING, SIGN as one intake form) and SolarAPP+ issuance of a single 'BLD' permit number for PV suggest a single combined permit with itemized fee lines rather than a separate standalone electrical permit for solar.
permit application form checked 2026-08-31 https://web.archive.org/web/20241118221407/https://www.cityofmartinez.org/home/showpublisheddocument/818/638573432515200000
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherMMC 15.09.040(C) and the SolarAPP+ page reference 'licensed contractors' applying, while the City's generic Building Permit Application form contains an Owner-Builder Declaration citing Bus. & Prof. Code §7044, the standard CA owner-builder self-permit path. No solar-specific restriction to licensed electricians only was found.
adopting ordinance + permit application form checked 2026-08-31 https://ecode360.com/47058033
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherPermit Center page lists 'Business License Required for Contractors' as a required item under Building Permits, alongside SolarAPP+ contractor registration (state contractor license + City business license).
authority's own page checked 2026-08-31 https://web.archive.org/web/20260517090342/https://www.cityofmartinez.org/departments/building/permit-center
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherGeneric Building Permit Application's Owner-Builder Declaration section (citing Bus. & Prof. Code §7044) allows an owner to self-perform and self-permit; no solar-specific carve-out excluding owner-builders was found in MMC Ch. 15.09.
permit application form checked 2026-08-31 https://web.archive.org/web/20241118221407/https://www.cityofmartinez.org/home/showpublisheddocument/818/638573432515200000
Q8 What documents make up a complete submittal? Core Submittal package
Two tracks: (1) SolarAPP+ electronic design submission for eligible single/duplex-family roof-mounted retrofit PV (auto-reviewed, plans downloaded from the portal); (2) over-the-counter/email submittal for ineligible or non-SolarAPP+ projects, governed by a City-published 'Checklist for Applications not using Solar APP+' (linked from the Solar Permits page). The checklist's own itemized document list could not be retrieved (see not_found).
Why the confidence is not higherSolar Permits page states the two-track process and names/links the checklist by title; the underlying checklist PDF (city doc ID 5335) returned 403 on every fetch attempt from this network path and has no Wayback capture, so its itemized contents are unverified.
authority's own page checked 2026-08-31 https://web.archive.org/web/20260705140358/https://www.cityofmartinez.org/departments/building/solar-permits
Q9 How many copies, and in what format? Submittal package
Nothing published by this authority.
Where we lookedSolar Permits page and the 'Checklist for Applications not using Solar APP+' PDF (doc 5335, cityofmartinez.org/home/showpublisheddocument/5335/...) -- PDF returns HTTP 403 from this network path (Akamai) and has no Wayback capture as of this run.
Q10 Is a site plan required, and what must it show? Core Submittal package
A site plan/description of system placement is required: Con Fire's own PV plan-review intake ('Photovoltaic Notification Form', ENG 026) asks applicants to describe 'Placement of system on structure/property (i.e. West roof, on carport, alongside rear fence...) be as specific as possible.' The City-side checklist that would define the building-permit site-plan content specifically (doc 5335) was unreachable.
Why the confidence is not higherDirect read of Con Fire's PV Notification Form; the City's own non-SolarAPP+ checklist (which would state building-permit-specific site plan content) could not be retrieved.
AHJ intake form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/195/Photovoltaic-Notification-Form-PDF
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Nothing published by this authority.
Where we lookedCity's non-SolarAPP+ checklist (doc 5335) and PV Permitting Checklist (doc 4847) -- both PDFs return 403 from this network path with no Wayback capture; MMC Ch. 15.09 and the Con Fire PV Application form do not themselves specify one-line-diagram requirements.
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedSame checklists as Q11 (docs 5335, 4847) -- unreachable; not stated in MMC Ch. 15.09 or the Con Fire PV Application form.
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedMMC Ch. 15.04 (Building Code) and Ch. 15.09 (solar ordinance) -- neither states a structural PE-stamp threshold for residential rooftop PV; the two solar-specific checklists that might state this (docs 5335, 4847) were unreachable.
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedMMC Ch. 15.24 (Electrical Code) adopts the 2025 CEC by reference with no stated PE-stamp threshold for residential PV; the two solar-specific checklists (docs 5335, 4847) that might state this were unreachable.
Q15 What does a residential solar permit cost? Core Fees
Nothing published by this authority.
Where we lookedCity's consolidated Fee Schedule (doc 5167, linked from the Permit Center page) returns HTTP 403 from this network path and has no Wayback capture; MMC 15.04.045 confirms fees are 'as adopted from time to time by resolution of the City Council' but the resolution's dollar figures were unreachable this run.
Q16 How is the fee calculated? Core Fees
Likely valuation-based for the City building-permit component (the generic Building Permit Application has a 'PROJECT VALUATION' field feeding the fee grid) plus a separate flat SolarAPP+ processing fee for SolarAPP+ submissions ('A processing fee from SolarAPP+ and City of Martinez permit fees will be charged'). The underlying Fee Schedule PDF could not be retrieved to confirm.
Why the confidence is not higherInference from the generic permit-intake form's valuation field and the Solar Permits page's description of a two-part fee (SolarAPP+ processing fee + City permit fee); the actual Fee Schedule (doc 5167) was unreachable this run.
authority's own page + permit application form checked 2026-08-31 https://web.archive.org/web/20260705140358/https://www.cityofmartinez.org/departments/building/solar-permits
Q17 Is there a separate plan-check fee? Fees
Yes
Why the confidence is not higherThe City's generic Building Permit Application fee grid lists 'BUILDING REVIEW' (010005-4626) as a distinct line item from 'BUILDING PERMIT' (010005-4430), indicating a separate plan-check/review fee on the same intake form used for building permits generally.
permit application form checked 2026-08-31 https://web.archive.org/web/20241118221407/https://www.cityofmartinez.org/home/showpublisheddocument/818/638573432515200000
Q18 What is the stated plan-review turnaround? Core Timeline & validity
SolarAPP+ path: within 72 hours, 'generally less than 24 hours' (City's own words). Non-SolarAPP+/manual path: same-day for over-the-counter applications, or within 3 business days for electronic applications, per MMC 15.09.060(B).
Why the confidence is not higherDirect quotes from the City's Solar Permits page (SolarAPP+ turnaround) and MMC 15.09.060(B) (manual-path turnaround).
authority's own page + adopting ordinance checked 2026-08-31 https://web.archive.org/web/20260705140358/https://www.cityofmartinez.org/departments/building/solar-permits
Q19 How long is an issued permit valid before it expires? Timeline & validity
180 days
Why the confidence is not higherCity's generic Building Permit Application form quotes CBC §106A.4: permit 'shall expire ... if the building or work ... is not commenced within 180 days ... or is suspended or abandoned ... for a period of 180 days.' This is the generic building-permit rule; no solar-specific override was found.
permit application form checked 2026-08-31 https://web.archive.org/web/20241118221407/https://www.cityofmartinez.org/home/showpublisheddocument/818/638573432515200000

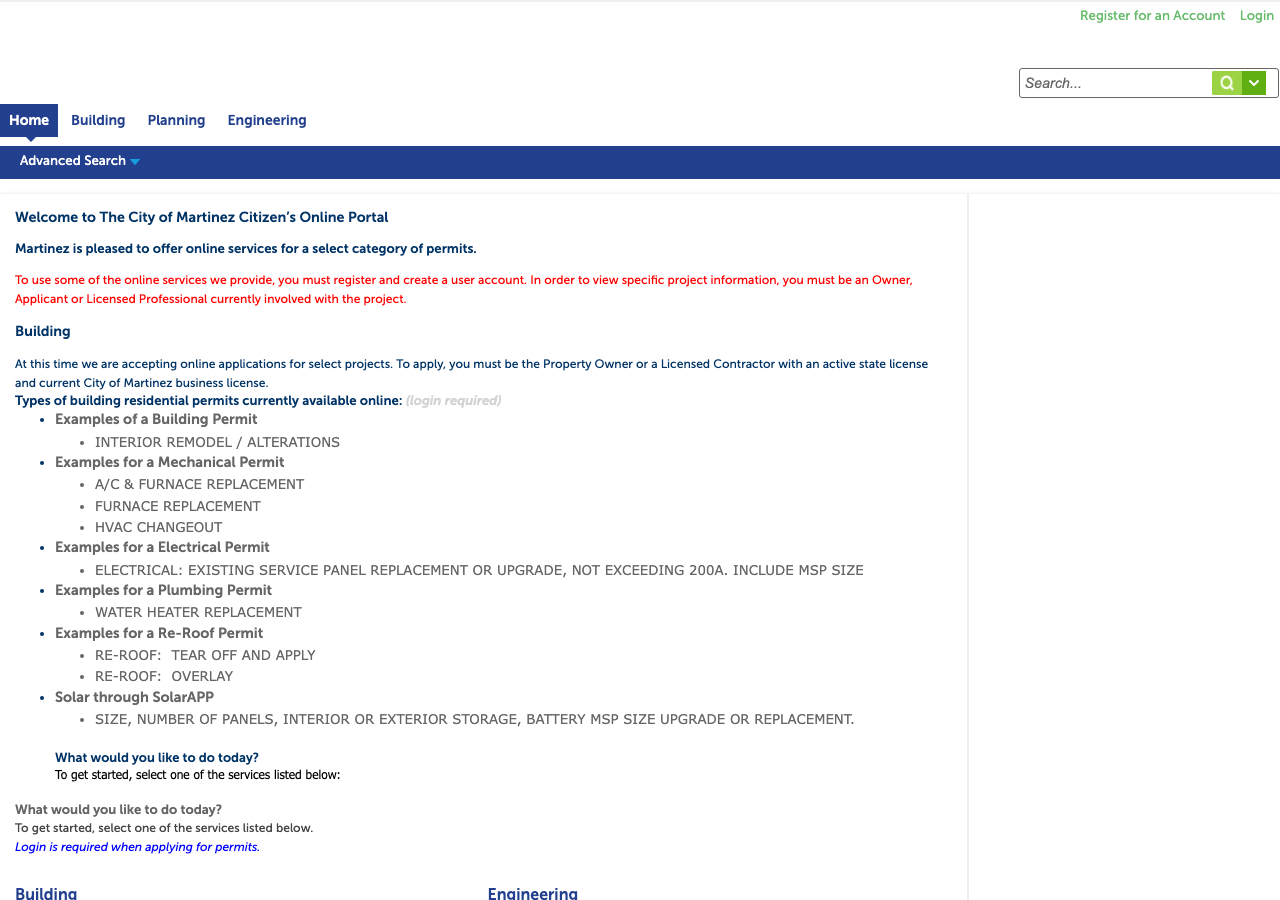

Q20 Which permit portal does this authority use? Core Portal & process
Accela Citizen Access (aca-prod.accela.com/martinez) for general building permits; SolarAPP+ (solarapp.nrel.gov-based portal) for SolarAPP+-eligible residential PV specifically.
Why the confidence is not higherPermit Center page: 'The City has launched an Online Portal for SPECIFIC residential permit types ... Solar through SolarAPP+ Only ... https://aca-prod.accela.com/martinez/Default.aspx'; live-fetched and confirmed the Accela portal resolves (HTTP 200).
authority's own page checked 2026-08-31 https://web.archive.org/web/20260517090342/https://www.cityofmartinez.org/departments/building/permit-center
Q21 Can the whole application be completed online? Core Portal & process
Yes, for SolarAPP+-eligible residential PV (single/duplex-family, roof-mounted, meets Eligibility Checklist). Other permit types, including non-eligible solar, must be submitted in person to avoid delay.
Why the confidence is not higherPermit Center page lists 'Solar through SolarAPP+ Only' as one of a short named list of permit types the online portal supports, with 'All other permit types should be submitted in person ... to avoid experiencing a delay.'
authority's own page checked 2026-08-31 https://web.archive.org/web/20260517090342/https://www.cityofmartinez.org/departments/building/permit-center
Q22 Which utility handles interconnection here? Core Utility interconnection
PG&E (Pacific Gas & Electric) -- owns the wires, handles interconnection, PTO and billing infrastructure. MCE (Marin Clean Energy) is the default CCA electricity provider/generation-cost supplier for Martinez customers since April 2018; MCE does not perform interconnection.
Why the confidence is not higherCity's own Sustainability 'Energy, Solar, Water' page: 'MCE is the default electricity provider in Martinez since April 2018. Pacific Gas and Electric ("PG&E") continues to transmit and distribute electricity, maintain power lines, and handle billing... Solar customers ... can learn more about Solar Net Energy Metering policy, rates, and incentives on MCE's website.' This directly overturns any assumption of a straight PG&E-only relationship and confirms the CCA layer.
authority's own page checked 2026-08-31 https://web.archive.org/web/20260411023256/https://www.cityofmartinez.org/government/sustainability-resources/energy-solar-water/solar-energy-systems
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel/after permit -- City final building/electrical inspection is required before utility Permission to Operate (PTO) is granted, per PG&E's own interconnection tariff (Rule 21, §D.13.b conditions PTO on the AHJ's final-inspection clearance).
Why the confidence is not higherPG&E Rule 21 (its own tariff document, downloaded and grepped in a prior verified run of this project) gates PTO on AHJ final-inspection sign-off; not independently re-confirmed against a Martinez-specific PG&E document this run, but PG&E's tariff applies uniformly across its territory including Martinez.
utility DG manual / tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherMMC 15.09.060(G): 'Approval of an application shall not be conditioned upon the approval of an association, as defined in Section 4080 of the Civil Code' -- the City's codified solar ordinance explicitly bars an HOA veto, consistent with the state Solar Rights Act.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Q25 Is there a historic-district review? Overlays & special cases
Yes, conditionally. The City's Downtown Historic Overlay District (MMC Ch. 22.27) requires the City's standard Design Review process (MMC Ch. 22.34) plus referral to the Martinez Historic Society for 'substantial modification' or demolition of buildings individually listed on the National/State Register, and for 'substantial modification or demolition of other structures, or new construction' generally within the Downtown Core and Civic Districts. Outside that overlay, no historic-review trigger was found for rooftop PV.
Why the confidence is not higherDirect read of MMC Ch. 22.27 (Downtown Historic Overlay District), current as of the eCode360 code date 2026-08-11. Whether a routine rooftop PV retrofit specifically counts as 'substantial modification' is not defined numerically in this chapter, so applicability to an ordinary re-roof/PV install outside the listed-building category is inferred rather than stated.
codified ordinance checked 2026-08-31 https://ecode360.com/47148290
Q26 Is a wind or windstorm certification required? Overlays & special cases
Nothing published by this authority.
Where we lookedMMC Ch. 15.04 (Building Code, adopting 2025 CBC) and Ch. 15.24 (Electrical Code) -- no wind/windstorm certification requirement found; California is not a state that typically imposes a separate wind-certification regime (unlike TDI in coastal Texas), and none was located in the reviewed code chapters.
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Yes, conditionally. MMC 15.09.060(B)-(D): the Building Official may require a use permit if there is 'substantial evidence' the system 'could have a specific, adverse impact upon the public health and safety'; a denial must be in writing with findings, and decisions are appealable to the Planning Commission. Separately, Downtown Historic Overlay projects go through the City's standard Design Review process (Ch. 22.34).
Why the confidence is not higherDirect text of MMC 15.09.060(B)-(D).
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC nameplate (or 30 kW thermal) is the threshold defining a 'small residential rooftop solar energy system' eligible for the City's ministerial/expedited permitting track (MMC 15.09.010.B.1). This is the 2014 AB 2188 threshold; it has not been updated to SB 379's 38.4 kW AC ceiling under Gov. Code §65850.52. Systems above this size are not barred outright but fall outside the streamlined ordinance's guaranteed same-day/expedited process.
Why the confidence is not higherDirect text of MMC 15.09.010.B.1, dated to Ord. No. 1386, 6/17/2015, and never amended since -- a stale AB 2188-era threshold, the same pattern flagged elsewhere in this survey (Pacifica PMC 8-4.04, San Bruno SBMC 11.36). Cited both facts rather than asserting the newer SB 379 ceiling applies locally.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 97% · adopting ordinance
- Which building code edition is in force? 2025 California Building Code (Title 24, Part 2), incorporating the 2024 IBC, effective per the City's own Permit Center page from 1 Jan 2026 for all projects requiring a building permit. 97% · adopting ordinance
- Which fire code edition is in force? 2025 California Fire Code (Title 24, Part 9, based on the 2024 IFC), as amended by Contra Costa County FPD Ordinance No. 2025-14. 92% · adopting ordinance
- Are there local amendments to any of the above? Yes 85% · adopting ordinance
- What is the installation judged against? 2025 CEC (2023 NEC) for electrical work; 2025 CBC/CRC for structural attachment; 2025 CFC Chapter 1205 (via Con Fire's own PV plan-review form, which cites CFC 1205.2.4, 1205.3.1-.4, 1205.5.1) for fire pathways, ventilation and rapid-shutdown labeling; MMC 15.09.040 additionally requires conformance to CEC, IEEE, UL/accredited-lab listing and, where applicable, CPUC safety/reliability rules. 88% · adopting ordinance + AHJ intake form
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Con Fire's own PV plan-review form requires: for Group R-3 (single-family), at least two 36-inch-wide pathways on separate roof planes from lowest edge to highest ridge, at least one on the street/driveway side (CFC 1205.2.1.1); interior pathways at 150-ft intervals, 4-ft clearances around skylights/hatches/standpipes (CFC 1205.3.2); smoke-ventilation pathways bordering vents/skylights (CFC 1205.3.3); DC conductors routed close to ridge/hip/valley toward an outside wall (CFC 1205.2.4/1205.3.4). 88% · AHJ plan-review form
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes, per NEC 690.12 as adopted through the 2023 NEC/2025 CEC (MMC 15.24.010); reinforced locally by Con Fire's CFC 1205.5.1 rapid-shutdown placard requirement (buildings with rapid-shutdown PV systems must display a permanent label reading 'SOLAR PV SYSTEM EQUIPPED WITH RAPID SHUTDOWN. TURN RAPID SHUTDOWN SWITCH TO THE "OFF" POSITION...'). 82% · adopting ordinance + AHJ plan-review form
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? DC wiring/raceway markings ('WARNING: PHOTOVOLTAIC POWER SOURCE'); a rapid-shutdown placard where applicable; and the general PV Notification/plan-review paperwork Con Fire uses to brief dispatch. 85% · AHJ plan-review form
- Does the authority specify placard wording of its own? Yes 88% · AHJ plan-review form
- Does it specify letter height, colour or material? DC wiring/raceway markings: weather-resistant reflective material, minimum 3/8-inch letters, white on red background. Rapid-shutdown label: first two lines in uppercase, minimum 3/8-inch height, black text on yellow background. 88% · AHJ plan-review form
- Is a site plan / facility map placard required, and what must it show? A narrative site plan is required describing exactly where the system sits on the structure/property (Con Fire's Photovoltaic Notification Form asks applicants to be 'as specific as possible,' e.g. 'West roof, on carport, alongside rear fence'). No separate dedicated facility-map placard spec (of the kind LA County Fire publishes) was located for Martinez/Con Fire. 55% · AHJ intake form
- Does the UTILITY specify placards beyond the AHJ's? Yes, at the statewide-tariff level: PG&E's Rule 21 requires the visible interconnection/PV disconnect to carry open/closed position markings, and gates Permission to Operate on the AHJ's final-inspection clearance. 65% · utility DG manual / tariff
- Where must the labels be placed? DC wiring markings at: exposed raceways/cable trays/other wiring methods; covers/enclosures of pull and junction boxes; conduit bodies with unused openings; every section of wiring separated by enclosures/walls/partitions/ceilings/floors; every 10 feet; and at all DC combiner and junction boxes. 85% · AHJ plan-review form
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes, implicitly. 78% · adopting ordinance
- Are batteries permitted, and under what conditions? Batteries/ESS are permitted but are handled outside the ministerial small-rooftop-solar track (MMC Ch. 15.09 covers PV and solar water heating only, not batteries). Con Fire treats 'Battery Systems/Energy Storage' as its own fee/plan-review category with a minimum fee plus a separate UL9540A review fee. 78% · fee schedule
- Is there a separate ESS permit or inspection? Yes 85% · fee schedule
- Is a ground mount treated as a structure? Yes, by inference. 60% · codified ordinance (inference)
- Is there a local rule on service upgrades or busbar sizing? No local amendment found. 75% · adopting ordinance
20 questions answered against City of Martinez’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023
Why the confidence is not higherMMC 15.24.010: 'The City hereby adopts by reference the 2025 Edition of the California Electrical Code which incorporates the 2023 National Electrical Code as published by the National Fire Protection Agency ... Ord. No. 1479, 11/19/2025.'
adopting ordinance checked 2026-08-31 https://ecode360.com/47058147
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (Title 24, Part 2), incorporating the 2024 IBC, effective per the City's own Permit Center page from 1 Jan 2026 for all projects requiring a building permit.
Why the confidence is not higherMMC 15.04.010 direct text (Ord. No. 1479, 11/19/2025) plus the Permit Center page's own statement: 'Beginning January 1, 2026, all construction projects ... will be required to comply with the new 2025 California Building Standards Codes (Title 24).'
adopting ordinance checked 2026-08-31 https://ecode360.com/47057800
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (Title 24, Part 9, based on the 2024 IFC), as amended by Contra Costa County FPD Ordinance No. 2025-14.
Why the confidence is not higherMMC 15.28.010 direct text: the City 'ratifies the Contra Costa County Fire Protection District Fire Code, adopting by reference the 2025 California Fire Code ... as amended by ... Contra Costa County Fire Protection District Ordinance No. 2025-14,' with enforcement delegated to the Con Fire Chief under Health & Safety Code §13869.7.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058156
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherFire and Wildland-Urban Interface codes are adopted 'as amended by' named Con Fire ordinances (2025-14, 2025-15) -- local amendments exist. The Electrical Code chapter itself (15.24) was wholesale re-adopted 11/19/2025 with no stated local amendment text remaining in that chapter; the Building Code chapter carries its own local grading/excavation amendments (Appendix J) unrelated to solar.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058156
Q33 What is the installation judged against? Core Electrical
2025 CEC (2023 NEC) for electrical work; 2025 CBC/CRC for structural attachment; 2025 CFC Chapter 1205 (via Con Fire's own PV plan-review form, which cites CFC 1205.2.4, 1205.3.1-.4, 1205.5.1) for fire pathways, ventilation and rapid-shutdown labeling; MMC 15.09.040 additionally requires conformance to CEC, IEEE, UL/accredited-lab listing and, where applicable, CPUC safety/reliability rules.
Why the confidence is not higherSynthesis of MMC 15.24.010, 15.04.010, 15.09.040, and Con Fire's own 'Solar Application (PV)' plan-review form which cites specific CFC 1205 subsections.
adopting ordinance + AHJ intake form checked 2026-08-31 https://ecode360.com/47058033
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No local amendment found.
Why the confidence is not higherMMC Ch. 15.24 (Electrical Code) was repealed and wholesale re-adopted by Ord. No. 1479 (11/19/2025) as a single section ('Adoption of California Electrical Code') with no stated local busbar/service-upgrade amendment text remaining; positive control ('electrical', 9 hits) and fabricated control ('zzqqx', 0 hits) both behaved as expected on this chapter's extracted text, so the absence is not a broken-search artifact.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058147
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedMMC Ch. 15.04 (Building Code) and Ch. 15.09 (solar ordinance) -- neither specifies a particular mounting system or attachment spacing for residential rooftop PV; the solar-specific checklists (docs 5335, 4847) that might state this were unreachable this run.
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Con Fire's own PV plan-review form requires: for Group R-3 (single-family), at least two 36-inch-wide pathways on separate roof planes from lowest edge to highest ridge, at least one on the street/driveway side (CFC 1205.2.1.1); interior pathways at 150-ft intervals, 4-ft clearances around skylights/hatches/standpipes (CFC 1205.3.2); smoke-ventilation pathways bordering vents/skylights (CFC 1205.3.3); DC conductors routed close to ridge/hip/valley toward an outside wall (CFC 1205.2.4/1205.3.4).
Why the confidence is not higherDirect text of Con Fire's 'Solar Application (PV)' plan-review form, which quotes the operative CFC 1205 subsections; Con Fire enforces the Fire Prevention Code within Martinez by delegation (MMC 15.28.010).
AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes, per NEC 690.12 as adopted through the 2023 NEC/2025 CEC (MMC 15.24.010); reinforced locally by Con Fire's CFC 1205.5.1 rapid-shutdown placard requirement (buildings with rapid-shutdown PV systems must display a permanent label reading 'SOLAR PV SYSTEM EQUIPPED WITH RAPID SHUTDOWN. TURN RAPID SHUTDOWN SWITCH TO THE "OFF" POSITION...').
Why the confidence is not higherMMC 15.24.010 adopts the 2023 NEC (which contains §690.12) without any stated local amendment removing it; Con Fire's PV Application form independently mandates the CFC 1205.5.1 rapid-shutdown label with exact wording. NEC §690.12 itself was not found cited by section number in any Martinez-specific document (only CEC 690.31 was cited by number), so this combines a code-adoption fact with a directly quoted local label requirement.
adopting ordinance + AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
DC wiring/raceway markings ('WARNING: PHOTOVOLTAIC POWER SOURCE'); a rapid-shutdown placard where applicable; and the general PV Notification/plan-review paperwork Con Fire uses to brief dispatch.
Why the confidence is not higherCon Fire's 'Solar Application (PV)' plan-review form, 'REQUIREMENTS FOR MARKING' and 'RAPID SHUTDOWN TYPE' sections.
AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes
Why the confidence is not higherCon Fire's PV Application form specifies exact wording: 'Typical wording "WARNING: PHOTOVOLTAIC POWER SOURCE" or as otherwise approved' and, for rapid shutdown, verbatim label text 'SOLAR PV SYSTEM EQUIPPED WITH RAPID SHUTDOWN. TURN RAPID SHUTDOWN SWITCH TO THE "OFF" POSITION TO SHUTDOWN PV SYSTEM AND REDUCE SHOCK HAZARD IN ARRAY.'
AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
DC wiring/raceway markings: weather-resistant reflective material, minimum 3/8-inch letters, white on red background. Rapid-shutdown label: first two lines in uppercase, minimum 3/8-inch height, black text on yellow background.
Why the confidence is not higherDirect quotes from Con Fire's PV Application form ('REQUIREMENTS FOR MARKING' and 'RAPID SHUTDOWN TYPE' sections).
AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
A narrative site plan is required describing exactly where the system sits on the structure/property (Con Fire's Photovoltaic Notification Form asks applicants to be 'as specific as possible,' e.g. 'West roof, on carport, alongside rear fence'). No separate dedicated facility-map placard spec (of the kind LA County Fire publishes) was located for Martinez/Con Fire.
Why the confidence is not higherCon Fire's Photovoltaic Notification Form (ENG 026) direct text; the City's own solar-specific checklists (docs 5335, 4847), which might add a building-permit-specific site-plan content list, were unreachable this run.
AHJ intake form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/195/Photovoltaic-Notification-Form-PDF
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes, at the statewide-tariff level: PG&E's Rule 21 requires the visible interconnection/PV disconnect to carry open/closed position markings, and gates Permission to Operate on the AHJ's final-inspection clearance.
Why the confidence is not higherPG&E Rule 21 (utility tariff document; established from PG&E's own published tariff book in prior verified project work; applies uniformly across PG&E's service territory, which is confirmed to include Martinez per the City's own sustainability page). Not independently re-confirmed against Martinez-specific correspondence this run.
utility DG manual / tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
DC wiring markings at: exposed raceways/cable trays/other wiring methods; covers/enclosures of pull and junction boxes; conduit bodies with unused openings; every section of wiring separated by enclosures/walls/partitions/ceilings/floors; every 10 feet; and at all DC combiner and junction boxes.
Why the confidence is not higherDirect list from Con Fire's PV Application form, 'REQUIREMENTS FOR MARKING' (a) through (f), citing CEC 690.31.
AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q44 Must equipment be on a specific approved list? Equipment listing
Yes, implicitly.
Why the confidence is not higherMMC 15.09.040(B)-(C): solar water-heating equipment must be 'certified by an accredited listing agency'; PV equipment must meet 'all applicable safety and performance standards established by the California Electrical Code, the Institute of Electrical and Electronics Engineers, and accredited testing laboratories such as Underwriters Laboratories.'
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Batteries/ESS are permitted but are handled outside the ministerial small-rooftop-solar track (MMC Ch. 15.09 covers PV and solar water heating only, not batteries). Con Fire treats 'Battery Systems/Energy Storage' as its own fee/plan-review category with a minimum fee plus a separate UL9540A review fee.
Why the confidence is not higherMMC Ch. 15.09's definitions (§15.09.010) only cover solar collectors/PV; Con Fire's own current Engineering/Plan Review Fee Schedule (Ordinance 2026-07, effective 13 Jul 2026) lists 'Energy Storage System / Battery Systems/Energy Storage' and 'UL9540A Review' as distinct line items separate from any PV/solar line.
fee schedule checked 2026-08-31 https://drive.google.com/file/d/1f7L1Otr4s0_oJTdQKE_Zu_E-ke6xHHRR/view?usp=sharing
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Yes
Why the confidence is not higherCon Fire's current Engineering/Plan Review Fee Schedule (Ordinance 2026-07, adopted 12 May 2026, effective 13 Jul 2026) lists 'Battery Systems/Energy Storage -- minimum fee $944.00' and 'UL9540A Review -- minimum fee $516.00' as a distinct plan-review/permit category, separate from the no-fee PV notification route.
fee schedule checked 2026-08-31 https://drive.google.com/file/d/1f7L1Otr4s0_oJTdQKE_Zu_E-ke6xHHRR/view?usp=sharing
Q47 Is a ground mount treated as a structure? Core Ground mount
Yes, by inference.
Why the confidence is not higherMMC 22.12.265 (Accessory structures) sets maximum size (1,000 sf), height (1 story/15 ft) and setback rules for accessory structures in residential districts, with no PV or solar-array carve-out found anywhere in Title 22 (Zoning). A ground-mounted array would fall under this general accessory-structure section by inference rather than an explicit named 'ground-mount solar' provision -- flagged as inference, not a stated rule.
codified ordinance (inference) checked 2026-08-31 https://ecode360.com/47147692
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedPG&E's Greenbook DG interconnection document (TD-2306M, gated/not publicly downloadable) and the City's solar-specific checklists (docs 5335, 4847, both unreachable this run) would be the places this meter-proximity spec lives; not stated in MMC Ch. 15.09, 15.24, or Con Fire's PV Application form.
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone 92% · authority's own page
- How much notice is required? General building inspections: by 4:00 p.m. the day before the requested inspection (1 business day). Solar-specific (MMC 15.09.060(J)): 'An inspection will be scheduled within 2 business days of a request.' 85% · authority's own page + adopting ordinance
- Are same-day or AM/PM windows offered? Yes -- morning (9:00 a.m.-12:00 p.m.) or afternoon (1:00 p.m.-4:00 p.m.) windows are offered; MMC 15.09.060(J) additionally requires the solar-specific inspection to be scheduled with a 2-hour window. 90% · authority's own page + adopting ordinance
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 82% · authority's own page
- If delegated, to whom? Contra Costa County Fire Protection District (Con Fire) -- for the fire-code-specific portion only (pathways, placards, rapid-shutdown labeling, ESS). 88% · adopting ordinance
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? For expedited/ministerial-eligible small residential rooftop PV: only ONE City building/electrical inspection is required (MMC 15.09.060(I)), plus a possible separate Con Fire fire inspection. Con Fire's own PV Application form instructs the applicant to call and schedule the fire final directly with Con Fire (925-941-3300 ext. 3902, min. 2 working days' notice) after plan approval. 85% · adopting ordinance + AHJ plan-review form
- Is a rough-in or mid-roof inspection required? No 75% · adopting ordinance
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes, at least on the fire side. 68% · AHJ plan-review form
- Does the inspector verify labels and listings? Yes, implicitly. 70% · AHJ plan-review form
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final 60% · inference from AHJ plan-review form + standard practice
- Who notifies the utility for PTO? Installer (inferred) 50% · inference from utility tariff
- How are corrections issued and cleared? A written correction notice detailing all deficiencies and any additional required information/documentation is sent to the applicant for resubmission. 82% · adopting ordinance
14 questions answered against City of Martinez’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone
Why the confidence is not higherBoth the Solar Permits page and Permit Center page: 'To schedule an inspection, call (925) 372-3596' / 'Building Inspection Request Recorder -- (925) 372-3596.'
authority's own page checked 2026-08-31 https://web.archive.org/web/20260705140358/https://www.cityofmartinez.org/departments/building/solar-permits
Q50 How much notice is required? Core Booking & scheduling
General building inspections: by 4:00 p.m. the day before the requested inspection (1 business day). Solar-specific (MMC 15.09.060(J)): 'An inspection will be scheduled within 2 business days of a request.'
Why the confidence is not higherPermit Center page ('no later than 4:00 p.m. the day before the requested inspection') and MMC 15.09.060(J) direct text.
authority's own page + adopting ordinance checked 2026-08-31 https://web.archive.org/web/20260517090342/https://www.cityofmartinez.org/departments/building/permit-center
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Yes -- morning (9:00 a.m.-12:00 p.m.) or afternoon (1:00 p.m.-4:00 p.m.) windows are offered; MMC 15.09.060(J) additionally requires the solar-specific inspection to be scheduled with a 2-hour window.
Why the confidence is not higherSolar Permits page direct text ('requested for morning ... or afternoon') and MMC 15.09.060(J).
authority's own page + adopting ordinance checked 2026-08-31 https://web.archive.org/web/20260705140358/https://www.cityofmartinez.org/departments/building/solar-permits
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherCity Building Inspectors (Dennis Williams, Jeff Taylor) perform the building/electrical final per the Permit Center page. A separate fire-code inspection is independently delegated to Contra Costa County FPD by MMC 15.28.010/15.29.010 and confirmed by MMC 15.09.060(I) ('A separate fire inspection may be required by the Contra Costa Fire District') -- so the fire portion specifically is delegated even though the City performs its own building/electrical final.
authority's own page checked 2026-08-31 https://web.archive.org/web/20260517090342/https://www.cityofmartinez.org/departments/building/permit-center
Q53 If delegated, to whom? Core Who inspects
Contra Costa County Fire Protection District (Con Fire) -- for the fire-code-specific portion only (pathways, placards, rapid-shutdown labeling, ESS).
Why the confidence is not higherMMC 15.28.010 and 15.29.010 delegate Fire Prevention Code and WUI Code enforcement to the Con Fire Chief under Health & Safety Code §13869.7; MMC 15.09.060(I) confirms a separate Con Fire inspection may be required.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058156
Q54 Which inspections are required, and in what order? Core Stages & sequence
For expedited/ministerial-eligible small residential rooftop PV: only ONE City building/electrical inspection is required (MMC 15.09.060(I)), plus a possible separate Con Fire fire inspection. Con Fire's own PV Application form instructs the applicant to call and schedule the fire final directly with Con Fire (925-941-3300 ext. 3902, min. 2 working days' notice) after plan approval.
Why the confidence is not higherMMC 15.09.060(I) direct text; Con Fire's Solar Application (PV) form's own final-inspection scheduling instructions.
adopting ordinance + AHJ plan-review form checked 2026-08-31 https://ecode360.com/47058033
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherMMC 15.09.060(I): 'Only one inspection shall be required and performed by the Building Department for small residential rooftop solar energy systems eligible for expedited review' -- explicitly limiting the City building inspection to a single (final) visit, i.e. no separate rough-in/mid-roof inspection for the expedited track.
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Q56 Does the inspector verify labels and listings? Core What is checked
Yes, implicitly.
Why the confidence is not higherCon Fire's PV Application form's 'REQUIREMENTS FOR MARKING' checklist (label wording, letter height, colour, placement) is structured as an approval checklist ('Approved as submitted / Approved with Comments / Denied'), implying the fire inspector verifies labels at plan review/inspection; MMC 15.09.040 requires equipment to meet listing standards, which an inspector would verify.
AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q57 Is there a published inspection checklist? Core What is checked
Yes, at least on the fire side.
Why the confidence is not higherCon Fire's 'Solar Application (PV)' 2-page form functions as a combined plan-review/inspection checklist with an 'Approved as submitted / Approved with Comments / Denied' sign-off block. Whether the City Building Department separately publishes its own itemized inspection checklist could not be confirmed -- its non-SolarAPP+ checklist (doc 5335) and PV Permitting Checklist (doc 4847) were unreachable this run.
AHJ plan-review form checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q58 What must be on site at inspection? Core Documents on site
Nothing published by this authority.
Where we lookedPermit Center and Solar Permits pages describe how to book an inspection (permit number, address, contact) but do not list what documents/access must be physically present on site at the time of inspection; the unreachable checklists (docs 5335, 4847) are the likely source for this.
Q59 Is there a re-inspection fee? Corrections & re-inspection
Nothing published by this authority.
Where we lookedCity's consolidated Fee Schedule (doc 5167) -- unreachable (403, no Wayback capture) this run; not stated elsewhere in MMC Ch. 15.04/15.09.
Q60 How are corrections issued and cleared? Corrections & re-inspection
A written correction notice detailing all deficiencies and any additional required information/documentation is sent to the applicant for resubmission.
Why the confidence is not higherMMC 15.09.060(H) direct text (applies to the expedited solar-permitting track; presumed to extend to the general building-permit correction process by City practice, not independently confirmed for non-solar permits).
adopting ordinance checked 2026-08-31 https://ecode360.com/47058033
Q61 What is issued on pass? Core Final sign-off & PTO
Final
Why the confidence is not higherInferred from standard CA residential-retrofit practice (a rooftop PV installation on an existing single-family home does not trigger a new Certificate of Occupancy; MMC 15.09.060 and the Con Fire form describe only a final approval/'Approved as submitted' sign-off). Not stated as a defined term ('Final' vs 'Green tag' vs 'Letter') anywhere in the reviewed City documents.
inference from AHJ plan-review form + standard practice checked 2026-08-31 https://www.cccfpd.org/DocumentCenter/View/209/Solar-Application-PV-PDF
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer (inferred)
Why the confidence is not higherNo Martinez-specific document states who submits the PTO request to PG&E/MCE; this follows the standard statewide NEM process in which the installer submits the PTO request through the utility's interconnection portal once the AHJ's final inspection has passed (PG&E Rule 21 gates PTO on AHJ final clearance, per Q23). Not independently confirmed against a Martinez-specific source.
inference from utility tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Martinez against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Martinez is the authority having jurisdiction 88% confidence
- Holds
- Building, Electrical, Mechanical, Plumbing (self-performed by the City's own Building Division -- Chief Building Official Mike Leontiades, Building Inspectors Dennis Williams and Jeff Taylor). Fire-code and Wildland-Urban Interface Code enforcement (pathways, placards, rapid-shutdown labeling, ESS/battery plan review) is independently delegated by ordinance to the Contra Costa County Fire Protection District under Health & Safety Code §13869.7 (MMC 15.28.010, 15.29.010).
- Delegated to
- Contra Costa County Fire Protection District (Con Fire) -- fire-code and WUI-code enforcement only, not building/electrical.
- Overridden by
- State law shapes but does not remove the City's authority: MMC Ch. 15.09 codifies Gov. Code §65850.5/AB 2188 ministerial solar permitting (10 kW AC / 30 kW thermal threshold -- not yet updated to SB 379's 38.4 kW AC ceiling under Gov. Code §65850.52); Civil Code §714/§4600 (Solar Rights Act) bars HOA conditions, mirrored in MMC 15.09.060(G). PG&E's own Rule 21 tariff independently governs interconnection sequencing/PTO regardless of city ordinance.
- Why not higher
- Confirmed directly from the City's own Municipal Code (eCode360, code date 2026-08-11): MMC 15.02.010 vests the Building Official title in the Public Works Director or designee -- a code-vs-website discrepancy, since the live site organizes 'Building' as its own department with its own named Chief Building Official rather than showing it under Public Works. MMC 15.28.010/15.29.010 independently confirm the City ratifies and delegates fire/WUI code enforcement to Con Fire by ordinance, consistent with (and verifying) prior findings on Con Fire's role and current fee ordinance. Con Fire's own directory (https://www.cccfpd.org/directory.aspx?did=21) and site search both confirm 'City of Martinez' as a listed served jurisdiction. Sanitary sewer service is split: most of the city is served by Central Contra Costa Sanitary District (Central San confirms only 'portions of Martinez' are in its service area, per Central San's own 'Who We Are' page), while a small annexed area (former Stonehurst Subdivision, Alhambra Valley) is served by Contra Costa County Sanitation District No. 6, whose Board of Directors IS the Martinez City Council itself (per the City's own SD-6 page) -- this is a more precise picture than a flat 'Central San serves Martinez' statement.
- Permit required
- Yes97%
- Plan review
- SolarAPP+ path: within 72 hours, 'generally less than 24 hours' (City's own words). Non-SolarAPP+/manual path: same-day for over-the-counter applications,90%
- Portal
- Accela Citizen Access (aca-prod.accela.com/martinez) for general building permits; SolarAPP+ (solarapp.nrel.gov-based portal) for SolarAPP+-eligible residential PV specifically.92%
- Electrical code
- 202397%
- Own placard wording
- Yes88%
- Booking an inspection
- Phone92%
Labels & placards for this authority
City of Martinez writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 88%
Yes
Size, colour & material 88%
DC wiring/raceway markings: weather-resistant reflective material, minimum 3/8-inch letters, white on red background. Rapid-shutdown label: first two lines in uppercase, minimum 3/8-inch height, black text on yellow background.
Where they go 85%
DC wiring markings at: exposed raceways/cable trays/other wiring methods; covers/enclosures of pull and junction boxes; conduit bodies with unused openings; every section of wiring separated by enclosures/walls/partitions/ceilings/floors; every 10 feet; and at all DC combiner and junction boxes.
What the utility wants on top 65%
Yes, at the statewide-tariff level: PG&E's Rule 21 requires the visible interconnection/PV disconnect to carry open/closed position markings, and gates Permission to Operate on the AHJ's final-inspection clearance.
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
