City of Marysville

Yuba County

Verified Aug. 4, 2026

City of Marysville is a city authority in the State of California, serving 12,844 residents. 3,083 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — For systems meeting the online eligibility criteria (≤ 38.4 kW AC, single racking/module/inverter model, etc.), Q18 Where you file — iWorq Citizen Portal (marysvilleca.portal.iworq.net), with a dedicated 'Solar Permit Application' entry point distinct from the general building-permit application. Q20

Permit required
Yes95% source
What it costs
Valuation-based, no flat solar line exists. Example: a $20,000 system valuation → Building Permit fee ≈ $476.92 (per the $2,001–$25,000 tier: $102.70 + $20.79/$1,000 over $2,000) + Plan Review at 65%…75% source
Plan review turnaround
For systems meeting the online eligibility criteria (≤ 38.4 kW AC, single racking/module/inverter model, etc.), the city's own portal states the application 'will automatically approve/deny' — i.e.,70% source
Key document
published checklist cited by 7 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 95% · department page
    • What does this authority permit itself, and what does it delegate? Both 82% · municipal code
    • Is a permit required for a residential rooftop PV system? Yes 95% · permit portal
    • Is there a separate electrical permit, or is it combined? Combined 75% · permit portal
    • Is a HOA or architectural approval required first? Only if applicable — no PV-specific trigger found. The general Building Permit Application's Submittal Checklist has a 'Design Review Appl. (if applicable)' line, and MMC Ch. 18.87 Architectural Review governs building/sign design review generally, but no HOA or architectural-review requirement specific to rooftop solar was found (full-text search of 'solar'/'photovoltaic' across the entire code returned zero hits in Ch. 18.87). 55% · application form
    • Is there a historic-district review? Yes, but only for parcels within the codified Historic Preservation Overlay Zone District (MMC Ch. 18.59) — §18.59.030 requires Planning & Historic Preservation Commission (or its Architectural Review subcommittee) approval of exterior work, and explicitly lists 'roofing' as an example of covered work, with no solar/PV exemption found anywhere in Ch. 18.59 or 18.94. Not a citywide requirement. 78% · municipal code
    • Is a wind or windstorm certification required? No 72% · full-text code search (absence)
    • Is a Specific Use Permit or Council approval ever required? No 78% · full-text code search (absence)
    • Is there a system-size cap on residential generation? Two uncoordinated figures found: the city's automated online eligibility path caps residential PV at 38.4 kW AC nameplate (matching the statewide SolarAPP+ ceiling); separately, the older 'Solar Submittal Checklist' states systems larger than 10.0 kW are routed to third-party plan review (a review trigger, not necessarily a hard cap). No zoning-code generation-size cap exists (control-checked full-text search). 82% · permit portal + published checklist
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Who is allowed to pull the electrical permit? Either 92% · municipal code
    • Must the contractor be registered with this authority before applying? Yes (in practice) 62% · permit portal
    • Is a homeowner permitted to self-install and self-permit? Yes 95% · municipal code
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Per the city's own 'Solar Submittal Checklist': signed owner contract; electrical schematic diagram (module wiring, disconnects, grounding/bonding, wire/conduit sizing, rapid shutdown, DC color coding, and battery locations/venting if applicable); site diagram (panel layout, combiner box, inverter, disconnect, main service, setbacks); equipment cut sheets (inverters, modules, generators, transfer switch); labeling schedule per CEC 110.21(B)/690.13/690.31/690.56/705.10/705.12; system kW capacity; engineer-stamped structural plans; PV System Summary; Single Line Diagram; manufacturer information; photos of existing main panel bus rating if reusing it. 92% · published checklist
    • How many copies, and in what format? 2 sets for roof-mount, 3 sets for ground-mount; minimum sheet size 11"x17". 90% · published checklist
    • Is a site plan required, and what must it show? Yes — a site diagram showing arrangement of panels on the roof or ground, location of combiner box, inverter, utility disconnect, main service, approximate distances from panel to all components, dimensioned setbacks to all structures and property lines, and generator/transfer locations if applicable. 90% · published checklist
    • Is a one-line / three-line diagram required? Yes 92% · published checklist
    • Are string and conductor calculations required? Yes 90% · published checklist
    • Is a structural PE stamp required, and at what threshold? Yes — 'Engineer stamp plans for all structurals, with a clear scope of work' is a general submittal item; for ground-mount/wind-generator systems an engineer is explicitly required once the array height exceeds 7 feet from ground to top of array, or wherever ground snow load (Pg) exceeds 50 psf. Separately, the city's automated online eligibility path caps roof-mount system+hardware weight at ≤ 4.0 psf to avoid triggering full structural engineering review. 88% · published checklist
    • Is an electrical PE stamp required, and at what threshold? Yes, for batteries specifically — 'For ALL battery connections: An Electrical Engineer is required.' No PE-stamp threshold is stated for PV-only (non-battery) electrical work. 90% · published checklist
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

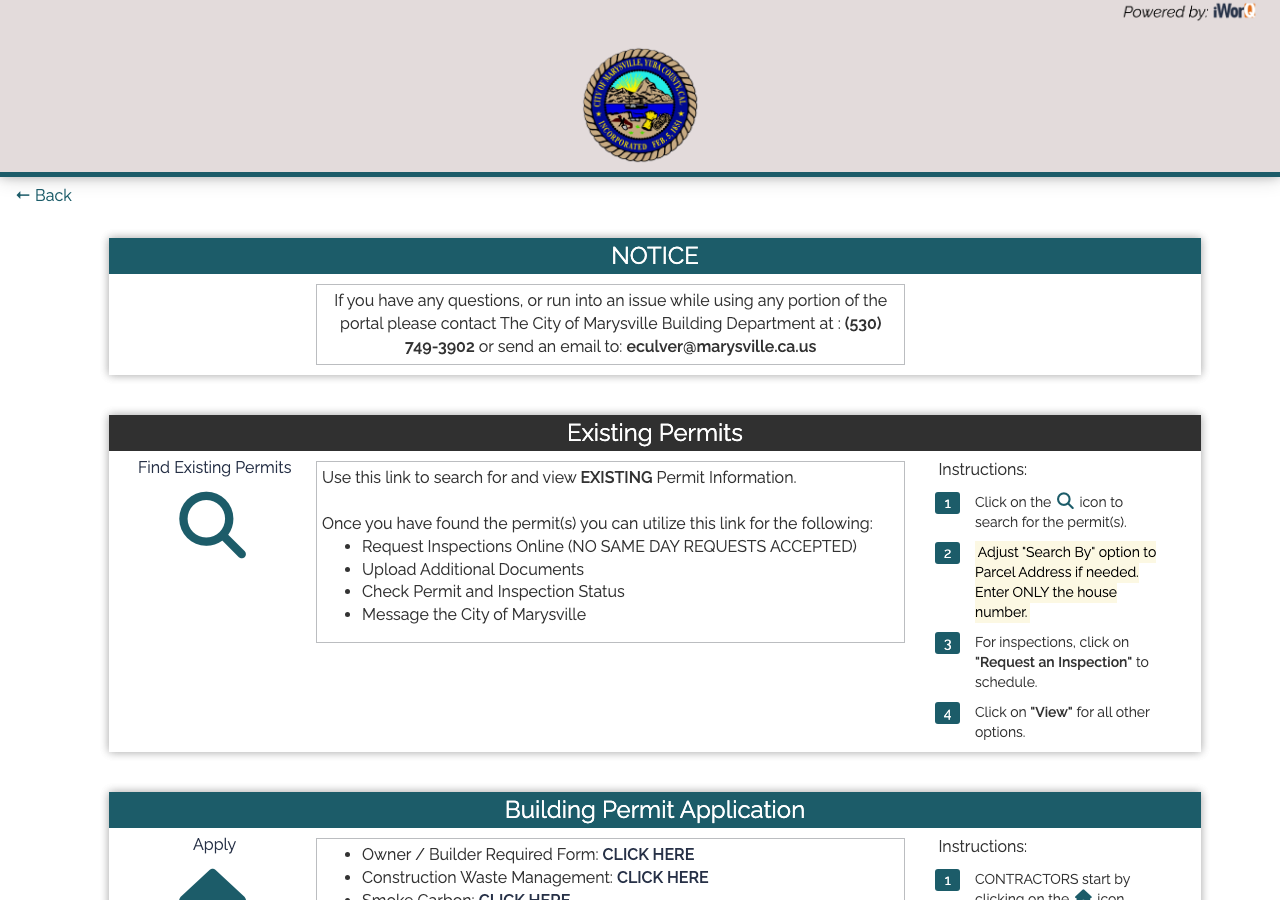

    • Which permit portal does this authority use? iWorq Citizen Portal (marysvilleca.portal.iworq.net), with a dedicated 'Solar Permit Application' entry point distinct from the general building-permit application. 95% · portal landing page
    • Can the whole application be completed online? Yes 95% · permit portal
    • What does a residential solar permit cost? Valuation-based, no flat solar line exists. Example: a $20,000 system valuation → Building Permit fee ≈ $476.92 (per the $2,001–$25,000 tier: $102.70 + $20.79/$1,000 over $2,000) + Plan Review at 65% of that (≈ $310) ≈ $787 total, before any itemized Title 14 electrical fees for panel/service upgrades. 75% · fee schedule
    • How is the fee calculated? Valuation 85% · fee schedule
    • Is there a separate plan-check fee? Yes — 'Structure plan review fees are 65% of the Building Permit Fee.' 90% · fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? For systems meeting the online eligibility criteria (≤ 38.4 kW AC, single racking/module/inverter model, etc.), the city's own portal states the application 'will automatically approve/deny' — i.e., effectively same-day/instant. For systems that don't qualify, the Solar Submittal Checklist states only that 'Solar plans larger than 10.0kW will be sent out to a third party for review,' with no published day-count. 70% · permit portal
    • How long is an issued permit valid before it expires? Not locally amended — defaults to the base 2025 CBC/CRC §105.5 permit-expiration provisions (180 days from issuance, extendable) as adopted wholesale by MMC §13.04.010. 60% · municipal code (inference)
    • Which utility handles interconnection here? Pacific Gas & Electric (PG&E) 68% · inference (no city electric utility found)

28 questions answered against City of Marysville’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherCity's own Building Permit page and Solar Checklist show the city issues residential PV permits directly through its own Building Department and iWorq portal.

department page checked 2026-08-31 https://www.marysville.ca.us/building-permit

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherMMC Title 13 (Buildings and Construction, incl. Ch. 13.20 Fire Code) and Title 14 (Electrical Code) are both adopted and enforced by the city itself — no third-party plan-check/inspection firm found anywhere (no non-city email domain, no staffing-firm name in the fee schedule or portal). Confidence held below 90 because the fire department itself was annexed into Linda FPD on 1 Jul 2026, so 'the fire department' named throughout Ch. 13.20 is now a separate legal agency, even though Building/Electrical remain squarely city functions.

municipal code checked 2026-08-31 https://ecode360.com/48170031

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherThe city runs a dedicated online 'Solar Permit Application' (iWorq) and publishes a 'City of Marysville Solar Submittal Checklist' for the permit package.

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherMMC Title 13 (Building) and Title 14 (Electrical) are technically separate codified permitting chapters (each with its own permit-authority section, 13.04.010 vs 14.12.010), but the city's own online 'Solar Permit Application' captures both a valuation-based 'Project Cost' field (building fee basis) and itemized service-panel/amperage fields (the exact categories used in the Title 14 electrical fee schedule) in a single submission with a single payment step — so in practice residential solar is processed as one combined application.

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherMMC §14.12.030 'Special residential owner's permit' lets a homeowner personally pull an electrical permit for work on their own residence, performed personally by the owner or an immediate family member; §14.12.010 otherwise requires a permit from 'the person, firm or corporation installing the work' (i.e., a licensed contractor).

municipal code checked 2026-08-31 https://ecode360.com/48170406

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Yes (in practice)

Why the confidence is not higherThe city's iWorq 'Solar Permit Application' states: 'A matching contractor must be selected from the search results... If you can't find a linked contractor in the search results, please contact us for assistance' and bars contractors with expired licenses — implying contractors must already be on file with the city before an application can be linked to them. No separate ordinance-level contractor-registration requirement was found (checked MMC Title 5 Business Licenses index and Title 14 Ch.14.08); this is portal-behavior evidence, not a codified rule.

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherMMC §14.12.030 explicitly authorizes a 'special residential owner's permit' for a homeowner to personally install, alter or repair electrical wiring/equipment in their own residence.

municipal code checked 2026-08-31 https://ecode360.com/48170406

Q8 What documents make up a complete submittal? Core Submittal package

Per the city's own 'Solar Submittal Checklist': signed owner contract; electrical schematic diagram (module wiring, disconnects, grounding/bonding, wire/conduit sizing, rapid shutdown, DC color coding, and battery locations/venting if applicable); site diagram (panel layout, combiner box, inverter, disconnect, main service, setbacks); equipment cut sheets (inverters, modules, generators, transfer switch); labeling schedule per CEC 110.21(B)/690.13/690.31/690.56/705.10/705.12; system kW capacity; engineer-stamped structural plans; PV System Summary; Single Line Diagram; manufacturer information; photos of existing main panel bus rating if reusing it.

Why the confidence is not higherDirectly extracted from the city's current linked 'Solar Checklist' .docx (unzipped and read as XML; not a summarized PDF).

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q9 How many copies, and in what format? Submittal package

2 sets for roof-mount, 3 sets for ground-mount; minimum sheet size 11"x17".

Why the confidence is not higherStated verbatim in the Solar Submittal Checklist. The online iWorq application separately accepts PDF uploads only.

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes — a site diagram showing arrangement of panels on the roof or ground, location of combiner box, inverter, utility disconnect, main service, approximate distances from panel to all components, dimensioned setbacks to all structures and property lines, and generator/transfer locations if applicable.

Why the confidence is not higherSolar Submittal Checklist, 'Site diagram' line item.

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes

Why the confidence is not higherChecklist requires both an 'Electrical schematic diagram of the system' and a separate 'Single Line Diagram' line item under the PV System Summary Sheet.

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q12 Are string and conductor calculations required? Drawings & calculations

Yes

Why the confidence is not higherChecklist requires the schematic to show 'wire, conduit type, size, and number of conductors in each section of conduit' and its System Summary Sheet has fields for 'Minimum PV Source Circuit Ampacity or Conductor Sizing', operating voltage/current, and calculated system voltage per CEC 690.7.

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Yes — 'Engineer stamp plans for all structurals, with a clear scope of work' is a general submittal item; for ground-mount/wind-generator systems an engineer is explicitly required once the array height exceeds 7 feet from ground to top of array, or wherever ground snow load (Pg) exceeds 50 psf. Separately, the city's automated online eligibility path caps roof-mount system+hardware weight at ≤ 4.0 psf to avoid triggering full structural engineering review.

Why the confidence is not higherCombines the Solar Submittal Checklist's engineering clauses with the iWorq Solar Permit Application's structural eligibility criteria (both current, first-party documents).

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Yes, for batteries specifically — 'For ALL battery connections: An Electrical Engineer is required.' No PE-stamp threshold is stated for PV-only (non-battery) electrical work.

Why the confidence is not higherSolar Submittal Checklist, general requirements section.

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q15 What does a residential solar permit cost? Core Fees

Valuation-based, no flat solar line exists. Example: a $20,000 system valuation → Building Permit fee ≈ $476.92 (per the $2,001–$25,000 tier: $102.70 + $20.79/$1,000 over $2,000) + Plan Review at 65% of that (≈ $310) ≈ $787 total, before any itemized Title 14 electrical fees for panel/service upgrades.

Why the confidence is not higherThe city's current (revised 16 Jan 2024) Fee Schedule has no 'solar', 'photovoltaic' or 'PV' line at all (control-checked: 'electrical' hit 23+ times, fabricated 'zzqqx' hit 0 times, confirming the search worked) — residential PV permits are billed off the general Building Permit total-valuation table (MMC §13.04.010 authority) using the applicant's declared 'Project Cost', exactly the field on the city's own online Solar Permit Application.

fee schedule checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_4a211cc703b34e51bc2d16fe36b3854b.pdf

Q16 How is the fee calculated? Core Fees

Valuation

Why the confidence is not higherFee schedule's Building Permit and Plan Check section (VI.A) is a sliding total-valuation table; the online Solar Permit Application collects a 'Project Cost' field consistent with this basis. No flat, per-kW, or per-panel PV line exists.

fee schedule checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_4a211cc703b34e51bc2d16fe36b3854b.pdf

Q17 Is there a separate plan-check fee? Fees

Yes — 'Structure plan review fees are 65% of the Building Permit Fee.'

Why the confidence is not higherFee schedule, Building Inspection Services – Plan Review line, immediately under the Building Permit valuation table.

fee schedule checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_4a211cc703b34e51bc2d16fe36b3854b.pdf

Q18 What is the stated plan-review turnaround? Core Timeline & validity

For systems meeting the online eligibility criteria (≤ 38.4 kW AC, single racking/module/inverter model, etc.), the city's own portal states the application 'will automatically approve/deny' — i.e., effectively same-day/instant. For systems that don't qualify, the Solar Submittal Checklist states only that 'Solar plans larger than 10.0kW will be sent out to a third party for review,' with no published day-count.

Why the confidence is not higherCombines the iWorq portal's own description of the automated path with the Solar Checklist's third-party-review trigger; no city document gives a business-day figure for the manual/third-party path.

permit portal checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q19 How long is an issued permit valid before it expires? Timeline & validity

Not locally amended — defaults to the base 2025 CBC/CRC §105.5 permit-expiration provisions (180 days from issuance, extendable) as adopted wholesale by MMC §13.04.010.

Why the confidence is not higherMMC Chapter 13.04 (Building Code) has only 5 codified sections (13.04.010–.050: adoption, work-exempt substitution, certificate-of-occupancy substitution, demolition, demolition fees) and none amends the state model code's permit-validity section, so the base CBC/CRC figure controls by inference from the wholesale-adoption clause, not a locally stated day-count.

municipal code (inference) checked 2026-08-31 https://ecode360.com/48170031

Q20 Which permit portal does this authority use? Core Portal & process

iWorq Citizen Portal (marysvilleca.portal.iworq.net), with a dedicated 'Solar Permit Application' entry point distinct from the general building-permit application.

Why the confidence is not higherCity's own Building Permit page links directly to both the general portal and the solar-specific application URL.

portal landing page checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherThe portal's own instructions: fill out information, attach files, pay fees, and 'this application will automatically approve/deny solar applications' — payment is collected as part of the same online submission.

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q22 Which utility handles interconnection here? Core Utility interconnection

Pacific Gas & Electric (PG&E)

Why the confidence is not higherMarysville has no municipal electric utility (its own fee schedule and utilities pages only cover city water/sewer); it sits inside Yuba County's PG&E service territory. Not independently confirmed from a Marysville-specific or PG&E territory-map page this session — inferred from the absence of any city-operated electric utility plus the surrounding county's confirmed PG&E territory.

inference (no city electric utility found) checked 2026-08-31 https://www.marysville.ca.us/finance-department

Q23 Where does the utility sit in the sequence? Core Utility interconnection

Nothing published by this authority.

Where we lookedCity building-permit, planning/zoning, and finance-department pages, and the Solar Submittal Checklist and iWorq Solar Permit Application — none states where PG&E interconnection sits in the sequence relative to city permitting/inspection (e.g., PTO before or after final). PG&E's own DG/Rule 21 manual (pge.com) was not fetched this session (standing note: pge.com content is a known-difficult automated-read source).

https://www.marysville.ca.us/building-permit

Q24 Is a HOA or architectural approval required first? Overlays & special cases

Only if applicable — no PV-specific trigger found. The general Building Permit Application's Submittal Checklist has a 'Design Review Appl. (if applicable)' line, and MMC Ch. 18.87 Architectural Review governs building/sign design review generally, but no HOA or architectural-review requirement specific to rooftop solar was found (full-text search of 'solar'/'photovoltaic' across the entire code returned zero hits in Ch. 18.87).

Why the confidence is not higherBuilding Permit Application form (submittal checklist section) plus a control-checked full-text search of the codified Architectural Review chapter.

application form checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_21950576913247b893dc87c2b641a702.pdf

Q25 Is there a historic-district review? Overlays & special cases

Yes, but only for parcels within the codified Historic Preservation Overlay Zone District (MMC Ch. 18.59) — §18.59.030 requires Planning & Historic Preservation Commission (or its Architectural Review subcommittee) approval of exterior work, and explicitly lists 'roofing' as an example of covered work, with no solar/PV exemption found anywhere in Ch. 18.59 or 18.94. Not a citywide requirement.

Why the confidence is not higherDirectly from MMC §18.59.030, cross-checked with a full-text 'solar'/'photovoltaic' search across the whole code (only 2 total hits code-wide, neither in Ch. 18.59/18.94), confirming no carve-out exists.

municipal code checked 2026-08-31 https://ecode360.com/48171251

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherFull-text search of the entire codified municipal code for 'windstorm' returned zero hits (positive control 'electrical' returned 10+, fabricated control 'zzqqx' returned 0, confirming the search engine works); California's Title 24 framework does not use a Texas-style wind-certification regime, and no local ordinance was found layering one on.

full-text code search (absence) checked 2026-08-31 https://ecode360.com/search/MA4528

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

No

Why the confidence is not higherA code-wide full-text search for 'solar' (2 hits) and 'photovoltaic' (1 hit) found no zoning provision requiring a Specific Use Permit or Council approval for residential PV — the only two 'solar' hits are a fire-access-road exception (MMC §13.20.050) and an unrelated landscaping 'solar noon' shading rule (§18.86.040). Control-checked with 'electrical' (10+ hits) and 'zzqqx' (0 hits).

full-text code search (absence) checked 2026-08-31 https://ecode360.com/search/MA4528

Q28 Is there a system-size cap on residential generation? Overlays & special cases

Two uncoordinated figures found: the city's automated online eligibility path caps residential PV at 38.4 kW AC nameplate (matching the statewide SolarAPP+ ceiling); separately, the older 'Solar Submittal Checklist' states systems larger than 10.0 kW are routed to third-party plan review (a review trigger, not necessarily a hard cap). No zoning-code generation-size cap exists (control-checked full-text search).

Why the confidence is not higherBoth figures come from the city's own current documents (iWorq portal eligibility criteria vs. the Solar Submittal Checklist), which were not found to be reconciled with each other.

permit portal + published checklist checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2023 97% · municipal code
    • Which building code edition is in force? 2025 California Building Code / California Residential Code (Title 24, Parts 2 and 2.5), effective per Ord. 1464 (12/16/2025). 97% · municipal code
    • Which fire code edition is in force? 2025 California Fire Code (Title 24, Part 9), including Appendix Chapter 4, effective per Ord. 1464 (12/16/2025). 97% · municipal code
    • Are there local amendments to any of the above? Yes 95% · municipal code
    • What is the installation judged against? The 2025 Title 24 code set (CBC/CRC/CEC/CFC) as locally amended in MMC Titles 13 and 14, plus — for the streamlined online path — the city's own iWorq eligibility checklist (System/Structural/Fire/Electrical criteria modeled closely on the statewide SolarAPP+ program). 85% · permit portal
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Solar Submittal Checklist: 'Fire Setbacks – 18in from crest of Roof' for roof-mount PV; solar panels covering more than 50% of total roof area require fire department approval. Separately, MMC §13.20.050(c) allows fire apparatus access roads to 'be permitted to be exempted or modified for solar photovoltaic power generation facilities' (a ground-mount/utility-scale-oriented provision). No broader local pathway amendment beyond base 2025 CFC §1205 was found. 85% · published checklist + municipal code
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Yes, per CEC §690.12 (2023 NEC base, via the 2025 CEC). 95% · published checklist
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? A 'Labeling schedule for equipment and electrical hazard' is required, citing CEC §110.21(B), 690.13, 690.31, 690.56, 705.10, and 705.12 — the city requires compliance with these NEC labeling sections but does not itself list discrete named placards (e.g., no city-specific 'PV DISCONNECT' placard name was found). 80% · published checklist
    • Does the authority specify placard wording of its own? No 75% · published checklist + full-text code search (absence)
    • Is a site plan / facility map placard required, and what must it show? The Solar Checklist's required 'Site diagram' functions as the facility map: it must show arrangement of panels on roof or ground, location of combiner box, inverter, utility disconnect, main service, approximate distances between all components, and dimensioned setbacks to all structures/property lines. No separate, formally named '705.10 placard/map' document was found. 70% · published checklist
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Must equipment be on a specific approved list? Yes 92% · published checklist + permit portal
    • Are batteries permitted, and under what conditions? Yes, under detailed conditions: lithium-ion only; individual battery units < 20 kWh; 80 kWh ESS aggregate capacity cap (location-dependent); ESS must not be installed within habitable space; minimum 3 ft from any door/window entering the dwelling; a listed heat detector interconnected to interior smoke alarms is required if installed in an attached garage; ESS unit(s) must weigh < 400 lbs with center of mass < 4 ft from the floor; an Electrical Engineer is required for all battery connections (per the separate Solar Checklist); ESS must be paired with new PV to use the streamlined path. 92% · permit portal
    • Is there a separate ESS permit or inspection? No — storage is folded into the same 'Solar Permit Application' as an optional 'PV + Storage' configuration rather than issued as a separate ESS permit. 78% · permit portal
    • Is a ground mount treated as a structure? Yes 85% · published checklist + permit portal
    • Is there a local rule on service upgrades or busbar sizing? For the streamlined online path: service ≤ 400A, service disconnect ≤ 200A, busbars ≤ 225A; max 2 DC strings in parallel; one PV module model and up to two string inverters (or one microinverter/AC-module model) per system. 80% · permit portal
    • Is a specific mounting system or attachment spacing required? Engineered or listed racking/attachment system required; for the streamlined path: only one racking model per project, ≤ 10" projection above the roof for flush-mount arrays on pitched (>2/12) roofs, ≥ 7/8" rooftop conduit standoff height, and at least 20% of any tilt-up-mounted array must sit under 2 feet above the roof. Metal roofs and wood shake/shingle roofing are excluded from the streamlined path. 85% · permit portal + published checklist

20 questions answered against City of Marysville’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2023

Why the confidence is not higherMMC §14.04.010: 'The city adopts, by reference, the 2025 California Electrical Code based on the 2023 National Electrical Code... as set forth in California Code of Regulations Title 24, Part 3.' Last amended by Ord. 1464, 16 Dec 2025 (code content flagged 'Recently Changed' as of 4 Aug 2026).

municipal code checked 2026-08-31 https://ecode360.com/48170389

Q30 Which building code edition is in force? Core Code editions in force

2025 California Building Code / California Residential Code (Title 24, Parts 2 and 2.5), effective per Ord. 1464 (12/16/2025).

Why the confidence is not higherMMC §13.04.010, verbatim adoption clause naming Parts 1–12 of the 2025 California Building Standards Code.

municipal code checked 2026-08-31 https://ecode360.com/48170031

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code (Title 24, Part 9), including Appendix Chapter 4, effective per Ord. 1464 (12/16/2025).

Why the confidence is not higherMMC §13.20.010, verbatim adoption clause. (Note: the operating fire department was separately annexed into Linda Fire Protection District effective 1 Jul 2026; the code-adoption chapter itself is unaffected and still names 'the city.')

municipal code checked 2026-08-31 https://ecode360.com/48170063

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherNumerous local amendments exist across Titles 13 and 14 — e.g., §13.04.020 (work exempt from permit, substituting CBC §105.2(1)-(2)), §13.20.040 (spill control amendment to CFC §5703.4), §13.20.049/.050 (fire apparatus access roads, incl. the solar-photovoltaic exemption/modification clause), and Title 14's own permit/fee/inspection chapters layered on the base CEC.

municipal code checked 2026-08-31 https://ecode360.com/48170029

Q33 What is the installation judged against? Core Electrical

The 2025 Title 24 code set (CBC/CRC/CEC/CFC) as locally amended in MMC Titles 13 and 14, plus — for the streamlined online path — the city's own iWorq eligibility checklist (System/Structural/Fire/Electrical criteria modeled closely on the statewide SolarAPP+ program).

Why the confidence is not higherCombines the code-adoption sections with the online portal's published eligibility criteria, both current first-party sources.

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

For the streamlined online path: service ≤ 400A, service disconnect ≤ 200A, busbars ≤ 225A; max 2 DC strings in parallel; one PV module model and up to two string inverters (or one microinverter/AC-module model) per system.

Why the confidence is not higheriWorq Solar Permit Application's published 'Electrical' eligibility criteria list. This is a portal-published eligibility gate rather than a numbered municipal-code section.

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Engineered or listed racking/attachment system required; for the streamlined path: only one racking model per project, ≤ 10" projection above the roof for flush-mount arrays on pitched (>2/12) roofs, ≥ 7/8" rooftop conduit standoff height, and at least 20% of any tilt-up-mounted array must sit under 2 feet above the roof. Metal roofs and wood shake/shingle roofing are excluded from the streamlined path.

Why the confidence is not higherCombines the Solar Submittal Checklist ('engineered or listed racking system') with the iWorq portal's detailed Structural eligibility criteria.

permit portal + published checklist checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Solar Submittal Checklist: 'Fire Setbacks – 18in from crest of Roof' for roof-mount PV; solar panels covering more than 50% of total roof area require fire department approval. Separately, MMC §13.20.050(c) allows fire apparatus access roads to 'be permitted to be exempted or modified for solar photovoltaic power generation facilities' (a ground-mount/utility-scale-oriented provision). No broader local pathway amendment beyond base 2025 CFC §1205 was found.

Why the confidence is not higherThe 18-inch ridge setback and 50%-coverage fire-approval trigger are stated verbatim in the city's own Solar Checklist; the access-road exemption is a codified local amendment, control-checked via full-text search of the entire Fire Code chapter (13.20) for 'solar'/'photovoltaic'.

published checklist + municipal code checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Yes, per CEC §690.12 (2023 NEC base, via the 2025 CEC).

Why the confidence is not higherSolar Checklist requires applicants to 'Identify location and method of rapid shutdown per CEC sec 690.12'; the iWorq portal's Electrical eligibility criteria separately exclude one specific rapid-shutdown method ('No exposed wiring or conductive parts [690.12(B)(2)(3)]') from the streamlined path, confirming rapid shutdown is actively enforced, not just cited.

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

A 'Labeling schedule for equipment and electrical hazard' is required, citing CEC §110.21(B), 690.13, 690.31, 690.56, 705.10, and 705.12 — the city requires compliance with these NEC labeling sections but does not itself list discrete named placards (e.g., no city-specific 'PV DISCONNECT' placard name was found).

Why the confidence is not higherSolar Submittal Checklist, verbatim labeling-schedule line item.

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

No

Why the confidence is not higherThe Solar Checklist references the NEC's own labeling sections (110.21(B), 690.13, 690.31, 690.56, 705.10, 705.12) rather than prescribing its own wording; a code-wide full-text search for 'placard' returned only unrelated hits (disabled-parking placards, sign-code definitions) — control-checked against 'electrical' (10+ hits) and 'zzqqx' (0 hits).

published checklist + full-text code search (absence) checked 2026-08-31 https://ecode360.com/search/MA4528

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSolar Submittal Checklist and a code-wide full-text search for 'placard' — the checklist cites NEC labeling sections (110.21(B), 690.13, 690.31, 690.56, 705.10, 705.12) but never states its own letter height, color, or material spec; the code-wide search returned only unrelated vehicle-placard and sign-code hits.

https://ecode360.com/search/MA4528

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

The Solar Checklist's required 'Site diagram' functions as the facility map: it must show arrangement of panels on roof or ground, location of combiner box, inverter, utility disconnect, main service, approximate distances between all components, and dimensioned setbacks to all structures/property lines. No separate, formally named '705.10 placard/map' document was found.

Why the confidence is not higherSolar Submittal Checklist, 'Site diagram' requirement; the city does not use the term 'facility map' or cite §705.10 directly for this item (705.10/705.12 are cited only in the general labeling-schedule line, Q38).

published checklist checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedCounty/city utility pages naming PG&E as the likely serving utility (see Q22) — PG&E's own interconnection/Rule 21 DG manual was not fetched this session (pge.com is a known-difficult automated-read source), so no utility-specific placard requirement beyond the AHJ's could be confirmed or ruled out.

https://www.pge.com/en/about/doing-business-with-pge/interconnections/net-energy-metering-program.html

Q43 Where must the labels be placed? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSolar Submittal Checklist's labeling-schedule line item cites the governing NEC sections but does not itself state a placement location beyond what those NEC sections already require; no separate city placement diagram or spec was found.

https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q44 Must equipment be on a specific approved list? Equipment listing

Yes

Why the confidence is not higherSolar Checklist: 'Photovoltaic systems shall be Class A listed and labeled for fire classification per UL 1703'; the iWorq portal's Electrical criteria separately require 'Modules and inverters must be listed in the California Energy Commission's database of approved equipment' (and, for storage, that batteries also be CEC-listed).

published checklist + permit portal checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Yes, under detailed conditions: lithium-ion only; individual battery units < 20 kWh; 80 kWh ESS aggregate capacity cap (location-dependent); ESS must not be installed within habitable space; minimum 3 ft from any door/window entering the dwelling; a listed heat detector interconnected to interior smoke alarms is required if installed in an attached garage; ESS unit(s) must weigh < 400 lbs with center of mass < 4 ft from the floor; an Electrical Engineer is required for all battery connections (per the separate Solar Checklist); ESS must be paired with new PV to use the streamlined path.

Why the confidence is not higheriWorq Solar Permit Application's 'System', 'Structural', 'Fire' and 'Electrical' eligibility sections (all '(PV + Storage Only)' line items), cross-checked with the Solar Submittal Checklist's battery-engineer requirement.

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No — storage is folded into the same 'Solar Permit Application' as an optional 'PV + Storage' configuration rather than issued as a separate ESS permit.

Why the confidence is not higherThe iWorq eligibility form's System/Structural/Fire/Electrical sections each embed '(PV + Storage Only)' sub-criteria inside the single Solar Permit Application rather than routing to a distinct ESS application; the fee schedule likewise has no separate ESS permit line (only a general Electrical Code storage-battery rating table).

permit portal checked 2026-08-31 http://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169

Q47 Is a ground mount treated as a structure? Core Ground mount

Yes

Why the confidence is not higherSolar Checklist requires engineering for ground-mount/wind-generator systems once the array height exceeds 7 feet (or wherever ground snow load exceeds 50 psf), including foundation, anchor and hardware details — the same structural-engineering treatment as an accessory structure. The city's automated online eligibility path separately excludes ground-mount systems entirely ('No ground mounted systems'), routing them instead to the standard/manual plan-review track.

published checklist + permit portal checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedCity building-permit and Solar Checklist documents (no AC-disconnect-to-meter placement rule stated); PG&E's own Greenbook/interconnection handbook, which would be the authoritative source for this utility-side requirement, was not fetched this session.

https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Portal 92% · permit portal
    • How much notice is required? At least 1 business day (no same-day requests). 85% · permit portal
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 80% · permit portal
    • If delegated, to whom? N/A — not delegated; performed by the city's own Building Department. 80% · permit portal
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? At minimum, a final inspection is required after installation ('Inspection will be required' — the online Solar Permit Application's own final step); no published multi-stage inspection sequence specific to PV (e.g., rough-in, mid-roof) was found. 55% · permit portal (partial)
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? No dedicated PV inspection checklist — the city's only published PV-related document set (Building Permit Application, Owner/Builder Application, Smoke Detector form, Solar Checklist) is a pre-permit submittal checklist, not an inspection-stage checklist. 68% · department page (absence)
    • Does the inspector verify labels and listings? Likely yes (inferred, not directly stated) 55% · inference from submittal requirements
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final (inspection approval) 50% · inference
    • Is there a re-inspection fee? $66.00 per incident 88% · application form

14 questions answered against City of Marysville’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Portal

Why the confidence is not higheriWorq citizen portal instructions: 'For inspections, click on "Request an Inspection" to schedule' — both under the general permit-search tool and the dedicated 'Search Solar Permits' tool.

permit portal checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q50 How much notice is required? Core Booking & scheduling

At least 1 business day (no same-day requests).

Why the confidence is not higheriWorq portal states plainly: 'Request Inspections Online (NO SAME DAY REQUESTS ACCEPTED)'.

permit portal checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Nothing published by this authority.

Where we lookediWorq citizen portal inspection-scheduling instructions — states only that same-day requests are not accepted; does not describe AM/PM or two-hour scheduling windows.

https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherInspections are requested through the city's own portal against permits issued by 'The City of Marysville Building Department' (per the portal's own contact notice); no third-party inspection firm or delegation was found anywhere on the city's site, fee schedule, or portal.

permit portal checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q53 If delegated, to whom? Core Who inspects

N/A — not delegated; performed by the city's own Building Department.

Why the confidence is not higherSame basis as Q52.

permit portal checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q54 Which inspections are required, and in what order? Core Stages & sequence

At minimum, a final inspection is required after installation ('Inspection will be required' — the online Solar Permit Application's own final step); no published multi-stage inspection sequence specific to PV (e.g., rough-in, mid-roof) was found.

Why the confidence is not higheriWorq portal's Solar Permit Application instructions state only that an inspection will follow approval; no separate PV-specific inspection-sequence document was located on the city's site.

permit portal (partial) checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

Nothing published by this authority.

Where we lookediWorq portal's Solar Permit Application instructions and the general Building Permit page — neither describes a rough-in or mid-roof inspection stage specific to PV; only a single generic 'Inspection will be required' step is stated.

https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q56 Does the inspector verify labels and listings? Core What is checked

Likely yes (inferred, not directly stated)

Why the confidence is not higherEquipment listing (UL 1703, CEC-approved-equipment database) and the labeling schedule are conditions of the permit application itself; no city document explicitly states that the field inspector checks labels/listings at final inspection.

inference from submittal requirements checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_d656d0a0bccc47378d522848bde0dc91.docx?dn=Solar%20Checklist.docx

Q57 Is there a published inspection checklist? Core What is checked

No dedicated PV inspection checklist — the city's only published PV-related document set (Building Permit Application, Owner/Builder Application, Smoke Detector form, Solar Checklist) is a pre-permit submittal checklist, not an inspection-stage checklist.

Why the confidence is not higherReviewed the full document set linked from the city's Building Permit page (5 PDFs/DOCX, all downloaded and extracted directly — none is an inspection checklist); no separate inspections page exists on the city site.

department page (absence) checked 2026-08-31 https://www.marysville.ca.us/building-permit

Q58 What must be on site at inspection? Core Documents on site

Nothing published by this authority.

Where we lookediWorq portal and city Building Permit page — neither publishes a list of documents required to be on-site at the time of a solar inspection (e.g., approved plans, permit card).

https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q59 Is there a re-inspection fee? Corrections & re-inspection

$66.00 per incident

Why the confidence is not higherThe city's current Building Permit Application form states: 'I am aware that I may be subject to a re-inspection fee in the amount of $66, per incident, if [access not provided / job not ready for inspection].' The Master Fee Schedule separately lists a 'Housing reinspection fee' at $66/hr and a general §305(g) reinspection fee at $52/ea, so $66 is the figure tied to the actual permit-application form applicants sign.

application form checked 2026-08-31 https://www.marysville.ca.us/_files/ugd/dbead1_21950576913247b893dc87c2b641a702.pdf

Q60 How are corrections issued and cleared? Corrections & re-inspection

Nothing published by this authority.

Where we lookediWorq portal and Building Permit page — no description found of how correction notices are issued or cleared (likely handled inside the iWorq portal's messaging feature, 'Message the City of Marysville', but no page describes the correction workflow itself).

https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q61 What is issued on pass? Core Final sign-off & PTO

Final (inspection approval)

Why the confidence is not higherNo city document names the specific instrument issued on a passing PV inspection (no 'green tag', 'CO', or 'letter' terminology found for solar specifically); inferred as a standard final-inspection sign-off consistent with the general Building Permit process.

inference checked 2026-08-31 https://marysvilleca.portal.iworq.net/portalhome/marysvilleca

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Nothing published by this authority.

Where we lookedCity building-permit, Solar Checklist, and iWorq portal documents — none states who (installer, homeowner, or AHJ) submits the Permission-to-Operate request to PG&E; PG&E's own NEM/interconnection page, the authoritative source, was not fetched this session.

https://www.pge.com/en/about/doing-business-with-pge/interconnections/net-energy-metering-program.html

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Marysville against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Marysville is the authority having jurisdiction 88% confidence
Holds
Building and Electrical (both self-performed in-house by the Community & Economic Development / Building Department). Fire code adoption is codified in the city's own Title 13 (MMC §13.20), but the operating fire department was, by the city's own 7 Jul 2026 press release, fully annexed into the Linda Fire Protection District effective 1 Jul 2026 — so 'the fire department' referenced throughout MMC 13.20 is now LFPD, though the Fire Chief still uses a @marysville.ca.us email and the code itself has not been amended to name LFPD. Residential PV fire criteria are in practice self-certified through the city's own online solar application, not routed to LFPD separately.
Overridden by
CA Gov. Code §65850.5 / §65850.52 (automated/ministerial permitting mandate for eligible small residential PV) — the city's own iWorq portal implements this directly ("this application will automatically approve/deny solar applications"); CA AB 130 (Stats. 2025, Ch. 22) freezes new more-restrictive local residential amendments 1 Oct 2025–1 Jun 2031.
Why not higher
City's own Building Permit page and Solar Checklist establish the city issues residential building and electrical permits directly (MMC Title 13 Buildings and Construction, Title 14 Electrical Code, both adopted and administered by the city, not the county). Marysville is an incorporated city inside Yuba County and is not part of the county's building department. The fire-department annexation is a genuine, very recent (7/1/2026) jurisdictional change confirmed on the city's own site; Linda Fire Protection District's own homepage has not yet been updated to reflect it, which is itself a finding (source lag, not evidence against the merger).

https://www.marysville.ca.us/fire-department

Permit required
Yes95%
Permit cost
Valuation-based, no flat solar line exists. Example: a $20,000 system valuation → Building Permit fee ≈ $476.92 (per the $2,001–$25,000 tier: $102.70 + $20.79/$1,000 over $2,000) + Plan…75%
Plan review
For systems meeting the online eligibility criteria (≤ 38.4 kW AC, single racking/module/inverter model, etc.),70%
Portal
iWorq Citizen Portal (marysvilleca.portal.iworq.net), with a dedicated 'Solar Permit Application' entry point distinct from the general building-permit application.95%
Electrical code
202397%
Own placard wording
No75%
Booking an inspection
Portal92%
Labels & placards for this authority

Wording 75%

No

Size, colour & material None%

Where they go None%

What the utility wants on top None%

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Yuba County
Regions served
1
Regions covered
City of Marysville · city
Solar Requirements
Authority Contact
Address
526 C Street, Marysville, CA 95901
Main Phone
(530) 749-3901
Building Department
Department
Building Department (Community & Economic Development)
Direct Phone
(530) 749-3901
Portal Software
iWorQ
Booking & Scheduling
Preferred channel
online_portal
Book in advance
next business day
Notes
Uses iWorQ online portal for permit applications and inspection requests. Solar-specific permit application available at https://marysvilleca.portal.iworq.net/MARYSVILLECA/new-permit/602/11169. Portal supports online inspection scheduling (no same-day requests accepted). Permit applications can also be submitted by email to permits@marysville.ca.us. Secondary contact email seen on portal: eculver@marysville.ca.us. Fax: (530) 749-3992. Solar installation checklist available on city website.
