City of Mendota

Fresno County

Verified Aug. 6, 2026

City of Mendota is a city authority in the State of California, serving 12,595 residents. 599 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Not stated for the standard path. For SolarAPP+-eligible systems, review is effectively automated/near-instant once the online eligibility and contractor-license… Q18 Where you file — SolarAPP+ (gosolarapp.org) for eligible residential rooftop PV; for non-eligible or standard submittals, Q20

Permit required
Yes92% source
What it costs
No PV-specific flat fee is published. The city's only located fee document — the 2010 Planning, Engineering & Building Fee Schedule (Ord. Res.50% source
Plan review turnaround
Not stated for the standard path. For SolarAPP+-eligible systems, review is effectively automated/near-instant once the online eligibility and contractor-license checks pass (per the platform's…62% source
Key document
published checklist (absence) + general CA practice cited by 6 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 95% · department page
    • What does this authority permit itself, and what does it delegate? Both 85% · permit application (own document)
    • Is a permit required for a residential rooftop PV system? Yes 92% · department page
    • Is there a separate electrical permit, or is it combined? Combined 80% · permit application (own document)
    • Is a wind or windstorm certification required? No — California does not use a Texas-DOI/TDI-style windstorm certification scheme for residential construction, and no Mendota-specific analog (e.g. a wind-speed engineering certificate) was found in any of the city's solar or building documents. 60% · published checklist (absence) + general CA practice
    • Is a Specific Use Permit or Council approval ever required? Not for a standard residential rooftop PV system. Nothing in the city's Planning Master Application, SolarAPP+ page, or Solar Standard Plan documents routes rooftop solar to a Conditional/Specific Use Permit or City Council hearing; the Planning Master Application's CUP/Variance/Rezone checkboxes are generic development-review categories with no solar carve-in or carve-out mentioned. This is consistent with the statewide ministerial-permitting mandate for small residential rooftop solar under Gov. Code §65850.5/§65850.52. 60% · published application (absence, inferred)
    • Is there a system-size cap on residential generation? No absolute cap on residential system size is published. The city's own pre-approved 'Solar PV Standard Electrical Plan' templates (both Central Inverter and Microinverter versions) are scoped to systems not exceeding 10kW AC output on a 3-wire, ≤225A, 120/240V service — beyond that scope (or with batteries, power optimizers, or transformer-less/micro inverters mismatched to the wrong template), the document states 'Electrical Plan review is required,' i.e. routed to full plan check rather than prohibited. The SolarAPP+ eligibility page separately states 'No maximum size limit is stated in this document; see help.solar-app.org for details.' 82% · published checklist (own document)
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? For the standard (non-SolarAPP+) rooftop path: the city's own 'Solar PV Standard Electrical Plan' (Central Inverter or Microinverter version, chosen by system type), filled in with module/inverter nameplate data, string/conductor counts and sizing calculations, plus 'ALL system installation instructions' to be provided alongside it, plus a roof plan showing equipment/disconnect locations and clearances, plus the general Building Permit Application with owner/contractor/valuation information. For SolarAPP+-eligible systems: the SolarAPP+ online submittal (contractor license, project and system data) plus the resulting Approval Document/Inspection Checklist emailed to the Building Department. 90% · published application/checklist (own document)
    • Is a site plan required, and what must it show? Yes. For general building permits, the city's Plot Plan Sample (Building Permit Application, p.4) requires: lot lines and measurements, all existing/proposed structures and any to be demolished, easements, dimensions and distances between structures and to property lines, driveway location/changes, north arrow, and frontage/adjacent street labels for corner lots. For rooftop PV specifically, the Solar Standard Plan documents additionally require a roof plan 'showing location of all equipment, disconnecting means and required clearances.' 92% · published checklist (own document)
    • Is a one-line / three-line diagram required? Yes 88% · published checklist (own document)
    • Are string and conductor calculations required? Yes 95% · published checklist (own document)
    • Is an electrical PE stamp required, and at what threshold? No explicit PE-stamp threshold is published. Systems that fit within the scope of the city's own pre-engineered 'Solar PV Standard Electrical Plan' (≤10kW AC output, ≤225A 120/240V 3-wire service, crystalline modules, central or micro-inverter, no batteries/power optimizers) can be permitted using that template without an engineer's stamp. The documents state only that systems exceeding this scope require 'Electrical Plan review' — that phrase is not defined as requiring a PE stamp specifically, just full plan check. 55% · published checklist (own document, inferred)
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

    • Which permit portal does this authority use? SolarAPP+ (gosolarapp.org) for eligible residential rooftop PV; for non-eligible or standard submittals, applicants go through the Building Department directly by email (buildingdepartment@cityofmendota.com) or in person at 643 Quince St. No separate general e-permitting portal (e.g. Accela, OpenGov) was found anywhere on the city's site. 90% · portal landing page (own document)
    • Can the whole application be completed online? Yes, for SolarAPP+-eligible systems (fully online via gosolarapp.org, per the city's own 4-step process). Non-eligible systems route through email/in-person submittal to the Building Department, which is not a self-service online application. 85% · portal (own document)
    • What does a residential solar permit cost? No PV-specific flat fee is published. The city's only located fee document — the 2010 Planning, Engineering & Building Fee Schedule (Ord. Res. 10-07, rates effective 24 Apr 2010) — has no solar/PV line at all; a residential PV permit would be charged off its general 'New Construction' valuation table (e.g., a system valued at $20,000 would fall in the '$2,000.01–$25,000.00' tier: $69.25 for the first $2,000 plus $14.00 per additional $1,000 ≈ $321.25), plus a separate plan-review fee. 50% · fee schedule (own document, OCR'd)
    • How is the fee calculated? Valuation 65% · fee schedule (own document, OCR'd)
    • Is there a separate plan-check fee? Yes 80% · fee schedule (own document, OCR'd)
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? Not stated for the standard path. For SolarAPP+-eligible systems, review is effectively automated/near-instant once the online eligibility and contractor-license checks pass (per the platform's normal operation and the city's own 4-step SolarAPP+ process, which moves straight from submittal to emailing the Building Department the approval document). 62% · department page (partial)
    • Which utility handles interconnection here? Pacific Gas and Electric Company (PG&E) 82% · utility tariff / service territory map
    • Where does the utility sit in the sequence? After permit 70% · utility process page

28 questions answered against City of Mendota’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherThe City of Mendota's own Building Department (buildingdepartment@cityofmendota.com, 643 Quince St) issues residential solar permits directly, confirmed by its SolarAPP+ page, its own 'Solar Central Inverter'/'Solar Microinverter' standard-plan applications, and its published Building Permit Application and 2010 Fee Schedule, all of which apply to Mendota addresses.

department page checked 2026-08-31 https://www.cityofmendota.com/solarapp/

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherThe city issues both a single combined Building Permit covering Building/Plumbing/Mechanical/Electrical fee lines (Building Permit Application PDF) and runs its own SolarAPP+ intake at buildingdepartment@cityofmendota.com — no delegation to Fresno County or a contract firm found for building/electrical. (Fire code is separately delegated to Fresno County Fire Protection District — see jurisdiction block.) Held below 90 because no named 'Building Official' appears anywhere on the city's site; only a generic department email and a named Planning Director (Cristian Gonzalez) are published, so in-house self-performance rests on inference from the permit documents rather than a named official.

permit application (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Building-Permit-Application1.pdf

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherBoth the Building Permit Application and the Solar Central Inverter/Microinverter standard-plan applications carry a 'Permit Number' field and instruct the installer to obtain permit approval (via SolarAPP+ or the standard path) before work; the SolarAPP+ page frames the entire 4-step process around obtaining a permit.

department page checked 2026-08-31 https://www.cityofmendota.com/solarapp/

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherThe city's own Building Permit Application PDF lists 'Building Permit, Plumbing, Mechanical, Electrical' fee line items together under one 'Building Permit No.' — one application/permit number covers all trades, including electrical, rather than a separate electrical permit being pulled.

permit application (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Building-Permit-Application1.pdf

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe general Building Permit Application (used for the standard, non-SolarAPP+ path) has both a 'Contractor' field with license number/class and a full 'Owner Builder Declaration' section allowing the property owner to self-perform. The SolarAPP+ page, however, separately states 'Licensed contractors only' as an eligibility requirement for that specific automated path — so an owner-builder can still pull the permit, just not through SolarAPP+ (see Q7).

permit application (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Building-Permit-Application1.pdf

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Nothing published by this authority.

Where we lookedSearched the Building Permit Application (fields are: owner, contractor, CSLB license #, address — no business-license field) and the Finance Department page, which confirms the city administers 'business license' generally but does not state that a business license is a precondition for building/solar permit issuance specifically.

https://www.cityofmendota.com/finance/

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherYes, but only via the standard (non-SolarAPP+) path: the Building Permit Application's Owner Builder Declaration lets the property owner self-perform ('I will perform all the above work personally or through my employees...'). The SolarAPP+ page explicitly excludes this route by requiring 'Licensed contractors only.'

permit application (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Building-Permit-Application1.pdf

Q8 What documents make up a complete submittal? Core Submittal package

For the standard (non-SolarAPP+) rooftop path: the city's own 'Solar PV Standard Electrical Plan' (Central Inverter or Microinverter version, chosen by system type), filled in with module/inverter nameplate data, string/conductor counts and sizing calculations, plus 'ALL system installation instructions' to be provided alongside it, plus a roof plan showing equipment/disconnect locations and clearances, plus the general Building Permit Application with owner/contractor/valuation information. For SolarAPP+-eligible systems: the SolarAPP+ online submittal (contractor license, project and system data) plus the resulting Approval Document/Inspection Checklist emailed to the Building Department.

Why the confidence is not higherDirectly compiled from the city's own Solar Central Inverter / Solar Microinverter Application PDFs (both instruct 'Provide this document to the inspector along with ALL system installation instructions' and a page-9 roof plan requirement) and the SolarAPP+ page's 4-step process.

published application/checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q9 How many copies, and in what format? Submittal package

Nothing published by this authority.

Where we lookedChecked the Building Permit Application, the Solar Central Inverter/Microinverter Applications, and the SolarAPP+ page for a stated number of copies or paper-vs-digital format requirement for the standard (non-SolarAPP+) path; none specify copy count or format (SolarAPP+ itself is fully digital, per Q20/21, but that only covers the automated path).

https://www.cityofmendota.com/wp-content/uploads/2023/07/Building-Permit-Application1.pdf

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes. For general building permits, the city's Plot Plan Sample (Building Permit Application, p.4) requires: lot lines and measurements, all existing/proposed structures and any to be demolished, easements, dimensions and distances between structures and to property lines, driveway location/changes, north arrow, and frontage/adjacent street labels for corner lots. For rooftop PV specifically, the Solar Standard Plan documents additionally require a roof plan 'showing location of all equipment, disconnecting means and required clearances.'

Why the confidence is not higherBoth requirements are stated directly in the city's own documents (generic Plot Plan Sample + solar-specific roof plan instruction).

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Building-Permit-Application1.pdf

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes

Why the confidence is not higherThe city's own 'Solar PV Standard Electrical Plan' (Central Inverter and Microinverter versions) is itself a fill-in-the-blank one-line-style electrical plan (string counts, conductor sizing, inverter/disconnect layout) that must be completed and given to the inspector; the document states that installations exceeding its scope (over 10kW AC / 225A 3-wire 120/240V service, batteries, power optimizers, transformer-less/micro inverters mixed with the wrong template) require full 'Electrical Plan review' instead, implying a project-specific diagram at that point.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q12 Are string and conductor calculations required? Drawings & calculations

Yes

Why the confidence is not higherThe Solar Central Inverter Application walks the applicant through Voc/Isc-based DC system voltage and current calculations, conductor sizing via its own ampacity Table A, combiner/output-circuit sizing, and OCPD/fuse sizing; the Microinverter version requires equivalent branch-circuit current and conductor-size calculations.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Nothing published by this authority.

Where we lookedSearched both the Solar Central Inverter and Solar Microinverter Standard Electrical Plan documents (both are purely electrical, with no structural/mounting section or PE-stamp language at all), the Building Permit Application, and the 2010 Fee/Building Permit schedule; no structural PE-stamp requirement or valuation/weight threshold for residential PV was found in any Mendota document.

https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

No explicit PE-stamp threshold is published. Systems that fit within the scope of the city's own pre-engineered 'Solar PV Standard Electrical Plan' (≤10kW AC output, ≤225A 120/240V 3-wire service, crystalline modules, central or micro-inverter, no batteries/power optimizers) can be permitted using that template without an engineer's stamp. The documents state only that systems exceeding this scope require 'Electrical Plan review' — that phrase is not defined as requiring a PE stamp specifically, just full plan check.

Why the confidence is not higherInferred from the scope-boundary language repeated in both Standard Electrical Plan documents; neither document nor the Building Permit Application states a PE-stamp trigger in so many words.

published checklist (own document, inferred) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q15 What does a residential solar permit cost? Core Fees

No PV-specific flat fee is published. The city's only located fee document — the 2010 Planning, Engineering & Building Fee Schedule (Ord. Res. 10-07, rates effective 24 Apr 2010) — has no solar/PV line at all; a residential PV permit would be charged off its general 'New Construction' valuation table (e.g., a system valued at $20,000 would fall in the '$2,000.01–$25,000.00' tier: $69.25 for the first $2,000 plus $14.00 per additional $1,000 ≈ $321.25), plus a separate plan-review fee.

Why the confidence is not higherThe fee schedule was fetched and OCR'd in full (it is an image-only scan); it contains detailed Planning, Engineering and Building Permit fee tables but zero mention of 'solar' or 'photovoltaic' anywhere (checked against a positive control — dozens of other line items extract cleanly — and a fabricated control returns nothing). Confidence is capped at 50 because this schedule is now 16 years old and Council fees are commonly re-adopted annually in California cities, so a newer schedule may exist that this session could not locate (no newer fee PDF is linked from the city's Public Documents page).

fee schedule (own document, OCR'd) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/09/Planning-Engineering-Building-Fee-Schedule.pdf

Q16 How is the fee calculated? Core Fees

Valuation

Why the confidence is not higherWith no PV-specific line, the 2010 fee schedule's 'New Construction' table computes the Building Permit fee from declared/contract project valuation via a tiered dollar formula; there is no per-kW or per-panel line anywhere in the schedule.

fee schedule (own document, OCR'd) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/09/Planning-Engineering-Building-Fee-Schedule.pdf

Q17 Is there a separate plan-check fee? Fees

Yes

Why the confidence is not higherThe same fee schedule's 'Plan Review Fees' section states a Single-family-dwelling plan-review fee of 65% of the building permit fee (25% for residential remodels), charged separately from the permit fee itself.

fee schedule (own document, OCR'd) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/09/Planning-Engineering-Building-Fee-Schedule.pdf

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Not stated for the standard path. For SolarAPP+-eligible systems, review is effectively automated/near-instant once the online eligibility and contractor-license checks pass (per the platform's normal operation and the city's own 4-step SolarAPP+ process, which moves straight from submittal to emailing the Building Department the approval document).

Why the confidence is not higherNo turnaround figure (e.g., 'X business days') is published anywhere on the city's Building & Planning or Solar pages for the standard/manual review path; the SolarAPP+ timing is inferred from the platform's normal automated behavior and the absence of any manual-review step in the city's own 4-step description.

department page (partial) checked 2026-08-31 https://www.cityofmendota.com/solarapp/

Q19 How long is an issued permit valid before it expires? Timeline & validity

Nothing published by this authority.

Where we lookedChecked the SolarAPP+ page, the Solar Central Inverter/Microinverter applications and the Building Permit Application for a stated permit-expiration/validity period; none give one. Mendota's own building-code adoption ordinance (which would set or confirm the CBC/CRC default expiration period, typically 180 days) could not be retrieved — the city's Municode Library page (confirmed live, titled 'Code of Ordinances | Mendota, CA') is an Angular single-page app that never rendered chapter content in headless Chrome after 45 seconds of both virtual-time-budget and real-clock rendering, and no alternate codifier host (codepublishing.com, qcode.us — Cloudflare-blocked, ecode360) was found to mirror it.

https://library.municode.com/ca/mendota/codes/code_of_ordinances

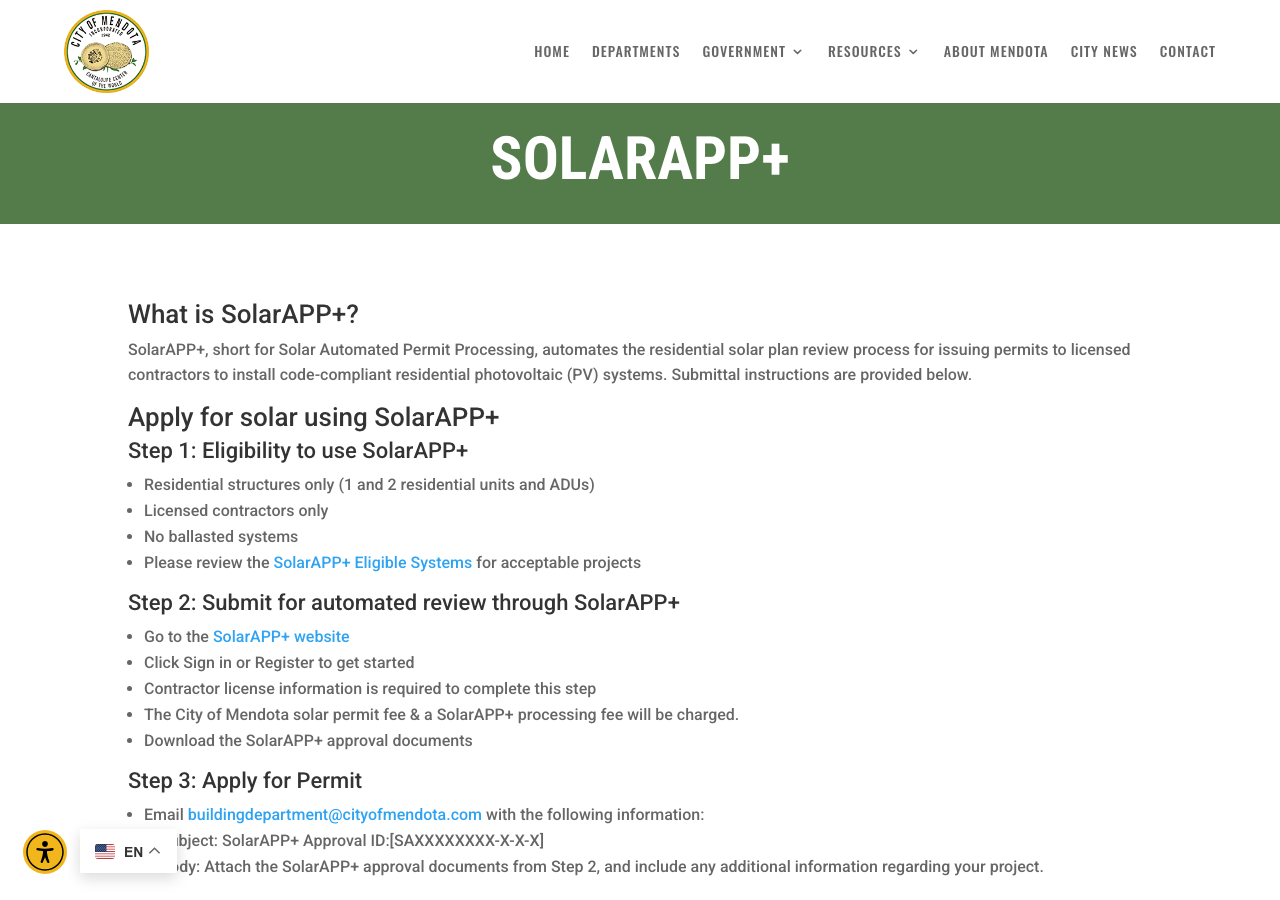

Q20 Which permit portal does this authority use? Core Portal & process

SolarAPP+ (gosolarapp.org) for eligible residential rooftop PV; for non-eligible or standard submittals, applicants go through the Building Department directly by email (buildingdepartment@cityofmendota.com) or in person at 643 Quince St. No separate general e-permitting portal (e.g. Accela, OpenGov) was found anywhere on the city's site.

Why the confidence is not higherDirectly and only described on the city's own SolarAPP+ page; the sitemap and Building & Planning page show no other permitting portal link.

portal landing page (own document) checked 2026-08-31 https://www.cityofmendota.com/solarapp/

Q21 Can the whole application be completed online? Core Portal & process

Yes, for SolarAPP+-eligible systems (fully online via gosolarapp.org, per the city's own 4-step process). Non-eligible systems route through email/in-person submittal to the Building Department, which is not a self-service online application.

Why the confidence is not higherDirectly stated in the city's SolarAPP+ process description.

portal (own document) checked 2026-08-31 https://www.cityofmendota.com/solarapp/

Q22 Which utility handles interconnection here? Core Utility interconnection

Pacific Gas and Electric Company (PG&E)

Why the confidence is not higherPG&E's own CPUC electric-service-territory tariff map has already been verified (in the companion Fresno County GovBot run) to name Mendota specifically, among the Fresno County communities it serves. The City of Mendota's own site does not itself name an electric utility (its 'Public Utilities' page covers only city-run water and sewer service; a site search for 'PG&E' returns zero results), so this is a utility-side rather than a city-side confirmation.

utility tariff / service territory map checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_MAPS_Service%20Area%20Map.pdf

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit

Why the confidence is not higherPG&E's own 5-step residential-solar process places 'City/County Inspection' (step 4 — the system 'must pass city or county inspections for safety and code compliance') before 'PG&E Engineering Review & PTO' (step 5), where the contractor submits the Interconnection Application together with 'a copy of the final building permit.' PTO issuance therefore necessarily follows the local permit's finalization, even though the interconnection application itself can be filed earlier in parallel.

utility process page checked 2026-08-31 https://www.pge.com/en/clean-energy/solar/getting-started-with-solar.html

Q24 Is a HOA or architectural approval required first? Overlays & special cases

Nothing published by this authority.

Where we lookedSearched the city's Planning Master Application, the Solar Central Inverter/Microinverter Applications and the SolarAPP+ page for any HOA or architectural-review gate specific to solar; none is mentioned. Could not search the codified Mendota Municipal Code itself for a zoning/HOA provision because Municode's Angular library page for Mendota does not render content to automated fetch (see Q19 note); CA Civil Code §714 (Solar Rights Act) separately limits private HOA/CC&R solar restrictions statewide, but that is state law, not confirmation of a city-imposed gate.

https://www.cityofmendota.com/wp-content/uploads/2023/07/City-of-Mendota-Planning-Application.pdf

Q25 Is there a historic-district review? Overlays & special cases

Nothing published by this authority.

Where we lookedSame limitation as Q24 — the Municode-hosted Municipal Code could not be rendered this session, so any historic-district overlay provision could not be checked. The city's own Planning Master Application lists generic entitlement types (Plan Amendment, Site Plan Review, Variance, CUP, etc.) but none specific to a historic-resource review for solar.

https://library.municode.com/ca/mendota/codes/code_of_ordinances

Q26 Is a wind or windstorm certification required? Overlays & special cases

No — California does not use a Texas-DOI/TDI-style windstorm certification scheme for residential construction, and no Mendota-specific analog (e.g. a wind-speed engineering certificate) was found in any of the city's solar or building documents.

Why the confidence is not higherInferred from the general absence of any wind-certification language in the Solar Central Inverter/Microinverter Applications or Building Permit Application, combined with the general fact that TDI windstorm certification is a Texas coastal-insurance mechanism with no California counterpart.

published checklist (absence) + general CA practice checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Not for a standard residential rooftop PV system. Nothing in the city's Planning Master Application, SolarAPP+ page, or Solar Standard Plan documents routes rooftop solar to a Conditional/Specific Use Permit or City Council hearing; the Planning Master Application's CUP/Variance/Rezone checkboxes are generic development-review categories with no solar carve-in or carve-out mentioned. This is consistent with the statewide ministerial-permitting mandate for small residential rooftop solar under Gov. Code §65850.5/§65850.52.

Why the confidence is not higherInferred from the absence of any CUP/Council-approval language in the city's own solar-specific documents, plus the general statewide ministerial-review rule; the city's own zoning ordinance itself (which would state this definitively) could not be retrieved due to the Municode rendering issue.

published application (absence, inferred) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/City-of-Mendota-Planning-Application.pdf

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No absolute cap on residential system size is published. The city's own pre-approved 'Solar PV Standard Electrical Plan' templates (both Central Inverter and Microinverter versions) are scoped to systems not exceeding 10kW AC output on a 3-wire, ≤225A, 120/240V service — beyond that scope (or with batteries, power optimizers, or transformer-less/micro inverters mismatched to the wrong template), the document states 'Electrical Plan review is required,' i.e. routed to full plan check rather than prohibited. The SolarAPP+ eligibility page separately states 'No maximum size limit is stated in this document; see help.solar-app.org for details.'

Why the confidence is not higherDirectly stated in both the Solar Central Inverter/Microinverter Applications and the SolarAPP+ page.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which fire code edition is in force? 2025 California Fire Code (Cal. Code Regs. Title 24, Part 9) 75% · adopting ordinance (fire AHJ's own document)
    • Are there local amendments to any of the above? Yes, on the fire side: FCFPD's Ordinance 2025-04 amends nine sections/appendices of the 2025 CFC (§101.1 jurisdiction name, §104.9.2 policy-compliance clause, §113.4 penalty amounts, §507.2.3 reservoir standards, §5704.2.9.6.1/§5706.2.4.4/§6104.2 tank-storage-limit language, Appendix A board-of-appeals procedure, and Appendix R — a utility-scale photovoltaic/battery-energy-storage fire-impact mitigation fee schedule for grid-scale solar farms, not residential rooftop PV). None of these amendments touch residential rooftop-PV ridge setbacks, pathways, or rapid shutdown. Whether the City of Mendota's own building/electrical code adoption carries local amendments could not be confirmed (Municode inaccessible, as in Q29/Q30). 68% · adopting ordinance (fire AHJ's own document)
    • What is the installation judged against? A residential PV installation in Mendota is judged against: (1) the city's own 'Solar PV Standard Electrical Plan' (Central Inverter or Microinverter version) for systems within its 10kW AC / 225A scope, or full Electrical Plan review otherwise; (2) whatever edition of the California Building/Residential/Electrical Code the city has adopted by reference (not independently confirmed this session — see Q29/Q30); and (3) for fire, the 2025 California Fire Code as adopted and locally amended by Fresno County Fire Protection District (Ord. 2025-04). 58% · composite (own documents + fire AHJ ordinance)
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Not established by either potential AHJ for residential rooftop PV. The city's own solar documents are purely electrical and contain no ridge-setback or fire-access-pathway language, and Fresno County Fire Protection District — which serves Mendota by name for fire — has zero PV/solar/battery category anywhere in its current (1 Jul 2026) Protection & Planning Fee Schedule or its Fire Permit Application submittal-type list, and its 2025 CFC local amendments (Ord. 2025-04) do not touch residential PV pathways/setbacks at all. 68% · fire AHJ's own documents (control-proven absence)
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Not addressed in the city's own current solar documents, which predate rapid shutdown. Both the 'Solar PV Standard Electrical Plan – Central Inverter' and '– Microinverter' documents state verbatim that they address 'only the requirements of the 2010 California Electrical Code (CEC)' and contain zero occurrences of 'rapid shutdown' or CEC/NEC §690.12 (grep'd across the full OCR'd text of both 9-page documents, with a passing positive control of 26 hits on other '690.x' section citations and 0 hits on a fabricated 'zzqqx' control). The 2010 CEC predates NEC/CEC §690.12 rapid-shutdown provisions entirely (first introduced in the 2014 NEC / 2016 CEC), so these are stale templates on this point. Whatever edition of the CEC the city has actually and currently adopted (not independently confirmed — see Q29) would still require rapid shutdown as a matter of state law regardless of what these handouts say; field inspectors likely still enforce it even though the department's own written guidance has not been updated. 68% · published checklist (own document, control-proven)
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? At the PV DC disconnecting means: a permanent label showing rated max power-point current, rated max power-point voltage, maximum system voltage, and PV short-circuit current (CEC §690.53 wording, on a 'phenolic plaque with contrasting colors'). At/near the AC output/interconnection point: a 'PV SYSTEM AC DISCONNECT' placard (rated AC output current, AC normal operating voltage, §690.54), a 'DUAL POWER SOURCES' warning placard, an 'ELECTRIC SHOCK HAZARD' warning at the inverter, and (where the backfed OCPD is not at the opposite end of the main breaker) a 'WARNING INVERTER OUTPUT CONNECTION – DO NOT RELOCATE THIS OVERCURRENT DEVICE' label (§690.64(B)(7)/705.12(D)(7)). A permanent exterior-mounted directory/plaque is also required showing the location of the service disconnect and the PV system disconnect if not co-located. 90% · published checklist (own document)
    • Does the authority specify placard wording of its own? Yes 92% · published checklist (own document)
    • Does it specify letter height, colour or material? Letter height: minimum 20-point type (≈⅜ inch), stated for both the DC-disconnect power-source label and the exterior directory/plaque. Colour/material: 'a phenolic plaque with contrasting colors between the text and background' meets the intent of the code — i.e. high contrast is required but no single mandated colour scheme (e.g. red/white) is specified in the text. 85% · published checklist (own document)
    • Is a site plan / facility map placard required, and what must it show? Yes. A permanent plaque or directory must be installed (mounted on the exterior of the building) providing the location of the service disconnecting means and the PV system disconnecting means, if not installed at the same location. 85% · published checklist (own document)
    • Where must the labels be placed? DC disconnect label: at the PV DC disconnecting means. AC/system labels: at the PV system AC disconnect / point of interconnection, and (for the exterior directory/plaque) mounted on the exterior of the building, at the same location as the main service disconnect where possible. The AC wiring sequence in the city's own document runs inverter(s) → [solar load center] → utility performance meter (if required) → utility safety disconnect switch → house electrical panel, which is where the corresponding placards attach. 80% · published checklist (own document)
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Where must the AC disconnect be, relative to the meter? Downstream of the utility's performance meter and upstream of the house's main electrical panel. The city's own Standard Electrical Plan describes the sequence: inverter(s) output → (a 'solar load center' collecting multiple central-inverter circuits, if applicable) → utility performance meter (if required by the local utility) → utility safety disconnect switch (if required) → point of interconnection at the house electrical panel; 'No electrical loads shall be connected between the output of the inverter and the connection to the house electrical panel.' 80% · published checklist (own document)
    • Must equipment be on a specific approved list? Yes 90% · published checklist (own document)
    • Are batteries permitted, and under what conditions? Batteries are not addressed by any dedicated Mendota ordinance or fee line found; they are explicitly excluded from the scope of the city's own pre-approved Standard Electrical Plan templates ('This plan is NOT intended... for systems containing batteries or power optimizer' / 'This plan is not intended for systems containing batteries'), meaning a battery-equipped system cannot use the streamlined standard-plan path and instead requires full Electrical Plan review. No separate city or Fresno County Fire Protection District battery/ESS ordinance, fee, or permit type was found (FCFPD's current fee schedule and fire-permit submittal-type list both control-checked with zero battery/ESS/energy-storage hits, apart from an unrelated fire-alarm-panel battery-backup line). 75% · published checklist (own document) + fire AHJ absence
    • Is there a separate ESS permit or inspection? No dedicated ESS permit or inspection type is published by either agency. The City's Standard Electrical Plan documents simply exclude battery systems from their scope (routing them to ordinary Electrical Plan review, not a distinct ESS permit), and Fresno County Fire Protection District's own Fire Permit Application submittal-type checklist (Plans for Fire Apparatus Access/Site Water Supply, Building Final, Underground Water Delivery, Fire Pump, Commercial/Residential Fire Sprinkler, Clean Agent System, Hood Suppression, Fire Alarm, Other) has no battery/ESS category at all. 72% · fire AHJ's own document (control-proven absence) + city documents

20 questions answered against City of Mendota’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

Nothing published by this authority.

Where we lookedThe city's Municode Library page (confirmed live, titled 'Code of Ordinances | Mendota, CA') is an Angular single-page app that never hydrated chapter content in headless Chrome after 45 seconds of virtual-time-budget rendering, so the currently-adopted NEC/CEC edition could not be confirmed from the ordinance itself; no alternate codifier host was found. Note as a related but distinct finding (see Q37): the city's own current 'Solar PV Standard Electrical Plan' documents (Central Inverter and Microinverter, both still the live linked applications on cityofmendota.com as of Aug 2026) state verbatim that they address 'only the requirements of the 2010 California Electrical Code (CEC)' — which would be roughly six California code cycles behind the 2023 NEC-based CEC that took effect statewide in the 2025 Title 24 cycle (1 Jan 2026).

https://library.municode.com/ca/mendota/codes/code_of_ordinances

Q30 Which building code edition is in force? Core Code editions in force

Nothing published by this authority.

Where we lookedSame limitation as Q29 — the city's own Building Code adoption chapter could not be retrieved via Municode (Angular shell did not hydrate) and no alternate host was found.

https://library.municode.com/ca/mendota/codes/code_of_ordinances

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code (Cal. Code Regs. Title 24, Part 9)

Why the confidence is not higherFresno County Fire Protection District (FCFPD) — which names 'the Cities of San Joaquin, Parlier, Mendota, Fowler and Huron' by name as served, alongside unincorporated communities, on its own About Us page — adopted the 2025 CFC by Ordinance 2025-04, effective 1 Feb 2026. This is the fire code in force for the agency providing fire service to Mendota; held at 75 rather than higher because I could not independently retrieve the City of Mendota's own municipal-code cross-reference ordinance ratifying/adopting FCFPD's code (Municode rendering issue, as in Q29/Q30), so the city-side half of this delegation is inferred rather than directly read.

adopting ordinance (fire AHJ's own document) checked 2026-08-31 https://www.fresnocountyfire.org/files/2d5ae14c7/Ordinance+2025-04+Adoption+of+the+CFC+signed.pdf

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes, on the fire side: FCFPD's Ordinance 2025-04 amends nine sections/appendices of the 2025 CFC (§101.1 jurisdiction name, §104.9.2 policy-compliance clause, §113.4 penalty amounts, §507.2.3 reservoir standards, §5704.2.9.6.1/§5706.2.4.4/§6104.2 tank-storage-limit language, Appendix A board-of-appeals procedure, and Appendix R — a utility-scale photovoltaic/battery-energy-storage fire-impact mitigation fee schedule for grid-scale solar farms, not residential rooftop PV). None of these amendments touch residential rooftop-PV ridge setbacks, pathways, or rapid shutdown. Whether the City of Mendota's own building/electrical code adoption carries local amendments could not be confirmed (Municode inaccessible, as in Q29/Q30).

Why the confidence is not higherDirectly read from the OCR'd text of FCFPD's own signed Ordinance 2025-04; the building/electrical half of the answer is a genuine gap, not an inferred 'no.'

adopting ordinance (fire AHJ's own document) checked 2026-08-31 https://www.fresnocountyfire.org/files/2d5ae14c7/Ordinance+2025-04+Adoption+of+the+CFC+signed.pdf

Q33 What is the installation judged against? Core Electrical

A residential PV installation in Mendota is judged against: (1) the city's own 'Solar PV Standard Electrical Plan' (Central Inverter or Microinverter version) for systems within its 10kW AC / 225A scope, or full Electrical Plan review otherwise; (2) whatever edition of the California Building/Residential/Electrical Code the city has adopted by reference (not independently confirmed this session — see Q29/Q30); and (3) for fire, the 2025 California Fire Code as adopted and locally amended by Fresno County Fire Protection District (Ord. 2025-04).

Why the confidence is not higherAssembled from three separately-sourced facts (own solar standard-plan documents; general statewide Title-24-by-reference practice, unconfirmed for Mendota specifically; and FCFPD's own fire-code ordinance) rather than stated in one place by the city itself.

composite (own documents + fire AHJ ordinance) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Nothing published by this authority.

Where we lookedThe city's Solar Central Inverter Application cites the 120%-rule busbar calculation (CEC §690.64(B)(2)) in full, but this is the state Electrical Code's own provision, not a Mendota-specific local amendment; no local service-upgrade or busbar-sizing amendment was found in any Mendota document, and the adoption ordinance itself could not be retrieved to check for one (Municode issue, as in Q29/Q30).

https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Nothing published by this authority.

Where we lookedBoth Solar Standard Electrical Plan documents (Central Inverter and Microinverter) are purely electrical — conductor sizing, grounding, signage — with no mounting-system, attachment-spacing, or roof-structural section at all (unlike, e.g., Madera's separate 'Solar Structural Criteria' document, no equivalent PDF is linked from Mendota's Public Documents page).

https://www.cityofmendota.com/public-documents/

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Not established by either potential AHJ for residential rooftop PV. The city's own solar documents are purely electrical and contain no ridge-setback or fire-access-pathway language, and Fresno County Fire Protection District — which serves Mendota by name for fire — has zero PV/solar/battery category anywhere in its current (1 Jul 2026) Protection & Planning Fee Schedule or its Fire Permit Application submittal-type list, and its 2025 CFC local amendments (Ord. 2025-04) do not touch residential PV pathways/setbacks at all.

Why the confidence is not higherControl-checked absence across two separately-run first-party document sets: FCFPD's Fire Permit Application (submittal types checked: 'sprinkler' appears twice as a positive control, 'solar'/'photovoltaic'/'zzqqx' all return zero) and its 2026 Fee Schedule (positive control 'sprinkler' ×8, fabricated control 'zzqqx' ×0). This proves no PV-pathway rule exists in either document set reached this session; it does not rule out a generic CRC/CFC baseline pathway requirement that might apply regardless of local amendment, which I could not independently verify for whichever edition the City itself has adopted (see Q30).

fire AHJ's own documents (control-proven absence) checked 2026-08-31 https://www.fresnocountyfire.org/files/386660eb2/FIRE+PERMIT+APPLICATION.pdf

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Not addressed in the city's own current solar documents, which predate rapid shutdown. Both the 'Solar PV Standard Electrical Plan – Central Inverter' and '– Microinverter' documents state verbatim that they address 'only the requirements of the 2010 California Electrical Code (CEC)' and contain zero occurrences of 'rapid shutdown' or CEC/NEC §690.12 (grep'd across the full OCR'd text of both 9-page documents, with a passing positive control of 26 hits on other '690.x' section citations and 0 hits on a fabricated 'zzqqx' control). The 2010 CEC predates NEC/CEC §690.12 rapid-shutdown provisions entirely (first introduced in the 2014 NEC / 2016 CEC), so these are stale templates on this point. Whatever edition of the CEC the city has actually and currently adopted (not independently confirmed — see Q29) would still require rapid shutdown as a matter of state law regardless of what these handouts say; field inspectors likely still enforce it even though the department's own written guidance has not been updated.

Why the confidence is not higherThe '2010 CEC, no §690.12' finding is directly proven from the city's own documents with passing controls; the overlay conclusion that rapid shutdown nonetheless legally applies is an inference from general California code-adoption practice, not a Mendota-specific citation.

published checklist (own document, control-proven) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

At the PV DC disconnecting means: a permanent label showing rated max power-point current, rated max power-point voltage, maximum system voltage, and PV short-circuit current (CEC §690.53 wording, on a 'phenolic plaque with contrasting colors'). At/near the AC output/interconnection point: a 'PV SYSTEM AC DISCONNECT' placard (rated AC output current, AC normal operating voltage, §690.54), a 'DUAL POWER SOURCES' warning placard, an 'ELECTRIC SHOCK HAZARD' warning at the inverter, and (where the backfed OCPD is not at the opposite end of the main breaker) a 'WARNING INVERTER OUTPUT CONNECTION – DO NOT RELOCATE THIS OVERCURRENT DEVICE' label (§690.64(B)(7)/705.12(D)(7)). A permanent exterior-mounted directory/plaque is also required showing the location of the service disconnect and the PV system disconnect if not co-located.

Why the confidence is not higherAll wording, citations and placement fully itemized and illustrated (including sample placard graphics) in the city's own Solar Central Inverter and Microinverter Standard Electrical Plan documents.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Yes

Why the confidence is not higherThe city's own documents give verbatim required wording for every placard: e.g. 'WARNING LINE AND LOAD TERMINALS MAY BE ENERGIZED IN THE OPEN POSITION', 'WARNING DUAL POWER SOURCES – SECOND SOURCE IS PHOTO-VOLTAIC SYSTEM', 'PV SYSTEM AC DISCONNECT', 'PV SYSTEM DC DISCONNECT', 'WARNING INVERTER OUTPUT CONNECTION – DO NOT RELOCATE THIS OVERCURRENT DEVICE', and the exterior directory/plaque wording describing the location of the service and PV disconnecting means.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Letter height: minimum 20-point type (≈⅜ inch), stated for both the DC-disconnect power-source label and the exterior directory/plaque. Colour/material: 'a phenolic plaque with contrasting colors between the text and background' meets the intent of the code — i.e. high contrast is required but no single mandated colour scheme (e.g. red/white) is specified in the text.

Why the confidence is not higherBoth figures quoted directly from the city's own Standard Electrical Plan documents ('20 point (3/8”) should be considered the minimum' and 'Minimum 20 point type on a sharply contrasting background').

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Yes. A permanent plaque or directory must be installed (mounted on the exterior of the building) providing the location of the service disconnecting means and the PV system disconnecting means, if not installed at the same location.

Why the confidence is not higherItem 28 of the city's Solar Microinverter Standard Electrical Plan states this requirement verbatim, citing CEC §690.56(B)/705.10; the Central Inverter version contains the equivalent directory-placard sample.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Microinverter-Application.pdf

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedThe city's own solar documents reference a 'Utility Performance Meter (if required)' and 'Utility Safety Switch (if required)' generically but do not reproduce PG&E's own signage requirements from its Distribution Interconnection Handbook / Greenbook; that document was not independently pulled and checked for a placard specification in this run.

https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

DC disconnect label: at the PV DC disconnecting means. AC/system labels: at the PV system AC disconnect / point of interconnection, and (for the exterior directory/plaque) mounted on the exterior of the building, at the same location as the main service disconnect where possible. The AC wiring sequence in the city's own document runs inverter(s) → [solar load center] → utility performance meter (if required) → utility safety disconnect switch → house electrical panel, which is where the corresponding placards attach.

Why the confidence is not higherDirectly described across items 22–28 of the city's own Solar Central Inverter and Microinverter Standard Electrical Plan documents.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q44 Must equipment be on a specific approved list? Equipment listing

Yes

Why the confidence is not higherThe Standard Electrical Plan documents require the inverter to be 'listed and labeled by a recognized testing agency,' each microinverter to be 'listed by a recognized listing agency,' any combiner box to be 'listed by a recognized listing agency and labeled as such,' and manufacturer-supplied trunk cables to be 'listed by a recognized listing agency.'

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Batteries are not addressed by any dedicated Mendota ordinance or fee line found; they are explicitly excluded from the scope of the city's own pre-approved Standard Electrical Plan templates ('This plan is NOT intended... for systems containing batteries or power optimizer' / 'This plan is not intended for systems containing batteries'), meaning a battery-equipped system cannot use the streamlined standard-plan path and instead requires full Electrical Plan review. No separate city or Fresno County Fire Protection District battery/ESS ordinance, fee, or permit type was found (FCFPD's current fee schedule and fire-permit submittal-type list both control-checked with zero battery/ESS/energy-storage hits, apart from an unrelated fire-alarm-panel battery-backup line).

Why the confidence is not higherThe exclusion-from-scope language is directly quoted from both city documents; the absence of any separate ESS process on either the city or fire-district side is control-proven (see Q36/Q46 notes) but is necessarily a composite, not a single explicit statement that 'batteries are permitted under conditions X.'

published checklist (own document) + fire AHJ absence checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No dedicated ESS permit or inspection type is published by either agency. The City's Standard Electrical Plan documents simply exclude battery systems from their scope (routing them to ordinary Electrical Plan review, not a distinct ESS permit), and Fresno County Fire Protection District's own Fire Permit Application submittal-type checklist (Plans for Fire Apparatus Access/Site Water Supply, Building Final, Underground Water Delivery, Fire Pump, Commercial/Residential Fire Sprinkler, Clean Agent System, Hood Suppression, Fire Alarm, Other) has no battery/ESS category at all.

Why the confidence is not higherControl-checked absence in FCFPD's own Fire Permit Application PDF (positive control 'sprinkler' present multiple times; fabricated 'zzqqx' absent) plus the city's own scope-exclusion language.

fire AHJ's own document (control-proven absence) + city documents checked 2026-08-31 https://www.fresnocountyfire.org/files/386660eb2/FIRE+PERMIT+APPLICATION.pdf

Q47 Is a ground mount treated as a structure? Core Ground mount

Nothing published by this authority.

Where we lookedNo ground-mount-specific provision was found in the Solar Central Inverter/Microinverter Applications (both are scoped explicitly to roof-mounted modules on single-family dwellings), the Building Permit Application, or the Planning Master Application; the zoning/accessory-structure definition that would classify a ground-mount array sits in the codified Municipal Code, which could not be rendered this session (Municode issue, as in Q29/Q30).

https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Downstream of the utility's performance meter and upstream of the house's main electrical panel. The city's own Standard Electrical Plan describes the sequence: inverter(s) output → (a 'solar load center' collecting multiple central-inverter circuits, if applicable) → utility performance meter (if required by the local utility) → utility safety disconnect switch (if required) → point of interconnection at the house electrical panel; 'No electrical loads shall be connected between the output of the inverter and the connection to the house electrical panel.'

Why the confidence is not higherDirectly described, step by step, in the city's own Solar Central Inverter Application (item 18).

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Phone or Portal 88% · department page (embedded booking form, own document)
    • How much notice is required? Effectively next business day. The city's own online inspection-request form states: 'Please note any inspection requests made after 12:00 a.m. will be for the following business day' — this phrasing is almost certainly intended as a cutoff time (compare Madera's near-identical 4:00 p.m./next-business-day pattern) but is quoted here exactly as published, since the literal text is ambiguous. 68% · department page (embedded booking form, own document)
    • Are same-day or AM/PM windows offered? Yes — AM/PM windows are offered but no same-day guarantee. The online inspection-request form lets the applicant choose 'Morning' (8:00 a.m.–12:00 p.m.) or 'Afternoon' (1:00 p.m.–5:00 p.m.); its own help text states 'The Building Inspector will arrive within the selected time frame, based on their availability.' 90% · department page (embedded booking form, own document)
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? The city's general 'Required Inspections' handout lists the standard sequence for new construction (plumbing underground, foundation/setback, slab/under-floor, roof deck & shear sheathing, frame, lath/gypsum-board, wall insulation, final), but a straightforward rooftop PV retrofit on an existing home would not trigger most of those (no new foundation, framing, etc.). Consistent with that, the Solar Central Inverter and Microinverter Standard Electrical Plan documents describe only a single site visit — 'Provide this document to the inspector along with ALL system installation instructions' — implying one consolidated final electrical inspection for a standard rooftop PV job rather than a staged sequence. 55% · published checklist (own document, inferred for solar)
    • Is a rough-in or mid-roof inspection required? No, for a standard rooftop PV retrofit — no dedicated rough-in or mid-roof inspection stage is described anywhere for solar specifically; the general Required Inspections list's 'roof deck and shear sheathing' step applies to new roof construction, not an existing-roof PV overlay. 50% · published checklist (absence, inferred)
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? Yes 85% · published checklist (own document)
    • What must be on site at inspection? The completed Solar PV Standard Electrical Plan (Central Inverter or Microinverter version, as applicable) together with all manufacturer system-installation instructions, plus the standard building-permit inspection card/approved plans; for a SolarAPP+ job, the printed SolarAPP+ Approval Document and Inspection Checklist. 85% · published checklist (own document)
    • Does the inspector verify labels and listings? Likely yes, though not stated as an explicit checklist item. The field inspector is handed the completed Solar Standard Electrical Plan (with filled-in module/inverter make, model, and listing-dependent fields) 'along with ALL system installation instructions,' which would put listed-equipment identification directly in front of the inspector at the time of inspection, and the plan itself repeatedly requires equipment to be listed/labeled by a recognized testing agency. 55% · published checklist (own document, inferred)
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

14 questions answered against City of Mendota’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Phone or Portal

Why the confidence is not higherThe SolarAPP+ page states inspections are scheduled 'by calling (559) 655-3291 or online at cityofmendota.com/building-and-planning/'; that Building & Planning page itself embeds a live online inspection-request form (Ninja Forms) asking for inspection type, permit number, preferred day, and morning/afternoon preference.

department page (embedded booking form, own document) checked 2026-08-31 https://www.cityofmendota.com/building-and-planning/

Q50 How much notice is required? Core Booking & scheduling

Effectively next business day. The city's own online inspection-request form states: 'Please note any inspection requests made after 12:00 a.m. will be for the following business day' — this phrasing is almost certainly intended as a cutoff time (compare Madera's near-identical 4:00 p.m./next-business-day pattern) but is quoted here exactly as published, since the literal text is ambiguous.

Why the confidence is not higherQuoted verbatim from the notice field of the city's own live Ninja Forms inspection-request widget on the Building & Planning page; confidence is reduced because the '12:00 a.m.' wording, taken literally, does not make practical sense as a same-day cutoff and may be a typo the city has not corrected.

department page (embedded booking form, own document) checked 2026-08-31 https://www.cityofmendota.com/building-and-planning/

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Yes — AM/PM windows are offered but no same-day guarantee. The online inspection-request form lets the applicant choose 'Morning' (8:00 a.m.–12:00 p.m.) or 'Afternoon' (1:00 p.m.–5:00 p.m.); its own help text states 'The Building Inspector will arrive within the selected time frame, based on their availability.'

Why the confidence is not higherQuoted directly from the form's own field descriptions on the city's Building & Planning page.

department page (embedded booking form, own document) checked 2026-08-31 https://www.cityofmendota.com/building-and-planning/

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherThe city's own inspection-request form refers throughout to 'the Building Inspector' arriving for the appointment, and the SolarAPP+ page's Step 4 routes inspection scheduling straight to the same city phone number/page — no delegation to a contractor or the county is mentioned anywhere.

department page (own document) checked 2026-08-31 https://www.cityofmendota.com/building-and-planning/

Q53 If delegated, to whom? Core Who inspects

N/A — not delegated; the City of Mendota's own Building Inspector performs the final solar inspection.

Why the confidence is not higherSame source as Q52.

department page (own document) checked 2026-08-31 https://www.cityofmendota.com/building-and-planning/

Q54 Which inspections are required, and in what order? Core Stages & sequence

The city's general 'Required Inspections' handout lists the standard sequence for new construction (plumbing underground, foundation/setback, slab/under-floor, roof deck & shear sheathing, frame, lath/gypsum-board, wall insulation, final), but a straightforward rooftop PV retrofit on an existing home would not trigger most of those (no new foundation, framing, etc.). Consistent with that, the Solar Central Inverter and Microinverter Standard Electrical Plan documents describe only a single site visit — 'Provide this document to the inspector along with ALL system installation instructions' — implying one consolidated final electrical inspection for a standard rooftop PV job rather than a staged sequence.

Why the confidence is not higherThe Required Inspections list is the city's own document but is written for new construction generally, not solar specifically; the single-inspection inference for solar is drawn from the Standard Electrical Plan's own phrasing rather than a document that states the sequence outright.

published checklist (own document, inferred for solar) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Required-Inspections.pdf

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No, for a standard rooftop PV retrofit — no dedicated rough-in or mid-roof inspection stage is described anywhere for solar specifically; the general Required Inspections list's 'roof deck and shear sheathing' step applies to new roof construction, not an existing-roof PV overlay.

Why the confidence is not higherInferred from the absence of any solar-specific rough-in/mid-roof step in either the general Required Inspections handout or the Solar Standard Electrical Plan documents.

published checklist (absence, inferred) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Required-Inspections.pdf

Q56 Does the inspector verify labels and listings? Core What is checked

Likely yes, though not stated as an explicit checklist item. The field inspector is handed the completed Solar Standard Electrical Plan (with filled-in module/inverter make, model, and listing-dependent fields) 'along with ALL system installation instructions,' which would put listed-equipment identification directly in front of the inspector at the time of inspection, and the plan itself repeatedly requires equipment to be listed/labeled by a recognized testing agency.

Why the confidence is not higherInferred from the structure of the inspection hand-off document rather than a city statement that 'the inspector verifies labels and listings.'

published checklist (own document, inferred) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q57 Is there a published inspection checklist? Core What is checked

Yes

Why the confidence is not higherThe city's own 'Solar PV Standard Electrical Plan' (Central Inverter and Microinverter versions) functions as the published inspection checklist — it is filled in by the applicant during design and is explicitly required to be handed to the field inspector at the time of inspection.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q58 What must be on site at inspection? Core Documents on site

The completed Solar PV Standard Electrical Plan (Central Inverter or Microinverter version, as applicable) together with all manufacturer system-installation instructions, plus the standard building-permit inspection card/approved plans; for a SolarAPP+ job, the printed SolarAPP+ Approval Document and Inspection Checklist.

Why the confidence is not higherDirectly stated ('Provide this document to the inspector along with ALL system installation instructions') in the city's own Solar Standard Electrical Plan documents; the SolarAPP+ inspection-checklist requirement follows from the standard SolarAPP+ workflow the city has adopted.

published checklist (own document) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Solar-Central-Inverter-Application.pdf

Q59 Is there a re-inspection fee? Corrections & re-inspection

$65.00 per hour, $100.00 minimum

Why the confidence is not higherBoth the 2010 Fee Schedule ('Reinspection fees assessed pursuant to MMC Section 15.04.080(B): $65.00 per hour ($100.00 minimum)') and the separate 'Required Inspections' handout (which cross-references the same MMC section for re-inspection fees) agree on this figure. Held at 70 rather than higher because the fee schedule itself is dated 2010 (16 years old) and could since have been superseded by a Council resolution this session did not locate.

fee schedule (own document, OCR'd) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/09/Planning-Engineering-Building-Fee-Schedule.pdf

Q60 How are corrections issued and cleared? Corrections & re-inspection

Nothing published by this authority.

Where we lookedNo document found describing how correction notices are issued or cleared for a solar/building inspection specifically — checked the Building & Planning page, the Solar Standard Electrical Plan documents, the Required Inspections handout, and the Building Permit Application.

https://www.cityofmendota.com/building-and-planning/

Q61 What is issued on pass? Core Final sign-off & PTO

Final (sign-off on the building-permit inspection card)

Why the confidence is not higherInferred from the general 'Required Inspections' handout's description of a 'Final inspection... after finish grading and the building is completed and ready for occupancy' — written for new construction generally rather than a rooftop PV retrofit specifically, and no document names a distinct term (e.g. 'Green Tag') for solar.

published checklist (own document, inferred) checked 2026-08-31 https://www.cityofmendota.com/wp-content/uploads/2023/07/Required-Inspections.pdf

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer

Why the confidence is not higherPG&E's own solar process page states that after the local inspection passes, 'your contractor submits all required paperwork to PG&E' (interconnection application, single-line diagram, copy of the final building permit), and PG&E then 'send[s] you official written permission to operate' — the contractor/installer is the one who files with PG&E to trigger PTO, not the city and not the customer directly. This is a utility-level (PG&E) fact, not a Mendota-specific statement, since no Mendota document addresses PTO notification.

utility process page checked 2026-08-31 https://www.pge.com/en/clean-energy/solar/getting-started-with-solar.html

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Mendota against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Mendota is the authority having jurisdiction 85% confidence
Holds
Building and Electrical (self-performed by the City's own Building Department)
Delegated to
Fresno County Fire Protection District (fire code adoption/enforcement only)
Overridden by
CA Gov. Code §65850.5/§65850.52 (ministerial small-residential-rooftop-solar review and SolarAPP+ mandate, which the city has implemented) and Civil Code §714 (Solar Rights Act, limits HOA restriction); on the fire side, Fresno County Fire Protection District's own Ordinance 2025-04 (2025 CFC) governs rather than any city-adopted fire code
Why not higher
The City of Mendota's own Building Department (buildingdepartment@cityofmendota.com, 643 Quince St) runs its own SolarAPP+ intake and publishes its own Building Permit Application, fee schedule, and solar standard-plan documents — there is no building/electrical delegation to Fresno County or a contract plan-check firm anywhere on the city's site. However, the city has NO fire department of its own: its 'Public Safety' page covers only police, there is no fire page anywhere in its sitemap, and Fresno County Fire Protection District's own 'About Us' page names 'the Cities of San Joaquin, Parlier, Mendota, Fowler and Huron' as served — so fire-code adoption and any fire-side plan review/inspection for Mendota sits with FCFPD, not the city. Held at 85 rather than higher because (a) no named 'Building Official' appears on the city's own site to confirm in-house self-performance beyond inference from the permit documents, and (b) the city's own municipal-code cross-reference ordinance recognizing FCFPD (the city-side mirror of FCFPD's own designation) could not be independently retrieved, since Mendota's Municode Library page is an Angular shell that did not render content to automated fetch this session.

https://www.cityofmendota.com/solarapp/

Permit required
Yes92%
Permit cost
No PV-specific flat fee is published. The city's only located fee document — the 2010 Planning, Engineering & Building Fee Schedule (Ord. Res.50%
Plan review
Not stated for the standard path. For SolarAPP+-eligible systems, review is effectively automated/near-instant once the online eligibility and contractor-license checks pass (per the…62%
Portal
SolarAPP+ (gosolarapp.org) for eligible residential rooftop PV; for non-eligible or standard submittals,90%
Own placard wording
Yes92%
Booking an inspection
Phone or Portal88%
Labels & placards for this authority

City of Mendota writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.

Wording 92%

Yes

Size, colour & material 85%

Letter height: minimum 20-point type (≈⅜ inch), stated for both the DC-disconnect power-source label and the exterior directory/plaque. Colour/material: 'a phenolic plaque with contrasting colors between the text and background' meets the intent of the code — i.e. high contrast is required but no single mandated colour scheme (e.g. red/white) is specified in the text.

Where they go 80%

DC disconnect label: at the PV DC disconnecting means. AC/system labels: at the PV system AC disconnect / point of interconnection, and (for the exterior directory/plaque) mounted on the exterior of the building, at the same location as the main service disconnect where possible. The AC wiring sequence in the city's own document runs inverter(s) → [solar load center] → utility performance meter (if required) → utility safety disconnect switch → house electrical panel, which is where the corresponding placards attach.

What the utility wants on top None%

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Fresno County
Regions served
1
Regions covered
City of Mendota · city
Solar Requirements
Notes
Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.cityofmendota.com/building-and-planning/
Authority Contact
Address
643 Quince Street, Mendota, CA 93640
Main Phone
(559) 655-3291
Building Department
Department
Planning & Building Department
Direct Phone
(559) 655-4298
Booking & Scheduling
Preferred channel
phone
Request an inspection
Notes
Solar inspection process: (1) Obtain SolarAPP+ approval or submit plans directly to the city; (2) Email buildingdepartment@cityofmendota.com with approval documents; (3) Receive permit number and inspection card from city; (4) Call (559) 655-3291 to schedule inspection. When scheduling, provide: type of inspection, permit number, preferred date, time preference (AM or PM), address, name/email/phone. City Hall hours: Mon–Fri 8:00am–5:00pm. No third-party online inspection portal (Accela/EnerGov/etc.) found. (collected Jul 2026)
