City of Monte Sereno

Santa Clara County

Verified Aug. 4, 2026

City of Monte Sereno is a city authority in the State of California, serving 3,479 residents. 249 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — For a qualifying small residential rooftop solar system (<=10kW AC/30kW thermal, single/duplex dwelling): same-day issuance for over-the-counter applications, Q18 Where you file — ePermits (epermits.montesereno.org) Q20

Permit required
Yes98% source
What it costs
$196.19 flat (Building fee schedule line item 'Solar'); a $150 plan-check deposit is collected at submittal and credited toward this fee.88% source
Plan review turnaround
For a qualifying small residential rooftop solar system (<=10kW AC/30kW thermal, single/duplex dwelling): same-day issuance for over-the-counter applications,90% source
Key document
department handout cited by 7 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 95% · department handout
    • What does this authority permit itself, and what does it delegate? Both 88% · department handout
    • Is a permit required for a residential rooftop PV system? Yes 98% · department handout
    • Is there a separate electrical permit, or is it combined? Combined 78% · department form
    • Is a HOA or architectural approval required first? No, for a qualifying small residential rooftop solar system. 78% · municipal code
    • Is there a historic-district review? No, for a qualifying small residential rooftop solar system on a property not on the City's historical inventory. 62% · municipal code
    • Is a Specific Use Permit or Council approval ever required? No -- the Building Official's issuance of a small residential rooftop solar permit is expressly 'nondiscretionary'; a Council/Use Permit process is not invoked unless the Building Official makes a written, evidence-based finding of a 'specific, adverse impact' on public health/safety, in which case the applicant may be required to apply for a minor residential permit, appealable to the Planning Commission (not Council). 82% · municipal code
    • Is there a system-size cap on residential generation? 10 kW AC nameplate (or 30 kW thermal) on a single- or duplex-family dwelling, not exceeding the maximum legal building height, is the ceiling for the 'small residential rooftop solar energy system' definition eligible for the City's expedited/administrative permitting path (unchanged AB 2188-era figure). 92% · municipal code
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Who is allowed to pull the electrical permit? Either 85% · department form
    • Is a homeowner permitted to self-install and self-permit? Yes 85% · department form
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Per the City's own PV handout Permit Process section: a completed Building Permit Application; site plan showing the building and PV panel locations with roof pathways dimensioned; electrical plans including a single-line diagram and load calculations (if the main breaker is under 200A); equipment brochure with installation requirements and UL listing; roof framing plan (rafter size, spacing, span, slope); attachment details for panels to the roof structure; and the weight of the panels to be installed. For ESS, add: site plan showing ESS battery location(s); floor plan showing ESS and smoke/CO/heat alarm locations; equipment brochure/UL listing; and an electrical single-line diagram showing the connection to the PV system and main panel. 95% · department handout
    • How many copies, and in what format? Electronic only, submitted through the ePermits portal (epermits.montesereno.org); the PV and ESS handouts give no physical-copy count, unlike some of the City's other minor-permit handouts (e.g. the Electrical Panel Replacement and EV Charger handouts, which specify '3 copies of each item' for over-the-counter submittal at City Hall). 68% · department page
    • Is a site plan required, and what must it show? Yes -- must show the location of the building and the location of the PV panels with roof pathways dimensioned. 95% · department handout
    • Is a one-line / three-line diagram required? Yes 95% · department handout
    • Are string and conductor calculations required? Yes 88% · department handout
    • Is a structural PE stamp required, and at what threshold? A stamped/signed structural PE is required unless the system meets the City's prescriptive path: combined module/support weight <=5 psf, standoff clearance 2"-10", panels anchored at max 4' on-center each direction with a minimum 5/16" diameter bolt embedded a minimum 2-1/2" into roof framing, and roof structurally sound with no signs of deflection/sagging. Outside these parameters, plans/calculations/details must be stamped and signed by a California-registered civil/structural engineer and approved by the City. 92% · department handout
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

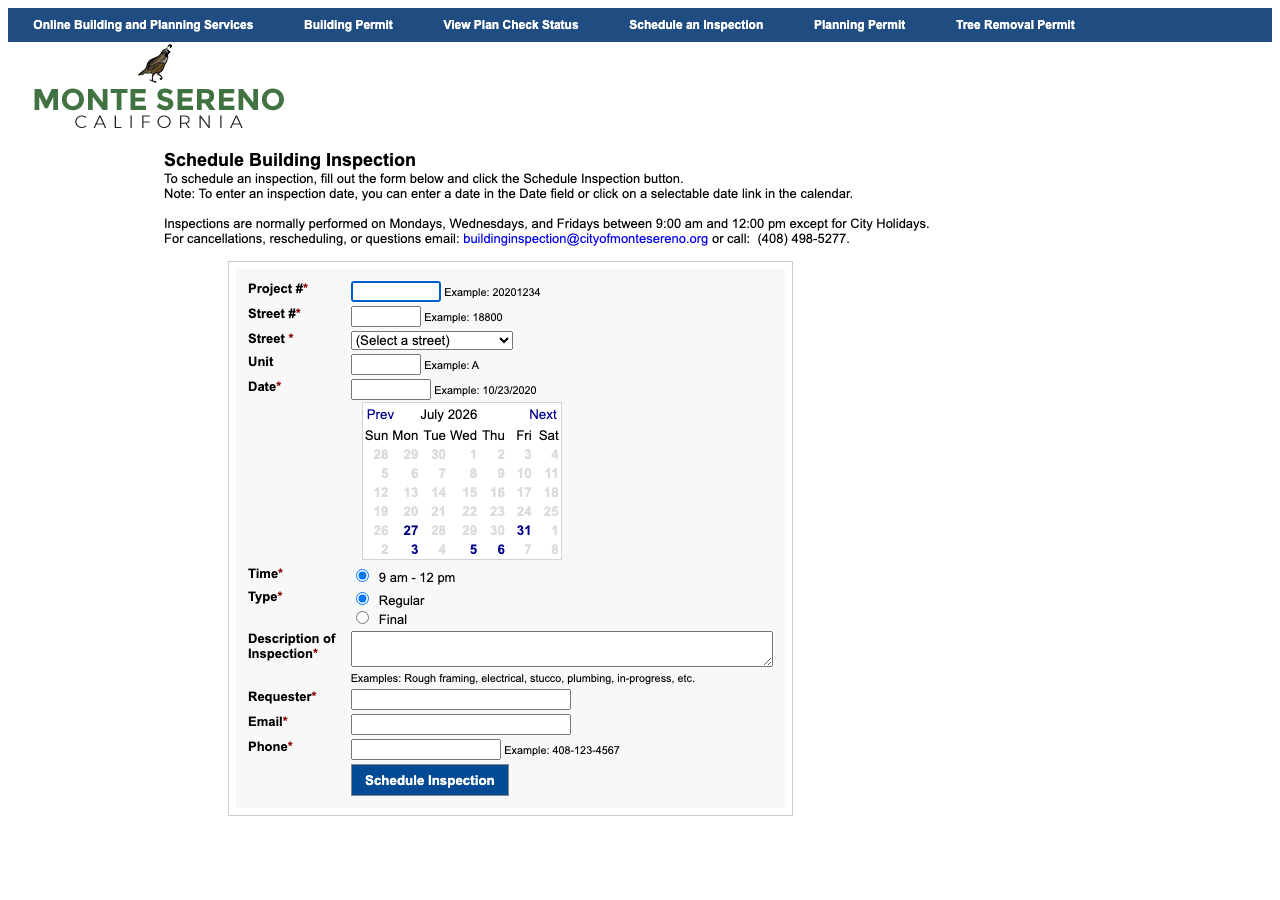

    • Which permit portal does this authority use? ePermits (epermits.montesereno.org) 95% · portal landing page
    • Can the whole application be completed online? Yes 88% · municipal code
    • What does a residential solar permit cost? $196.19 flat (Building fee schedule line item 'Solar'); a $150 plan-check deposit is collected at submittal and credited toward this fee. 88% · fee schedule
    • How is the fee calculated? Flat 85% · fee schedule
    • Is there a separate plan-check fee? No 72% · fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

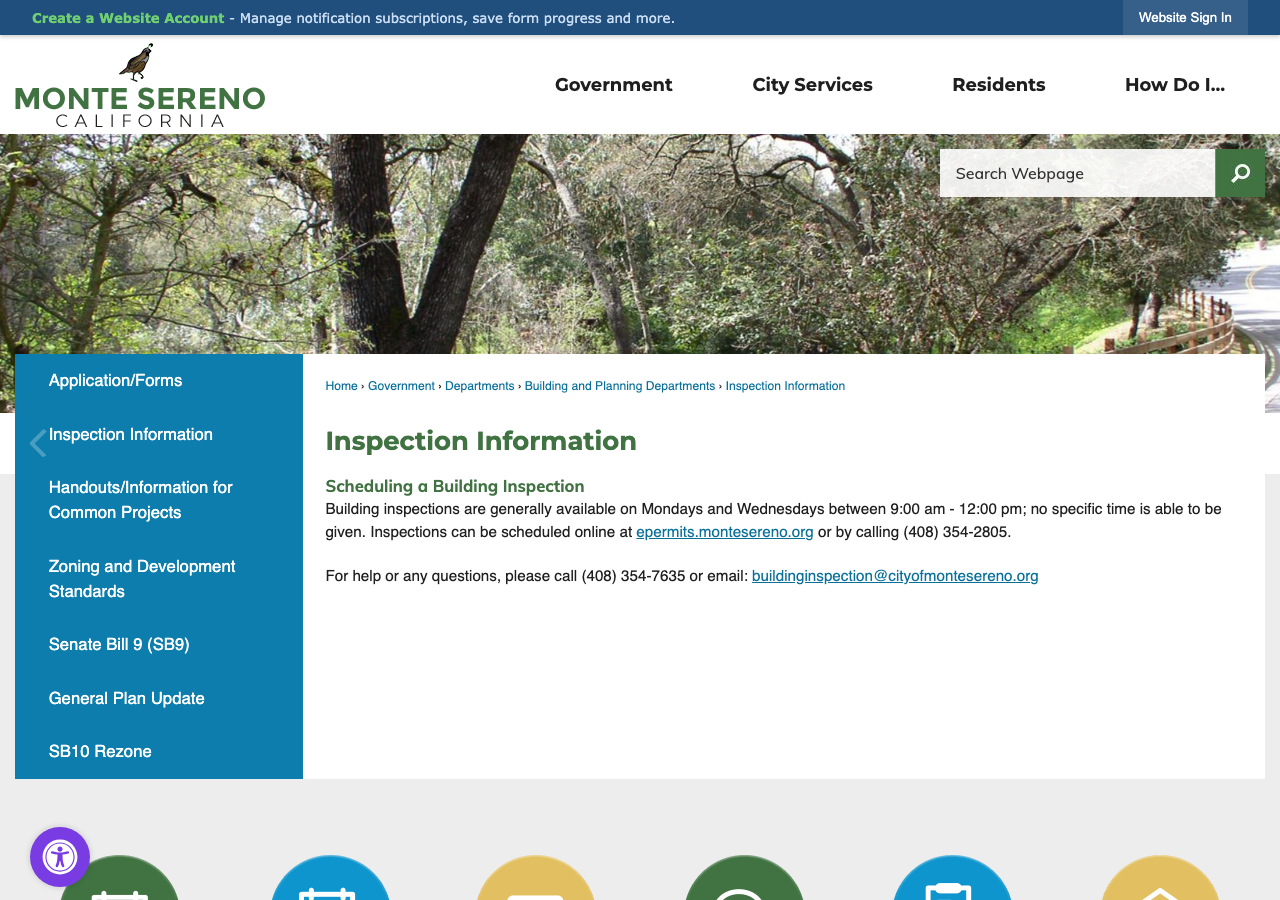

    • What is the stated plan-review turnaround? For a qualifying small residential rooftop solar system (<=10kW AC/30kW thermal, single/duplex dwelling): same-day issuance for over-the-counter applications, or within 1-3 business days for electronic applications, upon a complete submittal. (Note: the City's general Building Permit Submittal Requirements handout separately states an ~3-week initial plan-check turnaround for building permits generally -- that figure is not the solar-specific expedited-path turnaround.) 90% · municipal code
    • Which utility handles interconnection here? PG&E (Pacific Gas & Electric) 90% · department handout

28 questions answered against City of Monte Sereno’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherCity's Building Division issues residential PV/ESS permits directly via its own ePermits portal and municipal code (MSMC Ch. 9.01) adopts CBC/CRC/CEC/CFC in full, including a codified small-residential-solar expedited permitting section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherCity self-performs building and electrical review/permitting/inspection for residential PV and ESS; fire-code plan review is delegated to Santa Clara County Fire Department per the City's own submittal-requirements handout.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4313/Building-Permit-Submittal-Requirements

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherPV handout states plainly: 'A permit is required to install a photovoltaic system. Permits are required prior to installation or replacement of photovoltaic (PV) systems.'

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherThe City's own Building Permit Application form lists 'Photovoltaic' as its own permit-type checkbox (distinct from, not in addition to, the 'Electrical' checkbox), and the ePermits portal lists 'Photovoltaic System' as a single minor-permit type -- one combined permit rather than a separate building permit plus a separate electrical permit.

department form checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4169/Building-Permit-Application

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe Building Permit Application form offers a checkbox for 'Licensed Contractor will do the work' or 'Property owner will do the work' -- not restricted to a licensed electrician specifically, and MSMC 9.01.080 imposes no contractor-type restriction on small residential rooftop solar applicants.

department form checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4169/Building-Permit-Application

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Nothing published by this authority.

Where we lookedBuilding Permit Application form (DocumentCenter/View/4169) and the Building & Planning Departments page -- the application form asks only for CSLB license class/number, not a City business-license number, and neither document states that a contractor must hold a Monte Sereno business license before applying for a permit. The Master Fee Schedule does list a 'General Contractor' business-license fee ($105), but that alone does not establish it is a permitting prerequisite.

https://www.montesereno.org/DocumentCenter/View/4169/Building-Permit-Application

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherThe Building Permit Application form has a dedicated 'Property owner will do the work' checkbox and references an 'Owner-Builder Declaration' on its reverse side; nothing excludes solar from owner-builder self-permitting.

department form checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4169/Building-Permit-Application

Q8 What documents make up a complete submittal? Core Submittal package

Per the City's own PV handout Permit Process section: a completed Building Permit Application; site plan showing the building and PV panel locations with roof pathways dimensioned; electrical plans including a single-line diagram and load calculations (if the main breaker is under 200A); equipment brochure with installation requirements and UL listing; roof framing plan (rafter size, spacing, span, slope); attachment details for panels to the roof structure; and the weight of the panels to be installed. For ESS, add: site plan showing ESS battery location(s); floor plan showing ESS and smoke/CO/heat alarm locations; equipment brochure/UL listing; and an electrical single-line diagram showing the connection to the PV system and main panel.

Why the confidence is not higherEnumerated item-by-item in the City's own dated (Revised 3/2026) 'Residential Photovoltaic Systems' and 'Residential Energy Storage Systems' Building Division Requirements handouts, extracted via pdftotext -layout.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q9 How many copies, and in what format? Submittal package

Electronic only, submitted through the ePermits portal (epermits.montesereno.org); the PV and ESS handouts give no physical-copy count, unlike some of the City's other minor-permit handouts (e.g. the Electrical Panel Replacement and EV Charger handouts, which specify '3 copies of each item' for over-the-counter submittal at City Hall).

Why the confidence is not higherSince 3 Jan 2024 the Building & Planning page requires 'all new applications for building permits that require a plan check' to be submitted online; the PV/ESS handouts' Permit Process sections say only 'Permits can be obtained/submitted online at https://epermits.montesereno.org/' with no copy-count language, in contrast to the copy-count language present on other handouts -- inferred from that contrast rather than a direct statement for solar specifically.

department page checked 2026-08-31 https://www.montesereno.org/2152/Building-and-Planning-Departments

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes -- must show the location of the building and the location of the PV panels with roof pathways dimensioned.

Why the confidence is not higherDirectly stated as a Building Permit Application Requirement in the PV handout's Permit Process section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes

Why the confidence is not higher'Electrical plans including single line diagram and load calculations (if main breaker is less than 200 amps)' is a listed Building Permit Application Requirement.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q12 Are string and conductor calculations required? Drawings & calculations

Yes

Why the confidence is not higherPV conductors must be sized at 125% of maximum PV current (CEC 705.12(B)(1)), and load calculations are required whenever the main breaker is under 200A -- both stated in the PV handout.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

A stamped/signed structural PE is required unless the system meets the City's prescriptive path: combined module/support weight <=5 psf, standoff clearance 2"-10", panels anchored at max 4' on-center each direction with a minimum 5/16" diameter bolt embedded a minimum 2-1/2" into roof framing, and roof structurally sound with no signs of deflection/sagging. Outside these parameters, plans/calculations/details must be stamped and signed by a California-registered civil/structural engineer and approved by the City.

Why the confidence is not higherStated verbatim as the threshold in the City's own PV handout Structural Requirements section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedPV handout Electrical Requirements section and the Building Permit Submittal Requirements handout -- neither states a threshold, or any requirement, for an electrical PE stamp on a residential PV/ESS submittal.

https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q15 What does a residential solar permit cost? Core Fees

$196.19 flat (Building fee schedule line item 'Solar'); a $150 plan-check deposit is collected at submittal and credited toward this fee.

Why the confidence is not higherMaster Fee Schedule effective August 17, 2026, Building Fees item 3: 'Solar ... $196.1944' (rounded per the schedule's own note). The Building Permit Submittal Requirements handout separately lists a $150 plan-check deposit for 'Photovoltaic, Demolition, Seismic Anchorage, etc.', described as non-refundable but 'credited toward the final permit fees.' Positive control ('electrical', 6 hits) and fabricated control ('zzqqx', 0 hits) both passed on this fee-schedule PDF. Note an older 'Master Fee Schedule Effective 8-18-2025' (doc 4287) is still linked from the Building & Planning page; the 4427 doc (Aug 17, 2026) is the one linked from the Finance Department page and is treated here as current.

fee schedule checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4427/Master-Fee-Schedule-Effective-August-17-2026

Q16 How is the fee calculated? Core Fees

Flat

Why the confidence is not higherThe 'Solar' line in the Building Fees schedule is a single flat dollar figure with no kW or valuation variable, unlike the general Building Permit fee (item 5), which is valuation-tiered.

fee schedule checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4427/Master-Fee-Schedule-Effective-August-17-2026

Q17 Is there a separate plan-check fee? Fees

No

Why the confidence is not higherThe fee schedule's 'Plan Review Fees (in addition to building permit fees)' section (65% of Building Permit Fee, etc.) is explicitly scoped to item 5 'Building Permit' (the valuation table), not to items 1-4 (Construction Tax, Electrical/Plumbing/Mechanical, Solar, Demolition), which each carry one flat all-inclusive figure. The $150 PV plan-check deposit is a deposit against, not an addition to, the $196.19 fee.

fee schedule checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4427/Master-Fee-Schedule-Effective-August-17-2026

Q18 What is the stated plan-review turnaround? Core Timeline & validity

For a qualifying small residential rooftop solar system (<=10kW AC/30kW thermal, single/duplex dwelling): same-day issuance for over-the-counter applications, or within 1-3 business days for electronic applications, upon a complete submittal. (Note: the City's general Building Permit Submittal Requirements handout separately states an ~3-week initial plan-check turnaround for building permits generally -- that figure is not the solar-specific expedited-path turnaround.)

Why the confidence is not higherMSMC 9.01.080(F)(a), codifying AB 2188, states this turnaround explicitly and by name for small residential rooftop solar systems.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q19 How long is an issued permit valid before it expires? Timeline & validity

Nothing published by this authority.

Where we lookedMSMC 9.01.020 (2025 CBC local amendments) -- searched in full for 'expir', 'permit valid', '180 days' and related terms with zero hits, meaning permit-expiration is not locally amended; however I could not retrieve the base (unamended) 2025 CBC Section 105.5 text itself from any City-hosted source to state the operative figure with confidence.

https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO

Q20 Which permit portal does this authority use? Core Portal & process

ePermits (epermits.montesereno.org)

Why the confidence is not higherNamed throughout the Building & Planning Departments page and every PV/ESS/electrical handout as the online permitting portal.

portal landing page checked 2026-08-31 https://www.montesereno.org/2152/Building-and-Planning-Departments

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherMSMC 9.01.080(E)(b): 'Electronic submittal of the required permit application and documents by email, or the Internet, shall be made available to all small residential rooftop solar energy system permit applicants,' and (E)(c) accepts an electronic signature in lieu of a wet signature; the PV/ESS handouts direct all submittals to the ePermits portal.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas & Electric)

Why the confidence is not higherNamed directly in the City's own 'Residential Electrical Panel Replacement' handout ('PG&E requires the height of the meter to be 48 inches to 66 inches above the ground... PG&E prohibits new meters on exterior walls adjacent to bedrooms...' and a PG&E 'utility release' inspection is described for electrical panel work).

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4389/Electrical-Panel-Replacement

Q23 Where does the utility sit in the sequence? Core Utility interconnection

Nothing published by this authority.

Where we lookedPV handout, Building Permit Submittal Requirements handout, Electrical Panel Replacement handout -- none states whether PG&E interconnection happens before, after, or parallel to City permit issuance.

https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No, for a qualifying small residential rooftop solar system.

Why the confidence is not higherMSMC 9.01.080(F)(b): 'Review of the application shall be limited to the Building Official's review of whether the application meets local, state, and federal health and safety requirements' -- which forecloses a separate HOA/Site and Architectural Commission review layered onto the expedited solar path. No PV-specific SAC or HOA-approval requirement was found in the Building Permit Submittal Requirements or Site Development Permit trigger list.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q25 Is there a historic-district review? Overlays & special cases

No, for a qualifying small residential rooftop solar system on a property not on the City's historical inventory.

Why the confidence is not higherMSMC 9.01.080(F)(b) scope-limits review of eligible small residential rooftop solar systems to health-and-safety compliance. The City does maintain a Heritage Preservation chapter (MSMC Ch. 12.01) with review triggers for structures 60+ years old or on the historical inventory (12.01.130), routed through the Site and Architecture Commission -- if a solar-bearing structure were itself an inventoried heritage feature that additional review could still apply, which is why confidence is capped rather than a clean 'No.'

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT12CICO_CH12.01HEPR_12.01.130COIMNOLIHIIN

Q26 Is a wind or windstorm certification required? Overlays & special cases

Nothing published by this authority.

Where we lookedPV handout's Structural Requirements section (weight/clearance/anchoring only, no wind-speed or windstorm-certification language) and MSMC 9.01.020/9.01.030 CBC/CRC local amendments -- no wind or windstorm certification requirement for PV specifically was found in either.

https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

No -- the Building Official's issuance of a small residential rooftop solar permit is expressly 'nondiscretionary'; a Council/Use Permit process is not invoked unless the Building Official makes a written, evidence-based finding of a 'specific, adverse impact' on public health/safety, in which case the applicant may be required to apply for a minor residential permit, appealable to the Planning Commission (not Council).

Why the confidence is not higherMSMC 9.01.080(F)(a)-(c) describes this administrative, nondiscretionary process and its narrow escalation path in detail.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q28 Is there a system-size cap on residential generation? Overlays & special cases

10 kW AC nameplate (or 30 kW thermal) on a single- or duplex-family dwelling, not exceeding the maximum legal building height, is the ceiling for the 'small residential rooftop solar energy system' definition eligible for the City's expedited/administrative permitting path (unchanged AB 2188-era figure).

Why the confidence is not higherMSMC 9.01.080(B) definitions, verbatim. This is a gate for the expedited/nondiscretionary path, not necessarily an absolute prohibition on larger systems, which is why it is recorded as the applicable cap/gate rather than an outright ceiling.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2023 80% · municipal code (adopting ordinance)
    • Which building code edition is in force? 2025 California Building Code (and 2025 California Residential Code for one- and two-family dwellings) 96% · municipal code (adopting ordinance)
    • Which fire code edition is in force? 2025 California Fire Code, including Appendices B, C, D, and O 92% · municipal code (adopting ordinance)
    • Are there local amendments to any of the above? Yes 92% · municipal code
    • What is the installation judged against? The 2025 California Building/Residential/Electrical/Fire/Green Building Codes as locally amended (MSMC Ch. 9.01), plus the City's own 'Residential Photovoltaic Systems' and 'Residential Energy Storage Systems' Building Division Requirements handouts, which restate and apply specific CBC 3111/CRC R329 pathway-setback rules and CEC 690/705/706 sections to residential PV/ESS review. 90% · department handout
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Per CBC 3111 / CRC R329 (except detached non-habitable buildings or roofs sloped 2:12 or less): at least two 36"-wide pathways from the lowest roof edge to the ridge, on separate roof planes, with at least one pathway on the street/driveway side; every roof plane with a PV array needs its own 36"-wide pathway (on the same plane, an adjacent plane, or straddling both) from lowest edge to ridge, over areas capable of supporting firefighter access and minimally obstructed. Ridge setback: 18" from both sides of a horizontal ridge where the PV system covers <=33% of roof area (or <=66% with fire sprinklers); 36" setback where it covers more than that. 95% · department handout
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Yes, required per CEC 690.12. Controlled conductors outside the array boundary must comply with 690.12(B)(1); inside the array boundary with 690.12(B)(2); controlled conductors must be limited to no more than 30V and 240VA within 10 seconds of rapid-shutdown initiation, measured between any two conductors and between any conductor and ground. 95% · department handout
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? A full set keyed to specific equipment/locations: DC circuit raceways/enclosures/conduits/combiner-junction boxes (CEC 690.31(G)(3)); within 1' of the service disconnecting means (690.56(C)(1)(a)); at each PV system disconnect, AC or DC (690.13(B)); at each DC PV disconnecting means (690.53); at all interactive-system points of interconnection (690.54); at the rapid-shutdown initiation device (690.56(C)(3)); at distribution equipment adjacent to back-fed breakers under the 'sum of breakers' rule (705.12(B)(2)(3)(c)); at PV disconnecting means where line/load may remain energized in the open position (690.13(B)); at DC disconnecting means where both line and load terminals may remain energized (690.13(B)); at back-fed breakers using the 120% rule (705.12(B)(2)(3)(b)); at electrical equipment with overcurrent devices supplying a busbar/conductor from multiple sources (705.12(B)(3)); and at each service equipment location and system-disconnect location for all interconnectable power-production sources (705.10). 95% · department handout
    • Does the authority specify placard wording of its own? No 65% · department handout
    • Does it specify letter height, colour or material? All marking and labeling shall be a minimum of 3/8" high white letters on a red background, in a material suitable for the environment where it is located (unless otherwise specified for a given label type). 95% · department handout
    • Is a site plan / facility map placard required, and what must it show? A CEC 705.10 facility placard is required at each service equipment location and at the location(s) of the system disconnect(s) for all electric power production sources capable of being interconnected; the City's own document cites the code section but does not add its own additional content requirements for a facility/site map beyond that citation. 75% · department handout
    • Where must the labels be placed? Each label/placard is tied to a specific device or junction point (service disconnect proximity, PV/DC disconnects, interconnection points, rapid-shutdown initiation device, back-fed breakers, multi-source busbars, combiner/junction boxes, and service equipment/disconnect locations) -- see q38 for the full list with code citations. 90% · department handout
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Must equipment be on a specific approved list? No dedicated City 'approved equipment list' -- equipment must instead be listed/labeled per code: PV panels/modules per UL 1703 or both UL 61730-1 and UL 61730-2; inverters per UL 1741 (and listed for utility interaction if grid-connected); ESS per UL 1741 or UL 9540; all other equipment listed by a nationally recognized testing laboratory for its intended application. 85% · department handout
    • Are batteries permitted, and under what conditions? Permitted, with detailed conditions: allowed locations (detached garages/accessory structures; attached garages meeting CRC R302.6 separation; outdoor exterior walls 3'+ from doors/windows and not below emergency escape openings; enclosed utility/storage closets with 5/8" Type X gypsum; never in sleeping rooms or spaces opening into them); units spaced a minimum 3' apart or per manufacturer; individual unit rating capped at 20 kWh; aggregate rating caps by location ranging 40-600 kWh depending on location and non-combustible-eave/setback conditions (CRC R330.4/R330.5); vehicle-impact bollards or wheel barriers required where subject to vehicle damage (CRC R330.8, with specific bollard/wheel-barrier construction details); and an interconnected heat alarm (System Sensor 5602/5622 in unconditioned spaces) required when installed in a garage. 95% · department handout
    • Is there a separate ESS permit or inspection? Yes -- 'Energy Storage System' is listed as its own distinct minor-permit type in the ePermits portal, separate from 'Photovoltaic System.' However, no separate ESS fee line exists in the Master Fee Schedule (only 'Solar' and the general 'Electrical, Plumbing or Mechanical' minimum fee), so it appears to be billed under the standard minimum permit fee rather than a bespoke ESS fee. 80% · department page
    • Is there a local rule on service upgrades or busbar sizing? The PV main disconnecting breaker shall be located at the opposite end of the busbar from the main disconnecting circuit breaker. 78% · department handout
    • Is a specific mounting system or attachment spacing required? Combined weight of modules/support components <=5 psf; standoff clearance from roof surface to underside of module 2"-10"; panels anchored to roof framing at max 4' on-center each direction with a minimum 5/16" diameter bolt embedded a minimum 2-1/2" into the roof framing (unless engineered otherwise by a CA-registered civil/structural engineer). 92% · department handout

20 questions answered against City of Monte Sereno’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2023

Why the confidence is not higherMSMC 9.01.010 adopts 'Part 3 - California Electrical Code, 2025 Edition' (Ord. NS-248, 11-18-2025); California's 2025 triennial code cycle is based on the 2023 NEC.

municipal code (adopting ordinance) checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.010ADCORE

Q30 Which building code edition is in force? Core Code editions in force

2025 California Building Code (and 2025 California Residential Code for one- and two-family dwellings)

Why the confidence is not higherMSMC 9.01.010: adopts 'Part 2 - California Building Code, 2025 Edition, including Appendices I, J, and P' and 'Part 2.5 - California Residential Code, 2025 Edition', per Ord. NS-248, adopted 11-18-2025. Also confirmed by the City's own PV/ESS handouts, which state their requirements are 'based on the 2025 California Electrical Code, 2025 California Building Code, and 2025 California Residential Code.'

municipal code (adopting ordinance) checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.010ADCORE

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code, including Appendices B, C, D, and O

Why the confidence is not higherMSMC 9.01.010, Ord. NS-248, 11-18-2025; fire-code review/enforcement is functionally carried out by the Santa Clara County Fire Department per the City's own submittal-requirements handout, and one CFC local amendment references 'the Santa Clara County Fire Department A-6 Standard' for fire-apparatus-access signage.

municipal code (adopting ordinance) checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.010ADCORE

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherMSMC 9.01.020 (CBC amendments), 9.01.030 (CRC amendments), 9.01.040 (WUI Code amendments), 9.01.050 (CFC amendments) and 9.01.060 (CALGreen amendments) each carry extensive local amendments (e.g. seismic bracing tables, ESS/battery fire-code definitions and Section 1207 requirements, hazardous-materials permit tables, address-identification and radio-coverage signage). None of the amendment text is solar-specific; the searched text contained 'photovoltaic' twice (a footing-exemption clause for PV carport/parking structures) and 'solar' zero times, control-checked ('electrical' 6 hits, fabricated 'zzqqx' 0 hits).

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO

Q33 What is the installation judged against? Core Electrical

The 2025 California Building/Residential/Electrical/Fire/Green Building Codes as locally amended (MSMC Ch. 9.01), plus the City's own 'Residential Photovoltaic Systems' and 'Residential Energy Storage Systems' Building Division Requirements handouts, which restate and apply specific CBC 3111/CRC R329 pathway-setback rules and CEC 690/705/706 sections to residential PV/ESS review.

Why the confidence is not higherDirectly stated across the adoption ordinance and the City's own PV/ESS handouts, which cite specific code sections as the review basis throughout.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

The PV main disconnecting breaker shall be located at the opposite end of the busbar from the main disconnecting circuit breaker.

Why the confidence is not higherStated as a stand-alone requirement in the PV handout's Electrical Requirements section; this restates the general center-fed-busbar/opposite-end principle underlying CEC 705.12 rather than announcing a novel local rule, but it is stated as a City requirement in the City's own document.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Combined weight of modules/support components <=5 psf; standoff clearance from roof surface to underside of module 2"-10"; panels anchored to roof framing at max 4' on-center each direction with a minimum 5/16" diameter bolt embedded a minimum 2-1/2" into the roof framing (unless engineered otherwise by a CA-registered civil/structural engineer).

Why the confidence is not higherStated verbatim in the PV handout's Structural Requirements section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Per CBC 3111 / CRC R329 (except detached non-habitable buildings or roofs sloped 2:12 or less): at least two 36"-wide pathways from the lowest roof edge to the ridge, on separate roof planes, with at least one pathway on the street/driveway side; every roof plane with a PV array needs its own 36"-wide pathway (on the same plane, an adjacent plane, or straddling both) from lowest edge to ridge, over areas capable of supporting firefighter access and minimally obstructed. Ridge setback: 18" from both sides of a horizontal ridge where the PV system covers <=33% of roof area (or <=66% with fire sprinklers); 36" setback where it covers more than that.

Why the confidence is not higherStated in full, with the exact figures, in the PV handout's 'Roof Pathways (CBC 3111, CRC R329)' section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Yes, required per CEC 690.12. Controlled conductors outside the array boundary must comply with 690.12(B)(1); inside the array boundary with 690.12(B)(2); controlled conductors must be limited to no more than 30V and 240VA within 10 seconds of rapid-shutdown initiation, measured between any two conductors and between any conductor and ground.

Why the confidence is not higherStated verbatim, with code citations, in the PV handout's Rapid Shutdown Requirements section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

A full set keyed to specific equipment/locations: DC circuit raceways/enclosures/conduits/combiner-junction boxes (CEC 690.31(G)(3)); within 1' of the service disconnecting means (690.56(C)(1)(a)); at each PV system disconnect, AC or DC (690.13(B)); at each DC PV disconnecting means (690.53); at all interactive-system points of interconnection (690.54); at the rapid-shutdown initiation device (690.56(C)(3)); at distribution equipment adjacent to back-fed breakers under the 'sum of breakers' rule (705.12(B)(2)(3)(c)); at PV disconnecting means where line/load may remain energized in the open position (690.13(B)); at DC disconnecting means where both line and load terminals may remain energized (690.13(B)); at back-fed breakers using the 120% rule (705.12(B)(2)(3)(b)); at electrical equipment with overcurrent devices supplying a busbar/conductor from multiple sources (705.12(B)(3)); and at each service equipment location and system-disconnect location for all interconnectable power-production sources (705.10).

Why the confidence is not higherThe PV handout's 'Marking/Labeling Requirements' section lists each of these with an accompanying diagram and code citation.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

No

Why the confidence is not higherThe specific phrase quoted in the handout ('PV SYSTEM DISCONNECT' or equivalent) is the CEC 690.13(B) statutory wording, not a City-authored substitute; no additional City-specific wording template beyond citing NEC sections was found.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

All marking and labeling shall be a minimum of 3/8" high white letters on a red background, in a material suitable for the environment where it is located (unless otherwise specified for a given label type).

Why the confidence is not higherStated as the opening rule of the PV handout's Marking/Labeling Requirements section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

A CEC 705.10 facility placard is required at each service equipment location and at the location(s) of the system disconnect(s) for all electric power production sources capable of being interconnected; the City's own document cites the code section but does not add its own additional content requirements for a facility/site map beyond that citation.

Why the confidence is not higherCited directly in the PV handout's marking/labeling diagram section; no separate facility-map content spec beyond the 705.10 citation was found elsewhere in the City's documents.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedPV handout (covers only NEC-based labeling) and the Electrical Panel Replacement handout (covers only PG&E meter-height/clearance rules) -- neither cites a PG&E-specific placard requirement beyond the NEC; would require PG&E's own Rule 21 / Distribution Interconnection Handbook to confirm.

https://www.pge.com/en/about/doing-business-with-pge/interconnections/electric-generation-interconnection.html

Q43 Where must the labels be placed? Core Labels Signage & labelling

Each label/placard is tied to a specific device or junction point (service disconnect proximity, PV/DC disconnects, interconnection points, rapid-shutdown initiation device, back-fed breakers, multi-source busbars, combiner/junction boxes, and service equipment/disconnect locations) -- see q38 for the full list with code citations.

Why the confidence is not higherEnumerated with an accompanying diagram in the PV handout's Marking/Labeling Requirements section.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q44 Must equipment be on a specific approved list? Equipment listing

No dedicated City 'approved equipment list' -- equipment must instead be listed/labeled per code: PV panels/modules per UL 1703 or both UL 61730-1 and UL 61730-2; inverters per UL 1741 (and listed for utility interaction if grid-connected); ESS per UL 1741 or UL 9540; all other equipment listed by a nationally recognized testing laboratory for its intended application.

Why the confidence is not higherThe PV and ESS handouts require code-based listing throughout but neither references a separate City-maintained approved-products list.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Permitted, with detailed conditions: allowed locations (detached garages/accessory structures; attached garages meeting CRC R302.6 separation; outdoor exterior walls 3'+ from doors/windows and not below emergency escape openings; enclosed utility/storage closets with 5/8" Type X gypsum; never in sleeping rooms or spaces opening into them); units spaced a minimum 3' apart or per manufacturer; individual unit rating capped at 20 kWh; aggregate rating caps by location ranging 40-600 kWh depending on location and non-combustible-eave/setback conditions (CRC R330.4/R330.5); vehicle-impact bollards or wheel barriers required where subject to vehicle damage (CRC R330.8, with specific bollard/wheel-barrier construction details); and an interconnected heat alarm (System Sensor 5602/5622 in unconditioned spaces) required when installed in a garage.

Why the confidence is not higherExtracted in full from the City's own dated (Revised 3/2026) 'Residential Energy Storage Systems' Building Division Requirements handout.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4387/Energy-Storage-Systems-ESS

Q46 Is there a separate ESS permit or inspection? Battery / ESS

Yes -- 'Energy Storage System' is listed as its own distinct minor-permit type in the ePermits portal, separate from 'Photovoltaic System.' However, no separate ESS fee line exists in the Master Fee Schedule (only 'Solar' and the general 'Electrical, Plumbing or Mechanical' minimum fee), so it appears to be billed under the standard minimum permit fee rather than a bespoke ESS fee.

Why the confidence is not higherThe Building & Planning Departments page's own list of online minor permits names 'Energy Storage System' separately from 'Photovoltaic System'; the Master Fee Schedule was searched for 'battery'/'energy storage'/'ESS' with zero hits beyond the generic 'Solar' and 'Electrical...Minimum fee' lines.

department page checked 2026-08-31 https://www.montesereno.org/2152/Building-and-Planning-Departments

Q47 Is a ground mount treated as a structure? Core Ground mount

Nothing published by this authority.

Where we lookedPV handout (titled around roof-top clearances/'Roof Pathways' throughout, no ground-mount section) and ESS handout, plus a full-text search of both for 'ground mount' -- zero hits in either; no ground-mount-specific City guidance was found.

https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedPV handout and Electrical Panel Replacement handout -- neither states AC-disconnect placement relative to the utility meter; this is typically governed by PG&E's own interconnection/DG manual rather than the City.

https://www.montesereno.org/DocumentCenter/View/4389/Electrical-Panel-Replacement

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Portal / Phone 90% · department page
    • How much notice is required? 2 business days (for the codified small-residential-rooftop-solar expedited path) 85% · municipal code
    • Are same-day or AM/PM windows offered? A 2-hour inspection window is provided for the expedited small-residential-rooftop-solar path, rather than a full-day or AM/PM-only window; general building inspections otherwise are only available Mondays and Wednesdays 9am-noon with 'no specific time' assigned. 82% · municipal code
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 80% · municipal code
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? For the expedited small-residential-rooftop-solar path: a single, consolidated final inspection after all work is complete (no separate rough-in/mid-roof stage). Both the PV and ESS handouts' Permit Process sections likewise each describe only 'One final inspection ... required after all the work has been completed.' 88% · department handout
    • Is a rough-in or mid-roof inspection required? No 82% · department handout
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? Yes 85% · department handout
    • What must be on site at inspection? For PV: an extension ladder extending a minimum of 3' above the roof eave, safely tied off, provided for the inspector; and a completed Smoke Alarm and Carbon Monoxide Alarm Certification Form given to the building inspector. For ESS: the same Smoke Alarm/CO Certification Form. 92% · department handout
    • Does the inspector verify labels and listings? Likely yes, but not stated as an explicit inspection-day checklist item. 55% · department handout
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final (a passed final inspection / permit sign-off) 65% · department handout
    • Is there a re-inspection fee? $130.86 per inspection (general Building Division 'Excess Inspection/Excess Re-inspection/Missed Inspection Fee'), applicable beginning with the second re-inspection -- the base permit fee already covers up to three plan reviews and the first re-inspection. No PV-specific re-inspection fee line exists. 75% · fee schedule
    • How are corrections issued and cleared? If an application is deemed incomplete, a written correction notice detailing all deficiencies and any additional information/documentation required for expedited eligibility is sent to the applicant for resubmission. 82% · municipal code

14 questions answered against City of Monte Sereno’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Portal / Phone

Why the confidence is not higherInspection Information page: 'Reservations can be made via epermits.montesereno.org or by calling (408) 354-2805.'

department page checked 2026-08-31 https://www.montesereno.org/2340/Inspection-Information

Q50 How much notice is required? Core Booking & scheduling

2 business days (for the codified small-residential-rooftop-solar expedited path)

Why the confidence is not higherMSMC 9.01.080(F)(h): 'An inspection will be scheduled within two (2) business days of a request and provide a two-hour inspection window.' Note the general Inspection Information page separately states building inspections generally run only Mondays and Wednesdays 9am-noon, which in practice constrains scheduling further, but the codified solar-specific commitment is the 2-business-day figure.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

A 2-hour inspection window is provided for the expedited small-residential-rooftop-solar path, rather than a full-day or AM/PM-only window; general building inspections otherwise are only available Mondays and Wednesdays 9am-noon with 'no specific time' assigned.

Why the confidence is not higherMSMC 9.01.080(F)(h) states the 2-hour-window commitment for solar; the Inspection Information page states the general Mon/Wed 9am-noon window with no specific time.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherMSMC 9.01.080(F)(g): 'Only one (1) inspection shall be required and performed by the Town [City] for small residential rooftop solar energy systems eligible for expedited review' -- the City performs its own field inspection. Santa Clara County Fire Department's role, per the City's submittal-requirements handout, is a plan-review step before permit issuance, not a stated separate field inspection for residential PV/ESS; SCCFD's own site publishes no PV/ESS plan-submittal category and no PV/solar fee line (control-checked: site search 'sprinkler' 10 hits, 'solar' 0 hits, fabricated 'zzqqx' 0 hits), consistent with fire not performing its own PV field inspection here.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q53 If delegated, to whom? Core Who inspects

Nothing published by this authority.

Where we lookedMSMC 9.01.080(F)(g) and the City's submittal-requirements handout -- the City performs its own single final PV/ESS field inspection (see q52), so 'if delegated, to whom' is not applicable to the field inspection itself; Santa Clara County Fire Department performs the plan-review step only, per the submittal-requirements handout, item K.

https://www.montesereno.org/DocumentCenter/View/4313/Building-Permit-Submittal-Requirements

Q54 Which inspections are required, and in what order? Core Stages & sequence

For the expedited small-residential-rooftop-solar path: a single, consolidated final inspection after all work is complete (no separate rough-in/mid-roof stage). Both the PV and ESS handouts' Permit Process sections likewise each describe only 'One final inspection ... required after all the work has been completed.'

Why the confidence is not higherMSMC 9.01.080(F)(g)-(h) plus the PV and ESS handouts' own Inspections sections, which are consistent with each other.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No

Why the confidence is not higherBoth the codified expedited-solar section (9.01.080(F)(g)) and the City's own PV and ESS handouts describe only a single final inspection, with no rough-in or mid-roof stage mentioned anywhere.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q56 Does the inspector verify labels and listings? Core What is checked

Likely yes, but not stated as an explicit inspection-day checklist item.

Why the confidence is not higherThe submittal package requires equipment brochures with UL listing and a detailed labeling schedule/diagram, consistent with the inspector verifying installed labels and listed equipment at the single final inspection, but no City document explicitly states 'the inspector checks labels and listings.'

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q57 Is there a published inspection checklist? Core What is checked

Yes

Why the confidence is not higherThe City's dated 'Residential Photovoltaic Systems' and 'Residential Energy Storage Systems' Building Division Requirements documents are themselves published requirements/checklists that combine submittal and inspection expectations (though not formatted as a literal checkbox checklist the way some other cities publish theirs).

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q58 What must be on site at inspection? Core Documents on site

For PV: an extension ladder extending a minimum of 3' above the roof eave, safely tied off, provided for the inspector; and a completed Smoke Alarm and Carbon Monoxide Alarm Certification Form given to the building inspector. For ESS: the same Smoke Alarm/CO Certification Form.

Why the confidence is not higherStated verbatim in the PV and ESS handouts' Permit Process/Inspections sections.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q59 Is there a re-inspection fee? Corrections & re-inspection

$130.86 per inspection (general Building Division 'Excess Inspection/Excess Re-inspection/Missed Inspection Fee'), applicable beginning with the second re-inspection -- the base permit fee already covers up to three plan reviews and the first re-inspection. No PV-specific re-inspection fee line exists.

Why the confidence is not higherMaster Fee Schedule (Aug 17, 2026), Building Fees item 11(a) and footnote [d]: 'Base fees include up to three plan reviews and any typically required inspections and first re-inspections. ... Excess inspection fees apply beginning with second re-inspection.'

fee schedule checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4427/Master-Fee-Schedule-Effective-August-17-2026

Q60 How are corrections issued and cleared? Corrections & re-inspection

If an application is deemed incomplete, a written correction notice detailing all deficiencies and any additional information/documentation required for expedited eligibility is sent to the applicant for resubmission.

Why the confidence is not higherMSMC 9.01.080(F)(f), verbatim, for the small-residential-rooftop-solar expedited path.

municipal code checked 2026-08-31 https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Q61 What is issued on pass? Core Final sign-off & PTO

Final (a passed final inspection / permit sign-off)

Why the confidence is not higherThe codified expedited path and the PV/ESS handouts describe only a single final inspection with no separate Certificate of Occupancy process mentioned for a PV/ESS retrofit on an existing dwelling; no document explicitly names what document/tag is issued on pass (e.g. a green tag), so this is inferred from the process description rather than a direct statement of the artifact issued.

department handout checked 2026-08-31 https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Nothing published by this authority.

Where we lookedPV handout, ESS handout, Building Permit Submittal Requirements handout -- none mentions Permission to Operate (PTO), net energy metering, or who initiates utility notification after final inspection.

https://www.montesereno.org/DocumentCenter/View/4382/Photovoltaic-Systems

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Monte Sereno against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Monte Sereno is the authority having jurisdiction 92% confidence
Holds
Building and Electrical (self-performed, in-house Building Division); Fire Code plan review for the project is routed to the Santa Clara County Fire Department (SCCFD), which is the fire authority named on the City's own Building Permit Submittal Requirements handout and confirmed as serving Monte Sereno on SCCFD's own site
Delegated to
Santa Clara County Fire Department (fire-code plan review only, per the City's Building Permit Submittal Requirements handout item K: 'The City of Monte Sereno will route the plans to the Santa Clara County (SCC) Fire Prevention Division for their review of fire code requirements')
Overridden by
CA Gov. Code Section 65850.5 / AB 2188, codified verbatim as MSMC 9.01.080 'Expedited permit process for small residential rooftop solar systems' -- this caps the City's review to health-and-safety compliance and mandates same-day/1-3-business-day issuance and a single inspection for systems <=10kW AC / 30kW thermal on a single- or duplex-family dwelling. AB 130 (Stats. 2025, Ch. 22) also currently bars the City from adopting any new more-restrictive residential amendment through 1 Jun 2031.
Why not higher
The City's own Building Division issues residential PV and ESS permits directly through its ePermits portal (both listed as distinct online minor-permit types) and its own dated (3/2026) 'Residential Photovoltaic Systems' and 'Residential Energy Storage Systems' handouts describe a City-run submittal, review and single-inspection process. Its Municipal Code (MSMC Ch. 9.01, Ord. NS-248, adopted 11-18-2025) adopts the 2025 CBC/CRC/CEC/CFC/CGBC/WUI Code in full, including a codified small-residential-solar expedited-permitting section (9.01.080) that tracks AB 2188 verbatim (oddly still using the word 'Town' throughout, apparently inherited boilerplate from a neighbouring Town's model ordinance -- worth flagging even though Monte Sereno is legally a City). The City's own Building Permit Submittal Requirements handout states plans are routed to SCC Fire Prevention Division for fire-code review; SCCFD's own site confirms it serves Monte Sereno as a member jurisdiction. The staff directory lists no title called 'Building Official' -- only a 'Building Inspector/Code Enforcer' (city email) and a 'Building Consultant' (routed only to a generic buildingdepartment@ email, no firm name given anywhere) -- so plan-check may rest with a contracted individual, but this is inference, not a stated fact, and I could not confirm a firm.

https://library.municode.com/ca/monte_sereno/codes/code_of_ordinances?nodeId=MUCO_TIT9BUCO_CH9.01CABUSTCO_9.01.080EXPEPRSMREROSOSY

Permit required
Yes98%
Permit cost
$196.19 flat (Building fee schedule line item 'Solar'); a $150 plan-check deposit is collected at submittal and credited toward this fee.88%
Plan review
For a qualifying small residential rooftop solar system (<=10kW AC/30kW thermal, single/duplex dwelling): same-day issuance for over-the-counter applications,90%
Portal
ePermits (epermits.montesereno.org)95%
Electrical code
202380%
Own placard wording
No65%
Booking an inspection
Portal / Phone90%
Labels & placards for this authority

Wording 65%

No

Size, colour & material 95%

All marking and labeling shall be a minimum of 3/8" high white letters on a red background, in a material suitable for the environment where it is located (unless otherwise specified for a given label type).

Where they go 90%

Each label/placard is tied to a specific device or junction point (service disconnect proximity, PV/DC disconnects, interconnection points, rapid-shutdown initiation device, back-fed breakers, multi-source busbars, combiner/junction boxes, and service equipment/disconnect locations) -- see q38 for the full list with code citations.

What the utility wants on top None%

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Santa Clara County
Regions served
1
Regions covered
City of Monte Sereno · city
Solar Requirements
Required placards
Building and Planning Departments | Monte Sereno, CA - Official Website Skip to Main Content Create a Website Account - Manage notification subscriptions, save form progress and more. Website Sign In Search Home Government Departments Building and Planning Departments Building and Planning Departments The Building Department is responsible for administering the California Building Code requirement
Separate roof inspection
New land use policies are also prepared by planning staff for consideration by the Site and Architectural Commission and City Council. Counter Hours The Building Department and Planning Department staff are generally available Monday, Wednesday, and Friday from 10:00 am - 12:00 pm at City Hall. Outs
Authority Contact
Address
18041 Saratoga-Los Gatos Road, Monte Sereno, CA 95030
Main Phone
(408) 354-7635
Building Department
Department
Building Department
Direct Phone
(408) 354-2805
Booking & Scheduling
Preferred channel
online
Notes
Inspections are normally performed on Mondays, Wednesdays, and Fridays between 9:00 am and 12:00 pm; no specific time slot is guaranteed. Schedule online at epermits.montesereno.org or by phone at (408) 354-2805. Online scheduling requires: project number, street number and name, inspection type (select "Final"), requester name, email, and phone number. General building dept email: buildingdepartment@cityofmontesereno.org. Building department counter hours: Mon/Wed/Fri 10 am–12 pm. City Hall is open Mon/Wed/Fri 9 am–12 pm and 1 pm–4 pm; closed Tue/Thu except by appointment. Inspector direct line: (408) 498-5282 (Alan Cunningham). (collected Jul 2026)
