City of Pacific Grove
Monterey County
City of Pacific Grove is a city authority in the State of California, serving 15,090 residents. 530 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, the 2025 edition code cycle it enforces, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 3 business days Q18 Where you file — iWorq (portal.iworq.net/PACIFICGROVE) -- also referenced as 'pacificgrove.portal.iworq.net'. Q20
- Permit required
- Yes98% source
- What it costs
- $720 flat (FY26-27, effective 1 Sep 2026 for Community Development fees)90% source
- Plan review turnaround
- 3 business days95% source
- Key document
- municipal code (control-checked absence) cited by 7 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 96% · municipal code
- What does this authority permit itself, and what does it delegate? Both 82% · staff directory
- Is a permit required for a residential rooftop PV system? Yes 98% · municipal code
- Is there a separate electrical permit, or is it combined? Combined 90% · permit application form
- Is a HOA or architectural approval required first? No 88% · municipal code
- Is there a historic-district review? Conditional/discretionary for HRI-listed properties only. PGMC §18.45.070(a): 'A use permit and/or architectural review may be required for properties on the city's historic resources inventory as deemed necessary by the community and economic development director,' guided by Chapter 23.76 PGMC (Historic Preservation). Critically, the City's ZONING code creates the same split independently: PGMC §23.70.015(e)(6) EXEMPTS 'solar energy equipment' from Community Development Permit/Design-Review requirements on properties NOT on the Historic Resources Inventory, while the parallel exemption list for HRI-LISTED properties, §23.70.015(d), does NOT include solar among its enumerated exemptions (only re-roofing, restoration of historic elements, and foundation/skirting work). So a non-HRI rooftop retrofit is broadly exempt from any zoning-code discretionary review, while an HRI-listed property's solar installation falls through to the discretionary review described in §18.45.070 and Ch. 23.76. 95% · municipal code
- Is a wind or windstorm certification required? No 68% · municipal code (control-checked absence)
- Is a Specific Use Permit or Council approval ever required? Yes, possible: PGMC §18.45.060(a) allows the building official to require a use permit 'if the official finds, based on substantial evidence, that the solar energy system could have a specific, adverse impact upon the public health and safety,' appealable to the planning commission; and §18.45.070(a) allows a use permit/architectural review requirement for HRI-listed properties at the community and economic development director's discretion (see Q25). 92% · municipal code
- Is there a system-size cap on residential generation? 10 kW AC nameplate / 30 kW thermal, on a single- or duplex-family dwelling, not exceeding the maximum legal building height -- the definition of 'small residential rooftop solar energy system' that must be met to use the chapter's expedited path. PGMC §18.45.030 cites this as implementing AB 2188 (2014), NOT Gov. Code §65850.5 or §65850.52 by name. The zoning code's own height-exceptions table (in the Ch. 23 accessory-structures/height section) cross-references 'Solar panels – See Chapters 18.45 and 23.70 PGMC' rather than granting any separate numeric height bonus -- i.e. no additional feet are granted beyond the solar ordinance's own 'does not exceed maximum legal building height' cap. This is the 'no bonus, cross-reference back to the solar chapter' outcome, distinct from cities that grant extra feet (Greenfield +5ft) or set an explicit cap in a use table. 90% · municipal code
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 85% · permit application form
- Must the contractor be registered with this authority before applying? Yes 55% · municipal code
- Is a homeowner permitted to self-install and self-permit? Yes 90% · permit application form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? No dedicated solar submittal checklist is published (confirmed 404 on the site's own 'SolarApp+' sub-link and a 'not in service' notice on the live SolarAPP+ page). The published minimum is the one-page OTC 'ELECTRICAL, MECHANICAL, PLUMBING, RE-ROOF, AND SOLAR PERMITS' application itself (project address/APN, valuation, scope of work, owner/applicant/contractor info, CSLB license, signature) -- plans/spec sheets are collected at counter/portal intake but no published document enumerates them for solar specifically. 70% · department page + permit application form
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? iWorq (portal.iworq.net/PACIFICGROVE) -- also referenced as 'pacificgrove.portal.iworq.net'. Not SolarAPP+ (the City's own SolarAPP+ page states: 'The Solar App+ System is not in service at this time for the City of Pacific Grove.') and not Symbium. 92% · department page
- Can the whole application be completed online? Yes, largely -- the iWorq solar permit application is a full online form (property/contractor/owner info, file upload for plans, 'Pay Fees' section) that can be submitted without an in-person visit, though inspections themselves are booked separately by phone. 78% · permit portal
- What does a residential solar permit cost? $720 flat (FY26-27, effective 1 Sep 2026 for Community Development fees) 90% · fee schedule
- How is the fee calculated? Flat 88% · fee schedule
- Is there a separate plan-check fee? No (for the standard flat solar permit) 70% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 3 business days 95% · municipal code
- How long is an issued permit valid before it expires? Application expires 180 days after submittal if no permit is issued; once issued, the City's Building Permits page states permits 'expire 180 days after permit issuance or last inspection.' 82% · department page + permit application form
- Which utility handles interconnection here? Pacific Gas & Electric Company (PG&E) is the electric (and gas) utility; Central Coast Community Energy (3CE / 'CCE') is the Community Choice Aggregator for generation, billed on the same PG&E bill. 92% · city utilities page + CCA member list
- Where does the utility sit in the sequence? Parallel -- PG&E interconnection approval runs alongside the City's building/electrical permit and inspection process rather than gating permit issuance; PG&E's own Rule 21 tariff requires evidence of the AHJ's final electrical-inspection clearance before Permission to Operate is granted. 60% · utility tariff
28 questions answered against City of Pacific Grove’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherPGMC § 18.45.020(a): 'This chapter applies to the permitting of all small residential rooftop solar energy systems in the city of Pacific Grove.' Own Building Division (Community Development Dept.) issues the permit.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherThe City's own Building Division issues both building and electrical permits for solar (combined permit, see Q4). BUT the Chief Building Official position itself is held by a named individual on a @4leafinc.com email (John Kuehl) per the City's current staff directory -- i.e. the plan-check/building-official function is contracted to 4LEAF Inc. while the Permit Technician and other CD staff remain on the city domain -- and fire code enforcement was absorbed into the City of Monterey Fire Department by a Dec. 2008 merger (Monterey's own Fire Chief and Assistant Fire Chief, on @monterey.gov emails, are listed as PG's own Fire Dept. staff on PG's current staff directory). No PGMC section names either arrangement; both rest on the city's own current pages, not the codified text.
staff directory checked 2026-08-31 https://www.cityofpacificgrove.gov/how_do_i/view/staff_directory.php
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherPGMC § 18.45.020(a), quoted above; also confirmed by the OTC permit application form's dedicated 'Solar' permit-type line.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe City's own 'APPLICATION FOR ELECTRICAL, MECHANICAL, PLUMBING, RE-ROOF, AND SOLAR PERMITS' (OTC form) has a single 'Solar' line under Permit Type with no separate electrical box, and the FY26-27 Community Development fee schedule carries one flat 'Solar voltaic system $720' line (not a separate electrical + building pair).
permit application form checked 2026-08-31 https://www.cityofpacificgrove.gov/Document_Center/Departments/Community%20Development/Building%20Permits%20%26%20Inspections/otc-permit-application-form-revised-9-26-19.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherOTC application form's applicant block offers 'Owner / Applicant / Licensed Contractor' as the Primary Applicant with no restriction to a specific electrician license class; Contractor block asks only for CSLB License No./Class/Expiration.
permit application form checked 2026-08-31 https://www.cityofpacificgrove.gov/Document_Center/Departments/Community%20Development/Building%20Permits%20%26%20Inspections/otc-permit-application-form-revised-9-26-19.pdf
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherPGMC Title 7 (Business Licenses and Regulations) taxes/licenses businesses including general contractors operating in the city (§ covering general-contractor receipts and subcontractor licensing under 'this chapter'); however, neither the OTC solar/electrical permit application nor the general Building Permit Application form itself has a City-business-license field, so this is inference from the general business-license ordinance rather than a stated permit precondition.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48183279
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherOTC application form's Applicant block includes an 'Owner-Builder' checkbox distinct from 'Licensed Contractor'; the City's Building Permits page states a permit 'will only be issued to a California State licensed Professional or the owner of the property.'
permit application form checked 2026-08-31 https://www.cityofpacificgrove.gov/Document_Center/Departments/Community%20Development/Building%20Permits%20%26%20Inspections/otc-permit-application-form-revised-9-26-19.pdf
Q8 What documents make up a complete submittal? Core Submittal package
No dedicated solar submittal checklist is published (confirmed 404 on the site's own 'SolarApp+' sub-link and a 'not in service' notice on the live SolarAPP+ page). The published minimum is the one-page OTC 'ELECTRICAL, MECHANICAL, PLUMBING, RE-ROOF, AND SOLAR PERMITS' application itself (project address/APN, valuation, scope of work, owner/applicant/contractor info, CSLB license, signature) -- plans/spec sheets are collected at counter/portal intake but no published document enumerates them for solar specifically.
Why the confidence is not higherBuilding Permits & Inspections page's own link inventory and Document Center were checked in full; only the OTC form, the EVSE checklist and a Title 24 code-changes bulletin are published under 'Building Submittal Requirements and Handouts' -- no PV-specific checklist exists.
department page + permit application form checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php
Q9 How many copies, and in what format? Submittal package
Nothing published by this authority.
Where we lookedOTC form, iWorq portal page (608/10808), and Building Permits page -- none specify number of copies or a page-count/format standard for solar submittals beyond 'file upload' on the iWorq portal
Q10 Is a site plan required, and what must it show? Core Submittal package
Nothing published by this authority.
Where we lookedNo solar-specific checklist exists (see Q8) specifying required site-plan content; the general Building Permit Application (for plan-check-triggering projects) does not address solar
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Nothing published by this authority.
Where we lookedNo solar-specific checklist requiring a one-line/three-line diagram was found; the OTC solar application itself has no drawing-content requirements listed
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedNo solar-specific checklist addressing string/conductor calculations was found
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedNo solar-specific checklist or ordinance section states a structural PE-stamp threshold for PV; general CBC structural provisions apply by default (2025 CBC, unamended for this purpose in Ch. 18.04)
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedSame as Q13 -- no PG-specific electrical PE-stamp threshold found for solar
Q15 What does a residential solar permit cost? Core Fees
$720 flat (FY26-27, effective 1 Sep 2026 for Community Development fees)
Why the confidence is not higherFY 2026-27 Master Fee Schedule - Community Development, 'MISCELLANEOUS BUILDING PERMITS' section: 'Solar voltaic system $720' (pdfinfo CreationDate/ModDate 2 Jun 2026 -- current). Prior FY24-25 schedule carried $670 for the identical line, confirming this is a routine annual update, not a one-off.
fee schedule checked 2026-08-31 https://www.cityofpacificgrove.gov/Document_Center/Departments/Administrative%20Services/Annual%20Budget%20%26%20Financial%20Reports/Master%20Fee%20Schedules/FY%202026-27/Master%20Fee%20Scedule%20FY%202026-27%20-%20COMMUNITY%20DEV.pdf
Q16 How is the fee calculated? Core Fees
Flat
Why the confidence is not higherThe $720 solar-voltaic line sits in the flat-dollar 'MISCELLANEOUS BUILDING PERMITS' table alongside flat Electrical/Plumbing/Mechanical/Reroof permits, distinct from the separate valuation-based 'PLAN CHECK' table used for new construction.
fee schedule checked 2026-08-31 https://www.cityofpacificgrove.gov/Document_Center/Departments/Administrative%20Services/Annual%20Budget%20%26%20Financial%20Reports/Master%20Fee%20Schedules/FY%202026-27/Master%20Fee%20Scedule%20FY%202026-27%20-%20COMMUNITY%20DEV.pdf
Q17 Is there a separate plan-check fee? Fees
No (for the standard flat solar permit)
Why the confidence is not higherThe 'MISCELLANEOUS BUILDING PERMITS' section header groups Electrical/Plumbing/Mechanical permits explicitly as '(not requiring plan check)', and 'Solar voltaic system' is listed in the same block; the schedule's separate 'PLAN CHECK' section states a plan-review fee applies 'in cases of new construction' as an alternative to the flat fees. No solar-specific plan-check line exists. Confidence held at 70 because the '(not requiring plan check)' qualifier is stated only against the first three line items, not repeated against the Solar line itself.
fee schedule checked 2026-08-31 https://www.cityofpacificgrove.gov/Document_Center/Departments/Administrative%20Services/Annual%20Budget%20%26%20Financial%20Reports/Master%20Fee%20Schedules/FY%202026-27/Master%20Fee%20Scedule%20FY%202026-27%20-%20COMMUNITY%20DEV.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
3 business days
Why the confidence is not higherPGMC § 18.45.060(a): the Building Department 'shall issue a building permit or other nondiscretionary permit within three business days for over-the-counter applications or up to three business days for electronic applications of receipt of a complete application.'
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q19 How long is an issued permit valid before it expires? Timeline & validity
Application expires 180 days after submittal if no permit is issued; once issued, the City's Building Permits page states permits 'expire 180 days after permit issuance or last inspection.'
Why the confidence is not higherOTC/Building Permit Application forms both state '180 days from date of application' for application expiration; the Building Permits & Inspections department page separately states the 180-day-from-issuance-or-last-inspection rule for issued permits. Note this is a shorter/different figure than the standard CBC §105.5 one-year default; PGMC §18.04 does not codify a separate solar-specific permit-validity period.
department page + permit application form checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php

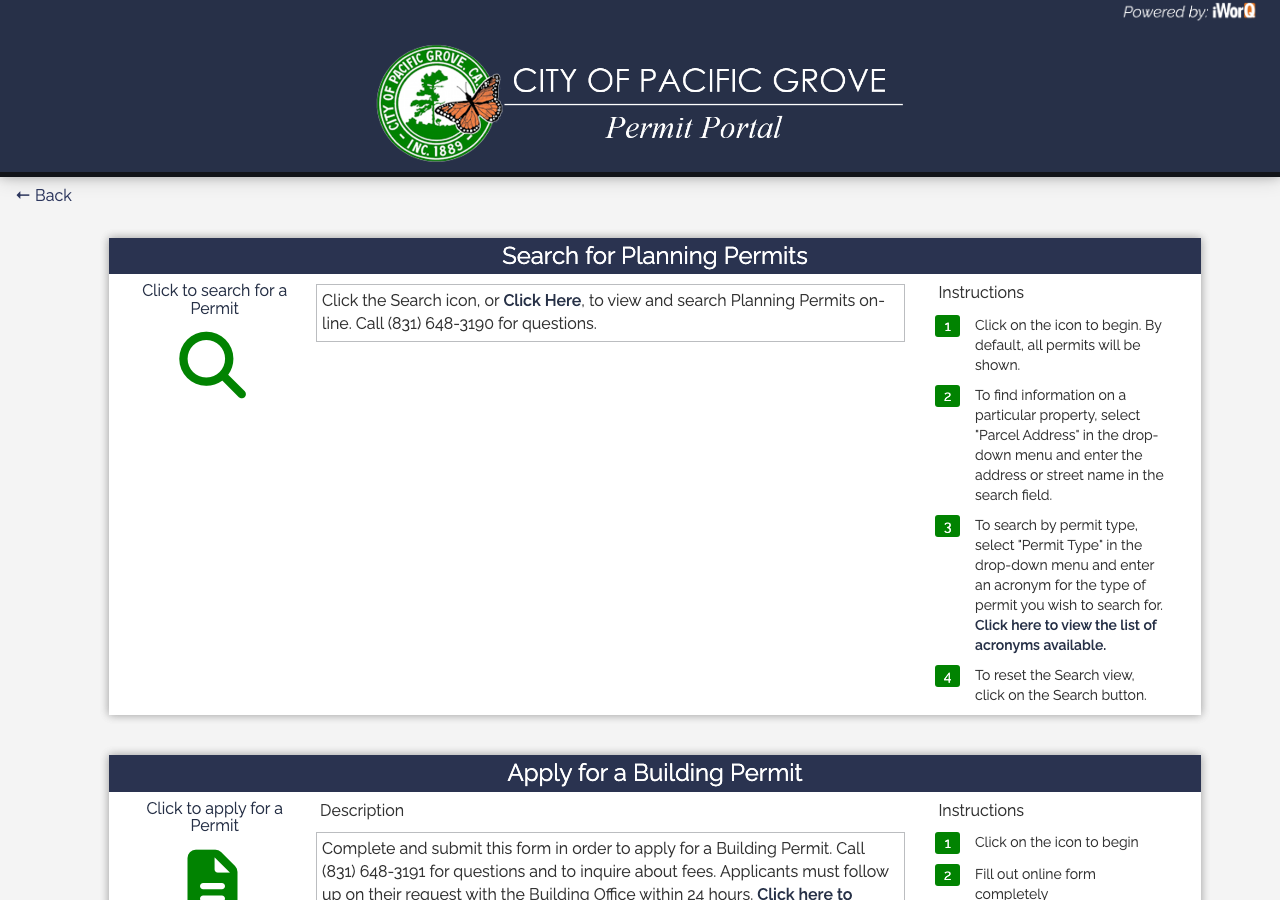

Q20 Which permit portal does this authority use? Core Portal & process
iWorq (portal.iworq.net/PACIFICGROVE) -- also referenced as 'pacificgrove.portal.iworq.net'. Not SolarAPP+ (the City's own SolarAPP+ page states: 'The Solar App+ System is not in service at this time for the City of Pacific Grove.') and not Symbium.
Why the confidence is not higherBuilding Permits & Inspections page links a dedicated 'Solar Permit Application' to portal.iworq.net/PACIFICGROVE/new-permit/608/10808; the City's own SolarAppPlus.php page states SolarAPP+ is not in service.
department page checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php
Q21 Can the whole application be completed online? Core Portal & process
Yes, largely -- the iWorq solar permit application is a full online form (property/contractor/owner info, file upload for plans, 'Pay Fees' section) that can be submitted without an in-person visit, though inspections themselves are booked separately by phone.
Why the confidence is not higherDirect review of the iWorq 'new-permit/608/10808' solar application form.
permit portal checked 2026-08-31 https://portal.iworq.net/PACIFICGROVE/new-permit/608/10808
Q22 Which utility handles interconnection here? Core Utility interconnection
Pacific Gas & Electric Company (PG&E) is the electric (and gas) utility; Central Coast Community Energy (3CE / 'CCE') is the Community Choice Aggregator for generation, billed on the same PG&E bill.
Why the confidence is not higherCity's own 'Electricity & Gas' utility-services page states plainly: 'Gas and Electricity for the City is provided by Pacific Gas and Electric Company (PG&E)' (not taken from PowerToChoose). Central Coast Community Energy's own current rebates/incentives page, filtered to 'Member Agency', lists 'City of Pacific Grove' by name among its member jurisdictions -- confirming 3CE/CCE membership from the CCA's own site rather than inference.
city utilities page + CCA member list checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/public_works/utility_services/electricity___gas.php
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel -- PG&E interconnection approval runs alongside the City's building/electrical permit and inspection process rather than gating permit issuance; PG&E's own Rule 21 tariff requires evidence of the AHJ's final electrical-inspection clearance before Permission to Operate is granted.
Why the confidence is not higherNo Pacific Grove-specific document states the utility sequencing for solar; this is inferred from PG&E's own statewide Electric Rule 21 tariff (§D.13.b: PTO for NEM ≤61kW processed within 30 business days of receiving, among other items, 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction'), which applies uniformly to all PG&E territory including Pacific Grove. Downloaded and confirmed live (26MB PDF) in this run.
utility tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherPGMC § 18.45.060(f): 'The city shall not condition approval of an application on the approval of an association, as defined in Section 4080 of the Civil Code.' No architectural-review/HOA step appears in §18.45's own administrative, nondiscretionary review process for non-historic properties (see also Q25 for historic-listed properties, and Q27 for the zoning-code exemption).
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q25 Is there a historic-district review? Overlays & special cases
Conditional/discretionary for HRI-listed properties only. PGMC §18.45.070(a): 'A use permit and/or architectural review may be required for properties on the city's historic resources inventory as deemed necessary by the community and economic development director,' guided by Chapter 23.76 PGMC (Historic Preservation). Critically, the City's ZONING code creates the same split independently: PGMC §23.70.015(e)(6) EXEMPTS 'solar energy equipment' from Community Development Permit/Design-Review requirements on properties NOT on the Historic Resources Inventory, while the parallel exemption list for HRI-LISTED properties, §23.70.015(d), does NOT include solar among its enumerated exemptions (only re-roofing, restoration of historic elements, and foundation/skirting work). So a non-HRI rooftop retrofit is broadly exempt from any zoning-code discretionary review, while an HRI-listed property's solar installation falls through to the discretionary review described in §18.45.070 and Ch. 23.76.
Why the confidence is not higherRead verbatim from both the current codified solar chapter (§18.45.070) AND the current codified zoning-code general exemptions section (§23.70.015(d)/(e)), which independently corroborate the same historic/non-historic split from two different chapters of the same code -- Pacific Grove has 'well over a thousand designated historic homes' per brief, so this reaches a large share of the housing stock.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48188362
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherFull-text search of the codified Building Codes chapter (18.04, including all 2025 CBC/CRC/CFC local amendments) and the Fire Prevention chapter (18.32) found no wind/windstorm-certification requirement; California uses the standard CBC/ASCE structural path rather than a TDI-style certification. Positive control ('electrical', 16 hits) and fabricated control ('zzqqx', 0 hits) both passed in the same extracted text.
municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Yes, possible: PGMC §18.45.060(a) allows the building official to require a use permit 'if the official finds, based on substantial evidence, that the solar energy system could have a specific, adverse impact upon the public health and safety,' appealable to the planning commission; and §18.45.070(a) allows a use permit/architectural review requirement for HRI-listed properties at the community and economic development director's discretion (see Q25).
Why the confidence is not higherVerbatim from the current codified solar ordinance.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC nameplate / 30 kW thermal, on a single- or duplex-family dwelling, not exceeding the maximum legal building height -- the definition of 'small residential rooftop solar energy system' that must be met to use the chapter's expedited path. PGMC §18.45.030 cites this as implementing AB 2188 (2014), NOT Gov. Code §65850.5 or §65850.52 by name. The zoning code's own height-exceptions table (in the Ch. 23 accessory-structures/height section) cross-references 'Solar panels – See Chapters 18.45 and 23.70 PGMC' rather than granting any separate numeric height bonus -- i.e. no additional feet are granted beyond the solar ordinance's own 'does not exceed maximum legal building height' cap. This is the 'no bonus, cross-reference back to the solar chapter' outcome, distinct from cities that grant extra feet (Greenfield +5ft) or set an explicit cap in a use table.
Why the confidence is not higherPGMC §18.45.030 definitions, quoted verbatim, cross-checked against the zoning height-exceptions table found via full-text search of Title 23.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC (as the basis of the 2025 California Electrical Code) 88% · municipal code
- Which building code edition is in force? 2025 California Building Code, 2025 California Residential Code (incl. Appendix BO), 2025 California Existing Building Code, 2025 California Historic Building Code, and 2025 California Green Building Standards Code, all adopted by PGMC §18.04.010(a). 95% · municipal code
- Which fire code edition is in force? 2025 California Fire Code (Title 24, CCR, Part 9), adopted with local amendments per PGMC §18.04.010(a)(10)/(b)(2). 95% · municipal code
- Are there local amendments to any of the above? Yes 92% · municipal code
- What is the installation judged against? The unamended 2025 California Electrical Code (Art. 690/705), plus CEC/IEEE/UL/CPUC safety and performance standards named directly in the solar ordinance. 88% · municipal code
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Base, unamended 2025 CFC §1205 (ridge setback / access pathways) applies -- no local amendment to §1205 was found. 85% · municipal code (control-checked absence)
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes, rapid shutdown applies under the 2025 CEC (2023 NEC basis, i.e. NEC §690.12), adopted without local amendment. The City's own code never cites §690.12 by section number anywhere (same pattern seen in neighboring Monterey and Marina) -- it is a consequence of unamended state-code adoption, not a locally-stated rule. 78% · municipal code
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Not locally specified by the AHJ -- no PV/ESS placard requirement was found anywhere in the codified, currently-amended Fire Prevention/Building Codes chapter (Ch. 18.04(b)(2)/18.32) or in any published Building Division handout. The base, unamended 2025 CFC §1205.1.1/705.10 signage requirements apply by default with no PG-specific wording, letter-height, colour or placement layered on top -- a genuinely different (and control-proven) shape from neighboring Marina and Monterey, whose locally-amended fire codes DO carry the 'SOLAR DISCONNECT INSIDE PANEL' / BESS placard language. 82% · municipal code (control-checked absence)
- Does the authority specify placard wording of its own? No 80% · municipal code (control-checked absence)
- Does it specify letter height, colour or material? Not specified locally -- see Q38/Q39. 78% · municipal code (control-checked absence)
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? No City-specific approved-equipment list; PGMC §18.45.040(c) requires only that equipment meet CEC/IEEE/UL/PUC standards generally. 70% · municipal code
- Is a ground mount treated as a structure? Not specifically addressed -- no ground-mount-specific solar zoning provision was found anywhere in Title 23 (Zoning). 72% · municipal code (control-checked absence)
- Is there a local rule on service upgrades or busbar sizing? No local minimum-busbar or service-upgrade sizing rule was found. 82% · municipal code (control-checked absence)
20 questions answered against City of Pacific Grove’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC (as the basis of the 2025 California Electrical Code)
Why the confidence is not higherPGMC §18.04.010(a)(4) adopts the '2025 California Electric Code (Title 24, CCR, Part 3)' by reference, current cycle (2025 Title 24 = 2023 NEC basis); no local amendments to the CEC were found in §18.04.010(b) (only CRC and CFC amendments appear there).
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code, 2025 California Residential Code (incl. Appendix BO), 2025 California Existing Building Code, 2025 California Historic Building Code, and 2025 California Green Building Standards Code, all adopted by PGMC §18.04.010(a).
Why the confidence is not higherVerbatim from PGMC §18.04.010(a), current codification.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (Title 24, CCR, Part 9), adopted with local amendments per PGMC §18.04.010(a)(10)/(b)(2).
Why the confidence is not higherVerbatim from PGMC §18.04.010.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherPGMC §18.04.010(b) amends the CRC (§R309.2, sprinkler-exception findings) and extensively amends the CFC (definitions, open burning, address ID, spark arrestors, sprinkler-area thresholds down to 500 sq ft for most Group classifications, mandatory Group R sprinklers with no small-dwelling exception, mandatory bathroom/under-stair/accessible-storage sprinklers, LPG storage limits, fire-apparatus-road grade). All via Ord. 25-019, effective 15 Oct 2025 -- squarely inside the AB 130 residential-amendment freeze window (1 Oct 2025-1 Jun 2031). Each amended section carries an explicit statutory 'FINDINGS' citation (e.g. 'related to home hardening', 'Geographical 1, Climatic 1', 'substantially equivalent to changes... in effect as of September 30, 2025') tracking the narrow H&SC §17958.5/17958.7 exceptions AB 130 requires for a more-restrictive residential amendment during the freeze -- even though the ordinance text never cites 'AB 130' by name. Note: Chapter 18.42 (Green Building Regulations / local reach code) was repealed outright by Ord. 13-019 in 2013, well before the freeze window, so no reach-code/AB130 tension exists there.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q33 What is the installation judged against? Core Electrical
The unamended 2025 California Electrical Code (Art. 690/705), plus CEC/IEEE/UL/CPUC safety and performance standards named directly in the solar ordinance.
Why the confidence is not higherPGMC §18.45.040(c): 'Solar energy systems for producing electricity shall meet all applicable safety and performance standards established by the California Electrical Code, the Institute of Electrical and Electronics Engineers, and accredited testing laboratories such as Underwriters Laboratories and, where applicable, rules of the Public Utilities Commission.'
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No local minimum-busbar or service-upgrade sizing rule was found.
Why the confidence is not higherFull-text search of Title 18 (Buildings and Construction) found zero hits for 'busbar', '225A', 'attic' (in an electrical-derating context), or any Palm-Springs-style local electrical amendment; Chapter 18.21 (Utilities) covers only undergrounding, not service sizing. Positive control ('electrical', 16 hits) and fabricated control ('zzqqx', 0 hits) both passed on the same extracted Title 18 text.
municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedNo solar-specific checklist or ordinance section addresses mounting-system/attachment-spacing requirements beyond the base, unamended 2025 CBC/CRC structural provisions; no dedicated solar submittal checklist exists to check (see Q8)
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Base, unamended 2025 CFC §1205 (ridge setback / access pathways) applies -- no local amendment to §1205 was found.
Why the confidence is not higherPGMC §18.04.010(b)(2)'s CFC amendment list (Ord. 25-019) covers §§101.1, 202, 307.1.1, 505.1, 605.3.1, 901.x, 903.x, 5704.2.9.6.1.0, 6104.2, D103.2 -- §1205 (Solar photovoltaic systems) is not amended anywhere in the current local fire-code chapter. Full-text search of Title 18 found zero hits for '1205', 'rapid shutdown', '690.12', or 'placard' outside of unrelated context (the lone 'ridge' hit was the word 'BRIDGE'). Positive control 'electrical' (16) and fabricated control 'zzqqx' (0) both passed.
municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes, rapid shutdown applies under the 2025 CEC (2023 NEC basis, i.e. NEC §690.12), adopted without local amendment. The City's own code never cites §690.12 by section number anywhere (same pattern seen in neighboring Monterey and Marina) -- it is a consequence of unamended state-code adoption, not a locally-stated rule.
Why the confidence is not higherPGMC §18.04.010(a)(4) adopts the 2025 CEC with no CEC-specific local amendments found in §18.04.010(b); confirmed by full-text search showing zero '690.12' hits in Title 18.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Not locally specified by the AHJ -- no PV/ESS placard requirement was found anywhere in the codified, currently-amended Fire Prevention/Building Codes chapter (Ch. 18.04(b)(2)/18.32) or in any published Building Division handout. The base, unamended 2025 CFC §1205.1.1/705.10 signage requirements apply by default with no PG-specific wording, letter-height, colour or placement layered on top -- a genuinely different (and control-proven) shape from neighboring Marina and Monterey, whose locally-amended fire codes DO carry the 'SOLAR DISCONNECT INSIDE PANEL' / BESS placard language.
Why the confidence is not higherFull-text search of Title 18 (including the current Ord. 25-019 fire-code amendment text in full) found zero hits for 'placard', '1205', 'disconnect' (in a PV context -- the one hit was in the unrelated EVSE chapter), or 'battery'/'energy storage'. Positive control ('electrical', 16) and fabricated control ('zzqqx', 0) both passed.
municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No
Why the confidence is not higherSame control-proven absence as Q38 -- the City has not adopted its own placard wording; it relies on the base unamended 2025 CFC.
municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Not specified locally -- see Q38/Q39.
Why the confidence is not higherSame control-proven absence.
municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedNo local facility-map/site-plan placard requirement beyond base CEC §705.10 was found in the codified fire/building chapters or any published handout
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedPG&E's own Greenbook/TD-2306M meter-proximity and placarding specification document is gated ('See your PG&E Job Owner for access') and was not independently retrieved, consistent with prior GovBot runs in PG&E territory
https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedNo PG-specific label-placement rule found beyond the base, unamended CFC/CEC default (see Q38-40)
Q44 Must equipment be on a specific approved list? Equipment listing
No City-specific approved-equipment list; PGMC §18.45.040(c) requires only that equipment meet CEC/IEEE/UL/PUC standards generally.
Why the confidence is not higherPGMC §18.45.040(c), quoted at Q33.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Nothing published by this authority.
Where we lookedNo PG-specific battery/ESS provision was found in the codified, currently-amended fire code (Ch. 18.04(b)(2)) or the solar ordinance (Ch. 18.45, which is silent on batteries); full-text search of Title 18 found zero hits for 'battery' or 'energy storage'. Base unamended 2025 CFC Ch. 12 (ESS) would apply by default but no PG document confirms local conditions
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Nothing published by this authority.
Where we lookedNo evidence of a separate ESS permit or inspection process found in any City document or fee schedule; FY26-27 Fire and Community Development fee schedules both control-checked with zero 'battery'/'photovoltaic' hits in Fire
Q47 Is a ground mount treated as a structure? Core Ground mount
Not specifically addressed -- no ground-mount-specific solar zoning provision was found anywhere in Title 23 (Zoning).
Why the confidence is not higherFull-text search of the entire extracted Title 23 (640,000+ characters) found only 2 total 'solar' hits and 0 'photovoltaic' hits city-wide -- one in the height-exceptions table (cross-referencing back to Ch. 18.45/23.70, no ground-mount language), one in the Design Review exemptions list (Q25). Positive control 'electrical' (10 hits) and fabricated control 'zzqqx' (0) both passed on the same extracted text, so this is a genuine, full-text-proven absence, not a TOC-level gap. A ground-mount PV array would likely be treated under the general 'accessory structure' provisions by inference, but no PG document states this.
municipal code (control-checked absence) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48188362
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedNo PG-specific or PG&E-specific document addressing AC-disconnect-to-meter distance/location was found; likely lives in PG&E's own gated Greenbook
https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone 92% · department page
- How much notice is required? Effectively next-business-day: 'Inspection requests received before 4:00 p.m. will be scheduled for the next business day.' The solar ordinance itself sets a tighter ceiling: PGMC §18.45.060(i), 'An inspection will be scheduled within two business days of a request,' for expedited-eligible small residential rooftop solar systems specifically. 90% · department page + municipal code
- Are same-day or AM/PM windows offered? Yes -- a same-day AM window: inspection requests are scheduled for a specific day, and 'To confirm the 2 hour time frame on the day of your inspection, please contact the main line at (831) 648-3191 between 8:00-9:00 am.' 88% · department page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 92% · municipal code
- If delegated, to whom? N/A -- not delegated for the final solar inspection itself; performed by the City's own Building Department per §18.45.060(h). (Note: the Chief Building Official position performing plan review/inspection oversight is itself staffed by a 4LEAF Inc. contractor per the current staff directory -- see Q2 -- but the inspection function legally sits with 'the building department,' not a named outside agency.) 75% · municipal code
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? A single consolidated final inspection performed by the Building Department, per PGMC §18.45.060(h)-(i); no rough-in/mid-roof stage for expedited-eligible systems. 90% · municipal code
- Is a rough-in or mid-roof inspection required? No 90% · municipal code
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? No 78% · department page
- What must be on site at inspection? Approved plans and the job card must be left on site; someone over the age of 18 must be present if access to the property/structure is required. 90% · department page
- Does the inspector verify labels and listings? Yes, by inference 60% · municipal code
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (a passed final/consolidated inspection closing out the permit) 55% · municipal code (inference)
- Is there a re-inspection fee? $148 (general re-inspection fee under CBC §108.8; no solar-specific re-inspection fee line exists) 85% · fee schedule
- How are corrections issued and cleared? For an incomplete application: PGMC §18.45.060(g) requires 'a written correction notice detailing all deficiencies in the application... sent to the applicant for resubmission.' For a failed inspection: §18.45.060(j), 'a subsequent inspection is authorized but need not conform to the requirements of this chapter' (i.e. the expedited timelines no longer bind once a system has failed once). 90% · municipal code
14 questions answered against City of Pacific Grove’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone
Why the confidence is not higherBuilding Permits & Inspections page: Inspection line (831) 648-3194 (also confirmable at the main 648-3191 line 8-9am for time-window confirmation); no online inspection-scheduling feature found on the iWorq portal pages reviewed.
department page checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php
Q50 How much notice is required? Core Booking & scheduling
Effectively next-business-day: 'Inspection requests received before 4:00 p.m. will be scheduled for the next business day.' The solar ordinance itself sets a tighter ceiling: PGMC §18.45.060(i), 'An inspection will be scheduled within two business days of a request,' for expedited-eligible small residential rooftop solar systems specifically.
Why the confidence is not higherBoth figures read directly from current City sources -- the department page's general practice and the codified solar-specific ordinance language.
department page + municipal code checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Yes -- a same-day AM window: inspection requests are scheduled for a specific day, and 'To confirm the 2 hour time frame on the day of your inspection, please contact the main line at (831) 648-3191 between 8:00-9:00 am.'
Why the confidence is not higherVerbatim from the Building Permits & Inspections department page.
department page checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherPGMC §18.45.060(h): 'Only one inspection may be required and performed by the building department for small residential rooftop solar energy systems eligible for expedited review.' This is the SAME shared model-ordinance sentence found (in near-verbatim form) in Claremont, La Verne, Marina, Cudahy, Colusa, El Segundo and Rancho Mirage -- Pacific Grove is a further confirmed instance of that lineage.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q53 If delegated, to whom? Core Who inspects
N/A -- not delegated for the final solar inspection itself; performed by the City's own Building Department per §18.45.060(h). (Note: the Chief Building Official position performing plan review/inspection oversight is itself staffed by a 4LEAF Inc. contractor per the current staff directory -- see Q2 -- but the inspection function legally sits with 'the building department,' not a named outside agency.)
Why the confidence is not higherPGMC §18.45.060(h) plus the staff-directory delegation finding at Q2.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q54 Which inspections are required, and in what order? Core Stages & sequence
A single consolidated final inspection performed by the Building Department, per PGMC §18.45.060(h)-(i); no rough-in/mid-roof stage for expedited-eligible systems.
Why the confidence is not higherPGMC §18.45.060(h)-(i), quoted above.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherPGMC §18.45.060(h) explicitly limits expedited-eligible systems to 'only one inspection.'
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q56 Does the inspector verify labels and listings? Core What is checked
Yes, by inference
Why the confidence is not higherPGMC §18.45.040(c) requires CEC/UL-listing compliance as a condition of the system meeting code, and the base (unamended) CFC/CEC would require labeling be checked at final; no single City document states outright 'the inspector verifies labels,' so this is inference from the general listing requirement rather than a stated inspection-checklist item.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q57 Is there a published inspection checklist? Core What is checked
No
Why the confidence is not higherThe Building Permits & Inspections page and Document Center were checked in full for a published solar inspection checklist; none exists (only the OTC application form and an unrelated EVSE checklist are published under 'Building Submittal Requirements and Handouts'). A general note that 'The approved plans and job card must be left at the site for inspector review' exists but is not a PV-specific checklist.
department page checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php
Q58 What must be on site at inspection? Core Documents on site
Approved plans and the job card must be left on site; someone over the age of 18 must be present if access to the property/structure is required.
Why the confidence is not higherVerbatim from the Building Permits & Inspections department page's inspection-requirements text.
department page checked 2026-08-31 https://www.cityofpacificgrove.gov/our_city/departments/community_development/building_permits___inspections/index.php
Q59 Is there a re-inspection fee? Corrections & re-inspection
$148 (general re-inspection fee under CBC §108.8; no solar-specific re-inspection fee line exists)
Why the confidence is not higherFY 2026-27 Master Fee Schedule - Community Development: 'Re-inspection fees assessed under provisions of CBC § 108.8 $148' -- the only re-inspection fee line in the schedule; no PV-specific line found (control-checked against the same document's full 'solar'/'electrical' hit set).
fee schedule checked 2026-08-31 https://www.cityofpacificgrove.gov/Document_Center/Departments/Administrative%20Services/Annual%20Budget%20%26%20Financial%20Reports/Master%20Fee%20Schedules/FY%202026-27/Master%20Fee%20Scedule%20FY%202026-27%20-%20COMMUNITY%20DEV.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
For an incomplete application: PGMC §18.45.060(g) requires 'a written correction notice detailing all deficiencies in the application... sent to the applicant for resubmission.' For a failed inspection: §18.45.060(j), 'a subsequent inspection is authorized but need not conform to the requirements of this chapter' (i.e. the expedited timelines no longer bind once a system has failed once).
Why the confidence is not higherVerbatim from the codified solar ordinance.
municipal code checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q61 What is issued on pass? Core Final sign-off & PTO
Final (a passed final/consolidated inspection closing out the permit)
Why the confidence is not higherNo City document uses CO/'green tag'/'letter' terminology for solar specifically; inferred from the single-consolidated-inspection structure of §18.45.060(h)-(i) and general municipal practice.
municipal code (inference) checked 2026-08-31 https://ecode360.com/print/PA4577?guid=48187591
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedNo Pacific Grove document (Building Permits page, solar ordinance, fee schedule, iWorq portal) states who -- AHJ, installer, or utility -- formally notifies PG&E for PTO; PG&E's own residential NEM/interconnection application pages were not independently fetched in this run
https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Pacific Grove against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Pacific Grove is the authority having jurisdiction 88% confidence
- Holds
- Building and Electrical permitting/plan-check for residential rooftop solar (Community Development Department, Building Division) -- combined OTC permit, own iWorq portal, own current fee line ($720 flat, FY26-27). BUT the Chief Building Official position is itself staffed by a named 4LEAF Inc. contractor (jkuehl@4leafinc.com) per the City's own current staff directory, while the Permit Technician and other Community Development staff remain on the @cityofpacificgrove.org domain -- a function-scoped delegation visible only in the staff directory, not on any process page or in the fee schedule's staffing appendix (none exists). Fire: Pacific Grove's own Fire & Emergency Preparedness page states plainly, in its own current text, 'In December 2008, the Pacific Grove Fire Department merged into the Monterey City Fire Department, creating a 67-person, 4-station department' -- and PG's own current staff directory lists its Fire Chief and Assistant Fire Chief on @monterey.gov emails. This is a genuine absorption/merger (like Windsor's true dissolution shape, not a mere service contract), confirmed independently from BOTH cities' own current pages (Monterey's Fire Dept. page names Pacific Grove among the jurisdictions it 'proudly serves' and maintains a Pacific-Grove-specific deferred-submittal plan-review form). Notably, the PGMC's own codified Fire Prevention chapter (18.32.020) still speaks generically of 'the chief of the fire department' with no PGMC section naming Monterey anywhere -- the merger is real and current on both cities' own pages/staff rosters but is NOT codified in Pacific Grove's municipal code. A separate 2010-reinstated Chapter 4.08 PGMC 'Volunteer Fire Department Association' survives as a ceremonial legacy body (preserving PGFD antique apparatus/records) with no operational fire-code role. The Fire fee schedule states outright: 'The City of Pacific Grove mirrors the City of Monterey's fee schedule for prevention services.'
- Delegated to
- City of Monterey Fire Department (fire suppression/prevention operations, since Dec. 2008); 4LEAF Inc. (Chief Building Official position only, building/electrical plan-check function)
- Overridden by
- Solar Rights Act, Civil Code §714, codified locally at PGMC §18.45.060(e)-(f) (bars conditioning approval on association/HOA approval); AB 130 (Stats. 2025, Ch. 22) freezes any MORE-restrictive local residential-code amendment 1 Oct 2025-1 Jun 2031 -- directly relevant because the City's current local Fire/Residential Code amendments were enacted via Ord. 25-019, EFFECTIVE 15 OCT 2025, squarely inside the freeze window, adding several more-restrictive residential sprinkler requirements (mandatory bathroom sprinklers, under-stair sprinklers, Group R with no small-building exception) -- each amended section carries the narrow H&SC §17958.5/17958.7 exception findings ('home hardening', 'Geographical/Climatic 1') that AB 130 requires, without citing 'AB 130' by name anywhere in the ordinance text. Pacific Grove's own certified Local Coastal Program (PGMC Ch. 23.90, current per Ord. 20-023, 2020) exempts 'improvements to an existing single-family residence' -- which would include a rooftop PV retrofit -- from Coastal Development Permit review under §23.90.040(a), UNLESS the residence sits on a beach/wetland/seaward of the mean high-tide line/an ESHA (including the Asilomar Dunes/Conference Grounds)/a highly-scenic-designated area/within 50ft of a coastal-bluff edge, or (for near-shore/scenic parcels) the work adds ≥10% floor area or height -- the same 'exempt-unless-narrow-carveouts' shape as Manhattan Beach/Dana Point, not Pacifica's mandatory-CDP shape.
- Why not higher
- Solar-permitting authority is established from the City's own current codified ordinance (PGMC Ch. 18.45) and its own Building Permits & Inspections department page (portal, fee, contact info). The building-official delegation and the fire-merger findings both rest on the City's own CURRENT staff directory (dated today) cross-corroborated by Monterey's own current Fire Dept. page and fee-schedule note -- strong but not codified, which is why confidence is held at 88 rather than 95: PGMC's own text never names either 4LEAF or Monterey.
- Permit required
- Yes98%
- Permit cost
- $720 flat (FY26-27, effective 1 Sep 2026 for Community Development fees)90%
- Plan review
- 3 business days95%
- Portal
- iWorq (portal.iworq.net/PACIFICGROVE) -- also referenced as 'pacificgrove.portal.iworq.net'. Not SolarAPP+ (the City's own SolarAPP+ page states: 'The Solar App+ System is not in service at…92%
- Electrical code
- 2023 NEC (as the basis of the 2025 California Electrical Code)88%
- Own placard wording
- No80%
- Booking an inspection
- Phone92%
Labels & placards for this authority
Wording 80%
No
Size, colour & material 78%
Not specified locally -- see Q38/Q39.
Where they go None%
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
