City of Palo Alto
Santa Clara County
City of Palo Alto is a city authority in the State of California, serving 68,572 residents. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — SolarAPP+-eligible systems: instant, automated same-day issuance ('available as instant permit'). Q18 Where you file — Accela Citizen Access (ACA), branded locally as the 'Palo Alto Online Permitting System (OPS),' for the building/electrical permit; Q20
- Permit required
- Yes95% source
- What it costs
- SolarAPP+ PV only: $655/permit (instant permit). SolarAPP+ PV+ESS: $1,331/permit (instant permit). Traditional review — Residential PV ≤10kW: $1,481/permit; PV >10kW: $1,868/permit;95% source
- Plan review turnaround
- SolarAPP+-eligible systems: instant, automated same-day issuance ('available as instant permit'). For projects routed through standard plan review (e.g., service upgrades, ESS, ineligible PV),70% source
- Key document
- absence in authority's own handout; California has no TDI-equivalent program cited by 14 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · authority's own handout
- What does this authority permit itself, and what does it delegate? Both 90% · authority's own handout
- Is a permit required for a residential rooftop PV system? Yes 95% · authority's own handout
- Is there a separate electrical permit, or is it combined? Combined 80% · fee schedule
- Is a HOA or architectural approval required first? No 60% · absence in authority's own checklist + state law context
- Is there a historic-district review? No — a rooftop PV retrofit on an existing single-family home does not by itself trigger Palo Alto's Historic-District/Individual Review (IR) process. 75% · authority-adopted design guideline (PAMC 18.12.110)
- Is a wind or windstorm certification required? No 60% · absence in authority's own handout; California has no TDI-equivalent program
- Is a Specific Use Permit or Council approval ever required? Only indirectly: Planning approval (not a Specific Use Permit or Council hearing) is required if a new, separate structure must be built to support the PV system (e.g., some ground-mount installations). Standard roof-mounted residential PV does not require Planning Commission or Council approval. 80% · published checklist
- Is there a system-size cap on residential generation? No stated numeric residential system-size cap beyond CPAU's Net Energy Metering program limit of 1 MW per generating facility. 70% · utility's own rule/regulation
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 55% · inference from authority's own document (absence of restriction)
- Must the contractor be registered with this authority before applying? No 60% · inference from absence across three authority documents
- Is a homeowner permitted to self-install and self-permit? Yes 60% · inference from authority's own FAQ + state law
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Building Permit Application; CPAU Photovoltaic Electric Load Sheet; Residential Electric Load Calculator; CPAU signed & approved Interconnection Agreement; site/roof plan; three-line electrical diagram; structural attachment details/calculations; waterproofing details; signage & labeling plan; manufacturer equipment spec sheets & installation instructions. 95% · published checklist
- How many copies, and in what format? Electronic submission only, via the Palo Alto Online Permitting System (OPS)/Accela Citizen Access (ACA) — no paper copies. Plan sheets, when produced, must be printable at 11"x17" minimum up to 30"x42" maximum, minimum 10-point (1/8") text. 90% · published checklist
- Is a site plan required, and what must it show? Yes — site/roof plan must show existing main panel and meter (with panel amperage), proposed PV panel and related equipment locations (panelboards, disconnects), existing roof penetrations (vents, chimneys, skylights), and property-line setback distances for any equipment not attached to the structure; elevation plans required if equipment is installed outside in a flood plain. 95% · published checklist
- Is a one-line / three-line diagram required? Yes — a three-line electrical diagram is required (not described as a one-line diagram). 95% · published checklist
- Are string and conductor calculations required? Yes 70% · published checklist
- Is a structural PE stamp required, and at what threshold? Conditionally required — a PE stamp is called for when structural calculations are needed (e.g., ballast systems, standing-seam roofs, tilt-up systems), listed as 'PE-stamped plans and calculations' under the Structural Calculation submittal item. No numeric system-size or roof-type threshold is stated in the published handout. 60% · published checklist (threshold not stated)
- Is an electrical PE stamp required, and at what threshold? No electrical PE stamp requirement is stated for standard residential PV/ESS. 65% · absence in authority's own handout
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

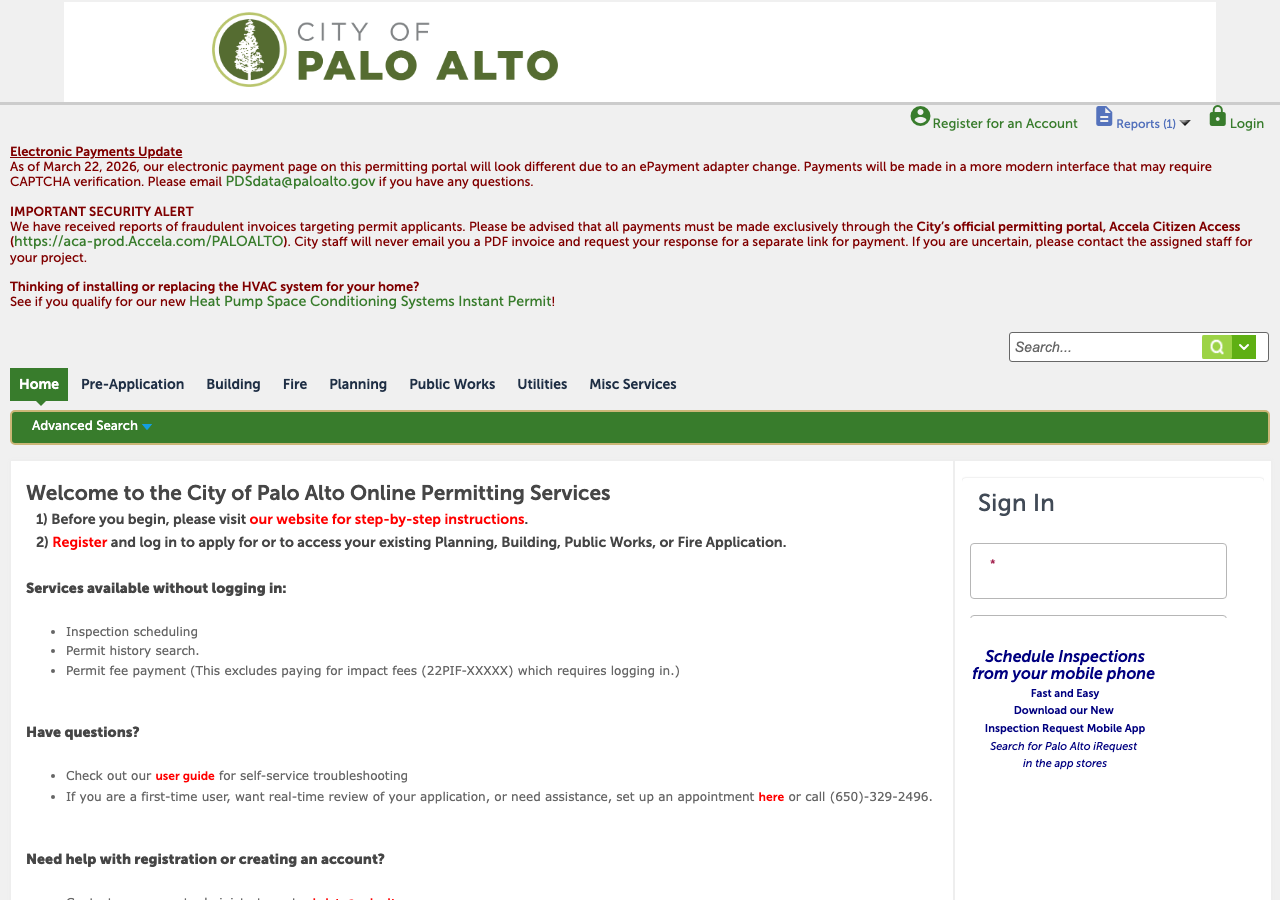

- Which permit portal does this authority use? Accela Citizen Access (ACA), branded locally as the 'Palo Alto Online Permitting System (OPS),' for the building/electrical permit; SolarAPP+ (gosolarapp.org) for the optional expedited PV pre-approval; the CPAU 'Utilities' tab within the same ACA portal for the Electric Utilities Pre-Approval. 95% · authority's own handout
- Can the whole application be completed online? Yes 90% · authority's own FAQ
- What does a residential solar permit cost? SolarAPP+ PV only: $655/permit (instant permit). SolarAPP+ PV+ESS: $1,331/permit (instant permit). Traditional review — Residential PV ≤10kW: $1,481/permit; PV >10kW: $1,868/permit; PV reinstallation: $1,002/permit. ESS (single-family/duplex): $1,859/permit. 95% · fee schedule
- How is the fee calculated? Tiered 90% · fee schedule
- Is there a separate plan-check fee? No 75% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? SolarAPP+-eligible systems: instant, automated same-day issuance ('available as instant permit'). For projects routed through standard plan review (e.g., service upgrades, ESS, ineligible PV), the department's own materials do not publish a specific business-day turnaround. 70% · fee schedule + absence of a published standard-review SLA
- How long is an issued permit valid before it expires? 12 months from issuance (permit becomes invalid if work is not commenced within 12 months, or is suspended/abandoned for 12 months); up to 3 extensions/reactivations of up to 180 days each may be granted by the Chief Building Official, more requires Council approval; all work must reach final inspection within 48 months of issuance. 95% · adopting ordinance + authority's own FAQ
- Which utility handles interconnection here? City of Palo Alto Utilities (CPAU) — a municipally owned electric utility. Palo Alto is not in PG&E territory. 98% · utility's own rule/regulation
- Where does the utility sit in the sequence? Before permit 90% · authority's own instructions + Rule 27
28 questions answered against City of Palo Alto’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherPlanning & Development Services (Development Services/Building Division) issues residential building and electrical permits for PV/ESS; PAMC Chapter 16.63 (Small Residential Rooftop Solar Energy Systems) and the department's own PV/ESS handouts confirm this is the permitting authority.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherDevelopment Services issues both the building permit and the electrical permit for residential PV/ESS as a single Building Permit Application (per the PV/ESS handouts). Interconnection/NEM approval is issued separately by City of Palo Alto Utilities (CPAU), a municipal electric utility, not delegated to an outside AHJ.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherPV handout title page lists applicable codes and states plans/forms must be submitted electronically for a permit; SolarAPP+ FAQ confirms a City permit is still required even after SolarAPP+ pre-approval.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe PV/ESS handouts list a single 'Building Permit Application' covering the PV/ESS work including electrical scope; the FY26 fee schedule lists 'Electrical Permits - Photovoltaic Systems' as a line item under one filing rather than a separately filed electrical permit, so electrical is combined into the same permit record.
fee schedule checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/2/development-services/building-permits/5.-fees/building-fee-schedule-fy26.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherNeither the PV nor ESS handout restricts who may pull the permit to a licensed electrician only; under CA Business & Professions Code §7044 an owner-builder may pull permits on their own single-family residence. No Palo Alto-specific restriction to licensed electricians was found in the published checklists.
inference from authority's own document (absence of restriction) checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
No
Why the confidence is not higherNo separate City contractor pre-registration step is described in the PV handout, ESS handout, or the SolarAPP+ FAQ/ACA registration guidance — the ACA portal application only asks for standard CSLB license information, not a distinct Palo Alto registration.
inference from absence across three authority documents checked 2026-08-30 https://www.paloalto.gov/Departments/Planning-Development-Services/Development-Services/Apply-for-a-Permit/Apply-for-a-Residential-SolarAPP-Permit
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherCA owner-builder exemption (Bus. & Prof. Code §7044) generally allows a homeowner to self-permit on their own single-family residence; the City's handouts do not state a contractor-only restriction. SolarAPP+'s own FAQ describes issuing permits to 'qualified businesses or individuals,' consistent with homeowner eligibility for at least the traditional (non-SolarAPP+) path.
inference from authority's own FAQ + state law checked 2026-08-30 https://www.paloalto.gov/Departments/Planning-Development-Services/Development-Services/Apply-for-a-Permit/Apply-for-a-Residential-SolarAPP-Permit
Q8 What documents make up a complete submittal? Core Submittal package
Building Permit Application; CPAU Photovoltaic Electric Load Sheet; Residential Electric Load Calculator; CPAU signed & approved Interconnection Agreement; site/roof plan; three-line electrical diagram; structural attachment details/calculations; waterproofing details; signage & labeling plan; manufacturer equipment spec sheets & installation instructions.
Why the confidence is not higherExact checklist under 'Submittal Information' in the current Residential Photovoltaic Systems handout.
published checklist checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q9 How many copies, and in what format? Submittal package
Electronic submission only, via the Palo Alto Online Permitting System (OPS)/Accela Citizen Access (ACA) — no paper copies. Plan sheets, when produced, must be printable at 11"x17" minimum up to 30"x42" maximum, minimum 10-point (1/8") text.
Why the confidence is not higherPV handout states 'All plans, forms and documents are to be submitted electronically through our Palo Alto Online Permitting System (OPS)' and specifies the plan sheet size/text-size General Requirements.
published checklist checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — site/roof plan must show existing main panel and meter (with panel amperage), proposed PV panel and related equipment locations (panelboards, disconnects), existing roof penetrations (vents, chimneys, skylights), and property-line setback distances for any equipment not attached to the structure; elevation plans required if equipment is installed outside in a flood plain.
Why the confidence is not higherDetailed under 'Applicable Forms/Documentation' and 'General Requirements' in the PV handout.
published checklist checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes — a three-line electrical diagram is required (not described as a one-line diagram).
Why the confidence is not higherListed explicitly as 'Three-line Electrical Diagram' in the PV handout submittal checklist and again in the Plan Review Information section.
published checklist checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Yes
Why the confidence is not higherA 'Residential Electrical Load Calculator'/'Residential Electrical Load Calculation' is a required submittal document and plan-review item; conductor sizing (CEC 310) and conduit fill are explicit plan-review/inspection checks, though the handout does not use the specific phrase 'string calculations.'
published checklist checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Conditionally required — a PE stamp is called for when structural calculations are needed (e.g., ballast systems, standing-seam roofs, tilt-up systems), listed as 'PE-stamped plans and calculations' under the Structural Calculation submittal item. No numeric system-size or roof-type threshold is stated in the published handout.
Why the confidence is not higherPV handout, Structural Attachment Details/Structural Calculation section, lists PE-stamped calculations as one required item 'as applicable' but does not define the trigger threshold in the extracted text.
published checklist (threshold not stated) checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
No electrical PE stamp requirement is stated for standard residential PV/ESS.
Why the confidence is not higherNeither the PV handout nor the ESS handout mentions an electrical PE stamp anywhere in their Submittal, Plan Review, or Inspection sections — only a structural PE stamp is called out (see q13). Treated as an authority-document absence, not a state-wide claim.
absence in authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q15 What does a residential solar permit cost? Core Fees
SolarAPP+ PV only: $655/permit (instant permit). SolarAPP+ PV+ESS: $1,331/permit (instant permit). Traditional review — Residential PV ≤10kW: $1,481/permit; PV >10kW: $1,868/permit; PV reinstallation: $1,002/permit. ESS (single-family/duplex): $1,859/permit.
Why the confidence is not higherCity of Palo Alto FY2026 Adopted Municipal Fee Schedule, Electrical Permits section (Photovoltaic Systems / Energy Storage System / SolarAPP+ line items). Live URL is blocked to automated fetch by Akamai bot protection; content verified from an Aug 2026 Wayback Machine capture of the identical live PDF (this is the FY26/current schedule, not a stale document).
fee schedule checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/2/development-services/building-permits/5.-fees/building-fee-schedule-fy26.pdf
Q16 How is the fee calculated? Core Fees
Tiered
Why the confidence is not higherTraditional-review PV fees are tiered by system size (≤10kW vs >10kW) per the FY26 fee schedule; SolarAPP+ and ESS categories are flat per-permit amounts within their own tier. No per-panel or straight building-valuation formula is used for these line items.
fee schedule checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/2/development-services/building-permits/5.-fees/building-fee-schedule-fy26.pdf
Q17 Is there a separate plan-check fee? Fees
No
Why the confidence is not higherThe FY26 fee schedule lists single all-inclusive per-permit amounts for each PV/ESS/SolarAPP+ category with no separate 'plan check' line item alongside them (contrast with the general valuation-based Building Permit Fees table, which does show that structure elsewhere for large projects).
fee schedule checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/2/development-services/building-permits/5.-fees/building-fee-schedule-fy26.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
SolarAPP+-eligible systems: instant, automated same-day issuance ('available as instant permit'). For projects routed through standard plan review (e.g., service upgrades, ESS, ineligible PV), the department's own materials do not publish a specific business-day turnaround.
Why the confidence is not higherFY26 fee schedule notes SolarAPP+ PV and SolarAPP+ PV+ESS as 'available as instant permit.' No authority document found stating a business-day SLA for the standard review track; third-party aggregator estimates (15-30+ business days) were not used because they are not the authority's own source.
fee schedule + absence of a published standard-review SLA checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/2/development-services/building-permits/5.-fees/building-fee-schedule-fy26.pdf
Q19 How long is an issued permit valid before it expires? Timeline & validity
12 months from issuance (permit becomes invalid if work is not commenced within 12 months, or is suspended/abandoned for 12 months); up to 3 extensions/reactivations of up to 180 days each may be granted by the Chief Building Official, more requires Council approval; all work must reach final inspection within 48 months of issuance.
Why the confidence is not higherPAMC §16.04.130/Building Code §105.5 Expiration (2025 CBC local amendment), confirmed again in the City's own SolarAPP+ FAQ page ('Issued permits expire 12 months after issuance').
adopting ordinance + authority's own FAQ checked 2026-08-30 https://www.paloalto.gov/Departments/Planning-Development-Services/Development-Services/Apply-for-a-Permit/Apply-for-a-Residential-SolarAPP-Permit
Q20 Which permit portal does this authority use? Core Portal & process
Accela Citizen Access (ACA), branded locally as the 'Palo Alto Online Permitting System (OPS),' for the building/electrical permit; SolarAPP+ (gosolarapp.org) for the optional expedited PV pre-approval; the CPAU 'Utilities' tab within the same ACA portal for the Electric Utilities Pre-Approval.
Why the confidence is not higherConfirmed across the PV/ESS handouts, the Electric Utilities Pre-Approval instructions, and the SolarAPP+ FAQ page.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/2/development-services/building-permits/9.-utility-forms-and-handouts/cpa-electric-utilities-pre-approval-pv-ess.pdf
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higherAll plans/forms/documents are submitted electronically through OPS/ACA; SolarAPP+ provides full online submission through to instant permit issuance for qualifying systems. A City ACA account/permit record is still required after SolarAPP+ approval, but that step is also completed online.
authority's own FAQ checked 2026-08-30 https://www.paloalto.gov/Departments/Planning-Development-Services/Development-Services/Apply-for-a-Permit/Apply-for-a-Residential-SolarAPP-Permit
Q22 Which utility handles interconnection here? Core Utility interconnection
City of Palo Alto Utilities (CPAU) — a municipally owned electric utility. Palo Alto is not in PG&E territory.
Why the confidence is not higherCPAU Rule 27 (Generating Facility Interconnections) governs interconnection of all Generating Facilities on 'the City of Palo Alto Utilities (CPAU) Electric Distribution System'; confirmed also by CPAU's own NEM program pages.
utility's own rule/regulation checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/1/utilities/rules-and-regulations/rule-27-generating-facility-interconnections-effective-2016-12-12.pdf
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Before permit
Why the confidence is not higherThe Electric Utilities Pre-Approval for PV/ESS is described as 'the first step to receiving a permit from the City of Palo Alto' and must be obtained and signed before the building permit application is submitted. Separately, final NEM/Permission-to-Operate approval is completed by CPAU within 30 business days AFTER CPAU receives evidence of final electrical inspection clearance from the Building Department — so interconnection sits both before permit application (pre-approval) and after permit completion (final NEM/PTO).
authority's own instructions + Rule 27 checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/2/development-services/building-permits/9.-utility-forms-and-handouts/cpa-electric-utilities-pre-approval-pv-ess.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherNo HOA or architectural-approval prerequisite is listed in the PV/ESS submittal checklists or the SolarAPP+ process description. California's Solar Rights Act (Civil Code §714) also bars HOAs from effectively prohibiting solar installations statewide.
absence in authority's own checklist + state law context checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q25 Is there a historic-district review? Overlays & special cases
No — a rooftop PV retrofit on an existing single-family home does not by itself trigger Palo Alto's Historic-District/Individual Review (IR) process.
Why the confidence is not higherThe City's own Single-Family Individual Review Guidelines (adopted under PAMC §18.12.110, applicable to Professorville and other R-1 areas) list IR triggers as new two-story homes, new second-story additions, additions of >150 sq ft of upper-story floor area, and (for Professorville) new one-story homes — not equipment retrofits such as rooftop solar. Text was extracted with pdftotext and checked for 'solar'/'photovoltaic' (no hits) and a fabricated control term (no hits), confirming the document is genuinely silent on solar, not a failed search.
authority-adopted design guideline (PAMC 18.12.110) checked 2026-08-30 https://arden.org/professorville/DraftIrGuidelinesBooklet.Professorville.pdf
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherNo wind/windstorm certification analogous to the Texas TDI program was found; California does not operate such a program and Palo Alto's own PV handout addresses wind loading only through standard CBC/CRC structural calculations, not a separate certification.
absence in authority's own handout; California has no TDI-equivalent program checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Only indirectly: Planning approval (not a Specific Use Permit or Council hearing) is required if a new, separate structure must be built to support the PV system (e.g., some ground-mount installations). Standard roof-mounted residential PV does not require Planning Commission or Council approval.
Why the confidence is not higherPV handout, Planning section: 'If a new separate structure is needed for the installation of a photovoltaic system, Planning approval will be required.'
published checklist checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No stated numeric residential system-size cap beyond CPAU's Net Energy Metering program limit of 1 MW per generating facility.
Why the confidence is not higherCPAU Rule 27 defines NEM eligibility as applying to 'generating facilities not exceeding 1 MW'; no separate, lower residential-specific cap was found in the PV/ESS handouts or PAMC Chapter 16.63.
utility's own rule/regulation checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/1/utilities/rules-and-regulations/rule-27-generating-facility-interconnections-effective-2016-12-12.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 90% · adopting ordinance / municipal code chapter
- Which building code edition is in force? 2025 California Building Code and 2025 California Residential Code (Title 24, Parts 2 and 2.5), adopted with local amendments by Ordinance No. 5674 amending PAMC Chapter 16.04, effective 31 days after passage on 20 Oct 2025. 90% · enacted ordinance
- Which fire code edition is in force? 2025 California Fire Code (Title 24, Part 9), adopted with local amendments as PAMC Chapter 15.04. 90% · adopting ordinance / municipal code chapter
- Are there local amendments to any of the above? Yes 95% · municipal code chapter
- What is the installation judged against? The California Building Code, California Residential Code, California Electrical Code, California Fire Code (current adopted editions), CPAU's Rule 27 (incorporating EUSERC 501), and the Palo Alto Municipal Code, as stated on the cover page of both the PV and ESS handouts. 95% · authority's own handout
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Fire-code roof access pathways and ridge setbacks apply per adopted CFC §1204.2/§1204.2.1 (Pathways to Ridge §1204.2.1.1, Setbacks at Ridge §1204.2.1.2, Emergency Escape/Rescue Openings §1204.2.2), with stated exceptions for Occupancy Group U structures and for flat roofs with a slope of 2:12 or less. The published handout does not restate the numeric setback distances itself, only the code citations and exceptions. 85% · authority's own handout (citing adopted fire code)
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes — rapid shutdown is required, tied to the CEC edition in force. The handout distinguishes current rapid-shutdown signage (CFC 1204.5.1, CEC 690.56(C)(3) 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM') from legacy labeling for systems installed under previous rapid-shutdown code editions (CEC 690.56(B)/(C)(1)(a)/(C)(1)(b)/(C)(2)). 90% · authority's own handout
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Service-equipment location placards (CEC 705.10 directory), PV AC system disconnect label (690.13(B)), PV DC equipment disconnect label (690.53), interactive-point-of-interconnection labels (690.54, 705.12(B)(2)(3)(b)/(c)), DC conduit/raceway marking (690.31(G)(3)/(4)), de-rated main breaker label, CPAU supply-side-tap caution label, and rapid-shutdown labeling (690.56/CFC 1204.5.1). 95% · ordinance/utility spec (authority's own handout)
- Does the authority specify placard wording of its own? Yes 95% · authority's own handout
- Does it specify letter height, colour or material? Yes — labels exposed to sunlight must be phenolic; conduit labels must be permanent and weather-resistant; general label background/lettering is red background with white lettering (two-color minimum; a three-color illustration in the handout is for illustration only); DC conduit/raceway marking and the rapid-shutdown-switch label require a minimum 3/8" text size. 90% · authority's own handout
- Is a site plan / facility map placard required, and what must it show? Yes — an Interconnected Power Production Sources Directory (CEC 705.10) is required at service equipment locations, shown in the handout as illustrated 'You Are Here' directory/facility maps (Illustrations 2, 3A, 3B, 3C) identifying the main service panel, rapid shutdown location, and any PV/ESS disconnect locations relative to each other. 85% · authority's own handout, citing CEC 705.10 + local illustration
- Does the UTILITY specify placards beyond the AHJ's? Yes — CPAU (the utility) requires its own AC disconnect ('Rule 27 Disconnect,' knife/blade type, lockable open, within 10 ft and within sight of the main service panel) plus, when a supply-side tap is used, a specific caution label reading 'CAUTION! SUPPLY SIDE TAP. OPEN AND LOCK AC PHOTOVOLTAIC DISCONNECT BEFORE REMOVING METER.' CPAU also sets electrical-equipment clearance requirements to the gas meter per its own Standard Detail SR-CN-0-1009. 90% · utility DG manual / handout
- Where must the labels be placed? Service-equipment locations; the AC and DC PV/ESS disconnects themselves; interactive points of interconnection; along DC conduits/raceways (every 10 ft, at turns, and above/below penetrations); within 3 ft of service equipment for rapid-shutdown-related labels; and at the CPAU Rule 27 AC disconnect (within 10 ft and within sight of the main service panel). 90% · authority's own handout
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? Within 10 ft of, and within sight of, the main electrical service panel (CPAU 'Rule 27' knife/blade disconnect, lockable in the open position). 95% · utility DG manual
- Must equipment be on a specific approved list? No 80% · authority's own handout
- Are batteries permitted, and under what conditions? Yes, under specific conditions: ESS must be UL 9540 listed; individual units limited to 20 kWh, aggregate limited to 280 kWh per structure; permitted locations are detached garages/accessory structures, attached garages separated per CRC R302.6, outdoors 3+ ft from doors/windows into the dwelling, or enclosed utility closets/basements/storage with finished or 5/8" Type X gypsum-protected walls/ceilings; prohibited in sleeping rooms, closets opening to sleeping rooms, or other habitable spaces; minimum 3 ft spacing between individual units (reducible with an accepted large-scale fire test); heat/smoke detection required per CRC R327.7/CFC 1206.11.6. 95% · fire code + authority's own handout
- Is there a separate ESS permit or inspection? Yes 95% · authority's own handout + fee schedule
- Is a ground mount treated as a structure? Yes (functionally) 75% · authority's own handout (setback/BFE treatment)
20 questions answered against City of Palo Alto’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023
Why the confidence is not higherPalo Alto adopted the 2025 California Electrical Code (Cal. Code Regs. Title 24 Part 3) by amendment to PAMC Chapter 16.16 (Sections 16.16.010 et seq.); the 2025 CEC cycle is based on the 2023 NEC.
adopting ordinance / municipal code chapter checked 2026-08-30 https://codelibrary.amlegal.com/codes/paloalto/latest/paloalto_ca/0-0-0-72683
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code and 2025 California Residential Code (Title 24, Parts 2 and 2.5), adopted with local amendments by Ordinance No. 5674 amending PAMC Chapter 16.04, effective 31 days after passage on 20 Oct 2025.
Why the confidence is not higherOrdinance No. 5674 text (repealing/re-adopting PAMC Ch. 16.04 for the 2025 CBC) retrieved and read directly; PASSED: OCTOBER 20, 2025, effective the 31st day after passage.
enacted ordinance checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/1/development-services/building-division/adoptive-ordinances/2025-edition/ord-5674-cbc.pdf
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (Title 24, Part 9), adopted with local amendments as PAMC Chapter 15.04.
Why the confidence is not higherPAMC §15.04.010 '2025 California Fire Code, Title 24, Part 9 adopted and amended.'
adopting ordinance / municipal code chapter checked 2026-08-30 https://codelibrary.amlegal.com/codes/paloalto/latest/paloalto_ca/0-0-0-69980
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherEach adopted code chapter (16.04 Building, 16.16 Electrical, 15.04 Fire, 16.06 Residential) contains its own dedicated 'Local Amendments' section (e.g., §16.04.030, §16.16.030, §15.04.020) with numerous section-by-section amendments.
municipal code chapter checked 2026-08-30 https://codelibrary.amlegal.com/codes/paloalto/latest/paloalto_ca/0-0-0-87033
Q33 What is the installation judged against? Core Electrical
The California Building Code, California Residential Code, California Electrical Code, California Fire Code (current adopted editions), CPAU's Rule 27 (incorporating EUSERC 501), and the Palo Alto Municipal Code, as stated on the cover page of both the PV and ESS handouts.
Why the confidence is not higherCover-page 'APPLICABLE CODES' line of the PV and ESS handouts.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedPV and ESS handouts (Plan Review / CPAU Electrical Engineering sections) and the PAMC Chapter 16.16 (California Electrical Code) local-amendments section list — neither describes a Palo Alto-specific rule on service upgrades or busbar sizing beyond the standard CEC 705.12 supply-side/busbar tap provisions already reflected in the signage table.
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedPV handout 'Structural Attachment Details' / 'Structural Calculation' items — states only that manufacturer's stamped span tables (including wind load) and, where applicable, PE-stamped calculations govern; no universal mounting-system or attachment-spacing figure (e.g., inches on-center) is published.
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Fire-code roof access pathways and ridge setbacks apply per adopted CFC §1204.2/§1204.2.1 (Pathways to Ridge §1204.2.1.1, Setbacks at Ridge §1204.2.1.2, Emergency Escape/Rescue Openings §1204.2.2), with stated exceptions for Occupancy Group U structures and for flat roofs with a slope of 2:12 or less. The published handout does not restate the numeric setback distances itself, only the code citations and exceptions.
Why the confidence is not higherPV handout, 'FIRE' plan-review section, listing CFC 1204.2 and its two exceptions verbatim.
authority's own handout (citing adopted fire code) checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes — rapid shutdown is required, tied to the CEC edition in force. The handout distinguishes current rapid-shutdown signage (CFC 1204.5.1, CEC 690.56(C)(3) 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM') from legacy labeling for systems installed under previous rapid-shutdown code editions (CEC 690.56(B)/(C)(1)(a)/(C)(1)(b)/(C)(2)).
Why the confidence is not higherPV handout Signs and Labels Table, rapid-shutdown rows and explicit 'legacy signage for systems installed under previous rapid shutdown codes' notes.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Service-equipment location placards (CEC 705.10 directory), PV AC system disconnect label (690.13(B)), PV DC equipment disconnect label (690.53), interactive-point-of-interconnection labels (690.54, 705.12(B)(2)(3)(b)/(c)), DC conduit/raceway marking (690.31(G)(3)/(4)), de-rated main breaker label, CPAU supply-side-tap caution label, and rapid-shutdown labeling (690.56/CFC 1204.5.1).
Why the confidence is not higherFull 'Signs and Labels Table' in the PV handout, cross-referenced by CEC article for each required label.
ordinance/utility spec (authority's own handout) checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes
Why the confidence is not higherThe handout specifies exact required wording for several labels, e.g. 'RATED AC OUTPUT CURRENT XXX AMPS NORMAL OPERATING AC VOLTAGE XXX VOLTS,' 'MAXIMUM MAIN BREAKER SIZE: XXX AMPS,' 'CAUTION! SUPPLY SIDE TAP. OPEN AND LOCK AC PHOTOVOLTAIC DISCONNECT BEFORE REMOVING METER,' and 'RAPID SHUTDOWN SWITCH FOR SOLAR PV SYSTEM.'
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Yes — labels exposed to sunlight must be phenolic; conduit labels must be permanent and weather-resistant; general label background/lettering is red background with white lettering (two-color minimum; a three-color illustration in the handout is for illustration only); DC conduit/raceway marking and the rapid-shutdown-switch label require a minimum 3/8" text size.
Why the confidence is not higher'Signs and Labels Table' introductory notes and specific label rows in the PV handout.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes — an Interconnected Power Production Sources Directory (CEC 705.10) is required at service equipment locations, shown in the handout as illustrated 'You Are Here' directory/facility maps (Illustrations 2, 3A, 3B, 3C) identifying the main service panel, rapid shutdown location, and any PV/ESS disconnect locations relative to each other.
Why the confidence is not higherPV handout Illustrations 2/3A/3B/3C and the CEC 705.10 directory requirement referenced throughout the Signs and Labels Table.
authority's own handout, citing CEC 705.10 + local illustration checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes — CPAU (the utility) requires its own AC disconnect ('Rule 27 Disconnect,' knife/blade type, lockable open, within 10 ft and within sight of the main service panel) plus, when a supply-side tap is used, a specific caution label reading 'CAUTION! SUPPLY SIDE TAP. OPEN AND LOCK AC PHOTOVOLTAIC DISCONNECT BEFORE REMOVING METER.' CPAU also sets electrical-equipment clearance requirements to the gas meter per its own Standard Detail SR-CN-0-1009.
Why the confidence is not higherPV/ESS handouts, 'CPAU ELECTRICAL ENGINEERING' and 'UTILITIES' REQUIREMENT SUMMARY FOR (RULE 27)' sections, plus Rule 27 itself.
utility DG manual / handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
Service-equipment locations; the AC and DC PV/ESS disconnects themselves; interactive points of interconnection; along DC conduits/raceways (every 10 ft, at turns, and above/below penetrations); within 3 ft of service equipment for rapid-shutdown-related labels; and at the CPAU Rule 27 AC disconnect (within 10 ft and within sight of the main service panel).
Why the confidence is not higherCompiled from the 'Location of Label' column of the PV handout's Signs and Labels Table.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
No
Why the confidence is not higherThe handouts require only that equipment be listed by a Nationally Recognized Testing Laboratory (NRTL) per a recognized standard (e.g., UL 1703 for PV panels, UL 9540 for ESS) — there is no separate City-maintained 'approved equipment list' beyond that generic NRTL-listing requirement.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, under specific conditions: ESS must be UL 9540 listed; individual units limited to 20 kWh, aggregate limited to 280 kWh per structure; permitted locations are detached garages/accessory structures, attached garages separated per CRC R302.6, outdoors 3+ ft from doors/windows into the dwelling, or enclosed utility closets/basements/storage with finished or 5/8" Type X gypsum-protected walls/ceilings; prohibited in sleeping rooms, closets opening to sleeping rooms, or other habitable spaces; minimum 3 ft spacing between individual units (reducible with an accepted large-scale fire test); heat/smoke detection required per CRC R327.7/CFC 1206.11.6.
Why the confidence is not higherESS handout, Plan Review and Inspection Information sections (CFC 1206.11.x, CRC R327.x).
fire code + authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-energy-storage-pa_01282025.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Yes
Why the confidence is not higherESS has its own permit fee line item (FY26 fee schedule) and its own required final inspections distinct from PV's — '990 Fire Inspection Final' and '707 Energy Storage System/Final' — versus PV's single '703 Photovoltaic/Final.'
authority's own handout + fee schedule checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-energy-storage-pa_01282025.pdf
Q47 Is a ground mount treated as a structure? Core Ground mount
Yes (functionally)
Why the confidence is not higherThe PV handout treats a Ground-Mounted Photovoltaic System (CRC R324.7) as its own system type and requires property-line setback distances 'when equipment is not attached to the structure,' plus elevation/Base Flood Elevation compliance when installed outside in a flood plain — treatment consistent with a structure for setback and flood-plain purposes. The handout does not use the word 'structure' explicitly for zoning classification purposes.
authority's own handout (setback/BFE treatment) checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Within 10 ft of, and within sight of, the main electrical service panel (CPAU 'Rule 27' knife/blade disconnect, lockable in the open position).
Why the confidence is not higherStated identically in both the PV and ESS handouts and in CPAU Rule 27 §D(1)(d): 'A knife/blade type, lockable (Rule 27) disconnect is required to be within 10' and within sight of the main service panel.'
utility DG manual checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/1/utilities/rules-and-regulations/rule-27-generating-facility-interconnections-effective-2016-12-12.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal (ACA) — plus a mobile app (iRequest) and phone 90% · authority's own FAQ
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes / Delegated (mixed) 90% · authority's own handout
- If delegated, to whom? Not delegated to an outside agency — building/electrical inspection is performed by the Palo Alto Building Division and, for ESS, fire-life-safety inspection is performed by the Palo Alto Fire Department. Both are City of Palo Alto departments. 85% · authority's own handout
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? PV: a single '703 – Photovoltaic/Final' inspection (plus '280 – Travel Time West of 280' scheduled alongside it for properties west of Highway 280) is required, with no separate rough-in stage described. ESS: '707 – Energy Storage System/Final' and '990 – Fire Inspection Final' are both required, scheduled at the same time. 85% · authority's own handout
- Is a rough-in or mid-roof inspection required? No 70% · authority's own handout (absence of a listed rough-in stage)
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes 90% · published department handout
- What must be on site at inspection? Approved plans, the permit, and manufacturer installation instructions must all be available on site at the time of inspection; panels/equipment must be de-energized and open/ready for inspection (with tenant/owner notified beforehand); torque tools should be on site for the electrician to demonstrate proper torqueing on request. 95% · authority's own handout
- Does the inspector verify labels and listings? Yes 95% · authority's own handout / stated practice
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final 90% · authority's own handout
- Who notifies the utility for PTO? Installer/Applicant 80% · utility's own rule/regulation
- Is there a re-inspection fee? $328 per primary inspection type, $164 per secondary inspection type, for Single-Family/Duplex re-inspections (up to 1 hour / 30 minutes respectively). Multi-Family/Commercial re-inspection is a flat $164 each. 95% · fee schedule
- How are corrections issued and cleared? Major changes (system size/scope, equipment change, relocation affecting wire/conduit size) must be submitted to the City for review and approval before inspection, generally as an Amendment/Revision filed in ACA (creating a new revision record, e.g. '18REV-xxxxx'); minor changes (e.g., moving equipment within the same general roof area) do not require resubmission. 75% · authority's own handout
14 questions answered against City of Palo Alto’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal (ACA) — plus a mobile app (iRequest) and phone
Why the confidence is not higherSolarAPP+ FAQ page: 'Schedule an Inspection using the iRequest app... Schedule an Inspection through the City's ACA Portal (registration/logging in is not required)... Schedule an Inspection by phone... (650) 329-2496 and select option 2.'
authority's own FAQ checked 2026-08-30 https://www.paloalto.gov/Departments/Planning-Development-Services/Development-Services/Apply-for-a-Permit/Apply-for-a-Residential-SolarAPP-Permit
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedBuilding Inspection department page (paloalto.gov) — blocked to automated fetch by Akamai bot protection (returns an 'Access Denied' edge error to both curl and the fetch tool) with no Wayback Machine capture available; the SolarAPP+ FAQ page describes how to book (portal/app/phone) but not a minimum-notice requirement.
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedSame Building Inspection department page — blocked to automated fetch (Akamai 'Access Denied', no Wayback capture); no AM/PM-window or same-day-inspection statement found in the PV/ESS handouts or the SolarAPP+ FAQ.
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes / Delegated (mixed)
Why the confidence is not higherFor PV, the City's own Building Division performs the '703 – Photovoltaic/Final' inspection. For ESS, the City's own Fire Department separately performs '990 – Fire Inspection Final' alongside the Building Division's '707 – Energy Storage System/Final' — both handled in-house by City of Palo Alto departments, not delegated to an outside agency.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-energy-storage-pa_01282025.pdf
Q53 If delegated, to whom? Core Who inspects
Not delegated to an outside agency — building/electrical inspection is performed by the Palo Alto Building Division and, for ESS, fire-life-safety inspection is performed by the Palo Alto Fire Department. Both are City of Palo Alto departments.
Why the confidence is not higherPV and ESS handouts list only City department inspection codes (703, 707, 990) with no third-party or county inspector referenced.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-energy-storage-pa_01282025.pdf
Q54 Which inspections are required, and in what order? Core Stages & sequence
PV: a single '703 – Photovoltaic/Final' inspection (plus '280 – Travel Time West of 280' scheduled alongside it for properties west of Highway 280) is required, with no separate rough-in stage described. ESS: '707 – Energy Storage System/Final' and '990 – Fire Inspection Final' are both required, scheduled at the same time.
Why the confidence is not higher'Required Inspections (to be scheduled at the same time)' lists in the PV and ESS handouts.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherThe PV handout's 'Required Inspections' list shows only the final ('703 – Photovoltaic/Final') inspection, with no separate rough-in or mid-roof inspection stage described for standard rooftop PV.
authority's own handout (absence of a listed rough-in stage) checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q56 Does the inspector verify labels and listings? Core What is checked
Yes
Why the confidence is not higherInspection Information section explicitly checks 'Signs, Placards, Directories and Markings (CFC 1204.5)' including field-applied hazard markings, rapid-shutdown labeling, and the interconnected power-production-sources directory, plus equipment listing requirements throughout.
authority's own handout / stated practice checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q57 Is there a published inspection checklist? Core What is checked
Yes
Why the confidence is not higherThe published Residential Photovoltaic Systems and Residential Energy Storage Systems handouts each contain a dedicated 'Inspection Information' section functioning as the published checklist (prior-to-inspection items and specific in-field checks).
published department handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q58 What must be on site at inspection? Core Documents on site
Approved plans, the permit, and manufacturer installation instructions must all be available on site at the time of inspection; panels/equipment must be de-energized and open/ready for inspection (with tenant/owner notified beforehand); torque tools should be on site for the electrician to demonstrate proper torqueing on request.
Why the confidence is not higher'Prior to Inspection' section of the PV/ESS handouts.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q59 Is there a re-inspection fee? Corrections & re-inspection
$328 per primary inspection type, $164 per secondary inspection type, for Single-Family/Duplex re-inspections (up to 1 hour / 30 minutes respectively). Multi-Family/Commercial re-inspection is a flat $164 each.
Why the confidence is not higherFY2026 Adopted Municipal Fee Schedule, 'Reinspection Fee - Single-Family/Duplex' and 'Reinspection Fee - Multi-Family/Commercial' line items.
fee schedule checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/2/development-services/building-permits/5.-fees/building-fee-schedule-fy26.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Major changes (system size/scope, equipment change, relocation affecting wire/conduit size) must be submitted to the City for review and approval before inspection, generally as an Amendment/Revision filed in ACA (creating a new revision record, e.g. '18REV-xxxxx'); minor changes (e.g., moving equipment within the same general roof area) do not require resubmission.
Why the confidence is not higherPV/ESS handouts 'Prior to Inspection' notes, and the SolarAPP+ FAQ's revision/amendment workflow through ACA.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q61 What is issued on pass? Core Final sign-off & PTO
Final
Why the confidence is not higherThe terminal inspection is titled '703 – Photovoltaic/Final' (PV) or '707 – Energy Storage System/Final' (ESS) in the handouts' Required Inspections lists — a 'Final' inspection sign-off rather than a separate Certificate of Occupancy, green tag, or letter.
authority's own handout checked 2026-08-30 https://www.cityofpaloalto.org/files/assets/public/v/4/development-services/building-permits/pa_residential-photovoltaic-systems-pa_01282025.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer/Applicant
Why the confidence is not higherCPAU Rule 27 conditions its 30-business-day NEM/interconnection approval on receipt of 'evidence of Applicant's final electric inspection clearance from the Palo Alto Building Department' — i.e., the applicant/installer is responsible for surfacing that clearance to CPAU to trigger Permission to Operate; CPAU does not describe pulling inspection results itself.
utility's own rule/regulation checked 2026-08-30 https://www.paloalto.gov/files/assets/public/v/1/utilities/rules-and-regulations/rule-27-generating-facility-interconnections-effective-2016-12-12.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Palo Alto against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Palo Alto is the authority having jurisdiction 95% confidence
- Holds
- Building and Electrical (City of Palo Alto Planning & Development Services / Development Services Building Division); Fire life-safety inspection for ESS (City of Palo Alto Fire Department). Utility interconnection/NEM sits separately with City of Palo Alto Utilities (CPAU) — a municipally owned electric utility, not PG&E — whose pre-approval (Rule 27) is a required prerequisite before the building permit application and whose interconnection agreement/AC-disconnect rule is enforced again at final inspection.
- Why not higher
- Palo Alto is a full-service charter city; Santa Clara County has no building/electrical role here. Development Services (not CPAU/Utilities) holds the building and electrical permit — confirmed directly by the PV/ESS handouts and PAMC Title 16 — while CPAU is the separate utility gatekeeper for interconnection under its own Rule 27. Both departments' own current documents were read directly (not summarized).
- Permit required
- Yes95%
- Permit cost
- SolarAPP+ PV only: $655/permit (instant permit). SolarAPP+ PV+ESS: $1,331/permit (instant permit).95%
- Plan review
- SolarAPP+-eligible systems: instant, automated same-day issuance ('available as instant permit').70%
- Portal
- Accela Citizen Access (ACA), branded locally as the 'Palo Alto Online Permitting System (OPS),' for the building/electrical permit;95%
- Electrical code
- 202390%
- Own placard wording
- Yes95%
- Booking an inspection
- Portal (ACA) — plus a mobile app (iRequest) and phone90%
Labels & placards for this authority
City of Palo Alto writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 95%
Yes
Size, colour & material 90%
Yes — labels exposed to sunlight must be phenolic; conduit labels must be permanent and weather-resistant; general label background/lettering is red background with white lettering (two-color minimum; a three-color illustration in the handout is for illustration only); DC conduit/raceway marking and the rapid-shutdown-switch label require a minimum 3/8" text size.
Where they go 90%
Service-equipment locations; the AC and DC PV/ESS disconnects themselves; interactive points of interconnection; along DC conduits/raceways (every 10 ft, at turns, and above/below penetrations); within 3 ft of service equipment for rapid-shutdown-related labels; and at the CPAU Rule 27 AC disconnect (within 10 ft and within sight of the main service panel).
What the utility wants on top 90%
Yes — CPAU (the utility) requires its own AC disconnect ('Rule 27 Disconnect,' knife/blade type, lockable open, within 10 ft and within sight of the main service panel) plus, when a supply-side tap is used, a specific caution label reading 'CAUTION! SUPPLY SIDE TAP. OPEN AND LOCK AC PHOTOVOLTAIC DISCONNECT BEFORE REMOVING METER.' CPAU also sets electrical-equipment clearance requirements to the gas meter per its own Standard Detail SR-CN-0-1009.
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
