City of Piedmont
Alameda County
City of Piedmont is a city authority in the State of California, serving 11,270 residents. 964 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 3 business days Q18 Where you file — eTRAKiT (https://pied-trk.aspgov.com/etrakit/), with Symbium (symbium.com) as an integrated instant-permit front end for eligible solar projects that auto-submits… Q20
- Permit required
- Yes98% source
- What it costs
- $559 flat (residential); $1,085 flat (commercial); $343 flat if processed as a 'SolarAPP+' permit type92% source
- Plan review turnaround
- 3 business days92% source
- Key document
- department page + published checklist (PDF) cited by 5 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · department page / ordinance
- What does this authority permit itself, and what does it delegate? Both 90% · department page
- Is a permit required for a residential rooftop PV system? Yes 98% · department page / ordinance
- Is there a separate electrical permit, or is it combined? Combined 85% · fee schedule
- Is a HOA or architectural approval required first? No 85% · ordinance
- Is there a historic-district review? No 68% · ordinance (absence checked)
- Is a wind or windstorm certification required? No 72% · published checklist (PDF), absence checked
- Is a Specific Use Permit or Council approval ever required? No, for a qualifying small residential rooftop system 78% · ordinance
- Is there a system-size cap on residential generation? 10 kW AC nameplate rating (or 30 kW thermal) for the streamlined 'small residential rooftop solar energy system' definition, on a single- or duplex-family dwelling, not exceeding the zone's maximum legal building height 95% · ordinance
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 78% · department page
- Must the contractor be registered with this authority before applying? Yes 82% · department page
- Is a homeowner permitted to self-install and self-permit? Yes 90% · department page / form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Eligibility Checklist for Expedited PV; Building Permit Application; Cover sheet (address, owner, designer, scope, sheet index, legend); schematic Site Plan; Standard Electrical Plan (Central/String Inverter or Microinverter/ACM, as applicable); Roof Plan showing panel layout and fire-safety pathway/marking items; Structural Criteria for Residential Rooftop Solar (or PE-stamped calcs if the checklist fails); manufacturer spec sheets for all major components; Contractor or Owner-Builder Declarations; Construction & Demolition Debris Recycling Statement if project value exceeds $50,000. 85% · department page + published checklist (PDF)
- How many copies, and in what format? The city's current live page states applications go through eTRAKiT (electronically) or the Symbium instant-permit portal, and that 'Paper and email applications are no longer be accepted.' A separate, older handout (ModDate 28 Nov 2023) still on the same solar page states '2 sets of plans (minimum 11x17)' if submitted in person, or e-mail submittal with a 10MB attachment cap — that in-person/email path appears superseded by the newer electronic-only policy but the city has not removed the conflicting document. 55% · department page (conflicting with an older linked PDF)
- Is a site plan required, and what must it show? Yes — a schematic site plan showing the building footprint, property lines, PV array location, main service location, all interior/exterior equipment and disconnect locations with working clearances, and other structures on the property. 88% · published checklist (PDF)
- Is a one-line / three-line diagram required? Yes 90% · published standard plan (PDF)
- Are string and conductor calculations required? Not as free-form calculations for a qualifying project — the Standard Plan pre-computes allowable string counts, MPPT limits and maximum combined OCPD vs. bus-bar-rating tables (e.g. Table 4, Max Combined Supply OCPDs per CEC 705.12(D)(2)) that the applicant selects from; project-specific conductor/string calculations are only required if the project falls outside the Eligibility Checklist's prescriptive limits, in which case a 'Comprehensive Standard Plan' or engineered plans are used instead. 75% · published standard plan (PDF)
- Is a structural PE stamp required, and at what threshold? A CA-licensed Civil or Structural Engineer's stamped, project-specific calculations are required only if any item on the Structural Criteria checklist (roof condition, rafter size/span, module weight ≤4 psf PV / 5 psf thermal, anchor spacing per Table 1) is answered 'No.' If every item is 'Yes,' no PE stamp is required. 85% · published checklist (PDF)
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

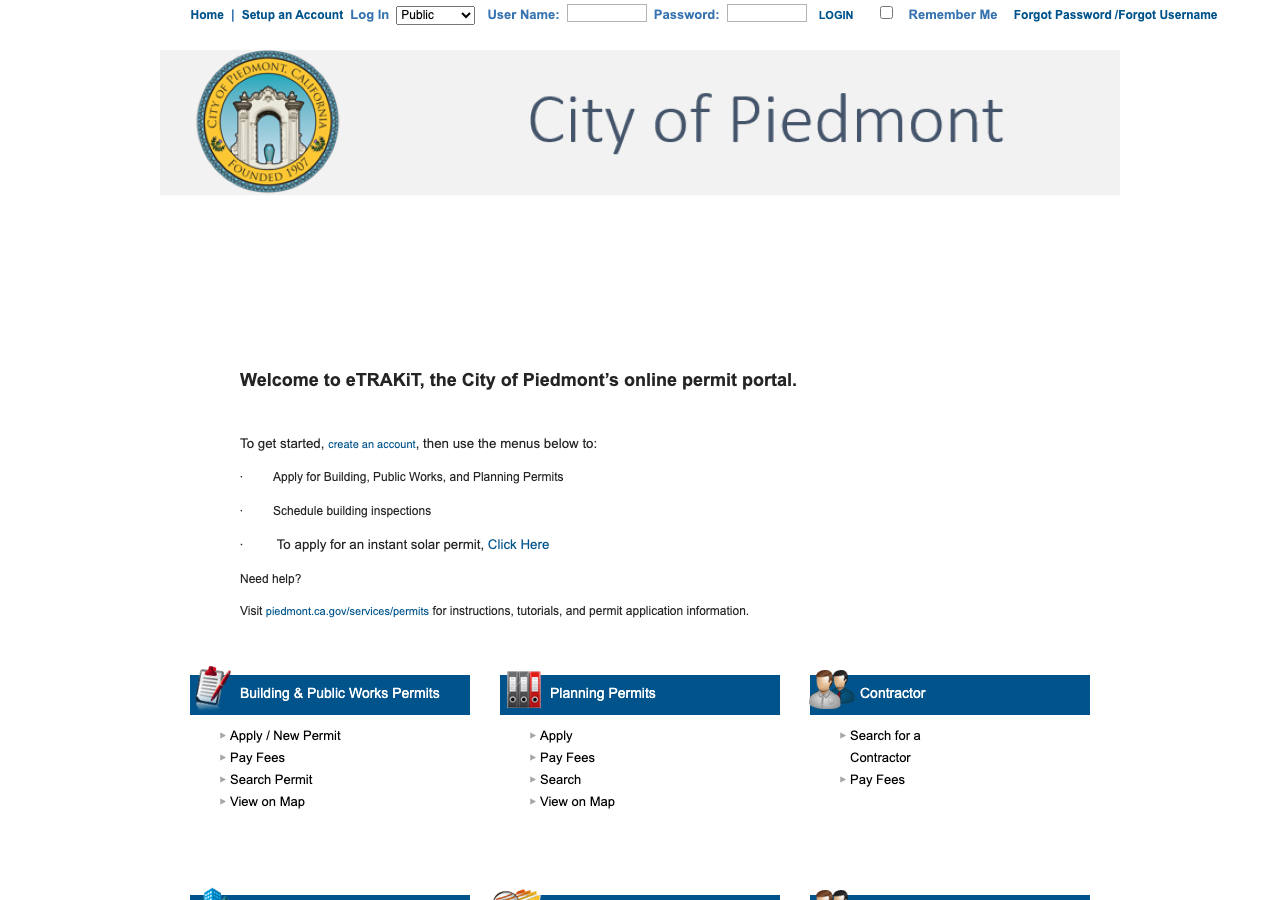

- Which permit portal does this authority use? eTRAKiT (https://pied-trk.aspgov.com/etrakit/), with Symbium (symbium.com) as an integrated instant-permit front end for eligible solar projects that auto-submits into eTRAKiT 92% · department page / portal
- Can the whole application be completed online? Yes 85% · department page
- What does a residential solar permit cost? $559 flat (residential); $1,085 flat (commercial); $343 flat if processed as a 'SolarAPP+' permit type 92% · published fee schedule
- How is the fee calculated? Flat 92% · fee schedule
- Is there a separate plan-check fee? No 68% · fee schedule (inference)
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 3 business days 92% · ordinance
- How long is an issued permit valid before it expires? 180 days (standard, unamended CRC/CBC default) 68% · fee schedule (inference) + ordinance (no override found)
- Which utility handles interconnection here? PG&E (Pacific Gas & Electric) 82% · department page (utility named)
28 questions answered against City of Piedmont’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherPiedmont City Code §8.02.010 adopts the 2025 CBSC by reference; the Planning & Building Department's own 'About Building' and 'Solar Building Permit' pages confirm it issues and inspects residential solar permits directly.
department page / ordinance checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherThe Planning & Building Department's Building Division performs its own plan check for structural, electrical, mechanical, plumbing and fire/life-safety, and its own inspections; the named Building Official (Paki Muthig) appears on the city's own directory/phone extension with no contract-firm indicators found.
department page checked 2026-08-31 https://www.piedmont.ca.gov/services___departments/planning___building/about_building_
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherThe city's Solar Building Permit page states plainly 'You need a solar building permit if you are installing solar panels on your property,' and PCC §8.04.020 applies the streamlined division to 'the permitting of each small residential rooftop solar energy system in the city.'
department page / ordinance checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe Fee Schedule (eff. 1/1/2026) carries one flat line, 'Solar Energy Related Permits — Residential, $559,' with no separate PV electrical-permit line; the city's eTRAKiT solar permit type covers Solar/Battery subtypes as a single building permit inclusive of the electrical scope.
fee schedule checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/Departments/Planning%20Division/2025%20Code%20Updates/Planning%20and%20Building%20Fee%20Schedule%20FY26.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherThe city's 'Working with a contractor' page states a permit may be pulled by either a properly licensed California contractor or a property owner acting legally as an owner-builder; no solar-specific electrician-only restriction was found.
department page checked 2026-08-31 https://piedmont.ca.gov/services/permits/building/working-with-contractors
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higher'Working with a contractor' page: contractors 'need a current City of Piedmont business license' in addition to their CSLB license — this is the city's own registration requirement, distinct from a specialized permitting-portal registration.
department page checked 2026-08-31 https://piedmont.ca.gov/services/permits/building/working-with-contractors
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherOwner-Builder is an explicit path on the city's Building Permits pages, and the Solar Building Permit page itself lists 'Contractor or Owner-Builder Declarations (required for all projects)' among the solar submittal documents.
department page / form checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q8 What documents make up a complete submittal? Core Submittal package
Eligibility Checklist for Expedited PV; Building Permit Application; Cover sheet (address, owner, designer, scope, sheet index, legend); schematic Site Plan; Standard Electrical Plan (Central/String Inverter or Microinverter/ACM, as applicable); Roof Plan showing panel layout and fire-safety pathway/marking items; Structural Criteria for Residential Rooftop Solar (or PE-stamped calcs if the checklist fails); manufacturer spec sheets for all major components; Contractor or Owner-Builder Declarations; Construction & Demolition Debris Recycling Statement if project value exceeds $50,000.
Why the confidence is not higherCombines the current 'Solar Building Permit' page's Resources/Requirements list with the (2015-authored, ModDate Nov 2023) 'Solar PV Permitting Requirements for Streamlined Review' handout's itemized submittal list — both still linked live by the city.
department page + published checklist (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q9 How many copies, and in what format? Submittal package
The city's current live page states applications go through eTRAKiT (electronically) or the Symbium instant-permit portal, and that 'Paper and email applications are no longer be accepted.' A separate, older handout (ModDate 28 Nov 2023) still on the same solar page states '2 sets of plans (minimum 11x17)' if submitted in person, or e-mail submittal with a 10MB attachment cap — that in-person/email path appears superseded by the newer electronic-only policy but the city has not removed the conflicting document.
Why the confidence is not higherDirect contradiction between the current 'Building Permits' page (paper/email no longer accepted) and the still-linked 2023-updated streamlined-review PDF describing in-person paper sets and e-mail submittal; flagged rather than resolved.
department page (conflicting with an older linked PDF) checked 2026-08-31 https://piedmont.ca.gov/services/permits/building
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — a schematic site plan showing the building footprint, property lines, PV array location, main service location, all interior/exterior equipment and disconnect locations with working clearances, and other structures on the property.
Why the confidence is not higherItem 3 of the Solar PV Permitting Requirements handout's submittal list.
published checklist (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/solar-PV-permitting-requirements-under10kW.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherThe required 'Standard Electrical Plan' (Central/String Inverter or Microinverter/ACM) is built around a single-line diagram — the standard plan document itself is titled around 'Single Line Diagram 1/2/4' selection steps.
published standard plan (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/solar-pv-standard-plan-simplified-central-string-inverter.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Not as free-form calculations for a qualifying project — the Standard Plan pre-computes allowable string counts, MPPT limits and maximum combined OCPD vs. bus-bar-rating tables (e.g. Table 4, Max Combined Supply OCPDs per CEC 705.12(D)(2)) that the applicant selects from; project-specific conductor/string calculations are only required if the project falls outside the Eligibility Checklist's prescriptive limits, in which case a 'Comprehensive Standard Plan' or engineered plans are used instead.
Why the confidence is not higherRead directly from the Simplified Standard Plan's own tables and its note 'Otherwise, use Comprehensive Standard Plan.'
published standard plan (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/solar-pv-standard-plan-simplified-central-string-inverter.pdf
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
A CA-licensed Civil or Structural Engineer's stamped, project-specific calculations are required only if any item on the Structural Criteria checklist (roof condition, rafter size/span, module weight ≤4 psf PV / 5 psf thermal, anchor spacing per Table 1) is answered 'No.' If every item is 'Yes,' no PE stamp is required.
Why the confidence is not higherStructural Criteria for Residential Rooftop Solar, Section 3 'Summary': 'One or more items are checked NO. Attach project-specific drawings and calculations stamped and signed by a California-licensed Civil or Structural Engineer.'
published checklist (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/structural-criteria-residential-rooftop-solar.pdf
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedPiedmont City Code Chapter 8 (§8.02.010/.060 California Electrical Code adoption and amendments) and all solar-specific PDFs (Eligibility Checklist, Structural Criteria, Standard Plans, PV Installation Affidavit, streamlined-review handout) — none of these state a valuation, system-size or scope threshold at which an electrical PE stamp (as distinct from the structural PE stamp covered under Q13) becomes required for a residential PV system.
https://www.piedmont.ca.gov/services/permits/building/types/solar
Q15 What does a residential solar permit cost? Core Fees
$559 flat (residential); $1,085 flat (commercial); $343 flat if processed as a 'SolarAPP+' permit type
Why the confidence is not higherPlanning & Building Department Fee Schedule, effective 1 January 2026, 'Solar Energy Related Permits' line items — the current, dated fee document (checked against the city's own 'new permit fees starting January 1, 2026' news notice).
published fee schedule checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/Departments/Planning%20Division/2025%20Code%20Updates/Planning%20and%20Building%20Fee%20Schedule%20FY26.pdf
Q16 How is the fee calculated? Core Fees
Flat
Why the confidence is not higherThe residential/commercial/SolarAPP+ solar lines are each a single flat dollar figure, unlike the schedule's separate valuation-based 'Building Permit & Inspection' and 'Plan Check' tables used for other permit types.
fee schedule checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/Departments/Planning%20Division/2025%20Code%20Updates/Planning%20and%20Building%20Fee%20Schedule%20FY26.pdf
Q17 Is there a separate plan-check fee? Fees
No
Why the confidence is not higherThe solar line is a single flat figure under 'Other Fees & Permits,' with no separate plan-check column populated the way the schedule's valuation-based building-permit tables split 'Building Permit & Inspection' from 'Plan Check Fee' — inferred structurally, not stated explicitly by the schedule.
fee schedule (inference) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/Departments/Planning%20Division/2025%20Code%20Updates/Planning%20and%20Building%20Fee%20Schedule%20FY26.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
3 business days
Why the confidence is not higherPCC §8.04.050(A): 'The Department will issue a building permit within three business days of receipt of a complete application which also meets the requirements of the approved checklist and standard plan.' Matches the (older) handout's '1-3 business days.'
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q19 How long is an issued permit valid before it expires? Timeline & validity
180 days (standard, unamended CRC/CBC default)
Why the confidence is not higherChapter 8's amendments to Residential Code §R105.1/R105.2 do not touch the permit-expiration provision (R105.5), and the current Fee Schedule's own 'Permit Renewal' table is structured around a 180-day threshold ('Less than 180 days: $0'; '181 to 365 days: 50% of original fee'; 'More than 365 days: 100%'), which only makes sense if 180 days is the base expiration point.
fee schedule (inference) + ordinance (no override found) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/Departments/Planning%20Division/2025%20Code%20Updates/Planning%20and%20Building%20Fee%20Schedule%20FY26.pdf
Q20 Which permit portal does this authority use? Core Portal & process
eTRAKiT (https://pied-trk.aspgov.com/etrakit/), with Symbium (symbium.com) as an integrated instant-permit front end for eligible solar projects that auto-submits into eTRAKiT
Why the confidence is not higherBoth are named and linked directly on the city's own 'Solar Building Permit' and 'About Building' pages.
department page / portal checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higher'About Building' page: 'The City of Piedmont has a new online permitting system called eTRAKiT... Paper and email applications are no longer be accepted,' and the Symbium instant path completes application, payment and (for eligible projects) issuance entirely online.
department page checked 2026-08-31 https://www.piedmont.ca.gov/services___departments/planning___building/about_building_
Q22 Which utility handles interconnection here? Core Utility interconnection
PG&E (Pacific Gas & Electric)
Why the confidence is not higherPiedmont has no municipal electric utility; the city's own Electrification Rebates 'Requirements' page ties electrical-panel-upgrade compliance to 'the current California Electrical Code, Article 230, and PG&E rules and regulations' — a city-side confirmation rather than a third-party lookup tool.
department page (utility named) checked 2026-08-31 https://www.piedmont.ca.gov/services___departments/sustainability_division/electrification-rebates/requirements
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedThe city's own Solar Building Permit page, the streamlined-review handout, and the Eligibility Checklist — none address the sequencing of PG&E interconnection relative to the city building permit (before/after/parallel); PG&E's own Rule 21/NEM interconnection pages were not independently retrieved in this run.
https://www.piedmont.ca.gov/services/permits/building/types/solar
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherPCC §8.04.050(C): 'The city will not condition the approval of an application on the approval of an association' — the city's own ordinance affirmatively removes HOA/association sign-off as a precondition for the small-residential-rooftop-solar permit.
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q25 Is there a historic-district review? Overlays & special cases
No
Why the confidence is not higherPCC §8.04.050(B) limits Building Official review of an eligible small-residential-rooftop-solar application to 'whether the application meets local, state, and federal health and safety requirements' — no discretionary or historic-district review channel is carved out for solar; a full-text pass over Chapter 17 (Planning & Land Use) found no historic-district-specific solar provision, only an unrelated SB9-lot-split historic-district exclusion criterion.
ordinance (absence checked) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherCalifornia has no TDI-style windstorm-certification regime; wind-uplift is instead addressed prescriptively inside the Structural Criteria worksheet itself (anchor-fastener/embedment checks and Table 1 maximum anchor spacing by wind exposure assumptions), not via a separate certificate.
published checklist (PDF), absence checked checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/structural-criteria-residential-rooftop-solar.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
No, for a qualifying small residential rooftop system
Why the confidence is not higherPCC §8.04.050(A) mandates an 'administrative, nondiscretionary review process' for qualifying systems (≤10kW AC/30kW thermal, single/duplex dwelling) — no Conditional Use Permit or Council hearing is required for those; larger or non-qualifying systems would fall outside this streamlined division and were not separately documented.
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC nameplate rating (or 30 kW thermal) for the streamlined 'small residential rooftop solar energy system' definition, on a single- or duplex-family dwelling, not exceeding the zone's maximum legal building height
Why the confidence is not higherPCC §8.04.010, Definitions — the AB 2188-era cap, carried into the city's current (eff. 1/1/2026) code.
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 85% · ordinance + known CA code-cycle mapping
- Which building code edition is in force? 2025 California Building Code (Part 2) and 2025 California Residential Code (Part 2.5), Title 24, effective 1 January 2026 96% · ordinance
- Which fire code edition is in force? 2025 California Fire Code (Part 9), Title 24, as adopted/amended by the CA State Fire Marshal, effective 1 January 2026 96% · ordinance
- Are there local amendments to any of the above? Yes 95% · ordinance
- What is the installation judged against? The 2025 California Building Standards Code (CBC/CRC/CEC/CFC/Energy/Green Building) as locally amended by PCC Chapter 8, judged in practice via the city's own prescriptive self-certification tools for qualifying systems: the Eligibility Checklist for Expedited PV, the Structural Criteria worksheet, and the Simplified Standard Electrical Plans (Central/String or Microinverter). 82% · department page + ordinance
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? 3 ft clear space at ridges and a 3 ft access pathway from eave to ridge; where modules are placed on both sides of a hip or valley, 1.5 ft clearance on each side of the hip/valley — drawn from CRC R324.7 series, per the State Fire Marshal Solar PV Installation Guide referenced by the city. 72% · published checklist (PDF), dated
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes, required under CEC §690.12. The city's own PV Installation Compliance Affidavit states 'Rapid Shutdown System installed if conductors run more than 10 ft from the PV array (CEC 690.12)' — but that affidavit is expressly keyed to the '2016 California Electrical Code,' while the code now in force is the 2025 CEC (Title 24 Part 3, based on the 2023 NEC); §690.12's basic rapid-shutdown mandate persists across those editions, but the city has not republished the affidavit to the current cycle. 65% · published inspection form (PDF), dated
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Inverter-output-connection overcurrent-device warning; ungrounded-DC-conductor shock-hazard warning (ungrounded systems only); PV power-source warning at junction/combiner boxes and conduit (marked every 10 ft); dual-power-sources / AC-disconnect rating sign; PV system AC disconnect rating sign; PV system DC disconnect rating sign; ground-fault shock-hazard warning; do-not-touch-terminals warning at listed disconnects; and, if the project includes a battery/ESS, a permanent red label at the ESS disconnect (local amendment, CRC R330.4). 85% · published standard plan (PDF) + ordinance
- Does the authority specify placard wording of its own? Yes, for the ESS disconnect specifically 78% · ordinance
- Does it specify letter height, colour or material? For the ESS disconnect: colour only ('permanent red label'), no letter height/material specified. For PV placards generally, the city's own Standard Plan carries an informational (non-mandatory) note: 'No type size is specified, but 20 point (3/8") should be considered the minimum,' referencing ANSI Z535.4 for safety-sign design guidance. 75% · published standard plan (PDF) + ordinance
- Is a site plan / facility map placard required, and what must it show? A permanent plaque or directory denoting all electric power sources on or in the premises is required (CEC 705.12) — the Standard Plan calls this out explicitly on its Markings page. No additional, distinct 'facility map' placard graphically depicting the roof/array layout is required to be posted at the equipment; a roof-layout diagram is instead a design-submittal document (reviewed at permitting), not a field placard. 70% · published standard plan (PDF)
- Where must the labels be placed? At the inverter (AC disconnect); at the main service/PV DC disconnect; on interior and exterior DC conduits, raceways and cable assemblies (marked every 10 ft and within 1 ft of turns/penetrations); at junction/combiner boxes; at the main electric panel/dual-power-source directory; and, for ESS, on the ESS disconnect located near and in line of sight of the main panel. 82% · published inspection form (PDF)
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes, in general terms 72% · ordinance
- Are batteries permitted, and under what conditions? Yes. Per the live Solar Building Permit page's ESS section: a disconnect near the main electric panel is required; batteries inside enclosed spaces/rooms require a smoke alarm/heat detector per the current CFC; enclosed utility closets/basements/storage housing batteries require not less than 5/8-inch Type X gypsum wallboard on walls and ceilings per the current CFC; and batteries must sit at least 3 ft from any property line and from any opening (door, window, vent) into the dwelling, basement or crawlspace — the last point is also codified locally at CRC §R330.4 as amended, which further requires an exterior disconnect near/in line of sight of the main panel with a permanent red label if the ESS disconnect is not co-located with the main panel. 92% · department page + ordinance
- Is there a separate ESS permit or inspection? No distinct standalone ESS permit/fee was identified — 'Solar, plus battery' and 'Battery only' are simply subtypes of the same eTRAKiT 'Solar' building-permit type, and the Fee Schedule carries no separate battery/ESS dollar line distinct from the flat residential-solar fee. 60% · department page (inference)
- Is there a local rule on service upgrades or busbar sizing? To qualify for the streamlined/expedited path, the PV system must interconnect to a single-phase 120/240V service panel with a bus bar rating of 225A or less, on the load side of the utility distribution equipment; larger or 3-phase services are routed out of the expedited path. 82% · published checklist (PDF)
- Is a specific mounting system or attachment spacing required? Yes — flush-mounted arrays only (2"-10" gap between module and roof, no roof-edge overhang, ≤4 psf PV/5 psf thermal loading, ≤50% roof-plane coverage), with maximum horizontal anchor spacing set by Table 1 (varies by roof slope and rafter spacing, e.g. 5'-4" at 0°-26° slope / 16" o.c.) and fastener minimums (5/16" lag screw, 2.5" rafter embedment) unless the manufacturer's own engineering governs. 82% · published checklist (PDF, statewide template)
20 questions answered against City of Piedmont’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023
Why the confidence is not higherPCC §8.02.010(E) adopts the '2025 California Electrical Code, Part 3 of Title 24,' effective 1/1/2026 — California's 2025 Title 24 cycle is based on the 2023 NEC (as in prior CA cycles, e.g. 2022 CBSC/2020 NEC); no Piedmont document states the NEC year number directly, only 'the 2025 California Electrical Code.'
ordinance + known CA code-cycle mapping checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (Part 2) and 2025 California Residential Code (Part 2.5), Title 24, effective 1 January 2026
Why the confidence is not higherPCC §8.02.010(A)-(B), adopted by Ord. 786 N.S. (Dec. 2025).
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (Part 9), Title 24, as adopted/amended by the CA State Fire Marshal, effective 1 January 2026
Why the confidence is not higherPCC §8.02.010(L).
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherChapter 8 carries extensive local amendments to the Residential, Building, Mechanical, Plumbing, Electrical, Energy, Green Building, Fire and WUI codes (§§8.02.020-.100) — though the Fire Code amendments (§8.02.090) contain no PV/ESS-specific content, only fireworks-prohibition and WUI provisions (control-checked: 'fire' 103 hits, 'electrical' 24 hits, fabricated 'zzqqx' 0 hits across the whole chapter).
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q33 What is the installation judged against? Core Electrical
The 2025 California Building Standards Code (CBC/CRC/CEC/CFC/Energy/Green Building) as locally amended by PCC Chapter 8, judged in practice via the city's own prescriptive self-certification tools for qualifying systems: the Eligibility Checklist for Expedited PV, the Structural Criteria worksheet, and the Simplified Standard Electrical Plans (Central/String or Microinverter).
Why the confidence is not higherSynthesis of §8.02.010 code adoption with the Solar Building Permit page's named resources.
department page + ordinance checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
To qualify for the streamlined/expedited path, the PV system must interconnect to a single-phase 120/240V service panel with a bus bar rating of 225A or less, on the load side of the utility distribution equipment; larger or 3-phase services are routed out of the expedited path.
Why the confidence is not higherEligibility Checklist for Expedited Solar Photovoltaic Permitting, 'Electrical Requirements' section, items C-D.
published checklist (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/eligibility-checklist-for-expedited-PV.pdf
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Yes — flush-mounted arrays only (2"-10" gap between module and roof, no roof-edge overhang, ≤4 psf PV/5 psf thermal loading, ≤50% roof-plane coverage), with maximum horizontal anchor spacing set by Table 1 (varies by roof slope and rafter spacing, e.g. 5'-4" at 0°-26° slope / 16" o.c.) and fastener minimums (5/16" lag screw, 2.5" rafter embedment) unless the manufacturer's own engineering governs.
Why the confidence is not higherStructural Criteria for Residential Rooftop Solar (Piedmont's adopted version of the statewide OPR/CALSEIA 'PV Toolkit for Local Governments,' Part 3, pp.51-54) — city-adopted but not city-authored; flagged as a generic statewide template the city links as its own official form.
published checklist (PDF, statewide template) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/structural-criteria-residential-rooftop-solar.pdf
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
3 ft clear space at ridges and a 3 ft access pathway from eave to ridge; where modules are placed on both sides of a hip or valley, 1.5 ft clearance on each side of the hip/valley — drawn from CRC R324.7 series, per the State Fire Marshal Solar PV Installation Guide referenced by the city.
Why the confidence is not higherFound in the (2015-authored, ModDate Nov 2023) submittal-requirements handout and the PV Installation Compliance Affidavit — not in a Fire Code local amendment; PCC §8.02.090 Fire Code amendments (control-checked) contain zero PV/pathway content, so this rule lives entirely in a Building Division handout rather than codified fire law.
published checklist (PDF), dated checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/PV-installation-affidavit.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes, required under CEC §690.12. The city's own PV Installation Compliance Affidavit states 'Rapid Shutdown System installed if conductors run more than 10 ft from the PV array (CEC 690.12)' — but that affidavit is expressly keyed to the '2016 California Electrical Code,' while the code now in force is the 2025 CEC (Title 24 Part 3, based on the 2023 NEC); §690.12's basic rapid-shutdown mandate persists across those editions, but the city has not republished the affidavit to the current cycle.
Why the confidence is not higherPV Installation Compliance Affidavit, front matter: 'All code references are to the 2016 California Electrical Code (CEC) and the 2016 California Residential Code (CRC)' — a stale citation on an otherwise still-linked, still-required document.
published inspection form (PDF), dated checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/PV-installation-affidavit.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Inverter-output-connection overcurrent-device warning; ungrounded-DC-conductor shock-hazard warning (ungrounded systems only); PV power-source warning at junction/combiner boxes and conduit (marked every 10 ft); dual-power-sources / AC-disconnect rating sign; PV system AC disconnect rating sign; PV system DC disconnect rating sign; ground-fault shock-hazard warning; do-not-touch-terminals warning at listed disconnects; and, if the project includes a battery/ESS, a permanent red label at the ESS disconnect (local amendment, CRC R330.4).
Why the confidence is not higherCompiled from the PV Installation Compliance Affidavit's 'Appropriate Signs Installed' section and the Simplified Standard Plan's 'Markings' page, cross-checked against the R330.4 ESS-disconnect amendment in Chapter 8.
published standard plan (PDF) + ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/solar-pv-standard-plan-simplified-central-string-inverter.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes, for the ESS disconnect specifically
Why the confidence is not higherPCC §8.02.020(P) (Residential Code §R330.4 amendment) specifies exact wording/colour of its own: 'a permanent red label affixed to indicate the ESS disconnect.' For general PV placards, the city adopts the NEC/CEC-prescribed wording verbatim via its Standard Plan rather than authoring independent language.
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
For the ESS disconnect: colour only ('permanent red label'), no letter height/material specified. For PV placards generally, the city's own Standard Plan carries an informational (non-mandatory) note: 'No type size is specified, but 20 point (3/8") should be considered the minimum,' referencing ANSI Z535.4 for safety-sign design guidance.
Why the confidence is not higherR330.4 local amendment text (color only) plus the Simplified Standard Plan's Markings-page informational note.
published standard plan (PDF) + ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/solar-pv-standard-plan-simplified-central-string-inverter.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
A permanent plaque or directory denoting all electric power sources on or in the premises is required (CEC 705.12) — the Standard Plan calls this out explicitly on its Markings page. No additional, distinct 'facility map' placard graphically depicting the roof/array layout is required to be posted at the equipment; a roof-layout diagram is instead a design-submittal document (reviewed at permitting), not a field placard.
Why the confidence is not higherSimplified Standard Plan Markings page: 'CEC 705.12 requires a permanent plaque or directory denoting all electric power sources on or in the premises'; the Roof Plan/diagram is listed among submittal documents, not among 'signs installed' items on the PV Installation Affidavit.
published standard plan (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/solar-pv-standard-plan-simplified-central-string-inverter.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedPiedmont's own solar and electrification pages reference 'PG&E rules and regulations' generally but do not reproduce or link PG&E's own placard/marking specifications (e.g. PG&E's Electric Rule 21/Greenbook marking requirements); PG&E's own interconnection-handbook pages were not independently retrieved in this run.
Q43 Where must the labels be placed? Core Labels Signage & labelling
At the inverter (AC disconnect); at the main service/PV DC disconnect; on interior and exterior DC conduits, raceways and cable assemblies (marked every 10 ft and within 1 ft of turns/penetrations); at junction/combiner boxes; at the main electric panel/dual-power-source directory; and, for ESS, on the ESS disconnect located near and in line of sight of the main panel.
Why the confidence is not higherCompiled from the PV Installation Compliance Affidavit's marking locations and the R330.4 ESS-disconnect local amendment.
published inspection form (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/PV-installation-affidavit.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Yes, in general terms
Why the confidence is not higherPCC §8.04.030(C): a solar energy system for producing electricity 'must meet all applicable safety and performance standards established by the California Electrical Code, the Institute of Electrical and Electronics Engineers, and accredited testing laboratories such as Underwriters Laboratories' — a UL/IEEE-listing standard rather than a discrete city-maintained approved-products list.
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes. Per the live Solar Building Permit page's ESS section: a disconnect near the main electric panel is required; batteries inside enclosed spaces/rooms require a smoke alarm/heat detector per the current CFC; enclosed utility closets/basements/storage housing batteries require not less than 5/8-inch Type X gypsum wallboard on walls and ceilings per the current CFC; and batteries must sit at least 3 ft from any property line and from any opening (door, window, vent) into the dwelling, basement or crawlspace — the last point is also codified locally at CRC §R330.4 as amended, which further requires an exterior disconnect near/in line of sight of the main panel with a permanent red label if the ESS disconnect is not co-located with the main panel.
Why the confidence is not higherDirectly stated on the city's current Solar Building Permit page and corroborated by the codified §R330.4 amendment.
department page + ordinance checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q46 Is there a separate ESS permit or inspection? Battery / ESS
No distinct standalone ESS permit/fee was identified — 'Solar, plus battery' and 'Battery only' are simply subtypes of the same eTRAKiT 'Solar' building-permit type, and the Fee Schedule carries no separate battery/ESS dollar line distinct from the flat residential-solar fee.
Why the confidence is not higherInferred from the Solar Building Permit page's subtype list and the fee schedule's single 'Solar Energy Related Permits' line with no ESS-specific figure; not stated explicitly either way.
department page (inference) checked 2026-08-31 https://www.piedmont.ca.gov/services/permits/building/types/solar
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedPCC §8.04.010's own definition scopes the streamlined division to 'small residential ROOFTOP solar energy system' only; no Piedmont document (Chapter 8, Chapter 17 zoning/accessory-structure provisions, or any solar handout) addresses a ground-mounted PV array or whether it is classified as an accessory structure.
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedThe PV Installation Compliance Affidavit states only that the 'AC disconnect [is] installed at the inverter location (CEC 690.15)' — no Piedmont document specifies its required position relative to the utility meter; PG&E's own interconnection/meter-clearance requirements (which typically govern this) were not independently retrieved in this run.
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal 82% · department page
- How much notice is required? 24 hours 88% · department page
- Are same-day or AM/PM windows offered? Yes — a two-hour inspection window is provided for the small-residential-rooftop-solar consolidated inspection, scheduled within two business days of the request. 85% · ordinance
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 95% · ordinance
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? For an eligible small-residential-rooftop-solar system, only ONE consolidated final inspection is required — the ordinance does not describe a separate rough-in/mid-roof stage for the streamlined path. 88% · ordinance
- Is a rough-in or mid-roof inspection required? No 85% · ordinance
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes 85% · published checklist (PDF)
- What must be on site at inspection? An approved set of plans and the inspection card must be on site at all times (general city inspection policy); for solar specifically, the completed and signed PV Installation Compliance Affidavit must be returned to the building inspector prior to or at final inspection. 85% · department page + published form (PDF)
- Does the inspector verify labels and listings? Yes 80% · published inspection form (PDF)
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final 72% · published form (PDF)
- Is there a re-inspection fee? No distinct 're-inspection' fee line is published; the current Fee Schedule's only relevant mechanism is its general Hourly Rates table (e.g. Building Official $213/hr, Plans Examiner $186/hr), which is not explicitly labeled for re-inspections. 55% · fee schedule (absence checked)
- How are corrections issued and cleared? If an application is deemed incomplete, the city sends the applicant a written correction notice detailing the deficiencies and any additional information/documentation needed to be eligible for expedited issuance; corrections are cleared by resubmission that satisfies the notice. 75% · ordinance
14 questions answered against City of Piedmont’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal
Why the confidence is not higher'Schedule an Inspection' page directs applicants to 'Go to the eTRAKiT portal' as the scheduling method; an older solar handout also lists phone/in-person as alternatives, but the current department page centers on the portal.
department page checked 2026-08-31 https://piedmont.ca.gov/services/permits/building/schedule-inspection
Q50 How much notice is required? Core Booking & scheduling
24 hours
Why the confidence is not higher'Schedule an Inspection' page: 'You need to schedule inspections at least 24 hours in advance.'
department page checked 2026-08-31 https://piedmont.ca.gov/services/permits/building/schedule-inspection
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Yes — a two-hour inspection window is provided for the small-residential-rooftop-solar consolidated inspection, scheduled within two business days of the request.
Why the confidence is not higherPCC §8.04.050(F): 'An inspection will be scheduled within two business days of a request and provide a two-hour inspection window.'
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherPCC §8.04.050(E): 'Only one inspection is required and performed by the Building Official for a small residential rooftop solar energy system eligible for expedited review.'
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q53 If delegated, to whom? Core Who inspects
Nothing published by this authority.
Where we lookedNot applicable — Q52 is answered 'Yes' (the Building Official performs the inspection in-house per PCC §8.04.050(E)); no delegation exists to name.
Q54 Which inspections are required, and in what order? Core Stages & sequence
For an eligible small-residential-rooftop-solar system, only ONE consolidated final inspection is required — the ordinance does not describe a separate rough-in/mid-roof stage for the streamlined path.
Why the confidence is not higherPCC §8.04.050(E)-(F).
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherPCC §8.04.050(E): 'Only one inspection is required' for an eligible small residential rooftop solar system — no separate rough-in/mid-roof inspection is contemplated.
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q56 Does the inspector verify labels and listings? Core What is checked
Yes
Why the confidence is not higherThe PV Installation Compliance Affidavit — completed by the installer and returned to the inspector at/before final inspection — has the installer initial that 'Number of PV modules and model number matches approved plans and spec sheets... (Photo may be taken of the PV module label and supplied at the time of inspection)' and separately verify all required signs are installed; this is the mechanism by which labels/listings are checked.
published inspection form (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/PV-installation-affidavit.pdf
Q57 Is there a published inspection checklist? Core What is checked
Yes
Why the confidence is not higherThe PV Installation Compliance Affidavit is a published, downloadable, item-by-item inspection checklist linked directly from the Solar Building Permit page.
published checklist (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/PV-installation-affidavit.pdf
Q58 What must be on site at inspection? Core Documents on site
An approved set of plans and the inspection card must be on site at all times (general city inspection policy); for solar specifically, the completed and signed PV Installation Compliance Affidavit must be returned to the building inspector prior to or at final inspection.
Why the confidence is not higherCombines the general 'Schedule an Inspection' page requirement with the Affidavit's own instruction: 'Applicant shall have approved set of plans on site at the time of inspection... must be returned to the City of Piedmont building inspector prior to or at final inspection.'
department page + published form (PDF) checked 2026-08-31 https://piedmont.ca.gov/services/permits/building/schedule-inspection
Q59 Is there a re-inspection fee? Corrections & re-inspection
No distinct 're-inspection' fee line is published; the current Fee Schedule's only relevant mechanism is its general Hourly Rates table (e.g. Building Official $213/hr, Plans Examiner $186/hr), which is not explicitly labeled for re-inspections.
Why the confidence is not higherFull-text control check of the current Fee Schedule PDF: 'fee' 28 hits, fabricated 'zzqqx' 0 hits, and no string match for 're-inspection' or 'reinspection' anywhere in the document — a genuine, control-proven absence of a labeled line item, though an hourly-rate-based charge cannot be ruled out.
fee schedule (absence checked) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/Departments/Planning%20Division/2025%20Code%20Updates/Planning%20and%20Building%20Fee%20Schedule%20FY26.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
If an application is deemed incomplete, the city sends the applicant a written correction notice detailing the deficiencies and any additional information/documentation needed to be eligible for expedited issuance; corrections are cleared by resubmission that satisfies the notice.
Why the confidence is not higherPCC §8.04.050(D).
ordinance checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Government/City%20Charter%20&%20Code/Chapter%208.1%20(Effective%202026-01-01).pdf
Q61 What is issued on pass? Core Final sign-off & PTO
Final
Why the confidence is not higherAll city and form language uses 'final inspection' / 'final inspection approval' terminology (e.g., the PV Installation Affidavit is to be 'SUBMIT AT FINAL INSPECTION' and returned 'prior to or at final inspection approval of the building permit'); no separate certificate-of-occupancy or green-tag document was found for a residential alteration of this type.
published form (PDF) checked 2026-08-31 https://www.piedmont.ca.gov/UserFiles/Servers/Server_13659739/File/Services/Permits/Building/PV-installation-affidavit.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedThe city's Solar Building Permit page, streamlined-review handout, Eligibility Checklist and PV Installation Affidavit were all checked for language assigning responsibility for notifying PG&E for Permission to Operate; none address it.
https://www.piedmont.ca.gov/services/permits/building/types/solar
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Piedmont against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Piedmont is the authority having jurisdiction 95% confidence
- Holds
- Building and Electrical (combined, in-house; also performs its own fire/life-safety plan check for solar — Piedmont has its own Fire Department but no separate fire permit/fee for residential PV)
- Overridden by
- California Solar Rights Act / Gov. Code nondiscretionary-review mandates (implemented locally at Piedmont City Code §§8.04.040-.050, which limit the Building Official's review to health-and-safety findings and bar conditioning approval on HOA/association sign-off); the 2025 California Building Standards Code, Title 24 (adopted by reference at §8.02.010, effective 01/01/2026) sets the baseline that the City has adopted with only targeted local amendments
- Why not higher
- Piedmont is a charter city (since 1923) with its own Planning & Building Department administering permits under Piedmont City Code Chapter 8 (Building, Construction & Fire Prevention), which adopts the 2025 CBSC by reference (§8.02.010) and contains its own codified small-residential-rooftop-solar division (§8.04). The Building Official (Paki Muthig) is named city staff on the city's own domain/phone extension, not a contract firm. Alameda County has no role — Piedmont is fully incorporated and self-performs building, electrical and fire.
- Permit required
- Yes98%
- Permit cost
- $559 flat (residential); $1,085 flat (commercial); $343 flat if processed as a 'SolarAPP+' permit type92%
- Plan review
- 3 business days92%
- Portal
- eTRAKiT (https://pied-trk.aspgov.com/etrakit/), with Symbium (symbium.com) as an integrated instant-permit front end for eligible solar projects that auto-submits into eTRAKiT92%
- Electrical code
- 202385%
- Own placard wording
- Yes, for the ESS disconnect specifically78%
- Booking an inspection
- Portal82%
Labels & placards for this authority
City of Piedmont writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 78%
Yes, for the ESS disconnect specifically
Size, colour & material 75%
For the ESS disconnect: colour only ('permanent red label'), no letter height/material specified. For PV placards generally, the city's own Standard Plan carries an informational (non-mandatory) note: 'No type size is specified, but 20 point (3/8") should be considered the minimum,' referencing ANSI Z535.4 for safety-sign design guidance.
Where they go 82%
At the inverter (AC disconnect); at the main service/PV DC disconnect; on interior and exterior DC conduits, raceways and cable assemblies (marked every 10 ft and within 1 ft of turns/penetrations); at junction/combiner boxes; at the main electric panel/dual-power-source directory; and, for ESS, on the ESS disconnect located near and in line of sight of the main panel.
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
