City of Placerville
El Dorado County
City of Placerville is a city authority in the State of California, serving 10,747 residents. 3,752 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 3 business days Q18 Where you file — OnCamino (Clariti Launch) portal, at app.oncamino.com/placerville_ca -- 'PV Solar' is one of the named quick-link application types alongside Reroof, Q20
- Permit required
- Yes97% source
- What it costs
- $200 flat for a standard installation (per PMC 4-12-7's own cost-of-service figure, which reconciles exactly with the Joint Fee Schedule's $95 Plan Review + $105 Permit = $200 for 'Expedited PV Solar…90% source
- Plan review turnaround
- 3 business days92% source
- Key document
- fee schedule + municipal code cited by 4 open the document
-
Confirm who has a say over your address

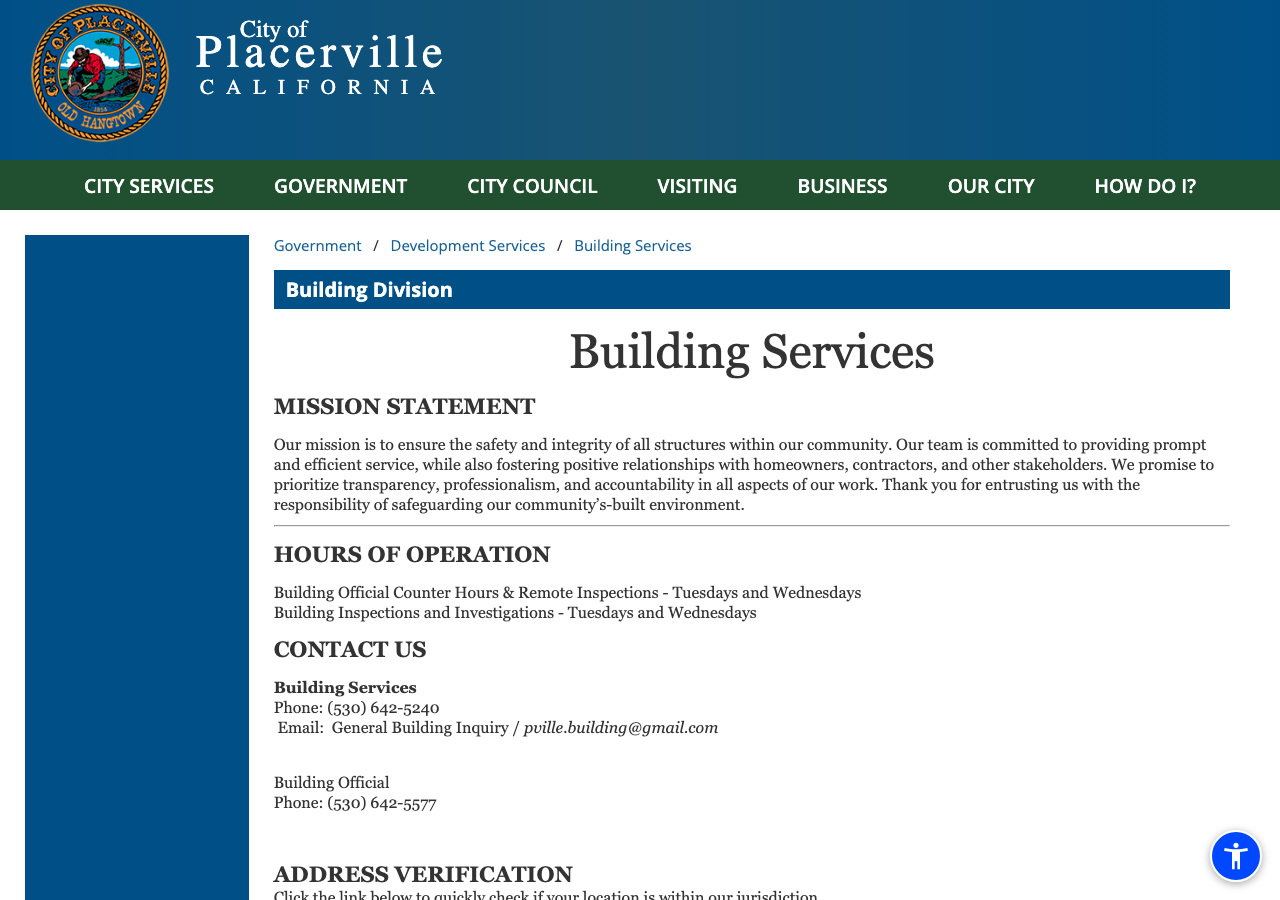

A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · department page + municipal code
- What does this authority permit itself, and what does it delegate? Both (Building and Electrical, one Building Division permit); Fire code is city-adopted but fire safety services/plan review are contracted to El Dorado County Fire Protection District 88% · department page + municipal code
- Is a permit required for a residential rooftop PV system? Yes 97% · department page + municipal code
- Is there a separate electrical permit, or is it combined? Combined 78% · fee schedule
- Is a HOA or architectural approval required first? No 92% · municipal code
- Is there a historic-district review? Yes, a discretionary Historic District design-review mechanism exists in the zoning code, but no solar-specific carve-out (or exemption) for it was found. PMC 10-4-10 creates a mapped 'Historical District' within which 'all buildings which shall be hereinafter constructed or altered as to their exterior appearance ... shall, as to their exterior architecture visible from the street, conform to the historical criteria.' The Planning Division's own fee schedule prices a 'Historic District Review' at $400. This sits in tension with PMC 4-12-6(A)'s own commitment to an 'administrative, nondiscretionary review process' for eligible small residential rooftop solar, and with state law (Gov. Code 65850.5); the city has not published anything reconciling the two. 70% · municipal code (zoning) + fee schedule
- Is a wind or windstorm certification required? No -- there is no California windstorm-certification regime comparable to a coastal-state TDI product-approval system, and no Placerville-specific wind-design certification requirement was found in the Municipal Code amendments (PMC 4-1-5) or PMC Chapter 4-12. 60% · municipal code (absence)
- Is a Specific Use Permit or Council approval ever required? No -- PMC 4-12-6(A) commits the city to 'an administrative, nondiscretionary review process to expedite approval of small residential rooftop solar energy systems,' issuing a permit rather than a discretionary Use Permit or Council approval. The Building Official may only decline the expedited path (appealable to the Development Services Director, not Council) on a written finding of 'a specific, adverse impact upon the public health and safety.' Generic 'Conditional Use Permit -- Major/Minor' fee lines exist in the Planning Division's fee schedule but nothing found ties them to solar. 85% · municipal code
- Is there a system-size cap on residential generation? 10 kW AC nameplate rating or 30 kW thermal -- the AB 2188-era statutory threshold that defines a 'small residential rooftop solar energy system' eligible for the city's expedited/nondiscretionary review path, per PMC 4-12-1. This is a gate on the STREAMLINED path, not an outright prohibition on larger systems: PMC 4-12-7 explicitly contemplates a fee 'above ten (10) kilowatts,' implying larger systems are still permitted, just outside the fast-track/standard-installation definition. 90% · municipal code
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 55% · municipal code (absence) + general CA practice
- Must the contractor be registered with this authority before applying? Yes 90% · department page (quoting municipal code)
- Is a homeowner permitted to self-install and self-permit? Yes 55% · department handout (absence) + general CA practice
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? General Plan Submittal Checklist items applicable to any building permit, including solar: wet-signed cover sheet (property address, APN, owner/contractor/business info, scope of work, WUI requirements, architect/engineer/designer info, sheet index, existing/new floor plan with north arrow, code study, type of construction, square footage, engineer's scale); 2 complete sets of plans plus 1 floor plan; complete electrical plans (main service, sub-panels, lighting, receptacles); elevations; and, per the checklist's own building-plans list, 'Solar equipment and roof layout' as a required plan sheet. No PV-specific supplemental checklist (of the kind other CA cities publish) was found on the live site -- the site's Building Division 'Forms and Handouts' toolbox lists only the general checklist above, plus a separate general Site Plan Requirements handout. 70% · published checklist
- How many copies, and in what format? 2 complete sets of plans plus 1 floor plan (with all rooms labeled) for a counter/paper submittal; drawing sheets 11x17 min. up to 36x42 max, all pages the same size. Electronic submittal is separately authorized by PMC 4-12-5(B): 'electronic submittal of the required permit application and documents by e-mail, the internet, or facsimile shall be made available to all small residential rooftop solar energy system permit applicants.' 68% · published checklist + municipal code
- Is a site plan required, and what must it show? Yes 80% · department handout
- Is a one-line / three-line diagram required? Yes 55% · published checklist (inference)
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? OnCamino (Clariti Launch) portal, at app.oncamino.com/placerville_ca -- 'PV Solar' is one of the named quick-link application types alongside Reroof, HVAC and Water Heater. 92% · department page + portal landing page
- Can the whole application be completed online? Yes 70% · municipal code + portal
- What does a residential solar permit cost? $200 flat for a standard installation (per PMC 4-12-7's own cost-of-service figure, which reconciles exactly with the Joint Fee Schedule's $95 Plan Review + $105 Permit = $200 for 'Expedited PV Solar < 10kW'); capped at $500 plus $15/kW for each kW above 10 kW for a system that is 'more than a standard installation.' Payment methods/surcharges not published. 90% · fee schedule + municipal code
- How is the fee calculated? Tiered 88% · fee schedule + municipal code
- Is there a separate plan-check fee? Yes 85% · fee schedule
-
Plan review — and start the utility in parallel

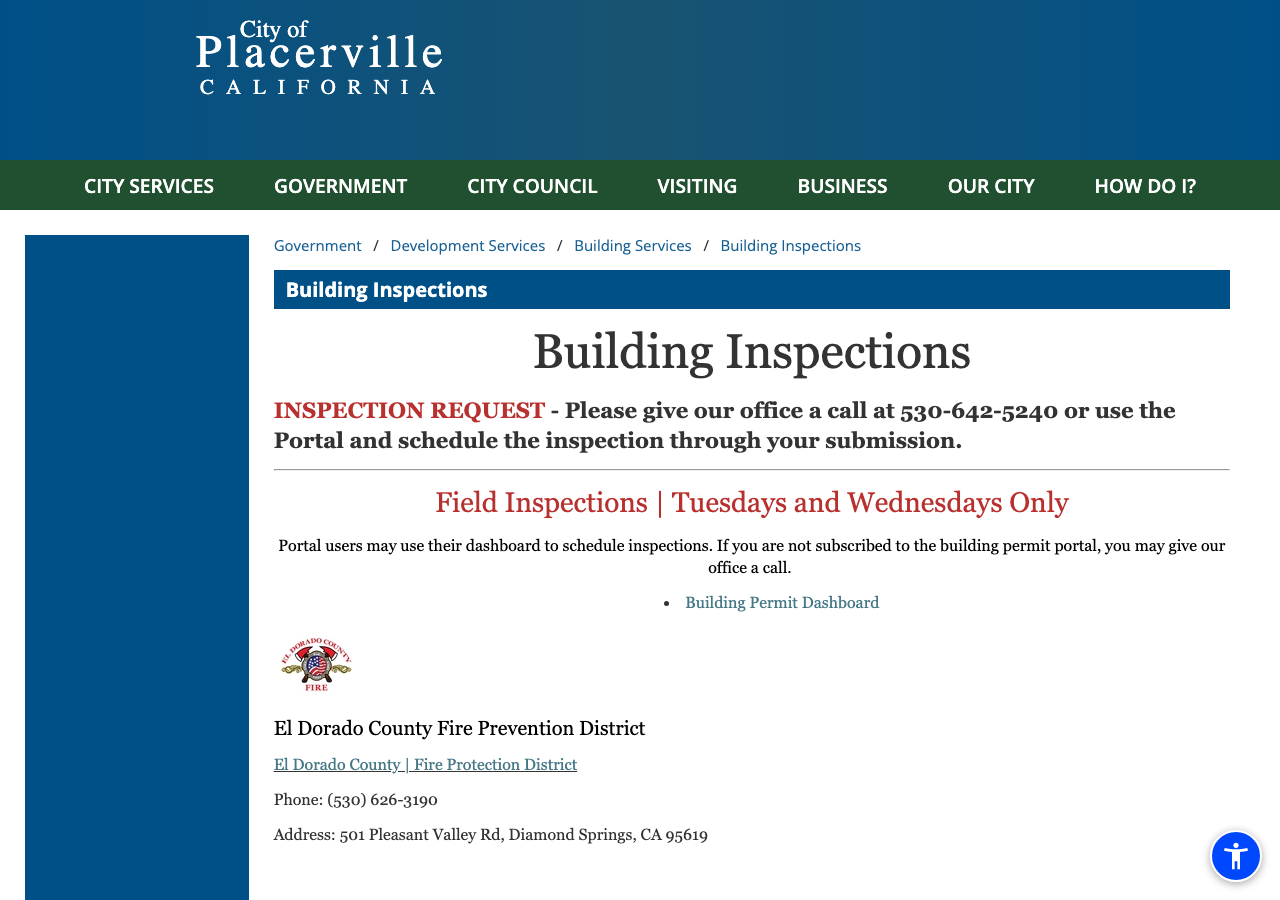

Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 3 business days 92% · municipal code
- Which utility handles interconnection here? PG&E (Pacific Gas & Electric Company) 95% · California Energy Commission GIS, point query
- Where does the utility sit in the sequence? Parallel, with a hard dependency at the end 85% · utility interconnection handbook
28 questions answered against City of Placerville’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity of Placerville's own Building Division (Development Services Dept.) issues residential building/electrical permits, and PMC 4-12-3 states outright: 'This chapter applies to the permitting of all small residential rooftop solar energy systems in the city.'
department page + municipal code checked 2026-08-31 https://www.cityofplacerville.org/buildingdivision
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both (Building and Electrical, one Building Division permit); Fire code is city-adopted but fire safety services/plan review are contracted to El Dorado County Fire Protection District
Why the confidence is not higherPMC 4-1-4 adopts CBC/CRC/CEC/CFC (Title 24 Parts 1-12) by reference in one section administered by the Building Division; the city's own 'El Dorado County Fire Department' page states 'The City of Placerville contracts El Dorado County Fire Protection District for fire safety and emergency services.'
department page + municipal code checked 2026-08-31 https://www.cityofplacerville.org/eldoradocountyfiredepartment
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherThe city's own 'Projects that Require a Permit' page lists 'Photovoltaic (solar) systems, Battery storage' and 'Racking' explicitly among items requiring a permit; PMC 4-12-3(A) confirms the chapter 'applies to the permitting of all small residential rooftop solar energy systems in the city.'
department page + municipal code checked 2026-08-31 https://www.cityofplacerville.org/BuildingDivision-ProjectsthatRequireapermit
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe Building Division's own Joint Fee Schedule carries a single 'Expedited PV Solar < 10kW' line with one Plan Review figure ($95) and one Permit figure ($105) rather than a separate electrical-permit fee, and the online portal's 'PV Solar' quick-link sits alongside Reroof/HVAC/Water Heater as one Building Permit application type. Not stated in so many words as 'combined' by the city.
fee schedule checked 2026-08-31 https://www.cityofplacerville.org/media/Development%20Services%20Department/Joint%20Fee%20Schedule%20(DWH%2004-16-2025).pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherPMC Chapter 4-12 (the city's solar ordinance) refers only to 'applicant' and 'installer' and never restricts who may pull the permit; no city document was found stating a licensed-electrician-only rule for solar, so this rests on the absence of a restriction plus California's general owner-builder allowance rather than an explicit city statement.
municipal code (absence) + general CA practice checked 2026-08-31 https://web.archive.org/web/20210620015408/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1611
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherPMC 5-1-4, quoted on the city's own Business License page: 'It shall be unlawful for any person to transact and carry on any business, trade, profession, calling, or occupation in the City without first having procured a license from said City.' The same page states explicitly that 'El Dorado County Business Licenses are not valid for use within the City limits' -- so an out-of-city contractor must obtain a City of Placerville business license before doing permitted work here.
department page (quoting municipal code) checked 2026-08-31 https://www.cityofplacerville.org/business-license
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherThe city's 'Exemption From Permit' handout (the standard CBC/CRC/CEC exemption list) contains no owner-builder restriction and no solar-specific carve-out; PMC Chapter 4-12 likewise does not exclude owner-installed systems. No Placerville-specific owner-builder form or statement was found, so this is an inference from silence plus California's universal owner-builder allowance (Business & Professions Code 7044), not a city-stated policy.
department handout (absence) + general CA practice checked 2026-08-31 https://www.cityofplacerville.org/media/Development%20Services%20Department/Exemption%20From%20Permit.pdf
Q8 What documents make up a complete submittal? Core Submittal package
General Plan Submittal Checklist items applicable to any building permit, including solar: wet-signed cover sheet (property address, APN, owner/contractor/business info, scope of work, WUI requirements, architect/engineer/designer info, sheet index, existing/new floor plan with north arrow, code study, type of construction, square footage, engineer's scale); 2 complete sets of plans plus 1 floor plan; complete electrical plans (main service, sub-panels, lighting, receptacles); elevations; and, per the checklist's own building-plans list, 'Solar equipment and roof layout' as a required plan sheet. No PV-specific supplemental checklist (of the kind other CA cities publish) was found on the live site -- the site's Building Division 'Forms and Handouts' toolbox lists only the general checklist above, plus a separate general Site Plan Requirements handout.
Why the confidence is not higherBoth PDFs (Plan_submittal_checklist and Proper Site Plan) were downloaded and extracted with pdftotext -layout and read in full; 'Solar equipment and roof layout' is an explicit named item on the general checklist. Confidence is not higher because this is a general building-plan checklist, not a solar-specific one, and the city's OnCamino/Clariti portal (which hosts a distinct 'PV Solar' application type) requires an account or guest sign-in to view its own document list, which this run could not get past.
published checklist checked 2026-08-31 https://www.cityofplacerville.org/media/Building%20Division%20Files/Plan%20and%20Permitting%20Information/Plan_submittal_checklist%20City%20of%20Placerville.pdf
Q9 How many copies, and in what format? Submittal package
2 complete sets of plans plus 1 floor plan (with all rooms labeled) for a counter/paper submittal; drawing sheets 11x17 min. up to 36x42 max, all pages the same size. Electronic submittal is separately authorized by PMC 4-12-5(B): 'electronic submittal of the required permit application and documents by e-mail, the internet, or facsimile shall be made available to all small residential rooftop solar energy system permit applicants.'
Why the confidence is not higherCopy-count and sheet-size figures are from the general Plan Submittal Checklist (not solar-specific); the electronic-submittal right is solar-specific and quoted directly from PMC 4-12-5(B).
published checklist + municipal code checked 2026-08-31 https://www.cityofplacerville.org/media/Building%20Division%20Files/Plan%20and%20Permitting%20Information/Plan_submittal_checklist%20City%20of%20Placerville.pdf
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes
Why the confidence is not higherThe general checklist requires a site plan; the city's separate 'Proper Site-Plan Submittal' handout requires: complete property boundary with measurements, streets labeled, proposed structure(s)/array location with setbacks, distances/bearings of property lines/easements/rights-of-way and adjacent APNs, existing utilities/structures within 15 ft, scale, north arrow, legend, street names, vicinity map, and project data (owner, address, APN). Not solar-specific, but not excluded from solar either.
department handout checked 2026-08-31 https://www.cityofplacerville.org/media/Building%20Division%20Files/Plan%20and%20Permitting%20Information/Proper%20Site%20Plan.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherNo document uses the term 'one-line diagram' explicitly, but the general Plan Submittal Checklist requires 'Complete electrical plans (Main service, sub-panels, lighting, receptacles)' as part of any building-plans submittal, and a single-line diagram is the industry-standard way to show this for a grid-tied PV system. Recorded at reduced confidence because the city's own document does not use the specific term.
published checklist (inference) checked 2026-08-31 https://www.cityofplacerville.org/media/Building%20Division%20Files/Plan%20and%20Permitting%20Information/Plan_submittal_checklist%20City%20of%20Placerville.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedPMC 4-12 (self-verification of electrical system capacity required by 4-12-6(D), but no named string/conductor CALCULATION SHEET requirement) and the general Plan Submittal Checklist (electrical plans required, no calculation-sheet line item)
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedGeneral Plan Submittal Checklist ('Structural Calculations provided (2) Copies' is an office-use checkbox with no stated valuation/size threshold) and PMC 4-12-6(C) (self-verification standard by the applicant, with no PE-stamp threshold named -- the checklist separately notes a wet-seal exception for single-family dwellings on the general cover-sheet signature requirement, but that is not a PV-specific structural-PE-stamp threshold)
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedPMC Chapter 4-12 and PMC 4-1-4/4-1-5 (no electrical PE-stamp threshold stated anywhere in the searchable, Wayback-archived portions of Title 4); general Plan Submittal Checklist is silent on electrical PE stamps entirely
Q15 What does a residential solar permit cost? Core Fees
$200 flat for a standard installation (per PMC 4-12-7's own cost-of-service figure, which reconciles exactly with the Joint Fee Schedule's $95 Plan Review + $105 Permit = $200 for 'Expedited PV Solar < 10kW'); capped at $500 plus $15/kW for each kW above 10 kW for a system that is 'more than a standard installation.' Payment methods/surcharges not published.
Why the confidence is not higherPMC 4-12-7 (Fees) read in full and independently cross-checked against the Building Division's own Joint Fee Schedule PDF (Updated 04/16/25), which shows the same $95/$105 split under 'Expedited PV Solar < 10kW' -- the two city documents corroborate each other exactly.
fee schedule + municipal code checked 2026-08-31 https://www.cityofplacerville.org/media/Development%20Services%20Department/Joint%20Fee%20Schedule%20(DWH%2004-16-2025).pdf
Q16 How is the fee calculated? Core Fees
Tiered
Why the confidence is not higherFlat $200 (via $95 plan review + $105 permit) for a standard system up to a breakpoint, then a statutory-formula ceiling of $500 + $15/kW above 10 kW for a non-standard/larger system, per PMC 4-12-7 and the Joint Fee Schedule.
fee schedule + municipal code checked 2026-08-31 https://www.cityofplacerville.org/media/Development%20Services%20Department/Joint%20Fee%20Schedule%20(DWH%2004-16-2025).pdf
Q17 Is there a separate plan-check fee? Fees
Yes
Why the confidence is not higherThe Joint Fee Schedule shows 'Expedited PV Solar < 10kW' as two distinct columns -- Plan Review $95 and Permit $105 (plus Green Fee and Document Fee) -- so a plan-review component is broken out separately from the permit-issuance component.
fee schedule checked 2026-08-31 https://www.cityofplacerville.org/media/Development%20Services%20Department/Joint%20Fee%20Schedule%20(DWH%2004-16-2025).pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
3 business days
Why the confidence is not higherPMC 4-12-6(A): 'The building division shall issue a building permit or other nondiscretionary permit within three (3) business days for electronic applications of receipt of a deemed complete application' meeting the approved checklist/standard plan.
municipal code checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q19 How long is an issued permit valid before it expires? Timeline & validity
Nothing published by this authority.
Where we lookedPMC Title 4 Chapter 3: 4-3-1 through 4-3-3 (Permits; Application For Permit; Permits Issuance) are each 'Rep. by Ord. 1623, 2-12-2008' (repealed, no replacement text found archived); 4-3-4(C) covers only PLAN REVIEW expiration (180 days if no permit issued, one 180-day extension), which is a different question from an ISSUED permit's own validity period. The remaining Chapter 3 sections (roughly nodes 1213-1224) were not captured by the Wayback Machine for this code, and the live American Legal site (codelibrary.amlegal.com) returns a Cloudflare JS challenge to every fetch method tried
Q20 Which permit portal does this authority use? Core Portal & process
OnCamino (Clariti Launch) portal, at app.oncamino.com/placerville_ca -- 'PV Solar' is one of the named quick-link application types alongside Reroof, HVAC and Water Heater.
Why the confidence is not higherConfirmed directly from the Building Division page's quick-links and by loading the portal itself (a Clariti-branded 'City of Placerville's Development Services' sign-in/guest portal).
department page + portal landing page checked 2026-08-31 https://www.cityofplacerville.org/buildingdivision
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higherPMC 4-12-5(B)-(C) requires the city to make 'electronic submittal of the required permit application and documents by e-mail, the internet, or facsimile' available for solar permits, and accepts an electronic signature in lieu of a wet signature. The OnCamino/Clariti portal itself supports starting and (per its own marketing text) tracking a full application online. Confidence is not higher because the actual document checklist behind the portal's 'PV Solar' application sits behind an account/guest sign-in wall this run could not get past, so the full online workflow could not be verified end-to-end.
municipal code + portal checked 2026-08-31 https://web.archive.org/web/20210617184546/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1618
Q22 Which utility handles interconnection here? Core Utility interconnection
PG&E (Pacific Gas & Electric Company)
Why the confidence is not higherIndependently confirmed by point-querying the California Energy Commission's own ElectricLoadServingEntities_IOU_POU ArcGIS feature service at Placerville City Hall's coordinates (-120.7986, 38.7295); it returns 'Pacific Gas & Electric Company' (Type: IOU). Not sourced from a ZIP-code lookup tool.
California Energy Commission GIS, point query checked 2026-08-31 https://services3.arcgis.com/bWPjFyq029ChCGur/ArcGIS/rest/services/ElectricLoadServingEntities_IOU_POU/FeatureServer/0/query?geometry=-120.7986,38.7295&geometryType=esriGeometryPoint&inSR=4326&spatialRel=esriSpatialRelIntersects&outFields=Utility,Acronym,Type&f=json
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel, with a hard dependency at the end
Why the confidence is not higherPG&E's own Distribution Interconnection Handbook, sec. 2.10 'Approved Building Permit' (re-extracted directly, not inherited): 'Before PG&E performs an inspection of the generation system, proof is required that the installation has passed a building and electrical inspection by the local authorities,' and the system 'must not be operated in parallel with PG&E's distribution system until the customer has received a written approval from PG&E.'
utility interconnection handbook checked 2026-08-31 https://www.pge.com/assets/pge/docs/about/doing-business-with-pge/distribution-interconnection-handbook.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherPMC 4-12-6(H): 'The city shall not condition approval of an application on the approval of an association or similar group, as defined in section 4080 of the Civil Code.'
municipal code checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q25 Is there a historic-district review? Overlays & special cases
Yes, a discretionary Historic District design-review mechanism exists in the zoning code, but no solar-specific carve-out (or exemption) for it was found. PMC 10-4-10 creates a mapped 'Historical District' within which 'all buildings which shall be hereinafter constructed or altered as to their exterior appearance ... shall, as to their exterior architecture visible from the street, conform to the historical criteria.' The Planning Division's own fee schedule prices a 'Historic District Review' at $400. This sits in tension with PMC 4-12-6(A)'s own commitment to an 'administrative, nondiscretionary review process' for eligible small residential rooftop solar, and with state law (Gov. Code 65850.5); the city has not published anything reconciling the two.
Why the confidence is not higherPMC 10-4-10 read in full from a Wayback capture (2021-04-15, only version findable -- the live American Legal site is Cloudflare-blocked); the $400 fee line read directly from the city's own Joint Fee Schedule. 70 rather than higher because I could not confirm whether the Historic District's boundary (on file with the city clerk as 'exhibit A') actually covers any residential parcels, or whether the Building Division's own practice already treats compliant rooftop PV as outside 10-4-10's scope.
municipal code (zoning) + fee schedule checked 2026-08-31 https://web.archive.org/web/20210415234214/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-8231
Q26 Is a wind or windstorm certification required? Overlays & special cases
No -- there is no California windstorm-certification regime comparable to a coastal-state TDI product-approval system, and no Placerville-specific wind-design certification requirement was found in the Municipal Code amendments (PMC 4-1-5) or PMC Chapter 4-12.
Why the confidence is not higherPMC 4-1-5 (the city's own CBC/CRC amendment section) amends only the roof-covering and snow-load provisions; it contains no wind-speed or wind-certification amendment. Checked also against Chapter 4-12, which requires only a general structural self-verification (4-12-6(C)), not a wind certificate. 60 because the live American Legal site could not be searched directly (Cloudflare-blocked) and only the two Wayback-captured amendment sections were available to check.
municipal code (absence) checked 2026-08-31 https://web.archive.org/web/20220627031312/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1161
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
No -- PMC 4-12-6(A) commits the city to 'an administrative, nondiscretionary review process to expedite approval of small residential rooftop solar energy systems,' issuing a permit rather than a discretionary Use Permit or Council approval. The Building Official may only decline the expedited path (appealable to the Development Services Director, not Council) on a written finding of 'a specific, adverse impact upon the public health and safety.' Generic 'Conditional Use Permit -- Major/Minor' fee lines exist in the Planning Division's fee schedule but nothing found ties them to solar.
Why the confidence is not higherPMC 4-12-6(A) and (E) read in full; the fee schedule's CUP lines ($1,500 major / $700 minor) were checked and are generic, not solar-specific -- confirmed by the absence of 'solar' or 'photovoltaic' anywhere near them in the same document.
municipal code checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC nameplate rating or 30 kW thermal -- the AB 2188-era statutory threshold that defines a 'small residential rooftop solar energy system' eligible for the city's expedited/nondiscretionary review path, per PMC 4-12-1. This is a gate on the STREAMLINED path, not an outright prohibition on larger systems: PMC 4-12-7 explicitly contemplates a fee 'above ten (10) kilowatts,' implying larger systems are still permitted, just outside the fast-track/standard-installation definition.
Why the confidence is not higherQuoted directly from PMC 4-12-1's definition of 'SMALL RESIDENTIAL ROOFTOP SOLAR ENERGY SYSTEM,' and corroborated by the $15/kW-above-10kW fee escalator in 4-12-7. This matches the pattern the wider CA survey has flagged: several California cities' codified solar chapters still carry the original AB 2188-era 10 kW AC / 30 kW thermal figure rather than a later-amended one; Placerville's Ord. 1671 dates to 9-8-2015 and was not found to have been amended since.
municipal code checked 2026-08-31 https://web.archive.org/web/20210617185824/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1584
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC (embedded in the 2025 California Electrical Code, Title 24 Part 3) 78% · municipal code (adopting ordinance)
- Which building code edition is in force? 2025 California Building Code / California Residential Code (Title 24 Parts 2 and 2.5) 78% · municipal code (adopting ordinance)
- Which fire code edition is in force? 2025 California Fire Code (Title 24 Part 9), adopted by the city (PMC 4-1-4) but plan-reviewed/enforced under contract by El Dorado County Fire Protection District, whose Board ratified its own 2025 CFC amendment ordinance (2025-01/ECF). 78% · municipal code + fire district ordinance
- Are there local amendments to any of the above? Yes 90% · municipal code
- What is the installation judged against? The 2025 CBC/CRC/CEC/CFC as locally amended by PMC 4-1-5 (roof covering, snow load), PMC Chapter 4-12's own solar-specific submittal/review/fee requirements, and -- on the fire-life-safety side -- El Dorado County Fire Protection District's own 'Solar Photovoltaic Installation Standard' (Std. #H-005, effective 8-20-2009) for pathway, setback and marking requirements. 75% · fire district standard + municipal code
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? 3-foot-wide clear access pathway(s) from eave to ridge on each roof slope with modules (one pathway for a hip roof, two for a single-ridge roof); modules no closer than 1.5 ft to a hip or valley if placed on both sides of it; modules located no higher than 3 ft below the ridge (for smoke-ventilation access). Ground-mounted, freestanding PV arrays are exempt from these setbacks but require a 10-ft clear brush area instead. 78% · fire district standard
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes, required under NEC 690.12 as part of the currently-adopted CEC (2023 NEC basis, via PMC 4-1-4's evergreen Title 24 Part 3 reference). 82% · fire district standard (gap) + municipal code (edition)
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? From El Dorado County FPD's Std. #H-005: a marking on the main service disconnect breaker-panel cover reading 'CAUTION: SOLAR ELECTRIC SYSTEM,' and markings on all interior/exterior DC conduit, raceways, enclosures, cable assemblies and junction boxes reading 'CAUTION: SOLAR CIRCUIT' (placed every 10 ft, at turns, and above/below penetrations). No markings are required on the inverter. These are stated to be 'in addition to those required by the National Electrical Code' (i.e., on top of standard NEC 690/705 labeling). 80% · fire district standard
- Does the authority specify placard wording of its own? Yes 88% · fire district standard
- Does it specify letter height, colour or material? Yes -- minimum 3/8 inch letter height, all capital letters, Arial or similar non-bold font, red background with white lettering, reflective/weather-resistant material suitable for the environment (Std. #H-005 references UL 969 as the weather-rating standard for the marking material, though UL listing of the marking itself is not required). 88% · fire district standard
- Is a site plan / facility map placard required, and what must it show? Yes, but it is utility-driven rather than an AHJ requirement: PG&E's Distribution Interconnection Handbook requires signage AND a site map at the meter panel when the AC disconnect switch is more than 10 feet from the point of interconnection, showing (1) a north-direction arrow, (2) a plan view of the site, and (3) the generator's AC disconnect and PG&E electric meter locations. Neither the city nor EDC FPD's Std. #H-005 publishes a separate facility-map placard requirement of their own. 78% · utility interconnection handbook
- Does the UTILITY specify placards beyond the AHJ's? Yes, PG&E. Beyond the fire district's marking requirements, PG&E's own standards (Distribution Interconnection Handbook) require: PG&E-approved open/closed markings on the AC disconnect switch; the switch lockable in both positions with a standard 5/16-inch-shaft PG&E lock; the switch located 10 feet or less from PG&E's electric meter at the point of interconnection (or, if farther, the site-map/signage requirement in Q41). 85% · utility interconnection handbook
- Where must the labels be placed? Fire-district markings: on the outside cover of the main service breaker panel (main disconnect marking), and on DC conduit/raceways/enclosures/junction boxes at 10-ft intervals, turns, and above/below penetrations (Std. #H-005). Utility markings: on/at the AC disconnect switch itself, located within 10 ft of PG&E's meter or mapped from the meter panel if farther (PG&E DIH). The city's own documents do not add a placement rule beyond these. 78% · fire district standard + utility interconnection handbook
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? 10 feet or less from PG&E's electric meter at the point of interconnection, and easily visible from the meter; if located more than 10 feet away, PG&E requires signage and a map at the meter panel showing the AC disconnect and meter locations. 85% · utility interconnection handbook
- Are batteries permitted, and under what conditions? Permitted, with two consequences tied to the city's contracted fire district. (1) 'Battery storage' is explicitly named as requiring a City permit on the 'Projects that Require a Permit' page. (2) PMC 4-12-1's definition of 'STANDARD SOLAR INSTALLATION' -- the only pathway eligible for the 3-business-day expedited review under 4-12-6(A) -- expressly excludes systems with batteries: 'The system does not contain batteries, power optimizers and generators.' So a battery/ESS installation is routed to standard (non-expedited) building-permit review rather than the fast-track solar process. On the fire side, El Dorado County FPD's ratified 2025 CFC amendment (Ordinance 2025-01/ECF, Section 509.3 'Fire Control Room,' which would otherwise require solar rapid-shutoff switches, fire risers etc. to sit in a dedicated fire control room) carries an express exception for 'One- and two-family dwellings, manufactured homes or similar uses defined as either a Group R-3, R-3.1, or R-4 occupancy' -- i.e., ordinary houses are exempted from that fire-control-room requirement. 85% · municipal code + fire district ordinance
- Is there a separate ESS permit or inspection? No 55% · department page + fee schedule (absence)
20 questions answered against City of Placerville’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC (embedded in the 2025 California Electrical Code, Title 24 Part 3)
Why the confidence is not higherPMC 4-1-4 adopts 'Part 3, known as the California electrical code, which is based on the national electrical code' by reference, without naming a specific triennial year -- an evergreen reference to whichever edition of Title 24 Part 3 is currently in force. California's 2025 CBSC cycle (effective 1 Jan 2026 statewide) is based on the 2023 NEC. 78 rather than higher because the city's own ordinance text does not itself name a year, so this is an inference from the state cycle, not a direct city statement of '2023 NEC.'
municipal code (adopting ordinance) checked 2026-08-31 https://web.archive.org/web/20240625193811/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1146
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code / California Residential Code (Title 24 Parts 2 and 2.5)
Why the confidence is not higherSame evergreen-reference mechanism: PMC 4-1-4 adopts 'Part 2, ... California building code' and 'Part 2.5, ... California residential code' by reference to Title 24 without naming a year, tracking whatever edition is currently in force under the state's triennial cycle -- currently the 2025 cycle, effective 1 Jan 2026.
municipal code (adopting ordinance) checked 2026-08-31 https://web.archive.org/web/20240625193811/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1146
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (Title 24 Part 9), adopted by the city (PMC 4-1-4) but plan-reviewed/enforced under contract by El Dorado County Fire Protection District, whose Board ratified its own 2025 CFC amendment ordinance (2025-01/ECF).
Why the confidence is not higherPMC 4-1-4 adopts 'Part 9, known as the California fire code' by the same evergreen reference; EDC FPD's Ordinance 2025-01(ECF) (re-extracted and read directly, not inherited from another file) was confirmed to be the district's current CFC amendment set, and the city's own page confirms EDC FPD is who is contracted for fire services here.
municipal code + fire district ordinance checked 2026-08-31 https://web.archive.org/web/20240625193811/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1146
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherPMC 4-1-5 locally amends CBC 1505.1.1/CRC R902 (Class A roof covering required in VHFHSZ), CBC 1607A.11.2 (no reduction in roof live loads allowed), and CBC 1608A.2 (roof snow live load fixed at 20 psf citywide) -- Ord. 1642, 6-14-2011. Separately, PMC Chapter 4-12 is itself a local solar-specific ordinance layered on the state codes, and EDC FPD's Ordinance 2025-01(ECF) locally amends the CFC (though its solar-relevant amendment, CFC 509.3, expressly exempts one- and two-family dwellings).
municipal code checked 2026-08-31 https://web.archive.org/web/20220627031312/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1161
Q33 What is the installation judged against? Core Electrical
The 2025 CBC/CRC/CEC/CFC as locally amended by PMC 4-1-5 (roof covering, snow load), PMC Chapter 4-12's own solar-specific submittal/review/fee requirements, and -- on the fire-life-safety side -- El Dorado County Fire Protection District's own 'Solar Photovoltaic Installation Standard' (Std. #H-005, effective 8-20-2009) for pathway, setback and marking requirements.
Why the confidence is not higherComposite of the city's own ordinance sections and the fire district's own standard, all read in full. 75 because H-005 is a 2009 document (predates NEC 690.12 rapid shutdown entirely) and no newer solar-specific fire standard was found published by EDC FPD, so what is 'judged against' in the field may in practice default more heavily to the current CEC/CFC than to H-005's specific numbers.
fire district standard + municipal code checked 2026-08-31 https://eldoradocountyfire.specialdistrict.org/files/72b8fe047/Solar-Photovoltaic-Installation-Standard-H005-082009.pdf
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedPMC 4-1-5 (the city's own CBC/CRC amendment section -- covers only roof covering and snow/live loads, no busbar or service-upgrade rule) and PMC Chapter 4-12 (no busbar-sizing rule); default is standard, unamended NEC 705.12
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedPMC 4-12-6(C) (only a general 'stable and adequate' self-verification standard, no prescriptive spacing/attachment spec) and PMC 4-1-5 (roof snow-load amendment sets a design VALUE -- 20 psf citywide -- but not a mounting-system or spacing rule); no manufacturer-neutral mounting standard found published by the city
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
3-foot-wide clear access pathway(s) from eave to ridge on each roof slope with modules (one pathway for a hip roof, two for a single-ridge roof); modules no closer than 1.5 ft to a hip or valley if placed on both sides of it; modules located no higher than 3 ft below the ridge (for smoke-ventilation access). Ground-mounted, freestanding PV arrays are exempt from these setbacks but require a 10-ft clear brush area instead.
Why the confidence is not higherQuoted directly from El Dorado County Fire Protection District's own 'Solar Photovoltaic Installation Standard' (Std. #H-005, eff. 8-20-2009, Rev. 08-26-09), the fire agency the city itself says it contracts with for fire services. 78 rather than higher because this document is dated 2009 (pre-dates the 2016 IRC/CRC R324/R329 pathway renumbering and 690.12 rapid shutdown) and no newer EDC FPD solar bulletin was found published to supersede it -- it may or may not still reflect the district's current field practice.
fire district standard checked 2026-08-31 https://eldoradocountyfire.specialdistrict.org/files/72b8fe047/Solar-Photovoltaic-Installation-Standard-H005-082009.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes, required under NEC 690.12 as part of the currently-adopted CEC (2023 NEC basis, via PMC 4-1-4's evergreen Title 24 Part 3 reference).
Why the confidence is not higherFollows directly from the 2023-NEC-based 2025 CEC being in force per PMC 4-1-4, with no local electrical amendment found to alter Article 690. Worth flagging: El Dorado County FPD's own solar fire-life-safety document (Std. #H-005, 2009) predates NEC 690.12 by roughly five code cycles and never mentions rapid shutdown at all -- a genuine gap between the contracted fire agency's own guidance and the current electrical code, in the same shape the wider CA survey has found elsewhere (e.g., Beverly Hills BHFD's 2010 guideline).
fire district standard (gap) + municipal code (edition) checked 2026-08-31 https://eldoradocountyfire.specialdistrict.org/files/72b8fe047/Solar-Photovoltaic-Installation-Standard-H005-082009.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
From El Dorado County FPD's Std. #H-005: a marking on the main service disconnect breaker-panel cover reading 'CAUTION: SOLAR ELECTRIC SYSTEM,' and markings on all interior/exterior DC conduit, raceways, enclosures, cable assemblies and junction boxes reading 'CAUTION: SOLAR CIRCUIT' (placed every 10 ft, at turns, and above/below penetrations). No markings are required on the inverter. These are stated to be 'in addition to those required by the National Electrical Code' (i.e., on top of standard NEC 690/705 labeling).
Why the confidence is not higherQuoted directly from the fire district's own standard, which this run downloaded and read in full with pdftotext -layout. 80 because this is the contracted fire agency's document rather than the city's own, and its 2009 vintage was not confirmed to have been superseded.
fire district standard checked 2026-08-31 https://eldoradocountyfire.specialdistrict.org/files/72b8fe047/Solar-Photovoltaic-Installation-Standard-H005-082009.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes
Why the confidence is not higherStd. #H-005 sec. 1.1.1 and 1.2.1 specify exact marking content verbatim: 'CAUTION: SOLAR ELECTRIC SYSTEM' (main disconnect) and 'CAUTION: SOLAR CIRCUIT' (DC conduit/raceways/junction boxes).
fire district standard checked 2026-08-31 https://eldoradocountyfire.specialdistrict.org/files/72b8fe047/Solar-Photovoltaic-Installation-Standard-H005-082009.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Yes -- minimum 3/8 inch letter height, all capital letters, Arial or similar non-bold font, red background with white lettering, reflective/weather-resistant material suitable for the environment (Std. #H-005 references UL 969 as the weather-rating standard for the marking material, though UL listing of the marking itself is not required).
Why the confidence is not higherQuoted verbatim from Std. #H-005 secs. 1.1.1 and 1.2.1.
fire district standard checked 2026-08-31 https://eldoradocountyfire.specialdistrict.org/files/72b8fe047/Solar-Photovoltaic-Installation-Standard-H005-082009.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes, but it is utility-driven rather than an AHJ requirement: PG&E's Distribution Interconnection Handbook requires signage AND a site map at the meter panel when the AC disconnect switch is more than 10 feet from the point of interconnection, showing (1) a north-direction arrow, (2) a plan view of the site, and (3) the generator's AC disconnect and PG&E electric meter locations. Neither the city nor EDC FPD's Std. #H-005 publishes a separate facility-map placard requirement of their own.
Why the confidence is not higherPG&E DIH sec. 2.10 (item l) re-extracted and read directly with pdftotext -layout; the absence of a city/fire-district equivalent was checked against Std. #H-005 (which covers physical component marking, not a site map) and against PMC Chapter 4-12 (silent on this point).
utility interconnection handbook checked 2026-08-31 https://www.pge.com/assets/pge/docs/about/doing-business-with-pge/distribution-interconnection-handbook.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes, PG&E. Beyond the fire district's marking requirements, PG&E's own standards (Distribution Interconnection Handbook) require: PG&E-approved open/closed markings on the AC disconnect switch; the switch lockable in both positions with a standard 5/16-inch-shaft PG&E lock; the switch located 10 feet or less from PG&E's electric meter at the point of interconnection (or, if farther, the site-map/signage requirement in Q41).
Why the confidence is not higherRe-extracted directly from PG&E's Distribution Interconnection Handbook, not inherited from any prior run's citation.
utility interconnection handbook checked 2026-08-31 https://www.pge.com/assets/pge/docs/about/doing-business-with-pge/distribution-interconnection-handbook.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
Fire-district markings: on the outside cover of the main service breaker panel (main disconnect marking), and on DC conduit/raceways/enclosures/junction boxes at 10-ft intervals, turns, and above/below penetrations (Std. #H-005). Utility markings: on/at the AC disconnect switch itself, located within 10 ft of PG&E's meter or mapped from the meter panel if farther (PG&E DIH). The city's own documents do not add a placement rule beyond these.
Why the confidence is not higherComposite of Std. #H-005 secs. 1.1-1.2 and PG&E DIH sec. 2.10, both read directly.
fire district standard + utility interconnection handbook checked 2026-08-31 https://eldoradocountyfire.specialdistrict.org/files/72b8fe047/Solar-Photovoltaic-Installation-Standard-H005-082009.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Nothing published by this authority.
Where we looked'Projects that Require a Permit' page, Joint Fee Schedule, and PMC Chapter 4-12 -- none reference a city-specific approved-equipment or approved-products list; only the generic expectation of NRTL/CEC-standard listing can be inferred, which is not the same as a stated list
https://www.cityofplacerville.org/BuildingDivision-ProjectsthatRequireapermit
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Permitted, with two consequences tied to the city's contracted fire district. (1) 'Battery storage' is explicitly named as requiring a City permit on the 'Projects that Require a Permit' page. (2) PMC 4-12-1's definition of 'STANDARD SOLAR INSTALLATION' -- the only pathway eligible for the 3-business-day expedited review under 4-12-6(A) -- expressly excludes systems with batteries: 'The system does not contain batteries, power optimizers and generators.' So a battery/ESS installation is routed to standard (non-expedited) building-permit review rather than the fast-track solar process. On the fire side, El Dorado County FPD's ratified 2025 CFC amendment (Ordinance 2025-01/ECF, Section 509.3 'Fire Control Room,' which would otherwise require solar rapid-shutoff switches, fire risers etc. to sit in a dedicated fire control room) carries an express exception for 'One- and two-family dwellings, manufactured homes or similar uses defined as either a Group R-3, R-3.1, or R-4 occupancy' -- i.e., ordinary houses are exempted from that fire-control-room requirement.
Why the confidence is not higherPROJREQ page read directly; PMC 4-12-1 definition read in full from the Wayback capture of the code; the CFC 509.3 exception was independently re-extracted (not inherited) from the Legistar-hosted copy of El Dorado County FPD Ordinance 2025-01(ECF) with pdftotext -layout, positive control 'fire' = 317 hits, fabricated control 'zzqqx' = 0 hits.
municipal code + fire district ordinance checked 2026-08-31 https://eldorado.legistar1.com/eldorado/attachments/d8af5af3-283d-474a-b123-1288fce77f60.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
No
Why the confidence is not higherThe Building Division's online quick-links (Reroof / HVAC / PV Solar / Water Heater) show no distinct Battery/ESS application type, and the Joint Fee Schedule has no ESS-specific fee line; 'Photovoltaic (solar) systems, Battery storage' are listed together as one bullet on the general permit-required list rather than as separate permit categories. Recorded as No rather than not_found because the absence was checked across all three of the city's own permit-type-naming sources.
department page + fee schedule (absence) checked 2026-08-31 https://www.cityofplacerville.org/BuildingDivision-ProjectsthatRequireapermit
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedEl Dorado County Fire Protection District's Std. #H-005 (states ground-mounted freestanding PV arrays are exempt from the roof setback rules and instead need a 10-ft clear brush area -- a FIRE standard, not a zoning determination) and Title 10 Zoning: searched 99 of 110 Wayback-archived Title 10 node captures (positive control 'setback' = 19 hits, fabricated control 'zzqqx' = 0 hits) and found no dedicated solar/PV zoning section at all (the only two 'solar' hits in the whole corpus were incidental references to 'solar noon' and 'solar gain' in a landscaping chapter) -- so whether the Zoning Title treats a ground-mounted array as an accessory structure subject to setbacks could not be determined either way
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
10 feet or less from PG&E's electric meter at the point of interconnection, and easily visible from the meter; if located more than 10 feet away, PG&E requires signage and a map at the meter panel showing the AC disconnect and meter locations.
Why the confidence is not higherQuoted directly from PG&E's Distribution Interconnection Handbook (re-extracted, not inherited).
utility interconnection handbook checked 2026-08-31 https://www.pge.com/assets/pge/docs/about/doing-business-with-pge/distribution-interconnection-handbook.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal or Phone 90% · department page
- How much notice is required? 2 business days 85% · municipal code
- Are same-day or AM/PM windows offered? PM window offered (four-hour), for expedited solar inspections 65% · municipal code (partially superseded by later practice -- flagged, not resolved)
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Delegated 72% · municipal code
- If delegated, to whom? El Dorado County Fire Protection District (contracted for fire safety and emergency services; whether its own inspectors separately inspect solar jobs is undetermined -- see Q52). 80% · department page
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? For an expedited-eligible small residential rooftop solar system: only ONE inspection, performed by the Building Division. PMC 4-12-6(J): 'Only one inspection shall be required and performed by the building division for small residential rooftop solar energy systems eligible for expedited review.' A non-standard installation (larger than 10 kW, or with batteries -- see Q45/28) falls outside this and would follow the city's ordinary building-permit inspection sequence, which was not separately published. 85% · municipal code
- Is a rough-in or mid-roof inspection required? No 80% · municipal code (absence)
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes, by the code's own mandate, though the current document could not be located on the live site. PMC 4-12-5(D)-(F) REQUIRES the Building Division to 'adopt a standard plan and checklist of all requirements with which small residential rooftop solar energy systems shall comply to be eligible for expedited review,' substantially conforming to the California Solar Permitting Guidebook, and requires 'an installation compliance checklist by the building official' to be 'checked and signed by the solar installer.' 65% · municipal code (duty) -- underlying document not independently located
- What must be on site at inspection? General building-inspection practice (not solar-specific): the approved set of plans available on site (physically or digitally); access to the areas where the permitted work is performed; the work fully complete and ready for inspection. The city's Inspection Instructions handout does not separately name a permit card, though PMC 4-12-6(F)/(J) implies an installer/company representative may be required to be present for the final solar inspection. 68% · department handout + municipal code
- Does the inspector verify labels and listings? Not explicitly stated by the city as an inspection-day requirement, but implied. PMC 4-12-5(F): 'An installation compliance checklist by the building official will be checked and signed by the solar installer as having met all the requirements applicable to the installation' -- which would include the marking/labeling requirements imposed by the fire district's Std. #H-005 and the NEC. No city document explicitly says the inspector checks equipment LISTINGS (e.g. UL marks) at final. 55% · municipal code (inference)
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (passed final inspection) 55% · department handout (inference)
- Who notifies the utility for PTO? Installer (industry-standard practice, not stated by the city) 50% · utility interconnection handbook (inference)
- Is there a re-inspection fee? $95 90% · fee schedule
- How are corrections issued and cleared? Two distinct mechanisms in Chapter 4-12: (1) for an incomplete APPLICATION, PMC 4-12-6(I) requires 'a written correction notice detailing all deficiencies in the application and any additional information or documentation required ... sent to the applicant for resubmission.' (2) For a FAILED INSPECTION, PMC 4-12-6(L): 'If a small residential rooftop solar energy system fails inspection, a subsequent inspection is authorized but need not conform to the requirements of this chapter' -- i.e., a re-inspection after failure is not bound by the 2-business-day scheduling promise or the single-inspection limit. 78% · municipal code
14 questions answered against City of Placerville’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal or Phone
Why the confidence is not higherThe city's own Building Inspections page: 'INSPECTION REQUEST - Please give our office a call at 530-642-5240 or use the Portal and schedule the inspection through your submission... Portal users may use their dashboard to schedule inspections. If you are not subscribed to the building permit portal, you may give our office a call.'
department page checked 2026-08-31 https://www.cityofplacerville.org/buildinginspections
Q50 How much notice is required? Core Booking & scheduling
2 business days
Why the confidence is not higherPMC 4-12-6(K): 'An inspection will be scheduled within two (2) business days of a request.' This applies to the expedited small-residential-rooftop-solar path specifically.
municipal code checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
PM window offered (four-hour), for expedited solar inspections
Why the confidence is not higherPMC 4-12-6(K): the district shall 'provide a four (4) hour P.M. inspection window.' Flagged at reduced confidence because this conflicts with two other of the city's own documents on WHICH DAYS inspections happen at all: the live Building Division/Building Inspections pages state field inspections occur 'Tuesdays and Wednesdays Only,' while the separate 'Inspection Instructions' PDF (revised 10/26/2023) says inspections run 'Monday through Friday, between 11:00 AM - 3:00 PM.' These three of the city's own sources do not agree with each other, and the most recent-looking one (the live Tu/We-only page) was not dated.
municipal code (partially superseded by later practice -- flagged, not resolved) checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Delegated
Why the confidence is not higherThe Building Division performs its own final building/electrical inspection for solar (PMC 4-12-6(J): 'Only one inspection shall be required and performed by the building division for small residential rooftop solar energy systems eligible for expedited review'), but the SAME section makes the fire component conditional: 'A separate fire inspection may be performed if an agreement with the local fire authority does not exist to perform safety inspections on behalf of the fire authority.' The city's own page confirms fire services are contracted to EDC FPD, but neither party publishes whether that contract includes a delegation of solar safety-inspection sign-off to the Building Division -- so the honest answer is that the fire component is conditionally delegated, not confirmed either way.
municipal code checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q53 If delegated, to whom? Core Who inspects
El Dorado County Fire Protection District (contracted for fire safety and emergency services; whether its own inspectors separately inspect solar jobs is undetermined -- see Q52).
Why the confidence is not higherCity's own 'El Dorado County Fire Department' page: 'The City of Placerville contracts El Dorado County Fire Protection District for fire safety and emergency services.'
department page checked 2026-08-31 https://www.cityofplacerville.org/eldoradocountyfiredepartment
Q54 Which inspections are required, and in what order? Core Stages & sequence
For an expedited-eligible small residential rooftop solar system: only ONE inspection, performed by the Building Division. PMC 4-12-6(J): 'Only one inspection shall be required and performed by the building division for small residential rooftop solar energy systems eligible for expedited review.' A non-standard installation (larger than 10 kW, or with batteries -- see Q45/28) falls outside this and would follow the city's ordinary building-permit inspection sequence, which was not separately published.
Why the confidence is not higherQuoted directly from PMC 4-12-6(J) -- language that is near-verbatim the same model-ordinance sentence the wider CA survey has also found in Claremont (CMC 15.50.060.E) and La Verne (LVMC 18.106.060(F)), suggesting a shared statewide model-ordinance ancestor.
municipal code checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherPMC 4-12-6(J) limits an expedited-eligible small residential rooftop solar job to a single inspection performed by the Building Division; no rough-in or mid-roof inspection stage is mentioned anywhere in Chapter 4-12 or in the general Inspection Instructions handout.
municipal code (absence) checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q56 Does the inspector verify labels and listings? Core What is checked
Not explicitly stated by the city as an inspection-day requirement, but implied. PMC 4-12-5(F): 'An installation compliance checklist by the building official will be checked and signed by the solar installer as having met all the requirements applicable to the installation' -- which would include the marking/labeling requirements imposed by the fire district's Std. #H-005 and the NEC. No city document explicitly says the inspector checks equipment LISTINGS (e.g. UL marks) at final.
Why the confidence is not higherPMC 4-12-5(F) read directly; no separate inspection-checklist document was found published (see Q57) to confirm the specific items checked.
municipal code (inference) checked 2026-08-31 https://web.archive.org/web/20210617184546/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1618
Q57 Is there a published inspection checklist? Core What is checked
Yes, by the code's own mandate, though the current document could not be located on the live site. PMC 4-12-5(D)-(F) REQUIRES the Building Division to 'adopt a standard plan and checklist of all requirements with which small residential rooftop solar energy systems shall comply to be eligible for expedited review,' substantially conforming to the California Solar Permitting Guidebook, and requires 'an installation compliance checklist by the building official' to be 'checked and signed by the solar installer.'
Why the confidence is not higherThe legal duty to publish this checklist is stated plainly in the code; however, unlike El Dorado County or the City of Tracy (which both publish a dedicated PV checklist PDF), this run could not find an equivalent document on Placerville's own site (the Building Division's 'Forms and Handouts'/toolbox page lists only a general Plan Submittal Checklist, not a solar-specific one), and the OnCamino/Clariti portal's own document list sits behind a login/guest wall this run could not get past. Recorded as Yes on the strength of the code's own mandate, at reduced confidence because the actual current document was not found published.
municipal code (duty) -- underlying document not independently located checked 2026-08-31 https://web.archive.org/web/20210617184546/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1618
Q58 What must be on site at inspection? Core Documents on site
General building-inspection practice (not solar-specific): the approved set of plans available on site (physically or digitally); access to the areas where the permitted work is performed; the work fully complete and ready for inspection. The city's Inspection Instructions handout does not separately name a permit card, though PMC 4-12-6(F)/(J) implies an installer/company representative may be required to be present for the final solar inspection.
Why the confidence is not higherQuoted from the Inspection Instructions PDF's 'Onsite Instructions' section (rev. 10/26/2023); the installer-presence point is inferred from PMC 4-12-6(K): 'The building official may require the presence of the installer or representative of the installing company during the final inspection.'
department handout + municipal code checked 2026-08-31 https://www.cityofplacerville.org/media/Building%20Division%20Files/2023/Inspection%20Instructions.pdf
Q59 Is there a re-inspection fee? Corrections & re-inspection
$95
Why the confidence is not higherBuilding Division's own Joint Fee Schedule: 'Re-inspection Fee $95.' Not stated as solar-specific, but no separate solar re-inspection line exists, so this is the applicable general figure.
fee schedule checked 2026-08-31 https://www.cityofplacerville.org/media/Development%20Services%20Department/Joint%20Fee%20Schedule%20(DWH%2004-16-2025).pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Two distinct mechanisms in Chapter 4-12: (1) for an incomplete APPLICATION, PMC 4-12-6(I) requires 'a written correction notice detailing all deficiencies in the application and any additional information or documentation required ... sent to the applicant for resubmission.' (2) For a FAILED INSPECTION, PMC 4-12-6(L): 'If a small residential rooftop solar energy system fails inspection, a subsequent inspection is authorized but need not conform to the requirements of this chapter' -- i.e., a re-inspection after failure is not bound by the 2-business-day scheduling promise or the single-inspection limit.
Why the confidence is not higherBoth quoted directly from PMC 4-12-6, read in full from the Wayback capture of the code.
municipal code checked 2026-08-31 https://web.archive.org/web/20210617180503/https://codelibrary.amlegal.com/codes/placervilleca/latest/placerville_ca/0-0-0-1625
Q61 What is issued on pass? Core Final sign-off & PTO
Final (passed final inspection)
Why the confidence is not higherNo document names a specific certificate type ('CO,' 'green tag,' or 'letter') for a rooftop PV retrofit on an existing home; the general Inspection Instructions and permit-card practice imply only a passed final inspection is required, since a PV retrofit does not typically change occupancy and would not trigger a new Certificate of Occupancy. Not stated explicitly by the city.
department handout (inference) checked 2026-08-31 https://www.cityofplacerville.org/media/Building%20Division%20Files/2023/Inspection%20Instructions.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer (industry-standard practice, not stated by the city)
Why the confidence is not higherNeither the city's site nor PMC Chapter 4-12 states who submits the Permission-to-Operate notification to PG&E. PG&E's own Distribution Interconnection Handbook states only that the customer's system 'must not be operated in parallel with PG&E's distribution system until the customer has received a written approval from PG&E' -- it does not name who files the completion/PTO paperwork, though in standard PG&E practice this is normally done by the installer on the customer's behalf.
utility interconnection handbook (inference) checked 2026-08-31 https://www.pge.com/assets/pge/docs/about/doing-business-with-pge/distribution-interconnection-handbook.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Placerville against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Placerville is the authority having jurisdiction 88% confidence
- Holds
- Building AND Electrical, issued as a single Building Division permit (PMC Title 4). Fire-code ADOPTION also sits with the city (PMC 4-1-4 adopts CA Fire Code by reference), but fire safety/emergency services and fire plan review/inspection are performed under contract by the El Dorado County Fire Protection District (EDC FPD) -- the city's own page states outright: 'The City of Placerville contracts El Dorado County Fire Protection District for fire safety and emergency services.'
- Delegated to
- El Dorado County Fire Protection District, 501 Pleasant Valley Rd, Diamond Springs CA -- fire safety/emergency response and, per its own Engineering/Plan Review program, fire-code plan review; PMC 4-12-6(J) itself contemplates that 'a separate fire inspection may be performed if an agreement with the local fire authority does not exist to perform safety inspections on behalf of the fire authority,' making the fire-inspection split conditional on the terms of that contract, which the city does not publish.
- Overridden by
- State law is layered on top and, on several points, drives the local ordinance itself: PMC Title 4 Chapter 12 (Ord. 1671, 9-8-2015) is the city's own codified implementation of Gov. Code 65850.5 (AB 2188) and the Solar Rights Act (Civil Code 714/4600); Gov. Code 66015 caps the residential permit fee; Health & Safety Code 17951 is cited as a fee-basis constraint; AB 130 (Stats. 2025 Ch. 22) now bars the city from adopting any MORE restrictive residential amendment through 1 Jun 2031.
- Why not higher
- Building/Electrical-issues-its-own-permit is confirmed from the city's own Building Division page and its codified PMC 4-12-3 ('This chapter applies to the permitting of all small residential rooftop solar energy systems in the city'). The fire-contract finding is a direct quote from the city's own 'El Dorado County Fire Department' page. 88 rather than higher because (a) the city's Municipal Code is hosted on American Legal Publishing (codelibrary.amlegal.com), whose live site returns a Cloudflare JS challenge to every fetch tool tried (curl, headless Chrome with virtual-time-budget, WebFetch) -- every code citation in this file had to be sourced from Wayback Machine captures instead, most recent available 2025-01-18 for the Title 4 TOC and 2025-07-26 for the Title 10 TOC, and (b) the exact scope of the city/EDC-FPD fire contract (does it include delegated inspection sign-off, or only suppression response?) is not published by either party.
- Permit required
- Yes97%
- Permit cost
- $200 flat for a standard installation (per PMC 4-12-7's own cost-of-service figure, which reconciles exactly with the Joint Fee Schedule's $95 Plan Review + $105 Permit = $200 for…90%
- Plan review
- 3 business days92%
- Portal
- OnCamino (Clariti Launch) portal, at app.oncamino.com/placerville_ca -- 'PV Solar' is one of the named quick-link application types alongside Reroof, HVAC and Water Heater.92%
- Electrical code
- 2023 NEC (embedded in the 2025 California Electrical Code, Title 24 Part 3)78%
- Own placard wording
- Yes88%
- Booking an inspection
- Portal or Phone90%
Labels & placards for this authority
City of Placerville writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 88%
Yes
Size, colour & material 88%
Yes -- minimum 3/8 inch letter height, all capital letters, Arial or similar non-bold font, red background with white lettering, reflective/weather-resistant material suitable for the environment (Std. #H-005 references UL 969 as the weather-rating standard for the marking material, though UL listing of the marking itself is not required).
Where they go 78%
Fire-district markings: on the outside cover of the main service breaker panel (main disconnect marking), and on DC conduit/raceways/enclosures/junction boxes at 10-ft intervals, turns, and above/below penetrations (Std. #H-005). Utility markings: on/at the AC disconnect switch itself, located within 10 ft of PG&E's meter or mapped from the meter panel if farther (PG&E DIH). The city's own documents do not add a placement rule beyond these.
What the utility wants on top 85%
Yes, PG&E. Beyond the fire district's marking requirements, PG&E's own standards (Distribution Interconnection Handbook) require: PG&E-approved open/closed markings on the AC disconnect switch; the switch lockable in both positions with a standard 5/16-inch-shaft PG&E lock; the switch located 10 feet or less from PG&E's electric meter at the point of interconnection (or, if farther, the site-map/signage requirement in Q41).
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
