City of Redondo Beach
Los Angeles County
City of Redondo Beach is a city authority in the State of California, serving 71,576 residents. 2,106 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Separate Q4 Plan review — SolarAPP+ path: instant permit issuance once fees are paid and documents uploaded. Manual/standard plan-review path: no published turnaround time found. Q18 Where you file — iWorQ ('Citizen Portal') — https://redondobeachca.portal.iworq.net/portalhome/redondobeachca — launched 31 Mar 2025 for all Planning/Building applications, Q20
- Permit required
- Yes98% source
- What it costs
- $362.00 flat (Electrical permit, 'Solar-Photovoltaic - Residential'), per the FY26-27 Community Development Master Fee Schedule effective 15 Aug 2026 (Resolution CC-2606-044).90% source
- Plan review turnaround
- SolarAPP+ path: instant permit issuance once fees are paid and documents uploaded. Manual/standard plan-review path: no published turnaround time found.55% source
- Key document
- authority checklist (absence) cited by 9 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · authority permit page
- What does this authority permit itself, and what does it delegate? Both 90% · authority department page
- Is a permit required for a residential rooftop PV system? Yes 98% · authority permit page
- Is there a separate electrical permit, or is it combined? Separate 80% · authority permit page
- Is a HOA or architectural approval required first? No 70% · authority checklist (absence)
- Is there a historic-district review? No general requirement found for non-landmarked properties; Historic Preservation review applies only to designated landmark structures/districts, and no solar-specific interaction with that program is documented. 55% · authority department page
- Is a wind or windstorm certification required? No 70% · authority checklist (absence)
- Is there a system-size cap on residential generation? No hard maximum on residential generation size, but there are procedural thresholds: systems ≤10kW AC that are roof-mounted, utility-interactive and without battery storage qualify for the expedited/Standard-Plan review; systems ≤15kW AC (or ESS ≤1 unit/20kWh) qualify for SolarAPP+ automated review; anything larger or with a larger ESS must go through full standard plan review rather than being capped outright. 80% · authority checklist
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 50% · authority FAQ
- Must the contractor be registered with this authority before applying? Yes 90% · authority FAQ
- Is a homeowner permitted to self-install and self-permit? Not directly addressed for the standard track; No for the SolarAPP+ track 55% · authority FAQ
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Completed permit application; compliance with the Eligibility Checklist for Expedited Solar PV Permitting; a Standard Electrical Plan (central/string or microinverter) OR a full electrical plan (service/utility disconnect location, module/string counts, inverter make/model, one-line diagram, grounding/bonding, battery locations if any, equipment cut sheets, CEC 690/705 labeling); a roof plan showing roof access point, code-compliant access pathways, fire classification and label locations; and a completed Structural Criteria form (or PE-stamped structural calcs if the criteria form fails). 95% · authority permit page
- How many copies, and in what format? Digital submission only, via the iWorQ Citizen Portal, PDF format, named per the city's file-naming convention (e.g. 'PC1_COMPLETE_PLANS', 'PC1_STRUC_CALCS', 'PC1_ENERGY_CALCS') 80% · authority checklist
- Is a site plan required, and what must it show? Yes — site diagram showing arrangement of panels on roof or ground, north arrow, lot dimensions, and distance from property lines to adjacent buildings/structures (existing and proposed) 95% · authority permit page
- Is a one-line / three-line diagram required? Yes 95% · authority permit page
- Are string and conductor calculations required? Yes 90% · authority permit page
- Is a structural PE stamp required, and at what threshold? Yes, but only if the system fails the expedited Structural Criteria checklist (roof slope 0–26°, single roof with no reroof overlay, 2–10in module standoff, ≤4 psf PV / 5 psf thermal, array ≤50% of roof area, lag-screw anchors per the standard spacing table). If any item fails, project-specific structural drawings/calculations stamped and signed by a California-licensed Civil or Structural Engineer are required. 95% · authority checklist
- Is an electrical PE stamp required, and at what threshold? Not required for systems meeting the Standard Plan / Eligibility Checklist; no separate electrical PE-stamp requirement is mentioned anywhere in the solar submittal materials (only structural stamps are called out). 60% · authority permit page
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

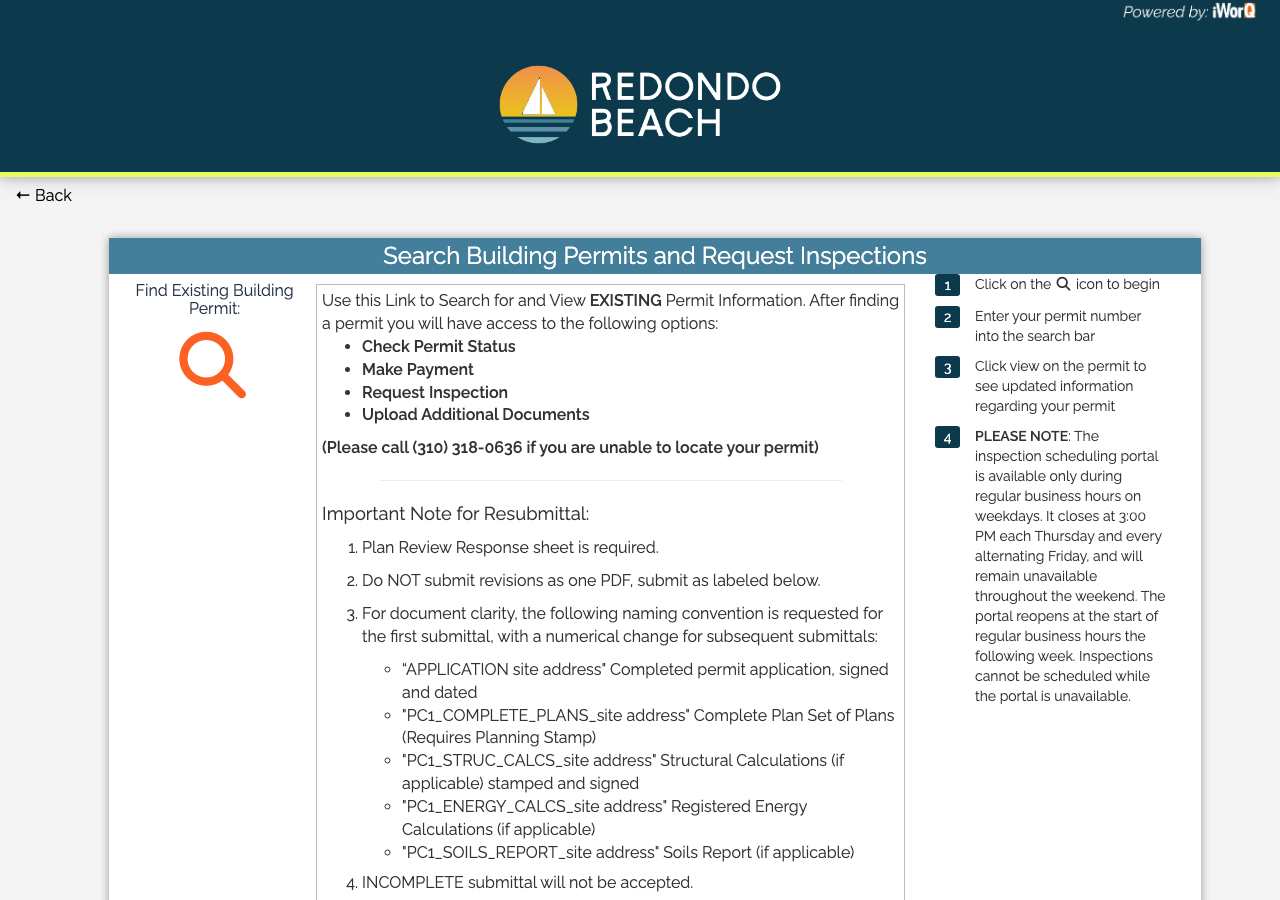

- Which permit portal does this authority use? iWorQ ('Citizen Portal') — https://redondobeachca.portal.iworq.net/portalhome/redondobeachca — launched 31 Mar 2025 for all Planning/Building applications, replacing the prior system. 90% · authority permit page
- Can the whole application be completed online? Yes 90% · authority permit page
- What does a residential solar permit cost? $362.00 flat (Electrical permit, 'Solar-Photovoltaic - Residential'), per the FY26-27 Community Development Master Fee Schedule effective 15 Aug 2026 (Resolution CC-2606-044). Note: the standalone Solar Photovoltaic Permits webpage separately states a combined 'plan review and permit fee not to exceed $500.00' — the two documents are not reconciled. 90% · fee schedule
- How is the fee calculated? Flat 90% · fee schedule
- Is there a separate plan-check fee? No separate mandatory plan-check fee for a standard/eligible system — the $362 fee is a combined electrical permit fee. If additional plan review is needed (e.g., non-eligible/oversized systems or plan revisions), it is billed at the general 'Stand Alone Plan Check' hourly rate of $275/hr. 75% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? SolarAPP+ path: instant permit issuance once fees are paid and documents uploaded. Manual/standard plan-review path: no published turnaround time found. 55% · authority permit page
- Which utility handles interconnection here? Southern California Edison (SCE) 85% · authority department page
28 questions answered against City of Redondo Beach’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity's own Solar Photovoltaic Permits page and Building & Safety Division issue solar permits directly; no county or district involvement found for building/electrical.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherBuilding & Safety Division issues both building and electrical permits in-house (no delegation to LA County DPW — Redondo Beach is NOT on LA County DPW's 16-city contract list — and no private plan-check vendor found). For a standard-plan-eligible rooftop PV system specifically, only an ELECTRICAL permit is required per the Solar Photovoltaic Permits page; a full building permit is only triggered if the structural eligibility checklist fails.
authority department page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/index.php
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherSolar Photovoltaic Permits page: 'The following permits are required to install a solar PV system with a maximum power output of 10 kW or less: A) An electrical permit is required.'
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Separate
Why the confidence is not higherSolar systems are issued their own Electrical permit (BLD/ELEC record in iWorQ), distinct from a general building permit, unless the structural eligibility checklist fails and a building permit is also required.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherNot addressed explicitly by the city for the standard (non-SolarAPP+) track. SolarAPP+ FAQ states 'At this time, only licensed contractors may submit through SolarAPP+' (homeowners barred from that specific automated path), which implies the manual/standard plan-review track is open to a broader pool including possible owner-builders under CA B&P Code 7044, but the city does not confirm this in writing.
authority FAQ checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solarapp.php
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherBuilding & Safety FAQ: 'Yes. All contractors doing business in the City need a business license, including general contractors and any sub-contractors working for them.'
authority FAQ checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/faqs.php
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Not directly addressed for the standard track; No for the SolarAPP+ track
Why the confidence is not higherSolarAPP+ FAQ explicitly answers 'I'm a homeowner. Can I use SolarAPP+? At this time, only licensed contractors may submit through SolarAPP+.' No city document confirms or denies homeowner self-install/self-permit on the manual/standard review track.
authority FAQ checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solarapp.php
Q8 What documents make up a complete submittal? Core Submittal package
Completed permit application; compliance with the Eligibility Checklist for Expedited Solar PV Permitting; a Standard Electrical Plan (central/string or microinverter) OR a full electrical plan (service/utility disconnect location, module/string counts, inverter make/model, one-line diagram, grounding/bonding, battery locations if any, equipment cut sheets, CEC 690/705 labeling); a roof plan showing roof access point, code-compliant access pathways, fire classification and label locations; and a completed Structural Criteria form (or PE-stamped structural calcs if the criteria form fails).
Why the confidence is not higherSolar Photovoltaic Permits page lists these items in full, corroborated by the standalone Eligibility Checklist and Structural Criteria PDFs.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q9 How many copies, and in what format? Submittal package
Digital submission only, via the iWorQ Citizen Portal, PDF format, named per the city's file-naming convention (e.g. 'PC1_COMPLETE_PLANS', 'PC1_STRUC_CALCS', 'PC1_ENERGY_CALCS')
Why the confidence is not higherResidential Submittal Guideline (rev. 09.09.24) specifies the required PDF file names for portal upload; the Building & Safety index page confirms all submittals as of 31 Mar 2025 go through iWorQ, not paper counters.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Applications/120%20%20SUBMITTAL%20GUIDELINES%20RESIDENTIAL.pdf
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — site diagram showing arrangement of panels on roof or ground, north arrow, lot dimensions, and distance from property lines to adjacent buildings/structures (existing and proposed)
Why the confidence is not higherSolar Photovoltaic Permits page, electrical-plan requirements list.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherSolar Photovoltaic Permits page requires 'One-line diagram of system' as part of the electrical plan when a Standard Plan is not used.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q12 Are string and conductor calculations required? Drawings & calculations
Yes
Why the confidence is not higherSolar page requires 'Total number of modules, number of modules per string and the total number of strings' and conductor type/size/conduit specification; Eligibility Checklist separately caps strings per MPPT input (no more than 4 with source-circuit fusing in the inverter, 2 without).
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Yes, but only if the system fails the expedited Structural Criteria checklist (roof slope 0–26°, single roof with no reroof overlay, 2–10in module standoff, ≤4 psf PV / 5 psf thermal, array ≤50% of roof area, lag-screw anchors per the standard spacing table). If any item fails, project-specific structural drawings/calculations stamped and signed by a California-licensed Civil or Structural Engineer are required.
Why the confidence is not higherCity's 'Structural Criteria for Residential Rooftop Solar Energy Installations' form, Section 4 (Summary).
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/solar%20-%20structural%20criteria.pdf
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Not required for systems meeting the Standard Plan / Eligibility Checklist; no separate electrical PE-stamp requirement is mentioned anywhere in the solar submittal materials (only structural stamps are called out).
Why the confidence is not higherAbsence checked across the Solar PV page, Eligibility Checklist, Structural Criteria form and Inspection Guide — none require an electrical PE stamp for compliant residential systems; only structural non-compliance triggers a PE stamp (structural, not electrical).
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q15 What does a residential solar permit cost? Core Fees
$362.00 flat (Electrical permit, 'Solar-Photovoltaic - Residential'), per the FY26-27 Community Development Master Fee Schedule effective 15 Aug 2026 (Resolution CC-2606-044). Note: the standalone Solar Photovoltaic Permits webpage separately states a combined 'plan review and permit fee not to exceed $500.00' — the two documents are not reconciled.
Why the confidence is not higherMaster Fee Schedule line item is the most current, dated document (effective 8/15/2026); the $500 cap on the solar landing page is undated and may represent an older or all-in cap including plan review hours.
fee schedule checked 2026-08-30 https://cms2.revize.com/revize/redondobeachca/Financial%20Services/Documents/Financial%20Services/Master%20Fee%20Schedule/FY26-27%20CD%20Master%20Fee%20Schedule-FINAL.pdf
Q16 How is the fee calculated? Core Fees
Flat
Why the confidence is not higherMaster Fee Schedule lists 'Solar-Photovotaic - Residential, Electrical, Each, $362.00' as a flat per-permit fee, not tied to system valuation, kW, or panel count.
fee schedule checked 2026-08-30 https://cms2.revize.com/revize/redondobeachca/Financial%20Services/Documents/Financial%20Services/Master%20Fee%20Schedule/FY26-27%20CD%20Master%20Fee%20Schedule-FINAL.pdf
Q17 Is there a separate plan-check fee? Fees
No separate mandatory plan-check fee for a standard/eligible system — the $362 fee is a combined electrical permit fee. If additional plan review is needed (e.g., non-eligible/oversized systems or plan revisions), it is billed at the general 'Stand Alone Plan Check' hourly rate of $275/hr.
Why the confidence is not higherMaster Fee Schedule electrical section lists only the flat solar line item plus a generic hourly stand-alone plan-check rate; no dedicated solar plan-check line exists.
fee schedule checked 2026-08-30 https://cms2.revize.com/revize/redondobeachca/Financial%20Services/Documents/Financial%20Services/Master%20Fee%20Schedule/FY26-27%20CD%20Master%20Fee%20Schedule-FINAL.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
SolarAPP+ path: instant permit issuance once fees are paid and documents uploaded. Manual/standard plan-review path: no published turnaround time found.
Why the confidence is not higherSolarAPP+ page states 'Once the online application process is complete and permit fees are paid, the permit will be issued instantly.' No day-count is published anywhere for the non-SolarAPP+ track (checked the Solar PV page, FAQ, and Building & Safety index).
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solarapp.php
Q19 How long is an issued permit valid before it expires? Timeline & validity
Nothing published by this authority.
Where we lookedChecked Residential Construction Checklist, Residential Submittal Guideline, FAQ, and Building Ordinances and Codes page for a stated permit-expiration/validity period. None state a local override of the state default; the RBMC Title 9 Ch.1 Building Code chapter itself (which would carry any local amendment to CBC 105.5) could not be retrieved because ecode360.com returns a Cloudflare interactive challenge (403) to both a plain fetch and the recommended iccsafe.org Referer header, and the Wayback Machine capture of the same page is JS-rendered with no code text in the raw HTML.
http://web.archive.org/web/20250901123141/https://ecode360.com/42663740
Q20 Which permit portal does this authority use? Core Portal & process
iWorQ ('Citizen Portal') — https://redondobeachca.portal.iworq.net/portalhome/redondobeachca — launched 31 Mar 2025 for all Planning/Building applications, replacing the prior system.
Why the confidence is not higherBuilding & Safety index page states iWorQ Portal launch date and mandatory use for all CAEDO applicants. Note: the dedicated Solar Photovoltaic Permits sub-page still references an older 'CTS Portal' by name — a stale reference not updated after the March 2025 migration.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/index.php
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higheriWorQ portal handles submission, plan review, fee payment, permit issuance, digital signature, and inspection requests end-to-end per the Building & Safety index and SolarAPP+ pages.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/index.php
Q22 Which utility handles interconnection here? Core Utility interconnection
Southern California Edison (SCE)
Why the confidence is not higherCity's own Construction Project Resource Guide, Utility Connection section: 'Southern California Edison 1-800-655-4555 Contact an Edison Planner for meter spotting, and checking clearance to power lines, and easements.' SCE's own 'Index of Communities' territory page is gated behind a Microsoft SharePoint OAuth login and could not be independently checked; this city-side reference is the basis for the answer.
authority department page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/construction_project_resource_guide.php
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedChecked the Solar Photovoltaic Permits page, SolarAPP+ page, Eligibility Checklist and Construction Project Resource Guide for any statement of when SCE interconnection/PTO happens relative to city permitting. None address sequencing. SCE's own DG/Rule 21 interconnection process pages return 404 or redirect to a gated SharePoint login, and an Internet Archive lookup for SCE's net-metering page was temporarily unavailable at check time.
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherNo HOA/architectural-approval requirement appears anywhere in the complete, enumerated solar submittal materials (Solar PV page, Eligibility Checklist, Structural Criteria, Residential Submittal Guideline, Residential Construction Checklist, FAQ) — verified via full-text search across all of them plus a positive control ('electrical', 47 hits) and fabricated control ('zzqqx', 0 hits).
authority checklist (absence) checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q25 Is there a historic-district review? Overlays & special cases
No general requirement found for non-landmarked properties; Historic Preservation review applies only to designated landmark structures/districts, and no solar-specific interaction with that program is documented.
Why the confidence is not higherHistoric Preservation page describes a landmark-designation program, not a blanket citywide review; the complete Residential Construction Checklist and Solar PV submittal list do not include a historic-review step.
authority department page checked 2026-08-30 https://www.redondo.org/departments/community_development/historic_preservation/index.php
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherNo wind/windstorm certification requirement found; California does not use a TDI-style windstorm certification scheme, and the city's own Structural Criteria form addresses wind uplift via prescriptive anchor spacing/fastener tables rather than a separate certification.
authority checklist (absence) checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/solar%20-%20structural%20criteria.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Nothing published by this authority.
Where we lookedChecked the Solar Photovoltaic Permits page, Eligibility Checklist, and Residential Construction Checklist — none mention a Specific Use Permit, Conditional Use Permit, or City Council approval step for any size/configuration of residential PV. The Zoning Code itself (which would state any such trigger, e.g., for oversized ground-mount systems) sits on ecode360.com and could not be retrieved (Cloudflare 403 on live fetch and Referer-header bypass; Wayback capture is JS-rendered with no body text).
http://web.archive.org/web/20250901123141/https://ecode360.com/42663740
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No hard maximum on residential generation size, but there are procedural thresholds: systems ≤10kW AC that are roof-mounted, utility-interactive and without battery storage qualify for the expedited/Standard-Plan review; systems ≤15kW AC (or ESS ≤1 unit/20kWh) qualify for SolarAPP+ automated review; anything larger or with a larger ESS must go through full standard plan review rather than being capped outright.
Why the confidence is not higherEligibility Checklist for Expedited Solar PV Permitting (10kW AC threshold) and SolarAPP+ FAQ (15kW / 1-battery-20kWh revision threshold).
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/solar%20checklist%20pdf.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC via the 2025 California Electrical Code (per the city's current 'Building Ordinances and Codes' page referencing 'the 2025 California Building Codes, which Redondo Beach adopts in part'). CONTRADICTION FLAGGED: several of the city's own solar-specific documents are dated to older cycles — the Residential Construction Checklist (rev. 01.19.23) says 'This project shall comply with the 2022 edition of the California... Electrical Code', and the Solar Inspection Guide references '2016 versions unless otherwise noted' of CEC/CRC/CBC/CFC. The eCode360 legislative history shows amendments only through Ord. No. 3294-25 (10 Jun 2025), which predates the typical 1 Jan 2026 effective date of a 2025-cycle adoption ordinance. 60% · authority department page
- Which building code edition is in force? 2025 California Building Code (per city's current code page), with the same dating contradiction as Q29 — the Residential Construction Checklist (rev. 01.19.23) still cites 'the 2022 edition of the California Building Code.' 60% · authority department page
- Which fire code edition is in force? 2022 California Fire Code as locally amended by Ordinance No. 3247-22 (Title 3, Chapter 4, Article 1, §3-4.110), specifically Chapter 12 'Energy System' §§1205.2.1–1205.2.1.3 and §1207.11.3–1207.11.7. The city's own solar/ESS bulletin implementing this amendment is headed 'Effective: January 1, 2025' and was last verified/uploaded 19 Mar 2026, but still uses 2022-cycle CFC chapter/section numbers rather than any 2025-cycle renumbering. 65% · adopting ordinance / city bulletin
- Are there local amendments to any of the above? Yes 95% · adopting ordinance / city bulletin
- What is the installation judged against? California Electrical Code Article 690/705, California Residential Code R331, California Building Code Chapter 15 (1509.7), and California Fire Code §605.11 / Chapter 12 (1205/1207) as locally amended by Ordinance No. 3247-22 and IB-0223. 90% · authority checklist
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Ridge: panels/modules on one side of any ridge only, set back at least 3ft from the ridge; if panels are on both sides of the ridge, 5ft setback on one side and 3ft on the other. Flat/alternate roofs: minimum 3ft clear perimeter around roof edges. Access pathways (per the Inspection Guide, citing CFC 605.11.3.2/CRC R331.4.2): hip roofs need a 3ft-wide pathway eave-to-ridge on each panelled slope; hips/valleys need panels ≥18in from the hip/valley if on both sides; single ridges need two 3ft-wide pathways eave-to-ridge; panels may not sit closer than 3ft to the top of the ridge. 95% · adopting ordinance / city bulletin
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Rapid shutdown (CEC 690.12) is not named explicitly in any Redondo Beach solar document reviewed, but is implicitly in force as part of whichever CEC edition applies (city's Inspection Guide cites the neighbouring CEC 690.11 arc-fault and 690.13–690.15/690.35 disconnect provisions but does not spell out 690.12 by name or edition). 55% · authority checklist
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? WARNING: ELECTRIC SHOCK HAZARD (ground-fault, on inverter/battery enclosure, CEC 690.5(C)); WARNING: ELECTRIC SHOCK HAZARD — ungrounded DC conductors (CEC 690.35(F)); DC disconnect location marking (CEC 690.14(C)(1)); PHOTOVOLTAIC SYSTEM DISCONNECT (CEC 690.14(C)(2)); DC disconnect ratings placard (CEC 690.53); AC output/voltage placard at point of interconnection (CEC 690.54); service/PV disconnect directory (CEC 690.56(B)/705.10); shock-hazard/energized-terminals placard on DC disconnects (CEC 690.17); inverter-output-OCPD warning (CEC 705.12(D)(7)); and a red-background/white-letter 'WARNING: PHOTOVOLTAIC POWER SOURCE' placard on conduits/raceways/enclosures (CFC 605.11.1.4/CEC 690.31(E)(3)-(4)/CRC R331.2.4). 95% · authority checklist
- Does the authority specify placard wording of its own? Yes 95% · authority checklist
- Does it specify letter height, colour or material? Yes — the CFC 605.11.1.1/605.11.1.2 placard must have 3/8-inch (9.5mm) minimum white letters on a red background, made of reflective, weather-resistant material. 95% · authority checklist
- Is a site plan / facility map placard required, and what must it show? Yes — a directory/placard at the electrical service (and at the PV inverter if in a different location) showing the location of the service disconnecting means and the PV system disconnecting means, per CEC 690.56(B)/690.14(D)(4) and NEC 705.10. 90% · authority checklist
- Where must the labels be placed? Adjacent to the main service disconnect (visible from where the disconnect is operated); on all interior/exterior DC conduit, enclosures, raceways, cable assemblies, junction/combiner boxes and disconnects; and repeated every 10 feet, within 1 foot of turns/bends, and within 1 foot above/below roof or wall penetrations. 95% · authority checklist
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes (functionally) — PV modules must be listed to UL 1703 (AC modules also UL 1741), combiner boxes listed to UL 1741, inverters listed to UL 1741 and marked 'utility interactive', and all connectors/terminals/disconnects must be listed for their application; equipment must match the approved plans. 90% · authority checklist
- Are batteries permitted, and under what conditions? Yes, with conditions — ESS is permitted only in detached garages/detached accessory structures, or outdoors/on exterior walls at least 3ft from doors/windows entering the dwelling unit; ESS may NOT be installed in any structure attached to the dwelling unit. Individual ESS units are capped at 20kWh; aggregate rating is capped at 80kWh (in detached garages/accessory structures, on exterior walls, or outdoors on the ground). Installations exceeding those caps must comply with the full, non-amended CFC §§1207.1–1207.9. 95% · adopting ordinance / city bulletin
- Is there a separate ESS permit or inspection? Functionally yes — the Eligibility Checklist for the expedited/Standard-Plan residential PV path explicitly requires the system to be 'without battery storage'; any system with an ESS is automatically routed out of that fast-track review and into the standard/full plan-review process, and is separately governed by the Ordinance No. 3247-22 ESS location/rating rules. This is a functional separate review track rather than a distinct 'permit type' in the fee schedule (no separate ESS fee line item was found). 65% · authority checklist
- Is there a local rule on service upgrades or busbar sizing? Yes — for the expedited/Standard-Plan path, the PV system must interconnect to a single-phase AC service panel of nominal 120/220 VAC with a busbar rating of 225A or less, and be connected to the load side of the utility distribution equipment. IB-0223 also documents a local RBMC amendment to CEC §230.70(A)(1) requiring the service disconnecting means at a readily-accessible outside location (interior allowed only where approved by the Building Official). 90% · authority checklist
- Is a specific mounting system or attachment spacing required? Yes — prescriptive lag-screw anchor spacing (5/16in dia., 2.5in embedment, 4–6ft o.c. for rafters, 4ft o.c. staggered for trusses), 2–10in standoff gap between module and roof, ≤4 psf (PV) / 5 psf (thermal) loading, and array coverage ≤50% of total roof area, per the city's Structural Criteria form — used unless the manufacturer's own listed racking system documentation is submitted instead. 95% · authority checklist
20 questions answered against City of Redondo Beach’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC via the 2025 California Electrical Code (per the city's current 'Building Ordinances and Codes' page referencing 'the 2025 California Building Codes, which Redondo Beach adopts in part'). CONTRADICTION FLAGGED: several of the city's own solar-specific documents are dated to older cycles — the Residential Construction Checklist (rev. 01.19.23) says 'This project shall comply with the 2022 edition of the California... Electrical Code', and the Solar Inspection Guide references '2016 versions unless otherwise noted' of CEC/CRC/CBC/CFC. The eCode360 legislative history shows amendments only through Ord. No. 3294-25 (10 Jun 2025), which predates the typical 1 Jan 2026 effective date of a 2025-cycle adoption ordinance.
Why the confidence is not higherLive city code page vs. dated PDF checklists disagree; the actual local 2025-cycle adopting ordinance text could not be verified because ecode360.com 403s all automated access (including with the recommended iccsafe.org Referer header) both live and via Wayback Machine (JS-rendered content, metadata-only capture).
authority department page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/building_ordinances_and_codes.php
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (per city's current code page), with the same dating contradiction as Q29 — the Residential Construction Checklist (rev. 01.19.23) still cites 'the 2022 edition of the California Building Code.'
Why the confidence is not higherSame conflict and same access limitation as Q29 (ecode360.com blocked).
authority department page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/building_ordinances_and_codes.php
Q31 Which fire code edition is in force? Code editions in force
2022 California Fire Code as locally amended by Ordinance No. 3247-22 (Title 3, Chapter 4, Article 1, §3-4.110), specifically Chapter 12 'Energy System' §§1205.2.1–1205.2.1.3 and §1207.11.3–1207.11.7. The city's own solar/ESS bulletin implementing this amendment is headed 'Effective: January 1, 2025' and was last verified/uploaded 19 Mar 2026, but still uses 2022-cycle CFC chapter/section numbers rather than any 2025-cycle renumbering.
Why the confidence is not higherCity-issued 'Solar Panel & Energy Storage System (ESS) Requirements' bulletin quotes Ordinance No. 3247-22 verbatim with full section text; the exact current-vs-2025-cycle status could not be cross-checked against ecode360 (blocked).
adopting ordinance / city bulletin checked 2026-08-30 https://www.redondo.org/Community%20Development/Building/BLDG%20DOCUMENTS/Handouts/SOLAR-RES%20ROOF%20LAYOUT%20GUIDELINES%202025%20-UPDATED.pdf
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherOrdinance No. 3247-22 rewrites CFC Chapter 12 solar/ESS sections locally (ridge setbacks, ESS location/rating limits); Information Bulletin IB-0223 documents additional local RBMC amendments to the 2022 CEC (e.g., §230.70(A)(1) service-disconnect location).
adopting ordinance / city bulletin checked 2026-08-30 https://www.redondo.org/Community%20Development/Building/BLDG%20DOCUMENTS/Handouts/SOLAR-RES%20ROOF%20LAYOUT%20GUIDELINES%202025%20-UPDATED.pdf
Q33 What is the installation judged against? Core Electrical
California Electrical Code Article 690/705, California Residential Code R331, California Building Code Chapter 15 (1509.7), and California Fire Code §605.11 / Chapter 12 (1205/1207) as locally amended by Ordinance No. 3247-22 and IB-0223.
Why the confidence is not higherCity's own Inspection Guide for PV Systems cites these code sections throughout its comprehensive checklist.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Yes — for the expedited/Standard-Plan path, the PV system must interconnect to a single-phase AC service panel of nominal 120/220 VAC with a busbar rating of 225A or less, and be connected to the load side of the utility distribution equipment. IB-0223 also documents a local RBMC amendment to CEC §230.70(A)(1) requiring the service disconnecting means at a readily-accessible outside location (interior allowed only where approved by the Building Official).
Why the confidence is not higherEligibility Checklist for Expedited Solar PV Permitting; Information Bulletin IB-0223.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/solar%20checklist%20pdf.pdf
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Yes — prescriptive lag-screw anchor spacing (5/16in dia., 2.5in embedment, 4–6ft o.c. for rafters, 4ft o.c. staggered for trusses), 2–10in standoff gap between module and roof, ≤4 psf (PV) / 5 psf (thermal) loading, and array coverage ≤50% of total roof area, per the city's Structural Criteria form — used unless the manufacturer's own listed racking system documentation is submitted instead.
Why the confidence is not higherCity's 'Structural Criteria for Residential Rooftop Solar Energy Installations' form, Sections 2–3.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/solar%20-%20structural%20criteria.pdf
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Ridge: panels/modules on one side of any ridge only, set back at least 3ft from the ridge; if panels are on both sides of the ridge, 5ft setback on one side and 3ft on the other. Flat/alternate roofs: minimum 3ft clear perimeter around roof edges. Access pathways (per the Inspection Guide, citing CFC 605.11.3.2/CRC R331.4.2): hip roofs need a 3ft-wide pathway eave-to-ridge on each panelled slope; hips/valleys need panels ≥18in from the hip/valley if on both sides; single ridges need two 3ft-wide pathways eave-to-ridge; panels may not sit closer than 3ft to the top of the ridge.
Why the confidence is not higherOrdinance No. 3247-22, RBMC §3-4.110 amending CFC §1205.2.1.1–1205.2.1.2 (setbacks), corroborated by the city's Inspection Guide citing CFC 605.11.3.2.1–605.11.3.2.4 / CRC R331.4.2.1–R331.4.2.4 for access pathways.
adopting ordinance / city bulletin checked 2026-08-30 https://www.redondo.org/Community%20Development/Building/BLDG%20DOCUMENTS/Handouts/SOLAR-RES%20ROOF%20LAYOUT%20GUIDELINES%202025%20-UPDATED.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Rapid shutdown (CEC 690.12) is not named explicitly in any Redondo Beach solar document reviewed, but is implicitly in force as part of whichever CEC edition applies (city's Inspection Guide cites the neighbouring CEC 690.11 arc-fault and 690.13–690.15/690.35 disconnect provisions but does not spell out 690.12 by name or edition).
Why the confidence is not higherCity's Inspection Guide for PV Systems (Sections 1–2) enumerates CEC 690-series items but does not use the term 'rapid shutdown' or cite §690.12 specifically.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
WARNING: ELECTRIC SHOCK HAZARD (ground-fault, on inverter/battery enclosure, CEC 690.5(C)); WARNING: ELECTRIC SHOCK HAZARD — ungrounded DC conductors (CEC 690.35(F)); DC disconnect location marking (CEC 690.14(C)(1)); PHOTOVOLTAIC SYSTEM DISCONNECT (CEC 690.14(C)(2)); DC disconnect ratings placard (CEC 690.53); AC output/voltage placard at point of interconnection (CEC 690.54); service/PV disconnect directory (CEC 690.56(B)/705.10); shock-hazard/energized-terminals placard on DC disconnects (CEC 690.17); inverter-output-OCPD warning (CEC 705.12(D)(7)); and a red-background/white-letter 'WARNING: PHOTOVOLTAIC POWER SOURCE' placard on conduits/raceways/enclosures (CFC 605.11.1.4/CEC 690.31(E)(3)-(4)/CRC R331.2.4).
Why the confidence is not higherCity's Inspection Guide for PV Systems, 'Table 1 - Signage Requirements for PV Systems', with full code citations.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes
Why the confidence is not higherInspection Guide Table 1 gives verbatim required wording for every placard type (e.g. 'WARNING: PHOTOVOLTAIC POWER SOURCE').
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Yes — the CFC 605.11.1.1/605.11.1.2 placard must have 3/8-inch (9.5mm) minimum white letters on a red background, made of reflective, weather-resistant material.
Why the confidence is not higherInspection Guide, Table 1 and accompanying text.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes — a directory/placard at the electrical service (and at the PV inverter if in a different location) showing the location of the service disconnecting means and the PV system disconnecting means, per CEC 690.56(B)/690.14(D)(4) and NEC 705.10.
Why the confidence is not higherInspection Guide, Table 1, row for CEC 690.56(B)/690.14(D)(4), 705.10.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedLooked for a Southern California Edison Distributed Generation / interconnection handbook specifying placards beyond the AHJ's own requirements. SCE's DG manual and 'Index of Communities' pages are gated behind a login.microsoftonline.com OAuth prompt (SharePoint), and no Redondo Beach city document references utility-specific placard requirements distinct from the CEC/CFC placards already documented in Q38-40.
Q43 Where must the labels be placed? Core Labels Signage & labelling
Adjacent to the main service disconnect (visible from where the disconnect is operated); on all interior/exterior DC conduit, enclosures, raceways, cable assemblies, junction/combiner boxes and disconnects; and repeated every 10 feet, within 1 foot of turns/bends, and within 1 foot above/below roof or wall penetrations.
Why the confidence is not higherInspection Guide for PV Systems, Signs and Labels section (items 63–66), citing CFC 605.11.1.1–605.11.1.4 and CEC 690.31(E)(3)-(4).
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Yes (functionally) — PV modules must be listed to UL 1703 (AC modules also UL 1741), combiner boxes listed to UL 1741, inverters listed to UL 1741 and marked 'utility interactive', and all connectors/terminals/disconnects must be listed for their application; equipment must match the approved plans.
Why the confidence is not higherInspection Guide for PV Systems, General and Electrical Requirements sections, multiple CEC 110.3/690.4 citations.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, with conditions — ESS is permitted only in detached garages/detached accessory structures, or outdoors/on exterior walls at least 3ft from doors/windows entering the dwelling unit; ESS may NOT be installed in any structure attached to the dwelling unit. Individual ESS units are capped at 20kWh; aggregate rating is capped at 80kWh (in detached garages/accessory structures, on exterior walls, or outdoors on the ground). Installations exceeding those caps must comply with the full, non-amended CFC §§1207.1–1207.9.
Why the confidence is not higherOrdinance No. 3247-22, RBMC §3-4.110 amending CFC §§1207.11.3–1207.11.4, quoted verbatim in the city's solar/ESS bulletin.
adopting ordinance / city bulletin checked 2026-08-30 https://www.redondo.org/Community%20Development/Building/BLDG%20DOCUMENTS/Handouts/SOLAR-RES%20ROOF%20LAYOUT%20GUIDELINES%202025%20-UPDATED.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Functionally yes — the Eligibility Checklist for the expedited/Standard-Plan residential PV path explicitly requires the system to be 'without battery storage'; any system with an ESS is automatically routed out of that fast-track review and into the standard/full plan-review process, and is separately governed by the Ordinance No. 3247-22 ESS location/rating rules. This is a functional separate review track rather than a distinct 'permit type' in the fee schedule (no separate ESS fee line item was found).
Why the confidence is not higherEligibility Checklist for Expedited Solar Photovoltaic Permitting, 'General Requirements' item D; cross-checked against the FY26-27 Master Fee Schedule, which has no distinct ESS/battery fee line.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/solar%20checklist%20pdf.pdf
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedChecked the Solar Photovoltaic Permits page, Eligibility Checklist, Structural Criteria form, and Inspection Guide — all four documents are scoped explicitly to ROOF-mounted residential PV (the Eligibility Checklist requires 'roof-mounted on one- or two-family dwelling or accessory structure' to qualify for the expedited path) and none state whether a ground-mount array is treated as an accessory structure under the Building/Zoning Code. Zero hits for 'ground mount' or 'ground-mount' across the full corpus of city solar documents (positive control 'electrical' = 47 hits, fabricated control 'zzqqx' = 0 hits, confirming the search itself works). The Zoning/Building Code chapter that would answer this sits on ecode360.com and could not be retrieved.
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedLooked for an SCE Rule 21 / DG interconnection manual specifying AC disconnect placement relative to the meter. SCE's relevant pages redirect to a gated SharePoint/OAuth login (login.microsoftonline.com) and returned 404/offline on direct and Wayback Machine attempts; no Redondo Beach city document specifies disconnect-to-meter placement beyond the general CEC 230.70/690.13-15 citations already captured in Q33-34.
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal 90% · authority permit page
- How much notice is required? Approximately 1 business day 85% · authority permit page
- Are same-day or AM/PM windows offered? No 85% · authority FAQ
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 95% · authority department page
- If delegated, to whom? N/A — not delegated 90% · authority department page
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? Primarily a single, comprehensive final electrical/solar inspection covering structural mounting, roof penetrations, conductor/conduit routing, grounding/bonding, equipment listing, labeling and access pathways — the city's Inspection Guide is structured as one 'Field Inspection Guide' rather than describing sequential rough-in/final stages. 80% · authority checklist
- Is a rough-in or mid-roof inspection required? No 65% · authority checklist (absence)
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes 95% · authority checklist
- What must be on site at inspection? The city-issued permit (and, for SolarAPP+ projects, the SolarAPP+-generated inspection checklist/approval documents) must be on site; approved plans are implicitly required per standard practice since the inspector verifies work 'according to the approved plan' throughout the Inspection Guide. 85% · authority permit page
- Does the inspector verify labels and listings? Yes 95% · authority checklist
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (permit finaled/closed in the iWorQ portal) 55% · authority permit page (inference)
- Is there a re-inspection fee? $174.00 flat 70% · fee schedule
14 questions answered against City of Redondo Beach’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal
Why the confidence is not higherSolarAPP+ page: inspections are requested via the iWorQ Citizen Portal's 'Projects' → 'Request Inspection' button.
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solarapp.php
Q50 How much notice is required? Core Booking & scheduling
Approximately 1 business day
Why the confidence is not higherSolar Photovoltaic Permits page: 'Inspection scheduled before 3:00 p.m. are typically inspected next business day.'
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solar_photovoltaic_permits.php
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
No
Why the confidence is not higherBuilding & Safety FAQ: 'Inspectors leave for the field at 8:30am. There are no AM or PM inspection requests taken.'
authority FAQ checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/faqs.php
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherRedondo Beach operates its own in-house Building & Safety Division and its own 3-station Fire Department (with its own Fire Prevention Bureau); confirmed NOT on LA County DPW's 16-city contract list and NOT on LA County Fire's contract-city list.
authority department page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/index.php
Q53 If delegated, to whom? Core Who inspects
N/A — not delegated
Why the confidence is not higherSame evidence as Q52; Redondo Beach performs its own final building/electrical/fire inspections in-house.
authority department page checked 2026-08-30 https://www.redondo.org/departments/fire_department/about_the_department.php
Q54 Which inspections are required, and in what order? Core Stages & sequence
Primarily a single, comprehensive final electrical/solar inspection covering structural mounting, roof penetrations, conductor/conduit routing, grounding/bonding, equipment listing, labeling and access pathways — the city's Inspection Guide is structured as one 'Field Inspection Guide' rather than describing sequential rough-in/final stages.
Why the confidence is not higherCity's Inspection Guide for PV Systems, Section 1 ('Field Inspection Guide... single-page reminder of the most important items in a field inspection').
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherThe city's own Inspection Guide for PV Systems — a comprehensive, itemized reference — describes only a single final field inspection and does not reference a rough-in or mid-roof-mount inspection stage.
authority checklist (absence) checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q56 Does the inspector verify labels and listings? Core What is checked
Yes
Why the confidence is not higherInspection Guide items require verification of module make/model/quantity against approved plans, equipment listed/labeled per plan, and all PV markings/labels/signs per Table 1.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q57 Is there a published inspection checklist? Core What is checked
Yes
Why the confidence is not higherCity publishes 'Solar_InspectionChecklist_7.pdf' (Inspection Guide for PV Systems) as a standalone document on the Solar Photovoltaic Permits and Forms pages.
authority checklist checked 2026-08-30 https://www.redondo.org/Community%20Development/Documents/Community%20Development/Building%20And%20Safety/Forms%2C%20Applications%2C%20Reports%2C%20And%20Handouts/Forms%20%26%20Handouts/Solar_InspectionChecklist_7.pdf
Q58 What must be on site at inspection? Core Documents on site
The city-issued permit (and, for SolarAPP+ projects, the SolarAPP+-generated inspection checklist/approval documents) must be on site; approved plans are implicitly required per standard practice since the inspector verifies work 'according to the approved plan' throughout the Inspection Guide.
Why the confidence is not higherSolarAPP+ page: 'Contractors must have the inspection checklist from SolarAPP+ as well as the City-issued permit on site for inspections.' Inspection Guide repeatedly references conformance to 'the approved plan.'
authority permit page checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/solarapp.php
Q59 Is there a re-inspection fee? Corrections & re-inspection
$174.00 flat
Why the confidence is not higherFY26-27 Master Fee Schedule, general Building Division fee line: 'Reinspection, Building, Flat Rate, $174.00.' This line item is listed under the Building category in the schedule rather than a solar-specific or Electrical-specific line, so it may be a department-wide (not solar-only) figure.
fee schedule checked 2026-08-30 https://cms2.revize.com/revize/redondobeachca/Financial%20Services/Documents/Financial%20Services/Master%20Fee%20Schedule/FY26-27%20CD%20Master%20Fee%20Schedule-FINAL.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Nothing published by this authority.
Where we lookedChecked the Solar Photovoltaic Permits page, SolarAPP+ page, FAQ, and Inspection Guide for a description of how field corrections are issued and cleared. None describe a correction-notice process (e.g., correction card, portal resubmission workflow) for a failed inspection.
Q61 What is issued on pass? Core Final sign-off & PTO
Final (permit finaled/closed in the iWorQ portal)
Why the confidence is not higherNo document explicitly names what document/tag is issued for a passed residential solar inspection; inferred from iWorQ portal language describing permits as 'issued'/'finaled' and the absence of any Certificate-of-Occupancy language for an equipment-only electrical permit on an existing dwelling.
authority permit page (inference) checked 2026-08-30 https://www.redondo.org/departments/community_development/building_and_safety/index.php
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedChecked the Solar Photovoltaic Permits page, SolarAPP+ page, Construction Project Resource Guide, and Eligibility Checklist for who is responsible for notifying SCE to grant Permission to Operate. None address this. SCE's own NEM/PTO process pages are gated (login.microsoftonline.com SharePoint) or 404, and the Internet Archive capture attempted was temporarily offline at check time.
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Redondo Beach against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Redondo Beach is the authority having jurisdiction 90% confidence
- Holds
- Building, Electrical, and Fire (Fire Prevention Bureau plan check/inspection) — all performed in-house by the City's Community Development Department (Building & Safety Division, Planning Division) and its own 3-station Fire Department. Confirmed NOT an LA County DPW 'contract city' (absent from dpw.lacounty.gov's 16-city list) and NOT an LA County Fire District contract city (absent from fire.lacounty.gov/contracting/). No private plan-check vendor (Willdan/Interwest/CSG/Bureau Veritas/4Leaf/Esgil/Charles Abbott) found referenced anywhere in the city's solar or fee-schedule documents.
- Overridden by
- California state law sets floors the city cannot go below: Gov. Code §65850.52 (SB 379) mandates expedited/streamlined residential solar permitting, implemented locally as RBMC Title 9, Chapter 14 ('Expedited, Streamlined Permitting Process for Small Residential Rooftop Solar Systems', §§9-14.01-9-14.06, confirmed to exist via the eCode360 table of contents though the chapter text itself could not be retrieved); AB 130 (Stats. 2025, Ch. 22) froze any MORE-restrictive local residential-code amendment from 1 Oct 2025 to 1 Jun 2031, which caps how far the city's own Ordinance No. 3247-22 ESS/setback amendments (effective 1 Jan 2025, so predate and survive the freeze) can be extended; and CA Civil Code §714/§4600 (Solar Rights Act) preempts any HOA/CC&R restriction on solar, consistent with the absence of any HOA-approval step in the city's own process.
- Why not higher
- City's own Building & Safety Division, Fire Department, and Planning Division pages, plus the fee schedule and solar-specific bulletins, are internally consistent that the City performs all building/electrical/fire review and inspection itself; corroborated by absence from both relevant LA County contract-city lists.
https://www.redondo.org/departments/community_development/building_and_safety/index.php
Check the code edition before you build
This authority's published code edition does not match what the state has adopted. That usually means the authority's ordinance has not been updated for the current cycle — but a local amendment can also be lawful. Confirm with the building department before you submit.
- Permit required
- Yes98%
- Permit cost
- $362.00 flat (Electrical permit, 'Solar-Photovoltaic - Residential'), per the FY26-27 Community Development Master Fee Schedule effective 15 Aug 2026 (Resolution CC-2606-044).90%
- Plan review
- SolarAPP+ path: instant permit issuance once fees are paid and documents uploaded. Manual/standard plan-review path: no published turnaround time found.55%
- Portal
- iWorQ ('Citizen Portal') — https://redondobeachca.portal.iworq.net/portalhome/redondobeachca — launched 31 Mar 2025 for all Planning/Building applications, replacing the prior system.90%
- Electrical code
- 2023 NEC via the 2025 California Electrical Code (per the city's current 'Building Ordinances and Codes' page referencing 'the 2025 California Building Codes,60%
- Own placard wording
- Yes95%
- Booking an inspection
- Portal90%
Labels & placards for this authority
City of Redondo Beach writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 95%
Yes
Size, colour & material 95%
Yes — the CFC 605.11.1.1/605.11.1.2 placard must have 3/8-inch (9.5mm) minimum white letters on a red background, made of reflective, weather-resistant material.
Where they go 95%
Adjacent to the main service disconnect (visible from where the disconnect is operated); on all interior/exterior DC conduit, enclosures, raceways, cable assemblies, junction/combiner boxes and disconnects; and repeated every 10 feet, within 1 foot of turns/bends, and within 1 foot above/below roof or wall penetrations.
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
