City of Reedley
Fresno County
City of Reedley is a city authority in the State of California, serving 25,227 residents. 2,789 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 1-3 business days for permits not eligible for over-the-counter approval; over-the-counter/same-day approval is available for applications using the Standard… Q18 Where you file — iWorQ -- 'https://reedley.portal.iworq.net/portalhome/reedley' for building-permit applications; Q20
- Permit required
- Yes92% source
- What it costs
- For a qualifying residential PV system <=10kW: Administrative Fee $40.00 (flat) + Plan Check Fee - Photovoltaic Residential <10kW $50.00 (flat) + Electrical Fee - Photovoltaic $200.00 (flat) +…92% source
- Plan review turnaround
- 1-3 business days for permits not eligible for over-the-counter approval; over-the-counter/same-day approval is available for applications using the Standard Electrical Plan80% source
- Key document
- inference from published bulletin + state law cited by 13 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 90% · department page
- What does this authority permit itself, and what does it delegate? Both 88% · municipal code (TOC, live)
- Is a permit required for a residential rooftop PV system? Yes 92% · published bulletin
- Is there a separate electrical permit, or is it combined? Combined 78% · published bulletin
- Is a HOA or architectural approval required first? No 62% · inference from published bulletin + state law
- Is a wind or windstorm certification required? No windstorm-certification requirement apparently exists beyond the standard (unamended) CBC/ASCE wind design -- not mentioned anywhere in the city's own Solar Bulletin, building-permit overview, or fee schedule 50% · inference
- Is a Specific Use Permit or Council approval ever required? No -- the city's own Solar Bulletin states plainly: 'Planning review is not required for solar PV installations of this size' (<=10kW). Larger/non-qualifying systems are not addressed by this bulletin and may require standard plan review, but a CUP/SUP/Council step is not indicated for typical residential systems. 85% · published bulletin
- Is there a system-size cap on residential generation? 10 kW AC is a gate, not an absolute cap -- the city's Solar Bulletin is explicitly scoped to 'Solar Photovoltaic Installations 10 kW or Less' for the streamlined/expedited pathway, and states 'Systems larger than 10 kw are subject to additional fees where applicable', and the current Master Fee Schedule prices a distinct 'Photovoltaic - Residential Only - Greater than 10 kw' plan-check line ($100) rather than barring larger systems 90% · published bulletin
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Must the contractor be registered with this authority before applying? Yes 70% · department page
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Per the city's own Solar Bulletin: a completed building permit application; demonstrated compliance with an 'eligibility checklist for expedited permitting'; a completed 'Standard Electrical Plan' (or, if not used, a full electrical plan showing disconnect locations, module/string counts, inverter/combiner data, one-line diagram, grounding/bonding and conductor sizing, battery locations/venting if applicable, equipment cut sheets, and CEC 690/705 labeling); a roof plan showing panel layout, roof access point, code-compliant access pathways, PV fire classification and label locations; and either a completed expedited 'Structural Criteria' (qualifying systems) or full stamped structural drawings/calculations from a CA-licensed civil or structural engineer (non-qualifying systems). 90% · published bulletin
- How many copies, and in what format? Electronic only -- one set of building plans uploaded through the city's iWorQ portal; no hard copies required, plans are reviewed and stamped electronically 85% · department page
- Is a site plan required, and what must it show? Yes -- a site diagram showing the arrangement of panels on the roof or ground, north arrow, lot dimensions, and the distance from property lines to adjacent existing/proposed buildings and structures 90% · published bulletin
- Is a one-line / three-line diagram required? Yes 90% · published bulletin
- Are string and conductor calculations required? Partially -- the bulletin requires conductor type/size, grounding/bonding, and the number of modules per string and total strings to be shown, but never uses the phrase 'electrical calculations' the way some neighboring cities' checklists do 65% · published bulletin
- Is a structural PE stamp required, and at what threshold? For qualifying systems (<=10kW, standard mounting), a completed expedited 'Structural Criteria' self-certification substitutes for a stamp. 'For non-qualifying systems, provide structural drawings and calculations stamped and signed by a California-licensed civil or structural engineer', with required detail on roof covering, framing, panel weight/attachment, and any structural reinforcement. 88% · published bulletin
- Is an electrical PE stamp required, and at what threshold? No separate electrical PE-stamp threshold found -- the bulletin's submittal requirements address a structural PE stamp explicitly (for non-qualifying systems) but never mention an electrical engineer's stamp at any size, consistent with the self-certified 'Standard Electrical Plan' model used for qualifying systems 58% · published bulletin
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? iWorQ -- 'https://reedley.portal.iworq.net/portalhome/reedley' for building-permit applications; a separate citizen-request instance also exists at 'reedleycitizenrequest.portal.iworq.net' 90% · portal landing page
- Can the whole application be completed online? Yes 85% · department page
- What does a residential solar permit cost? For a qualifying residential PV system <=10kW: Administrative Fee $40.00 (flat) + Plan Check Fee - Photovoltaic Residential <10kW $50.00 (flat) + Electrical Fee - Photovoltaic $200.00 (flat) + General Plan Zoning & Building Maintenance Fee (Valuation x $0.0011) + CBSC SB1473 State Mandated Fee ($4.00 per $100,000 valuation, min $1.00) + Strong-Motion (Seismic) State Mandated Fee, Residential (Valuation x 0.00013). For a $25,000 system this totals approximately $322. Systems >10kW use a $100.00 Plan Check Fee - Photovoltaic instead of $50.00, 'subject to additional fees where applicable'. 92% · fee schedule
- How is the fee calculated? Tiered / mixed -- several flat per-permit line items ($40 admin, $200 electrical-PV, $50 or $100 plan-check-PV depending on size) plus several separate valuation-based state-mandated and city fee lines (General Plan/Zoning fee, SB1473, Strong-Motion) that apply on top 82% · fee schedule
- Is there a separate plan-check fee? Yes -- 'Plan Check Fee - Photovoltaic - Residential Only - Less than 10 kw' ($50.00) and '...Greater than 10 kw' ($100.00) are distinct line items from the Electrical Permit Fee ($200.00) and the Administrative Fee ($40.00) 92% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 1-3 business days for permits not eligible for over-the-counter approval; over-the-counter/same-day approval is available for applications using the Standard Electrical Plan 80% · published bulletin
- How long is an issued permit valid before it expires? Not stated for solar specifically; inferred at the standard unamended CBC/CRC Sec. 105.5 180-day-without-progress expiration, since the Master Fee Schedule carries a 'Permit Extension Fee ($75.00)' consistent with that model and no local amendment to Sec. 105.5 could be confirmed (RMC 9-1-2 'Amendments' text could not be retrieved -- amlegal blocked after initial TOC access) 55% · fee schedule (inference)
- Which utility handles interconnection here? Pacific Gas and Electric Company (PG&E) 90% · city General Plan
- Where does the utility sit in the sequence? After permit for installation purposes; utility PTO is separately gated on the city's final inspection -- PG&E's own Rule 21 tariff (Sec. D.13.b) processes NEM PTO upon receipt of, among other things, 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction' 60% · utility tariff
28 questions answered against City of Reedley’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity's own Community Development / Building Division pages describe an in-house Building Division that issues building permits and performs inspections; the city's own Fire Department page confirms a separate self-performed municipal fire department; see jurisdiction block for full evidence.
department page checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherBuilding and Electrical are both administered in-house by the Community Development Department's Building Division (RMC Title 9, Ch.1 'Building Codes', confirmed live on American Legal at docid 0-0-0-5684, sections 9-1-1 Adoption of Codes through 9-1-6). No @willdan.com/@esgil.com/@transtech-style contract-firm branding found on the portal, phone extensions, or address -- all point to the city's own Building Division at 1733 9th Street. Fire is a separate, self-performing municipal Fire Department, not delegated to Fresno County Fire Protection District.
municipal code (TOC, live) checked 2026-08-31 https://codelibrary.amlegal.com/codes/reedleyca/latest/reedley_ca/0-0-0-5684
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherThe city's own 'Solar Photovoltaic Installations 10 kW or Less Submittal Requirements Bulletin' states 'The following permits are required to install a solar PV system... a) BUILDING PERMIT', and the codified RMC 9-1-5 is titled 'Small Residential Rooftop Solar Energy System Review Process' -- both presuppose a mandatory permit.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe city's own Solar Bulletin lists exactly one required permit type for a qualifying PV system -- 'a) BUILDING PERMIT' (singular) -- with an 'Electrical Fee - Photovoltaic $200' charged as a fee LINE within that single process rather than a separate electrical-permit application; the current Master Fee Schedule's Electrical Permit Fees section lists 'Photovoltaic $200.00' alongside a distinct 'Plan Check Fee - Photovoltaic' line, consistent with one combined solar permit. This is narrower than the general rule stated on the city's own Building Permits Overview page ('Separate construction permits are required for building, electrical, plumbing, and mechanical work'), which appears to describe ordinary construction rather than the solar-specific pathway. Reported both; the solar-specific bulletin is treated as controlling for this question.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Nothing published by this authority.
Where we lookedRMC 9-1-4 'LICENSED CONTRACTORS' is confirmed to exist by section title (Title 9, Ch.1 TOC, American Legal docid 0-0-0-5684) but its body text could not be retrieved -- amlegal.com's Cloudflare challenge cleared once early in this run (yielding the TOC) then began returning 403/521/522/timeout to every subsequent request including a plain overview-page control, for the rest of the session. The Solar Bulletin and building-permit pages do not separately restrict who may pull the electrical portion.
https://codelibrary.amlegal.com/codes/reedleyca/latest/reedley_ca/0-0-0-5684
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherCity's own Business License page states 'A City Business License must be obtained prior to doing any business inside the city limits' under a heading 'All Contractors or Home-Based Businesses Inside the City Limits', directing contractors to submit the application to the Building Division. Not stated as an explicit building-permit-application prerequisite in so many words (inferred, as with the comparable Sanger finding).
department page checked 2026-08-31 https://reedley.ca.gov/administrative-finance-services/business-license/
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Nothing published by this authority.
Where we lookedBuilding Permits Overview, Applying, and Obligations pages (community-development-department/building-division/building-permits/*) and the Solar Bulletin -- none contains an owner-builder / self-install-and-self-permit statement one way or the other; RMC 9-1-4 'Licensed Contractors', which would likely address this, could not be retrieved (amlegal blocked after initial access).
https://reedley.ca.gov/community-development-department/building-division/building-permits/overview/
Q8 What documents make up a complete submittal? Core Submittal package
Per the city's own Solar Bulletin: a completed building permit application; demonstrated compliance with an 'eligibility checklist for expedited permitting'; a completed 'Standard Electrical Plan' (or, if not used, a full electrical plan showing disconnect locations, module/string counts, inverter/combiner data, one-line diagram, grounding/bonding and conductor sizing, battery locations/venting if applicable, equipment cut sheets, and CEC 690/705 labeling); a roof plan showing panel layout, roof access point, code-compliant access pathways, PV fire classification and label locations; and either a completed expedited 'Structural Criteria' (qualifying systems) or full stamped structural drawings/calculations from a CA-licensed civil or structural engineer (non-qualifying systems).
Why the confidence is not higherDirectly enumerated, item by item, in the city's own Solar Photovoltaic Installations Submittal Requirements Bulletin. The referenced eligibility-checklist, Standard Electrical Plan and Structural Criteria documents themselves are linked from the Building Division page but could not be independently retrieved this run (WP Download Manager pagination not fully crawled by Wayback).
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q9 How many copies, and in what format? Submittal package
Electronic only -- one set of building plans uploaded through the city's iWorQ portal; no hard copies required, plans are reviewed and stamped electronically
Why the confidence is not higherBuilding Permits 'Applying' page: 'Your completed plans should be submitted online at https://reedley.portal.iworq.net/portalhome/reedley ... No hard copies of plans are needed as they will be reviewed and stamped electronically. Please upload 1 set of building plans...'. The Solar Bulletin corroborates electronic submittal through the same portal for over-the-counter approval.
department page checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/building-permits/applying/
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes -- a site diagram showing the arrangement of panels on the roof or ground, north arrow, lot dimensions, and the distance from property lines to adjacent existing/proposed buildings and structures
Why the confidence is not higherQuoted directly from the Solar Bulletin's electrical-plan submittal item; the roof plan requirement separately calls for roof access point, pathway and fire-classification information.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherSolar Bulletin, standard-electrical-plan alternative requirements, explicitly lists 'One-line diagram of system' as a required item.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Partially -- the bulletin requires conductor type/size, grounding/bonding, and the number of modules per string and total strings to be shown, but never uses the phrase 'electrical calculations' the way some neighboring cities' checklists do
Why the confidence is not higherDirectly compared against the bulletin's itemized electrical-plan list; it requires component specification (conductor type/size, module/string counts) rather than explicitly-labeled load or voltage-drop calculations.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
For qualifying systems (<=10kW, standard mounting), a completed expedited 'Structural Criteria' self-certification substitutes for a stamp. 'For non-qualifying systems, provide structural drawings and calculations stamped and signed by a California-licensed civil or structural engineer', with required detail on roof covering, framing, panel weight/attachment, and any structural reinforcement.
Why the confidence is not higherQuoted essentially verbatim from the Solar Bulletin's structural-criteria section -- the threshold is 'non-qualifying' rather than a stated square-footage or weight figure.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
No separate electrical PE-stamp threshold found -- the bulletin's submittal requirements address a structural PE stamp explicitly (for non-qualifying systems) but never mention an electrical engineer's stamp at any size, consistent with the self-certified 'Standard Electrical Plan' model used for qualifying systems
Why the confidence is not higherInference from a comprehensive document that is explicit about the one professional-stamp requirement it does impose (structural) and silent on an electrical one throughout its entire electrical-plan section.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q15 What does a residential solar permit cost? Core Fees
For a qualifying residential PV system <=10kW: Administrative Fee $40.00 (flat) + Plan Check Fee - Photovoltaic Residential <10kW $50.00 (flat) + Electrical Fee - Photovoltaic $200.00 (flat) + General Plan Zoning & Building Maintenance Fee (Valuation x $0.0011) + CBSC SB1473 State Mandated Fee ($4.00 per $100,000 valuation, min $1.00) + Strong-Motion (Seismic) State Mandated Fee, Residential (Valuation x 0.00013). For a $25,000 system this totals approximately $322. Systems >10kW use a $100.00 Plan Check Fee - Photovoltaic instead of $50.00, 'subject to additional fees where applicable'.
Why the confidence is not higherCurrent (FY2024-25, fees effective 1 Jul 2024, last revised by Resolution 2024-036/2024-050) Citywide Master Fee Schedule, Community Development Department Building Fees and Electrical Permit Fees sections, read directly with pdftotext. Supersedes the older $29 admin / $40 plan-check figures still printed in the city's undated Solar Bulletin -- the current adopted schedule is used here.
fee schedule checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2024/07/Citywide_Master_Fee_Schedule_2024-25-1721402772.pdf
Q16 How is the fee calculated? Core Fees
Tiered / mixed -- several flat per-permit line items ($40 admin, $200 electrical-PV, $50 or $100 plan-check-PV depending on size) plus several separate valuation-based state-mandated and city fee lines (General Plan/Zoning fee, SB1473, Strong-Motion) that apply on top
Why the confidence is not higherRead directly from the current Master Fee Schedule; no single 'Flat' or 'Valuation' choice cleanly describes it, so 'Tiered' is used as the closest fit to a schedule combining both bases.
fee schedule checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2024/07/Citywide_Master_Fee_Schedule_2024-25-1721402772.pdf
Q17 Is there a separate plan-check fee? Fees
Yes -- 'Plan Check Fee - Photovoltaic - Residential Only - Less than 10 kw' ($50.00) and '...Greater than 10 kw' ($100.00) are distinct line items from the Electrical Permit Fee ($200.00) and the Administrative Fee ($40.00)
Why the confidence is not higherCurrent Master Fee Schedule, Plan Check Fees section.
fee schedule checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2024/07/Citywide_Master_Fee_Schedule_2024-25-1721402772.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
1-3 business days for permits not eligible for over-the-counter approval; over-the-counter/same-day approval is available for applications using the Standard Electrical Plan
Why the confidence is not higherCity's own Solar Bulletin, Plan Review section: 'Permits not approved "over the counter" should be reviewed in 1-3 business days.' The bulletin's fee figures are dated/superseded (see Q15) which is why this process-timing statement is not scored higher, though nothing else found contradicts it.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q19 How long is an issued permit valid before it expires? Timeline & validity
Not stated for solar specifically; inferred at the standard unamended CBC/CRC Sec. 105.5 180-day-without-progress expiration, since the Master Fee Schedule carries a 'Permit Extension Fee ($75.00)' consistent with that model and no local amendment to Sec. 105.5 could be confirmed (RMC 9-1-2 'Amendments' text could not be retrieved -- amlegal blocked after initial TOC access)
Why the confidence is not higherInference from the existence of a priced 'Permit Extension Fee' in the current fee schedule plus the statewide default; the actual local-amendment text (RMC 9-1-2) was not retrievable this run.
fee schedule (inference) checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2024/07/Citywide_Master_Fee_Schedule_2024-25-1721402772.pdf
Q20 Which permit portal does this authority use? Core Portal & process
iWorQ -- 'https://reedley.portal.iworq.net/portalhome/reedley' for building-permit applications; a separate citizen-request instance also exists at 'reedleycitizenrequest.portal.iworq.net'
Why the confidence is not higherBoth URLs are linked directly from the Building Division page and the Building Permits 'Applying' page, and are named as the electronic submittal channel in the city's own Solar Bulletin.
portal landing page checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higher'Applying' page states plans are submitted online with 'No hard copies of plans are needed as they will be reviewed and stamped electronically'; the Solar Bulletin states applications 'may also be submitted electronically for "over the counter" approval' through the same iWorQ portal.
department page checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/building-permits/applying/
Q22 Which utility handles interconnection here? Core Utility interconnection
Pacific Gas and Electric Company (PG&E)
Why the confidence is not higherConfirmed from two of the city's own sources: (1) the adopted General Plan 2030's Utilities section states 'Pacific Gas and Electrical Company is the major supplier of electricity' (natural gas is separately attributed to Southern California Gas Co.); (2) the city's own Utilities page states the Administrative Services Department 'handles billing and payment collection for water, sewer and trash services' only -- no electricity -- confirming Reedley itself is not a municipal electric utility, consistent with PG&E serving power. The brief's PG&E field is therefore confirmed, not overturned.
city General Plan checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/2019/12/Reedley-General-Plan-2030-Adopted-February-18-2014-1.pdf
Q23 Where does the utility sit in the sequence? Core Utility interconnection
After permit for installation purposes; utility PTO is separately gated on the city's final inspection -- PG&E's own Rule 21 tariff (Sec. D.13.b) processes NEM PTO upon receipt of, among other things, 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction'
Why the confidence is not higherThis is PG&E's statewide Rule 21 tariff provision, not a Reedley-specific document; no Reedley-side statement of the utility sequence was found on the city's own pages.
utility tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherNo HOA/architectural-approval step appears anywhere in the city's own Solar Bulletin approval-requirements section (which lists only the Building Permit for qualifying systems); California's Solar Rights Act (Civil Code Sec. 714) independently bars HOAs from unreasonably restricting solar installations statewide. Not a direct city-document statement, so scored as inference.
inference from published bulletin + state law checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q25 Is there a historic-district review? Overlays & special cases
Nothing published by this authority.
Where we lookedAttempted the city's own Title 10 Zoning Code (linked as a standalone PDF from the Community Development Library page, wpdmdl=20477) both live (403, Cloudflare) and via Wayback (no independent capture of the underlying file exists -- only the linking HTML page was archived); also attempted the Public Review Draft (RZCU) rewrite PDF via Wayback, which returned a genuine 404 for the exact captured redirect target. No historic-district determination could be made.
https://reedley.ca.gov/community-development-department/community-development-library/
Q26 Is a wind or windstorm certification required? Overlays & special cases
No windstorm-certification requirement apparently exists beyond the standard (unamended) CBC/ASCE wind design -- not mentioned anywhere in the city's own Solar Bulletin, building-permit overview, or fee schedule
Why the confidence is not higherInference from three of the city's own documents being silent on wind/windstorm certification, combined with the pattern found in multiple other San Joaquin/Central Valley cities in this survey (Palm Springs, Desert Hot Springs) having no such requirement; the full zoning/building code could not be searched directly (Cloudflare-blocked), so this is not a control-proven absence.
inference checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
No -- the city's own Solar Bulletin states plainly: 'Planning review is not required for solar PV installations of this size' (<=10kW). Larger/non-qualifying systems are not addressed by this bulletin and may require standard plan review, but a CUP/SUP/Council step is not indicated for typical residential systems.
Why the confidence is not higherDirect quote from the Solar Bulletin's Approval Requirements section.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC is a gate, not an absolute cap -- the city's Solar Bulletin is explicitly scoped to 'Solar Photovoltaic Installations 10 kW or Less' for the streamlined/expedited pathway, and states 'Systems larger than 10 kw are subject to additional fees where applicable', and the current Master Fee Schedule prices a distinct 'Photovoltaic - Residential Only - Greater than 10 kw' plan-check line ($100) rather than barring larger systems
Why the confidence is not higherSynthesized directly from the Solar Bulletin's title/scope statement and the Master Fee Schedule's two-tier PV plan-check fee.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2020 (via the 2022 California Electrical Code) 78% · adopting ordinance / department page
- Which building code edition is in force? 2022 California Building Code (and 2022 California Residential-equivalent housing/dangerous-buildings/plumbing/mechanical/pool codes) 80% · department page
- Are there local amendments to any of the above? Yes 75% · municipal code (TOC, live)
- What is the installation judged against? The 2022 CBC (and companion 2022 CRC/plumbing/mechanical/pool codes) for structural/building, the 2022 CEC (2020 NEC) for electrical, plus the city's own codified small-residential-rooftop-solar review process at RMC 9-1-5 for the solar-specific administrative pathway 75% · synthesis of city documents
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Roof access point, code-compliant access pathways, and PV fire classification must be shown on the roof plan; the bulletin points applicants to the (statewide, unamended) State Fire Marshal Solar PV Installation Guide for example pathway configurations rather than stating a Reedley-specific ridge-setback figure of its own 68% · published bulletin
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Required as a matter of the adopted 2020 NEC/2022 CEC Sec. 690.12 (module-level rapid shutdown), but the city's own Solar Submittal Requirements Bulletin never uses the words 'rapid shutdown' or cites Sec. 690.12 anywhere -- its electrical-plan checklist requires disconnect locations and 'Labeling of equipment as required by CEC, Sections 690 and 705' only in generic terms 70% · published bulletin (control-checked absence)
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Three signs verified at final inspection per the city's own Solar Bulletin: a sign identifying the PV power source system attributes at the DC disconnect; a sign identifying the AC point of connection; and a sign identifying the switch for the alternative power system 82% · published bulletin
- Does the authority specify placard wording of its own? No specific wording is prescribed by the city -- the bulletin describes what each sign must identify (PV source at DC disconnect, AC point of connection, alternative-power switch) but does not give verbatim required text the way e.g. Sanger's or Hollister's ordinances do 70% · published bulletin
- Does it specify letter height, colour or material? Not specified -- no letter height, colour, or material requirement is stated anywhere in the city's own Solar Bulletin or fee schedule 62% · published bulletin (absence)
- Does the UTILITY specify placards beyond the AHJ's? Not confirmed as Reedley-specific; PG&E's own statewide Rule 21 tariff requires a visible interconnection disconnect with open/closed position markings, lockable and reachable, shown on the single-line diagram (Sec. H.1.d 'Visible Disconnect Required') 55% · utility tariff
- Where must the labels be placed? At the DC disconnect and at the AC point of connection, per the city's own inspection checklist; no more precise physical placement (e.g., distance from the meter) is stated 65% · published bulletin
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? No city-maintained approved-equipment list -- the submittal instead requires 'Equipment cut sheets including inverters, modules, AC and DC disconnects, combiners and wind generators' for city review, with no reference to a city or state approved-products list 72% · published bulletin
- Are batteries permitted, and under what conditions? Yes, batteries are permitted as part of a PV submittal -- the bulletin's only stated condition is documentation: 'If batteries are to be installed, include them in the diagram and show their locations and venting.' No capacity cap, fire-rated-room, or separation requirement is stated in this document. 75% · published bulletin
- Is there a separate ESS permit or inspection? No -- batteries appear to be folded into the single solar Building Permit process (shown on the same diagram, same submittal) rather than requiring their own separate ESS permit or inspection 62% · published bulletin (inference)
- Is a specific mounting system or attachment spacing required? No prescriptive citywide spacing figure found -- the Solar Bulletin requires the submittal to show 'quantity and spacing of structural attachments' with manufacturer spec sheets and a completed 'Structural Criteria' checklist for city review on a project-specific basis, rather than the city imposing a fixed number 65% · published bulletin
20 questions answered against City of Reedley’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2020 (via the 2022 California Electrical Code)
Why the confidence is not higherThe city's own Building Permits Overview page confirms the '2022 California Electrical Code' is adopted; the underlying NEC edition (2020) is not stated on that page but is the fixed statewide mapping for the 2022 CBSC/Title 24 cycle. The Overview page was captured ~March 2025, before the 1 Jan 2026 statewide 2025-cycle (2023 NEC) effective date, so a newer local re-adoption may exist that was not checked this run.
adopting ordinance / department page checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/building-permits/overview/
Q30 Which building code edition is in force? Core Code editions in force
2022 California Building Code (and 2022 California Residential-equivalent housing/dangerous-buildings/plumbing/mechanical/pool codes)
Why the confidence is not higherBuilding Permits Overview page lists the codes the building permit is 'based on': '2022 California Building Code, 2022 California Housing Code, 2022 California Code for Abatement of Dangerous Buildings, 2022 California Plumbing Code, 2022 California Mechanical Code, 2022 California Electrical Code, 2022 California Swimming Pool Spa and Hot Tub Code.' This page was captured ~March 2025, before the 1 Jan 2026 statewide 2025-cycle effective date, so confidence is docked for the possibility of an intervening local re-adoption not captured this run.
department page checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/building-permits/overview/
Q31 Which fire code edition is in force? Code editions in force
Nothing published by this authority.
Where we lookedThe Building Permits Overview page's list of 'Codes' the building permit is based on (2022 CBC, Housing Code, Dangerous Buildings Code, Plumbing, Mechanical, Electrical, Pool/Spa Code) conspicuously does not include a Fire Code at all; RMC's fire-code adoption section would be expected in Title 5 (Police and Public Safety) but that Title's chapter list could not be retrieved -- amlegal.com's Cloudflare challenge cleared once early in this run and then blocked every subsequent request including a plain control fetch of the code overview page.
https://codelibrary.amlegal.com/codes/reedleyca/latest/overview
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherRMC Title 9, Chapter 1 ('Building Codes') is confirmed, from its own live table of contents, to contain a section '9-1-2: AMENDMENTS' and a dedicated local ordinance '9-1-5: SMALL RESIDENTIAL ROOFTOP SOLAR ENERGY SYSTEM REVIEW PROCESS' -- itself a local amendment/addition beyond the base adopted model codes. The full text of either section could not be retrieved this run (amlegal blocked after the initial TOC fetch), so this is confirmed by section title only, not full content.
municipal code (TOC, live) checked 2026-08-31 https://codelibrary.amlegal.com/codes/reedleyca/latest/reedley_ca/0-0-0-5684
Q33 What is the installation judged against? Core Electrical
The 2022 CBC (and companion 2022 CRC/plumbing/mechanical/pool codes) for structural/building, the 2022 CEC (2020 NEC) for electrical, plus the city's own codified small-residential-rooftop-solar review process at RMC 9-1-5 for the solar-specific administrative pathway
Why the confidence is not higherSynthesized from the Building Permits Overview page's code list (Q30) and the confirmed existence of RMC 9-1-5 (Q32); the fire-code component of this composite could not be identified (see Q31 not_found).
synthesis of city documents checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/building-permits/overview/
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedRMC 9-1-2 'AMENDMENTS' (Title 9, Ch.1) is the section that would carry any local busbar/service-upgrade rule but its text could not be retrieved (amlegal blocked); the Solar Bulletin and current Master Fee Schedule are both silent on any busbar-sizing or service-upgrade-specific rule.
https://codelibrary.amlegal.com/codes/reedleyca/latest/reedley_ca/0-0-0-5684
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
No prescriptive citywide spacing figure found -- the Solar Bulletin requires the submittal to show 'quantity and spacing of structural attachments' with manufacturer spec sheets and a completed 'Structural Criteria' checklist for city review on a project-specific basis, rather than the city imposing a fixed number
Why the confidence is not higherSolar Bulletin structural-plan item; the referenced 'Structural Criteria' document itself (which might set a number) could not be independently retrieved this run.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Roof access point, code-compliant access pathways, and PV fire classification must be shown on the roof plan; the bulletin points applicants to the (statewide, unamended) State Fire Marshal Solar PV Installation Guide for example pathway configurations rather than stating a Reedley-specific ridge-setback figure of its own
Why the confidence is not higherSolar Bulletin roof-plan item, which cites 'http://osfm.fire.ca.gov/pdf/reports/solarphotovoltaicguideline.pdf' by name as the source of pathway examples -- no Reedley-specific numeric setback was found in this or any other city document reviewed.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Required as a matter of the adopted 2020 NEC/2022 CEC Sec. 690.12 (module-level rapid shutdown), but the city's own Solar Submittal Requirements Bulletin never uses the words 'rapid shutdown' or cites Sec. 690.12 anywhere -- its electrical-plan checklist requires disconnect locations and 'Labeling of equipment as required by CEC, Sections 690 and 705' only in generic terms
Why the confidence is not higherGrepped the bulletin's full extracted text for 'rapid' and '690.12' (zero hits) and for '690' generically (one hit, the generic 690/705 labeling clause) and for the fabricated control 'zzqqx' (zero hits, confirming the search worked) -- a genuine, control-proven absence of rapid-shutdown-specific language in the city's own guidance, though the underlying NEC requirement applies regardless of whether the bulletin names it.
published bulletin (control-checked absence) checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Three signs verified at final inspection per the city's own Solar Bulletin: a sign identifying the PV power source system attributes at the DC disconnect; a sign identifying the AC point of connection; and a sign identifying the switch for the alternative power system
Why the confidence is not higherDirectly quoted from the Solar Bulletin's Inspections section (common inspection checklist items).
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No specific wording is prescribed by the city -- the bulletin describes what each sign must identify (PV source at DC disconnect, AC point of connection, alternative-power switch) but does not give verbatim required text the way e.g. Sanger's or Hollister's ordinances do
Why the confidence is not higherSolar Bulletin inspection-checklist wording is descriptive/functional rather than a verbatim placard script.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Not specified -- no letter height, colour, or material requirement is stated anywhere in the city's own Solar Bulletin or fee schedule
Why the confidence is not higherChecked the Solar Bulletin's full text (which does address signage requirements substantively in the inspection section) and found no dimensional/material spec; the codified fire chapter that might otherwise carry one could not be retrieved (amlegal blocked).
published bulletin (absence) checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSolar Bulletin's roof-plan and site-diagram requirements were checked in full; neither distinctly requires a facility/site-map placard of the Sec. 705.10 kind (as opposed to the site diagram submitted for plan review). RMC 9-1-5 and Title 5 fire provisions, which might address this, could not be retrieved.
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Not confirmed as Reedley-specific; PG&E's own statewide Rule 21 tariff requires a visible interconnection disconnect with open/closed position markings, lockable and reachable, shown on the single-line diagram (Sec. H.1.d 'Visible Disconnect Required')
Why the confidence is not higherThis is PG&E's generic statewide tariff text, not a Reedley-specific document; no Reedley-side utility handout addressing placards was found.
utility tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
At the DC disconnect and at the AC point of connection, per the city's own inspection checklist; no more precise physical placement (e.g., distance from the meter) is stated
Why the confidence is not higherSolar Bulletin inspection-checklist language names these two locations only.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
No city-maintained approved-equipment list -- the submittal instead requires 'Equipment cut sheets including inverters, modules, AC and DC disconnects, combiners and wind generators' for city review, with no reference to a city or state approved-products list
Why the confidence is not higherSolar Bulletin electrical-plan item; consistent with the CEC-listing model rather than a jurisdiction-maintained list.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, batteries are permitted as part of a PV submittal -- the bulletin's only stated condition is documentation: 'If batteries are to be installed, include them in the diagram and show their locations and venting.' No capacity cap, fire-rated-room, or separation requirement is stated in this document.
Why the confidence is not higherDirect quote from the Solar Bulletin's electrical-plan requirements; the codified fire chapter that might add further conditions could not be retrieved (amlegal blocked).
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
No -- batteries appear to be folded into the single solar Building Permit process (shown on the same diagram, same submittal) rather than requiring their own separate ESS permit or inspection
Why the confidence is not higherInferred from the Solar Bulletin's phrasing, which treats battery documentation as one more diagram element within the single PV submittal rather than describing a separate application, fee line, or inspection step; no distinct ESS fee line exists in the current Master Fee Schedule either (checked; none found).
published bulletin (inference) checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedReedley's Title 10 Zoning Code (the source that would define 'Structure' and any ground-mount-specific rule) could not be retrieved live (403, Cloudflare) or via Wayback (only the linking HTML page was archived, not the underlying PDF, for either the adopted code or the 2024 Public Review Draft rewrite). The city's own January-2025 'Residential Setbacks' brochure lists allowed setback projections (cornices, eaves, decks, chimneys, planter boxes, AC units, EV charging equipment) with no mention of ground-mounted solar either way -- suggestive but not conclusive.
https://reedley.ca.gov/community-development-department/community-development-library/
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedSolar Bulletin requires 'Locations of main service or utility disconnect' to be shown on the electrical plan but states no specific distance/location rule relative to the meter; PG&E's general Rule 21 tariff was checked and, consistent with the playbook's prior finding for other PG&E-territory cities, contains no meter-proximity specification (the more detailed Greenbook document is access-gated to PG&E job owners).
https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone 90% · department handout
- How much notice is required? 1-2 business days advance notice recommended ('leave a voice mail 1 or 2 days prior to your inspections'); the Solar Bulletin separately states inspection requests received within business hours are scheduled for the next business day 85% · department handout
- Are same-day or AM/PM windows offered? Some time-slot system exists -- the Inspection Request handout asks the caller to provide 'Date of Inspection AND preferred time slot' -- but no AM/PM window structure is spelled out in any document found 60% · department handout
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 85% · published bulletin
- If delegated, to whom? N/A -- not delegated; the city's in-house Building Division performs the final solar inspection (see Q52) 85% · published bulletin
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? Submit application/plans (portal or in person) -> plan review (over-the-counter or 1-3 business days) -> permit issuance -> installation -> final on-site inspection before 'final approval is granted for the solar system' 72% · published bulletin
- Is a rough-in or mid-roof inspection required? No -- the Solar Bulletin describes only a single final inspection ('it must be inspected before final approval is granted') with no separate rough-in or mid-roof stage called out 65% · published bulletin
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes 88% · published bulletin
- What must be on site at inspection? Inspection Card, approved set of plans/forms, the permit itself, a ladder, and the work must be readily accessible (someone on site if needed) 88% · department handout
- Does the inspector verify labels and listings? Yes 82% · published bulletin
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (a final inspection approval) -- the Solar Bulletin frames the outcome as the system being 'inspected before final approval is granted for the solar system' rather than describing a Certificate of Occupancy, which the general building-permit pages associate only with new construction/occupancy changes 68% · published bulletin
- Who notifies the utility for PTO? Installer 55% · inference
- Is there a re-inspection fee? $95.00 flat ('Re-Inspection (applicable to all permits issued) / per occurrence') 88% · fee schedule
- How are corrections issued and cleared? Not documented specifically for solar; the general building-permit 'Obligations' page describes the standard process -- if the inspector finds non-conforming work, 'he will advise you and may send you a notice asking that the situation be remedied. Another inspection may be required before you resume work.' 55% · department page
14 questions answered against City of Reedley’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone
Why the confidence is not higherBoth the city's own 'Building Division Inspection Request' handout ('Inspection number: (559) 637-4200 ext. 112 ... Please leave a voice mail') and the Solar Bulletin ('On-site inspections can be scheduled by contacting the Building Division by telephone at (559)637-4200 ext. 112') agree on phone/voicemail as the booking method.
department handout checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2019/12/Building-Division-Inspection-Request-Procedure.pdf
Q50 How much notice is required? Core Booking & scheduling
1-2 business days advance notice recommended ('leave a voice mail 1 or 2 days prior to your inspections'); the Solar Bulletin separately states inspection requests received within business hours are scheduled for the next business day
Why the confidence is not higherQuoted from the city's own Inspection Request handout, corroborated by the Solar Bulletin's next-business-day scheduling statement.
department handout checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2019/12/Building-Division-Inspection-Request-Procedure.pdf
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Some time-slot system exists -- the Inspection Request handout asks the caller to provide 'Date of Inspection AND preferred time slot' -- but no AM/PM window structure is spelled out in any document found
Why the confidence is not higherInferred from the phrase 'preferred time slot' in the city's own handout; no explicit AM/PM cutoff times (unlike Sanger's 8:00-11:59/12:00-3:30 windows) were found for Reedley.
department handout checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2019/12/Building-Division-Inspection-Request-Procedure.pdf
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherSolar Bulletin: 'Once all permits to construct the solar installation have been issued and the system has been installed, it must be inspected before final approval is granted... On-site inspections can be scheduled by contacting the Building Division'; no delegation to any outside inspection firm is indicated anywhere in the city's own materials.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q53 If delegated, to whom? Core Who inspects
N/A -- not delegated; the city's in-house Building Division performs the final solar inspection (see Q52)
Why the confidence is not higherSame evidence as Q52.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q54 Which inspections are required, and in what order? Core Stages & sequence
Submit application/plans (portal or in person) -> plan review (over-the-counter or 1-3 business days) -> permit issuance -> installation -> final on-site inspection before 'final approval is granted for the solar system'
Why the confidence is not higherSynthesized from the Solar Bulletin's own 'Plan Review' and 'Inspections' sections; a distinct rough-in stage is not described for solar specifically.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No -- the Solar Bulletin describes only a single final inspection ('it must be inspected before final approval is granted') with no separate rough-in or mid-roof stage called out
Why the confidence is not higherFollows from the single-inspection framing in the Solar Bulletin's Inspections section.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q56 Does the inspector verify labels and listings? Core What is checked
Yes
Why the confidence is not higherThe Solar Bulletin's own inspection checklist explicitly includes 'Appropriate signs are properly constructed, installed and displayed' and 'Equipment ratings are consistent with application and installed signs on the installation' as points the inspector checks.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q57 Is there a published inspection checklist? Core What is checked
Yes
Why the confidence is not higherThe Solar Bulletin itself contains a published inspection checklist ('The inspection checklist provides an overview of common points of inspection that the applicant should be prepared to show compliance...') with itemized points covering module/model match, grounding, conductor sizing, and signage.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q58 What must be on site at inspection? Core Documents on site
Inspection Card, approved set of plans/forms, the permit itself, a ladder, and the work must be readily accessible (someone on site if needed)
Why the confidence is not higherQuoted directly from the city's own 'Building Division Inspection Request' handout's 'Items required to be on site for inspection' list.
department handout checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2019/12/Building-Division-Inspection-Request-Procedure.pdf
Q59 Is there a re-inspection fee? Corrections & re-inspection
$95.00 flat ('Re-Inspection (applicable to all permits issued) / per occurrence')
Why the confidence is not higherCurrent (FY2024-25) Master Fee Schedule, Community Development Department Building Fees Continued section; stated as applicable to all permits issued, which includes solar. (The Fire Department's own, separate re-inspection fee is $52.00 and applies to fire-specific inspections, not solar.)
fee schedule checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/2024/07/Citywide_Master_Fee_Schedule_2024-25-1721402772.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Not documented specifically for solar; the general building-permit 'Obligations' page describes the standard process -- if the inspector finds non-conforming work, 'he will advise you and may send you a notice asking that the situation be remedied. Another inspection may be required before you resume work.'
Why the confidence is not higherGeneral building-code-enforcement language from the Obligations page, not a solar-specific corrections procedure; no dedicated correction-notice form or process was found for PV.
department page checked 2026-08-31 https://reedley.ca.gov/community-development-department/building-division/building-permits/obligations/
Q61 What is issued on pass? Core Final sign-off & PTO
Final (a final inspection approval) -- the Solar Bulletin frames the outcome as the system being 'inspected before final approval is granted for the solar system' rather than describing a Certificate of Occupancy, which the general building-permit pages associate only with new construction/occupancy changes
Why the confidence is not higherSolar Bulletin's own phrase; cross-checked against the Building Permits Overview page, which discusses Certificates of Occupancy only in the context of new construction, not retrofits like PV.
published bulletin checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer
Why the confidence is not higherNot stated in a Reedley-specific document retrieved this run (RMC 9-1-5, which almost certainly carries this exact provision given the near-universal statewide model-ordinance language for AB 2188-style small-residential-solar sections, could not be retrieved -- amlegal blocked). Scored as inference from the comparable Sanger ordinance's identical section title and from standard California NEM practice, where the installer/applicant obtains utility interconnection approval independently of the city's permit sign-off.
inference checked 2026-08-31 https://reedley.ca.gov/wp-content/uploads/reedleyweb/download-manager-files/Solar%20Submittal%20Requirements%20Bulletin.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Reedley against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Reedley is the authority having jurisdiction 85% confidence
- Holds
- Building and Electrical, in-house Community Development Department Building Division (RMC Title 9, Ch.1, sections 9-1-1 through 9-1-6, confirmed live on American Legal); Fire is a separate, self-performing municipal Fire Department (own address at 1060 D St, own Fire Chief, not delegated to Fresno County Fire Protection District) whose own current Master Fee Schedule Fire Department section carries no PV/ESS line at all, and whose approval the city's own Solar Bulletin says is 'not required for solar PV installations of this size' (<=10kW)
- Overridden by
- California Solar Rights Act (Civil Code Sec. 714) and Gov. Code Sec. 65850.5 et seq. govern the administrative/expedited review pathway codified at RMC 9-1-5 'Small Residential Rooftop Solar Energy System Review Process'; no contract plan-check or inspection firm was found anywhere in the city's contact information, portal domain, phone extensions, or address -- everything points to city-owned infrastructure (reedley.ca.gov, reedley.portal.iworq.net, (559)637-4200 city extensions, 1733 9th Street)
- Why not higher
- City's own Community Development / Building Division pages and Solar Bulletin describe an in-house Building Division that issues permits and inspects in-house; the Fire Department page confirms an independent municipal department; the Administrative Services 'Utilities' page confirms the city itself bills only water/sewer/trash (not electricity), ruling out a municipal electric utility and confirming PG&E as the outside wires utility (see Q22). Unlike the comparable Sanger run, no single named 'Building Official' was found in any page retrieved this run -- the in-house conclusion rests on contact-point ownership (portal subdomain, phone extensions, address) rather than a named official, and is flagged as such rather than claimed as airtight as Sanger's.
https://reedley.ca.gov/community-development-department/building-division/
Check the code edition before you build
This authority's published code edition does not match what the state has adopted. That usually means the authority's ordinance has not been updated for the current cycle — but a local amendment can also be lawful. Confirm with the building department before you submit.
- Permit required
- Yes92%
- Permit cost
- For a qualifying residential PV system <=10kW: Administrative Fee $40.00 (flat) + Plan Check Fee - Photovoltaic Residential <10kW $50.00 (flat) + Electrical Fee - Photovoltaic $200.00…92%
- Plan review
- 1-3 business days for permits not eligible for over-the-counter approval; over-the-counter/same-day approval is available for applications using the Standard Electrical Plan80%
- Portal

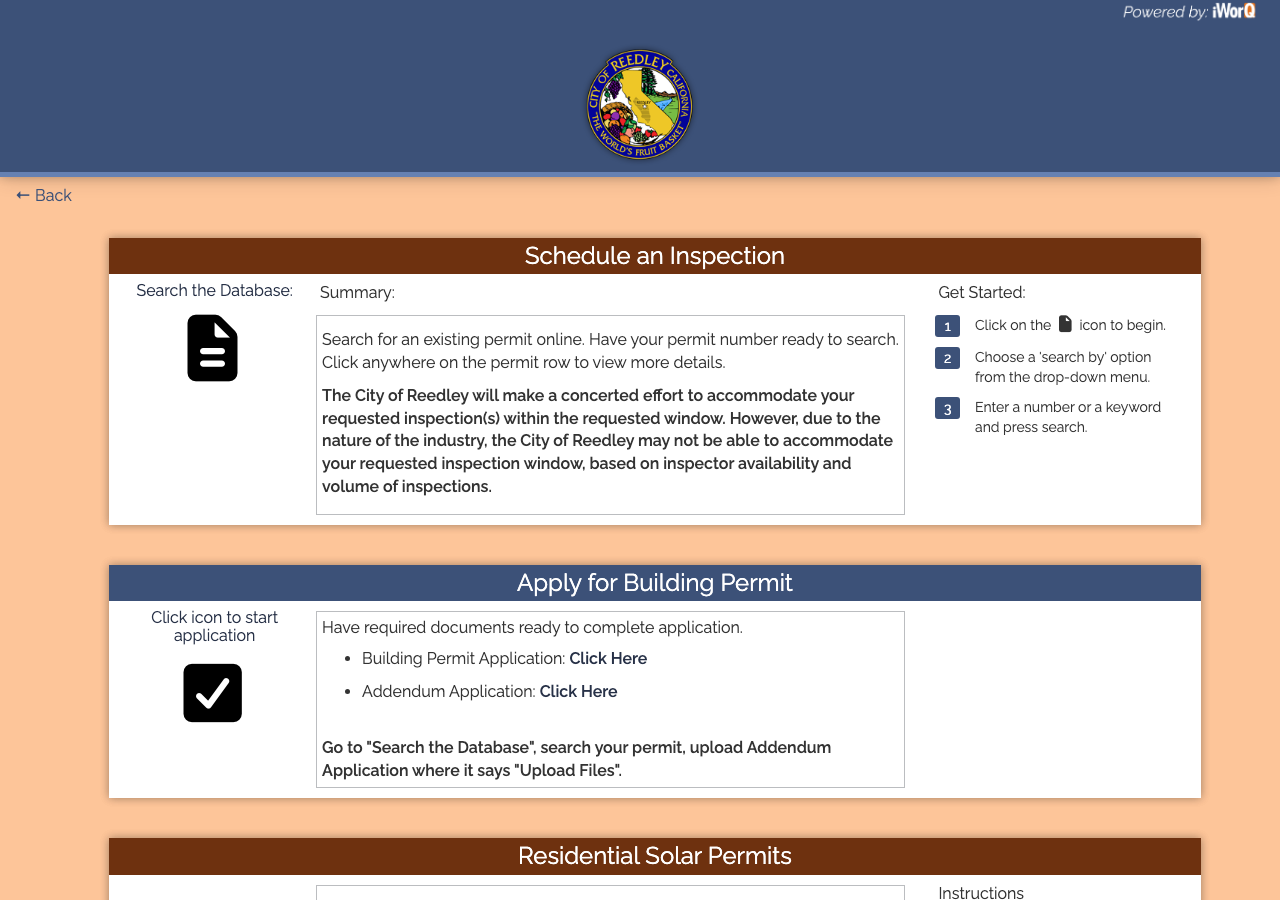

- iWorQ -- 'https://reedley.portal.iworq.net/portalhome/reedley' for building-permit applications; a separate citizen-request instance also exists at 'reedleycitizenrequest.portal.iworq.net'90%
- Electrical code
- 2020 (via the 2022 California Electrical Code)78%
- Own placard wording
- No specific wording is prescribed by the city -- the bulletin describes what each sign must identify (PV source at DC disconnect, AC point of connection,70%
- Booking an inspection
- Phone90%
Labels & placards for this authority
Wording 70%
No specific wording is prescribed by the city -- the bulletin describes what each sign must identify (PV source at DC disconnect, AC point of connection, alternative-power switch) but does not give verbatim required text the way e.g. Sanger's or Hollister's ordinances do
Size, colour & material 62%
Not specified -- no letter height, colour, or material requirement is stated anywhere in the city's own Solar Bulletin or fee schedule
Where they go 65%
At the DC disconnect and at the AC point of connection, per the city's own inspection checklist; no more precise physical placement (e.g., distance from the meter) is stated
What the utility wants on top 55%
Not confirmed as Reedley-specific; PG&E's own statewide Rule 21 tariff requires a visible interconnection disconnect with open/closed position markings, lockable and reachable, shown on the single-line diagram (Sec. H.1.d 'Visible Disconnect Required')
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
