City of San Bruno
San Mateo County
City of San Bruno is a city authority in the State of California, serving 43,908 residents. 1,125 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Same day (instant permit) for SolarAPP+-eligible over-the-counter applications, or 1-3 business days for electronic applications, Q18 Where you file — MGO Connect (MyGovernmentOnline), with SolarAPP+ (NREL) used as the front-end code-compliance/eligibility check that feeds an approval package into MGO Connect Q20
- Permit required
- Yes95% source
- What it costs
- $441 (PV only, up to 38kW AC, SFR/duplex); $641 (PV+ESS up to 38kW); $690 (PV+ESS+EV charger); $543 (ESS only);95% source
- Plan review turnaround
- Same day (instant permit) for SolarAPP+-eligible over-the-counter applications, or 1-3 business days for electronic applications, per the codified expedited-review ordinance;80% source
- Key document
- ordinance (absence) + platform inference cited by 5 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · authority's own page
- What does this authority permit itself, and what does it delegate? Both 90% · ordinance
- Is a permit required for a residential rooftop PV system? Yes 95% · ordinance
- Is there a separate electrical permit, or is it combined? Combined 85% · fee schedule
- Is a HOA or architectural approval required first? Generally No for conforming rooftop residential PV; architectural review is required only if the system would not conform to the applicable zoning district's structure regulations (e.g., a nonconforming ground-mount), in which case an architectural review permit is required and must be approved unless it poses a safety threat 80% · ordinance
- Is there a historic-district review? Not addressed specifically for solar in the zoning or building chapters reviewed; general architectural review under 12.84.110 could apply if a historic-district design guideline creates a conformance conflict, but no dedicated historic-district solar review provision was found 55% · ordinance
- Is a wind or windstorm certification required? No 65% · ordinance / authority's own document
- Is a Specific Use Permit or Council approval ever required? Yes, conditionally - a use permit can be required if the building official finds a solar installation could have a 'specific, adverse impact' on public health/safety; denial or approval decisions are appealable to the Planning Commission 90% · ordinance
- Is there a system-size cap on residential generation? No hard cap on residential system size; the codified ordinance (2015) defines 'small residential rooftop solar energy system' as <=10kW AC / 30kW thermal for streamlined-review purposes, but the city's current administrative practice (SolarAPP+) raises the expedited-review threshold to 38kW AC (PV, and PV+ESS); systems above 38kW AC, PV+EV combos, multi-family and commercial are simply routed to standard (non-expedited) review rather than being capped outright 80% · ordinance + authority's current page (conflict noted)
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 70% · authority's own document
- Must the contractor be registered with this authority before applying? No 55% · authority's own page
- Is a homeowner permitted to self-install and self-permit? Yes 80% · authority's own document
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? SolarAPP+ approval documents + approval number, plus the City's Expedited Solar / SolarAPP+ Permit application, submitted through MGO Connect; for non-SolarAPP+-eligible projects (>38kW AC, PV+EV combos, multi-family/commercial), standard building permit submittal applies per Building Permit Submittal Requirements 80% · authority's own page
- How many copies, and in what format? Electronic/digital only via MGO Connect (PDF, Adobe Acrobat 9.0-compatible); no paper copies accepted as of 1 Jul 2024 85% · authority's own document
- Is a site plan required, and what must it show? Yes - a plot plan is required and must show property lines, lot dimensions, all existing/proposed structures with dimensions to property lines, location of all mechanical/electrical/gas/water meters and equipment, driveways/paved areas, north arrow, and site hazard zones (flood/FHSZ/liquefaction/earthquake); aerial images (Google Maps etc.) are explicitly NOT acceptable 90% · published checklist
- Is a one-line / three-line diagram required? Yes 60% · inference from platform used
- Are string and conductor calculations required? Yes 60% · inference from platform used
- Is a structural PE stamp required, and at what threshold? Not specifically published for PV; general threshold is CBC/CRC Section 2308 - any design outside 'Conventional Light-Frame Construction' (trusses, roofs on posts extending >6 ft, non-conventional bracing, etc.) requires a CA-licensed architect/engineer stamp with 2 sets of stamped calculations 60% · authority's own document
- Is an electrical PE stamp required, and at what threshold? Not specifically published; no local ordinance sets an electrical-PE-stamp threshold for residential PV. SolarAPP+ performs an automated NEC code-compliance check without requiring a PE stamp for eligible (<=38kW AC) residential systems; a stamp would only be expected if a project is kicked out of SolarAPP+ to standard plan review, which is not separately documented for electrical (as opposed to structural) design. 50% · ordinance (absence) + platform inference
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? MGO Connect (MyGovernmentOnline), with SolarAPP+ (NREL) used as the front-end code-compliance/eligibility check that feeds an approval package into MGO Connect 90% · portal landing page
- Can the whole application be completed online? Yes 85% · portal landing page
- What does a residential solar permit cost? $441 (PV only, up to 38kW AC, SFR/duplex); $641 (PV+ESS up to 38kW); $690 (PV+ESS+EV charger); $543 (ESS only); non-SolarAPP+/multi-family/commercial PV or ESS billed hourly ($392-$645/hr, 2-2.25 hr minimum) 95% · published fee schedule
- How is the fee calculated? Tiered 90% · published fee schedule
- Is there a separate plan-check fee? No for SolarAPP+-eligible residential PV (plan review bundled into the flat Sec 225A-E fee); Yes for anything routed outside SolarAPP+, where 'Plan review will be hourly with a 2 hour minimum up front' per the fee schedule note 85% · published fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? Same day (instant permit) for SolarAPP+-eligible over-the-counter applications, or 1-3 business days for electronic applications, per the codified expedited-review ordinance; no separate published turnaround for standard (non-expedited) plan review was found 80% · ordinance
- How long is an issued permit valid before it expires? 6 months for permits valued not over $50,000 (nearly all residential PV/ESS jobs fall in this tier); 12 months for $50,001-$500,000; 18/24/36 months at higher valuation tiers; extensions of 6 months available for good cause 90% · authority's own document
- Which utility handles interconnection here? PG&E (Pacific Gas & Electric) 85% · city source + CCA's own board page
- Where does the utility sit in the sequence? Parallel/after permit - PG&E requires evidence of the AHJ's final electrical inspection clearance before granting Permission to Operate (interconnection approval is not a prerequisite to pulling the city permit, but PTO is gated on the city's final sign-off) 75% · utility tariff
28 questions answered against City of San Bruno’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity of San Bruno Community & Economic Development Dept, Building Division issues residential building and electrical permits for solar PV directly; Municipal Code ch. 11.36 codifies a city solar permitting program
authority's own page checked 2026-08-30 https://www.sanbruno.ca.gov/1116/Expedited-Solar-Permits
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherSBMC 11.16.010/.020 names the city building official as the AHJ enforcing the Electrical Code, and the Building Division issues the combined building+electrical permit; ESS installs also get one Fire Dept inspection (still a city department, not an outside delegate) per Master Fee Sched. Sec 225B-D
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherSBMC 11.36.020 applies to 'the permitting of all small residential rooftop solar energy systems'; fee schedule Sec 225A-E prices the residential solar permit
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherFee schedule Sec 225A-E prices one instant permit covering building+electrical for solar (2 inspections) rather than a separate electrical permit line; standalone Electrical Permit fee schedule (Sec 219-229) is a different, non-solar fee track
fee schedule checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherState-standard C-10/C-46 licensed electrician or licensed contractor normally pulls the permit; the city's Owner-Builder disclosure package confirms a property owner may also be responsible party of record instead of a licensed contractor
authority's own document checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/1242
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
No
Why the confidence is not higherOnline Permits page requires everyone (contractors and residents) to create an MGO Connect account as of 1 Jul 2024, but no separate city contractor license-registration/bonding step is described before applying, beyond SolarAPP+'s own contractor training/registration which is NREL's, not the city's
authority's own page checked 2026-08-30 https://www.sanbruno.ca.gov/1118/Online-Permits
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherCity's Owner-Builder Acknowledgment package (statewide CSLB-mandated form) is offered as an alternative to hiring a licensed contractor; nothing in SBMC ch. 11.36 or the solar page excludes owner-builders from small residential rooftop PV
authority's own document checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/1242
Q8 What documents make up a complete submittal? Core Submittal package
SolarAPP+ approval documents + approval number, plus the City's Expedited Solar / SolarAPP+ Permit application, submitted through MGO Connect; for non-SolarAPP+-eligible projects (>38kW AC, PV+EV combos, multi-family/commercial), standard building permit submittal applies per Building Permit Submittal Requirements
Why the confidence is not higherSolar page lists the exact steps: SolarAPP+ approval package + approval number + MGO Connect application; general submittal content (plot plan, elevations, structural info) comes from the Building Permit Submittal Requirements handout
authority's own page checked 2026-08-30 https://www.sanbruno.ca.gov/1116/Expedited-Solar-Permits
Q9 How many copies, and in what format? Submittal package
Electronic/digital only via MGO Connect (PDF, Adobe Acrobat 9.0-compatible); no paper copies accepted as of 1 Jul 2024
Why the confidence is not higherDigital Plan Requirements handout mandates PDF submittal with specific formatting; Apply for a Building Permit page confirms permit processing 'is done electronically' since 1 Jul 2024
authority's own document checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/9035
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes - a plot plan is required and must show property lines, lot dimensions, all existing/proposed structures with dimensions to property lines, location of all mechanical/electrical/gas/water meters and equipment, driveways/paved areas, north arrow, and site hazard zones (flood/FHSZ/liquefaction/earthquake); aerial images (Google Maps etc.) are explicitly NOT acceptable
Why the confidence is not higherResidential Plot Plan Checklist (2025 California Codes) lists these items verbatim
published checklist checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/9038
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherSolarAPP+ (the platform the city uses for expedited PV review per its own solar page) requires a one-line diagram as a standard input to its automated code-compliance check; the city's own PV-specific paper checklist is gated behind an MGO Connect login and could not be retrieved directly
inference from platform used checked 2026-08-30 https://www.sanbruno.ca.gov/1116/Expedited-Solar-Permits
Q12 Are string and conductor calculations required? Drawings & calculations
Yes
Why the confidence is not higherString/conductor sizing is a required input field in SolarAPP+'s automated review, which the city's solar page states it uses for code-compliance checking of residential PV up to 38kW
inference from platform used checked 2026-08-30 https://www.sanbruno.ca.gov/1116/Expedited-Solar-Permits
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Not specifically published for PV; general threshold is CBC/CRC Section 2308 - any design outside 'Conventional Light-Frame Construction' (trusses, roofs on posts extending >6 ft, non-conventional bracing, etc.) requires a CA-licensed architect/engineer stamp with 2 sets of stamped calculations
Why the confidence is not higherBuilding Permit Submittal Requirements handout states the Sec. 2308 threshold; it is not solar-specific and SolarAPP+'s prescriptive structural pathway can clear many roof-mount PV jobs without a stamp
authority's own document checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/1247
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Not specifically published; no local ordinance sets an electrical-PE-stamp threshold for residential PV. SolarAPP+ performs an automated NEC code-compliance check without requiring a PE stamp for eligible (<=38kW AC) residential systems; a stamp would only be expected if a project is kicked out of SolarAPP+ to standard plan review, which is not separately documented for electrical (as opposed to structural) design.
Why the confidence is not higherSearched SBMC 11.16 (Electrical Code chapter and its amendments) for a PE-stamp threshold and found none; inferring from the SolarAPP+ automated-review model described on the city solar page, which is a national NREL platform rather than a San Bruno-specific rule
ordinance (absence) + platform inference checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q15 What does a residential solar permit cost? Core Fees
$441 (PV only, up to 38kW AC, SFR/duplex); $641 (PV+ESS up to 38kW); $690 (PV+ESS+EV charger); $543 (ESS only); non-SolarAPP+/multi-family/commercial PV or ESS billed hourly ($392-$645/hr, 2-2.25 hr minimum)
Why the confidence is not higherFY2025-26 Master Fee Schedule Sec 225A-225D and Sec 226A-226D, effective 1 Jul 2025 per the Building Permit Fees page
published fee schedule checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q16 How is the fee calculated? Core Fees
Tiered
Why the confidence is not higherMaster Fee Schedule prices residential solar/ESS/EV combinations as flat tiered 'Instant Permit' amounts (Sec 225A-E) based on which components are installed, reverting to hourly for non-SolarAPP+, multi-family or commercial projects (Sec 226B-D)
published fee schedule checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q17 Is there a separate plan-check fee? Fees
No for SolarAPP+-eligible residential PV (plan review bundled into the flat Sec 225A-E fee); Yes for anything routed outside SolarAPP+, where 'Plan review will be hourly with a 2 hour minimum up front' per the fee schedule note
Why the confidence is not higherMaster Fee Schedule, note preceding Sec 225A: 'For solar system and ESS plans that do not go through SolarApp+ Plan review will be hourly with a 2 hour minimum'
published fee schedule checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Same day (instant permit) for SolarAPP+-eligible over-the-counter applications, or 1-3 business days for electronic applications, per the codified expedited-review ordinance; no separate published turnaround for standard (non-expedited) plan review was found
Why the confidence is not higherSBMC 11.36.060.A: city 'shall issue a building permit...the same day for over-the-counter applications or within one to three business days for electronic applications'; corroborated by fee schedule labeling Sec 225A-E as 'Instant Permit'
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q19 How long is an issued permit valid before it expires? Timeline & validity
6 months for permits valued not over $50,000 (nearly all residential PV/ESS jobs fall in this tier); 12 months for $50,001-$500,000; 18/24/36 months at higher valuation tiers; extensions of 6 months available for good cause
Why the confidence is not higherBuilding Permit Time Limits handout, table of estimated construction value vs. time limit
authority's own document checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/1250
Q20 Which permit portal does this authority use? Core Portal & process
MGO Connect (MyGovernmentOnline), with SolarAPP+ (NREL) used as the front-end code-compliance/eligibility check that feeds an approval package into MGO Connect
Why the confidence is not higherOnline Permits page names MGO Connect as the portal since 1 Jul 2024; Expedited Solar Permits page describes the SolarAPP+ -> MGO Connect application flow
portal landing page checked 2026-08-30 https://www.sanbruno.ca.gov/1118/Online-Permits
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higherOnline Permits page states the application, document submittal, plan review, payment, and permit issuance/download can all be completed through MGO Connect without a City Hall visit 'in the vast majority of cases'
portal landing page checked 2026-08-30 https://www.sanbruno.ca.gov/1118/Online-Permits
Q22 Which utility handles interconnection here? Core Utility interconnection
PG&E (Pacific Gas & Electric)
Why the confidence is not higherCity's own Utility Billing page confirms San Bruno bills only water and sewer (transitioned to San Mateo County tax roll) - no municipal electric utility exists; San Bruno is a member jurisdiction of WestLight Energy (formerly Peninsula Clean Energy), the CCA that supplies generation 'at rates below PG&E's,' confirming PG&E remains the underlying distribution/interconnecting utility
city source + CCA's own board page checked 2026-08-30 https://www.sanbruno.ca.gov/270/Utility-Billing
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel/after permit - PG&E requires evidence of the AHJ's final electrical inspection clearance before granting Permission to Operate (interconnection approval is not a prerequisite to pulling the city permit, but PTO is gated on the city's final sign-off)
Why the confidence is not higherPG&E Rule 21 tariff, Sec D.13.b: NEM Interconnection approval 'shall normally be processed...following...evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction'
utility tariff checked 2026-08-30 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
Generally No for conforming rooftop residential PV; architectural review is required only if the system would not conform to the applicable zoning district's structure regulations (e.g., a nonconforming ground-mount), in which case an architectural review permit is required and must be approved unless it poses a safety threat
Why the confidence is not higherSBMC 12.84.110 Solar energy systems
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44257773
Q25 Is there a historic-district review? Overlays & special cases
Not addressed specifically for solar in the zoning or building chapters reviewed; general architectural review under 12.84.110 could apply if a historic-district design guideline creates a conformance conflict, but no dedicated historic-district solar review provision was found
Why the confidence is not higherSearched SBMC Title 11 (Buildings) and Title 12.84 (solar/architectural review section) for 'historic' cross-references to solar; none found
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44257773
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherSBMC building/residential code chapters (11.04, 11.10) were searched for a wind or windstorm certification requirement; only the standard CBC/CRC engineered-design threshold (Sec 2308) appears, with no separate wind-certification requirement of the kind used in windstorm-designated states
ordinance / authority's own document checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/1247
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Yes, conditionally - a use permit can be required if the building official finds a solar installation could have a 'specific, adverse impact' on public health/safety; denial or approval decisions are appealable to the Planning Commission
Why the confidence is not higherSBMC 11.36.060.A and .C
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No hard cap on residential system size; the codified ordinance (2015) defines 'small residential rooftop solar energy system' as <=10kW AC / 30kW thermal for streamlined-review purposes, but the city's current administrative practice (SolarAPP+) raises the expedited-review threshold to 38kW AC (PV, and PV+ESS); systems above 38kW AC, PV+EV combos, multi-family and commercial are simply routed to standard (non-expedited) review rather than being capped outright
Why the confidence is not higherSBMC 11.36.030 (10kW/30kW definition, Ord. 1834, 2015) vs. Expedited Solar Permits page (current 38kW AC threshold) - the codified ordinance is stale and superseded in practice by the newer SolarAPP+ threshold
ordinance + authority's current page (conflict noted) checked 2026-08-30 https://www.sanbruno.ca.gov/1116/Expedited-Solar-Permits
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 90% · adopting ordinance + state adoption cycle
- Which building code edition is in force? 2025 California Building Code, Volumes 1 & 2, plus the 2025 California Historical Code and 1997 Uniform Housing Code 90% · adopting ordinance
- Which fire code edition is in force? 2025 California Fire Code (with Appendices B and D), based on the 2024 International Fire Code 90% · adopting ordinance
- Are there local amendments to any of the above? Yes 90% · ordinance
- What is the installation judged against? The 2025 California Electrical Code as locally amended (amendments concern appeals/enforcement authority only, not technical solar requirements), plus SBMC 11.36.040.C requiring conformance to CEC, IEEE, and accredited testing lab (e.g., UL) standards 85% · ordinance
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Not locally amended; searched the codified San Bruno Fire Code chapter (11.24) for ridge setback/access pathway language and found none specific to rooftop PV (only an unrelated PV-canopy sprinkler exception at Sec 903.2.8). Ridge setbacks/pathways therefore default to the unamended 2025 California Fire Code (based on 2024 IFC) Chapter 12 solar photovoltaic provisions, which are not reproduced in the municipal code 65% · ordinance (absence) + base CFC by reference
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Not locally addressed; searched Title 11 (Building, Electrical, Fire, Residential chapters) for 'rapid shutdown' and '690.12' with zero hits against working positive ('electrical'/'disconnect') and fabricated ('zzqqx') controls, so rapid shutdown is governed by the unamended 2025 CEC (based on 2023 NEC) Sec. 690.12, not a local amendment 75% · ordinance (absence) + NEC by reference
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? None specified locally beyond the standard NEC/CFC-required placards (e.g., NEC 690.56 rapid-shutdown label, 705.12 point-of-connection marking, main service disconnect labeling per CEC 110.21(B) referenced in the city's own Service Upgrades handout); no dedicated San Bruno PV placard requirement was found in Title 11 65% · ordinance (absence)
- Does the authority specify placard wording of its own? No 70% · ordinance (absence)
- Does it specify letter height, colour or material? Not specified 70% · ordinance (absence)
- Is a site plan / facility map placard required, and what must it show? Not locally specified beyond NEC Sec. 705.10 (which requires a permanent plaque/directory at each service disconnecting means location identifying all power sources); no San Bruno facility-map or site-plan placard requirement beyond the standard plot plan (showing meter/equipment locations, required at permit submittal) was found 60% · checklist (absence for field placard)
- Does the UTILITY specify placards beyond the AHJ's? Not confirmed from a San Bruno- or PG&E-specific document beyond the general Rule 21 requirement that interconnection equipment be lockable/accessible for utility disconnection; PG&E's detailed DG placard/AC-disconnect specification document (the 'Greenbook,' TD-7001M, which defers distributed-generation detail to the access-gated TD-2306M) could not be retrieved to confirm placard specifics 45% · utility tariff (partial)
- Where must the labels be placed? Not specified by the city; standard NEC labeling locations apply (at each service disconnect, at the PV disconnecting means, and at points of interconnection per NEC Art. 690/705), since no SBMC provision addresses label placement 55% · ordinance (absence) + NEC default
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes, in substance 75% · ordinance
- Are batteries permitted, and under what conditions? Yes - batteries/ESS are permitted and are explicitly covered by the city's SolarAPP+ expedited program for residential PV+ESS combinations up to 38kW AC; ESS-only permits are also available 90% · authority's own page + fee schedule
- Is there a separate ESS permit or inspection? Yes - ESS can be permitted standalone (Sec 225D, 'Residential ESS ONLY') or combined with solar (Sec 225B/C), and ESS installs require an additional Fire Department inspection beyond the standard building inspections 90% · published fee schedule
- Is a ground mount treated as a structure? Yes 75% · ordinance
- Is there a local rule on service upgrades or busbar sizing? No solar-specific local rule; general service-upgrade requirements (rigid service mast, 2 points of support, minimum mast height, surge protection, lug barriers, isolated main disconnects, listed/labeled service equipment, grounding electrode bonding) are published in the city's own Residential Electrical Service Upgrades and Grounding Electrode Systems handouts, based on the 2025 CEC 80% · authority's own document
- Is a specific mounting system or attachment spacing required? Not published specifically; searched Building Code (11.04) and Residential Code (11.10) chapters for a mounting-system or attachment-spacing amendment and found none - installations are judged against the unamended 2025 CBC/CRC and manufacturer engineering 55% · ordinance (absence)
20 questions answered against City of San Bruno’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023
Why the confidence is not higherState-mandated: the 2025 California Electrical Code (adopted by SBMC 11.16.010 via Ord. 1968, 11/12/2025) is based on the 2023 NEC; no local ordinance text names the NEC edition directly, so this is by CA statewide adoption cycle
adopting ordinance + state adoption cycle checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code, Volumes 1 & 2, plus the 2025 California Historical Code and 1997 Uniform Housing Code
Why the confidence is not higherSBMC 11.04.010, most recently amended by Ord. 1968 (11/12/2025)
adopting ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (with Appendices B and D), based on the 2024 International Fire Code
Why the confidence is not higherSBMC 11.24.010
adopting ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherSBMC 11.04.020 (Building), 11.16.020 (Electrical), 11.24.010.C (Fire, 2024 IFC modifications) and 11.10.020 (Residential) each carry local amendments; none of the amendments found are solar-specific (they cover airport noise insulation, appeals process, address identification, etc.)
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q33 What is the installation judged against? Core Electrical
The 2025 California Electrical Code as locally amended (amendments concern appeals/enforcement authority only, not technical solar requirements), plus SBMC 11.36.040.C requiring conformance to CEC, IEEE, and accredited testing lab (e.g., UL) standards
Why the confidence is not higherSBMC 11.16.010/.020 and 11.36.040
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No solar-specific local rule; general service-upgrade requirements (rigid service mast, 2 points of support, minimum mast height, surge protection, lug barriers, isolated main disconnects, listed/labeled service equipment, grounding electrode bonding) are published in the city's own Residential Electrical Service Upgrades and Grounding Electrode Systems handouts, based on the 2025 CEC
Why the confidence is not higher2025 California Electrical Code / Residential Electrical Service Upgrades handout; 2025 CEC Grounding Electrode Systems handout
authority's own document checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/9022
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Not published specifically; searched Building Code (11.04) and Residential Code (11.10) chapters for a mounting-system or attachment-spacing amendment and found none - installations are judged against the unamended 2025 CBC/CRC and manufacturer engineering
Why the confidence is not higherSearched SBMC 11.04.020 and 11.10.020 amendment lists; no mounting/attachment-spacing provision found
ordinance (absence) checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Not locally amended; searched the codified San Bruno Fire Code chapter (11.24) for ridge setback/access pathway language and found none specific to rooftop PV (only an unrelated PV-canopy sprinkler exception at Sec 903.2.8). Ridge setbacks/pathways therefore default to the unamended 2025 California Fire Code (based on 2024 IFC) Chapter 12 solar photovoltaic provisions, which are not reproduced in the municipal code
Why the confidence is not higherSBMC 11.24 (San Bruno Fire Code) full text searched for 'pathway', 'setback', 'ridge' with positive control 'sprinkler' present and fabricated control 'zzqqx' absent
ordinance (absence) + base CFC by reference checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Not locally addressed; searched Title 11 (Building, Electrical, Fire, Residential chapters) for 'rapid shutdown' and '690.12' with zero hits against working positive ('electrical'/'disconnect') and fabricated ('zzqqx') controls, so rapid shutdown is governed by the unamended 2025 CEC (based on 2023 NEC) Sec. 690.12, not a local amendment
Why the confidence is not higherCorpus search of SBMC Title 11 for 'rapid shutdown' and '690.12' - zero hits; positive controls 'electrical'/'disconnect' and negative control 'zzqqx' behaved correctly
ordinance (absence) + NEC by reference checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
None specified locally beyond the standard NEC/CFC-required placards (e.g., NEC 690.56 rapid-shutdown label, 705.12 point-of-connection marking, main service disconnect labeling per CEC 110.21(B) referenced in the city's own Service Upgrades handout); no dedicated San Bruno PV placard requirement was found in Title 11
Why the confidence is not higherSearched SBMC 11.36 (Solar), 11.16 (Electrical), 11.24 (Fire), and 11.32 (Placards - dangerous-buildings only) for placard/label text; only address-identification and dangerous-building placard provisions were found, none PV-specific
ordinance (absence) checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No
Why the confidence is not higherSBMC 11.36 (the city's own Small Solar System Permitting Program chapter) does not specify placard wording; searched full chapter text with no result
ordinance (absence) checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Not specified
Why the confidence is not higherSearched SBMC 11.36, 11.16, 11.24 for 'letter', 'height', 'color', 'material' in connection with placards/labels - only unrelated address-numbering height/illumination rules were found (SBMC 502.1.1 amendment: address numbers 6 inches high with 1/2 inch stroke), no PV placard color/letter-height spec
ordinance (absence) checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Not locally specified beyond NEC Sec. 705.10 (which requires a permanent plaque/directory at each service disconnecting means location identifying all power sources); no San Bruno facility-map or site-plan placard requirement beyond the standard plot plan (showing meter/equipment locations, required at permit submittal) was found
Why the confidence is not higherSearched SBMC Title 11 for a facility-map/placard requirement; Residential Plot Plan Checklist requires meter/equipment locations on the site plan but this is a submittal document, not a required field placard
checklist (absence for field placard) checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/9038
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Not confirmed from a San Bruno- or PG&E-specific document beyond the general Rule 21 requirement that interconnection equipment be lockable/accessible for utility disconnection; PG&E's detailed DG placard/AC-disconnect specification document (the 'Greenbook,' TD-7001M, which defers distributed-generation detail to the access-gated TD-2306M) could not be retrieved to confirm placard specifics
Why the confidence is not higherPG&E Electric Rule 21 tariff PDF (26MB) searched for 'placard'/'label'/'disconnect switch' - found only a generic reference to a utility-accessible disconnect switch, no placard wording/format spec; TD-2306M is gated per PG&E ('see your Job Owner for access')
utility tariff (partial) checked 2026-08-30 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
Not specified by the city; standard NEC labeling locations apply (at each service disconnect, at the PV disconnecting means, and at points of interconnection per NEC Art. 690/705), since no SBMC provision addresses label placement
Why the confidence is not higherSearched SBMC Title 11 for label-placement language; none found beyond address-number placement rules
ordinance (absence) + NEC default checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q44 Must equipment be on a specific approved list? Equipment listing
Yes, in substance
Why the confidence is not higherSBMC 11.36.040.C requires PV systems to meet CEC/IEEE standards and testing by 'accredited testing laboratories such as Underwriters Laboratories' - i.e., equipment must be UL-listed/CEC-compliant, though the city does not maintain its own separate approved-equipment list
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes - batteries/ESS are permitted and are explicitly covered by the city's SolarAPP+ expedited program for residential PV+ESS combinations up to 38kW AC; ESS-only permits are also available
Why the confidence is not higherExpedited Solar Permits page ('photovoltaic up to 38kW projects which also include an Energy Storage System (ESS)'); Master Fee Schedule Sec 225B-D prices PV+ESS and ESS-only permits
authority's own page + fee schedule checked 2026-08-30 https://www.sanbruno.ca.gov/1116/Expedited-Solar-Permits
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Yes - ESS can be permitted standalone (Sec 225D, 'Residential ESS ONLY') or combined with solar (Sec 225B/C), and ESS installs require an additional Fire Department inspection beyond the standard building inspections
Why the confidence is not higherMaster Fee Schedule Sec 225B, 225C, 225D each note 'one Fire Department inspection' in addition to building inspections
published fee schedule checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q47 Is a ground mount treated as a structure? Core Ground mount
Yes
Why the confidence is not higherSBMC 12.84 defines an 'alternative energy structure' as 'a structure or installation such as a windmill, solar collecting array, or geothermal system'; Sec 12.84.110 subjects nonconforming solar installations to the district's structure regulations (setbacks, etc.), confirming ground-mounted PV is treated as a structure
ordinance checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44257773
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedSearched PG&E Electric Rule 21 tariff (26MB PDF) for 'AC disconnect' placement relative to the meter; found only a generic reference to a utility-accessible disconnect switch with no dimensional/placement spec. PG&E's Distributed Generation Greenbook (TD-7001M) defers this detail to TD-2306M, which PG&E states is accessible only through an assigned Job Owner and could not be retrieved. Also searched SBMC Title 11 and the city's own Residential Electrical Service Upgrades handout - neither addresses PV-specific AC disconnect placement.
https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

- How is an inspection booked? Portal 85% · authority's own page
- How much notice is required? At least 24 hours (next business day cutoff is 3pm) 85% · authority's own page
- Are same-day or AM/PM windows offered? Yes - AM (8am-12pm) or PM (1pm-4pm) windows are offered; inspector calls in the morning to confirm the time 90% · authority's own page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 85% · fee schedule + department page
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? For SolarAPP+-eligible residential PV, only one consolidated building inspection is codified as required (SBMC 11.36.060.H); the current fee schedule prices 'two inspections' for PV-only (Sec 225A) and 'three building inspections plus one Fire inspection' for PV+ESS (Sec 225B/C), so the codified single-inspection rule has been superseded in practice by the more granular current fee-schedule sequence 75% · ordinance + fee schedule (conflict noted)
- Is a rough-in or mid-roof inspection required? Not specifically required for rooftop PV as a distinct 'mid-roof' inspection; the codified rule calls for a single consolidated inspection (SBMC 11.36.060.I), and the fee schedule's multi-inspection counts (2-3) likely correspond to rough/final or building+electrical splits rather than a named mid-roof stage - not itemized by name in any published document found 50% · ordinance + fee schedule (inference)
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes, but general (not solar-specific) - the published Residential Construction Inspection Checklist covers foundation/framing/electrical/plumbing/mechanical/insulation items; no separate PV-specific inspection checklist was found published outside the MGO-Connect-gated SolarAPP+ eligibility checklist 65% · published checklist
- What must be on site at inspection? Not explicitly itemized for solar; general practice per the Building Permit Time Limits handout requires construction to match 'the approved set of plans' on file with the Building Division, implying the approved plan set/permit card must be available at inspection 55% · authority's own document (inference)
- Does the inspector verify labels and listings? Not explicitly stated for solar inspections specifically, but the city's own Residential Electrical Service Upgrades handout requires 'Equipment must be listed and labeled as suitable for use as service equipment,' and SBMC 11.36.040.C requires CEC/UL-listed solar equipment, both of which a field inspector would verify as standard practice 55% · authority's own document (inference)
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (building final inspection sign-off); California single-family residential permits do not receive a certificate of occupancy - PG&E's Rule 21 process requires 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction' before granting Permission to Operate 65% · utility tariff + standard CA practice
- Who notifies the utility for PTO? Installer (the interconnection applicant submits the NEM/Rule 21 Interconnection Request together with evidence of the AHJ's final inspection clearance directly to PG&E; PG&E does not independently pull inspection status from the city) 65% · utility tariff
- Is there a re-inspection fee? $0 for the 1st re-inspection (no charge); $195 for the 2nd and subsequent re-inspections (building trades, Sec 414A/B); for Fire Department re-inspections, 1st is free, 2nd is 'initial fee plus 25%', 3rd+ is 'initial fee plus 50%' (Fire fee schedule Sec I.D-F) 90% · published fee schedule
- How are corrections issued and cleared? For plan review: a written correction notice detailing deficiencies is sent to the applicant for resubmission (SBMC 11.36.060.G). For failed field inspections: cancellations must be made by 3pm the day before to avoid a re-inspection fee, and a subsequent inspection is scheduled via MGO Connect/phone and billed per Sec 414A/B if beyond the 1st re-inspection 75% · ordinance + department page
14 questions answered against City of San Bruno’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal
Why the confidence is not higherInspections page: for permits in MGO Connect, inspections are requested via the MGO Customer Portal ('Request Inspection'); legacy-system permits are scheduled by phone (650-616-7076)
authority's own page checked 2026-08-30 https://www.sanbruno.ca.gov/492/Inspections
Q50 How much notice is required? Core Booking & scheduling
At least 24 hours (next business day cutoff is 3pm)
Why the confidence is not higherInspections page: 'Inspections should be scheduled at least 24 hours in advance... cutoff for Next-Day Inspections is 3pm'
authority's own page checked 2026-08-30 https://www.sanbruno.ca.gov/492/Inspections
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Yes - AM (8am-12pm) or PM (1pm-4pm) windows are offered; inspector calls in the morning to confirm the time
Why the confidence is not higherInspections page states inspection time frames are 'in the morning (8am-12pm) or in the afternoon (1pm-4pm)'
authority's own page checked 2026-08-30 https://www.sanbruno.ca.gov/492/Inspections
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes

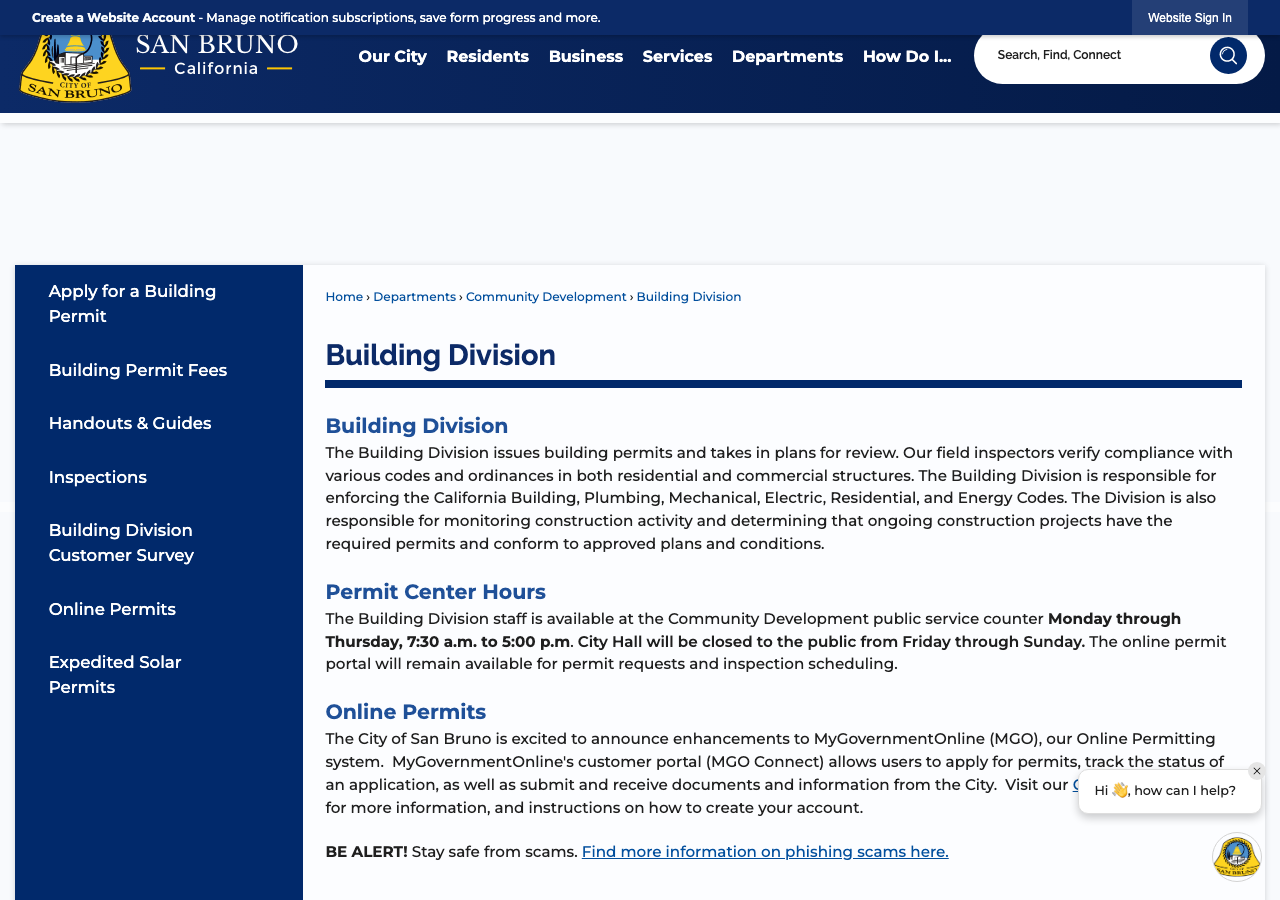

Why the confidence is not higherBuilding Division performs building/electrical solar inspections itself; the Fire Department (also a city department, not an external delegate) performs the additional ESS-specific inspection per the fee schedule
fee schedule + department page checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q53 If delegated, to whom? Core Who inspects
Nothing published by this authority.
Where we lookedNot applicable - inspection is not delegated to an outside agency; see Q52. Checked the Inspections page and fee schedule for any third-party/contracted inspection arrangement (as some CA cities use, e.g., a private firm) and found none for San Bruno.
Q54 Which inspections are required, and in what order? Core Stages & sequence
For SolarAPP+-eligible residential PV, only one consolidated building inspection is codified as required (SBMC 11.36.060.H); the current fee schedule prices 'two inspections' for PV-only (Sec 225A) and 'three building inspections plus one Fire inspection' for PV+ESS (Sec 225B/C), so the codified single-inspection rule has been superseded in practice by the more granular current fee-schedule sequence
Why the confidence is not higherSBMC 11.36.060.H/I vs. Master Fee Schedule Sec 225A-D (conflict noted - fee schedule is the more current, FY2025-26, source)
ordinance + fee schedule (conflict noted) checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Not specifically required for rooftop PV as a distinct 'mid-roof' inspection; the codified rule calls for a single consolidated inspection (SBMC 11.36.060.I), and the fee schedule's multi-inspection counts (2-3) likely correspond to rough/final or building+electrical splits rather than a named mid-roof stage - not itemized by name in any published document found
Why the confidence is not higherSBMC 11.36.060.I and Master Fee Schedule Sec 225A-D reviewed; neither names a rough-in or mid-roof inspection stage for PV specifically
ordinance + fee schedule (inference) checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q56 Does the inspector verify labels and listings? Core What is checked
Not explicitly stated for solar inspections specifically, but the city's own Residential Electrical Service Upgrades handout requires 'Equipment must be listed and labeled as suitable for use as service equipment,' and SBMC 11.36.040.C requires CEC/UL-listed solar equipment, both of which a field inspector would verify as standard practice
Why the confidence is not higherResidential Electrical Service Upgrades handout ('Equipment must be listed and labeled...'); SBMC 11.36.040.C
authority's own document (inference) checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/9022
Q57 Is there a published inspection checklist? Core What is checked
Yes, but general (not solar-specific) - the published Residential Construction Inspection Checklist covers foundation/framing/electrical/plumbing/mechanical/insulation items; no separate PV-specific inspection checklist was found published outside the MGO-Connect-gated SolarAPP+ eligibility checklist
Why the confidence is not higherResidential Construction Inspection Checklist (2025 California Codes)
published checklist checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/9048
Q58 What must be on site at inspection? Core Documents on site
Not explicitly itemized for solar; general practice per the Building Permit Time Limits handout requires construction to match 'the approved set of plans' on file with the Building Division, implying the approved plan set/permit card must be available at inspection
Why the confidence is not higherBuilding Permit Time Limits handout: 'Construction must be completed as approved by the Building Division... Do not proceed with construction work if it is not on the approved set of plans'
authority's own document (inference) checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/1250
Q59 Is there a re-inspection fee? Corrections & re-inspection
$0 for the 1st re-inspection (no charge); $195 for the 2nd and subsequent re-inspections (building trades, Sec 414A/B); for Fire Department re-inspections, 1st is free, 2nd is 'initial fee plus 25%', 3rd+ is 'initial fee plus 50%' (Fire fee schedule Sec I.D-F)
Why the confidence is not higherFY2025-26 Master Fee Schedule Sec 414A/B (building) and Chapter 5 Sec I.D-F (fire)
published fee schedule checked 2026-08-30 https://www.sanbruno.ca.gov/DocumentCenter/View/4416
Q60 How are corrections issued and cleared? Corrections & re-inspection
For plan review: a written correction notice detailing deficiencies is sent to the applicant for resubmission (SBMC 11.36.060.G). For failed field inspections: cancellations must be made by 3pm the day before to avoid a re-inspection fee, and a subsequent inspection is scheduled via MGO Connect/phone and billed per Sec 414A/B if beyond the 1st re-inspection
Why the confidence is not higherSBMC 11.36.060.G; Inspections page (cancellation/re-inspection fee policy); Master Fee Schedule Sec 414A/B
ordinance + department page checked 2026-08-30 https://ecode360.com/print/SA5001?guid=44253356
Q61 What is issued on pass? Core Final sign-off & PTO
Final (building final inspection sign-off); California single-family residential permits do not receive a certificate of occupancy - PG&E's Rule 21 process requires 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction' before granting Permission to Operate
Why the confidence is not higherPG&E Electric Rule 21 tariff, Sec D.13.b; general CA practice (no CO issued for SFR final inspections)
utility tariff + standard CA practice checked 2026-08-30 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer (the interconnection applicant submits the NEM/Rule 21 Interconnection Request together with evidence of the AHJ's final inspection clearance directly to PG&E; PG&E does not independently pull inspection status from the city)
Why the confidence is not higherPG&E Electric Rule 21 tariff, Sec D.13.b describes the Applicant furnishing 'evidence of Applicant's final electric inspection clearance' as part of the Interconnection Request package
utility tariff checked 2026-08-30 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of San Bruno against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of San Bruno is the authority having jurisdiction 90% confidence
- Holds
- Building and Electrical (city Building Division); Fire Department separately inspects Energy Storage System components
- Overridden by
- California AB 130 (2025) freezes any more-restrictive local residential amendment 1 Oct 2025-1 Jun 2031; the Solar Rights Act (Civil Code Sec 714) preempts HOA restrictions; the city's own codified 10kW AC/30kW-thermal expedited-review threshold (SBMC 11.36.030, unchanged since 2015) is superseded in current administrative practice by the 38kW AC SolarAPP+ threshold on the city's own solar page
- Why not higher
- SBMC 11.36 (Small Solar System Permitting Program) and 11.16 (Electrical Code, naming the building official as AHJ) both establish the City of San Bruno Community & Economic Development Department, Building Division as the AHJ for residential rooftop PV; the city's Utility Billing page confirms no municipal electric utility exists (water/sewer only), so PG&E is the interconnecting utility and WestLight Energy (formerly Peninsula Clean Energy) is only the generation-supply CCA, not an AHJ. Fire Department involvement is limited to a specific ESS inspection line item in the fee schedule, not a competing AHJ claim.
- Permit required
- Yes95%
- Permit cost
- $441 (PV only, up to 38kW AC, SFR/duplex); $641 (PV+ESS up to 38kW); $690 (PV+ESS+EV charger); $543 (ESS only);95%
- Plan review
- Same day (instant permit) for SolarAPP+-eligible over-the-counter applications, or 1-3 business days for electronic applications, per the codified expedited-review ordinance;80%
- Portal
- MGO Connect (MyGovernmentOnline), with SolarAPP+ (NREL) used as the front-end code-compliance/eligibility check that feeds an approval package into MGO Connect90%
- Electrical code
- 202390%
- Own placard wording
- No70%
- Booking an inspection
- Portal85%
Labels & placards for this authority
Wording 70%
No
Size, colour & material 70%
Not specified
Where they go 55%
Not specified by the city; standard NEC labeling locations apply (at each service disconnect, at the PV disconnecting means, and at points of interconnection per NEC Art. 690/705), since no SBMC provision addresses label placement
What the utility wants on top 45%
Not confirmed from a San Bruno- or PG&E-specific document beyond the general Rule 21 requirement that interconnection equipment be lockable/accessible for utility disconnection; PG&E's detailed DG placard/AC-disconnect specification document (the 'Greenbook,' TD-7001M, which defers distributed-generation detail to the access-gated TD-2306M) could not be retrieved to confirm placard specifics
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
