City of San Joaquin

Fresno County

Verified Aug. 6, 2026

City of San Joaquin is a city authority in the State of California, serving 3,701 residents. 260 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Same day (over-the-counter applications) or 1 to 3 business days (electronic applications) Q18 Where you file — PermitsConnect (cityofsanjoaquin.permitsconnect.com) — a hosted PT1/PermitsConnect instance with separate Building Application, Q20

Permit required
Yes95% source
Plan review turnaround
Same day (over-the-counter applications) or 1 to 3 business days (electronic applications)95% source
Key document
ordinance cited by 4 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes 92% · ordinance
    • What does this authority permit itself, and what does it delegate? Both 68% · ordinance
    • Is a permit required for a residential rooftop PV system? Yes 95% · ordinance
    • Is there a separate electrical permit, or is it combined? Combined 88% · ordinance
    • Is a HOA or architectural approval required first? No (only conditionally, for historic-listed properties) 82% · ordinance
    • Is there a historic-district review? Yes, but only for properties on the city's list of historic resources 82% · ordinance
    • Is a wind or windstorm certification required? No 55% · ordinance
    • Is a Specific Use Permit or Council approval ever required? Only if the City Manager makes a written finding, based on substantial evidence, that the system 'could have a specific, adverse impact upon the public health and safety' — in which case an Administrative Use Permit is required, appealable to the Planning Commission; standard installations do not need one. 90% · ordinance
    • Is there a system-size cap on residential generation? 10 kW AC nameplate (or 30 kW thermal) is the ceiling for the expedited 'small residential rooftop solar energy system' process; larger systems fall outside Ch. 155's definition and would presumably need standard (non-expedited) building permit review rather than being prohibited outright. 88% · ordinance
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? The generic city 'Construction Permit Application' (property/owner info, licensed-contractor or owner-builder declaration, workers'-compensation declaration, description and valuation of work) submitted via the PermitsConnect online Building Application wizard (permit type, parcel/APN, work description). MC §155.005(C) directs the Planning Department to adopt a solar-specific 'standard plan and checklist' modeled on the CA Solar Permitting Guidebook, but no such document is published on the city's website (verified: site search for 'solar' returns zero results, while a control search for 'council' returns real results and a fabricated term 'zzqqx' returns none, so the search itself is working). 60% · published checklist / proven absence
    • How many copies, and in what format? Electronic submittal (email or the online PermitsConnect portal) is expressly made available per MC §155.005(B); no paper-copy count is specified anywhere in the code or on the portal. 55% · ordinance
    • Is a site plan required, and what must it show? No dedicated 'site plan' is required for a typical single-family rooftop solar installation. MC Ch. 150 Subch. 'Site Plan Review' (§150.080(B)) only applies to new parcels/structures/uses in R-M, C-G, C-H, M-1 and M-2 zones — not single-family (R-1) residential rooftop retrofits — and Ch. 155's expedited process does not itself specify site-plan contents. 70% · ordinance
  4. Apply and pay

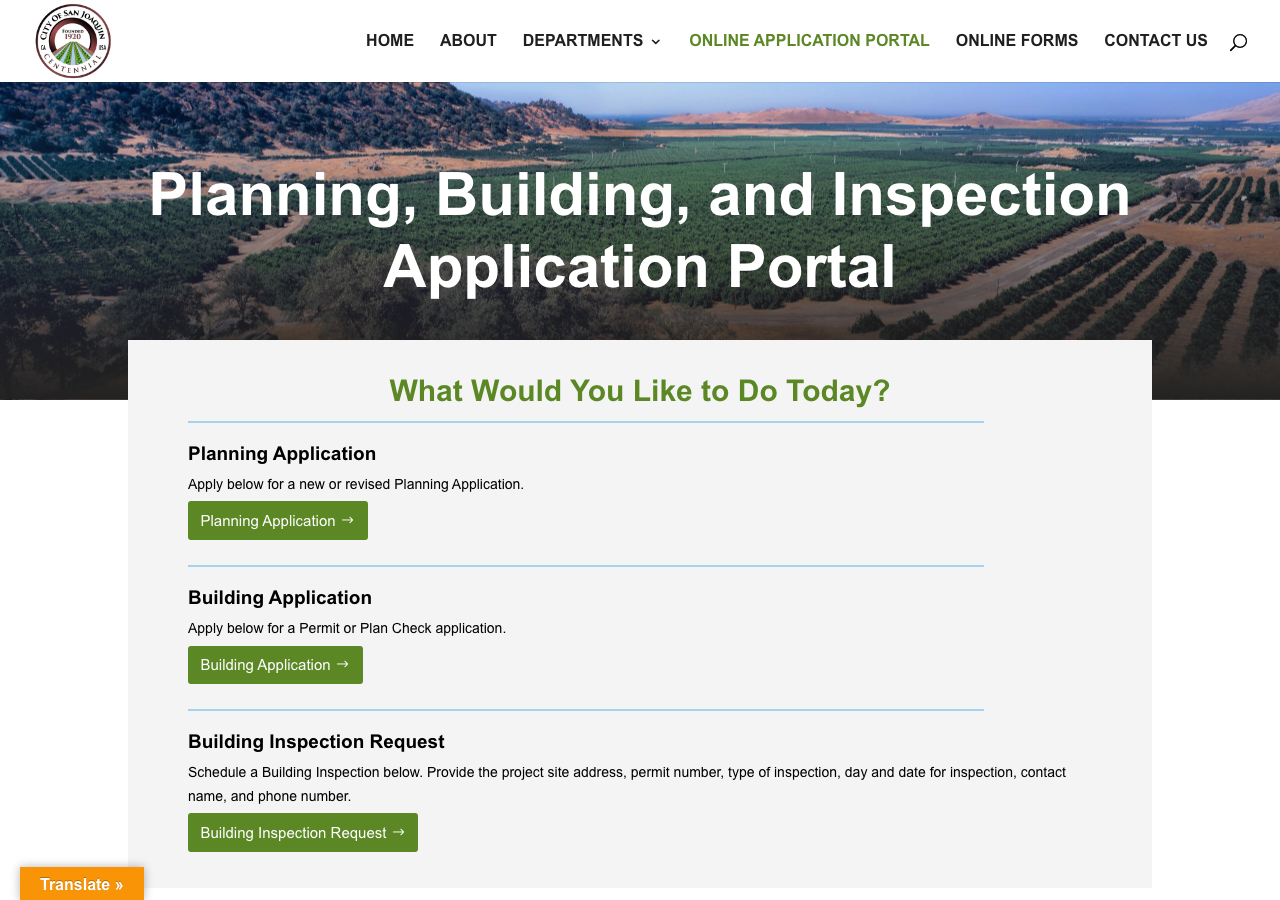

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

    • Which permit portal does this authority use? PermitsConnect (cityofsanjoaquin.permitsconnect.com) — a hosted PT1/PermitsConnect instance with separate Building Application, Planning Application and Inspection Request wizards 95% · portal landing page
    • Can the whole application be completed online? Yes 72% · portal
    • How is the fee calculated? Valuation 65% · ordinance
    • Is there a separate plan-check fee? Yes 78% · ordinance
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? Same day (over-the-counter applications) or 1 to 3 business days (electronic applications) 95% · ordinance
    • Which utility handles interconnection here? Pacific Gas & Electric (PG&E) 62% · utility corporate history (secondary)

28 questions answered against City of San Joaquin’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes

Why the confidence is not higherCity's own codified Municipal Code Ch. 150 (Building Regulations; Construction) and Ch. 155 (Expedited Permit Process for Small Residential Rooftop Solar Systems) establish the city as the permitting/inspecting authority for construction and solar within city limits; no county delegation found for the incorporated city.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2871

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both

Why the confidence is not higherMC §150.001 adopts building/electrical/plumbing/mechanical/fire codes by reference and §150.004(A) issues a single 'combined building, plumbing and electrical permit'; Ch. 155 vests solar permit issuance in the Planning Department with final inspection by the 'building and safety division' (§155.006). No named contract firm or delegation to another agency was found on the city's website (very small city; no Building Official or Planning Director is named on any public page), so this is read from the code text rather than confirmed staffing.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2943

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes

Why the confidence is not higherMC §150.001 requires permits for building/electrical/plumbing/mechanical work city-wide; §155.006(A) confirms a 'building permit' is issued for small residential rooftop solar systems (same-day or 1-3 business days).

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined

Why the confidence is not higherMC §150.004(A)(1)-(2) states fees 'shall be charged in the issuance of a combined building, plumbing and electrical permit'; the city's online permitting portal (PermitsConnect) lists only 'Building', 'Grading', 'MH Permit' and 'Miscellaneous' as permit types (GetBuildingPermitTypes endpoint) — there is no separate 'Electrical' permit type.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2943

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either

Why the confidence is not higherThe city's own 'Construction Permit Application' form (used for all construction incl. combined building/electrical work) lets the applicant identify either a California Licensed Contractor or an Owner-Builder (citing Bus. & Prof. Code §7044) as the permit holder; no provision restricts the electrical portion to a licensed electrician specifically since the permit is combined.

published checklist checked 2026-08-31 https://cityofsanjoaquin.org/wp-content/uploads/2023/08/Construction-Permit-Application.pdf

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

Nothing published by this authority.

Where we lookedChecked MC Ch. 110 (Business Licenses Generally) table of contents and the city's own 'Construction Permit Application' PDF for any requirement that a contractor be registered/licensed with the city before a building permit is accepted; the business license chapter imposes a general tax on businesses 'transacting business' in the city (a 'Contractor/Subcontractor' rate line exists in the Business License Fee Schedule) but no section ties business-license status to permit *issuance*, and the Construction Permit Application form itself has no business-license field.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2456

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes

Why the confidence is not higherThe city's Construction Permit Application form contains a full 'Owner-Builder's Declaration' section (citing Bus. & Prof. Code §7044/§7044.5 exemptions), confirming owner-builder self-permitting is accepted; no city-specific restriction on self-install for solar was found.

published checklist checked 2026-08-31 https://cityofsanjoaquin.org/wp-content/uploads/2023/08/Construction-Permit-Application.pdf

Q8 What documents make up a complete submittal? Core Submittal package

The generic city 'Construction Permit Application' (property/owner info, licensed-contractor or owner-builder declaration, workers'-compensation declaration, description and valuation of work) submitted via the PermitsConnect online Building Application wizard (permit type, parcel/APN, work description). MC §155.005(C) directs the Planning Department to adopt a solar-specific 'standard plan and checklist' modeled on the CA Solar Permitting Guidebook, but no such document is published on the city's website (verified: site search for 'solar' returns zero results, while a control search for 'council' returns real results and a fabricated term 'zzqqx' returns none, so the search itself is working).

Why the confidence is not higherThe ordinance itself requires a checklist that could not be located anywhere on cityofsanjoaquin.org; only the generic construction permit form and portal fields could be confirmed as the actual submittal package.

published checklist / proven absence checked 2026-08-31 https://cityofsanjoaquin.org/?s=solar

Q9 How many copies, and in what format? Submittal package

Electronic submittal (email or the online PermitsConnect portal) is expressly made available per MC §155.005(B); no paper-copy count is specified anywhere in the code or on the portal.

Why the confidence is not higher§155.005(B) only guarantees electronic submittal is offered; no document states a required number of copies or file format for solar specifically.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12990

Q10 Is a site plan required, and what must it show? Core Submittal package

No dedicated 'site plan' is required for a typical single-family rooftop solar installation. MC Ch. 150 Subch. 'Site Plan Review' (§150.080(B)) only applies to new parcels/structures/uses in R-M, C-G, C-H, M-1 and M-2 zones — not single-family (R-1) residential rooftop retrofits — and Ch. 155's expedited process does not itself specify site-plan contents.

Why the confidence is not higherConfirmed by reading §150.080's own applicability clause, which lists only multi-family/commercial/industrial zones; no solar-specific site-plan content list is published (see absence proven for Q8).

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-3081

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Nothing published by this authority.

Where we lookedRead MC Ch. 155 in full (§§155.001-155.006) and the generic Construction Permit Application; neither specifies a one-line/three-line diagram requirement. The document that would normally set this (the standard plan/checklist required by §155.005(C)) is not published on the city's site (see Q8).

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12990

Q12 Are string and conductor calculations required? Drawings & calculations

Nothing published by this authority.

Where we lookedSame review as Q11 — no string/conductor calculation requirement appears in Ch. 155 or Ch. 150, and the standard-plan/checklist document the ordinance requires the Planning Department to adopt is not published.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12990

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Nothing published by this authority.

Where we lookedReviewed Ch. 150 (Construction Codes, §§150.001-150.009) and Ch. 155 in full; no structural PE stamp threshold is stated for residential rooftop PV.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2917

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedSame review as Q13; no electrical PE stamp threshold is stated anywhere in Ch. 150 or Ch. 155.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2917

Q15 What does a residential solar permit cost? Core Fees

Nothing published by this authority.

Where we lookedMC §150.004(A)(1)-(2) states the combined building/plumbing/electrical permit fee is set by 'the fees as set forth in the 1994 Uniform Administrative Code, Chapter 3' (a valuation table) plus up to $50 in blueprint-review time charges — but the dollar table itself is not reproduced in the code, and no current master fee schedule or building/solar fee schedule PDF is published on the city's website (Online Forms page lists only a Business License Fee Schedule, which does not cover construction permits). §150.004 itself carries an editor's note: 'This section is currently undergoing review and revision by the city.'

https://cityofsanjoaquin.org/home/online-forms/

Q16 How is the fee calculated? Core Fees

Valuation

Why the confidence is not higher§150.004(A)(1)-(2) ties the combined permit fee to 'the fees as set forth in the 1994 Uniform Administrative Code, Chapter 3', which is a construction-valuation-based fee table (not a flat, per-kW or per-panel fee); the underlying dollar table is not reproduced in the current code text.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2943

Q17 Is there a separate plan-check fee? Fees

Yes

Why the confidence is not higher§150.004(A)(1)-(2) adds 'an additional time charge of $5 per hour for blue print review not to exceed a total of $50' on top of the combined permit fee — a plan-review charge, though small and capped rather than a large separate line item.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2943

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Same day (over-the-counter applications) or 1 to 3 business days (electronic applications)

Why the confidence is not higherMC §155.006(A): 'The Planning Department shall issue a building permit... on the same day for over-the-counter applications or within one to three business days for electronic applications upon receipt of a complete application that meets the requirements of the approved checklist and standard plan.'

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q19 How long is an issued permit valid before it expires? Timeline & validity

Nothing published by this authority.

Where we lookedRead Ch. 150 (§§150.001-150.009) and Ch. 155 in full; no permit-validity/expiration period is stated for building or solar permits.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2943

Q20 Which permit portal does this authority use? Core Portal & process

PermitsConnect (cityofsanjoaquin.permitsconnect.com) — a hosted PT1/PermitsConnect instance with separate Building Application, Planning Application and Inspection Request wizards

Why the confidence is not higherCity's own 'San Joaquin Online Portal' page links directly to https://cityofsanjoaquin.permitsconnect.com/Home/BuildingApplication, /Home/PlanningApplication and /Home/InspectionRequest.

portal landing page checked 2026-08-31 https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/

Q21 Can the whole application be completed online? Core Portal & process

Yes

Why the confidence is not higherThe PermitsConnect 'Building Application' page is a full multi-step wizard (permit type selection, parcel/APN lookup, work description, contractor/owner declarations) intended to be completed and submitted online, and MC §155.005(B) separately guarantees electronic submittal of solar applications and documents; it is unclear from the portal's own markup whether plan documents attach directly in the wizard or are emailed separately per §155.005(B).

portal checked 2026-08-31 https://cityofsanjoaquin.permitsconnect.com/Home/BuildingApplication

Q22 Which utility handles interconnection here? Core Utility interconnection

Pacific Gas & Electric (PG&E)

Why the confidence is not higherNo city page or utility territory map could be confirmed this run (web-search budget exhausted for this task), but Fresno County has no municipal electric utility, and PG&E's own corporate history (via Wikipedia) records its predecessor 'San Joaquin Light and Power Corporation' as having originally served exactly this part of the San Joaquin Valley/Fresno County, consistent with PG&E's present-day territory. Recorded as inference from utility-territory knowledge, not a city-side or utility-side document, per the standing caution not to trust geography-only assumptions.

utility corporate history (secondary) checked 2026-08-31 https://en.wikipedia.org/wiki/Pacific_Gas_and_Electric_Company

Q23 Where does the utility sit in the sequence? Core Utility interconnection

Nothing published by this authority.

Where we lookedNo PG&E-specific interconnection/DG sequencing document (Rule 21 process, Greenbook, or NEM handbook) could be retrieved this run to confirm where San Joaquin-area interconnection sits relative to city permit issuance; PG&E's Greenbook manual URL returned a 404 and no city document addresses utility sequencing.

https://www.pge.com/

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No (only conditionally, for historic-listed properties)

Why the confidence is not higherMC §155.003(C): 'A use permit and/or architectural review may be required for properties on the city's list of historic resources as deemed necessary by the community development director.' No general HOA/architectural review requirement exists for standard rooftop solar.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12979

Q25 Is there a historic-district review? Overlays & special cases

Yes, but only for properties on the city's list of historic resources

Why the confidence is not higherMC §155.003(C) (same section as Q24) — architectural/use-permit review is conditional on historic-resource listing, as determined by the (unstaffed-per-website) 'community development director'.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12979

Q26 Is a wind or windstorm certification required? Overlays & special cases

No

Why the confidence is not higherRead Ch. 150 (construction codes) and Ch. 155 in full; no wind/windstorm certification requirement is stated for residential solar. Not a high-wind/coastal jurisdiction; absence is based on a full read of the relevant chapters, not a dedicated wind-code search.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2871

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Only if the City Manager makes a written finding, based on substantial evidence, that the system 'could have a specific, adverse impact upon the public health and safety' — in which case an Administrative Use Permit is required, appealable to the Planning Commission; standard installations do not need one.

Why the confidence is not higherMC §155.006(A) and (C) set out this exact conditional-use-permit trigger and appeal path.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q28 Is there a system-size cap on residential generation? Overlays & special cases

10 kW AC nameplate (or 30 kW thermal) is the ceiling for the expedited 'small residential rooftop solar energy system' process; larger systems fall outside Ch. 155's definition and would presumably need standard (non-expedited) building permit review rather than being prohibited outright.

Why the confidence is not higherMC §155.002 definition of 'SMALL RESIDENTIAL ROOFTOP SOLAR ENERGY SYSTEM', item (1).

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12961

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? Other — city's own codified text cites 'the 2019 National Electrical Code' (Ord. 2019-03, passed 12-10-2019), not one of the standard NFPA 70 editions (2017/2020/2023); no newer local electrical-code adoption ordinance was found in the current code library (current through Ord. 2026-01, 2-3-2026), so the codified reference is stale relative to California's statewide 2022/2025 Building Standards Code cycles (2023 NEC as of the 2025 CBC cycle). 55% · adopting ordinance
    • Which building code edition is in force? 1994/2019 Uniform Building Code lineage — §150.001(B) adopts 'The 2019 Uniform Building Code of the International Conference of Building Officials' by reference (plus 2019 Uniform Plumbing/Mechanical/Administrative Codes, and the 1994 Uniform Housing Code); no newer local building-code adoption ordinance appears in the current code library. 55% · adopting ordinance
    • Which fire code edition is in force? 2019 Uniform Fire Code (Volumes 1 and 2, with specified appendix chapters) per §150.001(C); no newer local fire-code adoption ordinance found. Actual fire suppression/response, however, is provided by a separate agency (see jurisdiction note) rather than a city fire department. 55% · adopting ordinance
    • Are there local amendments to any of the above? Yes 90% · ordinance
    • What is the installation judged against? The locally-adopted 2019-cited Uniform Building/Electrical/Plumbing/Mechanical/Fire Codes (Ch. 150) plus the health-and-safety/listing standards set out in Ch. 155 (§155.004) — accredited-listing-agency certification for thermal systems, and California Electrical Code / IEEE / UL / CPUC safety-and-reliability standards for PV systems. 70% · ordinance
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    Nothing recorded for City of San Joaquin on this step yet — 1 question checked and found unpublished. The guidance above is general.

  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Rapid shutdown is required under NEC 690.12 as incorporated by the locally-cited '2019 National Electrical Code' (§150.001(A)); the exact shutdown boundary/timing depends on which NFPA 70 edition is actually operative, which the city's own stale citation leaves ambiguous (see Q29). 45% · adopting ordinance (inference)
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    Nothing recorded for City of San Joaquin on this step yet — 6 questions checked and found unpublished. The guidance above is general.

  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Must equipment be on a specific approved list? Yes 88% · ordinance
    • Are batteries permitted, and under what conditions? Not addressed. Ch. 155 (the city's only solar-specific ordinance) defines and regulates 'solar energy systems' (PV and solar-thermal) only; after reading §§155.001-155.006 in full, no battery, energy-storage-system, or ESS provision of any kind appears in the chapter, and none was found in Ch. 150 either. 70% · ordinance
    • Is a ground mount treated as a structure? Yes (by omission — treated as an ordinary structure under Ch. 150, not eligible for the Ch. 155 expedited process) 68% · ordinance (inference)

20 questions answered against City of San Joaquin’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

Other — city's own codified text cites 'the 2019 National Electrical Code' (Ord. 2019-03, passed 12-10-2019), not one of the standard NFPA 70 editions (2017/2020/2023); no newer local electrical-code adoption ordinance was found in the current code library (current through Ord. 2026-01, 2-3-2026), so the codified reference is stale relative to California's statewide 2022/2025 Building Standards Code cycles (2023 NEC as of the 2025 CBC cycle).

Why the confidence is not higherDirect quote from the city's own §150.001(A); confidence lowered because '2019 NEC' is not a real NFPA edition (likely shorthand for the code cycle then in effect) and no later amending ordinance for this section could be found, despite the code library showing entries as recent as Feb 2026.

adopting ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2918

Q30 Which building code edition is in force? Core Code editions in force

1994/2019 Uniform Building Code lineage — §150.001(B) adopts 'The 2019 Uniform Building Code of the International Conference of Building Officials' by reference (plus 2019 Uniform Plumbing/Mechanical/Administrative Codes, and the 1994 Uniform Housing Code); no newer local building-code adoption ordinance appears in the current code library.

Why the confidence is not higherQuoted directly from §150.001; California's statewide 2022 CBC cycle (and the 2025 cycle) would apply as a matter of state law even without a new local ordinance, but the city's own document has not been updated to reflect this, and §150.004 (fees/general construction) itself carries an editor's note that it 'is currently undergoing review and revision by the city.'

adopting ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2918

Q31 Which fire code edition is in force? Code editions in force

2019 Uniform Fire Code (Volumes 1 and 2, with specified appendix chapters) per §150.001(C); no newer local fire-code adoption ordinance found. Actual fire suppression/response, however, is provided by a separate agency (see jurisdiction note) rather than a city fire department.

Why the confidence is not higherQuoted directly from §150.001(C); same staleness caveat as Q29/Q30.

adopting ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2918

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes

Why the confidence is not higherCh. 150 contains multiple express local amendments beyond the adopted model codes: expansive-soils construction practice (§150.002), city-wide Fire Zone 3 declaration (§150.003), additional foundation/rebar/subfloor/roof-underlayment/sewer-diameter requirements (§150.004(B)-(G)), and a construction restriction on Manning Avenue (§150.008); §150.001(L) also expressly substitutes the local fence chapter (Ch. 151) for the UBC's fence provisions.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2917

Q33 What is the installation judged against? Core Electrical

The locally-adopted 2019-cited Uniform Building/Electrical/Plumbing/Mechanical/Fire Codes (Ch. 150) plus the health-and-safety/listing standards set out in Ch. 155 (§155.004) — accredited-listing-agency certification for thermal systems, and California Electrical Code / IEEE / UL / CPUC safety-and-reliability standards for PV systems.

Why the confidence is not higherCombines §150.001 (code adoption) with §155.004 (solar-specific performance standards); no single consolidated 'installation standard' document exists beyond these two ordinance sections.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12985

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Nothing published by this authority.

Where we lookedRead Ch. 150 (Construction Codes, §§150.001-150.009) and Ch. 155 in full; no local rule on service-upgrade or busbar sizing (e.g. a 120%-rule restatement or main-breaker interconnection rule) was found.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2917

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Nothing published by this authority.

Where we lookedRead Ch. 155 in full (§§155.001-155.006); no mounting-system, attachment-spacing, or fastener-pattern requirement is specified. The document that might contain this (the §155.005(C) standard plan/checklist) is not published — see Q8.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12990

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Nothing published by this authority.

Where we lookedRead Ch. 155 in full and Ch. 94 (Fire Prevention/Fire Protection Services — only 2 short sections, §§94.01 and 94.20-94.21, neither about PV); no ridge-setback or fire-access-pathway dimensions are specified anywhere in the city's own code for rooftop PV.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2080

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Rapid shutdown is required under NEC 690.12 as incorporated by the locally-cited '2019 National Electrical Code' (§150.001(A)); the exact shutdown boundary/timing depends on which NFPA 70 edition is actually operative, which the city's own stale citation leaves ambiguous (see Q29).

Why the confidence is not higherInferred from the fact that every NEC edition since 2017 (690.12) requires rapid shutdown, combined with the city's own ambiguous '2019 NEC' citation; no city document independently restates the requirement or its boundary distance.

adopting ordinance (inference) checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2918

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedRead Ch. 155 in full and Ch. 152 (Signs, §§152.01-152.05+); Ch. 152 regulates business/advertising signage only (real-estate, subdivision, political, construction signs, etc.) and does not address NEC-required service-equipment placards; no PV-specific placard specification exists in either chapter.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-3187

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame review as Q38 — no PV placard wording of any kind is specified by the city.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-3187

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame review as Q38 — no letter height, colour, or material specification for PV placards exists in the city's code.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-3187

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedRead Ch. 155 in full; no site-plan/facility-map placard requirement (NEC 705.10-style) is specified locally beyond the generic NEC incorporation discussed at Q29/Q37.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12950

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedCould not retrieve a PG&E interconnection/DG manual this run (Greenbook URL 404'd; PG&E service-area pages 404'd to WebFetch) to check for utility-specified placards beyond the AHJ's own (none found at AHJ level per Q38-41).

https://www.pge.com/

Q43 Where must the labels be placed? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame review as Q38 — no label-placement location is specified in the city's own code; would default to whatever the incorporated 2019-cited NEC requires, which was not independently verified this run.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-3187

Q44 Must equipment be on a specific approved list? Equipment listing

Yes

Why the confidence is not higherMC §155.004(B) requires water-heating solar systems be 'certified by an accredited listing agency as defined by the California Plumbing and Mechanical Code'; §155.004(C) requires PV systems meet 'applicable safety and performance standards established by the California Electrical Code, the Institute of Electrical and Electronics Engineers, and accredited testing laboratories such as Underwriters Laboratories' and CPUC rules where applicable.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12985

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Not addressed. Ch. 155 (the city's only solar-specific ordinance) defines and regulates 'solar energy systems' (PV and solar-thermal) only; after reading §§155.001-155.006 in full, no battery, energy-storage-system, or ESS provision of any kind appears in the chapter, and none was found in Ch. 150 either.

Why the confidence is not higherBased on a complete read of the only two chapters (150 and 155) that could plausibly contain such a rule, rather than a working full-text search API (amlegal's site-wide search endpoint could not be made to return results this run — see note); this is a real absence within the sections read, not a search-tool failure, but is not confirmed against the rest of the ~2,900-section code.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12950

Q46 Is there a separate ESS permit or inspection? Battery / ESS

Nothing published by this authority.

Where we lookedRead Ch. 155 in full; because no ESS/battery provision exists at all (Q45), there is no way to confirm from the city's own text whether a separate ESS permit or inspection process would apply, as opposed to a standard building permit for any other equipment.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12950

Q47 Is a ground mount treated as a structure? Core Ground mount

Yes (by omission — treated as an ordinary structure under Ch. 150, not eligible for the Ch. 155 expedited process)

Why the confidence is not higherCh. 155's own definition of the systems it covers is limited to 'ROOFTOP' systems 'installed on a single- or two-family dwelling' (§155.002); a ground-mounted array falls outside that definition and would default to a standard Ch. 150 building permit as any other structure, though no section says so explicitly.

ordinance (inference) checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12961

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Nothing published by this authority.

Where we lookedNo PG&E interconnection/DG manual (Greenbook, Electric Rule 21 handbook, or Electric Service Requirements manual) could be retrieved this run to confirm AC-disconnect placement relative to the meter; the city's own Ch. 150/155 text is silent on this utility-side placement question.

https://www.pge.com/

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Portal 90% · portal
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes 90% · ordinance
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? A single, consolidated final inspection performed by the Building and Safety Division after permit issuance (no separate rough-in/mid-roof stage for the expedited small-residential-rooftop category); if the system fails, a subsequent (re-)inspection is authorized. 85% · ordinance
    • Is a rough-in or mid-roof inspection required? No 85% · ordinance
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final 50% · ordinance (inference)
    • How are corrections issued and cleared? MC §155.006(F): if an application (not necessarily post-inspection field work) is deemed incomplete or deficient, 'a written correction notice detailing all deficiencies... shall be sent to the applicant for resubmission.' No separate, inspection-stage correction/clearance process is described. 55% · ordinance

14 questions answered against City of San Joaquin’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Portal

Why the confidence is not higherThe city's PermitsConnect site has a dedicated 'Inspection Request' wizard (parcel/APN lookup, contact details, permit/inspection-item selection, review & confirm) at /Home/InspectionRequest, linked directly from the city's own Online Portal page.

portal checked 2026-08-31 https://cityofsanjoaquin.permitsconnect.com/Home/InspectionRequest

Q50 How much notice is required? Core Booking & scheduling

Nothing published by this authority.

Where we lookedChecked the PermitsConnect Inspection Request wizard's date picker logic (onDisableDates function) — it only blocks specific blackout/holiday dates from a server-supplied list, it does not encode or display a minimum lead-time/notice requirement; no department page states one either.

https://cityofsanjoaquin.permitsconnect.com/Home/InspectionRequest

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Nothing published by this authority.

Where we lookedChecked the PermitsConnect Inspection Request wizard and the city's Contact Us page; neither states whether same-day or AM/PM inspection windows are offered.

https://cityofsanjoaquin.org/home/contact-us/

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes

Why the confidence is not higherMC §155.006(G): 'Only one inspection shall be required and performed by the building and safety division for small residential rooftop solar energy systems eligible for expedited review.'

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q53 If delegated, to whom? Core Who inspects

Nothing published by this authority.

Where we lookedQ52 establishes that the city's own 'building and safety division' performs the (single) required inspection itself; this question does not apply.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q54 Which inspections are required, and in what order? Core Stages & sequence

A single, consolidated final inspection performed by the Building and Safety Division after permit issuance (no separate rough-in/mid-roof stage for the expedited small-residential-rooftop category); if the system fails, a subsequent (re-)inspection is authorized.

Why the confidence is not higherMC §155.006(G)-(I): 'Only one inspection shall be required...should include consolidated inspections...If a small residential rooftop solar energy system fails inspection, a subsequent inspection is authorized.'

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

No

Why the confidence is not higherMC §155.006(G) expressly limits expedited small-residential-rooftop solar to a single required inspection — no separate rough-in or mid-roof inspection is called for.

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q56 Does the inspector verify labels and listings? Core What is checked

Nothing published by this authority.

Where we lookedMC §155.004(B)-(C) requires listed/certified equipment (Q44), but no section of Ch. 155 or Ch. 150 states that label/listing verification is an explicit step of the single required inspection; this is a plausible but unconfirmed inference, so it is left unanswered rather than guessed.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12985

Q57 Is there a published inspection checklist? Core What is checked

No

Why the confidence is not higherMC §155.005(C) requires the Planning Department to adopt a standard plan and checklist, but no such document (nor any other published inspection checklist) could be found anywhere on cityofsanjoaquin.org; confirmed via the site's own search (a search for 'solar' returns zero results, a control search for 'council' returns real results, and a fabricated control 'zzqqx' returns none — proving the search function itself works).

proven absence (site search) checked 2026-08-31 https://cityofsanjoaquin.org/?s=solar

Q58 What must be on site at inspection? Core Documents on site

Nothing published by this authority.

Where we lookedRead Ch. 155 in full; no section specifies what documents (permit card, plans, listing labels, etc.) must be present on-site at the time of inspection.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q59 Is there a re-inspection fee? Corrections & re-inspection

Nothing published by this authority.

Where we lookedChecked §150.004 (fees) and the only published fee document on the site (Business License Fee Schedule, which does not cover construction/inspection fees); no re-inspection fee amount is stated anywhere.

https://cityofsanjoaquin.org/wp-content/uploads/2025/08/Business-License-Fees-1.pdf

Q60 How are corrections issued and cleared? Corrections & re-inspection

MC §155.006(F): if an application (not necessarily post-inspection field work) is deemed incomplete or deficient, 'a written correction notice detailing all deficiencies... shall be sent to the applicant for resubmission.' No separate, inspection-stage correction/clearance process is described.

Why the confidence is not higherThe only corrections language found is framed around application review, not field inspection corrections; it is unclear whether the same mechanism is used for a failed field inspection versus the 're-inspection' language in §155.006(I).

ordinance checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q61 What is issued on pass? Core Final sign-off & PTO

Final

Why the confidence is not higherNo document uses a specific term like 'Certificate of Occupancy', 'green tag' or 'Final'; inferred from §155.006(G)-(I) describing pass/fail of 'inspection' for a building permit, which in standard CA municipal practice is closed out with a permit final.

ordinance (inference) checked 2026-08-31 https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-12996

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Nothing published by this authority.

Where we lookedNo city or PG&E document reviewed this run states who (installer vs. AHJ vs. utility) files the Permission-to-Operate notification with the utility; PG&E's own interconnection materials could not be retrieved (see Q42/Q48).

https://www.pge.com/

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of San Joaquin against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of San Joaquin is the authority having jurisdiction 80% confidence
Holds
Building, Electrical, Plumbing and Mechanical permitting/inspection (Ch. 150, 'Building Official'), plus solar-specific permit issuance by the Planning Department and final inspection by the 'building and safety division' (Ch. 155)
Overridden by
California Solar Rights Act / Gov. Code §65850.5 (AB 2188, Stats. 2014) bounds the city's review per §155.001; fire suppression/response is provided by a separate agency rather than the city itself (see why)
Why not higher
City of San Joaquin is an incorporated general-law city in Fresno County with its own codified Municipal Code Ch. 150 (Building Regulations; Construction) naming a city 'Building Official', and its own Ch. 155 expedited-solar ordinance administered by the city's Planning Department with inspection by the 'building and safety division' — no evidence of county delegation was found (Fresno County's own Building & Safety page returned a 404 for a contract-city check this run). CORRECTION/finding: the code's own §94.20 (passed 1955) names 'Mid Valley Fire District' as the fire agency 'under authority of Cal. Health and Safety Code §§13800-13970', but the city's own current (2026) Contact Us page instead names 'Tranquility Fire Dept.' at 559.698.5500 as the fire department — the codified section is stale and the live contact page is treated as controlling for fire response. Building/electrical code ADOPTION itself remains with the city regardless (§150.001 adopts the 2019-cited Uniform Building/Fire/Electrical Codes). Note: no Building Official, Planning Director, or contract-firm name appears anywhere on the city's public website (a very small city — pop. ~3,700), so 'in-house vs. contracted' staffing could not be independently confirmed beyond the code text itself.

https://codelibrary.amlegal.com/codes/sanjoaquin/latest/sanjoaquin_ca/0-0-0-2871

Permit required
Yes95%
Plan review
Same day (over-the-counter applications) or 1 to 3 business days (electronic applications)95%
Portal
PermitsConnect (cityofsanjoaquin.permitsconnect.com) — a hosted PT1/PermitsConnect instance with separate Building Application, Planning Application and Inspection Request wizards95%
Electrical code
Other — city's own codified text cites 'the 2019 National Electrical Code' (Ord. 2019-03, passed 12-10-2019), not one of the standard NFPA 70 editions (2017/2020/2023);55%
Booking an inspection
Portal90%
Labels & placards for this authority

Wording None%

Size, colour & material None%

Where they go None%

What the utility wants on top None%

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Fresno County
Regions served
1
Regions covered
City of San Joaquin · city
Solar Requirements
Notes
Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/ --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://cityofsanjoaquin.org/home/online-forms/san-joaquin-online-portal/
Authority Contact
Address
21900 Colorado Avenue, San Joaquin, CA 93660
Main Phone
559-693-4311
Building Department
Department
Planning, Building & Inspection
Direct Phone
559-693-4311
Booking & Scheduling
Preferred channel
online
Notes
Schedule final solar inspections via the PermitsConnect portal at cityofsanjoaquin.permitsconnect.com/Home/InspectionRequest. Required information: project site address, permit number, type of inspection, preferred day and date, contact name, and phone number. Alternatively call City Hall at 559-693-4311. City is very small (pop ~3,700); building services appear to be handled through a combined Planning, Building & Inspection function with no dedicated direct line. (collected Jul 2026)
