City of Santa Fe Springs
Los Angeles County
City of Santa Fe Springs is a city authority in the State of California, serving 19,219 residents. 863 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 3 business days (or same-day for over-the-counter applications using the standard plan) Q18 Where you file — Transtech 'Plan Submittal Portal' (gopost-transtech.eplansoftreview.com, portal=santafesprings) for plan check; Q20
- Permit required
- Yes95% source
- What it costs
- No single PV-specific dollar figure. Components: Building permit fee is valuation-based (Table 1A, e.g.75% source
- Plan review turnaround
- 3 business days (or same-day for over-the-counter applications using the standard plan)90% source
- Key document
- permit application form cited by 4 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · municipal code
- What does this authority permit itself, and what does it delegate? Both 85% · council agenda item (site-search snippet)
- Is a permit required for a residential rooftop PV system? Yes 95% · municipal code
- Is there a separate electrical permit, or is it combined? Combined 70% · permit application form
- Is a HOA or architectural approval required first? No (for a single-family residence) 75% · municipal code
- Is there a historic-district review? No 85% · municipal code (full TOC walk)
- Is a wind or windstorm certification required? No dedicated wind/windstorm certification found 55% · department page
- Is a Specific Use Permit or Council approval ever required? Yes, conditionally 85% · municipal code
- Is there a system-size cap on residential generation? 10 kW AC / 30 kW thermal — this is an ELIGIBILITY GATE for the ministerial/expedited Part 1A ordinance, not an absolute size cap. Larger systems fall outside the 'Small Residential Rooftop Solar Energy System' definition and would be reviewed under the discretionary use-permit/site-plan process instead. 90% · municipal code
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 90% · permit application form
- Must the contractor be registered with this authority before applying? No 55% · permit application form
- Is a homeowner permitted to self-install and self-permit? Yes 90% · permit application form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? No dedicated PV submittal checklist is published. General flow (per the city's 'Building Permit Process' handout): plot plan + floor plan + roof plan to Planning for zoning clearance, then plans to Building & Safety for plan check via the Plan Submittal Portal. SFSMC §155.033(D) REQUIRES the Building Official to promulgate a standard plan/checklist for small residential rooftop solar conforming to the CA Solar Permitting Guidebook, but no such document could be found on the Building Forms page or via a 44-hit sitewide search for 'solar' (positive control 'solar'=44 hits incl. unrelated docs; fabricated control 'zzqqx'=0 hits, confirming search works). 55% · department handout + ordinance
- How many copies, and in what format? Digital/electronic only, via the city's Plan Submittal Portal (Transtech eplansoftreview.com) 85% · department page
- Is a site plan required, and what must it show? Yes, a plot plan is required as part of the general building-permit process (shows zoning compliance for the parcel); no PV-specific site-plan content list is published. 55% · department handout
- Is a structural PE stamp required, and at what threshold? Not solar-specific. General amendment SFSMC §150.004.001 (CRC R301.1.3.2) requires a CA-licensed architect/engineer stamp for wood-frame dwellings more than one story (Seismic Design Category D0/D1/D2/E) or more than two stories (Category A/B/C); the Building Official otherwise has discretion under §150.001.002 to require stamped plans for any project. 55% · municipal code
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

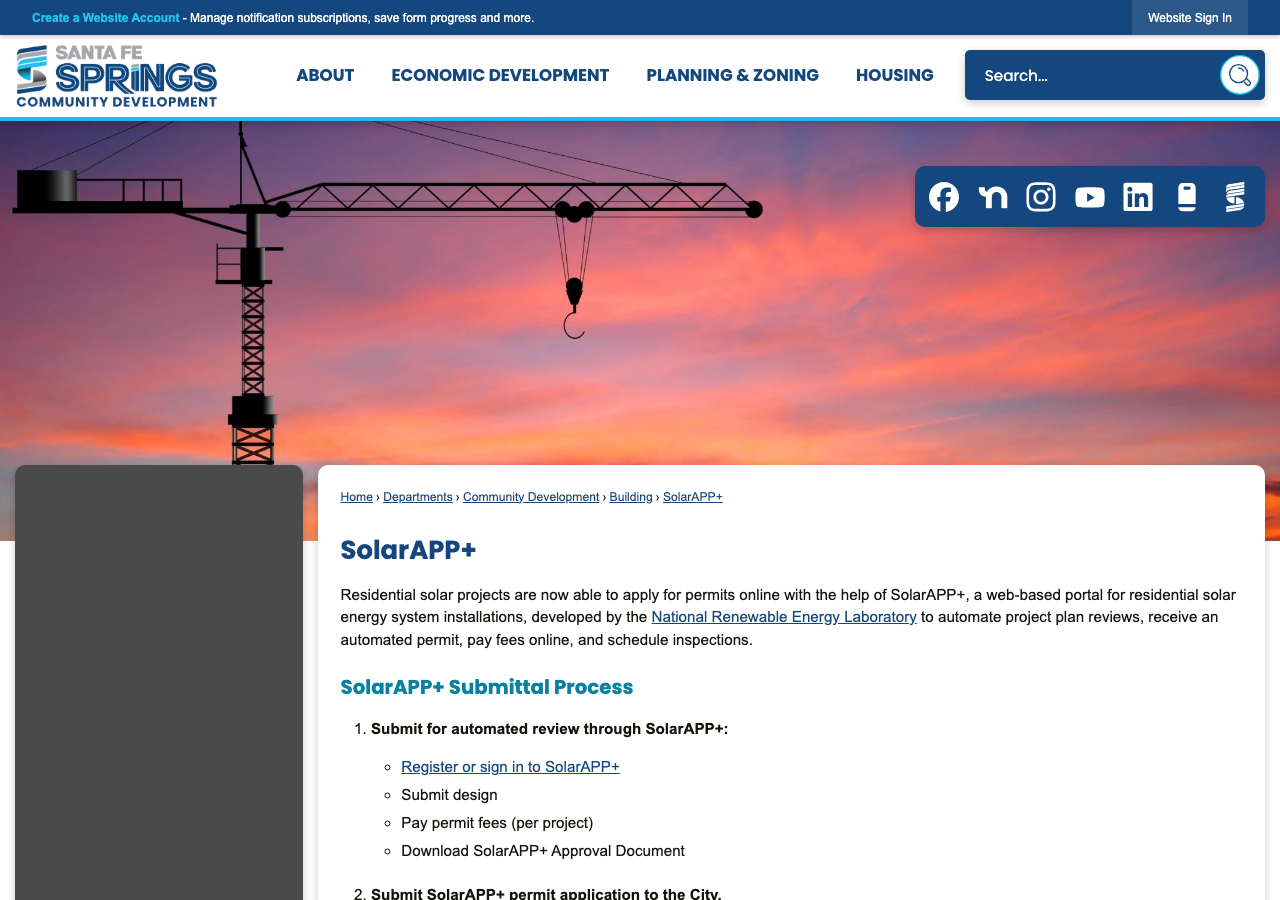

- Which permit portal does this authority use? Transtech 'Plan Submittal Portal' (gopost-transtech.eplansoftreview.com, portal=santafesprings) for plan check; a separate JotForm (santafesprings.jotform.com) for inspection requests 90% · department page
- Can the whole application be completed online? Partially / conflicting evidence 65% · department page (conflicts with Building page)
- What does a residential solar permit cost? No single PV-specific dollar figure. Components: Building permit fee is valuation-based (Table 1A, e.g. ~$110-$650+ for a typical $10k-$25k residential PV valuation) plus 85% plan-check fee; Electrical permit fee is tiered by inverter/equipment kW rating under the 'Power Apparatus' schedule ($33.42 for >3-10kW, $77.25 for >10-50kW, etc.) plus 70% plan-check fee; separately, Fire-Rescue charges a flat $220 'Residential Solar Panel' plan-review fee. 75% · fee schedule
- How is the fee calculated? Valuation 80% · fee schedule
- Is there a separate plan-check fee? Yes 90% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 3 business days (or same-day for over-the-counter applications using the standard plan) 90% · municipal code
- How long is an issued permit valid before it expires? 365 days (1 year) from issuance before work must commence, or before a required inspection lapses; extendable in increments of up to 180 days, maximum 2 years cumulative 90% · municipal code
- Which utility handles interconnection here? Southern California Edison (SCE) 90% · department FAQ page
28 questions answered against City of Santa Fe Springs’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherSFSMC §150.001.002 requires a building permit from the Building Official for any building/electrical work in the city, and Part 1A of the zoning code (§§155.030-155.034) codifies the city's own small-residential-rooftop-solar permitting ordinance.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.001BUCOAD
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherCity legally holds both Building/Electrical (SFSMC Ch.150) and Fire (SFSMC Ch.93, own Fire-Rescue Department) jurisdiction. However Building & Safety plan check AND inspection were contracted to Transtech Engineering, Inc. by City Council award on 2/6/2024 (confirmed by the council-agenda item title/recommendation text indexed in the city's own site search, and by the city's Plan Submittal Portal running on Transtech's own domain gopost-transtech.eplansoftreview.com). Fire-Rescue is self-performed, not delegated.
council agenda item (site-search snippet) checked 2026-08-31 https://www.santafesprings.gov/Search/Results?searchPhrase=Transtech
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherSFSMC §150.001.002: 'No person shall erect, construct, enlarge, alter, repair... any building, structure... without first obtaining a separate permit... from the Building Official.' No solar-specific exemption exists.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.001BUCOAD
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe city's own Permit Worksheet is a single combined application covering building, electrical, mechanical and plumbing scopes of work on one form (with a distinct 'ELECTRICAL P#' field populated once issued), rather than a wholly separate electrical-only application. The Building Fee Schedule nonetheless prices electrical as its own fee table (§150.006).
permit application form checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/213/Permit-Worksheet-PDF
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherThe city's own Permit Worksheet has a 'PERMIT HOLDER INFORMATION' block with checkboxes for 'LICENSED CONTRACTOR' or 'OWNER BUILDER'.
permit application form checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/213/Permit-Worksheet-PDF
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
No
Why the confidence is not higherLooked at the Permit Worksheet and Building Department FAQ/page; neither describes a city-specific contractor registration step beyond supplying the CSLB license number/class/expiration on the worksheet. Absence noted, not confirmed against a business-license ordinance.
permit application form checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/213/Permit-Worksheet-PDF
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherThe Permit Worksheet's 'OWNER BUILDER' checkbox is a first-class option alongside 'LICENSED CONTRACTOR', and the Building FAQ states 'Permits must be obtained by a licensed contractor or residential owner-occupied property.'
permit application form checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/213/Permit-Worksheet-PDF
Q8 What documents make up a complete submittal? Core Submittal package
No dedicated PV submittal checklist is published. General flow (per the city's 'Building Permit Process' handout): plot plan + floor plan + roof plan to Planning for zoning clearance, then plans to Building & Safety for plan check via the Plan Submittal Portal. SFSMC §155.033(D) REQUIRES the Building Official to promulgate a standard plan/checklist for small residential rooftop solar conforming to the CA Solar Permitting Guidebook, but no such document could be found on the Building Forms page or via a 44-hit sitewide search for 'solar' (positive control 'solar'=44 hits incl. unrelated docs; fabricated control 'zzqqx'=0 hits, confirming search works).
Why the confidence is not higherOrdinance mandates a document that was not found published; genuine absence proved by search + Building Forms page walk, not a retrieval failure.
department handout + ordinance checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/660/Building-Permit-Process-PDF
Q9 How many copies, and in what format? Submittal package
Digital/electronic only, via the city's Plan Submittal Portal (Transtech eplansoftreview.com)
Why the confidence is not higherBuilding page states: 'As of June 17, 2024, all plan checks and resubmittals shall be through the City's Plan Submittal Portal.' No copy-count language found (paper no longer accepted).
department page checked 2026-08-31 https://www.santafesprings.gov/207/Building
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes, a plot plan is required as part of the general building-permit process (shows zoning compliance for the parcel); no PV-specific site-plan content list is published.
Why the confidence is not higherInferred from the 'Building Permit Process' flowchart ('APPLICANT SUBMITS PLOT PLAN, FLOOR PLAN & ROOF PLAN TO PLANNING DEPT. TO CHECK FOR ZONING COMPLIANCE'); no solar-specific site-plan checklist exists (see Q8).
department handout checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/660/Building-Permit-Process-PDF
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Nothing published by this authority.
Where we lookedSFSMC section 155.033(D) (ordinance requires a checklist to be promulgated); Building Forms page; 44-hit sitewide solar search -- no published one-line/three-line diagram requirement found for PV specifically
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedSame as Q11 -- no published string/conductor calculation requirement found for PV specifically
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Not solar-specific. General amendment SFSMC §150.004.001 (CRC R301.1.3.2) requires a CA-licensed architect/engineer stamp for wood-frame dwellings more than one story (Seismic Design Category D0/D1/D2/E) or more than two stories (Category A/B/C); the Building Official otherwise has discretion under §150.001.002 to require stamped plans for any project.
Why the confidence is not higherNo PV-specific structural-stamp threshold was found; this is the general residential structural-stamp trigger that could apply to a roof-mount racking review at the Building Official's discretion.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.004RECOAD
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedSFSMC Ch.150 (§150.005 Electrical Code adoption, no amendments) and the Building Fee Schedule; no electrical PE-stamp threshold specified anywhere found
Q15 What does a residential solar permit cost? Core Fees
No single PV-specific dollar figure. Components: Building permit fee is valuation-based (Table 1A, e.g. ~$110-$650+ for a typical $10k-$25k residential PV valuation) plus 85% plan-check fee; Electrical permit fee is tiered by inverter/equipment kW rating under the 'Power Apparatus' schedule ($33.42 for >3-10kW, $77.25 for >10-50kW, etc.) plus 70% plan-check fee; separately, Fire-Rescue charges a flat $220 'Residential Solar Panel' plan-review fee.
Why the confidence is not higherBuilding/Electrical fee tables (current FY2026-27 schedule, pdfinfo CreationDate 1 Jul 2026) contain no PV-specific line, only the generic valuation/kW schedules; Fire's $220 residential-PV line is concrete and current (Reso 9933, adopted 12 Nov 2024, eff. 12 Jan 2025, pdfinfo-confirmed).
fee schedule checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/204/Building-Fee-Schedule-FY-2026-to-2027-PDF
Q16 How is the fee calculated? Core Fees
Valuation
Why the confidence is not higherBuilding Fee Schedule Table 1A note 10: 'Plan Check Fees shall be 85% as per Building Code Section 107.2' on a valuation table; Electrical is Tiered by kW/HP rating (Power Apparatus schedule); Fire's residential-solar line is Flat ($220). No single basis covers the whole permit.
fee schedule checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/204/Building-Fee-Schedule-FY-2026-to-2027-PDF
Q17 Is there a separate plan-check fee? Fees
Yes
Why the confidence is not higherBuilding Fee Schedule: 'Plan Check Fees shall be 85%' of the building permit fee (Table 1A note 10); Electrical Code Fee item 35: plan check fee = 70% of the electrical permit fee. Both are itemized separately from the permit fee itself.
fee schedule checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/204/Building-Fee-Schedule-FY-2026-to-2027-PDF
Q18 What is the stated plan-review turnaround? Core Timeline & validity
3 business days (or same-day for over-the-counter applications using the standard plan)
Why the confidence is not higherSFSMC §155.034(A): 'The Building Department shall issue a building permit or other nondiscretionary permit the same day for over-the-counter applications or within three business days of receipt of a complete application' using the standard plan, for small residential rooftop solar.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.034PEREINRE
Q19 How long is an issued permit valid before it expires? Timeline & validity
365 days (1 year) from issuance before work must commence, or before a required inspection lapses; extendable in increments of up to 180 days, maximum 2 years cumulative
Why the confidence is not higherSFSMC §150.001.003(B): permit expires if work not commenced within 1 year of issuance, or no required inspection approved within 1 year of the last approved inspection; §150.001.003(B)(5) allows Building-Official-discretion extensions in ≤180-day increments, cumulative cap 2 years from original expiration.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.001BUCOAD
Q20 Which permit portal does this authority use? Core Portal & process
Transtech 'Plan Submittal Portal' (gopost-transtech.eplansoftreview.com, portal=santafesprings) for plan check; a separate JotForm (santafesprings.jotform.com) for inspection requests
Why the confidence is not higherBuilding page links the eplansoftreview.com portal directly and states it has been mandatory for all plan checks/resubmittals since 17 Jun 2024; Building FAQ links the JotForm for scheduling inspections.
department page checked 2026-08-31 https://www.santafesprings.gov/207/Building
Q21 Can the whole application be completed online? Core Portal & process
Partially / conflicting evidence
Why the confidence is not higherThe Building page says plan check/resubmittal has been portal-only since 17 Jun 2024, but the Building FAQ (a separately maintained page) states 'All requests for plan check or inspections must be done in person or by phone 562-868-0511, ext. 7560.' Reported both, not resolved.
department page (conflicts with Building page) checked 2026-08-31 https://www.santafesprings.gov/m/faq?cat=31
Q22 Which utility handles interconnection here? Core Utility interconnection
Southern California Edison (SCE)
Why the confidence is not higherCity's own FAQ: 'If you have questions about your electric bill, please contact Southern California Edison'; a separate FAQ notes 'some street lights in Santa Fe Springs are owned and maintained by Southern California Edison.' The city itself only bills water (it operates a Water Utility Authority per its own Public Financing Authority agenda items). Not a Clean Power Alliance member: 'Santa Fe Springs' has zero hits on cleanpoweralliance.org's own membership page while a known member (Downey) has 2 hits, confirming the search mechanism works.
department FAQ page checked 2026-08-31 https://www.santafesprings.gov/m/FAQ#question-195
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedSCE's own DG/interconnection pages (soft-404 per prior GovBot runs); no Santa Fe Springs document states the interconnection sequence
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No (for a single-family residence)
Why the confidence is not higherSFSMC §155.105 and §155.175.15 'Architectural Design Standards' are scoped only to the R-3/R-4 multi-family district (Part 4) and the mixed-use overlay (Part 6.A) respectively; there is no design-review requirement in Part 3 (R-1 Single-Family Residential). SFSMC §155.034(A) also makes the solar review nondiscretionary/ministerial by default.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT3SIMIREZODI_S155.067BUHE
Q25 Is there a historic-district review? Overlays & special cases
No
Why the confidence is not higherWalked the full codified Table of Contents (2,428 lines) for the entire Code of Ordinances: zero chapters, parts, or sections contain the word 'Historic' anywhere. Santa Fe Springs has no historic-preservation or historic-district ordinance at all.
municipal code (full TOC walk) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances
Q26 Is a wind or windstorm certification required? Overlays & special cases
No dedicated wind/windstorm certification found
Why the confidence is not higherThe Building Department's own page lists design parameters (Wind Speed 95 mph, Exposure C, ASCE 7-16) but this is a base structural-design parameter, not a separate PV-specific windstorm certification requirement (unlike Banning's 130-mph 'Special Wind Region' solar handout). No local amendment or solar handout imposing a certification was found.
department page checked 2026-08-31 https://www.santafesprings.gov/207/Building
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Yes, conditionally
Why the confidence is not higherSFSMC §155.034(A): 'The Building Official may require an applicant to apply for a use permit if the Official finds, based on substantial evidence, that the solar energy system could have a specific, adverse impact upon the public health and safety. Such decisions may be appealed to the Planning Commission.'
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.034PEREINRE
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC / 30 kW thermal — this is an ELIGIBILITY GATE for the ministerial/expedited Part 1A ordinance, not an absolute size cap. Larger systems fall outside the 'Small Residential Rooftop Solar Energy System' definition and would be reviewed under the discretionary use-permit/site-plan process instead.
Why the confidence is not higherSFSMC §155.030 definition: 'Small Residential Rooftop Solar Energy System... A solar energy system that is no larger than ten kilowatts alternating current nameplate rating or 30 kilowatts thermal... installed on a single or duplex family dwelling... does not exceed the maximum legal building height.' This is the AB 2188-era figure, codified via Ord. 1066 (10-8-15) and still current.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.030DE
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2025 California Electrical Code (based on the 2023 NEC) 95% · municipal code
- Which building code edition is in force? 2025 California Building Standards Code family: 2025 CBC, 2025 CRC, 2025 CPC, 2025 CMC, 2025 CGBSC (Green Building), 2025 California Energy Code, 2025 CEBC 95% · municipal code
- Which fire code edition is in force? 2025 California Fire Code, based on the 2024 International Fire Code 95% · municipal code
- Are there local amendments to any of the above? Yes — for Building and Fire; not found for Electrical 85% · municipal code
- What is the installation judged against? The 2025 CBC/CRC/CEC/CFC as adopted and locally amended in SFSMC Ch.150 and Ch.93; for the PV system specifically, SFSMC §155.032 requires conformance to the CA Plumbing/Mechanical Code (solar water heating), the CA Electrical Code, IEEE standards, UL/accredited-lab listing, and applicable CPUC safety/reliability rules. 85% · municipal code
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Not locally codified — defaults to the unamended 2025 CFC/2024 IFC pathway and setback provisions 80% · municipal code (control-checked absence)
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Not locally addressed; the unamended 2025 CEC (based on 2023 NEC, which contains NEC 690.12) applies by default 60% · municipal code (control-checked absence)
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? None specified locally beyond the unamended state code (CEC/CFC placarding sections); no local ordinance names a specific placard for PV service equipment 75% · municipal code (control-checked absence)
- Does the authority specify placard wording of its own? No 80% · municipal code (control-checked absence)
- Does it specify letter height, colour or material? No 80% · municipal code (control-checked absence)
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes 85% · municipal code
- Are batteries permitted, and under what conditions? Yes, permitted, but with no residential-specific codified conditions found. Fire-Rescue's own current fee schedule carries a flat 'Battery Energy Storage System' plan-review/permit fee of $560 (undifferentiated by occupancy), and Building's own Permit Worksheet has a dedicated 'ESS (Batteries)' line under the electrical section. 70% · fee schedule + permit application form
- Is there a separate ESS permit or inspection? Effectively yes for fee/tracking purposes, though not documented as a wholly separate permit TYPE 65% · permit application form
- Is a ground mount treated as a structure? Not directly addressed for residential; likely yes by default/inference 55% · municipal code (inference)
- Is there a local rule on service upgrades or busbar sizing? No 80% · municipal code
20 questions answered against City of Santa Fe Springs’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2025 California Electrical Code (based on the 2023 NEC)
Why the confidence is not higherSFSMC §150.005: 'Article 89, Article 90, Chapters 1 through 9... of the 2025 California Electrical Code, Title 24 Part 3... is hereby adopted by reference.' (Ord. No. 1165, 12-2-25). No local amendments to this section.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.005ELCOAD
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Standards Code family: 2025 CBC, 2025 CRC, 2025 CPC, 2025 CMC, 2025 CGBSC (Green Building), 2025 California Energy Code, 2025 CEBC
Why the confidence is not higherSFSMC §§150.002, 150.004, 150.007, 150.009 (Ord. No. 1165, passed 12-2-25) plus the Building Department's own page, which lists all seven codes plus the Energy Code as currently in effect.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.002CABUCOADRE
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code, based on the 2024 International Fire Code
Why the confidence is not higherSFSMC §93.01: 'The City of Santa Fe Springs adopts by reference the 2025 edition of the California Fire Code based on the 2024 International Fire Code... (Ord. 1127, passed 2-21-23; Ord. No. 1164, §§1,2, 10-21-25).'
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITIXGERE_CH93FIPRPR_GEPR_S93.01ADCAFICOOTREST
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes — for Building and Fire; not found for Electrical
Why the confidence is not higherBuilding: §150.002.001 deletes CBC admin sections 104.7/105.2/105.3.2/105.5/107.5/109.3/111.1-3 and replaces Ch.9 (fire) with the local Fire Code chapter; §150.004.001 amends CRC R301.1.3.2 (wood-frame stamp rule). Fire: §93.03 contains an extensive, multi-page amendment set (~17.7KB of text) to the CFC. Electrical: §150.005 was adopted with zero amendment subsections — a control-checked absence (unlike §150.002.001/§150.004.001, there is no '150.005.001 Amended' subsection).
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.002CABUCOADRE
Q33 What is the installation judged against? Core Electrical
The 2025 CBC/CRC/CEC/CFC as adopted and locally amended in SFSMC Ch.150 and Ch.93; for the PV system specifically, SFSMC §155.032 requires conformance to the CA Plumbing/Mechanical Code (solar water heating), the CA Electrical Code, IEEE standards, UL/accredited-lab listing, and applicable CPUC safety/reliability rules.
Why the confidence is not higherSFSMC §155.032(A)-(C).
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.032SOENSYRE
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No
Why the confidence is not higherSFSMC §150.005 (Electrical Code adoption) contains no amendment subsection at all — a control-checked genuine absence, unlike Palm Springs' codified 225A-busbar/attic-derating rule. No busbar-sizing or service-upgrade rule specific to solar was found anywhere in Ch.150 or Ch.93.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.005ELCOAD
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedSFSMC §150.002.001 (Building Code amendments) and §155.032 (Solar Energy System Requirements); neither addresses a specific mounting system or attachment spacing — defaults to unamended CBC/CRC and manufacturer engineering
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Not locally codified — defaults to the unamended 2025 CFC/2024 IFC pathway and setback provisions
Why the confidence is not higherFull-text search of SFSMC §93.03 (the entire Fire Code amendment section, ~17.7KB) for 'solar', 'photovoltaic', 'setback', 'ridge', 'pathway' returned zero hits, while a positive control ('fire code official') returned 12 hits and a fabricated control ('zzqqx') returned 0 — confirming the search was working and the absence is real, not a retrieval failure.
municipal code (control-checked absence) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITIXGERE_CH93FIPRPR_GEPR_S93.03AMFICO
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Not locally addressed; the unamended 2025 CEC (based on 2023 NEC, which contains NEC 690.12) applies by default
Why the confidence is not higherNo local amendment to §150.005 (Electrical Code) or to Ch.93 (Fire Code) mentions rapid shutdown or '690.12' — control-checked absence (see Q36 methodology) — so the state-code baseline governs without local modification.
municipal code (control-checked absence) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.005ELCOAD
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
None specified locally beyond the unamended state code (CEC/CFC placarding sections); no local ordinance names a specific placard for PV service equipment
Why the confidence is not higherChapter 93 (Fire Code amendments, full text) and the Part 1A solar ordinance (§§155.030-034) contain zero references to 'placard', 'label', or 'disconnect' signage wording — control-checked absence.
municipal code (control-checked absence) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITIXGERE_CH93FIPRPR_GEPR_S93.03AMFICO
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No
Why the confidence is not higherSame control-checked absence as Q38 — no placard wording of the city's own was found anywhere in the Fire Code chapter or the solar zoning ordinance.
municipal code (control-checked absence) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITIXGERE_CH93FIPRPR_GEPR_S93.03AMFICO
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
No
Why the confidence is not higherSame control-checked absence — no letter-height, colour, or material specification was found locally.
municipal code (control-checked absence) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITIXGERE_CH93FIPRPR_GEPR_S93.03AMFICO
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSFSMC Ch.93 (Fire Code) and Part 1A solar ordinance (§§155.030-155.034); no facility-map/site-plan placard requirement found
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSCE's own DG/net-metering pages (soft-404 per prior GovBot runs, not substituted with another utility's document per playbook rule)
Q43 Where must the labels be placed? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSame as Q42 — SCE's own label-placement spec was not reachable; no Santa Fe Springs document reproduces it
Q44 Must equipment be on a specific approved list? Equipment listing
Yes
Why the confidence is not higherSFSMC §155.032(C): PV systems 'shall meet all applicable safety and performance standards established by the California Electrical Code, the Institute of Electrical and Electronics Engineers, and accredited testing laboratories such as Underwriters Laboratories.'
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.032SOENSYRE
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, permitted, but with no residential-specific codified conditions found. Fire-Rescue's own current fee schedule carries a flat 'Battery Energy Storage System' plan-review/permit fee of $560 (undifferentiated by occupancy), and Building's own Permit Worksheet has a dedicated 'ESS (Batteries)' line under the electrical section.
Why the confidence is not higherFire Prevention Fee Schedule (Reso 9933, eff. 1/12/2025) lists 'Battery Energy Storage System $560.00' under HAZARDS, with no R-3-only carve-out language found (unlike SBCoFD/Twentynine Palms' exemption pattern) — the codified Fire Code chapter (§93.03) itself is silent on batteries/ESS beyond a lead-acid-battery hazard classification.
fee schedule + permit application form checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/653/Fire-Prevention-Fee-Schedule-PDF
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Effectively yes for fee/tracking purposes, though not documented as a wholly separate permit TYPE
Why the confidence is not higherThe Building & Safety Permit Worksheet lists 'ESS (Batteries)' as its own distinct checkbox line, separate from the generic 'Power Apparatus' kW tiers used for PV inverters; Fire-Rescue separately fees ESS at a flat $560 versus PV's flat $220 — both point to ESS being tracked/charged distinctly, but no document describes a standalone 'ESS permit' process or inspection stage.
permit application form checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/213/Permit-Worksheet-PDF
Q47 Is a ground mount treated as a structure? Core Ground mount
Not directly addressed for residential; likely yes by default/inference
Why the confidence is not higherSFSMC Part 1A's 'Small Residential Rooftop Solar Energy System' definition (§155.030) is scoped to rooftop systems on single/duplex dwellings, implicitly excluding ground mounts from the ministerial ordinance. The only codified 'ground-mounted equipment' screening rule (§155.097/§155.175.9) applies solely to the multi-family (Part 4) and mixed-use (Part 6.A) zones, not R-1 — so a residential ground mount would default to the general zoning definition of 'structure' and standard accessory-building setbacks. Flagged as inference.
municipal code (inference) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.030DE
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedSCE's own DG manual (soft-404 per prior GovBot runs); no Santa Fe Springs document specifies AC-disconnect location relative to the meter
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal (JotForm) or Phone 90% · department FAQ page
- How much notice is required? 24 hours 90% · department FAQ page
- Are same-day or AM/PM windows offered? For small residential rooftop solar specifically: a 2-hour inspection window, scheduled within 2 business days of the request 85% · municipal code
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Delegated 75% · council agenda item (site-search snippet)
- If delegated, to whom? Transtech Engineering, Inc. (Building & Safety plan check and inspection); Fire-Rescue's own component is self-performed, not delegated 75% · council agenda item + portal domain
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? Per the zoning ordinance, only ONE inspection is required for a small residential rooftop solar system, performed by the Building Department — in apparent tension with Fire-Rescue's own $220 'Residential Solar Panel' plan-review fee and its permit-application checkbox for 'Solar PV Systems - Residential', which imply Fire also reviews these jobs. 80% · municipal code (conflicts with Fire fee schedule/application)
- Is a rough-in or mid-roof inspection required? No 85% · municipal code
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? No 75% · department page (control-checked absence)
- Does the inspector verify labels and listings? Not explicitly documented, but implied 55% · department FAQ page (inference)
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (inspection sign-off); no Certificate of Occupancy is issued for a PV retrofit on an existing dwelling 55% · municipal code (inference)
- Is there a re-inspection fee? Not a fixed dollar figure for solar specifically. General basis: Fire's 'Re-inspection (1 hr. min.)' is billed at the 'Fully allocated hourly rate' (undefined dollar amount); Building's general schedule has 'For inspections for which no fee is specifically indicated, per hour: $164.54' and an electrical 're-inspection resulting from defective workmanship' fee of $55.53. 70% · fee schedule
14 questions answered against City of Santa Fe Springs’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal (JotForm) or Phone
Why the confidence is not higherBuilding FAQ: 'Please use the following inspection link: https://santafesprings.jotform.com/241696745524062 and fill out one inspection request per job site,' with a phone number also given for scheduling.
department FAQ page checked 2026-08-31 https://www.santafesprings.gov/m/faq?cat=31
Q50 How much notice is required? Core Booking & scheduling
24 hours
Why the confidence is not higherBuilding FAQ: 'Inspections must be received 24 hours in advance.'
department FAQ page checked 2026-08-31 https://www.santafesprings.gov/m/faq?cat=31
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
For small residential rooftop solar specifically: a 2-hour inspection window, scheduled within 2 business days of the request
Why the confidence is not higherSFSMC §155.034(I): 'An inspection will be scheduled within two business days of a request and provide a two-hour inspection window.'
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.034PEREINRE
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Delegated
Why the confidence is not higherBuilding plan check AND inspection services were awarded by City Council to Transtech Engineering, Inc. on 2/6/2024 (confirmed via the city's own site-search index of that council agenda item's title and recommendation text); the Building page confirms the Transtech-hosted portal has handled all plan check/resubmittal since 17 Jun 2024. Not independently confirmed by reading the signed contract PDF itself.
council agenda item (site-search snippet) checked 2026-08-31 https://www.santafesprings.gov/Search/Results?searchPhrase=Transtech
Q53 If delegated, to whom? Core Who inspects
Transtech Engineering, Inc. (Building & Safety plan check and inspection); Fire-Rescue's own component is self-performed, not delegated
Why the confidence is not higherSame council-agenda evidence as Q52, cross-checked against the Transtech-branded plan-check portal domain (gopost-transtech.eplansoftreview.com) and the in-house, city-domain-only Fire-Rescue staff (fire@santafesprings.gov, Fire Marshal Kevin Yang) with the codified §93.02 establishing the city's own Fire Department.
council agenda item + portal domain checked 2026-08-31 https://www.santafesprings.gov/Search/Results?searchPhrase=Transtech
Q54 Which inspections are required, and in what order? Core Stages & sequence
Per the zoning ordinance, only ONE inspection is required for a small residential rooftop solar system, performed by the Building Department — in apparent tension with Fire-Rescue's own $220 'Residential Solar Panel' plan-review fee and its permit-application checkbox for 'Solar PV Systems - Residential', which imply Fire also reviews these jobs.
Why the confidence is not higherSFSMC §155.034(H): 'Only one inspection shall be required and performed by the Building Department for small residential rooftop solar energy systems eligible for expedited review.' Reported both; not resolved which controls in practice.
municipal code (conflicts with Fire fee schedule/application) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.034PEREINRE
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherSFSMC §155.034(H) limits expedited-eligible systems to a single Building Department inspection; no separate rough-in or mid-roof inspection is described.
municipal code checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH155ZO_ZODI_PT1ASMREROSOSY_S155.034PEREINRE
Q56 Does the inspector verify labels and listings? Core What is checked
Not explicitly documented, but implied
Why the confidence is not higherNo published PV inspection checklist exists (see Q57) to confirm this directly. SFSMC §155.032(C) requires UL/accredited-lab listing as a condition of the installation itself, which a final inspection would need to confirm as part of standard code compliance; the Building FAQ states generically that 'A Building Inspector will be signing off on all work done.'
department FAQ page (inference) checked 2026-08-31 https://www.santafesprings.gov/m/faq?cat=31
Q57 Is there a published inspection checklist? Core What is checked
No
Why the confidence is not higherNo PV-specific inspection checklist was found on the Building Forms page, the Fire Prevention/Plan Review pages, or in a 44-hit sitewide search for 'solar' (fabricated control 'zzqqx' returned 0 hits, confirming the search mechanism works).
department page (control-checked absence) checked 2026-08-31 https://www.santafesprings.gov/207/Building
Q58 What must be on site at inspection? Core Documents on site
Nothing published by this authority.
Where we lookedBuilding FAQ (only gives scheduling info: job-site address and permit number); Building Forms page; no published 'what must be on site' checklist for PV inspections found
Q59 Is there a re-inspection fee? Corrections & re-inspection
Not a fixed dollar figure for solar specifically. General basis: Fire's 'Re-inspection (1 hr. min.)' is billed at the 'Fully allocated hourly rate' (undefined dollar amount); Building's general schedule has 'For inspections for which no fee is specifically indicated, per hour: $164.54' and an electrical 're-inspection resulting from defective workmanship' fee of $55.53.
Why the confidence is not higherFire Prevention Fee Schedule (Reso 9933) FIELD INSPECTION section; Building/Electrical Fee Schedule items 13 (general) and 31 (electrical). No PV-specific re-inspection line exists in either.
fee schedule checked 2026-08-31 https://www.santafesprings.gov/DocumentCenter/View/653/Fire-Prevention-Fee-Schedule-PDF
Q60 How are corrections issued and cleared? Corrections & re-inspection
Nothing published by this authority.
Where we lookedBuilding page, Building FAQ, and Permit Worksheet; none describe a documented corrections/resubmittal process beyond the general Plan Submittal Portal
Q61 What is issued on pass? Core Final sign-off & PTO
Final (inspection sign-off); no Certificate of Occupancy is issued for a PV retrofit on an existing dwelling
Why the confidence is not higherInferred from the general permitting scheme (SFSMC §150.001 issues a 'Certificate of Occupancy' only in the new-construction/change-of-occupancy context, §150.001 item 16); no document explicitly names what is issued on a passed solar inspection specifically.
municipal code (inference) checked 2026-08-31 https://library.municode.com/ca/santa_fe_springs/codes/code_of_ordinances?nodeId=TITXVLAUS_CH150BURE_GEPR_S150.001BUCOAD
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedSCE's own DG/PTO pages (soft-404 per prior GovBot runs); no Santa Fe Springs document states who notifies SCE for PTO
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Santa Fe Springs against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Santa Fe Springs is the authority having jurisdiction 88% confidence
- Holds
- Building and electrical (plan check and inspection contracted to Transtech Engineering, Inc. per City Council contract award, 2/6/2024) plus Fire-Rescue plan review and permitting (self-performed, in-house Fire-Rescue Department under its own Fire Chief)
- Delegated to
- Transtech Engineering, Inc. (Building & Safety plan check and inspection only)
- Overridden by
- CA Gov't Code §65850.5/AB 2188 (nondiscretionary small-residential-rooftop-solar ordinance, codified as SFSMC Part 1A, §§155.030-155.034) and the Solar Rights Act (Civil Code §714) both constrain the city's discretion; no LA County or other agency retains jurisdiction over residential PV/electrical here.
- Why not higher
- SFSMC §150.001.002 and §93.02 codify the city's own Building Official and Fire Department as the enforcing authorities. The city moved its Building & Safety plan check fully off any external/county dependency and onto a Transtech-hosted portal as of 17 June 2024 -- its own page notes that pre-6/17/2024 applications 'not approved by the County' would continue under City review, implying partial reliance on LA County plan review before that date, distinct from (and about two years ahead of) LA County's separate, later 1 Jul 2026 contract-city discontinuation. Fire-Rescue is a genuine in-house department (§93.02: 'Fire Department of the City of Santa Fe Springs which is hereby established... operated under the supervision of the Fire Chief'), not LACoFD -- confirmed unusual for a small LA County city.
- Permit required
- Yes95%
- Permit cost
- No single PV-specific dollar figure. Components: Building permit fee is valuation-based (Table 1A, e.g.75%
- Plan review
- 3 business days (or same-day for over-the-counter applications using the standard plan)90%
- Portal
- Transtech 'Plan Submittal Portal' (gopost-transtech.eplansoftreview.com, portal=santafesprings) for plan check; a separate JotForm (santafesprings.jotform.com) for inspection requests90%
- Electrical code
- 2025 California Electrical Code (based on the 2023 NEC)95%
- Own placard wording
- No80%
- Booking an inspection
- Portal (JotForm) or Phone90%
Labels & placards for this authority
Wording 80%
No
Size, colour & material 80%
No
Where they go None%
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
