City of Susanville
Lassen County
City of Susanville is a city authority in the State of California, serving 16,728 residents. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Not published as a stated turnaround; SolarApp+, which the city uses for eligible residential PV, issues automated same-day approval Q18 Where you file — SolarApp+ (for eligible residential rooftop PV); conventional/paper permits otherwise handled at the Building and Planning counter at City Hall Q20
- Permit required
- Yes92% source
- What it costs
- $104 minimum for solar ($35 SolarApp+ online application fee + $69 minimum permit fee), plus payment-processor convenience fees (credit/debit/wallet: $0.30 + 2.9%; ACH: 0.8%, capped at $5.00)88% source
- Plan review turnaround
- Not published as a stated turnaround; SolarApp+, which the city uses for eligible residential PV, issues automated same-day approval55% source
- Key document
- fee schedule cited by 8 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 90% · department page
- What does this authority permit itself, and what does it delegate? Both 85% · permit form
- Is a permit required for a residential rooftop PV system? Yes 92% · fee schedule
- Is there a separate electrical permit, or is it combined? Combined 60% · fee schedule
- Is a HOA or architectural approval required first? No requirement found from the city 50% · ordinance
- Is there a historic-district review? No solar-specific trigger found 45% · ordinance
- Is a wind or windstorm certification required? No 55% · checklist
- Is a Specific Use Permit or Council approval ever required? No — not required for a standard residential rooftop PV system 50% · ordinance
- Is there a system-size cap on residential generation? No specific residential system-size cap identified; the zoning code exempts roof-mounted solar equipment from the district height limit outright, rather than capping capacity 55% · ordinance
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Licensed electrician 60% · permit form
- Must the contractor be registered with this authority before applying? Yes 70% · permit form
- Is a homeowner permitted to self-install and self-permit? Yes 88% · permit form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? No solar-specific submittal checklist is published; the general Plan Check Submittal Requirements handout applies (site/plot plan, architectural/structural plans, permit application, subcontractors list, owner-builder form if applicable). Solar-specific projects processed via SolarApp+ instead use that portal's own equipment-and-design questionnaire in place of full construction documents. 65% · checklist
- How many copies, and in what format? General building permits: four (4) complete sets of plans plus one 11x14 reduced set; solar via SolarApp+ is submitted digitally through the online portal instead of paper sets. 60% · checklist
- Is a site plan required, and what must it show? Yes — general submittal doc requires a site/plot plan showing lot dimensions, structure orientation, meters/point of connection, easements, drainage, and (for solar-relevant items) electrical service equipment size and location. 60% · checklist
- Is a one-line / three-line diagram required? Yes 65% · utility DG manual
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? SolarApp+ (for eligible residential rooftop PV); conventional/paper permits otherwise handled at the Building and Planning counter at City Hall 78% · fee schedule
- Can the whole application be completed online? Yes, for SolarApp+-eligible systems 65% · fee schedule
- What does a residential solar permit cost? $104 minimum for solar ($35 SolarApp+ online application fee + $69 minimum permit fee), plus payment-processor convenience fees (credit/debit/wallet: $0.30 + 2.9%; ACH: 0.8%, capped at $5.00) 88% · fee schedule
- How is the fee calculated? Flat 70% · fee schedule
- Is there a separate plan-check fee? No (for SolarApp+-eligible systems) 55% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? Not published as a stated turnaround; SolarApp+, which the city uses for eligible residential PV, issues automated same-day approval 55% · fee schedule
- How long is an issued permit valid before it expires? 180 days 85% · permit form
- Which utility handles interconnection here? Lassen Municipal Utility District (LMUD) — a publicly owned, community-governed municipal utility district serving Susanville and most of Lassen County 92% · utility rate schedule
- Where does the utility sit in the sequence? Parallel, with cross-requirements: LMUD requires a completed application ($300 fee) including the building permit as a checklist item before it will approve interconnection, but LMUD's own sequence chart lists 'LMUD application approval' before 'City/County building permit obtained,' and final energization requires both the city's final inspection AND a separate LMUD final interconnection inspection. 60% · utility DG manual
28 questions answered against City of Susanville’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes

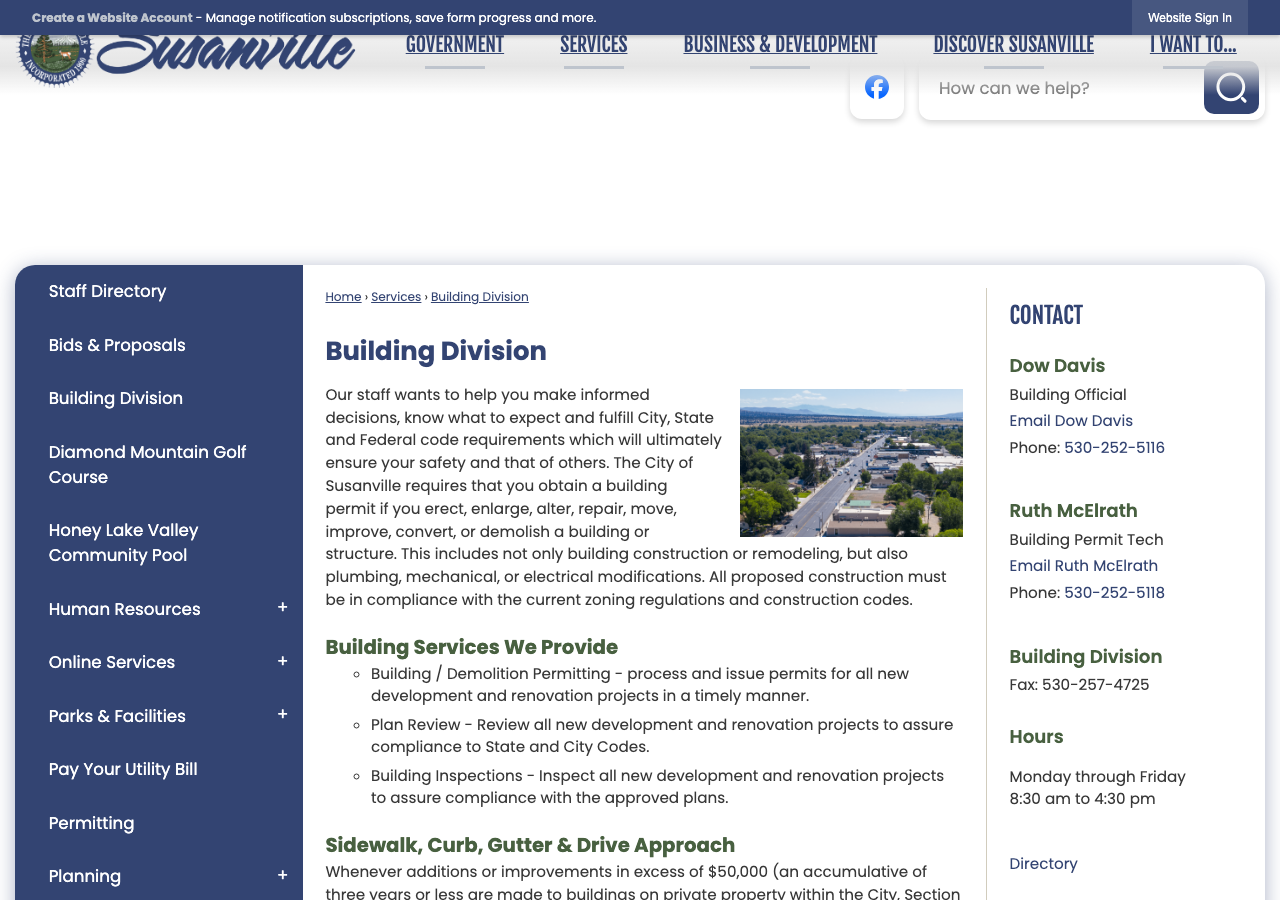

Why the confidence is not higherCity's own Building Division page and its Building Permit Application form show the city issuing and inspecting building/electrical/mechanical/plumbing permits directly, distinct from Lassen County's separate Planning and Building Services department.
department page checked 2026-08-30 https://www.cityofsusanville.gov/196/Building-Division
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherThe city's own Building Permit Application form has fee lines for Building, Electrical, Mechanical and Plumbing all issued by the same Building Division; nothing is shown as delegated.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity's FY25-26 fee schedule lists a 'Solar Permit Online Application Fee' and 'Minimum permit fee' specific to solar, and the Building Division FAQ states a permit is required for electrical system work generally.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherFee schedule shows one 'Solar Permit Online Application Fee' ($35) plus one 'Minimum permit fee' ($69) noted as run through 'SolarApp+ Fee Schedule' — SolarApp+ issues a single combined building+electrical permit for eligible systems — but the same schedule also carries separate generic Electrical/Mechanical/Plumbing/Building application-fee lines, so it is not certain solar always uses only the combined route.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Licensed electrician
Why the confidence is not higherThis is state law (CSLB), not a Susanville-specific rule: the city's Building Permit Application only requires the applicant to affirm a valid CA contractor license under Business & Professions Code §7000 et seq. (C-10 or C-46 for the electrical scope); no city-specific electrician rule was found.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherThe Building Permit Application has a required field for 'City of Susanville Business License No.' for the contractor, in addition to the CA state license number field.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherThe Building Permit Application includes a formal 'Owner-Builder's Declaration' (Section 1B) allowing the property owner to be the permit holder of record.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q8 What documents make up a complete submittal? Core Submittal package
No solar-specific submittal checklist is published; the general Plan Check Submittal Requirements handout applies (site/plot plan, architectural/structural plans, permit application, subcontractors list, owner-builder form if applicable). Solar-specific projects processed via SolarApp+ instead use that portal's own equipment-and-design questionnaire in place of full construction documents.
Why the confidence is not higherSearched the city's own general Plan Check Submittal Requirements PDF (undated stamp, references only 2022 code editions) — it lists no solar-specific line items. Repeated targeted searches for a Susanville-specific PV checklist ('solar checklist', 'photovoltaic', 'one-line diagram') returned no city document, only other jurisdictions' checklists.
checklist checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/150/Plan-Check-Submittal-Form-PDF
Q9 How many copies, and in what format? Submittal package
General building permits: four (4) complete sets of plans plus one 11x14 reduced set; solar via SolarApp+ is submitted digitally through the online portal instead of paper sets.
Why the confidence is not higherFigure is from the general Plan Check Submittal Requirements handout, which is not solar-specific and is undated relative to the Dec 2025 code-adoption ordinance.
checklist checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/150/Plan-Check-Submittal-Form-PDF
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — general submittal doc requires a site/plot plan showing lot dimensions, structure orientation, meters/point of connection, easements, drainage, and (for solar-relevant items) electrical service equipment size and location.
Why the confidence is not higherThis is the general building plan-check requirement, not a solar-specific site-plan spec; no dedicated PV site-plan checklist was found.
checklist checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/150/Plan-Check-Submittal-Form-PDF
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherNot stated on a city document, but the utility (LMUD), which every interconnecting system must satisfy, requires a single-line drawing depicting the PV AC disconnect location as part of its application, and the city's general plan requirements ask for 'relevant information on plumbing, mechanical and electrical components.'
utility DG manual checked 2026-08-30 https://www.lmud.org/new-construction/renewable-energy-projects/distributed-customer-generation/
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedCity's general Plan Check Submittal Requirements PDF (DocumentCenter/View/150) and repeated targeted searches for a Susanville PV/solar checklist; no string or conductor calculation requirement is separately stated anywhere city-side.
https://www.cityofsusanville.gov/DocumentCenter/View/150/Plan-Check-Submittal-Form-PDF
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedPlan Check Submittal Requirements PDF gives a general structural-calc trigger ('If ground snow loads exceeds 50 PSF a licensed professional must submit construction documents') but this is a general building-design threshold, not a solar-specific PE-stamp rule, and no PE-stamp threshold specific to PV racking/attachment was found in any Susanville document.
https://www.cityofsusanville.gov/DocumentCenter/View/150/Plan-Check-Submittal-Form-PDF
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedSearched Building Division page, fee schedule, and Plan Check Submittal Requirements PDF for any electrical PE-stamp threshold; none found; CA residential PV under NEC 690 typically does not require one.
Q15 What does a residential solar permit cost? Core Fees
$104 minimum for solar ($35 SolarApp+ online application fee + $69 minimum permit fee), plus payment-processor convenience fees (credit/debit/wallet: $0.30 + 2.9%; ACH: 0.8%, capped at $5.00)
Why the confidence is not higherCity's own FY2025-26 adopted fee schedule (Exhibit A) lists these as distinct solar line items, cross-referenced to 'SolarApp+ Fee Schedule'. Larger systems needing standard plan review would add the generic Electrical ($60 application + $138 permit) fees instead.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q16 How is the fee calculated? Core Fees
Flat
Why the confidence is not higherSolar-specific line items in the fee schedule are flat dollar amounts ($35 + $69), not tied to system valuation or kW/panel count.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q17 Is there a separate plan-check fee? Fees
No (for SolarApp+-eligible systems)
Why the confidence is not higherThe fee schedule's solar line items are only the $35 online application fee and $69 minimum permit fee — no separate solar plan-check line appears, consistent with SolarApp+ bypassing manual plan review. The city's general policy elsewhere states plan-check fees are 65% of permit cost, but that appears to apply to conventional (non-SolarApp+) building permits.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Not published as a stated turnaround; SolarApp+, which the city uses for eligible residential PV, issues automated same-day approval
Why the confidence is not higherNo Susanville document states a plan-review turnaround time; inference is based on SolarApp+'s standard automated same-day review for code-compliant systems, referenced only indirectly via the fee schedule's 'SolarApp+ Fee Schedule' citation.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q19 How long is an issued permit valid before it expires? Timeline & validity
180 days
Why the confidence is not higherThe city's own Building Permit Application form states: 'This permit shall become invalid unless work...is commenced within 180 days after its issuance, or if...suspended or abandoned for a period of 180 days...Section 105.5 California Building Code.' This is the general CBC rule, not solar-specific, but applies to all city-issued building permits including solar.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q20 Which permit portal does this authority use? Core Portal & process
SolarApp+ (for eligible residential rooftop PV); conventional/paper permits otherwise handled at the Building and Planning counter at City Hall
Why the confidence is not higherThe city's own adopted fee schedule ties the 'Solar Permit Online Application Fee' explicitly to the 'SolarApp+ Fee Schedule.' No dedicated city landing page or link to the SolarApp+ portal was found, and Susanville was not found on any public jurisdiction list of SolarApp+ adopters — the fee-schedule citation is the only direct evidence.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q21 Can the whole application be completed online? Core Portal & process
Yes, for SolarApp+-eligible systems
Why the confidence is not higherSolarApp+ by design allows complete online application, instant compliance check, and permit issuance for qualifying systems; the city's fee schedule confirms SolarApp+ use but does not itself describe the online workflow, so this is partly inferred.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q22 Which utility handles interconnection here? Core Utility interconnection
Lassen Municipal Utility District (LMUD) — a publicly owned, community-governed municipal utility district serving Susanville and most of Lassen County
Why the confidence is not higherConfirmed from LMUD's own site (net metering tariff, interconnection agreement addressed to LMUD, 65 S. Roop St, Susanville) rather than a ZIP-code lookup tool. PacifiCorp does not appear to serve the Susanville city limits based on LMUD's stated near-2,000-sq-mi service territory covering the city.
utility rate schedule checked 2026-08-30 https://www.lmud.org/faqs/net-metering-special-conditions/
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel, with cross-requirements: LMUD requires a completed application ($300 fee) including the building permit as a checklist item before it will approve interconnection, but LMUD's own sequence chart lists 'LMUD application approval' before 'City/County building permit obtained,' and final energization requires both the city's final inspection AND a separate LMUD final interconnection inspection.
Why the confidence is not higherLMUD's own Distributed/Customer Generation page gives an explicit numbered sequence, but the document is internally ambiguous about which comes strictly first (the application checklist references the building permit as a required attachment, yet the sequence chart lists LMUD approval before permit).
utility DG manual checked 2026-08-30 https://www.lmud.org/new-construction/renewable-energy-projects/distributed-customer-generation/
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No requirement found from the city
Why the confidence is not higherNo Susanville ordinance requiring HOA/architectural approval prior to a solar permit was found in the zoning or building chapters searched; California Civil Code §714 (Solar Rights Act) in any case limits HOA power to block solar. Absence inferred from search of zoning provisions, not a direct city statement.
ordinance checked 2026-08-30 https://ecode360.com/44219533
Q25 Is there a historic-district review? Overlays & special cases
No solar-specific trigger found
Why the confidence is not higherSusanville's Municipal Code has a 'Historic Building Preservation' chapter (Title 15), but no reference linking it to solar/PV installations was found in searches of that chapter's content via search-engine indexing; direct chapter fetch is blocked (eCode360 403s).
ordinance checked 2026-08-30 https://ecode360.com/44217953
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherCalifornia does not use a Texas-style windstorm-certification regime; the city's own Plan Check Submittal Requirements handout gives a design wind load (110 mph, 3-second gust, Exposure B/C) as an engineering input, not a separate certification requirement.
checklist checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/150/Plan-Check-Submittal-Form-PDF
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
No — not required for a standard residential rooftop PV system
Why the confidence is not higherNo Susanville ordinance was found requiring Council or Use Permit approval for residential rooftop solar specifically; inferred from absence in the zoning General Provisions/Special Uses chapter, which does address solar equipment height exceptions without requiring discretionary approval for that exception.
ordinance checked 2026-08-30 https://ecode360.com/44219533
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No specific residential system-size cap identified; the zoning code exempts roof-mounted solar equipment from the district height limit outright, rather than capping capacity
Why the confidence is not higherFound via search-engine indexing of Susanville's zoning General Development Standards ('Roof structures for solar equipment may be erected above height limits...'); direct chapter fetch is blocked (eCode360 403s), so this is a secondary-source confirmation, not a direct read.
ordinance checked 2026-08-30 https://ecode360.com/44219443
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC (adopted as part of the 2025 California Electrical Code) 72% · adopting ordinance (indexed via search cache)
- Which building code edition is in force? 2025 California Building Code (Title 24, Parts 1 & 2), with local Appendices C, G, H, I, J 72% · adopting ordinance (indexed via search cache)
- Which fire code edition is in force? 2025 California Fire Code, with Appendices B, BB, C, CC, D, E, F, G, H, I, J, K, L, M, N, O, P, Q and Appendix Chapter 4 adopted 70% · adopting ordinance (indexed via search cache)
- Are there local amendments to any of the above? Yes 75% · adopting ordinance (indexed via search cache)
- What is the installation judged against? The adopted 2025 CBC/CRC/CEC/CFC (with the city's appendix amendments); Susanville's zoning code separately states rooftop PV 'shall be installed in accordance with the State Fire Marshal safety regulations and guidelines' — i.e., no separate city technical standard beyond the state-adopted codes. 70% · ordinance (indexed via search cache)
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? No local ridge-setback/pathway rule beyond the state code: Susanville's zoning code explicitly defers rooftop PV to 'State Fire Marshal safety regulations and guidelines' (i.e., the unamended CRC R324/CFC 605.11 pathway and setback requirements), with no additional city-specific pathway spec found. 60% · ordinance (indexed via search cache)
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes, per NEC 690.12 as adopted in the 2025 California Electrical Code (no local amendment found) 65% · adopting ordinance (indexed via search cache)
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
Nothing recorded for City of Susanville on this step yet — 6 questions checked and found unpublished. The guidance above is general.
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? The PV AC disconnect must be visible and located within 10 feet of the utility (LMUD) meter 85% · utility DG manual
- Must equipment be on a specific approved list? Yes — equipment must be listed (UL/NRTL) as required generally by the adopted NEC/CEC (Article 690); no additional city-specific approved-products list was found 55% · adopting ordinance (indexed via search cache)
- Are batteries permitted, and under what conditions? Yes, under the state-adopted 2025 California Fire Code's energy-storage-system provisions; no Susanville-specific battery/ESS ordinance or restriction was found 50% · adopting ordinance (indexed via search cache)
20 questions answered against City of Susanville’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC (adopted as part of the 2025 California Electrical Code)
Why the confidence is not higherSearch-engine indexing of Susanville's eCode360 Chapter 15.04/15.16/15.20 shows adoption of the '2025 Edition' California Electrical Code (which is based on NFPA 70 2023) via Ordinance 25-1050 (adopted 3 Dec 2025). Direct fetch of the chapter 403s even with the iccsafe.org Referer bypass, and the static /laws/ PDF retrieved (Ordinance 24-1044) was a different, zoning-only ordinance, not this one — so this is a secondary-source (Google-cached) reading of the primary text, not a direct one.
adopting ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44217558
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (Title 24, Parts 1 & 2), with local Appendices C, G, H, I, J
Why the confidence is not higherSame access limitation as q29: confirmed via search-engine snippets of the eCode360 chapter (44217558/44217554), citing Ordinance 25-1050 (3 Dec 2025). Could not directly fetch/pdftotext the ordinance itself — the static /laws/ PDF located and downloaded was Ordinance 24-1044 (a zoning ordinance), not the code-adoption ordinance.
adopting ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44217554
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code, with Appendices B, BB, C, CC, D, E, F, G, H, I, J, K, L, M, N, O, P, Q and Appendix Chapter 4 adopted
Why the confidence is not higherSame search-engine-cache limitation as q29/q30; ecode360 chapter fetch 403s directly.
adopting ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44217558
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherThe city adopts specific appendices of the CBC and CFC by reference (a local amendment technique) via Ordinance 25-1050, and separately retains the 1997 Uniform Code for the Abatement of Dangerous Buildings; also note the general Plan Check handout still cites 2022 code editions, which is itself evidence the city has not fully synchronized all public-facing documents to the Dec 2025 adoption.
adopting ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44217554
Q33 What is the installation judged against? Core Electrical
The adopted 2025 CBC/CRC/CEC/CFC (with the city's appendix amendments); Susanville's zoning code separately states rooftop PV 'shall be installed in accordance with the State Fire Marshal safety regulations and guidelines' — i.e., no separate city technical standard beyond the state-adopted codes.
Why the confidence is not higherConfirmed via search-engine snippet of Susanville zoning Chapter 17.104 (General Provisions, Conditions, Exceptions and Special Uses); direct chapter fetch 403s.
ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44219533
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedSearched eCode360 (via search-engine cache, since direct fetch 403s) for Chapter 15.04/15.16/15.20 and zoning chapters for any local service-upgrade or busbar-sizing amendment; none found beyond the base 2025 CEC adoption.
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedSearched zoning General Development Standards chapter and eCode360 building chapters for a specific mounting-system/attachment-spacing rule; only found the height-exemption clause for roof-mounted solar equipment, no attachment-spacing spec.
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
No local ridge-setback/pathway rule beyond the state code: Susanville's zoning code explicitly defers rooftop PV to 'State Fire Marshal safety regulations and guidelines' (i.e., the unamended CRC R324/CFC 605.11 pathway and setback requirements), with no additional city-specific pathway spec found.
Why the confidence is not higherBased on the same Chapter 17.104 search-engine snippet; no separate fire-department bulletin with different numbers was found in repeated searches.
ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44219533
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes, per NEC 690.12 as adopted in the 2025 California Electrical Code (no local amendment found)
Why the confidence is not higherInferred from the 2025 CEC adoption (q29/q30); no Susanville-specific rapid-shutdown bulletin or amendment was located.
adopting ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44217558
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSearched Susanville's fee schedule, Building Division page, and eCode360 (via search cache) for any city-specific service-equipment placard spec; none found. LMUD's interconnection agreement and DG page also specify a disconnect location but no placard wording.
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSearched eCode360 (via search cache) for 'placard' across Susanville's code; no hits relevant to solar. Zoning Chapter 17.104 only references deferring to 'State Fire Marshal safety regulations,' with no city-authored wording.
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSame search as q39 for placard letter height/colour/material spec — no city-specific spec found.
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedNo Susanville-specific facility-map/site-plan placard rule (beyond NEC 705.10 as incorporated via the 2025 CEC) was found in the Building Division page, fee schedule, or Plan Check handout.
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedReviewed LMUD's Distributed/Customer Generation page and its full Interconnection and Purchase Agreement (LMUD-CUSTOMER-GENERATION-INTERCONNECTION-AGREEMENT-Ver-04-03-19.pdf, extracted with pdftotext) end to end; the agreement covers billing, metering, access and indemnity but has no placard/labeling clause beyond the disconnect-location note already captured at q48.
Q43 Where must the labels be placed? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedNo city or LMUD document states a general label-placement rule beyond the AC-disconnect location captured at q48.
https://www.lmud.org/new-construction/renewable-energy-projects/distributed-customer-generation/
Q44 Must equipment be on a specific approved list? Equipment listing
Yes — equipment must be listed (UL/NRTL) as required generally by the adopted NEC/CEC (Article 690); no additional city-specific approved-products list was found
Why the confidence is not higherInferred from standard NEC listing requirements incorporated by the city's code adoption; no Susanville-specific equipment list or bulletin was found.
adopting ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44217558
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, under the state-adopted 2025 California Fire Code's energy-storage-system provisions; no Susanville-specific battery/ESS ordinance or restriction was found
Why the confidence is not higherInferred from the fire code adoption; searches for a Susanville-specific battery/ESS ordinance or bulletin returned nothing beyond the general fire-code chapter reference.
adopting ordinance (indexed via search cache) checked 2026-08-30 https://ecode360.com/44217558
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Nothing published by this authority.
Where we lookedReviewed the full FY2025-26 fee schedule line by line (grepped for 'battery', 'storage', 'ESS', 'generator') — found a 'Generator installation permit' service type on the Building Division page but no distinct battery/ESS permit fee or process; not enough to state a confident Yes/No.
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedSearched zoning General Development Standards and Special Uses chapters (via search-engine cache) for ground-mount PV treatment; found only the roof-mounted equipment height exemption, nothing addressing ground-mounted systems as accessory structures.
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
The PV AC disconnect must be visible and located within 10 feet of the utility (LMUD) meter
Why the confidence is not higherStated directly on LMUD's own Distributed/Customer Generation page (single-line-drawing requirement: 'a PV(A/C) DISCONNECT VISABLE [sic] WITHIN 10FT OF THE UTILITY METER').
utility DG manual checked 2026-08-30 https://www.lmud.org/new-construction/renewable-energy-projects/distributed-customer-generation/
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone 88% · permit form
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 80% · department page
- If delegated, to whom? Not delegated — City of Susanville Building Division inspects directly; LMUD separately performs its own utility-side final interconnection inspection before energization/PTO 78% · utility DG manual
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? General building-permit sequence per the city's own Inspection Record form: setback/excavation, foundation, groundwork/underground (plumbing/electrical/mechanical), framing, wall covering, roof, then Final (electric/plumbing, mechanical, building, fire, etc.). A rooftop-only PV retrofit would typically only need the Electrical rough-in (if any) and Final inspection stages from this list. 55% · permit form
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? No 55% · department page
- What must be on site at inspection? Not solar-specific, but the general rule (posted on the city's inspection record) is that work must not be covered until approved and the contractor/homeowner must be present for all inspections; standard practice under the adopted CBC §105.4 requires the approved plans and permit to be available on site. 50% · permit form
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (building inspector sign-off on the Building Permit Inspection Record); no separate Certificate of Occupancy is issued for a retrofit rooftop PV addition to an existing single-family home 55% · permit form
- Who notifies the utility for PTO? Installer (customer-generator side) 55% · utility DG manual
- Is there a re-inspection fee? $93.00 88% · fee schedule
14 questions answered against City of Susanville’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone
Why the confidence is not higherThe city's own Building Permit & Application form/inspection record states: 'TO SCHEDULE AN INSPECTION, PLEASE CALL (530) 252-5118.'
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedCity's Building Permit Application inspection-record page and Building Division department page; neither states a minimum notice period for scheduling an inspection.
https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedSame documents as q50; no mention of same-day or AM/PM inspection windows.
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherThe city's own Building Division performs building/electrical inspections per its department page and the inspection-record section of its own permit form; LMUD separately performs its own utility-side pre-inspection and final interconnection inspection, but that is in addition to, not instead of, the city's inspection.
department page checked 2026-08-30 https://www.cityofsusanville.gov/196/Building-Division
Q53 If delegated, to whom? Core Who inspects
Not delegated — City of Susanville Building Division inspects directly; LMUD separately performs its own utility-side final interconnection inspection before energization/PTO
Why the confidence is not higherCombines the city's own department page/permit form (city inspects) with LMUD's published sequence, which shows a distinct 'LMUD final interconnection inspection' step after the city's final inspection.
utility DG manual checked 2026-08-30 https://www.lmud.org/new-construction/renewable-energy-projects/distributed-customer-generation/
Q54 Which inspections are required, and in what order? Core Stages & sequence
General building-permit sequence per the city's own Inspection Record form: setback/excavation, foundation, groundwork/underground (plumbing/electrical/mechanical), framing, wall covering, roof, then Final (electric/plumbing, mechanical, building, fire, etc.). A rooftop-only PV retrofit would typically only need the Electrical rough-in (if any) and Final inspection stages from this list.
Why the confidence is not higherThis is the general-purpose inspection checklist printed on the back of the city's Building Permit Application; it is not solar-specific, so the applicability of each stage to a PV-only job is an inference.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedCity's general Inspection Record lists 'Groundwork/Underwork - Electrical' and 'Framing - Electrical' stages for new construction, but no document specifically states whether a rough-in/mid-roof inspection is required for a rooftop PV retrofit on an existing home.
https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q56 Does the inspector verify labels and listings? Core What is checked
Nothing published by this authority.
Where we lookedNo city document states inspector practice regarding verifying equipment labels/listings at final; Building Division page and permit form are silent on this specific point.
Q57 Is there a published inspection checklist? Core What is checked
No
Why the confidence is not higherNo published solar-specific inspection checklist was found in the city's Document Center listings (which do include a general Plan Check Submittal Requirements doc, a fire-sprinkler handout, and a subcontractors-list form, but nothing titled as an inspection checklist for PV).
department page checked 2026-08-30 https://www.cityofsusanville.gov/196/Building-Division
Q58 What must be on site at inspection? Core Documents on site
Not solar-specific, but the general rule (posted on the city's inspection record) is that work must not be covered until approved and the contractor/homeowner must be present for all inspections; standard practice under the adopted CBC §105.4 requires the approved plans and permit to be available on site.
Why the confidence is not higherThe city's Building Permit Application inspection-record page states 'THE CONTRACTOR AND/OR HOME OWNER MUST BE PRESENT FOR ALL INSPECTIONS AND FINALS' and 'DO NOT COVER ANY ITEMS UNTIL APPROVED,' but does not separately list required on-site documents for a solar job.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q59 Is there a re-inspection fee? Corrections & re-inspection
$93.00
Why the confidence is not higherCity's FY2025-26 adopted fee schedule lists 'Re-inspection fees: $93.00 (.9hrs (Building Official) plus .5hrs (Permit Tech)) (Fee allowed by Ord 02-886).' Not solar-specific but applies city-wide to all permit types including solar.
fee schedule checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/973/Rates-and-Fees-Worksheet-ADOPTED-FY-25-26pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Nothing published by this authority.
Where we lookedNo city document describes the correction-notice/clearance process in any detail beyond the general 'do not cover until approved' instruction on the inspection record.
https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q61 What is issued on pass? Core Final sign-off & PTO
Final (building inspector sign-off on the Building Permit Inspection Record); no separate Certificate of Occupancy is issued for a retrofit rooftop PV addition to an existing single-family home
Why the confidence is not higherInferred from the structure of the city's own Building Permit Inspection Record form, which ends in a 'FINAL INSPECTION' block signed by the inspector; no city document specifically addresses what is issued for a solar-only permit.
permit form checked 2026-08-30 https://www.cityofsusanville.gov/DocumentCenter/View/161/Building-Permit-Application-PDF
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer (customer-generator side)
Why the confidence is not higherLMUD's published interconnection sequence has the customer/installer contact LMUD to schedule the final interconnection inspection after the city's final inspection is approved, which is the step that leads to PTO/energization; no document states the city itself notifies LMUD.
utility DG manual checked 2026-08-30 https://www.lmud.org/new-construction/renewable-energy-projects/distributed-customer-generation/
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Susanville against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Susanville is the authority having jurisdiction 90% confidence
- Holds
- Building and Electrical
- Why not higher
- City of Susanville operates its own Building Division (66 N. Lassen St; Building Official Dow Davis, 530-252-5116) that issues building, electrical, mechanical and plumbing permits and performs inspections — this is a distinct department from Lassen County's Planning and Building Services (707 Nevada St, Ste 5), which serves only the unincorporated county. Susanville also operates its own Fire Department (independent of CAL FIRE Lassen-Modoc, mutual aid only), so fire-code enforcement is also city-held, not delegated. No evidence found that any function is contracted out to the county or a private firm.
- Permit required
- Yes92%
- Permit cost
- $104 minimum for solar ($35 SolarApp+ online application fee + $69 minimum permit fee), plus payment-processor convenience fees (credit/debit/wallet: $0.30 + 2.9%;88%
- Plan review
- Not published as a stated turnaround; SolarApp+, which the city uses for eligible residential PV, issues automated same-day approval55%
- Portal
- SolarApp+ (for eligible residential rooftop PV); conventional/paper permits otherwise handled at the Building and Planning counter at City Hall78%
- Electrical code
- 2023 NEC (adopted as part of the 2025 California Electrical Code)72%
- Booking an inspection
- Phone88%
Labels & placards for this authority
Wording None%
Size, colour & material None%
Where they go None%
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
