City of Walnut Creek

Contra Costa County

Verified Aug. 5, 2026

City of Walnut Creek is a city authority in the State of California, serving 70,127 residents. 5,772 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes. Q3 Electrical and building permits — Combined. Q4 Plan review — 3–7 business days for the ministerial/'over-the-counter' path that a standard single-family solar permit falls under (per the current Turnaround Times page). Q18 Where you file — Accela Citizen Access (the city's 'ACA Portal', aca-prod.accela.com/WC). Q20

Permit required
Yes.95% source
What it costs
$280.00 flat (FY2026 and FY2027) for a Single Family and Duplex Residential solar PV system.95% source
Plan review turnaround
3–7 business days for the ministerial/'over-the-counter' path that a standard single-family solar permit falls under (per the current Turnaround Times page).75% source
Key document
authority's own bulletin — inference cited by 9 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes. 95% · authority's own page
    • What does this authority permit itself, and what does it delegate? Both (Building and Electrical, combined into one unified permit for single-family/duplex PV). Fire life-safety review/inspection is held separately by Contra Costa County Fire Protection District (Con Fire), but IB-025 states Con Fire performs NO separate review/inspection for eligible small residential PV systems (city just sends notice). 88% · fee schedule + authority's own bulletin
    • Is a permit required for a residential rooftop PV system? Yes. 95% · authority's own page
    • Is there a separate electrical permit, or is it combined? Combined. 95% · fee schedule
    • Is a HOA or architectural approval required first? No dedicated HOA/architectural-approval precondition was found for rooftop PV. The city's Design Review process (Ministerial/Objective/Discretionary) is triggered by new dwelling-unit construction or additions requiring a legislative amendment — a rooftop PV retrofit on an existing home is not among its listed triggers. 60% · authority's own page — absence
    • Is a wind or windstorm certification required? No wind/windstorm certification requirement was found on any city solar, building-code, or fee-schedule page reviewed — consistent with Walnut Creek's inland (non-coastal) location, where this is not a typical California requirement. 50% · authority's own bulletin — absence
    • Is a Specific Use Permit or Council approval ever required? Not found required for a standard residential rooftop PV system. No Specific Use Permit, Conditional Use Permit, or City Council approval step appears on the Solar/Electrical page, IB-025, or the Design Review page for PV specifically. 55% · authority's own page — absence
    • Is there a system-size cap on residential generation? No blanket system-size cap. The city's expedited/streamlined permitting path (from IB-025) is limited to systems of 10 kW AC (CEC rating) or less, roof-mounted on a one/two-family dwelling, without battery storage, and within height limits — but systems above that threshold are not prohibited, only routed to standard (non-expedited) plan review. 68% · authority's own bulletin
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Who is allowed to pull the electrical permit? Either — the property owner or a California-licensed contractor. 85% · authority's own page
    • Must the contractor be registered with this authority before applying? No dedicated city contractor-registration requirement was found beyond the state CSLB license implied by the FAQ's 'California licensed contractor' language. Contractors doing business in the city may separately need the city's general Business License (a business-tax registration, not a permit-eligibility gate), but no page found ties that to permit issuance. 55% · authority's own page — absence
    • Is a homeowner permitted to self-install and self-permit? Yes. 82% · authority's own page
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Per Information Bulletin IB-025 ('Submittal Requirements for Photovoltaic Array Systems'): (1) Plot Plan/Title Sheet (address, owner, existing buildings, setbacks, easements, panel locations, output capacity in kW); (2) Construction Plans (roof/structure plan showing PV layout and attachment, elevations showing electrical equipment locations); (3) Battery Bank plan if applicable; (4) Electrical Plan (one-line diagram, overcurrent protection, module/string counts, inverter make/model, grounding/bonding, equipment cut sheets, CEC 690/705 labeling); (5) Structural Support information (roof covering, framing, weight, attachment method, racking system documentation). 92% · published checklist
    • How many copies, and in what format? Not stated for solar specifically in current form. As of 2026 the city states it is 'fully committed to an all-online permitting system' and 'no longer accept[s] paper or emailed permit applications' — so submittal is now digital-only via the Accela portal. The 2018 IB-025 bulletin (still the linked solar checklist) predates this shift and does not specify a copy count for solar; the related 2021 battery-storage bulletin PB-074 specifies 'Minimum plan size is 11”x17”, 3 full sets of plans and 2 sets of supporting documents' — a physical-submittal instruction that the 2026 online-only policy appears to have superseded. 55% · authority's own page — dated bulletins conflict with current practice
    • Is a site plan required, and what must it show? Yes — a Plot Plan/Title Sheet showing: property address and owner; all existing buildings/accessory footprints; trees and drip lines; private sewer/septic and well locations; parcel property lines; setbacks; north arrow; easements; PV panel locations; and system output capacity in kW. 92% · published checklist
    • Is a one-line / three-line diagram required? Yes. 95% · published checklist
    • Are string and conductor calculations required? Effectively yes — the electrical plan must show total module count, modules per string, total strings, and conductor type/size/conduit sizing for every circuit segment, though IB-025 does not use the word 'calculations' as a separate line item. 68% · published checklist — inference
    • Is a structural PE stamp required, and at what threshold? No blanket dollar/size threshold is published. IB-025's Structural Support section requires engineering documentation only conditionally: 'Where a listed or engineer-designed racking system is used, provide documentation showing manufacturer... maximum allowable weight... and product evaluation information or structural design for the rack system' — otherwise a listed racking system's own ICC-ES/manufacturer evaluation report substitutes for a project-specific PE stamp. 58% · published checklist
    • Is an electrical PE stamp required, and at what threshold? For most residential systems, no PE stamp is required if a licensed C-10 electrical contractor designs and signs the drawings; a registered electrical engineer's stamp is an alternative path. IB-025: 'the City of Walnut Creek requires that the system be designed by a registered electrical engineer or licensed electrical contractor, except small residential rooftop solar energy system' (i.e., systems meeting the city's ≤10kW-AC/roof-mount/no-battery streamlined criteria are exempt even from that design-professional-of-record requirement). 78% · authority's own bulletin
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

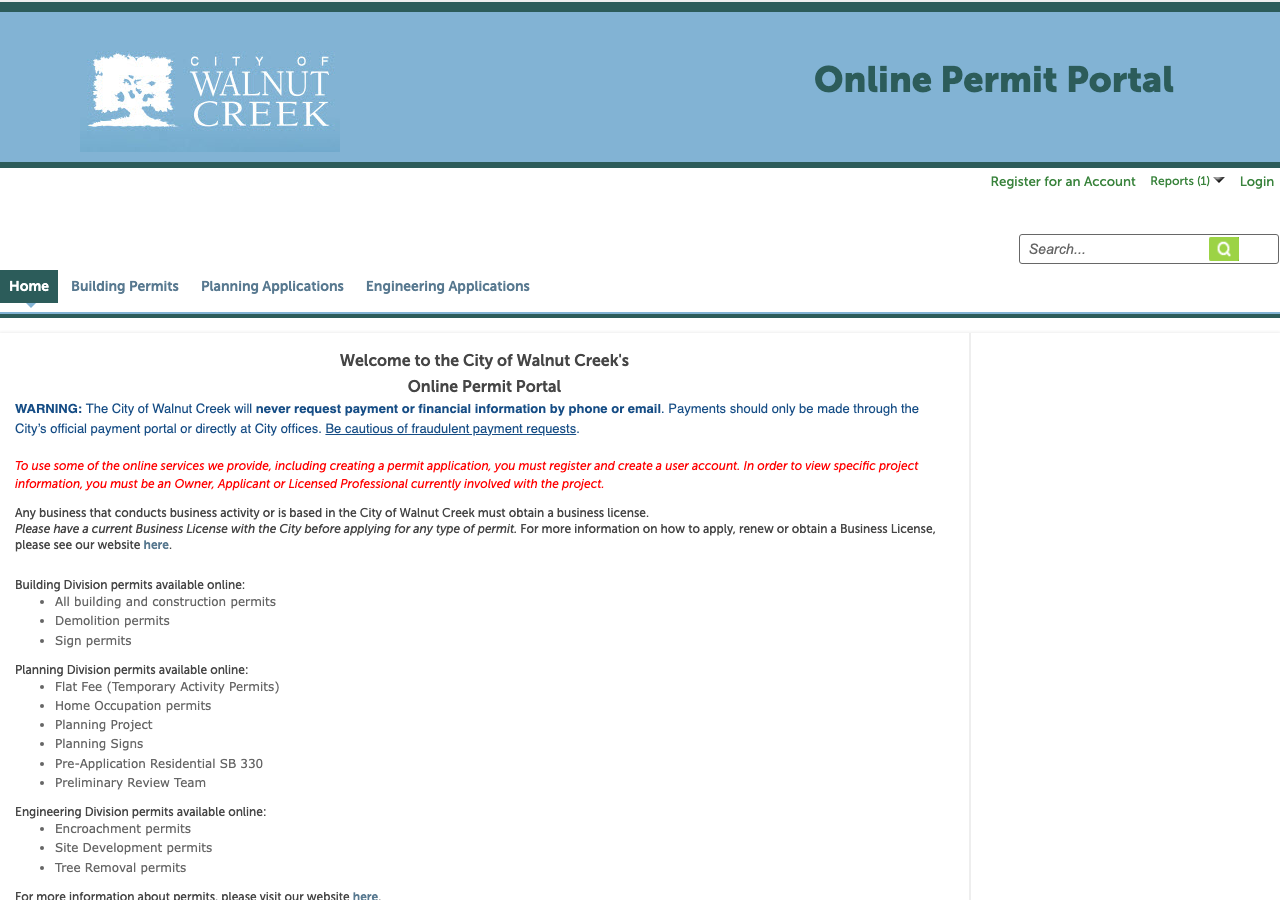

    • Which permit portal does this authority use? Accela Citizen Access (the city's 'ACA Portal', aca-prod.accela.com/WC). 92% · authority's own page
    • Can the whole application be completed online? Yes. 92% · authority's own page
    • What does a residential solar permit cost? $280.00 flat (FY2026 and FY2027) for a Single Family and Duplex Residential solar PV system. 95% · published fee schedule
    • How is the fee calculated? Flat, for single-family/duplex residential (unified $280 permit). Multi-family/non-residential PV instead uses a tiered valuation formula (A + Bx, A=$419.12 fixed + $0.0832/sq ft of panel area). 95% · published fee schedule
    • Is there a separate plan-check fee? No — the $280 fee is explicitly a unified permit that already includes plan checking. 90% · published fee schedule
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? 3–7 business days for the ministerial/'over-the-counter' path that a standard single-family solar permit falls under (per the current Turnaround Times page). The city's older IB-025 bulletin cites a more specific 3-business-day turnaround for electronic applications meeting its small-residential streamlined-PV criteria. 75% · authority's own page
    • Which utility handles interconnection here? PG&E (Pacific Gas and Electric Company) is the interconnecting/wires utility. MCE (Marin Clean Energy, operating as 'MCE Clean Energy') is the default Community Choice Aggregation generation provider for Walnut Creek accounts, per the city's own Solar Incentives page, but MCE does not own the distribution wires or process the physical interconnection application — that remains PG&E's role under the standard CA CCA/IOU split. 82% · authority's own page + authority's own bulletin
    • Where does the utility sit in the sequence? Parallel, functionally — the interconnection application to PG&E can be filed alongside city permitting, but energization/Permission to Operate is withheld until after IB-025's required city final inspection AND PG&E's written interconnection authorization are both in hand. 62% · authority's own bulletin — inference

28 questions answered against City of Walnut Creek’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes.

Why the confidence is not higherCity's own Building Division issues residential building/electrical/plumbing permits including a distinct 'Solar Photovoltaic - Single Family and Duplex Residential' line in its current Master Fee Schedule, and its own Solar/Electrical/Heating/Plumbing page and IB-025 bulletin walk applicants through the city's own submittal and inspection process. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-and-land-use-regulations/solar-electrical-heating-and-plumbing

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both (Building and Electrical, combined into one unified permit for single-family/duplex PV). Fire life-safety review/inspection is held separately by Contra Costa County Fire Protection District (Con Fire), but IB-025 states Con Fire performs NO separate review/inspection for eligible small residential PV systems (city just sends notice).

Why the confidence is not higherMaster Fee Schedule FY26&27 labels the residential PV fee 'Unified permit: includes plan checking and the inspection of all electrical, plumbing, and other related work.' IB-025 (city bulletin) states: 'The city will perform plan review and inspections on small residential installations and notice of the installation will be sent to the Fire District. No separate review and inspection is required by Fire District.' Con Fire's own fee schedule confirms it bills separately only for Energy Storage System (battery) review, not plain PV. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

fee schedule + authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/32770/638912803924430000

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes.

Why the confidence is not higherBuilding Permit FAQ page lists 'photoelectric solar energy producing systems and components' under 'What work requires a permit?' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-permit-faqs

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined.

Why the confidence is not higherMaster Fee Schedule: 'Solar Photovoltaic - Single Family and Duplex Residential — $280.00 — Unified permit: includes plan checking and the inspection of all electrical, plumbing, and other related work.' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

fee schedule checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/32770/638912803924430000

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either — the property owner or a California-licensed contractor.

Why the confidence is not higherBuilding Permit FAQ: 'Permit issuance requires the signature of the legal property owner or a California licensed contractor. An agent for either party may sign for a permit, provided the agent submits written authorization...' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-permit-faqs

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

No dedicated city contractor-registration requirement was found beyond the state CSLB license implied by the FAQ's 'California licensed contractor' language. Contractors doing business in the city may separately need the city's general Business License (a business-tax registration, not a permit-eligibility gate), but no page found ties that to permit issuance.

Why the confidence is not higherBuilding Permit FAQ ('Who can sign for a permit?') names only property-owner or CA-licensed-contractor signature — no city registration step is mentioned. Checked FAQ, Building Permits, and Permits landing pages; none references a city contractor registry. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page — absence checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-permit-faqs

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes.

Why the confidence is not higherBuilding Permit FAQ confirms the legal property owner may sign and pull the permit directly (owner-builder), without requiring a licensed contractor. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-permit-faqs

Q8 What documents make up a complete submittal? Core Submittal package

Per Information Bulletin IB-025 ('Submittal Requirements for Photovoltaic Array Systems'): (1) Plot Plan/Title Sheet (address, owner, existing buildings, setbacks, easements, panel locations, output capacity in kW); (2) Construction Plans (roof/structure plan showing PV layout and attachment, elevations showing electrical equipment locations); (3) Battery Bank plan if applicable; (4) Electrical Plan (one-line diagram, overcurrent protection, module/string counts, inverter make/model, grounding/bonding, equipment cut sheets, CEC 690/705 labeling); (5) Structural Support information (roof covering, framing, weight, attachment method, racking system documentation).

Why the confidence is not higherIB-025 'Checklist' section, city's own current bulletin linked directly from the live Solar/Electrical/Heating/Plumbing page. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published checklist checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q9 How many copies, and in what format? Submittal package

Not stated for solar specifically in current form. As of 2026 the city states it is 'fully committed to an all-online permitting system' and 'no longer accept[s] paper or emailed permit applications' — so submittal is now digital-only via the Accela portal. The 2018 IB-025 bulletin (still the linked solar checklist) predates this shift and does not specify a copy count for solar; the related 2021 battery-storage bulletin PB-074 specifies 'Minimum plan size is 11”x17”, 3 full sets of plans and 2 sets of supporting documents' — a physical-submittal instruction that the 2026 online-only policy appears to have superseded.

Why the confidence is not higherBuilding Permits page (current, 2026) states permits are all-online now; IB-025 (2018) and PB-074 (2021) predate that policy and give physical set-count instructions instead. Flagging the contradiction rather than resolving it silently. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page — dated bulletins conflict with current practice checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes — a Plot Plan/Title Sheet showing: property address and owner; all existing buildings/accessory footprints; trees and drip lines; private sewer/septic and well locations; parcel property lines; setbacks; north arrow; easements; PV panel locations; and system output capacity in kW.

Why the confidence is not higherIB-025 Checklist, item 1 (Plot Plan/Title Sheet). (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published checklist checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes.

Why the confidence is not higherIB-025 Electrical Plan requirements explicitly list 'One-line diagram of system' as a required submittal item. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published checklist checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q12 Are string and conductor calculations required? Drawings & calculations

Effectively yes — the electrical plan must show total module count, modules per string, total strings, and conductor type/size/conduit sizing for every circuit segment, though IB-025 does not use the word 'calculations' as a separate line item.

Why the confidence is not higherIB-025 Electrical Plan section: 'Total number of modules, number of modules per string, and the total number of strings'; 'Specify grounding/bonding, conductor type and size, conduit type and size, and number of conductors in each section of conduit.' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published checklist — inference checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

No blanket dollar/size threshold is published. IB-025's Structural Support section requires engineering documentation only conditionally: 'Where a listed or engineer-designed racking system is used, provide documentation showing manufacturer... maximum allowable weight... and product evaluation information or structural design for the rack system' — otherwise a listed racking system's own ICC-ES/manufacturer evaluation report substitutes for a project-specific PE stamp.

Why the confidence is not higherIB-025 'Structural Support' checklist section — no fixed valuation or system-size threshold stated; PE involvement is conditional on the racking system chosen, not a bright-line trigger. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published checklist checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

For most residential systems, no PE stamp is required if a licensed C-10 electrical contractor designs and signs the drawings; a registered electrical engineer's stamp is an alternative path. IB-025: 'the City of Walnut Creek requires that the system be designed by a registered electrical engineer or licensed electrical contractor, except small residential rooftop solar energy system' (i.e., systems meeting the city's ≤10kW-AC/roof-mount/no-battery streamlined criteria are exempt even from that design-professional-of-record requirement).

Why the confidence is not higherIB-025 'General Requirements' item 1, and the bulletin's 'Expedited permitting process for Small residential rooftop solar energy system' section defining the exempt-scale eligibility criteria. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q15 What does a residential solar permit cost? Core Fees

$280.00 flat (FY2026 and FY2027) for a Single Family and Duplex Residential solar PV system.

Why the confidence is not higherCity of Walnut Creek Master Fee Schedule, Fees and Charges for Fiscal Years 2026 & 2027, Community Development - Building Division, Section 4.B 'Solar Photovoltaic - Single Family and Duplex Residential': $280.00 for both FY2026 and FY2027. PDF internal metadata confirms this is the 'FY26&27 - Master Fee Schedule_ALL DEPTS.xlsx' export, created 15 Aug 2025. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published fee schedule checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/32770/638912803924430000

Q16 How is the fee calculated? Core Fees

Flat, for single-family/duplex residential (unified $280 permit). Multi-family/non-residential PV instead uses a tiered valuation formula (A + Bx, A=$419.12 fixed + $0.0832/sq ft of panel area).

Why the confidence is not higherMaster Fee Schedule Section 4.B (flat, residential) and 4.C (formula, multi-family/non-residential). (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published fee schedule checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/32770/638912803924430000

Q17 Is there a separate plan-check fee? Fees

No — the $280 fee is explicitly a unified permit that already includes plan checking.

Why the confidence is not higherMaster Fee Schedule Section 4.B: 'Unified permit: includes plan checking and the inspection of all electrical, plumbing, and other related work.' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

published fee schedule checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/32770/638912803924430000

Q18 What is the stated plan-review turnaround? Core Timeline & validity

3–7 business days for the ministerial/'over-the-counter' path that a standard single-family solar permit falls under (per the current Turnaround Times page). The city's older IB-025 bulletin cites a more specific 3-business-day turnaround for electronic applications meeting its small-residential streamlined-PV criteria.

Why the confidence is not higherTurnaround Times page (current, 2026): '“Over-the counter” permits... The review can take between 3 to 7 days.' IB-025 (2018, still linked): '...a building permit will be issued at the same day for over-the-counter applications or within three (3) business days for electronic applications.' Treated as consistent, not contradictory, since both describe the same simple/ministerial track.

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/turnaround-times

Q19 How long is an issued permit valid before it expires? Timeline & validity

Nothing published by this authority.

Where we lookedBuilding Codes page, Building Permit FAQs, Fees/Rates/Deposits page, and Master Fee Schedule — none states a permit-validity/expiration duration; the Municipal Code (which would carry any local amendment to CBC/CRC §105.5's default) is hosted on eCode360 (WA4684) which returned a Cloudflare 'Just a moment...' 403 challenge to a plain fetch and to a fetch carrying the required iccsafe.org Referer header, and has zero Wayback Machine captures (confirmed via CDX query).

https://ecode360.com/WA4684

Q20 Which permit portal does this authority use? Core Portal & process

Accela Citizen Access (the city's 'ACA Portal', aca-prod.accela.com/WC).

Why the confidence is not higherFees, rates, and deposits page: 'If you are applying for your permit using our online permit system Accela, you must pay by credit card* through the online system. Log-in or register for an account on the ACA Portal.' Link resolves to https://aca-prod.accela.com/WC/Default.aspx. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/fees-rates-and-deposits

Q21 Can the whole application be completed online? Core Portal & process

Yes.

Why the confidence is not higherBuilding Permits page: 'The City of Walnut Creek has fully committed to an all-online permitting system – all permit types shall be applied for via our Online Permit Portal. We are no longer accepting paper or emailed permit applications.' No SolarAPP+ integration was found on this or any other Walnut Creek page reviewed (Solar/Electrical page, Building Permits page, Building Codes page, FAQ) — the city's own Accela ACA Portal is the sole route, not SolarAPP+. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas and Electric Company) is the interconnecting/wires utility. MCE (Marin Clean Energy, operating as 'MCE Clean Energy') is the default Community Choice Aggregation generation provider for Walnut Creek accounts, per the city's own Solar Incentives page, but MCE does not own the distribution wires or process the physical interconnection application — that remains PG&E's role under the standard CA CCA/IOU split.

Why the confidence is not higherCity's own 'Solar Incentives' page (E.C.O. Sustainability department) discusses 'MCE has a generous net energy metering (NEM) program' and 'MCE's Feed-In Tariff program' with no mention of a separate interconnection process — consistent with MCE being generation-only. IB-025 independently states 'PG&E customers must not interconnect their generating facility with the utility's distribution facilities until they receive written authorization from Pacific Gas and Electric Company,' confirming PG&E (not MCE) is the interconnecting party. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page + authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/government/departments/e-c-o-sustainability/incentives/solar-incentives

Q23 Where does the utility sit in the sequence? Core Utility interconnection

Parallel, functionally — the interconnection application to PG&E can be filed alongside city permitting, but energization/Permission to Operate is withheld until after IB-025's required city final inspection AND PG&E's written interconnection authorization are both in hand.

Why the confidence is not higherIB-025: 'PG&E customers must not interconnect their generating facility with the utility's distribution facilities until they receive written authorization from Pacific Gas and Electric Company. Unauthorized interconnections may result in injury...' No city document states the filing order explicitly, so this is inferred from standard CA NEM sequencing plus IB-025's energization caveat. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin — inference checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No dedicated HOA/architectural-approval precondition was found for rooftop PV. The city's Design Review process (Ministerial/Objective/Discretionary) is triggered by new dwelling-unit construction or additions requiring a legislative amendment — a rooftop PV retrofit on an existing home is not among its listed triggers.

Why the confidence is not higherDesign Review page defines Objective/Discretionary Design Review triggers as new dwelling-unit construction, residential mixed-use, or projects needing a legislative amendment; no PV/rooftop-equipment trigger appears anywhere on the page. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page — absence checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/planning-entitlements/design-review

Q25 Is there a historic-district review? Overlays & special cases

Nothing published by this authority.

Where we lookedFull-domain Wayback CDX search (2024-2026 captures) of walnutcreekca.gov for urlkey patterns containing 'historic' or 'preserv' — the only hits were a dead pre-redesign URL ('.../building-division/current-historic-building-codes', old URL structure, not present in current nav) and an unrelated Tree Preservation document. No live 'Historic Preservation Commission' or 'Historic District' page found in current site navigation (Government > Meet Your Government > Commissions & Committees list, which includes Design Review Commission but no historic-preservation body).

https://web.archive.org/cdx/search/cdx?url=walnutcreekca.gov&matchType=domain&output=json&filter=urlkey:.*historic.*

Q26 Is a wind or windstorm certification required? Overlays & special cases

No wind/windstorm certification requirement was found on any city solar, building-code, or fee-schedule page reviewed — consistent with Walnut Creek's inland (non-coastal) location, where this is not a typical California requirement.

Why the confidence is not higherChecked IB-025, PB-074, Building Codes page, Master Fee Schedule, and FAQ — none mentions wind/windstorm certification. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin — absence checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Not found required for a standard residential rooftop PV system. No Specific Use Permit, Conditional Use Permit, or City Council approval step appears on the Solar/Electrical page, IB-025, or the Design Review page for PV specifically.

Why the confidence is not higherChecked Solar/Electrical/Heating/Plumbing page, IB-025, and Design Review page — none lists a discretionary Council/Use-Permit step for rooftop PV; Design Review's Discretionary track is reserved for legislative-amendment projects. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page — absence checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/planning-entitlements/design-review

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No blanket system-size cap. The city's expedited/streamlined permitting path (from IB-025) is limited to systems of 10 kW AC (CEC rating) or less, roof-mounted on a one/two-family dwelling, without battery storage, and within height limits — but systems above that threshold are not prohibited, only routed to standard (non-expedited) plan review.

Why the confidence is not higherIB-025 'Expedited permitting process for Small residential rooftop solar energy system' eligibility list. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2023 NEC, adopted as the basis of the 2025 California Electrical Code, effective for all permit applications submitted on or after January 1, 2026. 96% · adopting regulation — authority's own page
    • Which building code edition is in force? 2025 California Building Code (based on the 2024 International Building Code with State amendments), effective for permit applications from January 1, 2026. 96% · adopting regulation — authority's own page
    • Which fire code edition is in force? 2025 California Fire Code (based on the 2024 International Fire Code with State amendments), per the city's own Building Codes page, effective January 1, 2026 — but Contra Costa County Fire Protection District's own 'Construction and Permitting' page has not yet been updated and still cites the 2022 California Fire Code under 'Ordinance No. 2022-34, Section 105.7.' This is a live code-cycle contradiction between the two authorities' own pages, not resolved here. 68% · adopting regulation — conflicting authority pages
    • Are there local amendments to any of the above? Yes — local amendments exist on both the building and fire sides. The Master Fee Schedule cites 'Section 9-0.5.302b of the City of Walnut Creek Municipal Code' as the local plan-review-fee authority, and Con Fire's own page cites 'Contra Costa County Fire Protection District Ordinance No. 2022-34, Section 105.7' amending the Fire Code. Content of the amendments could not be independently confirmed: Walnut Creek's municipal code is hosted on eCode360 (client WA4684 per codepublishing.com's redirect notice), but eCode360 returns a Cloudflare 'Just a moment...' challenge page (HTTP 403) to both a plain fetch and a fetch carrying the iccsafe.org Referer header, and no Wayback Machine capture of ecode360.com/WA4684 exists (confirmed via direct CDX query, zero results). 68% · fee schedule + fire-district page — amendment content unconfirmed
    • What is the installation judged against? The currently applicable California Electrical Code (2023 NEC-based, 2025 CEC), per IB-025: 'The design and installation must meet the currently applicable California Electrical Code provisions (based on the National Electrical Code).' Inspection is additionally checked against CEC Sections 690 and 705 specifically, per IB-025's own inspection checklist. 85% · authority's own bulletin
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Access pathways are required 'by the California Building and Fire Codes' per the city's own bulletin, which does not restate the dimensional ridge-setback table itself (that content lives in the copyrighted CFC/CRC text, not reproduced on any Walnut Creek page found). 55% · authority's own bulletin — dimensions unretrievable
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Yes — NEC 690.12 rapid shutdown applies under the 2023 NEC as adopted via the 2025 California Electrical Code, in force for all permit applications from January 1, 2026. Not restated by article/section number in any Walnut Creek-specific bulletin found, but the battery-storage bulletin PB-074 independently requires plans to 'Show location and/or method of rapid shutdown initiation of the storage battery system,' confirming the requirement is enforced in practice. 78% · adopting regulation + authority's own bulletin — inference
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? At minimum: (1) a DC-disconnect sign identifying PV power-source system attributes; (2) an AC point-of-connection sign; (3) a sign identifying the alternative-power-system switch (all per IB-025's inspection checklist); (4) a plaque at the main service panel indicating the type and location of all power sources on/in the building, per CEC 705.10 (per battery bulletin PB-074); and (5) where a line/supply-side tap is used, PG&E's own required 'engraved placard (signage), indicating there is a line/supply side connection... installed on the metering equipment' (per PG&E's TD-7001M Greenbook, §6.3.3.a). 85% · authority's own bulletin + utility manual
    • Does the authority specify placard wording of its own? No — the city references the NEC/CEC-mandated signage content (CEC 690/705, 705.10) rather than authoring its own custom placard wording. 62% · authority's own bulletin — absence
    • Is a site plan / facility map placard required, and what must it show? Yes — a plaque/placard at the main service panel indicating the type and location of all power sources on or in the building is required, per CEC 705.10 as cited in the city's own battery-storage bulletin PB-074. 85% · authority's own bulletin
    • Does the UTILITY specify placards beyond the AHJ's? Yes — PG&E's Greenbook (TD-7001M) requires an additional 'engraved placard (signage), indicating there is a line/supply side connection... installed on the metering equipment' whenever a fusible AC disconnect is installed ahead of the main breaker (a line/supply-side tap), on top of whatever the AHJ's own building/fire-code signage requires. 85% · utility manual
    • Where must the labels be placed? At the DC disconnect, at the AC point of connection, and at the alternative-power-system switch (IB-025); a plaque at the main service panel (PB-074/CEC 705.10); and, for line-side-tap installations, an engraved placard on the metering equipment itself (PG&E Greenbook). 82% · authority's own bulletin + utility manual
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Where must the AC disconnect be, relative to the meter? The AC disconnect must sit downstream of (after) the revenue meter and upstream of (ahead of) the main breaker for a line/supply-side-tap connection; it is not required at all for a single-phase, self-contained/socket-based meter panel rated 320A or less serving an inverter-based generator (unless it is a K-base meter panel, which always requires one), per PG&E's Table 6-3. 85% · utility manual
    • Must equipment be on a specific approved list? Yes. 90% · authority's own bulletin
    • Are batteries permitted, and under what conditions? Yes, under detailed conditions set out in the city's own Policy Bulletin PB-074: ESS must comply with CRC §R327 (exception for UL 9540-listed systems under 1 kWh); may only be installed in detached garages/accessory structures, attached garages separated per CRC R302.6, outdoors 3+ feet from doors/windows, or enclosed utility spaces with fire-rated finish (5/8" Type X gypsum where wood-framed); is barred from sleeping rooms and habitable spaces; requires 3-foot unit spacing (or documented large-scale fire-test clearance); requires smoke/heat alarms per CRC R314; and requires impact protection where subject to vehicle damage. 92% · authority's own bulletin
    • Is there a separate ESS permit or inspection? Not a separate PERMIT type at the city Building Division (folded into the same solar/electrical plan-review submittal per PB-074, and the Master Fee Schedule has no distinct ESS fee line item — only 'Solar'). However, Contra Costa County Fire Protection District DOES bill a distinct, separate 'Energy Storage System' plan review: 'Battery Systems/Energy Storage — minimum fee $944.00' plus a 'UL9540A Review — minimum fee $516.00' — with no equivalent standalone PV-only line item anywhere in the same fee schedule. 78% · fire district fee schedule
    • Is there a local rule on service upgrades or busbar sizing? Yes, in effect — IB-025's own inspection checklist restates the NEC/CEC 120%-rule for busbar loading: 'Sum of the main OCPD and the inverter OCPD is rated for not more than 120% of the buss bar rating.' This is a restatement of the national code provision (CEC/NEC 705.12(B)(3)(2)) rather than a Walnut-Creek-specific amendment, but it is the city's own stated inspection criterion. 75% · authority's own bulletin
    • Is a specific mounting system or attachment spacing required? No fixed universal spacing table is published. IB-025 requires project-specific documentation of the mounting/attachment method (roof plan showing PV layout and attachment locations, framing plan/details for any roof-strengthening work, and — where a listed racking system is used — the manufacturer's maximum-load and attachment-method documentation) rather than specifying a citywide spacing standard. 58% · authority's own bulletin

20 questions answered against City of Walnut Creek’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2023 NEC, adopted as the basis of the 2025 California Electrical Code, effective for all permit applications submitted on or after January 1, 2026.

Why the confidence is not higherBuilding Codes page (current, 2026): '2025 California Electrical Code (Based on the National Electrical Code, 2023 Edition with State amendments)... became applicable to all building permit applications made on or after January 1, 2026.' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

adopting regulation — authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-codes

Q30 Which building code edition is in force? Core Code editions in force

2025 California Building Code (based on the 2024 International Building Code with State amendments), effective for permit applications from January 1, 2026.

Why the confidence is not higherBuilding Codes page, same statement as q29. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

adopting regulation — authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-codes

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code (based on the 2024 International Fire Code with State amendments), per the city's own Building Codes page, effective January 1, 2026 — but Contra Costa County Fire Protection District's own 'Construction and Permitting' page has not yet been updated and still cites the 2022 California Fire Code under 'Ordinance No. 2022-34, Section 105.7.' This is a live code-cycle contradiction between the two authorities' own pages, not resolved here.

Why the confidence is not higherCity Building Codes page lists '2025 California Fire Code' as in force from 1 Jan 2026; CCCFPD's Construction and Permitting page (fetched live, 2026) still states 'California Code of Regulations Title 24, Part 9: 2022 California Fire Code and as amended by the Contra Costa County Fire Protection District Ordinance No. 2022-34, Section 105.7' with no visible update.

adopting regulation — conflicting authority pages checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-codes

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes — local amendments exist on both the building and fire sides. The Master Fee Schedule cites 'Section 9-0.5.302b of the City of Walnut Creek Municipal Code' as the local plan-review-fee authority, and Con Fire's own page cites 'Contra Costa County Fire Protection District Ordinance No. 2022-34, Section 105.7' amending the Fire Code. Content of the amendments could not be independently confirmed: Walnut Creek's municipal code is hosted on eCode360 (client WA4684 per codepublishing.com's redirect notice), but eCode360 returns a Cloudflare 'Just a moment...' challenge page (HTTP 403) to both a plain fetch and a fetch carrying the iccsafe.org Referer header, and no Wayback Machine capture of ecode360.com/WA4684 exists (confirmed via direct CDX query, zero results).

Why the confidence is not higherMaster Fee Schedule Plan Review Fees section names Municipal Code §9-0.5.302b; CCCFPD Construction and Permitting page names its own Ordinance 2022-34 §105.7. eCode360 access attempts (live + Referer-header + Wayback CDX) all failed as described.

fee schedule + fire-district page — amendment content unconfirmed checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/32770/638912803924430000

Q33 What is the installation judged against? Core Electrical

The currently applicable California Electrical Code (2023 NEC-based, 2025 CEC), per IB-025: 'The design and installation must meet the currently applicable California Electrical Code provisions (based on the National Electrical Code).' Inspection is additionally checked against CEC Sections 690 and 705 specifically, per IB-025's own inspection checklist.

Why the confidence is not higherIB-025 'General Requirements' item 2 and the 'Electrical Plan' / 'Inspection' sections' explicit references to CEC 690/705. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Yes, in effect — IB-025's own inspection checklist restates the NEC/CEC 120%-rule for busbar loading: 'Sum of the main OCPD and the inverter OCPD is rated for not more than 120% of the buss bar rating.' This is a restatement of the national code provision (CEC/NEC 705.12(B)(3)(2)) rather than a Walnut-Creek-specific amendment, but it is the city's own stated inspection criterion.

Why the confidence is not higherIB-025 'Inspection' section, final bullet. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

No fixed universal spacing table is published. IB-025 requires project-specific documentation of the mounting/attachment method (roof plan showing PV layout and attachment locations, framing plan/details for any roof-strengthening work, and — where a listed racking system is used — the manufacturer's maximum-load and attachment-method documentation) rather than specifying a citywide spacing standard.

Why the confidence is not higherIB-025 'Construction Plans' item 2a and 'Structural Support' section. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Access pathways are required 'by the California Building and Fire Codes' per the city's own bulletin, which does not restate the dimensional ridge-setback table itself (that content lives in the copyrighted CFC/CRC text, not reproduced on any Walnut Creek page found).

Why the confidence is not higherIB-025 'Construction Plans' item 2a: 'Show access pathways required by the California Building and Fire Codes.' No Walnut Creek document found republishes the specific setback dimensions. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin — dimensions unretrievable checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Yes — NEC 690.12 rapid shutdown applies under the 2023 NEC as adopted via the 2025 California Electrical Code, in force for all permit applications from January 1, 2026. Not restated by article/section number in any Walnut Creek-specific bulletin found, but the battery-storage bulletin PB-074 independently requires plans to 'Show location and/or method of rapid shutdown initiation of the storage battery system,' confirming the requirement is enforced in practice.

Why the confidence is not higherInference from the Building Codes page's 2023 NEC/2025 CEC adoption (q29) plus PB-074's explicit rapid-shutdown submittal requirement for battery systems. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

adopting regulation + authority's own bulletin — inference checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-codes

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

At minimum: (1) a DC-disconnect sign identifying PV power-source system attributes; (2) an AC point-of-connection sign; (3) a sign identifying the alternative-power-system switch (all per IB-025's inspection checklist); (4) a plaque at the main service panel indicating the type and location of all power sources on/in the building, per CEC 705.10 (per battery bulletin PB-074); and (5) where a line/supply-side tap is used, PG&E's own required 'engraved placard (signage), indicating there is a line/supply side connection... installed on the metering equipment' (per PG&E's TD-7001M Greenbook, §6.3.3.a).

Why the confidence is not higherCombines IB-025 Inspection checklist, PB-074 General Information section (CEC 705.10 plaque), and PG&E TD-7001M Greenbook §6.3.3.a (line-side-tap placard). PG&E Greenbook confirmed via pdfinfo: Title 'TD-7001M, Electric & Gas Service Requirements', CreationDate 22 Apr 2026 — matches the current edition. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin + utility manual checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

No — the city references the NEC/CEC-mandated signage content (CEC 690/705, 705.10) rather than authoring its own custom placard wording.

Why the confidence is not higherIB-025 and PB-074 both describe signage by function/code citation ('sign identifying PV power source system attributes,' 'plaque...per CEC 705.10') without dictating specific wording text of their own. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin — absence checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedIB-025 (Photovoltaic Array Systems bulletin), PB-074 (Energy Storage System bulletin), and the current Master Fee Schedule — none specifies letter height, colour, or material for required PV/service-equipment placards; all three reference signage only by function or code citation (CEC 690/705/705.10).

https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Yes — a plaque/placard at the main service panel indicating the type and location of all power sources on or in the building is required, per CEC 705.10 as cited in the city's own battery-storage bulletin PB-074.

Why the confidence is not higherPB-074 'General Information': 'A plaque shall be installed at the main service panel indicating type and location of all power sources on or in the building (CEC 705.10).' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/19603/636850489997770000

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes — PG&E's Greenbook (TD-7001M) requires an additional 'engraved placard (signage), indicating there is a line/supply side connection... installed on the metering equipment' whenever a fusible AC disconnect is installed ahead of the main breaker (a line/supply-side tap), on top of whatever the AHJ's own building/fire-code signage requires.

Why the confidence is not higherPG&E TD-7001M, 'Electric & Gas Service Requirements,' §6.3.3.a (Table 6-3 discussion). PDF verified via pdfinfo: Title 'TD-7001M, Electric & Gas Service Requirements', CreationDate 22 Apr 2026, Effective Date 06/22/2026 printed on the page — the current edition, not the gated TD-2306M Distribution Interconnection Handbook nor Portland General Electric's handbook.

utility manual checked 2026-08-30 https://www.pge.com/content/dam/pge/docs/account/service-requests/greenbook-manual-full.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

At the DC disconnect, at the AC point of connection, and at the alternative-power-system switch (IB-025); a plaque at the main service panel (PB-074/CEC 705.10); and, for line-side-tap installations, an engraved placard on the metering equipment itself (PG&E Greenbook).

Why the confidence is not higherCombined IB-025 Inspection checklist, PB-074, and PG&E Greenbook §6.3.3.a, as cited in q38/q41/q42. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin + utility manual checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q44 Must equipment be on a specific approved list? Equipment listing

Yes.

Why the confidence is not higherIB-025: 'All components used in the photovoltaic power system or alternative energy source system must be listed by a nationally recognized testing agency to standards appropriate for the intended applications.' PB-074 separately requires ESS equipment to be 'listed by a Nationally Recognized Testing Laboratory... according to a recognized standard-UL9540.' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Yes, under detailed conditions set out in the city's own Policy Bulletin PB-074: ESS must comply with CRC §R327 (exception for UL 9540-listed systems under 1 kWh); may only be installed in detached garages/accessory structures, attached garages separated per CRC R302.6, outdoors 3+ feet from doors/windows, or enclosed utility spaces with fire-rated finish (5/8" Type X gypsum where wood-framed); is barred from sleeping rooms and habitable spaces; requires 3-foot unit spacing (or documented large-scale fire-test clearance); requires smoke/heat alarms per CRC R314; and requires impact protection where subject to vehicle damage.

Why the confidence is not higherPolicy Bulletin No. PB-074, 'Submittal Requirements for Energy Storage System (ESS) in One- and Two-Family Dwelling With Solar Photovoltaic System,' revised 12 Jul 2021 (pdfinfo CreationDate confirms). (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/19603/636850489997770000

Q46 Is there a separate ESS permit or inspection? Battery / ESS

Not a separate PERMIT type at the city Building Division (folded into the same solar/electrical plan-review submittal per PB-074, and the Master Fee Schedule has no distinct ESS fee line item — only 'Solar'). However, Contra Costa County Fire Protection District DOES bill a distinct, separate 'Energy Storage System' plan review: 'Battery Systems/Energy Storage — minimum fee $944.00' plus a 'UL9540A Review — minimum fee $516.00' — with no equivalent standalone PV-only line item anywhere in the same fee schedule.

Why the confidence is not higherCity Master Fee Schedule Section 4 has only 'Solar' subcategories, no ESS line. CCCFPD's 'Engineering/Plan Review Fee Schedule' (effective 13 Jul 2026, pdfinfo CreationDate 21 May 2026), Section 11 'Energy Storage System', lists the two fees quoted. This directly matches this brief's flagged pattern of some fire districts billing ESS review as a real parallel track while having no PV-specific fee line at all.

fire district fee schedule checked 2026-08-30 https://drive.google.com/file/d/1f7L1Otr4s0_oJTdQKE_Zu_E-ke6xHHRR/view?usp=sharing

Q47 Is a ground mount treated as a structure? Core Ground mount

Nothing published by this authority.

Where we lookedSolar/Electrical/Heating/Plumbing page, IB-025 bulletin, and the Accessory Structures page — none classifies a ground-mounted PV array as a 'structure' for zoning/setback purposes or otherwise addresses ground-mount treatment specifically.

https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits/building-and-land-use-regulations/accessory-structures

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

The AC disconnect must sit downstream of (after) the revenue meter and upstream of (ahead of) the main breaker for a line/supply-side-tap connection; it is not required at all for a single-phase, self-contained/socket-based meter panel rated 320A or less serving an inverter-based generator (unless it is a K-base meter panel, which always requires one), per PG&E's Table 6-3.

Why the confidence is not higherPG&E TD-7001M Greenbook §6.3, Table 6-3 'Requirements for AC Disconnect Switches,' and §6.3.3.a: 'A fusible AC disconnect switch is required for generator interconnections ahead of the main breaker (line/supply side connection) and after the meter.'

utility manual checked 2026-08-30 https://www.pge.com/content/dam/pge/docs/account/service-requests/greenbook-manual-full.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? All three: Portal (Accela, once linked to the project), Phone (voicemail line), and Email. 92% · authority's own page
    • How much notice is required? Effectively overnight/next-day: 'You have until midnight to schedule an inspection for next day service.' Online requests can also be placed up to 5 days in advance. 85% · authority's own page
    • Are same-day or AM/PM windows offered? No AM/PM window is offered or mentioned. Inspections occur the business day after they are requested (not same-day), and the applicant must call a confirmation line between 8:00–8:30am the morning of the inspection to confirm the timeframe. 80% · authority's own page
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes. 82% · authority's own page + authority's own bulletin
    • If delegated, to whom? Not delegated for standard residential rooftop PV — held by the city's own Building Division. Contra Costa County Fire Protection District (Con Fire) is notified but, per IB-025, performs no separate review/inspection for eligible small residential PV; Con Fire's own fee schedule shows it separately bills only for Energy Storage System (battery) reviews, not plain PV. 75% · authority's own page + fire district fee schedule
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? For eligible small residential PV (≤10kW AC, roof-mount, no battery, per IB-025's streamlined criteria): a single consolidated final inspection by the Building Division. Sequencing for larger/non-eligible systems is not separately published. 68% · authority's own bulletin
    • Is a rough-in or mid-roof inspection required? Not required for eligible small residential PV — IB-025 describes a single consolidated final inspection, with no rough-in or mid-roof stage mentioned. 65% · authority's own bulletin — absence
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? Yes. 88% · authority's own bulletin
    • What must be on site at inspection? Not itemized as a standalone 'bring this to your inspection' list, but IB-025's inspection checklist implies the approved plans and equipment specification sheets must be available on site, since the inspector checks that 'Number of PV modules and model number matches plans, and specification sheets.' 55% · authority's own bulletin — inference
    • Does the inspector verify labels and listings? Yes. 88% · authority's own bulletin
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Not explicitly named on any Walnut Creek page found (no 'CO', 'Final', or 'Green Tag' terminology used specifically for a solar addition to an existing single-family home). By inference from standard California building-permit practice for an alteration to an existing residence, this would be a 'Final' inspection sign-off rather than a new Certificate of Occupancy. 50% · authority's own page — inference
    • Who notifies the utility for PTO? Not explicitly stated by the city. Standard California NEM practice, consistent with IB-025's own language that 'PG&E customers must not interconnect... until they receive written authorization from Pacific Gas and Electric Company,' is that the installer/customer submits the interconnection application and requests Permission to Operate from PG&E once the city's final inspection is complete. 50% · authority's own bulletin — inference
    • Is there a re-inspection fee? $215.00 (FY2026) / $225.00 (FY2027) per additional inspection. 85% · published fee schedule

14 questions answered against City of Walnut Creek’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

All three: Portal (Accela, once linked to the project), Phone (voicemail line), and Email.

Why the confidence is not higherBuilding Inspections page: 'You can request an inspection online, by phone or email,' with distinct instructions for each (Accela portal linking, inspectionrequest@walnutcreekca.gov, and voicemail at 925-943-5833). (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/request-a-building-inspection

Q50 How much notice is required? Core Booking & scheduling

Effectively overnight/next-day: 'You have until midnight to schedule an inspection for next day service.' Online requests can also be placed up to 5 days in advance.

Why the confidence is not higherBuilding Inspections page: 'Inspections are performed the day after you schedule them... You have until midnight to schedule an inspection for next day service'; separately, 'You can request your inspection up to 5 days in advance' for the online path. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/request-a-building-inspection

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

No AM/PM window is offered or mentioned. Inspections occur the business day after they are requested (not same-day), and the applicant must call a confirmation line between 8:00–8:30am the morning of the inspection to confirm the timeframe.

Why the confidence is not higherBuilding Inspections page: 'Please confirm your inspection and timeframe the morning of your inspection day, between 8am - 8:30am... This schedule goes live at 8AM every morning.' No AM/PM selection option is described anywhere on the page. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/request-a-building-inspection

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes.

Why the confidence is not higherBuilding Inspections page describes the city's own Building Division inspection-scheduling process with no delegation mentioned. IB-025 additionally confirms, for eligible small residential PV: 'One consolidated inspection will be required and performed by the Building Division... No separate review and inspection is required by Fire District.' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page + authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/request-a-building-inspection

Q53 If delegated, to whom? Core Who inspects

Not delegated for standard residential rooftop PV — held by the city's own Building Division. Contra Costa County Fire Protection District (Con Fire) is notified but, per IB-025, performs no separate review/inspection for eligible small residential PV; Con Fire's own fee schedule shows it separately bills only for Energy Storage System (battery) reviews, not plain PV.

Why the confidence is not higherSame sourcing as q46/q52.

authority's own page + fire district fee schedule checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/request-a-building-inspection

Q54 Which inspections are required, and in what order? Core Stages & sequence

For eligible small residential PV (≤10kW AC, roof-mount, no battery, per IB-025's streamlined criteria): a single consolidated final inspection by the Building Division. Sequencing for larger/non-eligible systems is not separately published.

Why the confidence is not higherIB-025: 'One consolidated inspection will be required and performed by the Building Division.' (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

Not required for eligible small residential PV — IB-025 describes a single consolidated final inspection, with no rough-in or mid-roof stage mentioned.

Why the confidence is not higherSame IB-025 citation as q54; absence noted after reviewing the full bulletin text. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin — absence checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q56 Does the inspector verify labels and listings? Core What is checked

Yes.

Why the confidence is not higherIB-025's own 'Inspection' checklist explicitly includes: 'Appropriate signs are property [sic] constructed, installed, and displayed, including: – Sign identifying PV power source system attributes at DC disconnect – Sign identifying AC point of connection – Sign identifying switch for alternative power system,' plus checks that 'Number of PV modules and model number matches plans, and specification sheets' (a listing/label verification). (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q57 Is there a published inspection checklist? Core What is checked

Yes.

Why the confidence is not higherIB-025 contains a dedicated 'Inspection' section listing specific points of inspection an applicant should be prepared to demonstrate compliance with. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q58 What must be on site at inspection? Core Documents on site

Not itemized as a standalone 'bring this to your inspection' list, but IB-025's inspection checklist implies the approved plans and equipment specification sheets must be available on site, since the inspector checks that 'Number of PV modules and model number matches plans, and specification sheets.'

Why the confidence is not higherIB-025 'Inspection' section, first bullet — implies plans/spec sheets are compared on site but does not explicitly instruct the applicant to have them present. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin — inference checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Q59 Is there a re-inspection fee? Corrections & re-inspection

$215.00 (FY2026) / $225.00 (FY2027) per additional inspection.

Why the confidence is not higherMaster Fee Schedule, Community Development - Building Division, Section E 'Other Inspections and Fees': 'For each and every additional visit or inspection for this phase of work for which the holder of the permit... is entirely responsible, a fee shall be charged... $215.00 [FY26] / $225.00 [FY27].' This is a general re-inspection fee (not solar-specific), the only such fee published.

published fee schedule checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/32770/638912803924430000

Q60 How are corrections issued and cleared? Corrections & re-inspection

Nothing published by this authority.

Where we lookedBuilding Inspections / Request-a-Building-Inspection page, Building Permit FAQs, and Turnaround Times page — none describes a correction-issuance or resubmittal-clearing workflow for a failed inspection or plan-review comment.

https://www.walnutcreekca.gov/government/community-development-department/permits/request-a-building-inspection

Q61 What is issued on pass? Core Final sign-off & PTO

Not explicitly named on any Walnut Creek page found (no 'CO', 'Final', or 'Green Tag' terminology used specifically for a solar addition to an existing single-family home). By inference from standard California building-permit practice for an alteration to an existing residence, this would be a 'Final' inspection sign-off rather than a new Certificate of Occupancy.

Why the confidence is not higherChecked Building Inspections/Request-a-Building-Inspection page and Turnaround Times page — neither names the specific document/tag issued on a passed final inspection. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own page — inference checked 2026-08-30 https://www.walnutcreekca.gov/government/community-development-department/permits/request-a-building-inspection

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Not explicitly stated by the city. Standard California NEM practice, consistent with IB-025's own language that 'PG&E customers must not interconnect... until they receive written authorization from Pacific Gas and Electric Company,' is that the installer/customer submits the interconnection application and requests Permission to Operate from PG&E once the city's final inspection is complete.

Why the confidence is not higherIB-025 general requirement 3; no Walnut Creek document states who specifically files the PTO request, so this is industry-standard inference, not a city statement. (City site returns Akamai 403 to automated fetch/curl/WebFetch; content confirmed via Wayback Machine capture of the live page, and cross-checked that Wayback itself was fully operational at time of read.)

authority's own bulletin — inference checked 2026-08-30 https://www.walnutcreekca.gov/home/showpublisheddocument/4580/636773672094800000

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for City of Walnut Creek against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

City of Walnut Creek is the authority having jurisdiction 88% confidence
Holds
Building and Electrical, combined into one unified permit issued by the city's own Community Development Department / Building Division for single-family and duplex residential PV. Contra Costa County Fire Protection District (Con Fire) — NOT a city department — holds fire/life-safety plan review and is the entity the city's own 'Fire Protection' page redirects to, but IB-025 (the city's own bulletin) states Con Fire performs no separate review/inspection for eligible small residential PV; Con Fire's own fee schedule shows it separately bills only Energy Storage System (battery) review, not plain PV.
Delegated to
Contra Costa County Fire Protection District (Con Fire) for fire/life-safety plan review generally, and specifically for a billable Energy Storage System plan review where batteries are involved; PG&E for interconnection authorization/Permission-to-Operate (MCE Clean Energy is the default generation CCA but is not the interconnecting utility).
Overridden by
CA AB 130 (Stats. 2025, Ch. 22) bars the city from adopting any MORE-restrictive residential building-code amendment from 1 Oct 2025 through 1 Jun 2031. Also note a live internal contradiction: Con Fire's own 'Construction and Permitting' page still cites the 2022 California Fire Code (Ordinance 2022-34) while the city's own Building Codes page states the 2025 CFC has applied to all permit applications since 1 Jan 2026 — unresolved on either agency's site as of this check.
Why not higher
City of Walnut Creek's own Building Division issues residential solar permits directly (Master Fee Schedule, IB-025, Solar/Electrical/Heating/Plumbing page) — confirming the BRIEF's assumed department name (Community Development Department / Building Division) is correct here, unlike the Alameda County CDA case flagged in this brief's guidance. The city's own 'Fire Protection' page (government/departments/emergency-preparedness/fire-protection) 302-redirects to cccfpd.org, confirming Contra Costa County FPD (not a city fire department) is the fire AHJ — verified directly via HTTP header trace through the Wayback Machine, not inferred from geography.

https://www.walnutcreekca.gov/government/departments/emergency-preparedness/fire-protection

Permit required
Yes.95%
Permit cost
$280.00 flat (FY2026 and FY2027) for a Single Family and Duplex Residential solar PV system.95%
Plan review
3–7 business days for the ministerial/'over-the-counter' path that a standard single-family solar permit falls under (per the current Turnaround Times page).75%
Portal
Accela Citizen Access (the city's 'ACA Portal', aca-prod.accela.com/WC).92%
Electrical code
2023 NEC, adopted as the basis of the 2025 California Electrical Code, effective for all permit applications submitted on or after January 1, 2026.96%
Own placard wording
No — the city references the NEC/CEC-mandated signage content (CEC 690/705, 705.10) rather than authoring its own custom placard wording.62%
Booking an inspection
All three: Portal (Accela, once linked to the project), Phone (voicemail line), and Email.92%
Labels & placards for this authority

Wording 62%

No — the city references the NEC/CEC-mandated signage content (CEC 690/705, 705.10) rather than authoring its own custom placard wording.

Size, colour & material None%

Where they go 82%

At the DC disconnect, at the AC point of connection, and at the alternative-power-system switch (IB-025); a plaque at the main service panel (PB-074/CEC 705.10); and, for line-side-tap installations, an engraved placard on the metering equipment itself (PG&E Greenbook).

What the utility wants on top 85%

Yes — PG&E's Greenbook (TD-7001M) requires an additional 'engraved placard (signage), indicating there is a line/supply side connection... installed on the metering equipment' whenever a fusible AC disconnect is installed ahead of the main breaker (a line/supply-side tap), on top of whatever the AHJ's own building/fire-code signage requires.

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
City
County
Contra Costa County
Regions served
1
Regions covered
City of Walnut Creek · city
Solar Requirements
Notes
Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.walnutcreekca.gov/government/community-development-department/permits/building-permits
Authority Contact
Address
1666 North Main Street, 2nd Floor, Walnut Creek, CA 94596
Main Phone
(925) 943-5899
Building Department
Department
Building Division, Community Development Department
Direct Phone
(925) 943-5834
Portal Software
Accela
Booking & Scheduling
Preferred channel
online
Book in advance
next business day (up to 5 days in advance)
Notes
Schedule online via Accela Citizen Access portal. Must have a registered Accela account linked to the specific permit — email buildingtech@walnutcreekca.gov to link your account to a project. Alternatively, email inspectionrequest@walnutcreekca.gov before midnight for next-day inspection. Inspections are performed the day after scheduling; schedule goes live at 8 AM each morning. Confirm inspection window the morning of, between 8:00–8:30 AM. Up to 5 days in advance scheduling is allowed. Before booking a solar final, check for outstanding conditions (incomplete waste management plan, pending approvals from other agencies) that can block final scheduling — call (925) 943-5834 or check the job card. (collected Jul 2026)
