City of Waterford
Stanislaus County
City of Waterford is a city authority in the State of California, serving 9,120 residents. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Up to 10 business days for plans requiring plan review (per the general checklist); SB 379/Symbium-eligible standard systems are intended to receive instantaneous… Q18 Where you file — Symbium (automated SB 379 solar permitting platform) Q20
- Permit required
- Yes95% source

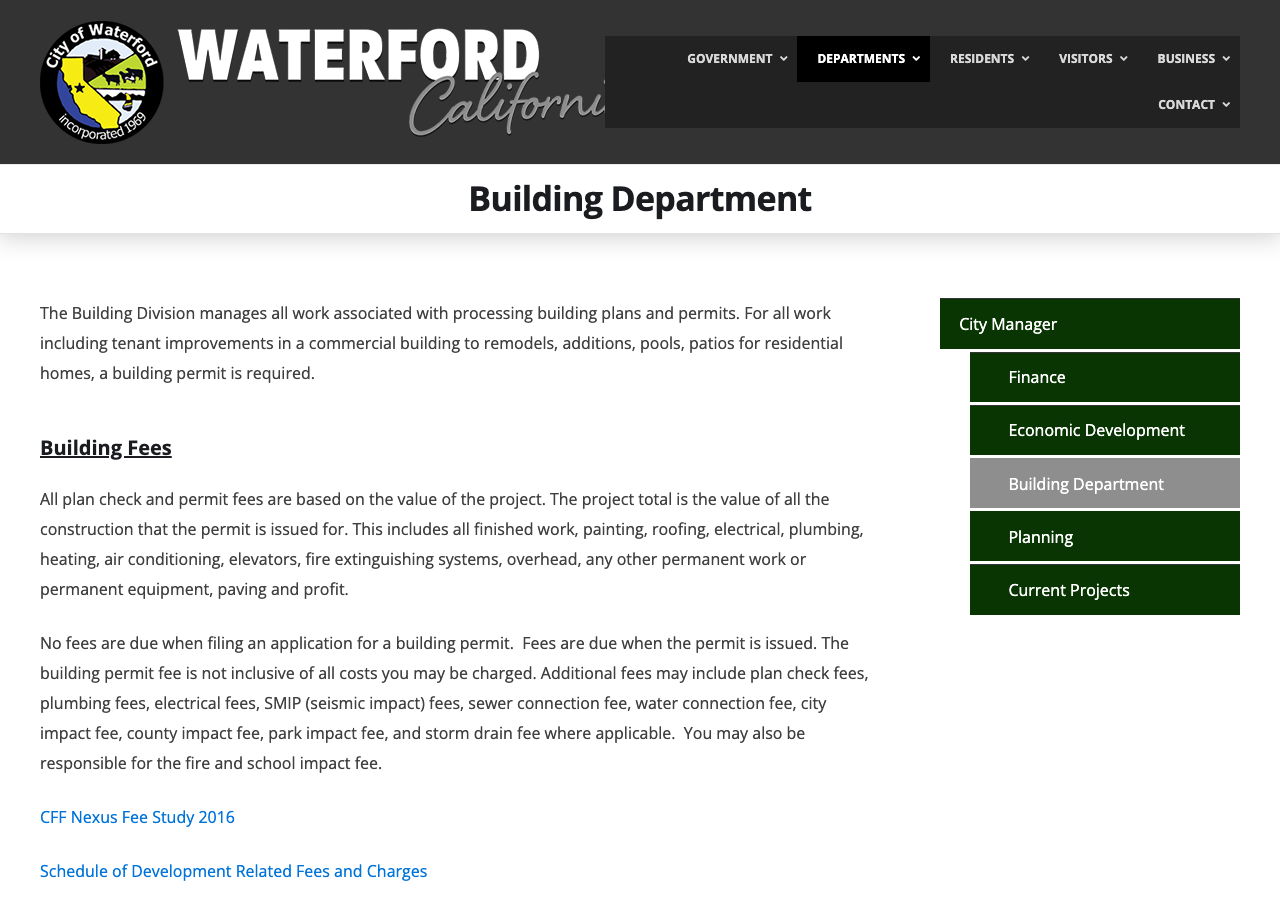

- What it costs
- $395 flat90% source
- Plan review turnaround
- Up to 10 business days for plans requiring plan review (per the general checklist); SB 379/Symbium-eligible standard systems are intended to receive instantaneous automated approval55% source
- Key document
- inference from CA building-code structure; no CA-specific wind-cert program exists cited by 5 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · authority's own department page
- What does this authority permit itself, and what does it delegate? Both 85% · authority's own staff directory + application form
- Is a permit required for a residential rooftop PV system? Yes 95% · authority's own department page
- Is there a separate electrical permit, or is it combined? Combined 75% · fee schedule
- Is a wind or windstorm certification required? No 60% · inference from CA building-code structure; no CA-specific wind-cert program exists
- Is a Specific Use Permit or Council approval ever required? No, not for a standard residential rooftop system 55% · state law inference; local zoning chapter inaccessible
- Is there a system-size cap on residential generation? No city zoning cap found; MID (the utility) caps interconnected system size at 115% of the customer's demonstrated annual electrical load (or, absent load history, 2 W/sq ft), per its NEM 2.0 tariff 75% · utility interconnection handbook
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 60% · authority's own application packet
- Must the contractor be registered with this authority before applying? Yes 85% · authority's own department page
- Is a homeowner permitted to self-install and self-permit? Yes 80% · authority's own application packet
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- Is a site plan required, and what must it show? Yes — a site/plot plan showing the layout of the panels, inverter, disconnects, meter, placards, and any gates/obstructions relative to the dwelling 70% · utility interconnection handbook
- Is a one-line / three-line diagram required? Yes 65% · utility interconnection handbook
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

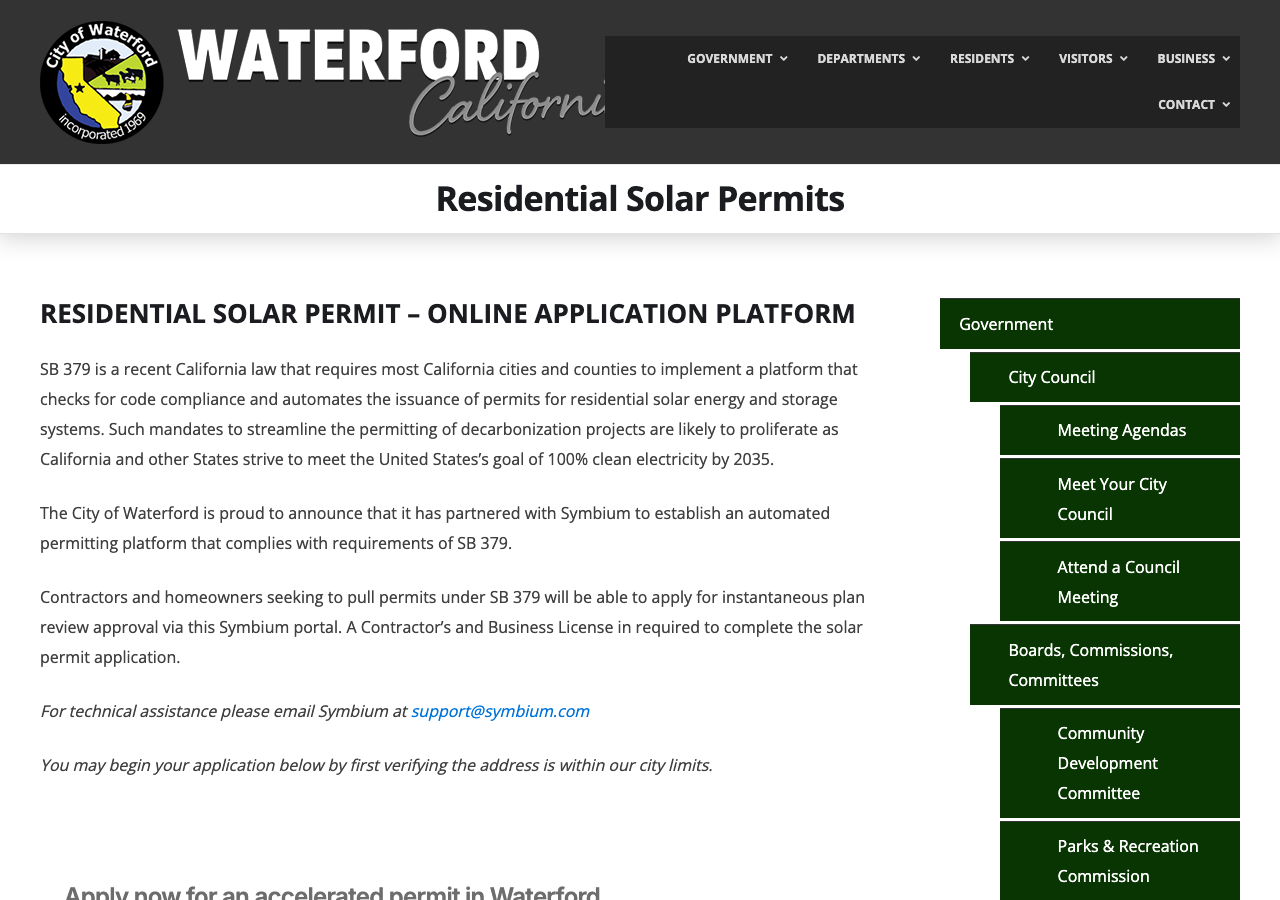

- Which permit portal does this authority use? Symbium (automated SB 379 solar permitting platform) 95% · authority's own department page
- Can the whole application be completed online? Yes, for SB 379-eligible standard residential systems 80% · authority's own department page
- What does a residential solar permit cost? $395 flat 90% · published fee schedule
- How is the fee calculated? Flat 90% · published fee schedule
- Is there a separate plan-check fee? No 70% · published fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? Up to 10 business days for plans requiring plan review (per the general checklist); SB 379/Symbium-eligible standard systems are intended to receive instantaneous automated approval 55% · application checklist
- Which utility handles interconnection here? Modesto Irrigation District (MID) 95% · utility's own service guide
- Where does the utility sit in the sequence? After permit (for final interconnection/PTO); MID's initial engineering-review approval to begin construction occurs before/parallel to the city permit 80% · utility interconnection handbook
28 questions answered against City of Waterford’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity of Waterford's own Building Department issues residential building and electrical permits directly (via its Symbium solar portal and standard counter process); MID's own Electric Service Guide independently lists 'City of Waterford Building Division' as the local governing authority within its service territory covering this address.
authority's own department page checked 2026-08-30 https://cityofwaterford.org/departments/city-managers-office/building-department/
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherThe Building Permit Application is a single combined form with line items for Building, Plumbing, Electrical and Plan Check fees issued by the City of Waterford; the Building Department page and staff directory show an in-house 'Building Inspector' (city extension 110) distinct from the City Engineer (contracted out to MCR Engineering) and City Planner (contracted to JB Anderson) roles — no building/electrical plan-check contract to a county or private firm (e.g. Bureau Veritas, 4Leaf, Interwest) was found in the staff directory or in web search.
authority's own staff directory + application form checked 2026-08-30 https://cityofwaterford.org/contact/staff-directory/
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherCity publishes a dedicated 'Residential Solar Permits' page directing applicants to its SB 379 Symbium automated permitting portal, and the residential fee schedule lists a flat 'Solar' permit fee, confirming a permit is required.
authority's own department page checked 2026-08-30 https://www.cityofwaterford.org/building-permits/residential-solar-permits/
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe residential fee schedule lists a single flat 'Solar' line item ($395) rather than separate building and electrical solar fees, and the general Building Permit Application form issues Building/Plumbing/Electrical under one permit number — indicating solar is processed as one combined permit, not two separate applications.
fee schedule checked 2026-08-30 https://cityofwaterford.org/wp-content/uploads/2025/01/SAMPLE-RESIDENTIAL-BUILDING-FEES-2025.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherThe City's owner-builder disclosure packet (standard CSLB form) allows a property owner to be the responsible permit holder without a licensed contractor, and the Symbium solar page separately states a 'Contractor's and Business License' is required to use the portal — implying both a licensed-contractor path and an owner path exist, though the owner-builder packet is generic to all building permits, not solar-specific.
authority's own application packet checked 2026-08-30 https://www.cityofwaterford.org/wp-content/uploads/2021/06/Building-Application-FullPacket-fillable-1.pdf
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherCity of Waterford's Symbium solar-permit page states 'A Contractor's and Business License is required to complete the solar permit application,' and the city's Business License page confirms any business operating/working in the city (including out-of-town contractors) must hold a $54 City of Waterford business license.
authority's own department page checked 2026-08-30 https://www.cityofwaterford.org/building-permits/residential-solar-permits/
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherThe city's Building Permit Application packet includes a full 'Property Owner's Package' — the standard California Owner-Builder Acknowledgment and Information Verification form — confirming the city issues Owner-Builder permits allowing a homeowner to self-permit; this packet is generic to all building permits (not solar-specific), so it is not certain it is offered on the Symbium portal itself.
authority's own application packet checked 2026-08-30 https://www.cityofwaterford.org/wp-content/uploads/2021/06/Building-Application-FullPacket-fillable-1.pdf
Q8 What documents make up a complete submittal? Core Submittal package
Nothing published by this authority.
Where we lookedLooked for a solar-specific submittal checklist on the Symbium portal landing page and the Building Department page; only the general (non-solar) 'Building Permit Application Checklist' PDF was found, which documents a full-construction submittal (plot plan, floor/foundation/roof framing, engineering calcs) rather than a rooftop-PV-specific document list. The Symbium portal itself is an interactive application that could not be completed/rendered by an automated fetch.
https://www.cityofwaterford.org/building-permits/residential-solar-permits/
Q9 How many copies, and in what format? Submittal package
Nothing published by this authority.
Where we lookedLooked for a solar-specific copy-count/format requirement; the only published figure (4 sets + 1 electronic copy) is on the general, non-solar Building Permit Application Checklist, and Symbium (the actual solar intake portal) is described as an online upload-based system with no stated copy count.
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — a site/plot plan showing the layout of the panels, inverter, disconnects, meter, placards, and any gates/obstructions relative to the dwelling
Why the confidence is not higherMID's Solar Interconnection Handbook requires a 'Site Diagram/Plan' with this content as part of the interconnection package the contractor must also prepare; the City's general Building Permit Checklist likewise requires a 'Scaled plot plan.' No Waterford-specific solar site-plan checklist could be independently confirmed since the Symbium portal is interactive and Title 15 of the municipal code (eCode360) is Cloudflare-blocked.
utility interconnection handbook checked 2026-08-30 https://www.mid.org/wp-content/uploads/MID-Solar-Handbook_FINAL_2026-1.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherMID's Solar Interconnection Handbook requires a 'Single Line Electrical Diagram' as part of the application package that accompanies the project; this is standard practice California-wide for both AHJ and utility submittals under the Solar Permitting Guidebook incorporated by SB 379/Symbium, but the City's own checklist could not be independently confirmed (Title 15 Cloudflare-blocked; Symbium portal is interactive).
utility interconnection handbook checked 2026-08-30 https://www.mid.org/wp-content/uploads/MID-Solar-Handbook_FINAL_2026-1.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedLooked in the MID Solar Interconnection Handbook and Electric Service Guide (which require CSI sheets and a single-line diagram but do not separately mandate string/conductor sizing calculations) and in the City's general (non-solar) building checklist; no Waterford-specific requirement for string/conductor calculations was found.
https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedLooked in the general Building Permit Application Checklist (requires a Registered CA Engineer stamp on roof framing/truss and foundation calcs for new construction generally) and searched for a solar-specific structural threshold; none is published, and Title 15 (which would state any threshold) is blocked by Cloudflare on every fetch method tried (curl w/ ICC referer, WebFetch, Wayback, archive.today).
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedLooked for an electrical PE stamp threshold for residential PV in the same sources as q13; none published, and Title 15 electrical amendments are inaccessible (Cloudflare-blocked).
Q15 What does a residential solar permit cost? Core Fees
$395 flat
Why the confidence is not higherBoth the 'SAMPLE RESIDENTIAL BUILDING FEES 2025' schedule (updated 2024) and the earlier 'Building Fee Master' (18 Feb 2021) list 'Solar' as a residential permit fee of $395.00, consistent across two dated editions three years apart.
published fee schedule checked 2026-08-30 https://cityofwaterford.org/wp-content/uploads/2025/01/SAMPLE-RESIDENTIAL-BUILDING-FEES-2025.pdf
Q16 How is the fee calculated? Core Fees
Flat
Why the confidence is not higherThe fee schedule lists 'Solar' as a single flat $395 line item, separate from the square-footage-tiered 'Plan Check and Inspections' table used for new construction.
published fee schedule checked 2026-08-30 https://cityofwaterford.org/wp-content/uploads/2025/01/SAMPLE-RESIDENTIAL-BUILDING-FEES-2025.pdf
Q17 Is there a separate plan-check fee? Fees
No
Why the confidence is not higherThe $395 solar fee appears as one flat line item on the fee schedule, not broken into a separate plan-check line the way the graduated new-construction fee table is; this suggests the flat fee is inclusive of plan check for solar, but the fee schedule does not say so explicitly.
published fee schedule checked 2026-08-30 https://cityofwaterford.org/wp-content/uploads/2025/01/SAMPLE-RESIDENTIAL-BUILDING-FEES-2025.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Up to 10 business days for plans requiring plan review (per the general checklist); SB 379/Symbium-eligible standard systems are intended to receive instantaneous automated approval
Why the confidence is not higherThe City's Building Permit Application Checklist (undated content, filed 2021) states 'Please allow up to 10 business days for Building Permits requiring Plan Review.' This is a general, non-solar-specific figure; the City's own Symbium page states solar permits are processed for 'instantaneous plan review approval' for SB 379-eligible systems, so the two figures likely apply to different tracks (automated vs. manual/non-qualifying) and neither is confirmed solar-specific in a dated document.
application checklist checked 2026-08-30 https://www.cityofwaterford.org/wp-content/uploads/2021/06/Building-Application-FullPacket-fillable-1.pdf
Q19 How long is an issued permit valid before it expires? Timeline & validity
Nothing published by this authority.
Where we lookedLooked in the Building Permit Application packet and fee schedule for a stated permit-validity/expiration period; none is published there, and Title 15 (Chapter 15.04, which would state the local expiration provision if amended from the CBC default) is Cloudflare-blocked on every fetch method tried.
Q20 Which permit portal does this authority use? Core Portal & process
Symbium (automated SB 379 solar permitting platform)
Why the confidence is not higherThe City's 'Residential Solar Permits' page states the City 'has partnered with Symbium to establish an automated permitting platform that complies with requirements of SB 379' and directs applicants to apply through the Symbium portal.
authority's own department page checked 2026-08-30 https://www.cityofwaterford.org/building-permits/residential-solar-permits/
Q21 Can the whole application be completed online? Core Portal & process
Yes, for SB 379-eligible standard residential systems
Why the confidence is not higherThe City's solar page states contractors/homeowners 'will be able to apply for instantaneous plan review approval via this Symbium portal,' consistent with SB 379's (Gov. Code §65850.52) mandate for automated online issuance of permits for qualifying residential solar systems; non-qualifying or larger systems would fall back to the standard, non-online building-permit process (see q18/q9).
authority's own department page checked 2026-08-30 https://www.cityofwaterford.org/building-permits/residential-solar-permits/
Q22 Which utility handles interconnection here? Core Utility interconnection
Modesto Irrigation District (MID)
Why the confidence is not higherMID's own Electric Service Guide — Solar Photovoltaic (dated 1 May 2025) lists 'City of Waterford Building Division' by name and address as one of the 'Local Governing Authorities Within MID's Service Area,' and MID's public-facing description of its territory names Waterford directly ("MID provides electricity to...Modesto, Empire, Salida, Waterford and Mountain House..."). This is a utility-owned-and-operated (irrigation district) service area, not PG&E and not Turlock Irrigation District, despite both operating elsewhere in Stanislaus County.
utility's own service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q23 Where does the utility sit in the sequence? Core Utility interconnection
After permit (for final interconnection/PTO); MID's initial engineering-review approval to begin construction occurs before/parallel to the city permit
Why the confidence is not higherPer MID's Solar Interconnection Handbook and Electric Service Guide: (1) the contractor submits an application to MID and receives an engineering-review approval before installing; (2) the contractor then obtains the City/County building permit and passes the local inspection; (3) MID's own Interconnection Inspection and Permission-to-Operate (PTO) letter explicitly require MID's 'receipt of the final, signed-off permit' from the city first. So the utility gates the front end (engineering approval) and the back end (PTO) is strictly after the city permit is finalized.
utility interconnection handbook checked 2026-08-30 https://www.mid.org/wp-content/uploads/MID-Solar-Handbook_FINAL_2026-1.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
Nothing published by this authority.
Where we lookedLooked for an HOA/architectural-review requirement specific to solar in Title 17 (Zoning); the eCode360 chapter is Cloudflare-blocked on every fetch method tried, and no secondary source describing a Waterford-specific ARC/solar review step was found.
Q25 Is there a historic-district review? Overlays & special cases
Nothing published by this authority.
Where we lookedSearched for a Waterford historic-district or historic-overlay zoning designation; none was found in general web search, and Title 17 (Zoning) could not be loaded directly (Cloudflare-blocked) to confirm the absence from the ordinance itself, so this is not a proven absence.
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherCalifornia does not administer a separate wind/windstorm certification program for residential construction analogous to the Texas Department of Insurance's windstorm certification; wind-load compliance in California is addressed within the adopted California Building Code's structural provisions rather than a stand-alone certificate, and no Waterford-specific wind-certification requirement was found.
inference from CA building-code structure; no CA-specific wind-cert program exists checked 2026-08-30 https://cityofwaterford.org/wp-content/uploads/2025/01/SAMPLE-RESIDENTIAL-BUILDING-FEES-2025.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
No, not for a standard residential rooftop system
Why the confidence is not higherCalifornia's Solar Rights Act (Gov. Code §65850.5) restricts cities from imposing additional discretionary approvals (such as a Conditional/Special Use Permit or City Council hearing) on a standard residential rooftop solar installation beyond the ministerial building-permit process; no Waterford ordinance requiring Council approval for residential rooftop PV was found, though Title 17 could not be directly read to confirm this from the local text (Cloudflare-blocked).
state law inference; local zoning chapter inaccessible checked 2026-08-30 https://ecode360.com/42932280
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No city zoning cap found; MID (the utility) caps interconnected system size at 115% of the customer's demonstrated annual electrical load (or, absent load history, 2 W/sq ft), per its NEM 2.0 tariff
Why the confidence is not higherMID's Solar Interconnection Handbook states: 'A solar system size cannot exceed 115% of the current customer's annual demonstrated load...New construction will default to the industry standard of 2 watts per square foot... Oversized systems will NOT be approved.' This is a utility interconnection cap, not a City of Waterford zoning size cap; no separate city-imposed system-size cap was found in the building fee/permit documents reviewed.
utility interconnection handbook checked 2026-08-30 https://www.mid.org/wp-content/uploads/MID-Solar-Handbook_FINAL_2026-1.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC (as incorporated into the 2025 California Electrical Code, Title 24 Part 3) 55% · municipal code (indexed, direct fetch blocked)
- Which building code edition is in force? 2025 California Building Code (Title 24, Part 2), per Ordinance No. 2025-04 55% · municipal code (indexed, direct fetch blocked)
- Which fire code edition is in force? 2025 California Fire Code, per Stanislaus Consolidated Fire Protection District Ordinance No. 2026-02 70% · fire district board agenda & draft ordinance text
- Are there local amendments to any of the above? Yes 85% · fire district ordinance text
- What is the installation judged against? The adopted 2025 California Building/Residential/Electrical Code (Title 24) with Waterford's local Title 15 amendments, and the 2025 California Fire Code with SCFPD's local amendments 55% · municipal code (indexed, direct fetch blocked)
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? No Waterford/SCFPD-specific amendment to the base 2025 CFC rooftop-access-pathway/setback provisions was found; the unamended 2025 California Fire Code (based on the 2024 IFC) rooftop solar access/pathway/setback requirements would apply by default 50% · fire district ordinance text (partial)
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
Nothing recorded for City of Waterford on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? At minimum: a 'Caution: PV and Utility Power' placard, a Solar Array AC Disconnect placard, a Utility-Use-Only AC Disconnect placard, a Solar Production (meter) placard, and (if applicable) a Solar Breaker placard — all specified by MID, the interconnecting utility 80% · utility electric service guide
- Does the authority specify placard wording of its own? Yes (by the utility, MID) — not confirmed for the City itself 75% · utility electric service guide
- Does it specify letter height, colour or material? Minimum 1/4-inch letters, impressed into or raised from a tag of plastic laminate, aluminum, brass, or other non-ferrous metal; attached with high-strength 5-minute epoxy (not removable without hand tools; rivets/screws not acceptable) 90% · utility electric service guide
- Is a site plan / facility map placard required, and what must it show? Yes — MID requires a site diagram/plan showing panel/inverter layout, metering, switches/disconnects, placarding/signage locations, obstructions, relative placement to the dwelling, and gates (marked locked/unlocked) 75% · utility electric service guide
- Does the UTILITY specify placards beyond the AHJ's? Yes 95% · utility electric service guide
- Where must the labels be placed? At/adjacent to the AC disconnects, the production/generation meter socket, and the main service panel — all within about 12 feet and in line of sight of each other, on the same side of any gate/fence as the main panel 85% · utility electric service guide
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? Between the main electric panel and the production/generation meter socket, within 12 feet and in line of sight of the main panel, in a readily accessible location; meter-socket centerline height must be 48-75 inches 90% · utility electric service guide
- Must equipment be on a specific approved list? Yes 90% · utility electric service guide
- Are batteries permitted, and under what conditions? Yes, batteries/ESS are permitted, but must be configured only for customer backup power or peak-shaving — MID prohibits any ESS from being configured to export power back onto MID's grid 80% · utility electric service guide
- Is there a separate ESS permit or inspection? Likely yes for a stand-alone/commercial ESS (SCFPD's fire fee schedule lists a distinct 'Battery Systems' fee of $397.45), but not confirmed for a residential system bundled with a new PV array 50% · fire district fee schedule
20 questions answered against City of Waterford’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC (as incorporated into the 2025 California Electrical Code, Title 24 Part 3)
Why the confidence is not higherSearch-engine-indexed text of the City's own eCode360 Chapter 15.04 ('California Building Codes') and its ordinance list consistently show the chapter enumerates adoption of the full 2025 California Building Standards Code suite (Parts 1-12, including Part 3 the CEC) via Ordinance No. 2025-04, with the chapter itself last touched by that ordinance. I could not load ecode360.com/42932280 directly — every fetch method (curl with the ICC referer bypass, WebFetch, Wayback Machine, archive.today, r.jina.ai) returned a 403/blocked response, confirmed by repeated testing — so this rests on cross-validated secondary indexing of the authority's own page rather than my own read of the primary text.
municipal code (indexed, direct fetch blocked) checked 2026-08-30 https://ecode360.com/42932280
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (Title 24, Part 2), per Ordinance No. 2025-04
Why the confidence is not higherSame basis as q29: eCode360's indexed listing for Waterford's Chapter 15.04 and its ordinance-list entry both reference Ordinance No. 2025-04 (effective 11/6/2025) adopting the full 2025 CBSC suite. Chapter 15.04 itself could not be loaded directly due to a persistent Cloudflare block confirmed across five different fetch methods.
municipal code (indexed, direct fetch blocked) checked 2026-08-30 https://ecode360.com/42932280
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code, per Stanislaus Consolidated Fire Protection District Ordinance No. 2026-02
Why the confidence is not higherI downloaded and extracted (pdftotext) the SCFPD Board of Directors agenda packet for 14 Jan 2026, which contains the full text of 'Ordinance No. 2026-02: Ordinance for Adoption of the 2025 California Fire Code and Providing Modification Thereof,' including specific amended sections (112.1, 113.4, 113.4.2/.3, 114.4, 507.5.1.2, 603.4.1, 912.2.2) and explicit references to the City of Waterford. This document shows the ordinance being introduced/first-read on 14 Jan 2026; I did not independently confirm the final adoption vote/effective date, only the introduction.
fire district board agenda & draft ordinance text checked 2026-08-30 https://www.scfpd.us/files/951c32670/SCFPD+Board+of+Directors+Meeting+Agenda+1-14-26.pdf
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherThe SCFPD 2025 California Fire Code adoption ordinance (Ord. 2026-02) itself amends and adds multiple sections beyond the base code (e.g., §112.1, §113.4, §113.4.2/.3, §114.4 penalty/citation provisions; §507.5.1.2 hydrant spacing; §603.4.1 PV/generator disconnect signage for commercial buildings; §912.2.2 FDC hydrant proximity), confirmed by direct reading of the ordinance text.
fire district ordinance text checked 2026-08-30 https://www.scfpd.us/files/951c32670/SCFPD+Board+of+Directors+Meeting+Agenda+1-14-26.pdf
Q33 What is the installation judged against? Core Electrical
The adopted 2025 California Building/Residential/Electrical Code (Title 24) with Waterford's local Title 15 amendments, and the 2025 California Fire Code with SCFPD's local amendments
Why the confidence is not higherConsistent with q29-32; the primary Title 15 chapter text itself could not be loaded (Cloudflare-blocked) so the precise wording of any electrical-specific local amendment is unconfirmed.
municipal code (indexed, direct fetch blocked) checked 2026-08-30 https://ecode360.com/42932280
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedLooked in Chapter 15.04 (Cloudflare-blocked) and in MID's Electric Service Guide for a city-level rule on service upgrades/busbar sizing specific to solar; MID's guide addresses panel 'rewires' as a utility engineering-review matter (contact MID Electric Engineering) rather than stating a City of Waterford ordinance provision on busbar sizing.
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedLooked in Chapter 15.04 (blocked) and the general Building Permit Checklist for a specific mounting-system/attachment-spacing amendment; none found in the accessible documents.
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
No Waterford/SCFPD-specific amendment to the base 2025 CFC rooftop-access-pathway/setback provisions was found; the unamended 2025 California Fire Code (based on the 2024 IFC) rooftop solar access/pathway/setback requirements would apply by default
Why the confidence is not higherI read the SCFPD Ordinance No. 2026-02 text in full for the sections included in the 14 Jan 2026 agenda packet (fire-hydrant spacing, electrical/PV disconnect signage for commercial buildings, sprinkler thresholds, citation procedures) and found no amendment to the rooftop PV access-pathway/setback section of the CFC. This agenda packet may not include every section of the full adopted ordinance, so this is not a fully proven absence.
fire district ordinance text (partial) checked 2026-08-30 https://www.scfpd.us/files/951c32670/SCFPD+Board+of+Directors+Meeting+Agenda+1-14-26.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Nothing published by this authority.
Where we lookedLooked in Chapter 15.04 (blocked) and MID's Electric Service Guide/Solar Handbook for a rapid-shutdown-specific statement; both discuss AC disconnects at length but do not cite NEC 690.12/705.12 rapid-shutdown requirements by section number, so I could not confirm the specific NEC edition tie-in beyond the general 2023 NEC (q29) already recorded.
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
At minimum: a 'Caution: PV and Utility Power' placard, a Solar Array AC Disconnect placard, a Utility-Use-Only AC Disconnect placard, a Solar Production (meter) placard, and (if applicable) a Solar Breaker placard — all specified by MID, the interconnecting utility
Why the confidence is not higherMID's Electric Service Guide — Solar Photovoltaic includes labeled figures (Figure 1: Caution PV and Utility Power Placard; Figure 2: Solar Array AC Disconnect Placard; Figure 3: Utility Use Only AC Disconnect Placard; Figure 4: Solar Production Placard; Figure 5: Solar Breaker Placard) as required signage at the service equipment. Waterford's own Title 15 electrical amendments (which would state any additional AHJ-specific placard beyond the adopted CEC/NEC) could not be read directly (Cloudflare-blocked), so this answer is sourced to the utility rather than confirmed as the AHJ's own separate requirement.
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes (by the utility, MID) — not confirmed for the City itself
Why the confidence is not higherMID's Electric Service Guide specifies exact placard content via labeled figures (see q38) and requires wording such as, in the gate-separation exception case, 'required MID solar equipment is located on the opposite side of adjacent gate.' Whether the City of Waterford's own Title 15 amendments separately specify wording could not be confirmed (Cloudflare-blocked).
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Minimum 1/4-inch letters, impressed into or raised from a tag of plastic laminate, aluminum, brass, or other non-ferrous metal; attached with high-strength 5-minute epoxy (not removable without hand tools; rivets/screws not acceptable)
Why the confidence is not higherQuoted directly from the extracted text of MID's Electric Service Guide — Solar Photovoltaic, Section G 'Solar Placarding Requirement': this is MID's (the utility's) specification, applicable to any residential PV system interconnecting in Waterford; the City's own ordinance text on this point is inaccessible (Cloudflare-blocked).
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes — MID requires a site diagram/plan showing panel/inverter layout, metering, switches/disconnects, placarding/signage locations, obstructions, relative placement to the dwelling, and gates (marked locked/unlocked)
Why the confidence is not higherQuoted from MID's Solar Interconnection Handbook and Electric Service Guide required-documentation lists. This is the utility's own facility-map/site-plan requirement; a Waterford-specific 705.10 facility-plan ordinance provision could not be independently confirmed (Cloudflare-blocked Title 15).
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes
Why the confidence is not higherMID's Electric Service Guide devotes an entire section (G. Solar Placarding Requirement) and five labeled figures to utility-specific placard content, material, and mounting method, going well beyond generic NEC 690/705 labeling — e.g., minimum 1/4' letters on a non-ferrous metal or plastic-laminate tag epoxied to the panel.
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
At/adjacent to the AC disconnects, the production/generation meter socket, and the main service panel — all within about 12 feet and in line of sight of each other, on the same side of any gate/fence as the main panel
Why the confidence is not higherQuoted from MID's Electric Service Guide, Sections E and H: 'The AC disconnect directly adjacent to the main electric panel and the production meter socket must be installed within 12 feet and within line of site of the main electric panel...ALL equipment should be on the same side of the gate/fence.'
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Yes
Why the confidence is not higherMID's Electric Service Guide requires modules and inverters to be UL 1703/UL 1741 listed by a nationally recognized testing laboratory AND on the California Energy Commission's list of 'Eligible Equipment.'
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, batteries/ESS are permitted, but must be configured only for customer backup power or peak-shaving — MID prohibits any ESS from being configured to export power back onto MID's grid
Why the confidence is not higherMID's Electric Service Guide — Solar Photovoltaic (which explicitly covers 'Solar With Optional Energy Storage Systems') states: 'All ESS solutions shall be configured to provide backup power for the customer in case of an outage or peak shaving only. ESS shall not be configured to export power back onto MID's system.' This is the utility's interconnection condition; the City's own fire-code/building-code ESS permit conditions under the 2025 CFC could not be separately confirmed beyond the general adoption noted in q31/q32.
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Likely yes for a stand-alone/commercial ESS (SCFPD's fire fee schedule lists a distinct 'Battery Systems' fee of $397.45), but not confirmed for a residential system bundled with a new PV array
Why the confidence is not higherSCFPD's Master Fee Schedule (in the same Jan 2026 agenda packet as the fire-code ordinance) lists 'Battery Systems' as its own commercial fee line item separate from 'Solar Photovoltaic Installations (Commercial)' ($397.45 each), implying a distinct fire-side ESS review step for commercial projects; no equivalent residential-specific ESS permit/fee line was found in either the City's building fee schedule or SCFPD's fee schedule.
fire district fee schedule checked 2026-08-30 https://www.scfpd.us/files/951c32670/SCFPD+Board+of+Directors+Meeting+Agenda+1-14-26.pdf
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedLooked for a ground-mount-as-structure provision in Title 17 (Zoning) and Title 15 (Buildings); both eCode360 chapters are Cloudflare-blocked on every fetch method tried, and no secondary source stating Waterford's specific treatment of ground-mounted PV was found.
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Between the main electric panel and the production/generation meter socket, within 12 feet and in line of sight of the main panel, in a readily accessible location; meter-socket centerline height must be 48-75 inches
Why the confidence is not higherQuoted from MID's Electric Service Guide, Section E (Grid Interconnection): 'The first AC disconnect should be located between the electric panel and the production meter socket...must be installed within 12 feet and within line of site of the main electric panel in a readily accessible location,' with meter socket height limits confirmed in the 'Common Reasons for Interconnection Problems' table.
utility electric service guide checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone 65% · application checklist
- How much notice is required? Effectively next business day — the checklist instructs applicants to call before 4pm to schedule, implying inspections booked one business day ahead 50% · application checklist
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 65% · authority's own staff directory
- If delegated, to whom? N/A — not delegated (see q52) 65% · authority's own staff directory
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
Nothing recorded for City of Waterford on this step yet — 2 questions checked and found unpublished. The guidance above is general.
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- What must be on site at inspection? The approved/stamped plan set, and (per MID's process) proof that the local inspection has passed before MID's own interconnection inspection 55% · application checklist (inference)
- Does the inspector verify labels and listings? Likely yes, but not confirmed in a Waterford-specific published document 45% · utility electric service guide (inference)
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (a signed-off/passed final building & electrical inspection) 75% · utility electric service guide (describing AHJ output)
- Who notifies the utility for PTO? Installer (the solar contractor) 90% · utility interconnection handbook
14 questions answered against City of Waterford’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone
Why the confidence is not higherThe City's Building Permit Application Checklist states: 'Please call (209)874-2328 before 4pm to schedule Inspections.' This document is a general (non-solar-specific) checklist filed in 2021; no separate Symbium-integrated online inspection-scheduling tool was found described on the City's solar page.
application checklist checked 2026-08-30 https://www.cityofwaterford.org/wp-content/uploads/2021/06/Building-Application-FullPacket-fillable-1.pdf
Q50 How much notice is required? Core Booking & scheduling
Effectively next business day — the checklist instructs applicants to call before 4pm to schedule, implying inspections booked one business day ahead
Why the confidence is not higherInferred from the same checklist line ('call before 4pm to schedule Inspections'); no explicit 'X business days' notice requirement is separately stated.
application checklist checked 2026-08-30 https://www.cityofwaterford.org/wp-content/uploads/2021/06/Building-Application-FullPacket-fillable-1.pdf
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedLooked in the Building Permit Application Checklist and Building Department page for any mention of AM/PM inspection windows; none is stated in either document.
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherThe City's own staff directory lists a 'Building Inspector' position on the City's own phone extension (Ext. 110), distinct from the contracted City Engineer (MCR Engineering) and City Planner (JB Anderson) roles, indicating the City performs its own building/electrical final inspections rather than delegating that function to the County or a private inspection firm; no delegation was found in web search.
authority's own staff directory checked 2026-08-30 https://cityofwaterford.org/contact/staff-directory/
Q53 If delegated, to whom? Core Who inspects
N/A — not delegated (see q52)
Why the confidence is not higherSee q52; the City's Building Inspector role appears to be performed in-house on the City's own phone system, with no named third-party inspection firm found.
authority's own staff directory checked 2026-08-30 https://cityofwaterford.org/contact/staff-directory/
Q54 Which inspections are required, and in what order? Core Stages & sequence
Nothing published by this authority.
Where we lookedLooked in the Building Permit Application Checklist and the residential solar page for a stated solar-specific inspection sequence/stages; only a generic new-construction inspection sequence would be inferable from the general checklist, and neither the City page nor Symbium's landing page states a solar-specific sequence.
https://www.cityofwaterford.org/building-permits/residential-solar-permits/
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedLooked for a stated rough-in/mid-roof inspection requirement for rooftop PV specifically; not found in the accessible City documents (general checklist covers new construction, not a PV retrofit sequence).
Q56 Does the inspector verify labels and listings? Core What is checked
Likely yes, but not confirmed in a Waterford-specific published document
Why the confidence is not higherMID's own separate Interconnection Inspection explicitly verifies 'the correct electrical wiring of required devices...as well as installation of MID required signage (placarding)' as a condition before the utility will energize/issue PTO, and MID requires a 'copy of the passed solar inspection results issued by the City/County' first — implying the City's own final electrical inspection is expected to check equipment/labels per standard CEC/NEC practice, but no Waterford-specific inspection checklist naming label verification was found.
utility electric service guide (inference) checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q57 Is there a published inspection checklist? Core What is checked
Nothing published by this authority.
Where we lookedLooked on the Building Department page and the residential-solar page for a published, Waterford-specific solar inspection checklist; none is posted publicly. MID publishes its own 'Common Reasons for Interconnection Problems' table (which functions as a checklist for the utility's inspection), but that is MID's inspection, not the City's.
https://cityofwaterford.org/departments/city-managers-office/building-department/
Q58 What must be on site at inspection? Core Documents on site
The approved/stamped plan set, and (per MID's process) proof that the local inspection has passed before MID's own interconnection inspection
Why the confidence is not higherInferred from standard practice (the City's general application notes 'You will receive one set of stamped approved drawings back with your approved permit') and from MID's requirement that the City/County passed-inspection result be produced before MID's own inspection; no Waterford-specific 'what must be on site' list for solar was separately published.
application checklist (inference) checked 2026-08-30 https://www.cityofwaterford.org/wp-content/uploads/2021/06/Building-Application-FullPacket-fillable-1.pdf
Q59 Is there a re-inspection fee? Corrections & re-inspection
Nothing published by this authority.
Where we lookedLooked in the City's residential fee schedule and fee master for a stated re-inspection fee; none is itemized there (only a generic 'Miscellaneous: Time and Materials' catch-all). Note MID, the utility, separately charges a $250 re-inspection fee for a failed Interconnection Inspection, but that is a utility fee, not the City's.
https://cityofwaterford.org/wp-content/uploads/2025/01/SAMPLE-RESIDENTIAL-BUILDING-FEES-2025.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Nothing published by this authority.
Where we lookedLooked on the Building Department page and in the application checklist for a stated corrections/re-inspection process; not published there beyond the general instruction to call and schedule inspections.
https://cityofwaterford.org/departments/city-managers-office/building-department/
Q61 What is issued on pass? Core Final sign-off & PTO
Final (a signed-off/passed final building & electrical inspection)
Why the confidence is not higherMID's Electric Service Guide describes the City/County step as producing a 'final, signed-off permit' / 'passed inspection results' rather than a Certificate of Occupancy (which would not apply to an accessory PV retrofit on an existing home); no separate 'green tag' or letter terminology was found in Waterford's own documents.
utility electric service guide (describing AHJ output) checked 2026-08-30 https://www.mid.org/wp-content/uploads/Service-Guide-Solar-PV-2025.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer (the solar contractor)
Why the confidence is not higherMID's Solar Interconnection Handbook states: 'the solar contractor will need to submit the copy of the City/County passed inspection results to pv@mid.org' to trigger MID's own Interconnection Inspection and, on passing, MID's Permission to Operate (PTO) letter — i.e., the installer/contractor is the party who notifies the utility, not the AHJ.
utility interconnection handbook checked 2026-08-30 https://www.mid.org/wp-content/uploads/MID-Solar-Handbook_FINAL_2026-1.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for City of Waterford against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
City of Waterford is the authority having jurisdiction 88% confidence
- Holds
- building and electrical (both, in-house)
- Overridden by
- Not overridden for permitting itself. Modesto Irrigation District (MID) — the interconnecting utility, not PG&E or Turlock Irrigation District — runs a parallel gatekeeping process: its engineering-review approval is needed before installation, and its own Interconnection Inspection/Permission-to-Operate (which the City does not control) requires the City's final permit sign-off first and imposes its own placard/equipment specifications beyond the City's. California's Solar Rights Act (Gov. Code §65850.5) and SB 379 (Gov. Code §65850.52, implemented here via the Symbium portal) also constrain what the City may require/how fast it must review for qualifying systems.
- Why not higher
- The City's own 'Residential Solar Permits' page and Building Department page confirm the City issues residential building and electrical permits directly (combined into one application/fee for solar), with an in-house Building Inspector (own phone extension) rather than a contracted county or private plan-check firm — unlike the City Engineer (MCR Engineering) and City Planner (JB Anderson Land Use and Planning) roles, which ARE contracted out per the City's own staff directory. Independently, MID's own Electric Service Guide lists 'City of Waterford Building Division' by name/address as the local governing authority within its service area, corroborating the City (not Stanislaus County) as the AHJ for this address.
https://cityofwaterford.org/departments/city-managers-office/building-department/
- Permit required
- Yes95%
- Permit cost
- $395 flat90%
- Plan review
- Up to 10 business days for plans requiring plan review (per the general checklist); SB 379/Symbium-eligible standard systems are intended to receive instantaneous automated approval55%
- Portal
- Symbium (automated SB 379 solar permitting platform)95%
- Electrical code
- 2023 NEC (as incorporated into the 2025 California Electrical Code, Title 24 Part 3)55%
- Own placard wording
- Yes (by the utility, MID) — not confirmed for the City itself75%
- Booking an inspection
- Phone65%
Labels & placards for this authority
City of Waterford writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 75%
Yes (by the utility, MID) — not confirmed for the City itself
Size, colour & material 90%
Minimum 1/4-inch letters, impressed into or raised from a tag of plastic laminate, aluminum, brass, or other non-ferrous metal; attached with high-strength 5-minute epoxy (not removable without hand tools; rivets/screws not acceptable)
Where they go 85%
At/adjacent to the AC disconnects, the production/generation meter socket, and the main service panel — all within about 12 feet and in line of sight of each other, on the same side of any gate/fence as the main panel
What the utility wants on top 95%
Yes
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
