Del Norte County
State of California
Del Norte County is a county authority in the State of California, covering 7 regions, serving 27,743 residents. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Effectively combined — one PV permit fee line ('plan check & inspection') covers the system, Q4 Plan review — Usually 1 to 3 days for expedited-eligible systems Q18 Where you file — No dedicated online permit portal identified — applications are submitted by email or in person to the Building Inspection Division (building@co.del-norte.ca.us) Q20
- Permit required
- Yes95% source
- What it costs
- $130 flat (plan check & inspection combined) for residential roof-mounted PV up to 20 kW AC; $260 flat for 21 kW AC and over88% source
- Plan review turnaround
- Usually 1 to 3 days for expedited-eligible systems88% source
- Key document
- ordinance (OCR'd, image-only PDF) cited by 5 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes — Del Norte County is the AHJ for residential solar on parcels in the unincorporated area (not Crescent City, which is a separate incorporated city with its own building department) 92% · fee schedule
- What does this authority permit itself, and what does it delegate? Both — the Building Inspection Division of the Community Development Department issues both building and electrical permits itself; nothing is delegated to a separate agency 92% · department page
- Is a permit required for a residential rooftop PV system? Yes 95% · ordinance / department page
- Is there a separate electrical permit, or is it combined? Effectively combined — one PV permit fee line ('plan check & inspection') covers the system, though the expedited page refers to 'the building and electrical permits' (plural) being issued together as one package 60% · fee schedule
- Is a HOA or architectural approval required first? No 92% · ordinance (OCR'd, image-only PDF)
- Is there a historic-district review? Conditional — only for parcels within the county's Historic (H) overlay zone, where exterior alterations require Historic Review Board approval before a permit can issue; not a countywide requirement for solar generally 55% · secondary source describing zoning overlay
- Is a wind or windstorm certification required? No 80% · department page (absence)
- Is a Specific Use Permit or Council approval ever required? Conditionally — only if the Building Inspection Division makes written findings, based on substantial evidence, that the proposed system could have a specific adverse impact on public health and safety, in which case a use permit under Title 20 (inland) or Title 21 (coastal) is required; not required for a routine expedited-eligible system 88% · ordinance (OCR'd, image-only PDF)
- Is there a system-size cap on residential generation? No absolute countywide cap — but the streamlined/expedited review path only applies to systems 'no larger than 10 kilowatts alternating current nameplate rating or 30 kilowatts thermal' on a single/duplex dwelling; larger residential systems are still permittable but must go through standard (non-expedited) plan review 85% · ordinance (OCR'd, image-only PDF)
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either — a licensed contractor, or the homeowner as owner-builder 80% · permit application form
- Must the contractor be registered with this authority before applying? No 55% · department page
- Is a homeowner permitted to self-install and self-permit? Yes 80% · permit application form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Building Permit Application; Building Permit Checklist (items relevant to project); Eligibility Checklist for Expedited Residential Solar Photovoltaic Permitting; Solar Panel PV Standard Plan for 1- and 2-Family Dwellings (with manufacturer spec sheets for inverter/modules/combiner boxes/racking, single-line diagram, and roof layout diagram) 92% · department page + checklist
- How many copies, and in what format? General Building Permit Checklist calls for 3 complete sets of construction plans and 4 copies of an 8.5x11 plot plan; County Code §14-17.40(A) separately authorizes electronic submittal (email) with e-signatures accepted in lieu of a wet signature 70% · published checklist
- Is a site plan required, and what must it show? Yes — a plot plan showing distances to property lines/existing structures (general checklist), plus a PV-specific roof layout diagram showing panel/module locations, clear access pathways, and approximate locations of electrical disconnects and roof access points 88% · checklist / standard plan
- Is a one-line / three-line diagram required? Yes 95% · standard plan
- Are string and conductor calculations required? Yes 95% · standard plan
- Is a structural PE stamp required, and at what threshold? Discretionary, no published numeric threshold — the Building Inspection Division 'may require' new foundation/structural plans to be stamped by a CA-licensed engineer or architect for residential work (mandatory only for commercial); the Eligibility Checklist separately calls for 'Structural Criteria and supporting documentation... if required' without stating a size trigger 60% · published checklist
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? No dedicated online permit portal identified — applications are submitted by email or in person to the Building Inspection Division (building@co.del-norte.ca.us) 75% · department page
- Can the whole application be completed online? No — there is no self-service online portal (no online payment or status tracking found), though electronic submittal by email with e-signatures is explicitly authorized 75% · ordinance (OCR'd, image-only PDF)
- What does a residential solar permit cost? $130 flat (plan check & inspection combined) for residential roof-mounted PV up to 20 kW AC; $260 flat for 21 kW AC and over 88% · fee schedule
- How is the fee calculated? Tiered — a flat fee per kW-AC tier (not valuation-based, unlike the general building-permit fee table) 88% · fee schedule
- Is there a separate plan-check fee? No 75% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? Usually 1 to 3 days for expedited-eligible systems 88% · department page
- How long is an issued permit valid before it expires? 180 days — the permit becomes null and void if work does not commence within 180 days, or is abandoned for 180 days with no inspections 92% · permit application form
- Which utility handles interconnection here? Pacific Power (PacifiCorp) 80% · utility source
- Where does the utility sit in the sequence? Parallel / No dependency at the county-permit stage — the county issues the building/electrical permit independent of utility approval, but the applicant must separately obtain the utility's interconnection approval before energizing 70% · ordinance (OCR'd, image-only PDF)
28 questions answered against Del Norte County’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes — Del Norte County is the AHJ for residential solar on parcels in the unincorporated area (not Crescent City, which is a separate incorporated city with its own building department)
Why the confidence is not higherCounty's own fee-schedule PDF explicitly scopes building inspection to 'the unincorporated area of the County of Del Norte'
fee schedule checked 2026-08-30 https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

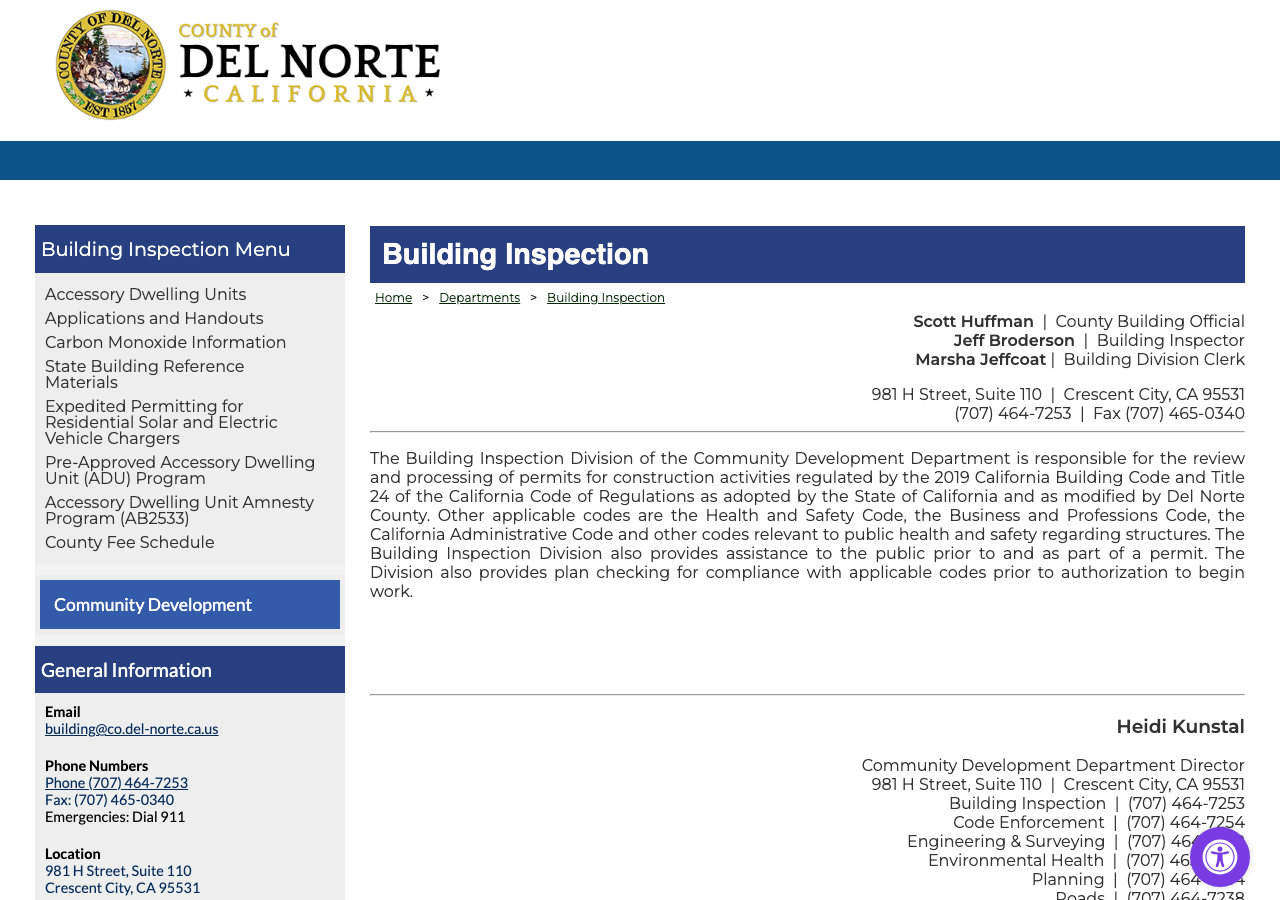

Both — the Building Inspection Division of the Community Development Department issues both building and electrical permits itself; nothing is delegated to a separate agency
Why the confidence is not higherFee schedule has a dedicated 'Electric Permits' section under Building Inspection; expedited-solar page issues 'building and electrical permits' from the same division
department page checked 2026-08-30 https://www.co.del-norte.ca.us/departments/buildinginspection
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherCounty Code Title 14 Ch.17 (Ordinance 2022-001) and the fee schedule's dedicated PV line items both presuppose a required permit; expedited page states 'no work can begin until the building and electrical permits are issued'
ordinance / department page checked 2026-08-30 https://www.co.del-norte.ca.us/departments/BuildingInspection/ExpeditedPermittingforResidentialSolarandElectricVehicleChargers
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Effectively combined — one PV permit fee line ('plan check & inspection') covers the system, though the expedited page refers to 'the building and electrical permits' (plural) being issued together as one package
Why the confidence is not higherFee schedule shows a single tiered PV fee ($130/$260) rather than separate building-fee and electrical-fee lines, but the department's own process text uses plural 'permits' — genuinely ambiguous from the primary sources available
fee schedule checked 2026-08-30 https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either — a licensed contractor, or the homeowner as owner-builder
Why the confidence is not higherThe county's own Building Permit Application form has a dedicated signature line 'SIGNATURE OF OWNER (IF OWNER/BUILDER)' alongside the contractor signature line, confirming owner-builder permits are accepted; no county document restricts solar specifically to licensed electricians only
permit application form checked 2026-08-30 https://drive.google.com/file/d/1bSCPLZOvX0vNICNVZLVucctmB43ZLbft/view
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
No
Why the confidence is not higherNo county-specific contractor registration/pre-qualification program was found on the Building Inspection, Materials, or Fee Schedule pages; the Materials page only links out to the state CSLB license-lookup tool, implying verification against the state license, not a local registration step
department page checked 2026-08-30 https://www.co.del-norte.ca.us/departments/BuildingInspection/Materials
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherBuilding Permit Application form provides an explicit 'signature of owner (if owner/builder)' line, and no county document found restricts solar installation to licensed contractors only
permit application form checked 2026-08-30 https://drive.google.com/file/d/1bSCPLZOvX0vNICNVZLVucctmB43ZLbft/view
Q8 What documents make up a complete submittal? Core Submittal package
Building Permit Application; Building Permit Checklist (items relevant to project); Eligibility Checklist for Expedited Residential Solar Photovoltaic Permitting; Solar Panel PV Standard Plan for 1- and 2-Family Dwellings (with manufacturer spec sheets for inverter/modules/combiner boxes/racking, single-line diagram, and roof layout diagram)
Why the confidence is not higherListed step-by-step on the county's own expedited-permitting page and confirmed by the actual checklist/standard-plan PDFs it links to
department page + checklist checked 2026-08-30 https://www.co.del-norte.ca.us/departments/BuildingInspection/ExpeditedPermittingforResidentialSolarandElectricVehicleChargers
Q9 How many copies, and in what format? Submittal package
General Building Permit Checklist calls for 3 complete sets of construction plans and 4 copies of an 8.5x11 plot plan; County Code §14-17.40(A) separately authorizes electronic submittal (email) with e-signatures accepted in lieu of a wet signature
Why the confidence is not higherThe '3 sets / 4 copies' figures come from the county's general Building Permit Checklist rather than a solar-specific copy count, but nothing on the solar-specific pages contradicts it and the ordinance explicitly allows electronic submittal as an alternative
published checklist checked 2026-08-30 https://drive.google.com/file/d/1PMufGiMoGgexFZuO0GjueH6yXsyMKq35/view
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — a plot plan showing distances to property lines/existing structures (general checklist), plus a PV-specific roof layout diagram showing panel/module locations, clear access pathways, and approximate locations of electrical disconnects and roof access points
Why the confidence is not higherCombines the general Building Permit Checklist's plot-plan requirement with the Solar PV Standard Plan's roof-layout-diagram page, both the county's own documents
checklist / standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherSolar PV Standard Plan requires selecting and completing 'Single Line Diagram 1' or 'Single Line Diagram 2 with Single Line Diagram 4' depending on configuration
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q12 Are string and conductor calculations required? Drawings & calculations
Yes
Why the confidence is not higherThe Standard Plan walks through Voc/Isc string calculations, maximum modules-in-series tables, and conductor-sizing tables (Steps 2-15) as a mandatory worksheet
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Discretionary, no published numeric threshold — the Building Inspection Division 'may require' new foundation/structural plans to be stamped by a CA-licensed engineer or architect for residential work (mandatory only for commercial); the Eligibility Checklist separately calls for 'Structural Criteria and supporting documentation... if required' without stating a size trigger
Why the confidence is not higherGeneral Building Permit Checklist language is 'may require' for residential (no fixed valuation/size threshold given); commercial is the only tier with a stated mandatory-stamp rule
published checklist checked 2026-08-30 https://drive.google.com/file/d/1PMufGiMoGgexFZuO0GjueH6yXsyMKq35/view
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedSolar PV Standard Plan (full 13-page OCR text), Eligibility Checklist, general Building Permit Checklist — none states a numeric threshold at which an electrical PE stamp (as distinct from the structural stamp) is required
https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q15 What does a residential solar permit cost? Core Fees
$130 flat (plan check & inspection combined) for residential roof-mounted PV up to 20 kW AC; $260 flat for 21 kW AC and over
Why the confidence is not higherBuilding Inspection fee schedule PDF, revision-stamped (ModDate) 21 Mar 2024 per its own metadata; read via OCR because the PDF has no text layer
fee schedule checked 2026-08-30 https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q16 How is the fee calculated? Core Fees
Tiered — a flat fee per kW-AC tier (not valuation-based, unlike the general building-permit fee table)
Why the confidence is not higherFee schedule lists distinct flat PV line items by kW tier (up to 20 kW vs 21 kW+) rather than applying the general Total-Valuation fee table used for other construction
fee schedule checked 2026-08-30 https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q17 Is there a separate plan-check fee? Fees
No
Why the confidence is not higherThe PV fee line items are explicitly labeled '(plan check & inspection)' as one combined number rather than listing a separate plan-check fee, unlike the general valuation-based building permit fee table which does list Plan Check separately
fee schedule checked 2026-08-30 https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Usually 1 to 3 days for expedited-eligible systems
Why the confidence is not higherStated directly on the county's expedited-permitting page: 'a permit will be processed and approved for issuance in a timely manner (usually 1 to 3 days)'
department page checked 2026-08-30 https://www.co.del-norte.ca.us/departments/BuildingInspection/ExpeditedPermittingforResidentialSolarandElectricVehicleChargers
Q19 How long is an issued permit valid before it expires? Timeline & validity
180 days — the permit becomes null and void if work does not commence within 180 days, or is abandoned for 180 days with no inspections
Why the confidence is not higherPrinted directly on the county's own Building Permit Application form (not solar-specific, but this is the same form used to apply for the solar permit)
permit application form checked 2026-08-30 https://drive.google.com/file/d/1bSCPLZOvX0vNICNVZLVucctmB43ZLbft/view
Q20 Which permit portal does this authority use? Core Portal & process
No dedicated online permit portal identified — applications are submitted by email or in person to the Building Inspection Division (building@co.del-norte.ca.us)
Why the confidence is not higherNo portal (Accela, eTRAKiT, CityView, etc.) is linked anywhere on the Building Inspection, Applications and Handouts, or Materials pages; the process described is document download, completion, and email/in-person submittal
department page checked 2026-08-30 https://www.co.del-norte.ca.us/departments/BuildingInspection
Q21 Can the whole application be completed online? Core Portal & process
No — there is no self-service online portal (no online payment or status tracking found), though electronic submittal by email with e-signatures is explicitly authorized
Why the confidence is not higherCounty Code §14-17.40(A): applicant 'may submit the application and related documentation... by electronic submittal... Electronic signatures shall be accepted... in lieu of a wet signature' — this is email-based submission, not a self-service application portal
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q22 Which utility handles interconnection here? Core Utility interconnection
Pacific Power (PacifiCorp)
Why the confidence is not higherConfirmed from the utility's own public statements naming Crescent City and Del Norte County as its service area (not from a ZIP-code lookup tool, per the caution against PowerToChoose-style sources)
utility source checked 2026-08-30 https://www.pacificpower.net/about/newsroom/news-releases/pacific-power-restores-electricity.html
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel / No dependency at the county-permit stage — the county issues the building/electrical permit independent of utility approval, but the applicant must separately obtain the utility's interconnection approval before energizing
Why the confidence is not higherCounty Code §14-17.40(G): 'Approval does not authorize an applicant to connect the small residential rooftop energy system to the local utility's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility' — this describes two independent tracks, not utility gating permit issuance
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherCounty Code §14-17.40(F): 'Approval of an application for a small residential rooftop solar energy system shall not be based or conditioned on the approval of an association, as defined in section 4080 of the Civil Code'
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q25 Is there a historic-district review? Overlays & special cases
Conditional — only for parcels within the county's Historic (H) overlay zone, where exterior alterations require Historic Review Board approval before a permit can issue; not a countywide requirement for solar generally
Why the confidence is not higherFound via secondary summary of the zoning code's Historic (H) overlay provisions (Title 20/21), not a primary-source PDF I extracted myself; treat this as an inference pending direct-text confirmation
secondary source describing zoning overlay checked 2026-08-30 https://library.municode.com/co/del_norte
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherTDI-style windstorm certification is a Texas insurance-code mechanism; California building departments, including Del Norte, do not require one — no such requirement appears anywhere in the county's solar, building, or fee-schedule materials
department page (absence) checked 2026-08-30 https://www.co.del-norte.ca.us/departments/BuildingInspection/Materials
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Conditionally — only if the Building Inspection Division makes written findings, based on substantial evidence, that the proposed system could have a specific adverse impact on public health and safety, in which case a use permit under Title 20 (inland) or Title 21 (coastal) is required; not required for a routine expedited-eligible system
Why the confidence is not higherCounty Code §14-17.40(E)
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No absolute countywide cap — but the streamlined/expedited review path only applies to systems 'no larger than 10 kilowatts alternating current nameplate rating or 30 kilowatts thermal' on a single/duplex dwelling; larger residential systems are still permittable but must go through standard (non-expedited) plan review
Why the confidence is not higherCounty Code §14-17.20 defines 'small residential rooftop solar energy system' with this 10 kW AC / 30 kW thermal ceiling for expedited eligibility only
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC (as the California Electrical Code, Title 24 Part 3) applies by default statewide adoption — the California Building Standards Commission's list of locally filed ordinances shows NO amendment ordinance on file for Del Norte County for the 2022 code cycle, meaning the county has not opted out of or delayed the state's standard code cycle 55% · state code-adoption filing list
- Which building code edition is in force? By default, the current state code cycle applies (2022 CBC effective 2023, transitioning to the 2025 CBC effective 1 Jan 2026) because no local amendment ordinance is on file with CBSC for Del Norte County — HOWEVER the county's own Building Inspection Division webpage text still explicitly states '2019 California Building Code,' which predates the current mandatory cycle by two full code cycles. This is flagged as a stale-page finding, not a confirmed local adoption of 2019. 50% · department page (stale, per own text)
- Are there local amendments to any of the above? No local amendment ordinance is on file with the state for the current building code cycle 65% · state code-adoption filing list
- What is the installation judged against? The state-adopted California Building Standards Code parts as codified into the county's own fee schedule: California Building Standards Administrative Code (Title 24 Pt.1), CBC (Pt.2), CEC/California Electrical Code (Pt.3), Mechanical (Pt.4), Plumbing (Pt.5), Energy (Pt.6), Historical Building Code (Pt.8), Building Conservation (Pt.10), Reference Standards (Pt.12), plus the Uniform Housing Code 80% · fee schedule
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
Nothing recorded for Del Norte County on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Rapid shutdown is not separately addressed in the county's own Solar PV Standard Plan text; it would be governed by whichever NEC/CEC edition is in force (NEC 690.12 rapid-shutdown has been mandatory since the 2017 NEC), which per q29 is inferred rather than confirmed locally 50% · standard plan
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Per the Standard Plan's Markings page: (1) WARNING - inverter output connection / do-not-relocate OCPD label (CEC 705.12(D)(7)); (2) WARNING - DC conductors ungrounded/may be energized (CEC 690.35(F), ungrounded systems only); (3) WARNING: PHOTOVOLTAIC POWER SOURCE marking on junction/combiner boxes and conduit every 10 ft (CRC R331.2, CFC 605.11.1); (4) WARNING - dual power sources / PV rated AC output plaque (CEC 690.54, 705.12(D)(4)); (5) PV System AC Disconnect rating placard (CEC 690.54); (6) WARNING - ground-fault shock hazard (CEC 690.5(C)); (7) WARNING - do not touch terminals, both sides may be energized (CEC 690.17); (8) PV System DC Disconnect rating placard (CEC 690.53); (9) a permanent plaque/directory denoting all electric power sources on the premises (CEC 705.12) 90% · standard plan
- Does the authority specify placard wording of its own? No — the placard text reproduced in the standard plan is the wording required by the referenced CEC/CRC/CFC sections themselves, not custom county-authored wording 80% · standard plan
- Does it specify letter height, colour or material? Advisory only, not mandatory: the Standard Plan's informational note cites ANSI Z535.4 and suggests 'a phenolic plaque with contrasting colors between the text and background' and '20 point (3/8") should be considered the minimum' letter height — explicitly framed as guidance ('informational note'), not a mandatory county spec 85% · standard plan
- Is a site plan / facility map placard required, and what must it show? Yes — a Roof Layout Diagram is required showing the roof layout of all panels/modules, clear access pathways, and approximate locations of electrical disconnecting means and roof access points 88% · standard plan
- Where must the labels be placed? At the inverter output OCPD, the AC and DC disconnects, junction/combiner boxes, and along exposed conduit runs (marked at least every 10 feet) 85% · standard plan
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes, in the general sense required by code — equipment must be listed and labeled for its application (CEC 690.4(D)) and installed per its listing/labeling instructions (CEC 110.3); this is a code requirement carried into the standard plan, not a distinct county-maintained approved-products list 75% · standard plan
- Are batteries permitted, and under what conditions? Systems WITH battery storage are excluded from the expedited/streamlined review path and must go through standard (non-expedited, comprehensive) permitting; no separate county-published battery/ESS submittal package was found 82% · published checklist
- Is there a local rule on service upgrades or busbar sizing? For the EXPEDITED review path only: system must interconnect to a single-phase 120/240 Vac service panel with a bus bar rating of 225 A or less, connected to the load side of the utility distribution equipment; this is an eligibility threshold for the streamlined process, not a blanket county-wide busbar rule for all PV installs 85% · published checklist
20 questions answered against Del Norte County’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC (as the California Electrical Code, Title 24 Part 3) applies by default statewide adoption — the California Building Standards Commission's list of locally filed ordinances shows NO amendment ordinance on file for Del Norte County for the 2022 code cycle, meaning the county has not opted out of or delayed the state's standard code cycle
Why the confidence is not higherThis is an inference from (a) the CBSC ordinance-filing list showing Del Norte with no filed local amendment, and (b) statewide CEC adoption timelines; it is NOT sourced to a Del Norte document naming '2023 NEC' directly — the county's own Building Inspection webpage still displays stale text naming the 2019 CBC, which is a genuine discrepancy worth flagging rather than trusting at face value
state code-adoption filing list checked 2026-08-30 https://www.dgs.ca.gov/BSC/Codes/2022-Ordinances
Q30 Which building code edition is in force? Core Code editions in force
By default, the current state code cycle applies (2022 CBC effective 2023, transitioning to the 2025 CBC effective 1 Jan 2026) because no local amendment ordinance is on file with CBSC for Del Norte County — HOWEVER the county's own Building Inspection Division webpage text still explicitly states '2019 California Building Code,' which predates the current mandatory cycle by two full code cycles. This is flagged as a stale-page finding, not a confirmed local adoption of 2019.
Why the confidence is not higherDirect conflict between the county's own (evidently outdated) department-page text and the state filing record showing no local override — genuinely ambiguous which is currently enforced in practice; recommend a phone confirmation before relying on this for a live permit
department page (stale, per own text) checked 2026-08-30 https://www.co.del-norte.ca.us/departments/buildinginspection
Q31 Which fire code edition is in force? Code editions in force
Nothing published by this authority.
Where we lookedThe Building Inspection fee schedule's own list of adopted Title 24 parts (Administrative, Building, Electrical, Mechanical, Plumbing, Energy, Historical Building, Building Conservation, Reference Standards, plus Uniform Housing Code) NOTABLY OMITS Part 9 (Fire Code); searched for a separate fire-code adoption ordinance or fire marshal page and found only the State Minimum Fire Safe Regulations (defensible-space/WUI, not a structural fire-code edition)
https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q32 Are there local amendments to any of the above? Core Code editions in force
No local amendment ordinance is on file with the state for the current building code cycle
Why the confidence is not higherCalifornia Building Standards Commission's 2022-Ordinances list shows a 'DEL NORTE COUNTY' entry with no ordinance number, meaning the county did not file a local-amendment ordinance for that cycle; this does not rule out amendments to non-building codes (e.g., fire) which were not checked in this same database
state code-adoption filing list checked 2026-08-30 https://www.dgs.ca.gov/BSC/Codes/2022-Ordinances
Q33 What is the installation judged against? Core Electrical
The state-adopted California Building Standards Code parts as codified into the county's own fee schedule: California Building Standards Administrative Code (Title 24 Pt.1), CBC (Pt.2), CEC/California Electrical Code (Pt.3), Mechanical (Pt.4), Plumbing (Pt.5), Energy (Pt.6), Historical Building Code (Pt.8), Building Conservation (Pt.10), Reference Standards (Pt.12), plus the Uniform Housing Code
Why the confidence is not higherThis exact list is printed as the regulatory-basis paragraph at the top of the county's own Building Inspection fee schedule (OCR'd)
fee schedule checked 2026-08-30 https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
For the EXPEDITED review path only: system must interconnect to a single-phase 120/240 Vac service panel with a bus bar rating of 225 A or less, connected to the load side of the utility distribution equipment; this is an eligibility threshold for the streamlined process, not a blanket county-wide busbar rule for all PV installs
Why the confidence is not higherEligibility Checklist for Expedited Solar Photovoltaic Permitting, Electrical Requirements section C-D
published checklist checked 2026-08-30 https://drive.google.com/file/d/1vJmXI7F9L4_yZD5ZPlXQbowbuj7XUAC9/view
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedExpedited-permitting page, Eligibility Checklist, Solar PV Standard Plan — all three require manufacturer racking/mounting installation instructions to be attached but none states a county-specific attachment-spacing or mounting-system rule beyond following the manufacturer's own listing
https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Nothing published by this authority.
Where we lookedEligibility Checklist Fire Safety section ('Clear access pathways provided' as a yes/no checkbox, no dimensions given) and the Roof Layout Diagram page (asks for pathways to be drawn, does not itself specify ridge setback distance); no separate Del Norte fire-code amendment document was reachable to check for a locally-set number
https://drive.google.com/file/d/1vJmXI7F9L4_yZD5ZPlXQbowbuj7XUAC9/view
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Rapid shutdown is not separately addressed in the county's own Solar PV Standard Plan text; it would be governed by whichever NEC/CEC edition is in force (NEC 690.12 rapid-shutdown has been mandatory since the 2017 NEC), which per q29 is inferred rather than confirmed locally
Why the confidence is not higherThe 13-page Standard Plan (creation date Feb 2018) covers sizing/labeling/OCPD calculations in detail but contains no rapid-shutdown section or NEC 690.12 citation anywhere in its extracted text — an odd omission for a document of its vintage, so this is reported as a gap in the local document rather than a confirmed local rule
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Per the Standard Plan's Markings page: (1) WARNING - inverter output connection / do-not-relocate OCPD label (CEC 705.12(D)(7)); (2) WARNING - DC conductors ungrounded/may be energized (CEC 690.35(F), ungrounded systems only); (3) WARNING: PHOTOVOLTAIC POWER SOURCE marking on junction/combiner boxes and conduit every 10 ft (CRC R331.2, CFC 605.11.1); (4) WARNING - dual power sources / PV rated AC output plaque (CEC 690.54, 705.12(D)(4)); (5) PV System AC Disconnect rating placard (CEC 690.54); (6) WARNING - ground-fault shock hazard (CEC 690.5(C)); (7) WARNING - do not touch terminals, both sides may be energized (CEC 690.17); (8) PV System DC Disconnect rating placard (CEC 690.53); (9) a permanent plaque/directory denoting all electric power sources on the premises (CEC 705.12)
Why the confidence is not higherDirectly reproduced from the county's own Solar PV Standard Plan (Toolkit Document #3), markings page
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No — the placard text reproduced in the standard plan is the wording required by the referenced CEC/CRC/CFC sections themselves, not custom county-authored wording
Why the confidence is not higherEvery label in the Standard Plan is captioned with the code section it implements (e.g. CEC 690.53, CEC 705.12); no independent Del Norte wording is layered on top
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Advisory only, not mandatory: the Standard Plan's informational note cites ANSI Z535.4 and suggests 'a phenolic plaque with contrasting colors between the text and background' and '20 point (3/8") should be considered the minimum' letter height — explicitly framed as guidance ('informational note'), not a mandatory county spec
Why the confidence is not higherVerbatim from the Standard Plan's Markings page footer
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes — a Roof Layout Diagram is required showing the roof layout of all panels/modules, clear access pathways, and approximate locations of electrical disconnecting means and roof access points
Why the confidence is not higherFinal page of the county's own Standard Plan document, titled 'Roof Layout Diagram for One- and Two-Family Dwellings'
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedPacific Power's public Customer Generation / net metering pages (pacificpower.net) — found PowerClerk application-process and net-billing-tariff information but no downloadable DG interconnection manual or labeling spec reachable without a customer/contractor login
https://www.pacificpower.net/savings-energy-choices/customer-generation.html
Q43 Where must the labels be placed? Core Labels Signage & labelling
At the inverter output OCPD, the AC and DC disconnects, junction/combiner boxes, and along exposed conduit runs (marked at least every 10 feet)
Why the confidence is not higherLocations specified against each label diagram on the Standard Plan's Markings page
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Yes, in the general sense required by code — equipment must be listed and labeled for its application (CEC 690.4(D)) and installed per its listing/labeling instructions (CEC 110.3); this is a code requirement carried into the standard plan, not a distinct county-maintained approved-products list
Why the confidence is not higherStandard Plan's scope paragraph requires manufacturer spec sheets and cites CEC 110.3/690.4(D) directly; no separate Del Norte-specific equipment list was found
standard plan checked 2026-08-30 https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Systems WITH battery storage are excluded from the expedited/streamlined review path and must go through standard (non-expedited, comprehensive) permitting; no separate county-published battery/ESS submittal package was found
Why the confidence is not higherEligibility Checklist General Requirements, item D: 'Solar system is utility interactive and without battery storage' as a condition of eligibility for the expedited process
published checklist checked 2026-08-30 https://drive.google.com/file/d/1vJmXI7F9L4_yZD5ZPlXQbowbuj7XUAC9/view
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Nothing published by this authority.
Where we lookedEligibility Checklist and expedited-permitting page — both establish that battery/ESS systems are excluded from the expedited path, but neither describes what the standard (non-expedited) ESS permit or inspection process consists of, and no separate ESS-specific county document was found
https://drive.google.com/file/d/1vJmXI7F9L4_yZD5ZPlXQbowbuj7XUAC9/view
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedDel Norte County zoning code (Title 20/21) via delnortecounty.municipalcodeonline.com — this site is an AngularJS single-page app that returns a shell page with no chapter text to a direct fetch, and its /api/search endpoint 404s; could not reach primary zoning text on ground-mount/accessory-structure treatment in the time available
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedSolar PV Standard Plan's OCPD/point-of-interconnection section (covers bus-bar/OCPD sizing per CEC 705.12(D)(2) but not physical AC-disconnect-to-meter placement) and Pacific Power's public customer-generation pages — neither states a required physical location for the AC disconnect relative to the utility meter
https://www.co.del-norte.ca.us/media/CDD/Building%20Inspection/Solar%20PV%20System%20Information.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
Nothing recorded for Del Norte County on this step yet — 3 questions checked and found unpublished. The guidance above is general.
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes — the county performs its own final inspection and does not delegate it 90% · ordinance (OCR'd, image-only PDF)
- If delegated, to whom? Not delegated for the primary building/electrical inspection — county Building Inspection Division staff perform it directly. A separate fire-safety inspection MAY be performed by the local fire authority only if no interagency agreement exists for that authority to perform inspections on the county's behalf (implying that where such an agreement exists, fire items are covered within the county's own single inspection) 78% · ordinance (OCR'd, image-only PDF)
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? One combined final inspection is required for expedited-eligible small residential rooftop solar systems; a subsequent (re-)inspection is authorized if the system fails; a separate fire inspection may occur only absent an interagency agreement 82% · ordinance (OCR'd, image-only PDF)
- Is a rough-in or mid-roof inspection required? No 80% · ordinance (OCR'd, image-only PDF)
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
Nothing recorded for Del Norte County on this step yet — 3 questions checked and found unpublished. The guidance above is general.
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- Who notifies the utility for PTO? Installer/applicant — the county's approval of the permit does not authorize grid connection; the applicant is responsible for obtaining that approval directly from the utility 85% · ordinance (OCR'd, image-only PDF)
- Is there a re-inspection fee? $61/hour, plus $61/hour beyond the first hour (fee schedule item 108.8) 80% · fee schedule
- How are corrections issued and cleared? A written correction notice detailing all deficiencies and any additional required information/documentation is sent to the applicant for resubmission 88% · ordinance (OCR'd, image-only PDF)
14 questions answered against Del Norte County’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Nothing published by this authority.
Where we lookedBuilding Inspection department page and staff directory page — list phone (707-464-7253) and email (building@co.del-norte.ca.us) as general contact channels but no page explicitly describes how a scheduled inspection request is submitted (no online booking form found)
https://www.co.del-norte.ca.us/departments/buildinginspection
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedBuilding Inspection department page, Building Permit Application form, Ordinance 2022-001 — none states a specific advance-notice period (e.g., '24 hours', '2 business days') for booking an inspection
https://www.co.del-norte.ca.us/departments/buildinginspection
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedSame set of department pages/forms reviewed for q49-50 — no mention of same-day service or AM/PM inspection windows
https://www.co.del-norte.ca.us/departments/buildinginspection
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes — the county performs its own final inspection and does not delegate it
Why the confidence is not higherCounty Code §14-17.50(A): 'Only one inspection shall be required and performed by staff for small residential rooftop solar energy systems eligible for expedited review'
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q53 If delegated, to whom? Core Who inspects
Not delegated for the primary building/electrical inspection — county Building Inspection Division staff perform it directly. A separate fire-safety inspection MAY be performed by the local fire authority only if no interagency agreement exists for that authority to perform inspections on the county's behalf (implying that where such an agreement exists, fire items are covered within the county's own single inspection)
Why the confidence is not higherCounty Code §14-17.50(A) and (C) together
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q54 Which inspections are required, and in what order? Core Stages & sequence
One combined final inspection is required for expedited-eligible small residential rooftop solar systems; a subsequent (re-)inspection is authorized if the system fails; a separate fire inspection may occur only absent an interagency agreement
Why the confidence is not higherCounty Code §14-17.50(A)-(D) in full
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No
Why the confidence is not higherCounty Code §14-17.50(A) caps expedited-eligible residential solar at 'only one inspection... required and performed by staff' — no separate rough-in/mid-roof stage is described
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q56 Does the inspector verify labels and listings? Core What is checked
Nothing published by this authority.
Where we lookedOrdinance 2022-001 §14-17.50 (describes only that one inspection occurs, not what it checks) and the Standard Plan/Eligibility Checklist (list what must be submitted, not what the inspector verifies on site) — no explicit inspection-checklist item confirming label/listing verification was found
https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q57 Is there a published inspection checklist? Core What is checked
Nothing published by this authority.
Where we lookedBuilding Inspection, Materials, and Applications and Handouts pages — all list submittal-stage checklists (Eligibility Checklist, Building Permit Checklist) but no separate published field-inspection checklist was found
Q58 What must be on site at inspection? Core Documents on site
Nothing published by this authority.
Where we lookedBuilding Inspection department page and Building Permit Application form — describe what must be submitted to apply, not what must be present on site at the time of the inspection itself; no such list was found
https://www.co.del-norte.ca.us/departments/buildinginspection
Q59 Is there a re-inspection fee? Corrections & re-inspection
$61/hour, plus $61/hour beyond the first hour (fee schedule item 108.8)
Why the confidence is not higherThis is the general county reinspection fee applicable to all building permits (not solar-specific), found in the same Building Inspection fee schedule PDF that lists the PV fees
fee schedule checked 2026-08-30 https://drive.google.com/file/d/1Ru3_onvARPMRR6bBY54cQ1zioBL9hd_a/view
Q60 How are corrections issued and cleared? Corrections & re-inspection
A written correction notice detailing all deficiencies and any additional required information/documentation is sent to the applicant for resubmission
Why the confidence is not higherCounty Code §14-17.40(C)
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Q61 What is issued on pass? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedBuilding Permit Application form (has fields for 'Completion Date' and 'Insp Sheet' but no named final-approval document type) and Ordinance 2022-001 §14-17.50 (states an inspection occurs but not what document/tag is issued on passing) — no 'Final', 'CO', 'green tag' or equivalent term found in any Del Norte document reviewed
https://drive.google.com/file/d/1bSCPLZOvX0vNICNVZLVucctmB43ZLbft/view
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer/applicant — the county's approval of the permit does not authorize grid connection; the applicant is responsible for obtaining that approval directly from the utility
Why the confidence is not higherCounty Code §14-17.40(G): 'Approval does not authorize an applicant to connect the small residential rooftop energy system to the local utility's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility'
ordinance (OCR'd, image-only PDF) checked 2026-08-30 https://drive.google.com/file/d/1ZxmsLCRbd4Bze4Kvx5s0NhKD0mef59Um/view
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for Del Norte County against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
Del Norte County is the authority having jurisdiction 92% confidence
- Holds
- Both — building and electrical, combined in one division
- Overridden by
- Crescent City is a separate incorporated AHJ with its own building department for parcels inside city limits; this record covers the unincorporated county only. State law (Gov. Code §65850.5/§65850.7, implemented via County Code Title 14 Ch.16-17) sets the expedited-review framework the county must follow.
- Why not higher
- The county's own Building Inspection fee schedule states building inspection fees apply 'for all buildings and/or structures in the unincorporated area of the County of Del Norte,' and building AND electrical permits are both issued by the Building Inspection Division of the Community Development Department (fee schedule lists an 'Electric Permits' section under the same division; expedited-solar page says 'no work can begin until the building and electrical permits are issued'). The brief's premise (check which department actually holds building/electrical) checks out here: it is not a separate 'Planning' or standalone 'Building Department' — it is the Building Inspection Division inside the Community Development Department (CDD), and CDD's director (Heidi Kunstal) oversees Planning, Building Inspection, Code Enforcement, Environmental Health, Engineering & Surveying, and Roads as one combined agency, unlike Alameda's CDA/PWA split.
https://www.co.del-norte.ca.us/departments/buildinginspection
Check the code edition before you build
This authority's published code edition does not match what the state has adopted. That usually means the authority's ordinance has not been updated for the current cycle — but a local amendment can also be lawful. Confirm with the building department before you submit.
- Permit required
- Yes95%
- Permit cost
- $130 flat (plan check & inspection combined) for residential roof-mounted PV up to 20 kW AC; $260 flat for 21 kW AC and over88%
- Plan review
- Usually 1 to 3 days for expedited-eligible systems88%
- Portal
- No dedicated online permit portal identified — applications are submitted by email or in person to the Building Inspection Division (building@co.del-norte.ca.us)75%
- Electrical code
- 2023 NEC (as the California Electrical Code, Title 24 Part 3) applies by default statewide adoption — the California Building Standards Commission's list of locally filed ordinances shows…55%
- Own placard wording
- No — the placard text reproduced in the standard plan is the wording required by the referenced CEC/CRC/CFC sections themselves, not custom county-authored wording80%
Labels & placards for this authority
Wording 80%
No — the placard text reproduced in the standard plan is the wording required by the referenced CEC/CRC/CFC sections themselves, not custom county-authored wording
Size, colour & material 85%
Advisory only, not mandatory: the Standard Plan's informational note cites ANSI Z535.4 and suggests 'a phenolic plaque with contrasting colors between the text and background' and '20 point (3/8") should be considered the minimum' letter height — explicitly framed as guidance ('informational note'), not a mandatory county spec
Where they go 85%
At the inverter output OCPD, the AC and DC disconnects, junction/combiner boxes, and along exposed conduit runs (marked at least every 10 feet)
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
