Glenn County

State of California

Verified Aug. 4, 2026

Glenn County is a county authority in the State of California, covering 4 regions, serving 28,917 residents. 583 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes. Q3 Electrical and building permits — Likely combined into a single building permit — the fee schedule lists 'Solar Residential - Roof Mounted' and 'Solar Residential - Ground Mounted' as their own… Q4 Where you file — eTRAKiT (CentralSquare Technologies), hosted at etrakit.countyofglenn.net — confirmed live today. Q20

Permit required
Yes.92% source
What it costs
$197.85 flat for Solar Residential - Roof Mounted; $171.33 flat for Solar Residential - Ground Mounted (both 'plus additional state mandated fees, if applicable').90% source
Key document
codified ordinance + fee schedule (absence) + general CA law cited by 8 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes — but only for UNINCORPORATED Glenn County. The two incorporated cities, Willows and Orland, are each a separate AHJ with their own in-house Building Division/Department. 95% · codified ordinance + two independent city department pages
    • What does this authority permit itself, and what does it delegate? Both — the county's own Planning & Community Development Services department, specifically its Building Inspector division (fee-schedule section header: 'Building & Inspection Services'), issues and inspects both building and electrical permits in-house for unincorporated-area residential solar. Fire-code enforcement is adopted by the county but its administration is defined per-parcel to whichever city or fire protection district serves that address (GCC 15.72.140), not to a single county fire office. 85% · department page + fee schedule + codified ordinance
    • Is a permit required for a residential rooftop PV system? Yes. 92% · fee schedule
    • Is there a separate electrical permit, or is it combined? Likely combined into a single building permit — the fee schedule lists 'Solar Residential - Roof Mounted' and 'Solar Residential - Ground Mounted' as their own distinct General-Construction-style line items (flat dollar figures, not scaled to the generic 'Electrical Permit Base fee' lines listed separately in the same schedule's 'Electrical Fees' subsection), consistent with a single combined solar permit type rather than a stand-alone electrical permit process for the same job. 62% · fee schedule (inference)
    • Is a HOA or architectural approval required first? No county-required HOA/architectural-committee approval found for solar specifically in any Glenn County document reviewed (expected, since HOAs are private covenants, not a county-administered process). California's Solar Rights Act (Civil Code §714/§4600) preempts an HOA's ability to disapprove or unreasonably restrict a compliant solar installation, regardless of CC&R language, statewide. 55% · codified ordinance + fee schedule (absence) + general CA law
    • Is a wind or windstorm certification required? No — California does not use a Texas-DOI/TDI-style separate wind-certification program. Wind loads are addressed through the adopted 2025 CBC/CRC's structural provisions (ASCE 7-based design), not a standalone wind-certificate process. No Glenn-specific wind-certification requirement was found in the reviewed materials. 55% · codified ordinance (absence, general CA practice)
    • Is a Specific Use Permit or Council approval ever required? Yes, conditionally. Under GCC Ch. 15.86 'Power Generation Facilities' (current, live-verified — identical text found on both the pre-2025 code host and the county's current live codifier): in Residential zoning districts (RE, AT, RE-NW, R-1, R-M, MHP, PDR), a residential-scale 'Direct Use' system (roof- or ground-mounted, serving the property's own load, up to 1/2 acre) is Permitted (P) by right; an 'Accessory Use' system larger than that (up to 15% of lot size or 5 acres, whichever is less) requires an Administrative Permit (ADM); and any 'Secondary Use' or 'Primary Use' (utility-scale, generating for offsite use) in a Residential district is Not Permitted (NP) at all. A Conditional Use Permit before the Planning Commission/Board is required only for Secondary/Primary Use facilities in the zoning districts where they ARE allowed (Agriculture, Williamson Act, Industrial) — never for ordinary residential rooftop/ground-mount PV. 90% · codified ordinance (zoning)
    • Is there a system-size cap on residential generation? No kW cap — Glenn's zoning ordinance caps residential PV by AREA, not generation capacity: a 'Direct Use' system (on-site load, roof- or ground-mounted) is capped at 1/2 acre of coverage to remain a by-right Permitted use; above that, an 'Accessory Use' system up to 15% of the lot (max 5 acres) requires an Administrative Permit. Separately, when a ground-mounted array 'will be located near a residence on an adjacent Lot,' GCC 15.86.030(G) requires either a 60-foot setback for solar panels (150 ft for enclosed buildings, 200 ft for wind turbines) OR visual screening with native, drought-resistant vegetation. 92% · codified ordinance (zoning)
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Must the contractor be registered with this authority before applying? No county-wide contractor business-license or registration fee was found anywhere in the current (2025) Master Fee Schedule — a full-text read of all 56 pages found zero 'business license' hits and only one unrelated 'contractor' hit ('Farm labor contractor $25.00/year'), against a working positive control ('electrical', 7 hits) confirming the extraction was not simply failing. 58% · fee schedule (absence)
    • Is a homeowner permitted to self-install and self-permit? Yes — the county's own 'Permit Forms and Applications' page for the Building Inspector lists 'Owner Builder Affidavits' as a standing form category, confirming owner-builder self-permitting is an accepted pathway; not stated as a solar-specific carve-out. 72% · department page
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • Is a site plan required, and what must it show? Yes, a site/plot plan is required — the county's 'Permit Requirements and Guidelines' page lists a dedicated 'Plot Plan Example' document among its standard permit-requirement handouts, and the general permit-application process requires a plot plan for any building permit. The plot plan's specific required content items (dimensions, north arrow, setbacks, etc.) could not be confirmed because the PDF itself is unreachable. 60% · department page (title only)
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

    • Which permit portal does this authority use? eTRAKiT (CentralSquare Technologies), hosted at etrakit.countyofglenn.net — confirmed live today. 92% · portal landing page
    • Can the whole application be completed online? No — the eTRAKiT portal's own current homepage states plainly: 'Permit Applications and Inspection Requests Coming Soon!' The portal today only supports read-only search/view of existing Permits, Projects, Properties and Inspections (plus a map view) — not submission of a new application. 90% · portal landing page
    • What does a residential solar permit cost? $197.85 flat for Solar Residential - Roof Mounted; $171.33 flat for Solar Residential - Ground Mounted (both 'plus additional state mandated fees, if applicable'). Non-residential solar is priced differently — on construction valuation via Table 3-A of the 1997 Uniform Administrative Code (CPI-modified) plus a 6% technology cost recovery fee — confirming the residential figures are a distinct, flat category. 90% · fee schedule
    • How is the fee calculated? Flat, for residential (both roof- and ground-mounted) — not valuation-, per-kW-, or per-panel-based. This contrasts with 'Solar Non-Residential', which IS valuation-based (construction-valuation × Table 3-A of the 1997 UAC, CPI-modified, plus 6% technology fee) in the same schedule. 88% · fee schedule
    • Is there a separate plan-check fee? Ambiguous in the current fee schedule. A general clause in the same 'Building & Inspection Services' section states 'Plan Review = 65% of building permit fee plus a 6% technology cost recovery fee' as an apparent building-wide default, but the schedule never states whether this 65% add-on applies on top of the flat $197.85/$171.33 residential-solar figures or whether those flat figures are an all-in over-the-counter price that already includes plan review (as Calaveras' and other CA counties' equivalent OTC solar lines explicitly state). No sentence resolves this for solar specifically. 55% · fee schedule (ambiguous)
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • How long is an issued permit valid before it expires? Not stated in any Glenn County document found. The Master Fee Schedule's 'Renew Expired Permit' line (50% of the original permit fee plus a 6% technology fee) confirms permits DO expire, but no document gives the specific day count. Since the county adopts the 2025 CBC in full by reference (Ch. 15.72.010) without a stated local modification to the permit-expiration section, the CBC's own standard §105.5 provision (180 days) would be expected to apply by default. 55% · fee schedule + codified ordinance (inference)
    • Which utility handles interconnection here? PG&E (Pacific Gas & Electric) — not from PowerToChoose. The county's own Office of Emergency Services page treats PG&E as the area electric utility, directing residents to 'Sign up for power outage notifications from PG&E' and to PG&E's own interactive Power Outage Map / PSPS map, and the county's OES page independently links PG&E's PSPS weather map at another URL. No split-utility or POU/co-op territory was found for Glenn (unlike Lassen); Glenn appears to be single-utility PG&E territory. 82% · county department page
    • Where does the utility sit in the sequence? After permit — PG&E's Electric Rule 21 requires, before it will process a NEM Interconnection Request (Permission to Operate) for the standard case, 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction over the Generating Facility' (§D.13.b). The county's final building/electrical inspection must clear before PG&E's PTO step proceeds. This is a statewide PG&E tariff provision, not Glenn-specific, but applies to Glenn as PG&E territory. 82% · utility tariff

28 questions answered against Glenn County’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes — but only for UNINCORPORATED Glenn County. The two incorporated cities, Willows and Orland, are each a separate AHJ with their own in-house Building Division/Department.

Why the confidence is not higherCounty's own current codified ordinance (GCC 15.72, adopted by Ord. 1337, 11/18/2025) states, verbatim and repeated in each adoption section, that the adopted code 'shall apply to the unincorporated areas of the county.' Both cities' own Building Division/Department pages were independently fetched and read directly, confirming each self-performs: Willows' page names its own Community Development Technician handling building permits; Orland's page describes its own Building Department staff accepting/reviewing/inspecting.

codified ordinance + two independent city department pages checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both — the county's own Planning & Community Development Services department, specifically its Building Inspector division (fee-schedule section header: 'Building & Inspection Services'), issues and inspects both building and electrical permits in-house for unincorporated-area residential solar. Fire-code enforcement is adopted by the county but its administration is defined per-parcel to whichever city or fire protection district serves that address (GCC 15.72.140), not to a single county fire office.

Why the confidence is not higherDepartment structure and in-house administration confirmed from the county's own Building Inspector welcome page (archived capture, Feb 2025) and the current Master Fee Schedule 2025's 'Building & Inspection Services' section header; the fire-authority definition is read directly from the current codified adoption chapter.

department page + fee schedule + codified ordinance checked 2026-08-31 https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/welcome

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes.

Why the confidence is not higherThe county's own current (2025) Master Fee Schedule lists two dedicated line items — 'Solar Residential - Roof Mounted' ($197.85) and 'Solar Residential - Ground Mounted' ($171.33) — under 'Building & Inspection Services', confirming a building permit (with its own fee) is required for residential solar.

fee schedule checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Likely combined into a single building permit — the fee schedule lists 'Solar Residential - Roof Mounted' and 'Solar Residential - Ground Mounted' as their own distinct General-Construction-style line items (flat dollar figures, not scaled to the generic 'Electrical Permit Base fee' lines listed separately in the same schedule's 'Electrical Fees' subsection), consistent with a single combined solar permit type rather than a stand-alone electrical permit process for the same job.

Why the confidence is not higherInferred from the fee schedule's structure — solar has its own dedicated line separate from the generic Electrical Fees subsection — rather than from an explicit county statement that solar permits are combined.

fee schedule (inference) checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Nothing published by this authority.

Where we lookedLooked for a Glenn-specific statement on who may pull the electrical permit for a residential solar job (licensed electrician vs. any contractor vs. homeowner) across the county's Building Inspector pages, the Permit Forms and Applications listing, and the current Master Fee Schedule; none states this. The underlying solar-specific submittal checklist ('07_Solar Requirements Residential.pdf') that likely answers this is listed by name on the county's Permit Requirements page but could not be retrieved: the live county site (countyofglenn.net) is behind a Cloudflare Turnstile 'Just a moment...' managed challenge that blocked plain curl, full browser-fingerprint curl headers, and headless Chrome with stealth patches (navigator.webdriver override, UA override, 45s+ real-time wait) alike, and no Wayback Machine capture of this specific PDF exists (its parent HTML page was captured; the linked PDF itself was not).

https://www.countyofglenn.net/sites/default/files/Building_Inspector/Forms/RandG/07_Solar%20Requirements%20Residential.pdf

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

No county-wide contractor business-license or registration fee was found anywhere in the current (2025) Master Fee Schedule — a full-text read of all 56 pages found zero 'business license' hits and only one unrelated 'contractor' hit ('Farm labor contractor $25.00/year'), against a working positive control ('electrical', 7 hits) confirming the extraction was not simply failing.

Why the confidence is not higherAbsence proven by full-text search of the current county fee schedule with a positive control ('electrical') and no fabricated-term false-positive check performed on this specific document beyond the electrical control; not corroborated by a direct county statement that no license is required, so recorded as inference from a real absence rather than an explicit policy statement.

fee schedule (absence) checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes — the county's own 'Permit Forms and Applications' page for the Building Inspector lists 'Owner Builder Affidavits' as a standing form category, confirming owner-builder self-permitting is an accepted pathway; not stated as a solar-specific carve-out.

Why the confidence is not higherDirect listing on the county's own current Permit Forms and Applications page (archived capture); the affidavit form's own text was not independently retrievable (Cloudflare-blocked PDF), so the underlying conditions are not confirmed beyond the category's existence.

department page checked 2026-08-31 https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/permit-forms-and-applications

Q8 What documents make up a complete submittal? Core Submittal package

Nothing published by this authority.

Where we lookedLooked for the county's own solar-specific submittal-package checklist ('07_Solar Requirements Residential.pdf', 176,738 bytes per its own listing) on the Permit Requirements and Guidelines page; confirmed to exist by name and file size but unreachable — live site Cloudflare-blocked (see q5 note), and no Wayback capture of the PDF itself exists despite the containing HTML page being captured twice (2024, 2025).

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q9 How many copies, and in what format? Submittal package

Nothing published by this authority.

Where we lookedSame document as q8 (copy count / format not stated anywhere else found); same retrieval failure.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes, a site/plot plan is required — the county's 'Permit Requirements and Guidelines' page lists a dedicated 'Plot Plan Example' document among its standard permit-requirement handouts, and the general permit-application process requires a plot plan for any building permit. The plot plan's specific required content items (dimensions, north arrow, setbacks, etc.) could not be confirmed because the PDF itself is unreachable.

Why the confidence is not higherCounty's own current Permit Requirements and Guidelines page lists the document by name; the document's content was not independently retrievable (Cloudflare blocked the live site; no Wayback capture exists for this specific PDF).

department page (title only) checked 2026-08-31 https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Nothing published by this authority.

Where we lookedLooked for a one-line/three-line diagram requirement specific to solar in the same unreachable solar checklist; no other county document states this.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q12 Are string and conductor calculations required? Drawings & calculations

Nothing published by this authority.

Where we lookedSame basis as q11 — string/conductor calculation requirements would be in the unreachable solar checklist; no other document addresses this.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Nothing published by this authority.

Where we lookedLooked for a structural PE-stamp threshold specific to solar (e.g. a ground-mount height or system-size trigger, as found in comparable CA counties' own checklists) in the unreachable solar checklist and in the current adoption chapter (GCC 15.72, fully read); neither states a Glenn-specific numeric threshold — the adoption chapter defers entirely to the base 2025 CBC/CRC's own prescriptive-limits language without restating it.

https://glenn.municipalcodeonline.com/book?type=ordinances

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

Nothing published by this authority.

Where we lookedSame basis as q13 for an electrical PE-stamp threshold; not stated in the fully-read adoption chapter, and the solar checklist that might address it is unreachable.

https://glenn.municipalcodeonline.com/book?type=ordinances

Q15 What does a residential solar permit cost? Core Fees

$197.85 flat for Solar Residential - Roof Mounted; $171.33 flat for Solar Residential - Ground Mounted (both 'plus additional state mandated fees, if applicable'). Non-residential solar is priced differently — on construction valuation via Table 3-A of the 1997 Uniform Administrative Code (CPI-modified) plus a 6% technology cost recovery fee — confirming the residential figures are a distinct, flat category.

Why the confidence is not higherDirect read (pdftotext -layout) of the county's current Master Fee Schedule 2025 (uploaded to the county's own /sites/default/files/2025-07/ folder, Wayback-captured 5 Sep 2025); no PDF metadata date was embedded (stripped AcroForm), so dating relies on the upload-folder name and file title rather than a pdfinfo CreationDate stamp.

fee schedule checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q16 How is the fee calculated? Core Fees

Flat, for residential (both roof- and ground-mounted) — not valuation-, per-kW-, or per-panel-based. This contrasts with 'Solar Non-Residential', which IS valuation-based (construction-valuation × Table 3-A of the 1997 UAC, CPI-modified, plus 6% technology fee) in the same schedule.

Why the confidence is not higherDirect comparison of the two adjacent fee-schedule categories in the current Master Fee Schedule 2025.

fee schedule checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q17 Is there a separate plan-check fee? Fees

Ambiguous in the current fee schedule. A general clause in the same 'Building & Inspection Services' section states 'Plan Review = 65% of building permit fee plus a 6% technology cost recovery fee' as an apparent building-wide default, but the schedule never states whether this 65% add-on applies on top of the flat $197.85/$171.33 residential-solar figures or whether those flat figures are an all-in over-the-counter price that already includes plan review (as Calaveras' and other CA counties' equivalent OTC solar lines explicitly state). No sentence resolves this for solar specifically.

Why the confidence is not higherRead directly from the current Master Fee Schedule 2025; flagged as an internal ambiguity rather than resolved, per instructions to report conflicts and not pick a side without a document that settles it.

fee schedule (ambiguous) checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Nothing published by this authority.

Where we lookedLooked for a stated plan-review turnaround (business days) on the Building Inspector department pages, the Permit Forms and Applications page, and the live eTRAKiT portal (whose own homepage says permit applications are 'Coming Soon,' suggesting no online turnaround SLA is currently published); none give a number of days.

https://etrakit.countyofglenn.net/

Q19 How long is an issued permit valid before it expires? Timeline & validity

Not stated in any Glenn County document found. The Master Fee Schedule's 'Renew Expired Permit' line (50% of the original permit fee plus a 6% technology fee) confirms permits DO expire, but no document gives the specific day count. Since the county adopts the 2025 CBC in full by reference (Ch. 15.72.010) without a stated local modification to the permit-expiration section, the CBC's own standard §105.5 provision (180 days) would be expected to apply by default.

Why the confidence is not higherInferred from full, unmodified adoption of the 2025 CBC (no local amendment to §105 found in the adoption chapter) plus the existence of a 'Renew Expired Permit' fee line proving expiration occurs in practice; not independently restated in any Glenn-specific document.

fee schedule + codified ordinance (inference) checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q20 Which permit portal does this authority use? Core Portal & process

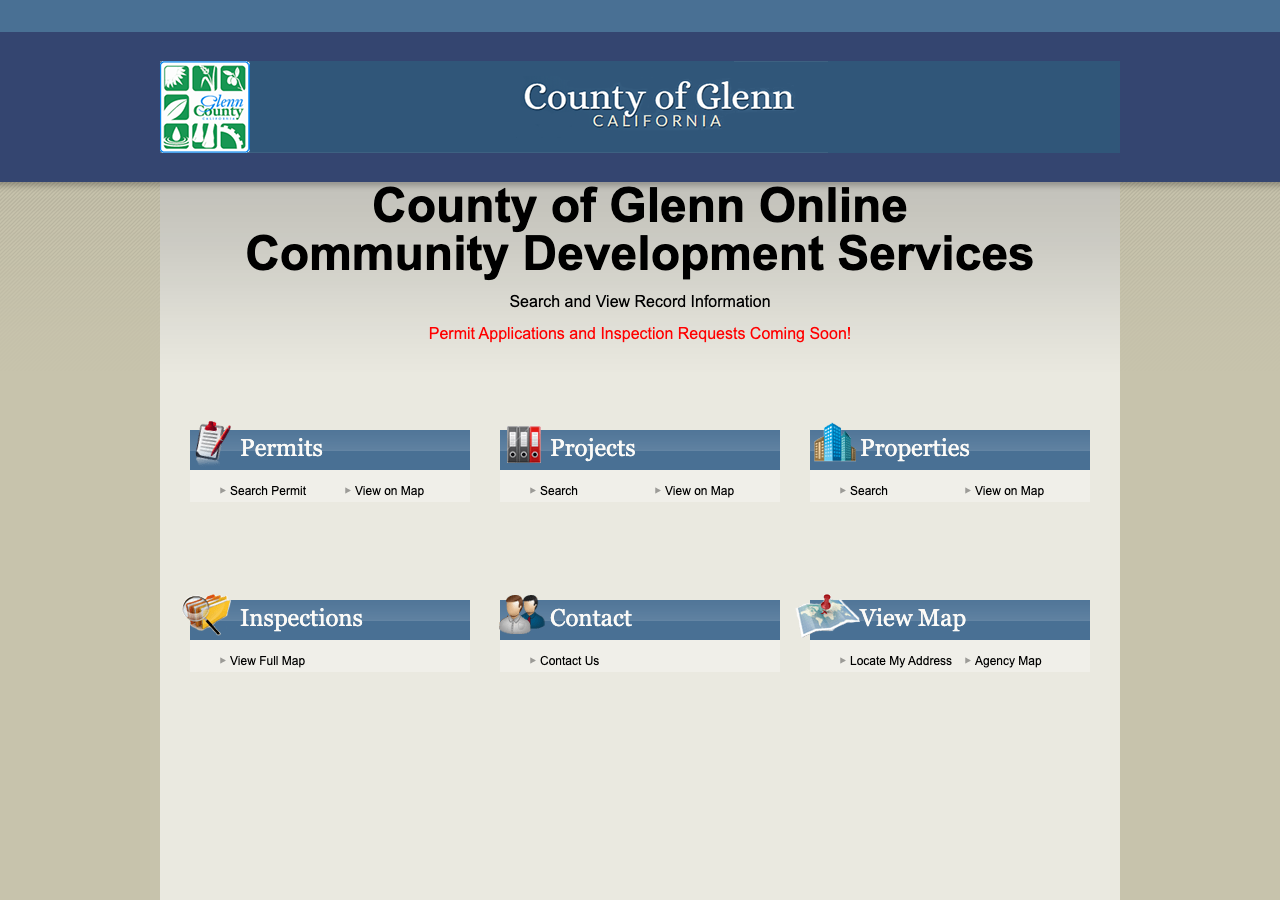

eTRAKiT (CentralSquare Technologies), hosted at etrakit.countyofglenn.net — confirmed live today.

Why the confidence is not higherPortal fetched directly and live (HTTP 200) at the time of this research; its own homepage identifies itself as 'County of Glenn Online Community Development Services' and is 'Powered by CentralSquare Technologies.'

portal landing page checked 2026-08-31 https://etrakit.countyofglenn.net/

Q21 Can the whole application be completed online? Core Portal & process

No — the eTRAKiT portal's own current homepage states plainly: 'Permit Applications and Inspection Requests Coming Soon!' The portal today only supports read-only search/view of existing Permits, Projects, Properties and Inspections (plus a map view) — not submission of a new application.

Why the confidence is not higherDirect quote from the portal's own live homepage, fetched today.

portal landing page checked 2026-08-31 https://etrakit.countyofglenn.net/

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas & Electric) — not from PowerToChoose. The county's own Office of Emergency Services page treats PG&E as the area electric utility, directing residents to 'Sign up for power outage notifications from PG&E' and to PG&E's own interactive Power Outage Map / PSPS map, and the county's OES page independently links PG&E's PSPS weather map at another URL. No split-utility or POU/co-op territory was found for Glenn (unlike Lassen); Glenn appears to be single-utility PG&E territory.

Why the confidence is not higherCounty's own OES 'Summer Heat and Power Outages' page (archived capture, current as of at least June 2023) and a second OES page (captured Sept 2024) directly linking PG&E's PSPS map — both county-authored, not a third-party lookup service.

county department page checked 2026-08-31 https://www.countyofglenn.net/dept/sheriff/office-emergency-services/summer-heat-and-power-outages

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit — PG&E's Electric Rule 21 requires, before it will process a NEM Interconnection Request (Permission to Operate) for the standard case, 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction over the Generating Facility' (§D.13.b). The county's final building/electrical inspection must clear before PG&E's PTO step proceeds. This is a statewide PG&E tariff provision, not Glenn-specific, but applies to Glenn as PG&E territory.

Why the confidence is not higherDirect quote from PG&E's own current CPUC tariff (Electric Rule 21), extracted with pdftotext from the full tariff document rather than a summary. Not independently confirmed against a Glenn-specific document.

utility tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No county-required HOA/architectural-committee approval found for solar specifically in any Glenn County document reviewed (expected, since HOAs are private covenants, not a county-administered process). California's Solar Rights Act (Civil Code §714/§4600) preempts an HOA's ability to disapprove or unreasonably restrict a compliant solar installation, regardless of CC&R language, statewide.

Why the confidence is not higherAbsence inferred from the documents reviewed (fee schedule, forms/requirements listings, Ch. 15.72 and 15.86); Solar Rights Act preemption is general California law, not confirmed against a Glenn-specific document this session.

codified ordinance + fee schedule (absence) + general CA law checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q25 Is there a historic-district review? Overlays & special cases

Nothing published by this authority.

Where we lookedLooked at the top-level listing of GCC Title 15, Division 15-3 'Development Districts' (which names only 'Standard Land Use Districts,' 'Special Land Use Districts,' and 'Combining Districts' as its three chapters); did not drill into the 'Combining Districts' chapter's own sub-list to confirm or rule out a historic-district or design-review overlay by name, so this is recorded as unresearched rather than a proven absence.

https://glenn.municipalcodeonline.com/book?type=ordinances

Q26 Is a wind or windstorm certification required? Overlays & special cases

No — California does not use a Texas-DOI/TDI-style separate wind-certification program. Wind loads are addressed through the adopted 2025 CBC/CRC's structural provisions (ASCE 7-based design), not a standalone wind-certificate process. No Glenn-specific wind-certification requirement was found in the reviewed materials.

Why the confidence is not higherGeneral California-practice inference matching every other CA county reviewed in this survey; not confirmed against a Glenn-specific structural-criteria handout (none was retrievable).

codified ordinance (absence, general CA practice) checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

Yes, conditionally. Under GCC Ch. 15.86 'Power Generation Facilities' (current, live-verified — identical text found on both the pre-2025 code host and the county's current live codifier): in Residential zoning districts (RE, AT, RE-NW, R-1, R-M, MHP, PDR), a residential-scale 'Direct Use' system (roof- or ground-mounted, serving the property's own load, up to 1/2 acre) is Permitted (P) by right; an 'Accessory Use' system larger than that (up to 15% of lot size or 5 acres, whichever is less) requires an Administrative Permit (ADM); and any 'Secondary Use' or 'Primary Use' (utility-scale, generating for offsite use) in a Residential district is Not Permitted (NP) at all. A Conditional Use Permit before the Planning Commission/Board is required only for Secondary/Primary Use facilities in the zoning districts where they ARE allowed (Agriculture, Williamson Act, Industrial) — never for ordinary residential rooftop/ground-mount PV.

Why the confidence is not higherDirect quote from GCC Ch. 15.86.030's permit table and text, read on the county's current live codifier (glenn.municipalcodeonline.com) via its rendered Kendo TreeView — confirmed word-for-word identical to the 2016-vintage text (Ord. 1256) found on the county's prior Drupal-hosted code host, so the ordinance is both current and unchanged since 2016.

codified ordinance (zoning) checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No kW cap — Glenn's zoning ordinance caps residential PV by AREA, not generation capacity: a 'Direct Use' system (on-site load, roof- or ground-mounted) is capped at 1/2 acre of coverage to remain a by-right Permitted use; above that, an 'Accessory Use' system up to 15% of the lot (max 5 acres) requires an Administrative Permit. Separately, when a ground-mounted array 'will be located near a residence on an adjacent Lot,' GCC 15.86.030(G) requires either a 60-foot setback for solar panels (150 ft for enclosed buildings, 200 ft for wind turbines) OR visual screening with native, drought-resistant vegetation.

Why the confidence is not higherDirect ordinance quote, GCC Ch. 15.86.030, confirmed current on the county's live codifier (word-for-word match against the 2016-era text). This chapter was adopted by Ord. 1256 in 2016 and has not been shown to be amended since; flagged as a possible dating limitation even though the current codifier still displays it unchanged.

codified ordinance (zoning) checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? 2023 NEC, as adopted via the 2025 California Electrical Code (Title 24, Part 3). Glenn County's own current adoption ordinance (GCC 15.72.090, 'California Electrical Code Adopted') reads: 'The 2025 California Code of Regulations Title 24, Part 3 also known as the California Electrical Code ... are hereby adopted ... and shall apply to the unincorporated areas of the county.' Adopted by Ord. 1337 on 11/18/2025 (there is no separate '2025 NEC' — the 2025 CEC cycle is based on the 2023 NEC statewide). 96% · codified ordinance
    • Which building code edition is in force? 2025 California Building Code (Title 24, Part 2) plus the 2025 California Residential Code (Title 24, Part 2.5), both adopted by the same Ord. 1337 (11/18/2025), together with the 2025 CMC, CPC, Energy Code, Green Building Code, WUI Code, Referenced Standards Code, Administrative Code, and Public Pools Code — a full, current, matched 2025 code cycle. 96% · codified ordinance
    • Which fire code edition is in force? 2025 California Fire Code (Title 24, Part 9), adopted in the same chapter/ordinance (GCC 15.72.080, Ord. 1337, 11/18/2025) as the rest of the 2025 code cycle, alongside the 2025 California Wildland-Urban Interface Code (Title 24, Part 7, GCC 15.72.137). 96% · codified ordinance
    • Are there local amendments to any of the above? No stated local climatic/geographic/topographical technical amendments were found in the county's current adoption chapter (GCC 15.72) — unlike several Sierra-foothill CA counties (e.g. Calaveras, Lassen) which carry codified snow-load or wind findings, Glenn's chapter is a straight adoption-by-reference of each state code with no numeric local modification. The chapter does retain two pre-Title-24 uncodified standards not superseded by the CBC (the 1997 Uniform Housing Code and the 1997 Uniform Code for the Abatement of Dangerous Buildings) and provides only a general, case-by-case variance process (§15.72.150, Board-level 'Modifications' on written application) rather than codified technical amendments. 85% · codified ordinance
    • What is the installation judged against? The installation is judged against the 2025 CEC/CBC/CRC/CFC/Energy Code/Green Code/WUI Code as adopted by Ord. 1337 (11/18/2025), plus Glenn's own zoning-level Power Generation Facilities standards (GCC Ch. 15.86) governing use classification, area limits, siting and setback — there is no separate Glenn-specific technical electrical standard beyond the adopted CEC itself. 85% · codified ordinance
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    Nothing recorded for Glenn County on this step yet — 1 question checked and found unpublished. The guidance above is general.

  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Required — the adopted 2025 CEC (Title 24 Part 3, based on the 2023 NEC), which Glenn County adopts in full by reference with no found local deletion, carries forward Article 690.12 (rapid shutdown) as a matter of the adopted code. The county's own dedicated solar handout ('07_Solar Requirements Residential.pdf', listed by name and file size on the Permit Requirements page) could NOT be retrieved to check whether the county's own practical guidance cites §690.12 by number the way several other CA counties' solar handouts do or do not (a pattern this survey has repeatedly found worth checking) — that half of the question is recorded separately as not_found rather than guessed. 75% · codified ordinance + adoption-inference
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Does the UTILITY specify placards beyond the AHJ's? Yes — PG&E's Electric Rule 21 (§H.1.d, 'Visible Disconnect Required') independently requires that the customer-side visible manual disconnect include 'markings or signage that clearly indicates open and closed positions,' be identified on the submitted single-line diagram, and — if not physically adjacent to the Point of Common Coupling — carry 'permanent signage ... at a Distribution Provider approved location providing a clear description of the location of the device.' This is a statewide PG&E requirement layered on top of whatever the county's own (unreachable) solar checklist covers. 78% · utility tariff
    • Where must the labels be placed? At minimum, at the visible AC/PV disconnect and the point of interconnection, per PG&E Rule 21's disconnect-marking requirement (see q42). Glenn County's own labeling specifics (junction box, combiner, service panel, etc., as found in other counties' solar checklists) could not be confirmed because the county's dedicated solar handout is unreachable. 60% · utility tariff (partial)
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Where must the AC disconnect be, relative to the meter? Not fully specified for Glenn. PG&E's Electric Rule 21 requires the visible manual disconnect to be near the Point of Common Coupling, reachable without obstacles, and — if not adjacent to the PCC — marked with location signage at a PG&E-approved spot, but does not give a specific 'X feet from the meter' figure in the public tariff. The more granular physical-placement spec would sit in PG&E's gated Distributed Generation interconnection handbook (as found in other CA county runs), which was not reachable this session. No Glenn-specific county rule was found either. 60% · utility tariff (partial)
    • Are batteries permitted, and under what conditions? No dedicated county battery/ESS ordinance was found — a full read of the current zoning chapter list under Division 15-5 'Special Use Standards' (which individually names 17 other specific uses, including newer additions like Cannabis, Industrial Hemp, and Emergency Shelters, proving the list is actively maintained) contains no 'Battery' or 'Energy Storage' chapter, and the current Master Fee Schedule 2025 has zero hits for 'battery,' 'energy storage,' or 'ESS' against a working positive control ('electrical', 7 hits in the same document). Batteries co-located with PV would be governed generically by whatever the adopted CFC/CEC itself requires (2025 cycle), not a Glenn-specific rule. 68% · fee schedule + zoning chapter list (absence)
    • Is there a separate ESS permit or inspection? No separate ESS permit or fee line was found — same absence basis as q45 (no ESS/battery line in the current Master Fee Schedule, no ESS-specific zoning chapter). A standalone or co-located battery installation would most likely be folded into the standard building/electrical permit fee, but no document confirms this explicitly. 65% · fee schedule (absence, inference)
    • Is a ground mount treated as a structure? Yes — Glenn's zoning code treats a ground-mounted system as its own regulated land use, not merely an accessory attachment: GCC Ch. 15.86 gives ground-mounted PV its own area cap (up to 1/2 acre for by-right 'Direct Use'), its own setback/screening rule when near a neighboring residence (60 ft for solar panels or vegetative screening), and notes explicitly that 'ground mounted facilities are subject to the lot coverage standards of each zoning district.' 85% · codified ordinance (zoning)
    • Is there a local rule on service upgrades or busbar sizing? No local rule on service upgrades or busbar sizing was found — a full read of the current adoption chapter (GCC 15.72, all sections) contains no amendment to the CEC's service/busbar provisions; the chapter is a pure adoption-by-reference with no such local addition. 65% · codified ordinance (absence)

20 questions answered against Glenn County’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

2023 NEC, as adopted via the 2025 California Electrical Code (Title 24, Part 3). Glenn County's own current adoption ordinance (GCC 15.72.090, 'California Electrical Code Adopted') reads: 'The 2025 California Code of Regulations Title 24, Part 3 also known as the California Electrical Code ... are hereby adopted ... and shall apply to the unincorporated areas of the county.' Adopted by Ord. 1337 on 11/18/2025 (there is no separate '2025 NEC' — the 2025 CEC cycle is based on the 2023 NEC statewide).

Why the confidence is not higherDirect quote from the county's own current, live-hosted codified adoption chapter, dated by its own 'Adopted by Ord. 1337 on 11/18/2025' history line.

codified ordinance checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q30 Which building code edition is in force? Core Code editions in force

2025 California Building Code (Title 24, Part 2) plus the 2025 California Residential Code (Title 24, Part 2.5), both adopted by the same Ord. 1337 (11/18/2025), together with the 2025 CMC, CPC, Energy Code, Green Building Code, WUI Code, Referenced Standards Code, Administrative Code, and Public Pools Code — a full, current, matched 2025 code cycle.

Why the confidence is not higherDirect read of GCC 15.72.010 and 15.72.133 (and the surrounding sections of the same chapter) on the county's current live codifier.

codified ordinance checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q31 Which fire code edition is in force? Code editions in force

2025 California Fire Code (Title 24, Part 9), adopted in the same chapter/ordinance (GCC 15.72.080, Ord. 1337, 11/18/2025) as the rest of the 2025 code cycle, alongside the 2025 California Wildland-Urban Interface Code (Title 24, Part 7, GCC 15.72.137).

Why the confidence is not higherDirect quote from the same current, live-hosted adoption chapter.

codified ordinance checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q32 Are there local amendments to any of the above? Core Code editions in force

No stated local climatic/geographic/topographical technical amendments were found in the county's current adoption chapter (GCC 15.72) — unlike several Sierra-foothill CA counties (e.g. Calaveras, Lassen) which carry codified snow-load or wind findings, Glenn's chapter is a straight adoption-by-reference of each state code with no numeric local modification. The chapter does retain two pre-Title-24 uncodified standards not superseded by the CBC (the 1997 Uniform Housing Code and the 1997 Uniform Code for the Abatement of Dangerous Buildings) and provides only a general, case-by-case variance process (§15.72.150, Board-level 'Modifications' on written application) rather than codified technical amendments.

Why the confidence is not higherFull read of the entire current GCC Ch. 15.72 (all ~16 sections, 15.72.010 through 15.72.160) on the county's live codifier — no snow-load, wind, seismic or similar local finding appears anywhere in the chapter.

codified ordinance checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q33 What is the installation judged against? Core Electrical

The installation is judged against the 2025 CEC/CBC/CRC/CFC/Energy Code/Green Code/WUI Code as adopted by Ord. 1337 (11/18/2025), plus Glenn's own zoning-level Power Generation Facilities standards (GCC Ch. 15.86) governing use classification, area limits, siting and setback — there is no separate Glenn-specific technical electrical standard beyond the adopted CEC itself.

Why the confidence is not higherCombination of the current adoption chapter (GCC 15.72) and the current zoning chapter (GCC 15.86), both read directly on the county's live codifier.

codified ordinance checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

No local rule on service upgrades or busbar sizing was found — a full read of the current adoption chapter (GCC 15.72, all sections) contains no amendment to the CEC's service/busbar provisions; the chapter is a pure adoption-by-reference with no such local addition.

Why the confidence is not higherAbsence proven by a full read of the entire current GCC Ch. 15.72 on the county's live codifier; the underlying CEC service/busbar sizing rules themselves were not separately reviewed for a Glenn-specific amendment beyond this chapter.

codified ordinance (absence) checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Nothing published by this authority.

Where we lookedLooked for a Glenn-specific numeric mounting/attachment-spacing standard (e.g. a rafter-spacing or racking table) in the unreachable solar checklist and in the fully-read GCC 15.72/15.86 chapters; neither the adoption chapter nor the zoning chapter states one — GCC 15.86 only addresses siting/area/setback, not attachment engineering.

https://glenn.municipalcodeonline.com/book?type=ordinances

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Nothing published by this authority.

Where we lookedLooked for a fire-code ridge-setback/access-pathway requirement in the county's adopted 2025 CFC/WUI Code; only the adoption-by-reference chapter (GCC 15.72.080/.137) was read, which contains no locally amended fire-access or ridge-setback text of its own — the CFC/WUI code bodies themselves (which would carry the standard §605.11 pathway language) were not independently reviewed for a Glenn-specific amendment, so this is recorded as unresearched rather than a confirmed absence.

https://glenn.municipalcodeonline.com/book?type=ordinances

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Required — the adopted 2025 CEC (Title 24 Part 3, based on the 2023 NEC), which Glenn County adopts in full by reference with no found local deletion, carries forward Article 690.12 (rapid shutdown) as a matter of the adopted code. The county's own dedicated solar handout ('07_Solar Requirements Residential.pdf', listed by name and file size on the Permit Requirements page) could NOT be retrieved to check whether the county's own practical guidance cites §690.12 by number the way several other CA counties' solar handouts do or do not (a pattern this survey has repeatedly found worth checking) — that half of the question is recorded separately as not_found rather than guessed.

Why the confidence is not higherCode-adoption half is high-confidence (current, unambiguous adoption ordinance); the practical-enforcement half (what the county's own solar checklist actually cites) could not be verified because the underlying PDF is unreachable — see q38-41 not_found entries for the same document.

codified ordinance + adoption-inference checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedLooked for the county's own placard/label specification for the service equipment in the unreachable solar checklist ('07_Solar Requirements Residential.pdf'); no other county document (fee schedule, forms listing, adoption ordinance) specifies placard content.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame unreachable document as q38; cannot confirm whether the county supplies its own custom placard wording.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedSame unreachable document as q38; letter height/colour/material specification not found anywhere else.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Nothing published by this authority.

Where we lookedLooked for a facility-map/site-directory placard requirement distinct from the general plot-plan drawing (q10) in the unreachable solar checklist; no other county document addresses this.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes — PG&E's Electric Rule 21 (§H.1.d, 'Visible Disconnect Required') independently requires that the customer-side visible manual disconnect include 'markings or signage that clearly indicates open and closed positions,' be identified on the submitted single-line diagram, and — if not physically adjacent to the Point of Common Coupling — carry 'permanent signage ... at a Distribution Provider approved location providing a clear description of the location of the device.' This is a statewide PG&E requirement layered on top of whatever the county's own (unreachable) solar checklist covers.

Why the confidence is not higherDirect quote from PG&E's own current CPUC tariff, extracted via pdftotext; a statewide PG&E requirement, not Glenn-specific, correctly attributed to the utility rather than the county.

utility tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

At minimum, at the visible AC/PV disconnect and the point of interconnection, per PG&E Rule 21's disconnect-marking requirement (see q42). Glenn County's own labeling specifics (junction box, combiner, service panel, etc., as found in other counties' solar checklists) could not be confirmed because the county's dedicated solar handout is unreachable.

Why the confidence is not higherPG&E Rule 21 provides the utility-level half at moderate-high confidence; the county-level half is not confirmed and is recorded separately as not_found (q38-41).

utility tariff (partial) checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Q44 Must equipment be on a specific approved list? Equipment listing

Nothing published by this authority.

Where we lookedLooked for a county-maintained approved-equipment list in the fee schedule, the Permit Forms and Applications page, and the adoption ordinance (GCC 15.72, fully read); none exists — only the standard CEC/UL listing requirement would apply by default, but no Glenn document states even that for solar specifically since the solar checklist is unreachable.

https://glenn.municipalcodeonline.com/book?type=ordinances

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

No dedicated county battery/ESS ordinance was found — a full read of the current zoning chapter list under Division 15-5 'Special Use Standards' (which individually names 17 other specific uses, including newer additions like Cannabis, Industrial Hemp, and Emergency Shelters, proving the list is actively maintained) contains no 'Battery' or 'Energy Storage' chapter, and the current Master Fee Schedule 2025 has zero hits for 'battery,' 'energy storage,' or 'ESS' against a working positive control ('electrical', 7 hits in the same document). Batteries co-located with PV would be governed generically by whatever the adopted CFC/CEC itself requires (2025 cycle), not a Glenn-specific rule.

Why the confidence is not higherAbsence proven across two independently current documents (the live zoning chapter-title list and the current fee schedule), both control-tested.

fee schedule + zoning chapter list (absence) checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No separate ESS permit or fee line was found — same absence basis as q45 (no ESS/battery line in the current Master Fee Schedule, no ESS-specific zoning chapter). A standalone or co-located battery installation would most likely be folded into the standard building/electrical permit fee, but no document confirms this explicitly.

Why the confidence is not higherSame control-tested absence as q45; the 'folded into standard permit' conclusion is inference, not a direct statement.

fee schedule (absence, inference) checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q47 Is a ground mount treated as a structure? Core Ground mount

Yes — Glenn's zoning code treats a ground-mounted system as its own regulated land use, not merely an accessory attachment: GCC Ch. 15.86 gives ground-mounted PV its own area cap (up to 1/2 acre for by-right 'Direct Use'), its own setback/screening rule when near a neighboring residence (60 ft for solar panels or vegetative screening), and notes explicitly that 'ground mounted facilities are subject to the lot coverage standards of each zoning district.'

Why the confidence is not higherDirect ordinance quote, GCC Ch. 15.86.030, confirmed current on the live codifier.

codified ordinance (zoning) checked 2026-08-31 https://glenn.municipalcodeonline.com/book?type=ordinances

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Not fully specified for Glenn. PG&E's Electric Rule 21 requires the visible manual disconnect to be near the Point of Common Coupling, reachable without obstacles, and — if not adjacent to the PCC — marked with location signage at a PG&E-approved spot, but does not give a specific 'X feet from the meter' figure in the public tariff. The more granular physical-placement spec would sit in PG&E's gated Distributed Generation interconnection handbook (as found in other CA county runs), which was not reachable this session. No Glenn-specific county rule was found either.

Why the confidence is not higherPG&E Rule 21 (public tariff) answers the functional requirement but not the exact dimension; the gated document that would likely answer it precisely was not accessed, consistent with instructions not to guess its contents.

utility tariff (partial) checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Phone — the county's own building-inspector page gives a dedicated 24-Hour Building Inspection Request Line, (530) 934-8447, 'for ALL inspection requests.' The county's current online portal (eTRAKiT) explicitly does NOT yet support online inspection requests — its own homepage states 'Permit Applications and Inspection Requests Coming Soon!' — so phone is the only currently available booking method. 85% · department page + live portal corroboration
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes — the county's in-house Building Inspector division performs its own final inspections directly; no third-party plan-check or inspection firm is named anywhere in the documents reviewed (fee schedule, department contact info, forms listing), and the department's own contact block (address, phone, and a dedicated 24-hour inspection line) all point to in-house county staff. 78% · department page (inference from absence)
    • If delegated, to whom? N/A — not delegated to another agency; see q52. 75% · department page (inference)
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    Nothing recorded for Glenn County on this step yet — 2 questions checked and found unpublished. The guidance above is general.

  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    Nothing recorded for Glenn County on this step yet — 3 questions checked and found unpublished. The guidance above is general.

  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • Who notifies the utility for PTO? The installer/applicant, not the AHJ — under PG&E Rule 21, the Producer (applicant/installer) submits the NEM Interconnection Request together with evidence of the AHJ's final inspection clearance; PG&E does not proactively pull this from the county. This is a utility-level answer (same PG&E-wide mechanism found in other CA county runs), not confirmed against a Glenn-specific document. 80% · utility tariff
    • Is there a re-inspection fee? No line item is named specifically 're-inspection fee' for solar, but the current Master Fee Schedule's general 'Building & Inspection Services' → 'Administrative or Inspection' section gives: 'Reinspection Fee — Actual Cost plus a 6% technology cost recovery fee' — a cost-basis charge rather than a flat dollar figure, applicable building-department-wide (not solar-specific). 80% · fee schedule
    • How are corrections issued and cleared? Not explicitly documented for solar. The current fee schedule includes a 'Review for Plan Revisions — Actual Cost plus a 6% technology cost recovery fee' line, implying a plan-revision/resubmittal mechanism exists, but no document lays out the actual correction-notice-to-clearance workflow. 55% · fee schedule (inference)

14 questions answered against Glenn County’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Phone — the county's own building-inspector page gives a dedicated 24-Hour Building Inspection Request Line, (530) 934-8447, 'for ALL inspection requests.' The county's current online portal (eTRAKiT) explicitly does NOT yet support online inspection requests — its own homepage states 'Permit Applications and Inspection Requests Coming Soon!' — so phone is the only currently available booking method.

Why the confidence is not higherCombines the county's own Building Inspector welcome page (archived capture, current as of at least early 2025) with the LIVE eTRAKiT portal homepage fetched today, which corroborates that online inspection requests are not yet live.

department page + live portal corroboration checked 2026-08-31 https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/welcome

Q50 How much notice is required? Core Booking & scheduling

Nothing published by this authority.

Where we lookedLooked for a stated advance-notice requirement for booking an inspection on the Building Inspector pages and the live eTRAKiT portal (whose inspection-request feature is not yet live per its own homepage); none is published.

https://etrakit.countyofglenn.net/

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

Nothing published by this authority.

Where we lookedLooked for AM/PM or same-day inspection-window language on the same pages; none is published.

https://etrakit.countyofglenn.net/

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes — the county's in-house Building Inspector division performs its own final inspections directly; no third-party plan-check or inspection firm is named anywhere in the documents reviewed (fee schedule, department contact info, forms listing), and the department's own contact block (address, phone, and a dedicated 24-hour inspection line) all point to in-house county staff.

Why the confidence is not higherInferred from the consistent absence of any contracted-firm name across every Glenn County Building Inspector document reviewed this session, following the playbook's 'named Building Official and every roster name on the county domain' test — though no single document states 'we do not contract out' in so many words.

department page (inference from absence) checked 2026-08-31 https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/welcome

Q53 If delegated, to whom? Core Who inspects

N/A — not delegated to another agency; see q52.

Why the confidence is not higherSame basis as q52.

department page (inference) checked 2026-08-31 https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/welcome

Q54 Which inspections are required, and in what order? Core Stages & sequence

Nothing published by this authority.

Where we lookedLooked for a published inspection-stage sequence for solar (rough-in vs. final, etc.) in the unreachable solar checklist and the general Building Inspector pages; neither is available/states one.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

Nothing published by this authority.

Where we lookedSame basis as q54 for a rough-in/mid-roof inspection requirement specifically.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q56 Does the inspector verify labels and listings? Core What is checked

Nothing published by this authority.

Where we lookedLooked for a statement that the inspector verifies labels/listings at final in the same unreachable solar checklist; no other document addresses inspector practice for solar.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q57 Is there a published inspection checklist? Core What is checked

Nothing published by this authority.

Where we lookedLooked in the Permit Requirements and Guidelines list (11 named documents: Permits Required and Exemptions, Engineering Required, Inspection Info and Procedure, Roofing Inspections, Plot Plan Example, Solar Requirements Residential, Residential Swimming Pool Permit Requirements, New House SFD Checklist, Special Inspection Firms, Residential/Commercial EV Checklists) for a distinct solar FINAL-INSPECTION checklist as opposed to the pre-installation submittal checklist already captured at q8; the list contains only submittal-stage documents by name, no separate inspection checklist — though the submittal checklist itself (which might combine both) is unreachable, so this is a title-level absence, not a content-level one.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q58 What must be on site at inspection? Core Documents on site

Nothing published by this authority.

Where we lookedLooked for a stated list of documents required on-site at inspection in the unreachable solar checklist and the general Building Inspector pages; neither is available/states one.

https://www.countyofglenn.net/dept/planning-community-development-services/building-inspector/resources/permit-requirements

Q59 Is there a re-inspection fee? Corrections & re-inspection

No line item is named specifically 're-inspection fee' for solar, but the current Master Fee Schedule's general 'Building & Inspection Services' → 'Administrative or Inspection' section gives: 'Reinspection Fee — Actual Cost plus a 6% technology cost recovery fee' — a cost-basis charge rather than a flat dollar figure, applicable building-department-wide (not solar-specific).

Why the confidence is not higherDirect quote from the current Master Fee Schedule 2025, page ~167 of the PDF ('Administrative or Inspection' subsection).

fee schedule checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q60 How are corrections issued and cleared? Corrections & re-inspection

Not explicitly documented for solar. The current fee schedule includes a 'Review for Plan Revisions — Actual Cost plus a 6% technology cost recovery fee' line, implying a plan-revision/resubmittal mechanism exists, but no document lays out the actual correction-notice-to-clearance workflow.

Why the confidence is not higherInferred from the existence of a 'Review for Plan Revisions' fee line in the current Master Fee Schedule; no explicit corrections-process document was found or retrievable.

fee schedule (inference) checked 2026-08-31 https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q61 What is issued on pass? Core Final sign-off & PTO

Nothing published by this authority.

Where we lookedLooked for the specific name of the document/status issued on a passing final inspection (CO / Final / Green tag / Letter) across the Building Inspector pages and the current fee schedule; neither uses a specific term for a routine solar retrofit on an existing, already-occupied home (the fee schedule's Certificate-of-Occupancy-adjacent language applies to new/occupancy-triggering construction generally, not solar specifically) — recorded as not_found per instructions rather than guessed by analogy to other counties.

https://www.countyofglenn.net/sites/default/files/2025-07/Master%20Fee%20Schedule%202025.-1.pdf

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

The installer/applicant, not the AHJ — under PG&E Rule 21, the Producer (applicant/installer) submits the NEM Interconnection Request together with evidence of the AHJ's final inspection clearance; PG&E does not proactively pull this from the county. This is a utility-level answer (same PG&E-wide mechanism found in other CA county runs), not confirmed against a Glenn-specific document.

Why the confidence is not higherDirect reading of PG&E Rule 21's process description (§D.13.b, see q23).

utility tariff checked 2026-08-31 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_RULES_21.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for Glenn County against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

Glenn County is the authority having jurisdiction 92% confidence
Holds
Building AND Electrical (and, by adoption, Fire Code) for UNINCORPORATED Glenn County only. Glenn County's own current Uniform-Codes adoption chapter (GCC 15.72, adopted by Ord. 1337 on 11/18/2025) states of every adopted code — Building, Electrical, Mechanical, Plumbing, Energy, Fire, WUI, Residential, Green Building, Referenced Standards, Administrative — that it 'shall apply to the unincorporated areas of the county,' repeated verbatim in each of the ~13 adoption sections. Glenn has exactly two incorporated cities, Willows (the county seat) and Orland, both independently confirmed to run their own in-house Building Divisions (Willows: cityofwillows.org/departments/community-development-services/building-division/, under 'Community Development & Services'; Orland: cityoforland.com/building-department/) and are excluded from county jurisdiction entirely.
Overridden by
PG&E Electric Rule 21 gates Permission to Operate on 'evidence of Applicant's final electric inspection clearance from the Governmental Authority having jurisdiction' (Rule 21 §D.13.b) — the county's own final inspection must clear before PG&E will energize/approve interconnection (same statewide mechanism found in other CA county runs). Separately, the county's own code DEFINES fire authority per-parcel rather than naming a single county fire department: GCC 15.72.140 defines 'Bureau of fire prevention' / 'Fire Marshal' as 'the fire department of any concerned or affected city or fire protection district located within the county' — i.e. whichever of Glenn's ~8 special fire districts (or CAL FIRE Tehama-Glenn Unit in State Responsibility Area land) covers that address is the fire-code authority, not the county Building Department itself. No document was found confirming whether that district review is a required submittal step for a residential PV permit or whether (as in Calaveras/Amador) it is folded into the county's own building-permit review — recorded as an open question, not resolved.
Why not higher
The 'shall apply to the unincorporated areas of the county' scope sentence is read directly from the county's own current, live codified adoption ordinance (Ch. 15.72, Ord. 1337, 11/18/2025) on its current codifier (glenn.municipalcodeonline.com, a CivicPlus/Municipal Code Online platform the county migrated to after its old Drupal-hosted 'govt/county-code' pages, confirmed via a 2025 redirect chain from the old URL). Both incorporated cities' own building-department pages were independently fetched and read directly (not inferred). Held at 92 rather than 96+ because the fire-jurisdiction-per-parcel mechanic, while codified, could not be cross-checked against an actual PV-permit workflow document.

https://glenn.municipalcodeonline.com/book?type=ordinances

Permit required
Yes.92%
Permit cost
$197.85 flat for Solar Residential - Roof Mounted; $171.33 flat for Solar Residential - Ground Mounted (both 'plus additional state mandated fees, if applicable').90%
Portal
eTRAKiT (CentralSquare Technologies), hosted at etrakit.countyofglenn.net — confirmed live today.92%
Electrical code
2023 NEC, as adopted via the 2025 California Electrical Code (Title 24, Part 3). Glenn County's own current adoption ordinance (GCC 15.72.090,96%
Booking an inspection
Phone — the county's own building-inspector page gives a dedicated 24-Hour Building Inspection Request Line, (530) 934-8447,85%
Labels & placards for this authority

Wording None%

Size, colour & material None%

Where they go 60%

At minimum, at the visible AC/PV disconnect and the point of interconnection, per PG&E Rule 21's disconnect-marking requirement (see q42). Glenn County's own labeling specifics (junction box, combiner, service panel, etc., as found in other counties' solar checklists) could not be confirmed because the county's dedicated solar handout is unreachable.

What the utility wants on top 78%

Yes — PG&E's Electric Rule 21 (§H.1.d, 'Visible Disconnect Required') independently requires that the customer-side visible manual disconnect include 'markings or signage that clearly indicates open and closed positions,' be identified on the submitted single-line diagram, and — if not physically adjacent to the Point of Common Coupling — carry 'permanent signage ... at a Distribution Provider approved location providing a clear description of the location of the device.' This is a statewide PG&E requirement layered on top of whatever the county's own (unreachable) solar checklist covers.

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
County
County
Glenn County
Regions served
4
Regions covered
Artois · county
Elk Creek · county
Glenn County · county
Hamilton City · county
Solar Requirements
Notes
Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.countyofglenn.net/government/departments/planning-community-development-services/building-inspector
Authority Contact
Address
225 N Tehama Street, Willows, CA 95988
Main Phone
(530) 934-6540
Building Department
Department
Building Inspector — Planning & Community Development Services
Direct Phone
(530) 934-6540
Portal Software
eTRAKiT
Booking & Scheduling
Preferred channel
phone
Notes
Call the 24-hour inspection request line (530) 934-8447 to schedule. Inspections are conducted Monday–Thursday only — no Friday inspections. After calling to schedule, call the office again after 9:00 AM on the inspection date for an approximate arrival window. Building permit applications accepted by email at building@countyofglenn.net. eTRAKiT portal (etrakit.countyofglenn.net) is live for permit lookups and project searches, but displays "Permit Applications and Inspection Requests Coming Soon" — not yet functional for scheduling. Appointments recommended for permit pickup and application submission. Director: Mardy Thomas. Office hours Mon–Fri 8:00 AM–5:00 PM, excluding County holidays. (collected Jul 2026)
