Inyo County
State of California
Inyo County is a county authority in the State of California, covering 17 regions, serving 19,016 residents. 99 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions

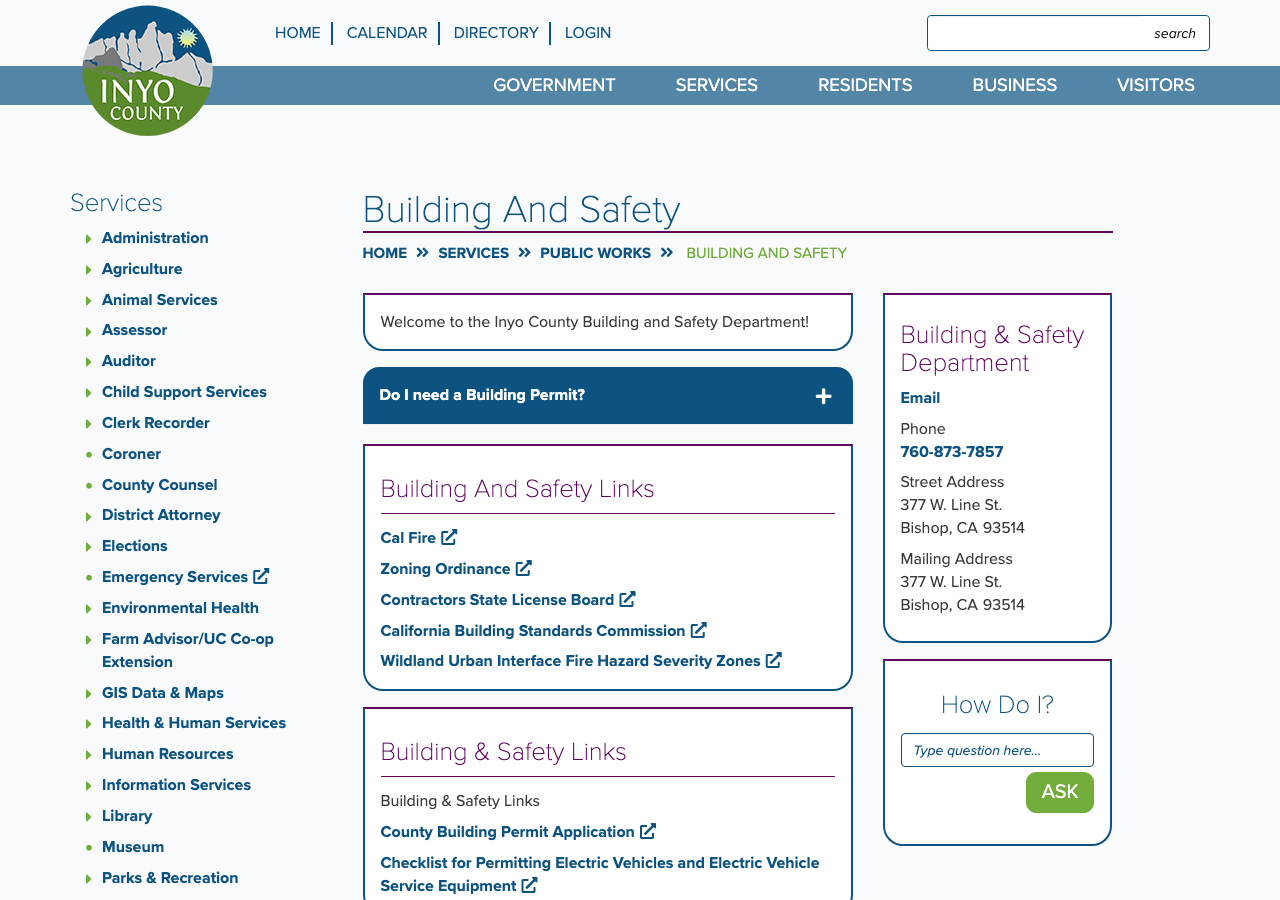

Whether a permit is needed — Yes. The county's own Building & Safety FAQ lists 'Solar (Roof and Ground Mount)' among the items requiring a building permit. Q3 Electrical and building permits — Separate — the county's Building Permit Application has a distinct 'Electrical Permit' fee line separate from 'Building Permit' and from the 'Solar' line item. Q4 Where you file — None. Inyo County has no online building-permit portal. Applications are submitted by email (buildingandsafety@inyocounty.us) or in person; Q20
- Permit required
- Yes. The county's own Building & Safety FAQ lists 'Solar (Roof and Ground Mount)' among the items requiring a building permit.95% source
- Key document
- permit schedule cited by 6 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes, but only for unincorporated Inyo County. The City of Bishop (the county's only incorporated city) is a separate AHJ. 95% · adopting regulation
- What does this authority permit itself, and what does it delegate? Both — Building AND Electrical, self-performed in-house by the county's Public Works Department (Building & Safety Division). Not delegated to a private plan-check/inspection firm. 90% · adopting regulation
- Is a permit required for a residential rooftop PV system? Yes. The county's own Building & Safety FAQ lists 'Solar (Roof and Ground Mount)' among the items requiring a building permit. 95% · department page
- Is there a separate electrical permit, or is it combined? Separate — the county's Building Permit Application has a distinct 'Electrical Permit' fee line separate from 'Building Permit' and from the 'Solar' line item. 80% · permit schedule
- Is a HOA or architectural approval required first? Not generally, for ordinary residential rooftop PV. Title 18 (Zoning) has an 'Architectural Design Review Board' but it is scoped to the county's 'D' (Architectural Design Review) zoning district and a separate 'Lone Pine Architectural Review Board' (a Lone Pine community-specific review, $200 fee) — neither is a general county-wide requirement, and the county's predominant residential (R) districts are not shown to carry this overlay. 62% · ordinance
- Is there a historic-district review? No dedicated historic-district review ordinance reaching residential PV was found. Title 18's only 'historic' references are (a) an exclusion criterion in the ministerial two-unit (SB 9-style) development ordinance and (b) a siting exclusion in the small-wind-energy-system chapter — neither is a general historic-review gate on rooftop solar. 72% · ordinance
- Is a wind or windstorm certification required? No TDI-style windstorm certification exists, but the county DOES carry its own codified structural wind-load design criterion, county-wide for the unincorporated area: 85 MPH sustained winds with 110 MPH 3-second gusts (Title 14 §14.08.130), adopted as a local amendment because Title 24's base wind provisions were found inadequate for the county's 'remote mountain terrain' and 'high winds.' 88% · ordinance
- Is a Specific Use Permit or Council approval ever required? Not for a standard residential rooftop PV retrofit (a ministerial building permit). Council/Planning-Commission-level approval (a 'Renewable Energy Permit' under Title 21) is required only for a utility-scale 'facility' (a photovoltaic or solar-thermal powerplant transmitting power off-site) — Title 21's own definitions expressly exclude a 'solar energy system' (Civil Code §801.5(a)(1)-(2) / Gov. Code §65850.5) from the 'facility'/'powerplant' definitions that trigger that permit. 85% · ordinance
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either — a licensed contractor or an owner-builder may pull the permit/apply. 78% · ordinance
- Is a homeowner permitted to self-install and self-permit? Yes — the county's own Building Permit Application contains the standard California owner-builder declaration (Business & Professions Code §7044), allowing an owner to do the work themselves or through employees without a licensed contractor. 82% · ordinance
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? General (not PV-specific) plan-check package per the county's 'Items Needed for Plan Check' checklist: plans at least 18"x24", 3 sets, title block (name/address/owner/APN/contact), compliance with W.U.I. standards, a site plan showing distances/existing structures/street/direction arrows/lat-long, a topo drawing, exterior elevations (existing & proposed), a Title 24 calculations page, sewer type/tie-in, an electrical plan page, a plumbing plan page, an HVAC page, and — if applicable — a fire-sprinkler plan approved by Cal Fire. No PV-specific submittal checklist exists. 72% · published checklist
- How many copies, and in what format? 3 sets, printed on at least 18"x24" paper. 80% · checklist
- Is a site plan required, and what must it show? Yes. The plot plan/site plan must show property lines and dimensions, distances from property lines to all proposed and existing structures/improvements, sewer lines, wells and/or points of connection to public utilities (sewer, electricity, water), drawn to scale. 78% · checklist
- Is a structural PE stamp required, and at what threshold? No fixed kW/psf threshold stated. Per Title 14 §14.08.050, engineered-design plan review (in-house or contract engineering consultant, Building Official's discretion) is triggered case-by-case whenever a submittal exceeds conventional light-frame construction provisions for seismic design, wind load, or ground snow load; ALL commercial structures require engineered plancheck regardless. 80% · ordinance / checklist
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? None. Inyo County has no online building-permit portal. Applications are submitted by email (buildingandsafety@inyocounty.us) or in person; the only 'permit' portal linked from the Building & Safety page (inyoso.permitium.com) is the Sheriff's Office concealed-weapon (CCW) permit application system, unrelated to building permits. 85% · portal landing page
- Can the whole application be completed online? No. The application itself is submitted by email/in person, not online; the only genuine online form on the Building & Safety pages is a post-issuance Inspection Request form. 82% · portal
- How is the fee calculated? Valuation-based (inferred). The Building Permit Application's Permit Cost Summary computes a 'Building Cost Total' and separately assesses state-mandated valuation-based surcharges (SMIP, Building Standards Revolving Fund) alongside the itemized Building/Electrical/Plumbing/Mechanical/Solar permit lines — this is the standard California ICC-valuation-table fee structure, though the county's actual fee resolution/table was not found published online. 70% · fee schedule
- Is there a separate plan-check fee? Yes. 'Plan Check' is a distinct line item from 'Building Permit' on the county's own Permit Cost Summary; the Planning Department separately lists a 'Building Permit Plan Check Fee' deposit of $50. 78% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- How long is an issued permit valid before it expires? Two different windows appear in the county's own documents: the Building Permit Application states a permit becomes void if work is not commenced within 180 days (one year for residential) of issuance or is suspended/abandoned for 180 days; separately, Title 14 §14.04.060 states plan-check applications void after 12 months without permit issuance, and issued building permits void 36 months after issuance absent a written extension request. Both are reported as the county has not reconciled them into a single stated figure. 78% · ordinance
- Which utility handles interconnection here? Southern California Edison (SCE). 90% · utility territory map + city source
28 questions answered against Inyo County’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes, but only for unincorporated Inyo County. The City of Bishop (the county's only incorporated city) is a separate AHJ.
Why the confidence is not higherTitle 14 §14.04.030 (Scope): 'The provisions of this Title shall apply to all buildings and structures in the unincorporated territory of Inyo County.' Bishop is confirmed self-performing via its own Building & Safety/Public Works pages and its own 'Small Residential Rooftop Solar Energy System Permits' PDF.
adopting regulation checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both — Building AND Electrical, self-performed in-house by the county's Public Works Department (Building & Safety Division). Not delegated to a private plan-check/inspection firm.
Why the confidence is not higherTitle 14 §14.04.020(C): 'The Director of the Inyo County Public Works Department shall serve as the Inyo County Building Official.' Named in-house staff on the county's own request-inspection page (Cindy Truelsen, Tyson Sparrow, James Feeney, all @inyocounty.us) and the plan-check checklist (Tyson Sparrow, Building Inspector, @inyocounty.us) — no contract-firm name, portal vendor, or off-domain email found anywhere checked.
adopting regulation checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes. The county's own Building & Safety FAQ lists 'Solar (Roof and Ground Mount)' among the items requiring a building permit.
Why the confidence is not higherDirect statement on the department's own page accordion 'Do I need a Building Permit?'
department page checked 2026-08-31 https://www.inyocounty.us/services/public-works/building-and-safety
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Separate — the county's Building Permit Application has a distinct 'Electrical Permit' fee line separate from 'Building Permit' and from the 'Solar' line item.
Why the confidence is not higherPermit Cost Summary table on the county's own fillable Building Permit Application lists Building Permit, Plan Check, Plumbing, Mechanical, Electrical Permit, and Solar as separate line items.
permit schedule checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/County%20Building%20Permit%20Application_0.pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either — a licensed contractor or an owner-builder may pull the permit/apply.
Why the confidence is not higherThe county's Building Permit Application includes the standard CA owner-builder declaration (B&P Code §7044) alongside the licensed-contractor declaration (§7031.5); no county rule restricts electrical work to a licensed electrician only.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/County%20Building%20Permit%20Application_0.pdf
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Nothing published by this authority.
Where we lookedchecked the Building & Safety department page, the request-inspection page and the building permit application for a contractor-registration/local-business-license requirement beyond the standard CSLB license verification; none found
https://www.inyocounty.us/services/public-works/building-and-safety
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes — the county's own Building Permit Application contains the standard California owner-builder declaration (Business & Professions Code §7044), allowing an owner to do the work themselves or through employees without a licensed contractor.
Why the confidence is not higherOwner-Builder / Licensed Contractor's Declaration section on the county's Building Permit Application.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/County%20Building%20Permit%20Application_0.pdf
Q8 What documents make up a complete submittal? Core Submittal package
General (not PV-specific) plan-check package per the county's 'Items Needed for Plan Check' checklist: plans at least 18"x24", 3 sets, title block (name/address/owner/APN/contact), compliance with W.U.I. standards, a site plan showing distances/existing structures/street/direction arrows/lat-long, a topo drawing, exterior elevations (existing & proposed), a Title 24 calculations page, sewer type/tie-in, an electrical plan page, a plumbing plan page, an HVAC page, and — if applicable — a fire-sprinkler plan approved by Cal Fire. No PV-specific submittal checklist exists.
Why the confidence is not higherOCR'd (scanned Canon-copier PDF, no text layer) from the county's own general plan-check handout, undated on its face but pdfinfo CreationDate 26 Feb 2019 — this is the general building checklist, not a solar-specific one, so it is a reasonable but not perfect proxy for what a PV submittal requires.
published checklist checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2019-07/Items%20Needed%20for%20Plan%20Check%2022619.pdf
Q9 How many copies, and in what format? Submittal package
3 sets, printed on at least 18"x24" paper.
Why the confidence is not higherStated verbatim in the 'Items Needed for Plan Check' handout (OCR'd).
checklist checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2019-07/Items%20Needed%20for%20Plan%20Check%2022619.pdf
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes. The plot plan/site plan must show property lines and dimensions, distances from property lines to all proposed and existing structures/improvements, sewer lines, wells and/or points of connection to public utilities (sewer, electricity, water), drawn to scale.
Why the confidence is not higher'Items Needed for Plan Check' handout, plus its attached sample plot-plan diagram (OCR'd).
checklist checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2019-07/Items%20Needed%20for%20Plan%20Check%2022619.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Nothing published by this authority.
Where we lookedno PV-specific submittal checklist exists; the general plan-check checklist requires only a generic 'electrical plan page' and does not name a one-line/three-line diagram
Q12 Are string and conductor calculations required? Drawings & calculations
Nothing published by this authority.
Where we lookedsame as above — no PV-specific checklist exists to specify string/conductor calculations
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
No fixed kW/psf threshold stated. Per Title 14 §14.08.050, engineered-design plan review (in-house or contract engineering consultant, Building Official's discretion) is triggered case-by-case whenever a submittal exceeds conventional light-frame construction provisions for seismic design, wind load, or ground snow load; ALL commercial structures require engineered plancheck regardless.
Why the confidence is not higherOrdinance 1255 §14.08.050 (Plancheck), read directly from the county's own codified ordinance text.
ordinance / checklist checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedchecked Title 14 (Building) in full for an electrical-PE-stamp threshold; none found (only the general seismic/wind/snow structural-plancheck trigger of §14.08.050, which does not name electrical engineering specifically)
https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q15 What does a residential solar permit cost? Core Fees
Nothing published by this authority.
Where we lookedchecked the county's Building Permit Application (blank fee-summary template, no dollar figures), the Planning Department's 'Application Fee Deposits' schedule (only a Planning-level 'Renewable Energy Permit $1,490' for utility-scale facilities and a $50 'Building Permit Plan Check Fee' deposit — neither is a residential PV building-permit fee), and the Building & Safety page; no published residential solar building-permit fee schedule found online
https://www.inyocounty.us/sites/default/files/2024-07/Fee%20Deposits_0.pdf
Q16 How is the fee calculated? Core Fees
Valuation-based (inferred). The Building Permit Application's Permit Cost Summary computes a 'Building Cost Total' and separately assesses state-mandated valuation-based surcharges (SMIP, Building Standards Revolving Fund) alongside the itemized Building/Electrical/Plumbing/Mechanical/Solar permit lines — this is the standard California ICC-valuation-table fee structure, though the county's actual fee resolution/table was not found published online.
Why the confidence is not higherInferred from the structure of the county's own Building Permit Application form (presence of SMIP and Building Standards Revolving Fund lines, which are Health & Safety Code §18937.5 surcharges tied to permit valuation), not from a published fee table itself.
fee schedule checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/County%20Building%20Permit%20Application_0.pdf
Q17 Is there a separate plan-check fee? Fees
Yes. 'Plan Check' is a distinct line item from 'Building Permit' on the county's own Permit Cost Summary; the Planning Department separately lists a 'Building Permit Plan Check Fee' deposit of $50.
Why the confidence is not higherBuilding Permit Application Permit Cost Summary table, and the Planning Department 'Application Fee Deposits' schedule.
fee schedule checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/County%20Building%20Permit%20Application_0.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Nothing published by this authority.
Where we lookedchecked the Building & Safety page and the plan-check checklist for a stated plan-review turnaround time; none found
https://www.inyocounty.us/services/public-works/building-and-safety
Q19 How long is an issued permit valid before it expires? Timeline & validity
Two different windows appear in the county's own documents: the Building Permit Application states a permit becomes void if work is not commenced within 180 days (one year for residential) of issuance or is suspended/abandoned for 180 days; separately, Title 14 §14.04.060 states plan-check applications void after 12 months without permit issuance, and issued building permits void 36 months after issuance absent a written extension request. Both are reported as the county has not reconciled them into a single stated figure.
Why the confidence is not higherCounty Building Permit Application boilerplate, cross-checked against Ordinance 1255 §14.04.060 (Building Permit Expiration).
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/County%20Building%20Permit%20Application_0.pdf
Q20 Which permit portal does this authority use? Core Portal & process

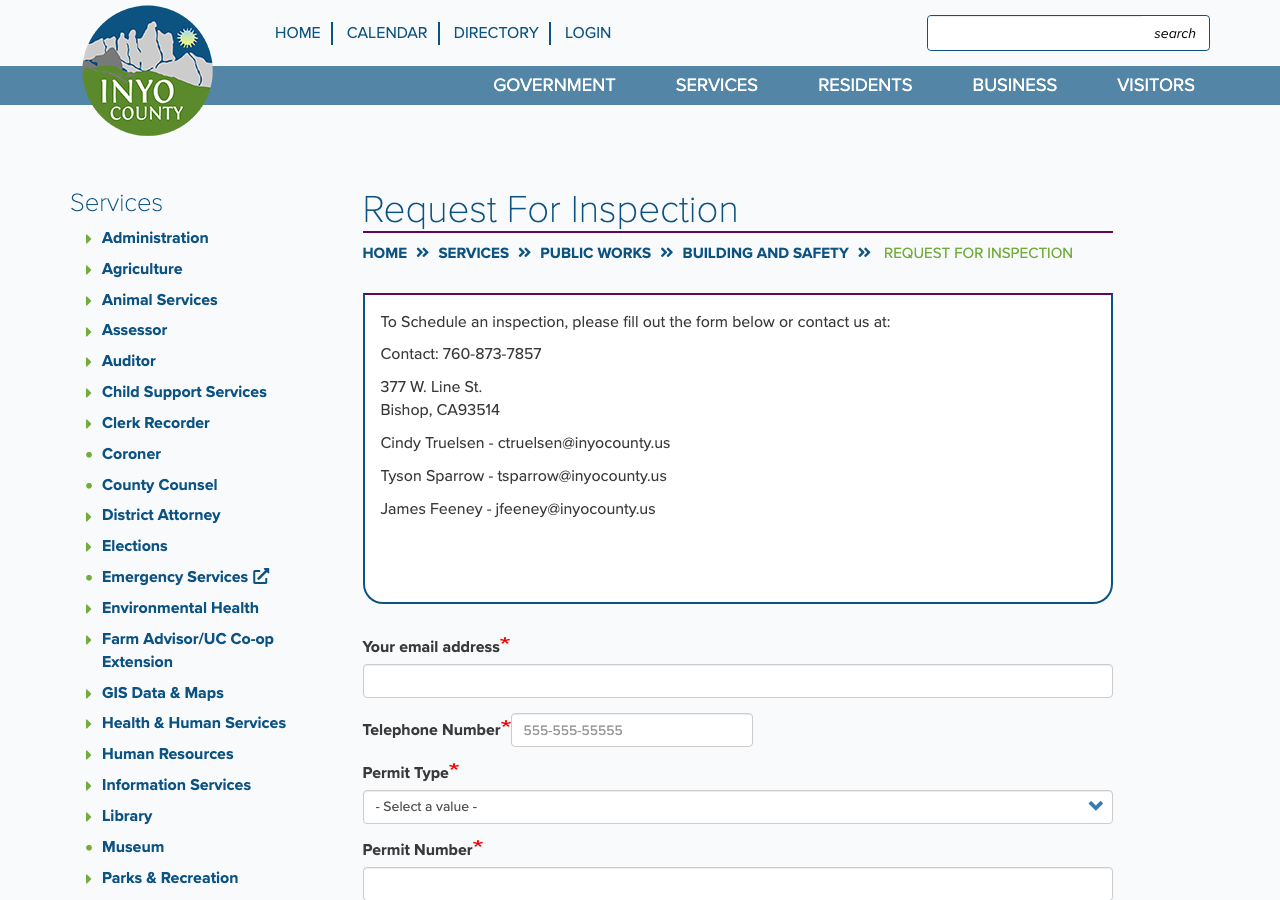

None. Inyo County has no online building-permit portal. Applications are submitted by email (buildingandsafety@inyocounty.us) or in person; the only 'permit' portal linked from the Building & Safety page (inyoso.permitium.com) is the Sheriff's Office concealed-weapon (CCW) permit application system, unrelated to building permits.
Why the confidence is not higherDirect statement on the department's own page ('Permit applications may be submitted via email to buildingandsafety@inyocounty.us'); the Permitium link was opened directly and its own page title reads 'Inyo County Sheriff's Office Online Concealed Weapon Permit Application.'
portal landing page checked 2026-08-31 https://inyoso.permitium.com/ccw/start
Q21 Can the whole application be completed online? Core Portal & process
No. The application itself is submitted by email/in person, not online; the only genuine online form on the Building & Safety pages is a post-issuance Inspection Request form.
Why the confidence is not higherBuilding & Safety department page and Request Inspection page, both read directly.
portal checked 2026-08-31 https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q22 Which utility handles interconnection here? Core Utility interconnection
Southern California Edison (SCE).
Why the confidence is not higherThe county's own joint Multi-Jurisdictional Hazard Mitigation Plan (Inyo County & City of Bishop) states directly, in its capabilities-assessment table: 'Southern California Edison provides safe and reliable electricity to community members in Bishop and Inyo County.' The same document separately shows LADWP's role in the county is water/aqueduct management and power GENERATION tied to the LA Aqueduct system, not retail distribution to county customers — LADWP is a major landowner and water agency here, not the interconnecting utility.
utility territory map + city source checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2020-04/12292017_InyoCountyMJHMP_FEMA_wAppendices.pdf
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedchecked for the county's own statement of where SCE sits in the permit sequence; none found. Per prior-run guidance, SCE's own DG/interconnection pages soft-404 unpredictably and one utility's Rule 21 sequence (e.g. PG&E's) must not be substituted for another's, so this is left unresolved rather than borrowed
Q24 Is a HOA or architectural approval required first? Overlays & special cases
Not generally, for ordinary residential rooftop PV. Title 18 (Zoning) has an 'Architectural Design Review Board' but it is scoped to the county's 'D' (Architectural Design Review) zoning district and a separate 'Lone Pine Architectural Review Board' (a Lone Pine community-specific review, $200 fee) — neither is a general county-wide requirement, and the county's predominant residential (R) districts are not shown to carry this overlay.
Why the confidence is not higherRead directly from Title 18 Chapter 18.69 (Architectural Design Review Board) and the Planning Department's Fee Deposits schedule ('Lone Pine Architectural Review Board... $200'); inference that ordinary residential parcels outside the 'D' district and Lone Pine are not subject to it, since Title 18 gave no county-wide PV-triggering overlay.
ordinance checked 2026-08-31 https://ecode360.com/print/IN4943?guid=44465069
Q25 Is there a historic-district review? Overlays & special cases
No dedicated historic-district review ordinance reaching residential PV was found. Title 18's only 'historic' references are (a) an exclusion criterion in the ministerial two-unit (SB 9-style) development ordinance and (b) a siting exclusion in the small-wind-energy-system chapter — neither is a general historic-review gate on rooftop solar.
Why the confidence is not higherFull-text search of the rendered Title 18 (Zoning) for 'historic' (14 hits, all read and none reaching PV); positive control 'setback' (14 hits) and fabricated control 'zzqqx' (0 hits) confirm the search worked.
ordinance checked 2026-08-31 https://ecode360.com/print/IN4943?guid=44465069
Q26 Is a wind or windstorm certification required? Overlays & special cases
No TDI-style windstorm certification exists, but the county DOES carry its own codified structural wind-load design criterion, county-wide for the unincorporated area: 85 MPH sustained winds with 110 MPH 3-second gusts (Title 14 §14.08.130), adopted as a local amendment because Title 24's base wind provisions were found inadequate for the county's 'remote mountain terrain' and 'high winds.'
Why the confidence is not higherOrdinance 1255 §14.08.020 (Express Findings) and §14.08.130 (Wind Loads), read directly from the county's own codified ordinance.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Not for a standard residential rooftop PV retrofit (a ministerial building permit). Council/Planning-Commission-level approval (a 'Renewable Energy Permit' under Title 21) is required only for a utility-scale 'facility' (a photovoltaic or solar-thermal powerplant transmitting power off-site) — Title 21's own definitions expressly exclude a 'solar energy system' (Civil Code §801.5(a)(1)-(2) / Gov. Code §65850.5) from the 'facility'/'powerplant' definitions that trigger that permit.
Why the confidence is not higherTitle 21 §§21.08.030, 21.08.070, 21.08.120, 21.08.130 (Definitions) and §21.16.010 (Renewable energy permit), read directly from the county's own codified ordinance — a clean, sourced distinction between the utility-scale ordinance and residential rooftop solar.
ordinance checked 2026-08-31 https://ecode360.com/print/IN4943?guid=44467123
Q28 Is there a system-size cap on residential generation? Overlays & special cases
Nothing published by this authority.
Where we lookedsearched Title 14 (Building), Title 18 (Zoning) and Title 21 (Renewable Energy Development) in full for 'kilowatt', 'kW', 'AB 2188', and Gov. Code §65850.5/.52/.55; zero hits across all three (fabricated control 'zzqqx' also 0, positive controls e.g. 'electrical'/'setback' present) — the county appears not to have codified the AB 2188-era small-residential-rooftop size cap/eligibility figure at all
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC, via the county's evergreen adoption of 'the most recent version of Title 24' (Title 14 §14.08.030) — the 2025 California Electrical Code (based on the 2023 NEC) took effect statewide 1 Jan 2026. 80% · adopting ordinance
- Which building code edition is in force? 2025 CBC (California Building Code, Title 24 Part 2), effective 1 Jan 2026 — via the same evergreen §14.08.030 adoption clause. 80% · adopting ordinance
- Which fire code edition is in force? 2025 California Fire Code (Title 24 Part 9), by the same evergreen 'all Parts of Title 24' adoption in §14.08.030 — Title 14 has no separate fire-code chapter of its own and no county fire department exists to publish an independent citation; enforcement for unincorporated-area life-safety/fire-code compliance is per-parcel (see jurisdiction notes). 65% · adopting ordinance
- Are there local amendments to any of the above? Yes. Title 14 §14.08.020 (Express Findings) states local amendments are 'reasonably necessary because of local climatic, geological or topographical conditions, including snow loads, freezing temperatures, high winds, and remote mountain terrain' and are 'more restrictive' than base Title 24 — codified as the elevation-banded Snow Load Design Criteria (§14.08.120) and the county-wide Wind Load Design Criteria (§14.08.130). 95% · ordinance
- What is the installation judged against? The most recent Title 24 cycle (CBC/CEC/CFC), PLUS two express county local amendments that reach a rooftop or ground-mount PV installation's structural design: the Inyo County Snow Load Design Criteria (elevation-banded table, §14.08.120) and the Inyo County Wind Load Design Criteria (85 mph sustained / 110 mph 3-sec gust, §14.08.130); the entire unincorporated county is also designated a Wildland-Urban Interface Fire Area (§14.08.140). 88% · ordinance
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? No local amendment to roof-access-pathway or ridge-setback rules was found anywhere in the county's own code (Title 14 has no fire-code chapter of its own; its only fire/WUI-related local content is the defensible-space clause at §14.08.140, which addresses vegetation/vent clearance, not roof pathways). The unamended, evergreen 2025 CFC §605.11 pathway/setback provisions would apply by default via §14.08.030's blanket Title 24 adoption. 65% · fire code + amendments
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Not locally amended. Rapid shutdown would be governed by NEC §690.12 as adopted through the state's evergreen Title 24/CEC cycle (currently the 2023 NEC via the 2025 CEC). No county-published PV handout or amendment addressing rapid shutdown was found. 55% · NEC edition in force
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? None published by the county. No placard/disconnect-marking specification of any kind (wording, size, colour, material) appears anywhere in Title 14 (Building) or Title 18 (Zoning) — a controlled absence. Base NEC/CFC §705.10-style labeling requirements would apply by default via the evergreen Title 24 adoption, unamended. 68% · ordinance / utility spec
- Does the authority specify placard wording of its own? No — the county does not specify placard wording of its own; none found anywhere in Title 14 or Title 18 (controlled absence, see Q38). 68% · ordinance
- Does it specify letter height, colour or material? No — no county-specified letter height, colour, or material requirement exists for any PV/electrical placard (controlled absence, see Q38). 65% · ordinance
- Is a site plan / facility map placard required, and what must it show? No county-specific site-plan/facility-map placard requirement beyond the general plot-plan submittal (property lines, dimensions, distances to structures and utility connection points) required for any building permit; no PV-specific facility-map placard rule found. 60% · 705.10 + local
- Where must the labels be placed? No local placement rule found; would default to unamended NEC §690/§705 placement requirements via the evergreen Title 24 adoption. No county PV handout exists to check for a location-specific rule. 55% · ordinance / utility spec
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Are batteries permitted, and under what conditions? No battery/ESS-specific ordinance provision exists at the county level. 'Battery' and 'energy storage' return zero hits across the complete text of Title 14 (Building), Title 18 (Zoning), and Title 21 (Renewable Energy Development) — the three county code titles that would plausibly govern construction, siting, or energy systems. 80% · fire code + amendments
- Is there a separate ESS permit or inspection? No — no separate ESS permit or inspection process is codified; see Q45 (same controlled absence). 78% · ordinance
- Is a ground mount treated as a structure? Effectively yes for permitting purposes — the county's own Building & Safety FAQ explicitly lists 'Solar (Roof and Ground Mount)' as requiring a building permit, treating a ground-mount system the same as any other permitted structure/installation. No separate zoning definition, setback, or height rule specific to a ground-mounted PV array was found in Title 18 (the zoning code's only 'ground mount'/'freestanding' hits concern signs and wireless-communications facilities, not solar) — so while a permit is unambiguously required, no PV-specific structural/zoning treatment as a distinct 'structure' category exists. 70% · ordinance
- Is there a local rule on service upgrades or busbar sizing? No local busbar-sizing or service-upgrade amendment exists for solar. Title 14 (the county's complete Building & Safety Ordinance, including its Utility Connection provisions at §§14.08.100-110) returns zero hits for 'busbar', '225', '200 amp', 'NEC', 'National Electrical', or '690.' — a controlled, full-document absence, not a failure to look. 80% · amendments
- Is a specific mounting system or attachment spacing required? No PV-specific mounting-system or attachment-spacing standard (e.g. a fixed inches-on-center figure) is published. What IS codified is the trigger for engineered design: per §14.08.050, any submittal exceeding conventional light-frame provisions for wind load or ground snow load requires plancheck by in-house or contract engineers — meaning a PV mounting rack in a high-snow-load community (e.g. Bishop Creek/Whitney Portal/Aspendell/Glacier Lodge at 100 PSF) or subject to the county's 110 mph 3-second gust wind criterion would need engineered, stamped calculations rather than a prescriptive table. 65% · amendments
20 questions answered against Inyo County’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC, via the county's evergreen adoption of 'the most recent version of Title 24' (Title 14 §14.08.030) — the 2025 California Electrical Code (based on the 2023 NEC) took effect statewide 1 Jan 2026.
Why the confidence is not higherOrdinance 1255 §14.08.030 adopts 'All Parts of the most recent version of the California Code of Regulations, Title 24' by reference, evergreen (no fixed year is named in county text, so this is the current cycle inferred from the state's own 2025 Title 24 timeline).
adopting ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q30 Which building code edition is in force? Core Code editions in force
2025 CBC (California Building Code, Title 24 Part 2), effective 1 Jan 2026 — via the same evergreen §14.08.030 adoption clause.
Why the confidence is not higherOrdinance 1255 §14.08.030.
adopting ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (Title 24 Part 9), by the same evergreen 'all Parts of Title 24' adoption in §14.08.030 — Title 14 has no separate fire-code chapter of its own and no county fire department exists to publish an independent citation; enforcement for unincorporated-area life-safety/fire-code compliance is per-parcel (see jurisdiction notes).
Why the confidence is not higherInferred from Ordinance 1255 §14.08.030's blanket 'all Parts of Title 24' language, which includes CFC as Part 9; the county's own text never names 'California Fire Code' or 'CFC' explicitly anywhere in Title 14, 18 or 21 (checked, zero hits), so this is a reasonable reading rather than an explicit citation.
adopting ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes. Title 14 §14.08.020 (Express Findings) states local amendments are 'reasonably necessary because of local climatic, geological or topographical conditions, including snow loads, freezing temperatures, high winds, and remote mountain terrain' and are 'more restrictive' than base Title 24 — codified as the elevation-banded Snow Load Design Criteria (§14.08.120) and the county-wide Wind Load Design Criteria (§14.08.130).
Why the confidence is not higherOrdinance 1255 §§14.08.020, 14.08.120, 14.08.130, read directly from the county's own current codified ordinance.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q33 What is the installation judged against? Core Electrical
The most recent Title 24 cycle (CBC/CEC/CFC), PLUS two express county local amendments that reach a rooftop or ground-mount PV installation's structural design: the Inyo County Snow Load Design Criteria (elevation-banded table, §14.08.120) and the Inyo County Wind Load Design Criteria (85 mph sustained / 110 mph 3-sec gust, §14.08.130); the entire unincorporated county is also designated a Wildland-Urban Interface Fire Area (§14.08.140).
Why the confidence is not higherOrdinance 1255, Chapter 14.08, read directly.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No local busbar-sizing or service-upgrade amendment exists for solar. Title 14 (the county's complete Building & Safety Ordinance, including its Utility Connection provisions at §§14.08.100-110) returns zero hits for 'busbar', '225', '200 amp', 'NEC', 'National Electrical', or '690.' — a controlled, full-document absence, not a failure to look.
Why the confidence is not higherFull-text search of the complete Ordinance 1255 text: fabricated control 'zzqqx' = 0 hits; positive control 'electrical' = 40+ hits (so the search itself works); none of the busbar/NEC-section terms appear anywhere in the title.
amendments checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
No PV-specific mounting-system or attachment-spacing standard (e.g. a fixed inches-on-center figure) is published. What IS codified is the trigger for engineered design: per §14.08.050, any submittal exceeding conventional light-frame provisions for wind load or ground snow load requires plancheck by in-house or contract engineers — meaning a PV mounting rack in a high-snow-load community (e.g. Bishop Creek/Whitney Portal/Aspendell/Glacier Lodge at 100 PSF) or subject to the county's 110 mph 3-second gust wind criterion would need engineered, stamped calculations rather than a prescriptive table.
Why the confidence is not higherOrdinance 1255 §§14.08.050, 14.08.120, 14.08.130, read directly; no PV-specific spacing number was found anywhere in Title 14 or the plan-check checklist, so this is inference from the general structural-review trigger, not a stated mounting spec.
amendments checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
No local amendment to roof-access-pathway or ridge-setback rules was found anywhere in the county's own code (Title 14 has no fire-code chapter of its own; its only fire/WUI-related local content is the defensible-space clause at §14.08.140, which addresses vegetation/vent clearance, not roof pathways). The unamended, evergreen 2025 CFC §605.11 pathway/setback provisions would apply by default via §14.08.030's blanket Title 24 adoption.
Why the confidence is not higherOrdinance 1255 read in full (Chapters 14.04-14.20); no ridge-setback or roof-pathway figure of any kind appears.
fire code + amendments checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Not locally amended. Rapid shutdown would be governed by NEC §690.12 as adopted through the state's evergreen Title 24/CEC cycle (currently the 2023 NEC via the 2025 CEC). No county-published PV handout or amendment addressing rapid shutdown was found.
Why the confidence is not higherAbsence of any '690.12' or 'rapid shutdown' text anywhere in Title 14, 18, or 21 (checked); no dedicated solar handout exists for the county to check instead, so this is inferred from the evergreen state-code adoption rather than a county statement.
NEC edition in force checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
None published by the county. No placard/disconnect-marking specification of any kind (wording, size, colour, material) appears anywhere in Title 14 (Building) or Title 18 (Zoning) — a controlled absence. Base NEC/CFC §705.10-style labeling requirements would apply by default via the evergreen Title 24 adoption, unamended.
Why the confidence is not higherFull-text search: 'placard' = 0 hits in both Title 14 and Title 18; 'disconnect' (8 hits, Title 14) and 'signage' (9 hits, Title 18, in the general sign-code chapter) confirm the search mechanics work; fabricated control 'zzqqx' = 0 hits.
ordinance / utility spec checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No — the county does not specify placard wording of its own; none found anywhere in Title 14 or Title 18 (controlled absence, see Q38).
Why the confidence is not higherSame full-text search as Q38.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
No — no county-specified letter height, colour, or material requirement exists for any PV/electrical placard (controlled absence, see Q38).
Why the confidence is not higherSame full-text search as Q38.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
No county-specific site-plan/facility-map placard requirement beyond the general plot-plan submittal (property lines, dimensions, distances to structures and utility connection points) required for any building permit; no PV-specific facility-map placard rule found.
Why the confidence is not higherCross-check of the 'Items Needed for Plan Check' plot-plan requirement against a full-text search of Title 14/18 for 'placard'/'facility map' (0 hits).
705.10 + local checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2019-07/Items%20Needed%20for%20Plan%20Check%2022619.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedSCE's own DG/interconnection and placard-spec pages were checked and are known (per prior runs) to soft-404 unpredictably; per standing guidance, one utility's placard document must never be substituted for another's, so this is left unresolved rather than guessed or borrowed
Q43 Where must the labels be placed? Core Labels Signage & labelling
No local placement rule found; would default to unamended NEC §690/§705 placement requirements via the evergreen Title 24 adoption. No county PV handout exists to check for a location-specific rule.
Why the confidence is not higherAbsence confirmed across Title 14/18 full-text search (see Q38 controls).
ordinance / utility spec checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Nothing published by this authority.
Where we lookedchecked Title 14, the plan-check checklist, and the Building & Safety page for an approved-equipment-list requirement; none found, but this is a narrower and harder concept to prove fully absent than a keyword search can rule out
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
No battery/ESS-specific ordinance provision exists at the county level. 'Battery' and 'energy storage' return zero hits across the complete text of Title 14 (Building), Title 18 (Zoning), and Title 21 (Renewable Energy Development) — the three county code titles that would plausibly govern construction, siting, or energy systems.
Why the confidence is not higherFull-text search across all three titles; fabricated control 'zzqqx' = 0 hits in the same documents, and positive controls ('electrical', 'setback', 'height') return many hits in the same texts, confirming the search mechanism works.
fire code + amendments checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
No — no separate ESS permit or inspection process is codified; see Q45 (same controlled absence).
Why the confidence is not higherSame full-text search as Q45.
ordinance checked 2026-08-31 https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
Q47 Is a ground mount treated as a structure? Core Ground mount
Effectively yes for permitting purposes — the county's own Building & Safety FAQ explicitly lists 'Solar (Roof and Ground Mount)' as requiring a building permit, treating a ground-mount system the same as any other permitted structure/installation. No separate zoning definition, setback, or height rule specific to a ground-mounted PV array was found in Title 18 (the zoning code's only 'ground mount'/'freestanding' hits concern signs and wireless-communications facilities, not solar) — so while a permit is unambiguously required, no PV-specific structural/zoning treatment as a distinct 'structure' category exists.
Why the confidence is not higherBuilding & Safety department page FAQ, cross-checked against a full-text search of Title 18 for 'ground mount'/'ground-mount'/'freestanding' (10 hits, all read — none about solar; positive control 'setback' 14 hits, fabricated 'zzqqx' 0 hits).
ordinance checked 2026-08-31 https://www.inyocounty.us/services/public-works/building-and-safety
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedSCE's own DG/interconnection pages were checked and are known to soft-404 unpredictably (per standing guidance); no county document addresses AC-disconnect placement relative to the meter, and one utility's document must not be substituted for another's
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone (760-873-7857) or email to named staff, or the county's own web-based Inspection Request form (which asks for permit type — County of Inyo, City of Bishop, or County and City — permit number, contractor info, address, and inspection type). 80% · department page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes — self-performed in-house. No third-party inspection firm was found anywhere (staff directory, application forms, or fee-schedule appendix); named in-house inspectors are Tyson Sparrow, Cindy Truelsen and James Feeney, all on the @inyocounty.us domain. 82% · department page
- If delegated, to whom? N/A — not delegated. The county performs its own final solar inspection in-house (see Q52). 80% · department page
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
Nothing recorded for Inyo County on this step yet — 2 questions checked and found unpublished. The guidance above is general.
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? No. No PV-specific inspection checklist is published anywhere on the county's Building & Safety or Request Inspection pages — the only published document is the general pre-permit 'Items Needed for Plan Check' handout, which is not an inspection checklist. 70% · department page
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
Nothing recorded for Inyo County on this step yet — 4 questions checked and found unpublished. The guidance above is general.
14 questions answered against Inyo County’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone (760-873-7857) or email to named staff, or the county's own web-based Inspection Request form (which asks for permit type — County of Inyo, City of Bishop, or County and City — permit number, contractor info, address, and inspection type).
Why the confidence is not higherCounty's own Request Inspection department page, read directly (including the underlying web form's field structure).
department page checked 2026-08-31 https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedchecked the Request Inspection page for a stated notice period (e.g. '24 hours', '2 business days'); none found
https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedchecked the Request Inspection page for stated AM/PM or same-day inspection windows; none found
https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes — self-performed in-house. No third-party inspection firm was found anywhere (staff directory, application forms, or fee-schedule appendix); named in-house inspectors are Tyson Sparrow, Cindy Truelsen and James Feeney, all on the @inyocounty.us domain.
Why the confidence is not higherCounty's own Request Inspection page and the plan-check checklist's named 'Building Inspector' signature block.
department page checked 2026-08-31 https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q53 If delegated, to whom? Core Who inspects
N/A — not delegated. The county performs its own final solar inspection in-house (see Q52).
Why the confidence is not higherSame evidence as Q52 — no delegation found across every tell checked (staff directory/email domains, fee-schedule staffing, portal domain, budget line items were not all exhaustively checked, but no contractor name surfaced anywhere in the documents reviewed).
department page checked 2026-08-31 https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q54 Which inspections are required, and in what order? Core Stages & sequence
Nothing published by this authority.
Where we lookedchecked the Building & Safety page and Request Inspection page for a published, ordered list of required PV inspections (rough-in, mid-roof, final, etc.); none found — only a generic 'Inspection Type' dropdown with unlisted options on the online request form
https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedsame document set as Q54 checked; no PV-specific rough-in/mid-roof inspection requirement found
https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q56 Does the inspector verify labels and listings? Core What is checked
Nothing published by this authority.
Where we lookedno published solar inspection checklist exists to confirm whether labels/listings are verified (see Q57)
https://www.inyocounty.us/services/public-works/building-and-safety
Q57 Is there a published inspection checklist? Core What is checked
No. No PV-specific inspection checklist is published anywhere on the county's Building & Safety or Request Inspection pages — the only published document is the general pre-permit 'Items Needed for Plan Check' handout, which is not an inspection checklist.
Why the confidence is not higherChecked both department pages and their linked document sets directly.
department page checked 2026-08-31 https://www.inyocounty.us/services/public-works/building-and-safety
Q58 What must be on site at inspection? Core Documents on site
Nothing published by this authority.
Where we lookedchecked the Building & Safety and Request Inspection pages for a stated 'what must be on site' requirement; none found
https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q59 Is there a re-inspection fee? Corrections & re-inspection
Nothing published by this authority.
Where we lookedchecked the Building Permit Application (blank fee template) and the Planning Fee Deposits schedule for a re-inspection fee line; none found
https://www.inyocounty.us/sites/default/files/2026-07/County%20Building%20Permit%20Application_0.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Nothing published by this authority.
Where we lookedchecked both department pages for a stated corrections/re-inspection clearance process; none found beyond the general phone/email contact channel
https://www.inyocounty.us/services/public-works/building-and-safety/request-inspection
Q61 What is issued on pass? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedno county document states what document (CO, final card, letter) is issued specifically on a PASSED solar inspection; general Title 14 references a 'certificate of occupancy' only in the Temporary Emergency Dwelling chapter, not for ordinary PV retrofits
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedno county document addresses who notifies SCE for Permission to Operate; this is a utility-level (SCE) process question that the county's own materials do not address, and SCE's own pages were not substituted per standing guidance
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for Inyo County against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
Inyo County is the authority having jurisdiction 88% confidence
- Holds
- Building AND Electrical for UNINCORPORATED Inyo County only, performed in-house by the Public Works Department's Building & Safety Division (Building Official = Director of Public Works, Title 14 §14.04.020(C)). There is no separate county fire department: Title 14 adopts the fire code only as part of its blanket 'all Parts of Title 24' clause (§14.08.030) and appoints no Building-Official fire-enforcement role (unlike Plumas County's §8-1.09). Fire protection/plan-review in the unincorporated area is per-parcel, coordinated through the 'Interagency Fire Protection Agencies' (IFPA) consortium named in the county/City-of-Bishop joint Hazard Mitigation Plan: Bishop Fire District, Big Pine Fire District, Lone Pine Fire District, Independence Fire District, CAL FIRE, US Forest Service, BLM, and LADWP (on its own lands) — and the county's own plan-check checklist separately states 'Fire Sprinkler plan must be approved by Cal Fire.' Title 14 §14.20 (Fire Mitigation Fees) itself defines 'fire agency' as 'any special district providing fire protection services within the unincorporated area of the county' — i.e. no single agency, by the county's own definition. The City of Bishop, the county's ONLY incorporated city, self-performs BOTH building and fire independently: its own Public Works/Building & Safety Department (staffed separately, own phone, own email domain @cityofbishop.ca.gov) issues its own permits and publishes its own dedicated 'Small Residential Rooftop Solar Energy System Permits' document, and its own volunteer City of Bishop Fire Department (39 volunteers + 1 paid chief) is functionally and organizationally distinct from the county. One oddity noted but not resolved: the county's own online Inspection Request form offers a 'Permit Type' dropdown of 'County of Inyo / City of Bishop / County and City', suggesting some shared intake mechanism between the two governments despite otherwise-separate staff, domains and documents — reported as an open question, not resolved either way.
- Overridden by
- State law overlays apply as everywhere in CA (Civil Code §714 Solar Rights Act preempting HOA/architectural restrictions; Gov. Code §65850.5/.52/.55 ministerial-permitting and fee-cap framework) but no county-specific override beyond the state baseline was found. Utility-scale renewable energy (solar/wind 'powerplants') is separately regulated county-wide under Title 21 (Renewable Energy Development, a Planning-Commission CUP-style permit) — but Title 21's own definitions explicitly EXCLUDE an ordinary residential 'solar energy system' from that process, so it does not reach residential rooftop PV.
- Why not higher
- Title 14 §14.04.030's unincorporated-only scope clause is explicit and codified. City of Bishop's independent self-performance is confirmed from Bishop's own department pages, its own staff (different domain/phone/address details from the county despite a coincidentally identical street number), and its own dedicated solar-permitting PDF. Confidence is not higher because (a) the shared county inspection-request-form dropdown naming Bishop was not resolved, and (b) no single named county fire agency exists to point to — the per-parcel/IFPA-consortium shape is corroborated by two of the county's own documents (Title 14 §14.20's definition and the MJHMP capabilities table) but not by a single authoritative roster of which fire district covers which unincorporated parcel.
https://www.inyocounty.us/sites/default/files/2026-07/Ordinance%201255.pdf
- Permit required
- Yes. The county's own Building & Safety FAQ lists 'Solar (Roof and Ground Mount)' among the items requiring a building permit.95%
- Portal
- None. Inyo County has no online building-permit portal. Applications are submitted by email (buildingandsafety@inyocounty.us) or in person;85%
- Electrical code
- 2023 NEC, via the county's evergreen adoption of 'the most recent version of Title 24' (Title 14 §14.08.030) — the 2025 California Electrical Code (based on the 2023 NEC) took effect…80%
- Own placard wording
- No — the county does not specify placard wording of its own; none found anywhere in Title 14 or Title 18 (controlled absence, see Q38).68%
- Booking an inspection
- Phone (760-873-7857) or email to named staff, or the county's own web-based Inspection Request form (which asks for permit type — County of Inyo, City of Bishop,80%
Labels & placards for this authority
Wording 68%
No — the county does not specify placard wording of its own; none found anywhere in Title 14 or Title 18 (controlled absence, see Q38).
Size, colour & material 65%
No — no county-specified letter height, colour, or material requirement exists for any PV/electrical placard (controlled absence, see Q38).
Where they go 55%
No local placement rule found; would default to unamended NEC §690/§705 placement requirements via the evergreen Title 24 adoption. No county PV handout exists to check for a location-specific rule.
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
