Kern County
State of California
Kern County is a county authority in the State of California, covering 71 regions, serving 909,235 residents. 6,609 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes — a permit is required for residential rooftop PV Q3 Electrical and building permits — Combined for residential rooftop PV — the solar fee ordinance sets a single 'Building Permit Fee for solar photovoltaic systems', Q4 Plan review — Walk-in: plan review and issuance of all required permits within 1 business day 'when reasonable to do so'. Q18 Where you file — Accela Citizen Access — https://accela.kerncounty.com/CitizenAccess (branded 'Citizen Portal'), with ePlanSoft ePlanCheck behind it for electronic plan review. Q20
- Permit required
- Yes — a permit is required for residential rooftop PV93% source
- What it costs
- $300 for systems 0 to ≤6 kW AC; $450 for >6 to ≤15 kW AC; $450 plus $15 per kW AC above 15 kW for >15 kW AC.88% source
- Plan review turnaround
- Walk-in: plan review and issuance of all required permits within 1 business day 'when reasonable to do so'. Electronic submittal: 1 to 3 business days 'when reasonable to do so'.90% source
- Key document
- published structural criteria form cited by 6 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes — Kern County Public Works, Building Inspection Division is the AHJ for residential solar on any parcel in unincorporated Kern County 92% · adopting ordinance / Code of Building Regulations (Ord. G-9359, eff. 1-1-2026)
- What does this authority permit itself, and what does it delegate? Both — Building Inspection Division issues building AND electrical permits itself; it also routes the submittal to other county departments (Fire, Environmental Health, Planning, Flood, Drainage) as a one-stop shop. Nothing is delegated for residential rooftop PV. 90% · department process guide
- Is a permit required for a residential rooftop PV system? Yes — a permit is required for residential rooftop PV 93% · ordinance (Municode, codified through Ord. G-9369, 6 Jan 2026)
- Is there a separate electrical permit, or is it combined? Combined for residential rooftop PV — the solar fee ordinance sets a single 'Building Permit Fee for solar photovoltaic systems', and permits 'may be combined on any project and one issuance fee charged' 62% · fee ordinance G-8792 (11 Sep 2018)
- Is a HOA or architectural approval required first? No — no HOA or architectural approval is required by the county before permitting. Chapter 17.57.040 lists every applicant pre-condition and none of them is third-party approval; the building official 'shall administratively approve the application' once the checklist is met. 58% · ordinance ch. 17.57
- Is there a historic-district review? No — the Kern County Zoning Ordinance has no historic-preservation or historic-district combining district. The combining districts are LS, PD, CL, RS, RL, MH, WE (wind energy), PE, GH, FP, FPS, KRC (Kern River Corridor), SC (scenic corridor) and H (airport approach height). 75% · zoning ordinance
- Is a wind or windstorm certification required? No separate wind/windstorm certification. But Kern County has adopted its own local design wind speed map — Chapter 16 Figure 1609D, 'Kern County Ultimate Design Wind Speed', and CRC Figure R301.2(5)A.1 — and the prescriptive solar anchor table only applies where the dwelling is in Exposure B with design wind speed 115–130 mph in a Special Wind Region, or Exposure C at ≤110 mph and not on the top half of a tall hill. Outside those envelopes an engineered design is required. 80% · Code of Building Regulations ch. 17.08 + structural criteria form
- Is a Specific Use Permit or Council approval ever required? Rarely, but yes in two circumstances. (a) Kern County Code 17.57.040(C): the building official 'shall require a use permit if he/she makes a finding, based on substantial evidence, that the solar energy system could have specific, adverse impact upon the public health and safety' — that decision is appealable to the Planning Commission, and a use permit so required 'may not be denied unless written findings are made based upon substantial evidence'. (b) Zoning: solar generators that are NOT accessory to a permitted use, or that exceed on-site demand, fall outside the by-right listing and require a conditional use permit. 85% · ordinance ch. 17.57 + zoning ordinance
- Is there a system-size cap on residential generation? Three different caps operate. (1) Zoning: a solar energy electrical generator is permitted by right in the residential and agricultural districts where it is 'accessory to a permitted or conditionally permitted use and where the power generated does not exceed the total on-site power demand' — i.e. by-right generation is capped at on-site consumption. (2) Expedited permitting: ≤10 kW AC CEC rating (ch. 17.57 definition and the eligibility checklist). (3) SolarAPP+: no stated wattage cap, but max main service 400 A, service disconnect and busbar ≤225 A, max main breaker 200 A; the county's own expedited checklist additionally requires a 120/240 V single-phase service with bus rating ≤225 A and module Isc <13 A. Above these, the standard plan-review route applies. 82% · zoning ordinance + ordinance ch. 17.57 + SolarAPP+ page
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either — a licensed contractor (C-10 or other appropriate class), a licensed engineer, the property owner, or an authorised owner's agent. Code 17.24.040: 'A property owner may do electrical work on his own property; a homeowner or a member of his immediate family may do electrical work on his residence.' Otherwise a 'qualified electrician' = licensed C-10 contractor, or someone examined/interviewed by the county working under a C-10. 90% · Code of Building Regulations ch. 17.24
- Must the contractor be registered with this authority before applying? No — no county contractor registration. The application requires only the CSLB Licensed Contractor Declaration (licence number and class) under B&P Code ch. 9. Separately, to use the SolarAPP+ route the installer must hold a SolarAPP+ account with verified licence information and complete the IREC training — that is NREL's requirement, not the county's. 78% · permit application form (rev. 2025)
- Is a homeowner permitted to self-install and self-permit? Yes — owner-builder is expressly provided for. The application has an 'OWNER – BUILDER DECLARATION' and the cover sheet notes 'OWNER-BUILDER REQUIRES NOTICE OF PROPERTY OWNER-SIGNED BY OWNER AND ID'. Code 17.24.040 separately allows a homeowner (or immediate family) to do the electrical work on their own residence. 88% · permit application form
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Standard (non-SolarAPP+) route: (1) completed Building Permit Application; (2) 'Eligibility Checklist for Expedited Rooftop Solar Permitting'; (3) three copies of plans showing total number of collectors and area, make/model/collector certification number, system certification number; (4) roof plan showing roof layout, collectors with attachment details, system schematic with major components, approximate location of roof access points, equipment cut sheets; (5) 'Structural Criteria for Residential Roof-Mounted Solar Arrays' form (or stamped structural drawings and calcs if it fails); (6) one-line diagram; (7) fees. SolarAPP+ route: SolarAPP+ approval documents uploaded into Accela Citizen Access. 88% · published submittal checklist
- How many copies, and in what format? Three copies/sets of plans for paper or over-the-counter submittal; electronically via the Accela Citizen Access portal, prepared to the county's Electronic Document Submittal Requirements 85% · published submittal checklist
- Is a site plan required, and what must it show? Yes. 'Plot plan shall be legible and to scale.' The roof plan must show roof layout, module and anchor layout, solar collectors with attachment details, system schematic including major components, approximate location of roof access points, and must 'clearly illustrate, with dimensions, required setbacks at the ridge, valley, and eave roof lines' plus 'a detailed legend denoting all vent stacks, mechanical vents, B-vents, fire places, cupolas, dormers, etc.' 88% · published submittal checklist
- Is a one-line / three-line diagram required? Yes — 'Provide a one-line diagram illustrating disconnects, AC/DC, wiring sizing, panel size, hot tap, and side line taps.' The county also publishes a 'Typical Electrical One Line Diagram' detail sheet. 90% · published submittal checklist
- Are string and conductor calculations required? Partly. Conductor sizing must be shown on the required one-line diagram. Full electrical load calculations are required only 'for projects with less than a 200 amp main, if there is a pool or other electrical demands other than the residence'. On the SolarAPP+ route the inspector may require conduit-fill calculations in the field. 80% · published submittal checklist
- Is a structural PE stamp required, and at what threshold? Only by exception. If every item on the county's 'Structural Criteria for Residential Roof-Mounted Solar Arrays' form is answered YES, no calculations and no stamp are required. If ANY item is NO, 'project-specific drawings and calculations stamped and signed by a California registered Civil or Structural Engineer or licensed Architect are required.' The prescriptive triggers include: array > 4 psf (PV) or 5 psf (thermal); array covering more than half the total roof area; module plane not parallel to roof; gap outside 2"–10"; overhang of any ridge/hip/gable/eave; anchor horizontal spacing exceeding Table 1 (e.g. flat–6:12 pitch: 5'-4" at 16" o.c., 6'-0" at 24" o.c., 5'-4" at 32" o.c.; 7:12–24:12: 1'-4"/2'-0"/2'-8"); anchor fastener other than 5/16" lag with 2.5" embedment or per manufacturer; roof sag exceeding span-in-feet ÷ 20; reroof overlay; roof slope 13:12–24:12 for solar thermal (calculation always required). 88% · published structural criteria form
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? Accela Citizen Access — https://accela.kerncounty.com/CitizenAccess (branded 'Citizen Portal'), with ePlanSoft ePlanCheck behind it for electronic plan review. For eligible retrofit rooftop PV, NREL SolarAPP+ (gosolarapp.org) does the automated plan review and the approval documents are then uploaded into Accela. 92% · portal / department page
- Can the whole application be completed online? Yes — 'You can now complete your entire permit process online, from application, to review, pay fees, and schedule inspections.' 85% · department page
- What does a residential solar permit cost? $300 for systems 0 to ≤6 kW AC; $450 for >6 to ≤15 kW AC; $450 plus $15 per kW AC above 15 kW for >15 kW AC. Plus a $25.50 minimum application fee at time of application, plus the state Strong Motion Instrumentation Program fee ($13 per $100,000 valuation for Group R one-to-three storeys, minimum $0.50). SolarAPP+ users also pay NREL $35 per solar permit and $25 per energy-storage add-on, on top of county fees. 88% · fee ordinance G-8792
- How is the fee calculated? Tiered (flat within band, then per kW above 15 kW AC) 90% · fee ordinance G-8792
- Is there a separate plan-check fee? No separate plan-check fee is published for residential solar — the tiered solar fee is a single figure. (The general 2008 fee schedule splits total permit fee into 1/3 plan check + 2/3 inspection only 'where the permit fee is determined by the percentage method of calculation', which solar is not.) 62% · fee ordinance G-8792 + 2008 fee ordinance
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? Walk-in: plan review and issuance of all required permits within 1 business day 'when reasonable to do so'. Electronic submittal: 1 to 3 business days 'when reasonable to do so'. Applies to systems meeting the 'small residential rooftop solar energy system' definition (≤10 kW AC / 30 kW thermal, single or duplex dwelling). SolarAPP+ approval is instant/automated. 90% · ordinance ch. 17.57
- How long is an issued permit valid before it expires? 360 days — a permit expires if work is not commenced within 360 days of issuance, or if work is suspended/abandoned for 360 days. A single extension of up to 180 days may be granted on written request, and a valid inspection must then be requested within 60 days. Regardless, all permits expire 5 years after issuance (annual extensions available for a fee). 92% · Code of Building Regulations ch. 17.04
- Which utility handles interconnection here? Split by address. Pacific Gas & Electric serves western and central Kern (its own tariff service-area map lists Arvin, Bakersfield, Buttonwillow, Edison, Fellows, Lamont, Lost Hills, Maricopa, McFarland, McKittrick, Shafter, Taft, Tehachapi, Tupman, Wasco). Southern California Edison serves portions of Kern County including Ridgecrest, California City, Tehachapi, Delano and McFarland. The utility must be confirmed per address. 72% · utility tariff service-area map + SCE service-area sheet
- Where does the utility sit in the sequence? Parallel for the application, but the utility is strictly last for energization. Kern County Code 17.57.040(E): county approval 'does not authorize an applicant to connect the small residential rooftop energy system to the local utility provider's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility provider.' And 17.24.190(B): 'No utility or service agency shall supply electrical energy ... to a wiring system which has not been inspected and approved.' 88% · ordinance ch. 17.57 + ch. 17.24
28 questions answered against Kern County’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes — Kern County Public Works, Building Inspection Division is the AHJ for residential solar on any parcel in unincorporated Kern County
Why the confidence is not higherKern County Code 17.04.030(B): the Code of Building Regulations 'shall apply ... to all construction in the unincorporated Kern County'. The county's own page separately directs City of Bakersfield addresses elsewhere. Not higher because incorporated-city boundaries must be checked per address.
adopting ordinance / Code of Building Regulations (Ord. G-9359, eff. 1-1-2026) checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both — Building Inspection Division issues building AND electrical permits itself; it also routes the submittal to other county departments (Fire, Environmental Health, Planning, Flood, Drainage) as a one-stop shop. Nothing is delegated for residential rooftop PV.
Why the confidence is not higher'How a Permit becomes a Structure' states 'Kern County Building Inspection is a one-stop-shop ... we will take care of notifying all departments'. Code ch. 17.24 makes the Public Works Director the 'Building official and Chief Electrical Inspector'. Not higher because the guide is undated on its face.
department process guide checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10712/638314119899930000
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes — a permit is required for residential rooftop PV
Why the confidence is not higherKern County ch. 17.57 establishes a permit process for 'small residential rooftop solar energy systems'; the county's 'Does my project require a building permit?' handout lists the CRC R105.2 exemptions and solar is not among them. Two of the authority's own documents agree.
ordinance (Municode, codified through Ord. G-9369, 6 Jan 2026) checked 2026-08-28 https://library.municode.com/ca/kern_county/codes/code_of_ordinances?nodeId=TIT17BUCO_CH17.57SMREROSOENSYREPR
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined for residential rooftop PV — the solar fee ordinance sets a single 'Building Permit Fee for solar photovoltaic systems', and permits 'may be combined on any project and one issuance fee charged'
Why the confidence is not higherOrdinance G-8792 prices solar as one building permit fee; the fee schedule says permits may be combined with one issuance fee. Cuts the other way: Code 17.24.100 says 'A separate permit shall be required for electrical installations'. The two are not reconciled in writing, so this is inference from two of the authority's own documents rather than a stated rule.
fee ordinance G-8792 (11 Sep 2018) checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10720/638314111279470000
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either — a licensed contractor (C-10 or other appropriate class), a licensed engineer, the property owner, or an authorised owner's agent. Code 17.24.040: 'A property owner may do electrical work on his own property; a homeowner or a member of his immediate family may do electrical work on his residence.' Otherwise a 'qualified electrician' = licensed C-10 contractor, or someone examined/interviewed by the county working under a C-10.
Why the confidence is not higherDirect quote from the current 2025 Code of Building Regulations 17.24.020(E) and 17.24.040, plus the county's 'Plan Check by Appointment' handout ('Permits may be applied for by the property owner (grant deed may be required), a licensed contractor/engineer, or an authorized owner's agent'). Not higher because the OTC handout dates from 2019.
Code of Building Regulations ch. 17.24 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
No — no county contractor registration. The application requires only the CSLB Licensed Contractor Declaration (licence number and class) under B&P Code ch. 9. Separately, to use the SolarAPP+ route the installer must hold a SolarAPP+ account with verified licence information and complete the IREC training — that is NREL's requirement, not the county's.
Why the confidence is not higherThe county's 2025 Building Permit Application has only the state licence declaration; no registration page or form exists in the Bulletins/Documents/Forms library. Absence proved by looking in the application form and all six Forms sub-folders; not higher because a counter practice could exist that is unpublished.
permit application form (rev. 2025) checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22777/639046855834070000
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes — owner-builder is expressly provided for. The application has an 'OWNER – BUILDER DECLARATION' and the cover sheet notes 'OWNER-BUILDER REQUIRES NOTICE OF PROPERTY OWNER-SIGNED BY OWNER AND ID'. Code 17.24.040 separately allows a homeowner (or immediate family) to do the electrical work on their own residence.
Why the confidence is not higherTwo of the authority's own current documents. Not higher because the owner-builder route's interaction with the expedited-solar checklist (which is written for 'the contractor or an authorized agent of the contractor') is not spelled out.
permit application form checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22777/639046855834070000
Q8 What documents make up a complete submittal? Core Submittal package
Standard (non-SolarAPP+) route: (1) completed Building Permit Application; (2) 'Eligibility Checklist for Expedited Rooftop Solar Permitting'; (3) three copies of plans showing total number of collectors and area, make/model/collector certification number, system certification number; (4) roof plan showing roof layout, collectors with attachment details, system schematic with major components, approximate location of roof access points, equipment cut sheets; (5) 'Structural Criteria for Residential Roof-Mounted Solar Arrays' form (or stamped structural drawings and calcs if it fails); (6) one-line diagram; (7) fees. SolarAPP+ route: SolarAPP+ approval documents uploaded into Accela Citizen Access.
Why the confidence is not higherVerbatim from the county's 'Submittal Requirements for Expedited Residential Solar Permitting' (revision date 9/24/2024) and the SolarAPP+ page. Not higher because the checklist's revision date predates the 1 Jan 2026 code cycle and the county has not reissued a 2025-cycle version of it.
published submittal checklist checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q9 How many copies, and in what format? Submittal package
Three copies/sets of plans for paper or over-the-counter submittal; electronically via the Accela Citizen Access portal, prepared to the county's Electronic Document Submittal Requirements
Why the confidence is not higherThe expedited solar checklist says 'Provide three copies of the plans'; the Plan Check by Appointment handout says 'Provide three (3) sets of accurate project plans'. Electronic route confirmed on the Electronic Document Review page. Not higher: the solar checklist is dated 9/24/2024 and the OTC handout is from 2019.
published submittal checklist checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes. 'Plot plan shall be legible and to scale.' The roof plan must show roof layout, module and anchor layout, solar collectors with attachment details, system schematic including major components, approximate location of roof access points, and must 'clearly illustrate, with dimensions, required setbacks at the ridge, valley, and eave roof lines' plus 'a detailed legend denoting all vent stacks, mechanical vents, B-vents, fire places, cupolas, dormers, etc.'
Why the confidence is not higherVerbatim from the county's expedited solar submittal checklist (Notes and Other Information items 1–3). Not higher because that checklist carries a 9/24/2024 revision date, one code cycle behind.
published submittal checklist checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes — 'Provide a one-line diagram illustrating disconnects, AC/DC, wiring sizing, panel size, hot tap, and side line taps.' The county also publishes a 'Typical Electrical One Line Diagram' detail sheet.
Why the confidence is not higherVerbatim from the county's expedited solar submittal checklist, item 4 of Notes and Other Information. Not higher because the checklist is revision-dated 9/24/2024.
published submittal checklist checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q12 Are string and conductor calculations required? Drawings & calculations
Partly. Conductor sizing must be shown on the required one-line diagram. Full electrical load calculations are required only 'for projects with less than a 200 amp main, if there is a pool or other electrical demands other than the residence'. On the SolarAPP+ route the inspector may require conduit-fill calculations in the field.
Why the confidence is not higherThe expedited checklist states the load-calculation trigger and the one-line wire-sizing requirement explicitly; the conduit-fill point is from the county's own SolarAPP+ Technical FAQ. There is no standing requirement for string voltage/temperature calculations in either document, which is why this is 'partly' rather than a flat Yes.
published submittal checklist checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Only by exception. If every item on the county's 'Structural Criteria for Residential Roof-Mounted Solar Arrays' form is answered YES, no calculations and no stamp are required. If ANY item is NO, 'project-specific drawings and calculations stamped and signed by a California registered Civil or Structural Engineer or licensed Architect are required.' The prescriptive triggers include: array > 4 psf (PV) or 5 psf (thermal); array covering more than half the total roof area; module plane not parallel to roof; gap outside 2"–10"; overhang of any ridge/hip/gable/eave; anchor horizontal spacing exceeding Table 1 (e.g. flat–6:12 pitch: 5'-4" at 16" o.c., 6'-0" at 24" o.c., 5'-4" at 32" o.c.; 7:12–24:12: 1'-4"/2'-0"/2'-8"); anchor fastener other than 5/16" lag with 2.5" embedment or per manufacturer; roof sag exceeding span-in-feet ÷ 20; reroof overlay; roof slope 13:12–24:12 for solar thermal (calculation always required).
Why the confidence is not higherAll figures read directly out of the county's own PDF form via pdftotext -layout, including Table 1. Not higher because the form's revision date is 9/24/2024, i.e. written against the 2022 code cycle, and the county has not republished it for the 2025 cycle.
published structural criteria form checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedKern County 2025 Code of Building Regulations ch. 17.24 (Electrical Code) read in full; the 'Submittal Requirements for Expedited Residential Solar Permitting' checklist and its 'Structural Criteria' form; the 2025 Residential Plan Checklists folder and all six Forms sub-folders in Bulletins/Documents/Forms. No electrical PE stamp requirement or threshold appears anywhere; the only stamp requirement published for solar is the STRUCTURAL one at Q13. The county's residential code checklist requires a California Registered Design Professional to stamp and sign submitted plans generally, but that provision sits in the single-family-dwelling checklist, not in the solar path. Absence is likely genuine but Kern never states 'no electrical stamp required', so it is recorded here rather than as a No.
https://www.kernpublicworks.com/services/development/building-inspection/bulletins-documents-forms
Q15 What does a residential solar permit cost? Core Fees
$300 for systems 0 to ≤6 kW AC; $450 for >6 to ≤15 kW AC; $450 plus $15 per kW AC above 15 kW for >15 kW AC. Plus a $25.50 minimum application fee at time of application, plus the state Strong Motion Instrumentation Program fee ($13 per $100,000 valuation for Group R one-to-three storeys, minimum $0.50). SolarAPP+ users also pay NREL $35 per solar permit and $25 per energy-storage add-on, on top of county fees.
Why the confidence is not higherThe county fee page links Ordinance G-8792 (adopted 11 Sep 2018) as the current solar fee resolution, and the separate 2024 expedited-solar checklist repeats exactly the same three tiers — two of the authority's own documents six years apart agreeing. Held below 95 because the governing ordinance is from 2018 and the fees page also still links a 2008 building fee ordinance, so an unposted CPI adjustment is possible (the application fee has clearly drifted from $23 in 2008 to $25.50 today).
fee ordinance G-8792 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10720/638314111279470000
Q16 How is the fee calculated? Core Fees
Tiered (flat within band, then per kW above 15 kW AC)
Why the confidence is not higherDirectly from the tier structure in Ordinance G-8792. Not valuation-based and not per-panel. Same caveat as Q15 on the ordinance's age.
fee ordinance G-8792 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10720/638314111279470000
Q17 Is there a separate plan-check fee? Fees
No separate plan-check fee is published for residential solar — the tiered solar fee is a single figure. (The general 2008 fee schedule splits total permit fee into 1/3 plan check + 2/3 inspection only 'where the permit fee is determined by the percentage method of calculation', which solar is not.)
Why the confidence is not higherInference from two county documents: G-8792 prices solar as a single fee, and the plan-check split in the 2008 ordinance is expressly limited to valuation-percentage fees. The expedited checklist does warn 'Additional fees may apply at the time of application', so an unlisted charge is possible.
fee ordinance G-8792 + 2008 fee ordinance checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10720/638314111279470000
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Walk-in: plan review and issuance of all required permits within 1 business day 'when reasonable to do so'. Electronic submittal: 1 to 3 business days 'when reasonable to do so'. Applies to systems meeting the 'small residential rooftop solar energy system' definition (≤10 kW AC / 30 kW thermal, single or duplex dwelling). SolarAPP+ approval is instant/automated.
Why the confidence is not higherKern County Code 17.57.040(B), confirmed live on Municode against the code as codified through Ord. G-9369 (6 Jan 2026). Held below 95 by the ordinance's own 'when reasonable to do so' qualifier, which makes it a target rather than a guarantee.
ordinance ch. 17.57 checked 2026-08-28 https://library.municode.com/ca/kern_county/codes/code_of_ordinances?nodeId=TIT17BUCO_CH17.57SMREROSOENSYREPR
Q19 How long is an issued permit valid before it expires? Timeline & validity
360 days — a permit expires if work is not commenced within 360 days of issuance, or if work is suspended/abandoned for 360 days. A single extension of up to 180 days may be granted on written request, and a valid inspection must then be requested within 60 days. Regardless, all permits expire 5 years after issuance (annual extensions available for a fee).
Why the confidence is not higherKern County Code 17.04.180(A), (B) and (D), quoted from the current 2025 Code of Building Regulations (Ord. G-9359). Plan-check side: an application with no permit issued within 180 days expires (17.04.190).
Code of Building Regulations ch. 17.04 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q20 Which permit portal does this authority use? Core Portal & process

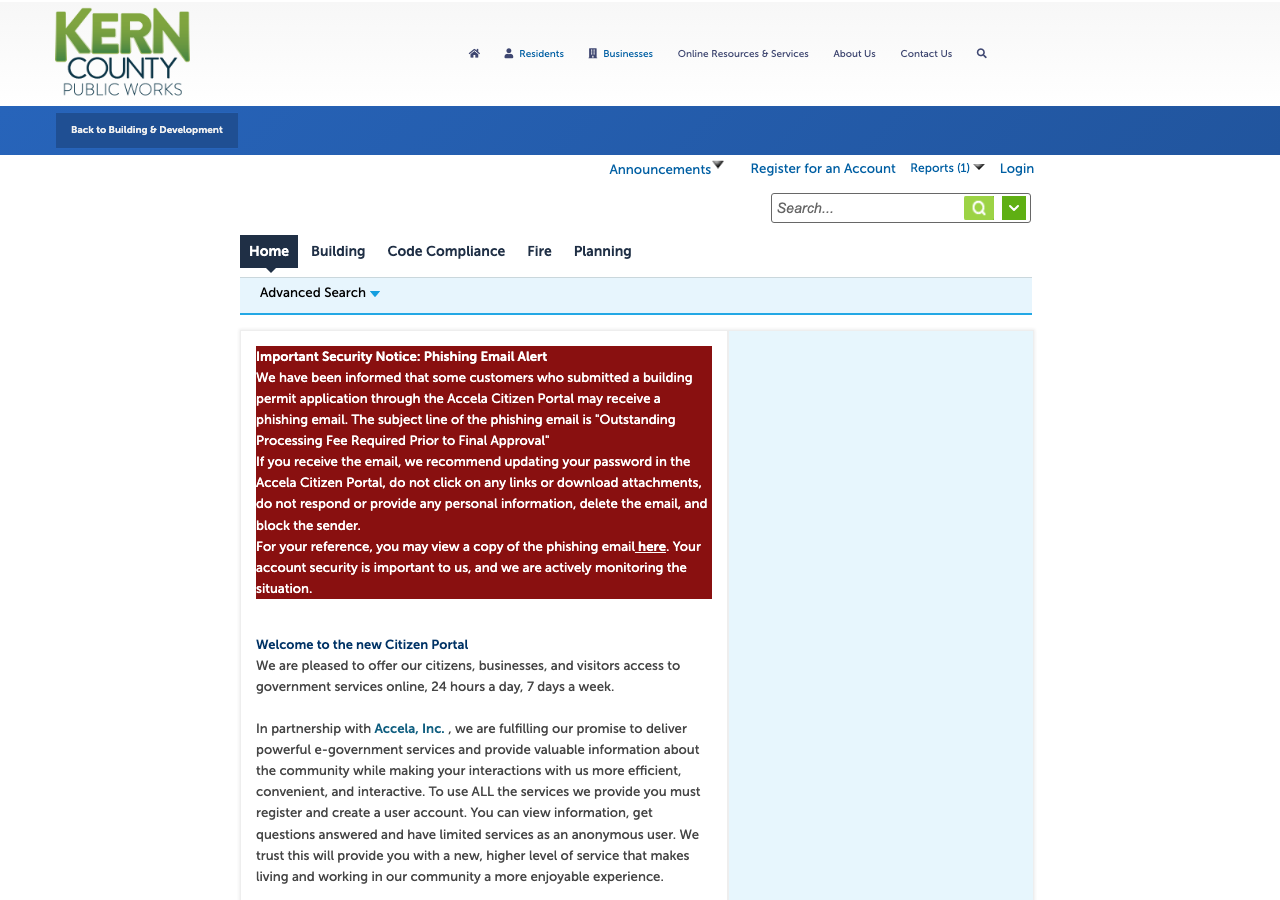

Accela Citizen Access — https://accela.kerncounty.com/CitizenAccess (branded 'Citizen Portal'), with ePlanSoft ePlanCheck behind it for electronic plan review. For eligible retrofit rooftop PV, NREL SolarAPP+ (gosolarapp.org) does the automated plan review and the approval documents are then uploaded into Accela.
Why the confidence is not higherBoth named on the county's own Building Inspection, Electronic Document Review and SolarAPP+ pages; portal fetched live on 28 Aug 2026 and returns the Kern County Citizen Access login. Not 95+ only because the county is described as 'transitioning to' electronic review.
portal / department page checked 2026-08-28 https://www.kernpublicworks.com/services/development/building-inspection/electronic-document-review
Q21 Can the whole application be completed online? Core Portal & process
Yes — 'You can now complete your entire permit process online, from application, to review, pay fees, and schedule inspections.'
Why the confidence is not higherVerbatim from the county's Electronic Document Review page. Held below 95 because the same page says the division is 'transitioning to' electronic review and the 'Complete Electronic Submittal Guide' is still marked 'coming soon'.
department page checked 2026-08-28 https://www.kernpublicworks.com/services/development/building-inspection/electronic-document-review
Q22 Which utility handles interconnection here? Core Utility interconnection
Split by address. Pacific Gas & Electric serves western and central Kern (its own tariff service-area map lists Arvin, Bakersfield, Buttonwillow, Edison, Fellows, Lamont, Lost Hills, Maricopa, McFarland, McKittrick, Shafter, Taft, Tehachapi, Tupman, Wasco). Southern California Edison serves portions of Kern County including Ridgecrest, California City, Tehachapi, Delano and McFarland. The utility must be confirmed per address.
Why the confidence is not higherSourced from each utility's own document: PG&E's CPUC tariff Electric Service Area Map (Sheet 34575-E) and SCE's own 'Southern California Edison's Service Area' sheet (updated 3/17/2025) which lists Kern among the 15 counties served. Held at 72 because the PG&E map is effective December 2014 and both utilities list Tehachapi, McFarland and Delano — i.e. the boundary genuinely interleaves and neither document resolves it at parcel level.
utility tariff service-area map + SCE service-area sheet checked 2026-08-28 https://www.pge.com/tariffs/assets/pdf/tariffbook/ELEC_MAPS_Service%20Area%20Map.pdf
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Parallel for the application, but the utility is strictly last for energization. Kern County Code 17.57.040(E): county approval 'does not authorize an applicant to connect the small residential rooftop energy system to the local utility provider's electricity grid. The applicant is responsible for obtaining such approval or permission from the local utility provider.' And 17.24.190(B): 'No utility or service agency shall supply electrical energy ... to a wiring system which has not been inspected and approved.'
Why the confidence is not higherTwo provisions of the county's own current code read together: interconnection application runs in parallel with permitting, but PTO cannot precede the county's final electrical inspection. Not higher because neither section states a sequencing rule in those words — it is the combined effect.
ordinance ch. 17.57 + ch. 17.24 checked 2026-08-28 https://library.municode.com/ca/kern_county/codes/code_of_ordinances?nodeId=TIT17BUCO_CH17.57SMREROSOENSYREPR
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No — no HOA or architectural approval is required by the county before permitting. Chapter 17.57.040 lists every applicant pre-condition and none of them is third-party approval; the building official 'shall administratively approve the application' once the checklist is met.
Why the confidence is not higherThis is a proved absence in the two places it would appear (ch. 17.57 and the expedited solar checklist), not a positive statement. Kept below 60 because private CC&Rs may still exist as a civil matter (constrained by Civil Code § 714) and the county would have no reason to mention them.
ordinance ch. 17.57 checked 2026-08-28 https://library.municode.com/ca/kern_county/codes/code_of_ordinances?nodeId=TIT17BUCO_CH17.57SMREROSOENSYREPR
Q25 Is there a historic-district review? Overlays & special cases
No — the Kern County Zoning Ordinance has no historic-preservation or historic-district combining district. The combining districts are LS, PD, CL, RS, RL, MH, WE (wind energy), PE, GH, FP, FPS, KRC (Kern River Corridor), SC (scenic corridor) and H (airport approach height).
Why the confidence is not higherAbsence proved by reading the full list of zone and combining districts (ch. 19.10 through 19.78) in the county's current Zoning Ordinance PDF and by a full-text search for 'historic' across all 638 pages — the only hits are flood-history and landscape-exemption references, not a review process. Search validated in the same run: control term 'electrical' returned 105 hits, fabricated term 'zzqqx' returned 0. Held at 75 because the Scenic Corridor (SC) combining district could impose design review in specific corridors.
zoning ordinance checked 2026-08-28 https://psbweb.co.kern.ca.us/planning/pdfs/KCZOFeb2026.pdf
Q26 Is a wind or windstorm certification required? Overlays & special cases
No separate wind/windstorm certification. But Kern County has adopted its own local design wind speed map — Chapter 16 Figure 1609D, 'Kern County Ultimate Design Wind Speed', and CRC Figure R301.2(5)A.1 — and the prescriptive solar anchor table only applies where the dwelling is in Exposure B with design wind speed 115–130 mph in a Special Wind Region, or Exposure C at ≤110 mph and not on the top half of a tall hill. Outside those envelopes an engineered design is required.
Why the confidence is not higherLocal wind figure confirmed in the 2025 Code of Building Regulations (17.08.420/17.08.430); the exposure conditions are quoted from Table 1 Note 4 of the county's structural criteria form. Not a 'certification' in the Texas TDI sense, hence the framing. Held at 80 because the structural form is revision-dated 9/24/2024, against the 2022 cycle.
Code of Building Regulations ch. 17.08 + structural criteria form checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Rarely, but yes in two circumstances. (a) Kern County Code 17.57.040(C): the building official 'shall require a use permit if he/she makes a finding, based on substantial evidence, that the solar energy system could have specific, adverse impact upon the public health and safety' — that decision is appealable to the Planning Commission, and a use permit so required 'may not be denied unless written findings are made based upon substantial evidence'. (b) Zoning: solar generators that are NOT accessory to a permitted use, or that exceed on-site demand, fall outside the by-right listing and require a conditional use permit.
Why the confidence is not higher(a) quoted verbatim from ch. 17.57.040(C)–(D) on Municode; (b) read from the by-right use lists in the residential and agricultural districts of the current zoning ordinance. Not higher because the zoning limb is inferred from what the by-right lists exclude rather than from an express CUP clause for household PV.
ordinance ch. 17.57 + zoning ordinance checked 2026-08-28 https://library.municode.com/ca/kern_county/codes/code_of_ordinances?nodeId=TIT17BUCO_CH17.57SMREROSOENSYREPR
Q28 Is there a system-size cap on residential generation? Overlays & special cases
Three different caps operate. (1) Zoning: a solar energy electrical generator is permitted by right in the residential and agricultural districts where it is 'accessory to a permitted or conditionally permitted use and where the power generated does not exceed the total on-site power demand' — i.e. by-right generation is capped at on-site consumption. (2) Expedited permitting: ≤10 kW AC CEC rating (ch. 17.57 definition and the eligibility checklist). (3) SolarAPP+: no stated wattage cap, but max main service 400 A, service disconnect and busbar ≤225 A, max main breaker 200 A; the county's own expedited checklist additionally requires a 120/240 V single-phase service with bus rating ≤225 A and module Isc <13 A. Above these, the standard plan-review route applies.
Why the confidence is not higherAll three read from the authority's own sources (zoning ordinance use lists; ch. 17.57.020(B)(1); county SolarAPP+ page and expedited eligibility checklist). Held at 82 because the zoning phrase 'does not exceed the total on-site power demand' is not defined or given a measurement method anywhere I could find.
zoning ordinance + ordinance ch. 17.57 + SolarAPP+ page checked 2026-08-28 https://psbweb.co.kern.ca.us/planning/pdfs/KCZOFeb2026.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? NEC 2023, as adopted in California via the 2025 California Electrical Code (CCR Title 24 Part 3). Kern County Code 17.24.060: 'Title 24, Part 3 being that portion of the 2025 Edition of the California Electrical Code ... is adopted by this reference into the Kern County Electrical Code.' Effective 1 January 2026 (Ord. G-9359, 4 Nov 2025). 88% · adopting ordinance G-9359 / 2025 Code of Building Regulations
- Which building code edition is in force? 2025 California Building Code (CCR Title 24 Part 2) including Appendix Chapters C, I, P and Q; and 2025 California Residential Code (Part 2.5) including Appendix Chapters BB, BF, CI and CJ. Both effective 1 January 2026. Also adopted: 2025 CA Green Building Standards Code (without amendment), 2025 CA Mechanical, Plumbing, Energy and Existing Building Codes, and the 2024 International Property Maintenance Code. 94% · adopting ordinance G-9359
- Which fire code edition is in force? 2025 California Fire Code (CCR Title 24 Part 9), together with those portions of the 2024 International Fire Code including Appendices B, C, D and H not included in the California code, as amended — collectively the 'Kern County Fire Code'. Also adopted: 2025 California Wildland-Urban Interface Code (ch. 17.34, Title 24 Part 7). 94% · adopting ordinance ch. 17.32
- Are there local amendments to any of the above? Yes — but none of them is solar-specific. The only electrical amendment is 17.24.080: CEC 250-50 is amended so that 'On new construction, where reinforced concrete footings are placed, a grounding electrode complying with Article 250.52 (A)(3) shall be installed.' Building-code amendments of relevance to PV are structural/climatic: Section 1609.3 ultimate design wind speed and new Chapter 16 Figure 1609D 'Kern County Ultimate Design Wind Speed', Section 1608.2 ground snow loads, and CRC R301.2 climatic and geographic design criteria. Fire-code amendments add local ESS permit requirements (105.5.6 operational, 105.6.8 construction) and a 2-working-day inspection notice rule (109.2.1). A full-text search of the 173-page adopting ordinance found no amendment to CBC/CRC/CFC solar sections. 88% · adopting ordinance G-9359
- What is the installation judged against? The Kern County Code of Building Regulations (Ordinance Code Title 17) — i.e. the 2025 California Building, Residential, Electrical, Mechanical, Plumbing, Energy, Green Building, Fire and Wildland-Urban Interface Codes as locally modified, effective 1 January 2026 — plus, for the plan set, the county's own expedited-solar eligibility and structural criteria checklists, and for fire aspects Kern County Fire Department Fire Prevention Standards. 90% · adopting ordinance ch. 17.04
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Residential (from the county's own eligibility checklist): access pathways at least 3 feet wide on gable roofs from eave to ridge; panels at least 18 inches from a hip or valley where located on both sides of that hip or valley; a minimum of 3 feet between the ridge and the panels for smoke ventilation; and no conductors within that 3-foot ridge area. Panel fire classification must be provided and meet the rating required for the structure. Commercial (Kern County Fire Department Standard 1204-1): 6 ft perimeter clearance including from all ridge lines, reducible to 4 ft where the longest roof axis is under 250 ft; 4 ft pathways from parapets/roof edges and around hatches; arrays no greater than 150 ft x 150 ft; interior 4 ft pathways every 150 ft; 8 ft pathway on all sides of smoke/heat vents (4 ft on at least one side for gravity-operated dropout vents). 80% · fire department standard + county eligibility checklist
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes — via the adopted code, not a local rule. Kern has adopted the 2025 California Electrical Code (NEC 2023 base) unamended except for grounding electrodes, so NEC/CEC 690.12 rapid shutdown applies. Kern County Fire Department Standard 1204-1 independently requires that rapid-shutdown PV systems be labelled per CFC 1204.5.1, that a diagram be provided with sections in red identifying areas of the PV system that do not shut down when the rapid shutdown switch is operated (CFC 1204.5.1.1), and that a label be provided within 3 feet of the rapid shutdown switch (CFC 1204.5.3). 80% · fire department standard + adopting ordinance
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Kern County does not publish its own placard list. What is required at/near the service equipment comes from three places: (1) the adopted 2025 CEC — the standard PV marking set at the service equipment; (2) KCFD Standard 1204-1 — rapid shutdown labelling per CFC, a rapid-shutdown diagram with non-de-energised sections shown in red, and a label within 3 feet of the rapid shutdown switch; (3) the serving utility — in PG&E territory a permanently attached sign on the front of the AC disconnect reading e.g. 'UTILITY AC DISCONNECT SWITCH', plus proper labelling of any Net Generation Output Meter. The county's own contribution is procedural: the plan set must include 'a sheet showing the location and verbiage of the required labels'. 62% · county eligibility checklist + fire department standard + utility greenbook
- Does the authority specify placard wording of its own? No — Kern County specifies no placard wording of its own. It requires the plan set to include 'a sheet showing the location and verbiage of the required labels' (i.e. the applicant states the wording, drawn from the adopted codes), and the fire department standard points to CFC sections rather than prescribing text. 72% · county eligibility checklist (proved absence)
- Does it specify letter height, colour or material? Not by the AHJ. Kern County specifies no letter height, colour or material. The serving utility does: in PG&E territory, 'Labels shall be permanent and suitable for the environment and shall be engraved phenolic or comply with ANSI Z535.4. Lettering shall be a minimum 3/8" high and in all capitals.' 78% · utility greenbook (PG&E doc 060559 Rev. 07)
- Is a site plan / facility map placard required, and what must it show? No AHJ-required site-plan placard. Two adjacent requirements do exist: (a) the county requires the plan set to carry a sheet showing the location and verbiage of the required labels, and the plot/roof plan must dimension ridge, valley and eave setbacks and legend every vent, B-vent, fireplace, cupola and dormer; (b) PG&E requires an actual on-site map placard — 'When the disconnect switch is not grouped with the meter panel provide a map showing the location', and the same for a Net Generation Output Meter if not grouped with the other meters and disconnect. Beyond that, the CEC 705.10 directory requirement applies through the adopted code. 65% · utility greenbook + county checklist
- Does the UTILITY specify placards beyond the AHJ's? Yes, in PG&E territory. PG&E Greenbook 060559 requires: 'Permanently attached signage on the front that explains this is the ac disconnect switch for the generation. Example: "UTILITY AC DISCONNECT SWITCH"'; labels permanent, environment-suitable, engraved phenolic or ANSI Z535.4 compliant, minimum 3/8" lettering in all capitals; a map showing location where the disconnect is not grouped with the meter panel; proper NGOM labelling plus a location map if not grouped; and where the disconnect is not accessible outside locked premises, signs with contact information plus a provider-approved locking device. The switch itself must carry marking clearly indicating open (off) and closed (on) positions. SCE's equivalent requirements were not obtained in this run. 85% · utility DG manual / greenbook
- Where must the labels be placed? Kern County itself does not specify label placement — only that placement be shown on the plans. Placement rules come from the fire department standard (a label within 3 feet of the rapid shutdown switch; the rapid-shutdown diagram at the labelled location) and from PG&E (signage on the front of the AC disconnect enclosure; a location map at the meter panel where the disconnect is not grouped with it). 65% · fire department standard + utility greenbook
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? PG&E territory: the disconnect must be installed between the PG&E meter and all generation sources; 'physically located for ease of access and visible to PG&E employees within 10 feet of the meter', 'in close proximity, or within line of sight, of the meter'; at the same grade level if outdoors with the meter; NOT allowed on any floor or level above grade, on a roof, or in a room that is not an approved electric meter room; mounted between 48" minimum and 75" maximum from ground to top of enclosure; lockable open with a PG&E padlock (5/16" shaft, keyed locks not allowed); visible air-gap open; manually and gang-operated; molded-case breakers and pull-out disconnects are NOT acceptable. Exemption: inverter-based systems on PG&E single-phase services up to 240 V may be exempted where the meter panel is self-contained, socket-based (form 'S'), rated CL 320 or less, and 120/240 V or 120/208 V single-phase. SCE requirements were not obtained in this run. 85% · utility DG manual / greenbook
- Must equipment be on a specific approved list? Effectively yes. The county's expedited checklist requires 'Make, model and collector certification number' and a 'System certification number' on the plans, and the panel fire classification must be provided and meet the rating required for the structure. On the SolarAPP+ route, compliance calculations are run 'based on contractor equipment selections and CEC Database of Approved Equipment list data', so equipment absent from the CEC list cannot be approved. 68% · SolarAPP+ page + county eligibility checklist
- Are batteries permitted, and under what conditions? Yes, permitted, but not on the county's expedited paper route. The expedited checklist requires that 'The solar system is utility interactive and without battery storage' and that the 'System does not utilize storage batteries, charge controllers or trackers' — a battery answers NO and forces standard plan review. Batteries ARE supported through SolarAPP+ (PV+Storage eligibility checklist; $25 storage add-on fee). Substantively they are governed by the adopted 2025 CRC (R202 ESS definitions, R330.4 ESS locations) and the 2025 California Fire Code as locally amended, and, where the dwelling is in a Fire Hazard Severity Zone, the 2025 California Wildland-Urban Interface Code (ch. 17.34) also applies. 82% · county eligibility checklist + SolarAPP+ page + adopting ordinance
- Is there a separate ESS permit or inspection? Yes — a fire construction permit. Kern County Fire Code 105.6.8 as amended: 'A construction permit is required to install, alter or modify an energy storage system regulated by this code.' Kern County Fire Code 105.5.6 additionally requires an operational permit 'for stationary and mobile energy storage systems regulated by Section 1207'. Maintenance is not a modification and needs no permit. 85% · adopting ordinance ch. 17.32
- Is a ground mount treated as a structure? Yes — a ground mount requires a building permit and goes through standard plan review, not the fast track. It is not on the county's list of work exempt from permit (CRC R105.2 as locally amended, which Kern amends only for retaining walls), ch. 17.57's expedited route is confined to roof-mounted systems on a single or duplex dwelling, and the county's SolarAPP+ page states plainly that SolarAPP+ 'is currently not able to be used for ... ground mounted' projects. Zoning treats it as a use: permitted by right where accessory to a permitted use and not exceeding total on-site power demand. 72% · SolarAPP+ page + exempt-work handout + zoning ordinance
- Is there a local rule on service upgrades or busbar sizing? Yes, on the expedited/SolarAPP+ routes. County expedited checklist: 'The PV system is interconnected to a single-phase AC service panel of nominal 120/220 VAC system with a bus rating of 225 amps or less'; the applicant must state existing service size (100/125/200 A or other) and the new size if the service is being upgraded; and 'for projects with less than a 200 amp main, if there is a pool or other electrical demands other than the residence, please provide electrical load calculations'. SolarAPP+ limits: max main service rating 400 A, service disconnects and busbars ≤225 A, max main breaker 200 A. Exceeding these pushes the job to standard plan review, not to refusal. 82% · published eligibility checklist + SolarAPP+ page
- Is a specific mounting system or attachment spacing required? Yes — prescriptive anchor spacing, in the county's 'Structural Criteria for Residential Roof-Mounted Solar Arrays' Table 1 (maximum horizontal anchor spacing). PV arrays (≤4 psf): flat to 6:12 slope — 5'-4" at 16" o.c. rafters, 6'-0" at 24" o.c., 5'-4" at 32" o.c.; 7:12 to 24:12 — 1'-4", 2'-0", 2'-8" respectively. Solar thermal (≤5 psf): flat to 6:12 — 4'-0"/4'-0"/5'-4"; 7:12 to 12:12 — 1'-4"/2'-0"/2'-8"; 13:12 to 24:12 — calculation required. Staggered anchors may be spaced at twice these values but never more than 6'-0". For manufacturer-plated wood trusses at flat to 6:12, spacing shall not exceed 4'-0" and adjacent rows shall be staggered. Fastener: 5/16" lag screws with 2.5" embedment into the rafter, or per the manufacturer's guidelines. Standoff gap 2" to 10" between module underside and roof surface; modules parallel to the roof plane; no overhang of ridges, hips, gable ends or eaves. Assumes mean roof height ≤40 ft and sheathing at least 7/16" OSB/plywood (1x skip sheathing acceptable). 88% · published structural criteria form
20 questions answered against Kern County’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
NEC 2023, as adopted in California via the 2025 California Electrical Code (CCR Title 24 Part 3). Kern County Code 17.24.060: 'Title 24, Part 3 being that portion of the 2025 Edition of the California Electrical Code ... is adopted by this reference into the Kern County Electrical Code.' Effective 1 January 2026 (Ord. G-9359, 4 Nov 2025).
Why the confidence is not higherThe county's own adopting ordinance names the 2025 CEC edition explicitly and is dated 4 Nov 2025 with a 1 Jan 2026 effective date. Held at 88 rather than 95 because the ordinance names the California edition, not the NEC year — the 2023 NEC base is the standard CBSC mapping, not something Kern states.
adopting ordinance G-9359 / 2025 Code of Building Regulations checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (CCR Title 24 Part 2) including Appendix Chapters C, I, P and Q; and 2025 California Residential Code (Part 2.5) including Appendix Chapters BB, BF, CI and CJ. Both effective 1 January 2026. Also adopted: 2025 CA Green Building Standards Code (without amendment), 2025 CA Mechanical, Plumbing, Energy and Existing Building Codes, and the 2024 International Property Maintenance Code.
Why the confidence is not higherQuoted verbatim from the county's own 2025 Code of Building Regulations, sections 17.06.030 and 17.08.030, which state 'All Chapters adopted by Ordinance G-9359 (11/4/2025) effective January 1, 2026.' Corroborated by the county's Bulletins page: 'The 2025 Building Code Forms are required for building permit applications submitted on or after January 1, 2026.'
adopting ordinance G-9359 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (CCR Title 24 Part 9), together with those portions of the 2024 International Fire Code including Appendices B, C, D and H not included in the California code, as amended — collectively the 'Kern County Fire Code'. Also adopted: 2025 California Wildland-Urban Interface Code (ch. 17.34, Title 24 Part 7).
Why the confidence is not higherQuoted verbatim from Kern County Code 17.32.001 in the current 2025 Code of Building Regulations. Note the WUI adoption matters in Kern: local and state Fire Hazard Severity Zones changed in this cycle and the county's own code-change briefing points installers at Kern County GIS to check the zone.
adopting ordinance ch. 17.32 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes — but none of them is solar-specific. The only electrical amendment is 17.24.080: CEC 250-50 is amended so that 'On new construction, where reinforced concrete footings are placed, a grounding electrode complying with Article 250.52 (A)(3) shall be installed.' Building-code amendments of relevance to PV are structural/climatic: Section 1609.3 ultimate design wind speed and new Chapter 16 Figure 1609D 'Kern County Ultimate Design Wind Speed', Section 1608.2 ground snow loads, and CRC R301.2 climatic and geographic design criteria. Fire-code amendments add local ESS permit requirements (105.5.6 operational, 105.6.8 construction) and a 2-working-day inspection notice rule (109.2.1). A full-text search of the 173-page adopting ordinance found no amendment to CBC/CRC/CFC solar sections.
Why the confidence is not higherRead from the county's own 173-page 2025 Code of Building Regulations extracted with pdftotext -layout. Absence of solar amendments proved by full-text search for solar/photovoltaic/rooftop/R329/rapid shutdown across the whole document; search validated in the same run with a positive control ('electrical' = 117 hits) and a fabricated control ('zzqqx' = 0 hits).
adopting ordinance G-9359 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q33 What is the installation judged against? Core Electrical
The Kern County Code of Building Regulations (Ordinance Code Title 17) — i.e. the 2025 California Building, Residential, Electrical, Mechanical, Plumbing, Energy, Green Building, Fire and Wildland-Urban Interface Codes as locally modified, effective 1 January 2026 — plus, for the plan set, the county's own expedited-solar eligibility and structural criteria checklists, and for fire aspects Kern County Fire Department Fire Prevention Standards.
Why the confidence is not higherDirect from 17.04.020 of the current adopting ordinance, which enumerates Title 24 Parts 1–12 as adopted with local modifications 'determined reasonably necessary because of local climatic, geological, or topographical conditions'. Held at 90 because the field standard also includes the SolarAPP+ inspection checklist on that route, which is NREL's document, not the county's.
adopting ordinance ch. 17.04 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Yes, on the expedited/SolarAPP+ routes. County expedited checklist: 'The PV system is interconnected to a single-phase AC service panel of nominal 120/220 VAC system with a bus rating of 225 amps or less'; the applicant must state existing service size (100/125/200 A or other) and the new size if the service is being upgraded; and 'for projects with less than a 200 amp main, if there is a pool or other electrical demands other than the residence, please provide electrical load calculations'. SolarAPP+ limits: max main service rating 400 A, service disconnects and busbars ≤225 A, max main breaker 200 A. Exceeding these pushes the job to standard plan review, not to refusal.
Why the confidence is not higherBoth sets of figures come from the county's own documents (expedited eligibility checklist; SolarAPP+ page FAQ). Held at 82 because these are eligibility thresholds for a fast track rather than a substantive local busbar rule, and the checklist is revision-dated 9/24/2024.
published eligibility checklist + SolarAPP+ page checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Yes — prescriptive anchor spacing, in the county's 'Structural Criteria for Residential Roof-Mounted Solar Arrays' Table 1 (maximum horizontal anchor spacing). PV arrays (≤4 psf): flat to 6:12 slope — 5'-4" at 16" o.c. rafters, 6'-0" at 24" o.c., 5'-4" at 32" o.c.; 7:12 to 24:12 — 1'-4", 2'-0", 2'-8" respectively. Solar thermal (≤5 psf): flat to 6:12 — 4'-0"/4'-0"/5'-4"; 7:12 to 12:12 — 1'-4"/2'-0"/2'-8"; 13:12 to 24:12 — calculation required. Staggered anchors may be spaced at twice these values but never more than 6'-0". For manufacturer-plated wood trusses at flat to 6:12, spacing shall not exceed 4'-0" and adjacent rows shall be staggered. Fastener: 5/16" lag screws with 2.5" embedment into the rafter, or per the manufacturer's guidelines. Standoff gap 2" to 10" between module underside and roof surface; modules parallel to the roof plane; no overhang of ridges, hips, gable ends or eaves. Assumes mean roof height ≤40 ft and sheathing at least 7/16" OSB/plywood (1x skip sheathing acceptable).
Why the confidence is not higherEvery figure read out of the county's own PDF table with pdftotext -layout. Held at 88 because the form is revision-dated 9/24/2024 (2022 cycle) and refers installers to the 4th edition (2019) California Solar Permitting Guidebook.
published structural criteria form checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Residential (from the county's own eligibility checklist): access pathways at least 3 feet wide on gable roofs from eave to ridge; panels at least 18 inches from a hip or valley where located on both sides of that hip or valley; a minimum of 3 feet between the ridge and the panels for smoke ventilation; and no conductors within that 3-foot ridge area. Panel fire classification must be provided and meet the rating required for the structure. Commercial (Kern County Fire Department Standard 1204-1): 6 ft perimeter clearance including from all ridge lines, reducible to 4 ft where the longest roof axis is under 250 ft; 4 ft pathways from parapets/roof edges and around hatches; arrays no greater than 150 ft x 150 ft; interior 4 ft pathways every 150 ft; 8 ft pathway on all sides of smoke/heat vents (4 ft on at least one side for gravity-operated dropout vents).
Why the confidence is not higherResidential figures verbatim from the county's expedited eligibility checklist. Commercial figures verbatim from KCFD Fire Prevention Standard 1204-1 'Solar Panels (Roof Mounted)'. Held at 80 because KCFD 1204-1 is dated 10 June 2021, states it is promulgated under the 2022 CFC, and its only substantive section is headed 'Commercial Roof Installations' — the fire department has published no residential roof-solar standard, and neither document has been reissued for the 2025 CFC (where the solar sections renumber from 1204 to 1205).
fire department standard + county eligibility checklist checked 2026-08-28 https://kerncountyfire.org/wp-content/uploads/SolarPanelsRoofMounted.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes — via the adopted code, not a local rule. Kern has adopted the 2025 California Electrical Code (NEC 2023 base) unamended except for grounding electrodes, so NEC/CEC 690.12 rapid shutdown applies. Kern County Fire Department Standard 1204-1 independently requires that rapid-shutdown PV systems be labelled per CFC 1204.5.1, that a diagram be provided with sections in red identifying areas of the PV system that do not shut down when the rapid shutdown switch is operated (CFC 1204.5.1.1), and that a label be provided within 3 feet of the rapid shutdown switch (CFC 1204.5.3).
Why the confidence is not higherRapid shutdown is not named in any Kern County ordinance — the answer is inferred from the adopted 2025 CEC plus the fire department's own standard, which does name the requirement and its labelling. Held at 80 because KCFD 1204-1 cites 2022-cycle CFC section numbers (1204.x) that renumber to 1205.x under the 2025 CFC now in force, and because its operative text addresses commercial roofs.
fire department standard + adopting ordinance checked 2026-08-28 https://kerncountyfire.org/wp-content/uploads/SolarPanelsRoofMounted.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Kern County does not publish its own placard list. What is required at/near the service equipment comes from three places: (1) the adopted 2025 CEC — the standard PV marking set at the service equipment; (2) KCFD Standard 1204-1 — rapid shutdown labelling per CFC, a rapid-shutdown diagram with non-de-energised sections shown in red, and a label within 3 feet of the rapid shutdown switch; (3) the serving utility — in PG&E territory a permanently attached sign on the front of the AC disconnect reading e.g. 'UTILITY AC DISCONNECT SWITCH', plus proper labelling of any Net Generation Output Meter. The county's own contribution is procedural: the plan set must include 'a sheet showing the location and verbiage of the required labels'.
Why the confidence is not higherAssembled from three of the authority's/utility's own documents rather than from one county placard specification, which does not exist. Held at 62 because KCFD 1204-1's requirements are written under 'Commercial Roof Installations' and against the 2022 CFC, so their application to a one- or two-family dwelling in 2026 is an inference.
county eligibility checklist + fire department standard + utility greenbook checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No — Kern County specifies no placard wording of its own. It requires the plan set to include 'a sheet showing the location and verbiage of the required labels' (i.e. the applicant states the wording, drawn from the adopted codes), and the fire department standard points to CFC sections rather than prescribing text.
Why the confidence is not higherProved absence: searched the whole 173-page 2025 Code of Building Regulations for placard/label/sign provisions (controls in the same run: 'electrical' 117 hits, 'zzqqx' 0 hits), read the expedited solar submittal and structural forms end to end, read both KCFD solar standards, and walked all six Bulletins/Documents/Forms sub-folders. No county-authored placard wording exists in any of them.
county eligibility checklist (proved absence) checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Not by the AHJ. Kern County specifies no letter height, colour or material. The serving utility does: in PG&E territory, 'Labels shall be permanent and suitable for the environment and shall be engraved phenolic or comply with ANSI Z535.4. Lettering shall be a minimum 3/8" high and in all capitals.'
Why the confidence is not higherCounty side is a proved absence across its code, forms library and fire standards (same search controls as Q39). Utility side is verbatim from PG&E Greenbook document 060559 Rev. #07, dated 3/25/2022. Held at 78 because the PG&E document is four years old and applies only to the PG&E half of the county — SCE's requirements were not obtained in this run.
utility greenbook (PG&E doc 060559 Rev. 07) checked 2026-08-28 https://www.pge.com/content/dam/pge/docs/about/doing-business-with-pge/060559.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
No AHJ-required site-plan placard. Two adjacent requirements do exist: (a) the county requires the plan set to carry a sheet showing the location and verbiage of the required labels, and the plot/roof plan must dimension ridge, valley and eave setbacks and legend every vent, B-vent, fireplace, cupola and dormer; (b) PG&E requires an actual on-site map placard — 'When the disconnect switch is not grouped with the meter panel provide a map showing the location', and the same for a Net Generation Output Meter if not grouped with the other meters and disconnect. Beyond that, the CEC 705.10 directory requirement applies through the adopted code.
Why the confidence is not higher(a) and (b) are verbatim from the county checklist and the PG&E Greenbook respectively. Held at 65 because the question asks for an AHJ facility-map placard and Kern does not impose one — the positive answer here is the utility's, and only in PG&E territory.
utility greenbook + county checklist checked 2026-08-28 https://www.pge.com/content/dam/pge/docs/about/doing-business-with-pge/060559.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes, in PG&E territory. PG&E Greenbook 060559 requires: 'Permanently attached signage on the front that explains this is the ac disconnect switch for the generation. Example: "UTILITY AC DISCONNECT SWITCH"'; labels permanent, environment-suitable, engraved phenolic or ANSI Z535.4 compliant, minimum 3/8" lettering in all capitals; a map showing location where the disconnect is not grouped with the meter panel; proper NGOM labelling plus a location map if not grouped; and where the disconnect is not accessible outside locked premises, signs with contact information plus a provider-approved locking device. The switch itself must carry marking clearly indicating open (off) and closed (on) positions. SCE's equivalent requirements were not obtained in this run.
Why the confidence is not higherVerbatim from PG&E's own Greenbook document 060559 Rev. #07 (approved 3/25/2022), which is also part of PG&E's Distribution Interconnection Handbook. Held at 85 because it is four years old and covers only the PG&E half of Kern County.
utility DG manual / greenbook checked 2026-08-28 https://www.pge.com/content/dam/pge/docs/about/doing-business-with-pge/060559.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
Kern County itself does not specify label placement — only that placement be shown on the plans. Placement rules come from the fire department standard (a label within 3 feet of the rapid shutdown switch; the rapid-shutdown diagram at the labelled location) and from PG&E (signage on the front of the AC disconnect enclosure; a location map at the meter panel where the disconnect is not grouped with it).
Why the confidence is not higherAssembled from KCFD Standard 1204-1 and PG&E Greenbook 060559 because the county publishes no placement rule of its own — that absence was proved by full-text search of the 2025 Code of Building Regulations and by reading the solar forms and the whole forms library. Held at 65 for the same 2022-CFC-numbering and commercial-scope caveats on the KCFD standard.
fire department standard + utility greenbook checked 2026-08-28 https://kerncountyfire.org/wp-content/uploads/SolarPanelsRoofMounted.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
Effectively yes. The county's expedited checklist requires 'Make, model and collector certification number' and a 'System certification number' on the plans, and the panel fire classification must be provided and meet the rating required for the structure. On the SolarAPP+ route, compliance calculations are run 'based on contractor equipment selections and CEC Database of Approved Equipment list data', so equipment absent from the CEC list cannot be approved.
Why the confidence is not higherBoth statements are from the authority's own documents, but neither is phrased as a standing 'approved list' requirement — the CEC-list dependency is a property of the SolarAPP+ engine described on the county's page, and the certification-number requirement is a plan-content rule.
SolarAPP+ page + county eligibility checklist checked 2026-08-28 https://www.kernpublicworks.com/services/development/building-inspection/solarapp-streamlined-permitting-process
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, permitted, but not on the county's expedited paper route. The expedited checklist requires that 'The solar system is utility interactive and without battery storage' and that the 'System does not utilize storage batteries, charge controllers or trackers' — a battery answers NO and forces standard plan review. Batteries ARE supported through SolarAPP+ (PV+Storage eligibility checklist; $25 storage add-on fee). Substantively they are governed by the adopted 2025 CRC (R202 ESS definitions, R330.4 ESS locations) and the 2025 California Fire Code as locally amended, and, where the dwelling is in a Fire Hazard Severity Zone, the 2025 California Wildland-Urban Interface Code (ch. 17.34) also applies.
Why the confidence is not higherExpedited exclusion and SolarAPP+ inclusion are both verbatim from county sources; the code basis is from the county's own adopting ordinance and its January 2026 code-change briefing. Held at 82 because Kern publishes no residential ESS bulletin of its own, so siting specifics fall back on the state code text.
county eligibility checklist + SolarAPP+ page + adopting ordinance checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10830/638730521337000000
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Yes — a fire construction permit. Kern County Fire Code 105.6.8 as amended: 'A construction permit is required to install, alter or modify an energy storage system regulated by this code.' Kern County Fire Code 105.5.6 additionally requires an operational permit 'for stationary and mobile energy storage systems regulated by Section 1207'. Maintenance is not a modification and needs no permit.
Why the confidence is not higherQuoted verbatim from the county's current 2025 Code of Building Regulations, ch. 17.32 fire code amendments. Held at 85 because the ordinance does not state a residential threshold, so whether a small household ESS is 'regulated by this code' for the operational-permit limb is a judgement the fire code official makes.
adopting ordinance ch. 17.32 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q47 Is a ground mount treated as a structure? Core Ground mount
Yes — a ground mount requires a building permit and goes through standard plan review, not the fast track. It is not on the county's list of work exempt from permit (CRC R105.2 as locally amended, which Kern amends only for retaining walls), ch. 17.57's expedited route is confined to roof-mounted systems on a single or duplex dwelling, and the county's SolarAPP+ page states plainly that SolarAPP+ 'is currently not able to be used for ... ground mounted' projects. Zoning treats it as a use: permitted by right where accessory to a permitted use and not exceeding total on-site power demand.
Why the confidence is not higherAssembled from three county sources, but each answers by exclusion rather than by saying 'a ground mount is a structure'. Kern publishes no residential ground-mount bulletin — the only KCFD ground-mount standard is expressly commercial (1 MW water-supply thresholds, 20 ft fire apparatus roads). Held at 72 for that reason.
SolarAPP+ page + exempt-work handout + zoning ordinance checked 2026-08-28 https://www.kernpublicworks.com/services/development/building-inspection/solarapp-streamlined-permitting-process
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
PG&E territory: the disconnect must be installed between the PG&E meter and all generation sources; 'physically located for ease of access and visible to PG&E employees within 10 feet of the meter', 'in close proximity, or within line of sight, of the meter'; at the same grade level if outdoors with the meter; NOT allowed on any floor or level above grade, on a roof, or in a room that is not an approved electric meter room; mounted between 48" minimum and 75" maximum from ground to top of enclosure; lockable open with a PG&E padlock (5/16" shaft, keyed locks not allowed); visible air-gap open; manually and gang-operated; molded-case breakers and pull-out disconnects are NOT acceptable. Exemption: inverter-based systems on PG&E single-phase services up to 240 V may be exempted where the meter panel is self-contained, socket-based (form 'S'), rated CL 320 or less, and 120/240 V or 120/208 V single-phase. SCE requirements were not obtained in this run.
Why the confidence is not higherVerbatim from PG&E Greenbook document 060559 Rev. #07, approved 3/25/2022, which is also part of PG&E's Distribution Interconnection Handbook. Held at 85 because it is four years old and applies only to the PG&E-served part of Kern County.
utility DG manual / greenbook checked 2026-08-28 https://www.pge.com/content/dam/pge/docs/about/doing-business-with-pge/060559.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal or Phone. 'It is your responsibility to call the Building Inspection Department to schedule inspections. Inspections can be scheduled by phoning the number listed on your Job Card. Alternatively, you may schedule inspections online through the Citizen Access Portal.' The published inspection-request line is (661) 862-8681 (same number for after-hours requests). Online scheduling requires a registered, logged-in Accela account — anonymous permit lookup cannot schedule. 88% · department process guide + department pages
- How much notice is required? Effectively same-day if booked before 8:00 AM: 'Same-day inspections are available if you schedule your inspection prior to 8 A.M.' No minimum lead time is published for building inspections. (The fire code, Kern County Fire Code 109.2.1 as amended, separately requires fire inspection requests to be filed 'not less than two working days before such inspection is desired'.) 82% · department process guide
- Are same-day or AM/PM windows offered? Same-day yes, if scheduled before 8:00 AM. No AM/PM windows are published. Instead the county publishes a 'Field Inspection Days' table assigning each community a set of weekdays — Bakersfield, Arvin, Delano, Lamont, Shafter, Wasco, Maricopa, Taft, Hartflat, Keene, Tehachapi, California City, Mojave, Rosamond and Fremont Valley are covered Monday–Friday; Ridgecrest Monday–Thursday; the Kern River Valley communities (Lake Isabella, Bodfish, Kernville, Wofford Heights, Weldon, Onyx, South Lake, Mt Mesa, Squirrel Valley, Alta Sierra, Canebrake, Havilah, Walker Basin, Twin Oaks, Caliente) and the Frazier Park/Lebec/Pine Mtn Club area Monday, Wednesday and Friday; Glennville, Granite Station, Woody, Boron and North Edwards Tuesday and Thursday only. 70% · department inspection schedule (dated 5/2/2022)
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes — Kern County Building Inspection Division performs its own final inspection, including on SolarAPP+ jobs ('Once the system is approved, Kern County inspectors will verify the installation's quality, adherence to the design, and compliance with safety standards during the inspection phase'). Ch. 17.57.040(F) contemplates that the single inspection 'may include a consolidated inspection by the building official and fire chief'. 90% · department page + ordinance ch. 17.57
- If delegated, to whom? Not delegated — no third-party or utility inspector is used for residential rooftop PV 85% · ordinance ch. 17.57 (proved absence)
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? One. Kern County Code 17.57.040(F): 'In most cases, for a small residential rooftop solar energy system to be eligible for expedited review, only one (1) inspection shall be required, which shall be done in a timely manner and may include a consolidated inspection by the building official and fire chief. If a small residential rooftop solar energy system fails an inspection, subsequent inspection(s) shall be authorized; however the subsequent inspection(s) need not conform to the requirements of this chapter.' The county's certification form spells out the trade-off: 'California Law only allows one site inspection ... Based on this limitation, some or all of the framing and most, if not all, of the anchors will not be visible to the inspector.' Outside the expedited route, the required inspections are those printed on the Job Card, which 'lists all required inspections and serves as a checklist'. 90% · ordinance ch. 17.57 + certification form
- Is a rough-in or mid-roof inspection required? No for eligible small residential rooftop solar — the AB 2188 one-inspection rule replaces it, provided the contractor signs the county's certification form. If the contractor declines to certify, 'the building inspector must have access to perform adequate inspections of random anchors, flashing, grounding, etc.', and if the work is not accessible and fails, 'subsequent inspections need not adhere to the one-inspection requirement'. 85% · county certification form
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Split answer. SolarAPP+ route: yes — an inspection checklist is issued with the approval documents ('With the SolarAPP+ inspection checklist, you know exactly what will be looked at and verified during the inspection'), and it reaches the county with the approval. Standard route: no county-published solar inspection checklist. What the county publishes for solar is a submittal/eligibility checklist and a structural criteria form, not an inspection checklist; the required inspections are listed on the Job Card issued with the permit. 78% · department document library (proved absence) + SolarAPP+ page
- What must be on site at inspection? The inspection record card (Job Card) and the approved plans, kept available until final approval — Kern County Code R109.3.1 as added: 'Work requiring a permit shall not be commenced until the permit holder ... shall have posted or otherwise made available an inspection record card ... The card and approved plans shall be maintained available by the permit holder until final approval has been granted by the building official.' For rooftop solar, also the signed 'Small Residential Rooftop Solar Energy Systems Certification Form' — 'Please leave this signed Certification Form with the job card.' And at final, the smoke alarm and carbon monoxide alarm certification form: 'The certification form for smoke alarms and carbon monoxide alarms will be required at the time of final inspection.' On the SolarAPP+ route, the SolarAPP+ approval documents and inspection checklist as well. 88% · adopting ordinance 17.06.080 + certification form + eligibility checklist
- Does the inspector verify labels and listings? Yes. On the SolarAPP+ route the county states that 'SolarAPP+ approval document items require the inspector to verify the values on the checklist' and that 'inspectors also verify that the work complies with UL standards, manufacturer's instructions, and municipal requirements', as well as verifying emergency access pathways and fire setbacks; conduit fill must be evaluated in the field. On the standard route, the plan set must carry a sheet showing the location and verbiage of the required labels, which the inspector then checks against the approved plans. 75% · department page
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final. 'After all required inspections have been completed and approved, your permit is considered "finaled"' — the sign-off is recorded on the Job Card/inspection record card. A Certificate of Occupancy is issued only 'if required by code'; Kern amends CRC R110.1 Exception 2 to exclude 'Nonbuilding structures', so a rooftop PV retrofit on an existing dwelling gets a permit final rather than a CO. No green tag or letter is described. 78% · department process guide + adopting ordinance 17.06.090
- Who notifies the utility for PTO? Installer (or customer) — the county does not notify the utility. Kern County Code 17.57.040(E) puts it on the applicant: county approval 'does not authorize an applicant to connect ... The applicant is responsible for obtaining such approval or permission from the local utility provider.' In PG&E territory the mechanism is that you or your contractor submit the final electric inspection clearance — 'a signed building or electrical permit, which also includes the Final Permit Cover for all associated NEM2 generation by the authority having jurisdiction (AHJ), such as a city or county building administration' — through PG&E's YourProjects portal (or NEMFollowups@pge.com for standard NEM under 30 kW solar / 10 kW storage; Rule21Gen@pge.com or your EGI representative for complex NEM). The submission must show the AHJ name, site/job address, description of work, permit number, APN, and the date the county inspector signed off. 85% · utility interconnection FAQ + ordinance ch. 17.57
- Is there a re-inspection fee? $23 per re-inspection for the second and subsequent re-inspection necessitated by faulty or incomplete work; payable before the next called inspection ('Re-inspection fees shall be paid prior to the next succeeding called inspection'). Treat the figure as indicative, not current. 52% · fee ordinance (2008, scanned; OCR-extracted)
- How are corrections issued and cleared? In writing, per department. 'If a department finds your submittal documents deficient in any way, the applicant will receive a written letter listing all deficiencies. Departmental letters (often referred to as "correction letters" or "compliance letters") will be sent to the applicant via email as each department completes their review. If no email is given, letters will be mailed to the applicant.' Clearing is the applicant's responsibility: 'it is the applicant's responsibility to resubmit or otherwise correct deficient documents and to provide a response to the departmental plan checker.' Each department clears its own review in the electronic permitting system and stamps the documents; the permit issues once all departments approve and remaining fees are paid. Resubmittals go through the Citizen Access portal (the county publishes a 'How to resubmit your plans' guide). Ch. 17.57.030 separately requires a written correction notice on an incomplete expedited-solar application. 85% · department process guide
14 questions answered against Kern County’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal or Phone. 'It is your responsibility to call the Building Inspection Department to schedule inspections. Inspections can be scheduled by phoning the number listed on your Job Card. Alternatively, you may schedule inspections online through the Citizen Access Portal.' The published inspection-request line is (661) 862-8681 (same number for after-hours requests). Online scheduling requires a registered, logged-in Accela account — anonymous permit lookup cannot schedule.
Why the confidence is not higherPhone/portal choice quoted verbatim from 'How a Permit becomes a Structure'; the (661) 862-8681 number and the registered-account restriction are from the Building Inspection contact block and the Check Your Permit Status page. Held at 88 because the process guide is undated on its face.
department process guide + department pages checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10712/638314119899930000
Q50 How much notice is required? Core Booking & scheduling
Effectively same-day if booked before 8:00 AM: 'Same-day inspections are available if you schedule your inspection prior to 8 A.M.' No minimum lead time is published for building inspections. (The fire code, Kern County Fire Code 109.2.1 as amended, separately requires fire inspection requests to be filed 'not less than two working days before such inspection is desired'.)
Why the confidence is not higherSame-day rule verbatim from the county's own process guide; the two-working-day rule is verbatim from the current adopting ordinance but applies to fire inspections, not to the building inspection a residential PV job normally gets. Held at 82 because no building-side minimum notice is stated anywhere I looked, so 'none published' is the honest reading rather than 'none exists'.
department process guide checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10712/638314119899930000
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Same-day yes, if scheduled before 8:00 AM. No AM/PM windows are published. Instead the county publishes a 'Field Inspection Days' table assigning each community a set of weekdays — Bakersfield, Arvin, Delano, Lamont, Shafter, Wasco, Maricopa, Taft, Hartflat, Keene, Tehachapi, California City, Mojave, Rosamond and Fremont Valley are covered Monday–Friday; Ridgecrest Monday–Thursday; the Kern River Valley communities (Lake Isabella, Bodfish, Kernville, Wofford Heights, Weldon, Onyx, South Lake, Mt Mesa, Squirrel Valley, Alta Sierra, Canebrake, Havilah, Walker Basin, Twin Oaks, Caliente) and the Frazier Park/Lebec/Pine Mtn Club area Monday, Wednesday and Friday; Glennville, Granite Station, Woody, Boron and North Edwards Tuesday and Thursday only.
Why the confidence is not higherThe day-by-community table is the county's own document, but it is stamped 'UPDATED 5/2/2022' — over four years old — and is the only scheduling-granularity document published. The absence of AM/PM windows is a proved absence across the Building Inspection pages and the forms library, not a stated policy.
department inspection schedule (dated 5/2/2022) checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10814/638315012325430000
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes — Kern County Building Inspection Division performs its own final inspection, including on SolarAPP+ jobs ('Once the system is approved, Kern County inspectors will verify the installation's quality, adherence to the design, and compliance with safety standards during the inspection phase'). Ch. 17.57.040(F) contemplates that the single inspection 'may include a consolidated inspection by the building official and fire chief'.
Why the confidence is not higherTwo of the authority's own current sources agree. Held at 90 because the fire-chief consolidation is permissive ('may'), so who actually attends a given residential job is not fixed in writing.
department page + ordinance ch. 17.57 checked 2026-08-28 https://www.kernpublicworks.com/services/development/building-inspection/solarapp-streamlined-permitting-process
Q53 If delegated, to whom? Core Who inspects
Not delegated — no third-party or utility inspector is used for residential rooftop PV
Why the confidence is not higherFollows from Q52 and from the absence of any delegation provision in ch. 17.57, ch. 17.24 Article IV (Inspection) or the 2025 Code of Building Regulations. The county does maintain an 'Approved Special Inspectors List' but that is CBC Chapter 17 special inspection for structural/commercial work, not solar finals.
ordinance ch. 17.57 (proved absence) checked 2026-08-28 https://library.municode.com/ca/kern_county/codes/code_of_ordinances?nodeId=TIT17BUCO_CH17.57SMREROSOENSYREPR
Q54 Which inspections are required, and in what order? Core Stages & sequence
One. Kern County Code 17.57.040(F): 'In most cases, for a small residential rooftop solar energy system to be eligible for expedited review, only one (1) inspection shall be required, which shall be done in a timely manner and may include a consolidated inspection by the building official and fire chief. If a small residential rooftop solar energy system fails an inspection, subsequent inspection(s) shall be authorized; however the subsequent inspection(s) need not conform to the requirements of this chapter.' The county's certification form spells out the trade-off: 'California Law only allows one site inspection ... Based on this limitation, some or all of the framing and most, if not all, of the anchors will not be visible to the inspector.' Outside the expedited route, the required inspections are those printed on the Job Card, which 'lists all required inspections and serves as a checklist'.
Why the confidence is not higherVerbatim from the current code on Municode and from the county's own Rooftop Solar Certification Form. Held at 90 because 'in most cases' leaves the building official discretion.
ordinance ch. 17.57 + certification form checked 2026-08-28 https://library.municode.com/ca/kern_county/codes/code_of_ordinances?nodeId=TIT17BUCO_CH17.57SMREROSOENSYREPR
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No for eligible small residential rooftop solar — the AB 2188 one-inspection rule replaces it, provided the contractor signs the county's certification form. If the contractor declines to certify, 'the building inspector must have access to perform adequate inspections of random anchors, flashing, grounding, etc.', and if the work is not accessible and fails, 'subsequent inspections need not adhere to the one-inspection requirement'.
Why the confidence is not higherQuoted from the county's Rooftop Solar Certification Form, which is the document that operates the exemption. Held at 85 because general electrical work in Kern does have a rough-wiring stage (17.24.210(C)–(D): fixtures shall not be connected 'until the rough wiring, including conductors, has been inspected', and grounding terminations 'shall be made up ... prior to rough electrical inspection'), so a service upgrade bundled with the PV job may still draw one.
county certification form checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10828/639228415025200000
Q56 Does the inspector verify labels and listings? Core What is checked
Yes. On the SolarAPP+ route the county states that 'SolarAPP+ approval document items require the inspector to verify the values on the checklist' and that 'inspectors also verify that the work complies with UL standards, manufacturer's instructions, and municipal requirements', as well as verifying emergency access pathways and fire setbacks; conduit fill must be evaluated in the field. On the standard route, the plan set must carry a sheet showing the location and verbiage of the required labels, which the inspector then checks against the approved plans.
Why the confidence is not higherThe first limb is verbatim from the county's SolarAPP+ page (a page the county publishes but whose FAQ text originates with NREL). The second limb is an inference from the plan-content requirement rather than a stated inspection duty. No county-authored solar inspection checklist exists to confirm it directly.
department page checked 2026-08-28 https://www.kernpublicworks.com/services/development/building-inspection/solarapp-streamlined-permitting-process
Q57 Is there a published inspection checklist? Core What is checked
Split answer. SolarAPP+ route: yes — an inspection checklist is issued with the approval documents ('With the SolarAPP+ inspection checklist, you know exactly what will be looked at and verified during the inspection'), and it reaches the county with the approval. Standard route: no county-published solar inspection checklist. What the county publishes for solar is a submittal/eligibility checklist and a structural criteria form, not an inspection checklist; the required inspections are listed on the Job Card issued with the permit.
Why the confidence is not higherAbsence proved by walking the whole Bulletins/Documents/Forms library — Bulletins/Policies & Guidelines, Typical Details, Plan Checklists (Residential 2025 and 2022, Non-Residential 2025 and 2022) and Forms (Building 2025/2022, Grading, Green Building, Special Inspection 2025/2022, Energy 2025/2022) — and the Building Inspection landing page. Every solar document found is a submittal or certification form. Held at 78 because a checklist could exist on the Job Card, which is issued per-permit and not published.
department document library (proved absence) + SolarAPP+ page checked 2026-08-28 https://www.kernpublicworks.com/services/development/building-inspection/bulletins-documents-forms
Q58 What must be on site at inspection? Core Documents on site
The inspection record card (Job Card) and the approved plans, kept available until final approval — Kern County Code R109.3.1 as added: 'Work requiring a permit shall not be commenced until the permit holder ... shall have posted or otherwise made available an inspection record card ... The card and approved plans shall be maintained available by the permit holder until final approval has been granted by the building official.' For rooftop solar, also the signed 'Small Residential Rooftop Solar Energy Systems Certification Form' — 'Please leave this signed Certification Form with the job card.' And at final, the smoke alarm and carbon monoxide alarm certification form: 'The certification form for smoke alarms and carbon monoxide alarms will be required at the time of final inspection.' On the SolarAPP+ route, the SolarAPP+ approval documents and inspection checklist as well.
Why the confidence is not higherFour separate county documents, each quoted verbatim, and the code provision is from the current 2025 adopting ordinance. Held at 88 because the smoke/CO requirement comes from the 2024-revision expedited checklist rather than from the ordinance.
adopting ordinance 17.06.080 + certification form + eligibility checklist checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/22775/639046855826800000
Q59 Is there a re-inspection fee? Corrections & re-inspection
$23 per re-inspection for the second and subsequent re-inspection necessitated by faulty or incomplete work; payable before the next called inspection ('Re-inspection fees shall be paid prior to the next succeeding called inspection'). Treat the figure as indicative, not current.
Why the confidence is not higherThe county's fees page still links 'Building Permit Fees 07/2008' as a live fee ordinance, and that is where the figure comes from. Two problems: the PDF has no text layer, so this was read by rendering at 200 dpi and OCRing with tesseract — a digit could be wrong; and the same document sets the permit issuance fee at $23 while the county's current process guide states a $25.50 application fee, proving the schedule has drifted since 2008 without the PDF being reissued. Nothing more recent is published — the 2025 Consolidated Land Development Fee Schedule covers planning/land-development items only and contains no re-inspection line. Verify by phone with (661) 862-8650 before relying on it.
fee ordinance (2008, scanned; OCR-extracted) checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10726/638314111299000000
Q60 How are corrections issued and cleared? Corrections & re-inspection
In writing, per department. 'If a department finds your submittal documents deficient in any way, the applicant will receive a written letter listing all deficiencies. Departmental letters (often referred to as "correction letters" or "compliance letters") will be sent to the applicant via email as each department completes their review. If no email is given, letters will be mailed to the applicant.' Clearing is the applicant's responsibility: 'it is the applicant's responsibility to resubmit or otherwise correct deficient documents and to provide a response to the departmental plan checker.' Each department clears its own review in the electronic permitting system and stamps the documents; the permit issues once all departments approve and remaining fees are paid. Resubmittals go through the Citizen Access portal (the county publishes a 'How to resubmit your plans' guide). Ch. 17.57.030 separately requires a written correction notice on an incomplete expedited-solar application.
Why the confidence is not higherQuoted verbatim from the county's 'How a Permit becomes a Structure' guide, corroborated by ch. 17.57.040(B). Held at 85 because the guide is undated on its face and describes plan-review corrections; field-correction handling after a failed inspection is not separately published.
department process guide checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10712/638314119899930000
Q61 What is issued on pass? Core Final sign-off & PTO
Final. 'After all required inspections have been completed and approved, your permit is considered "finaled"' — the sign-off is recorded on the Job Card/inspection record card. A Certificate of Occupancy is issued only 'if required by code'; Kern amends CRC R110.1 Exception 2 to exclude 'Nonbuilding structures', so a rooftop PV retrofit on an existing dwelling gets a permit final rather than a CO. No green tag or letter is described.
Why the confidence is not higherThe 'finaled' language and the conditional CO are verbatim from the county's process guide; the R110.1 amendment is from the current adopting ordinance. Held at 78 because the county nowhere says explicitly that a solar retrofit does not get a CO — that is an inference from the amendment.
department process guide + adopting ordinance 17.06.090 checked 2026-08-28 https://www.kernpublicworks.com/home/showpublisheddocument/10712/638314119899930000
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer (or customer) — the county does not notify the utility. Kern County Code 17.57.040(E) puts it on the applicant: county approval 'does not authorize an applicant to connect ... The applicant is responsible for obtaining such approval or permission from the local utility provider.' In PG&E territory the mechanism is that you or your contractor submit the final electric inspection clearance — 'a signed building or electrical permit, which also includes the Final Permit Cover for all associated NEM2 generation by the authority having jurisdiction (AHJ), such as a city or county building administration' — through PG&E's YourProjects portal (or NEMFollowups@pge.com for standard NEM under 30 kW solar / 10 kW storage; Rule21Gen@pge.com or your EGI representative for complex NEM). The submission must show the AHJ name, site/job address, description of work, permit number, APN, and the date the county inspector signed off.
Why the confidence is not higherCounty limb quoted verbatim from ch. 17.57.040(E) on Municode; utility limb quoted verbatim from PG&E's own NEM 2 Building Permit Final Inspection Clearance FAQ. Held at 85 because the PG&E FAQ is framed around NEM2 legacy deadlines rather than as a general standing procedure, and because the SCE-served part of the county was not checked in this run.
utility interconnection FAQ + ordinance ch. 17.57 checked 2026-08-28 https://www.pge.com/assets/pge/docs/clean-energy/solar/nem-2-build-permit-faq.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for Kern County against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
Kern County is the authority having jurisdiction 92% confidence
- Holds
- building, electrical, mechanical, plumbing and grading permits and inspections for all unincorporated Kern County; acts as a 'one-stop shop' that routes plans to Fire, Environmental Health, Planning, Flood/Drainage where those reviews apply
- Overridden by
- CA Gov. Code § 65850.5 (expedited solar permitting, implemented locally as Kern County Code ch. 17.57); CA Civil Code § 714 (Solar Rights Act); AB 2188 one-inspection rule; the serving utility (PG&E or SCE) separately controls interconnection and energization — county approval expressly 'does not authorize an applicant to connect ... to the local utility provider's electricity grid' (17.57.040 E)
- Why not higher
- Kern County's own Building Inspection pages, the 2025 Code of Building Regulations (Ord. G-9359, eff. 1 Jan 2026) and Kern County Code ch. 17.57 all place building AND electrical permitting/inspection in the Building Inspection Division of the PUBLIC WORKS Department. Correction worth recording: this is NOT the Kern County Planning & Natural Resources Department (kernplanning.com), which is a separate department and which confusingly publishes its own 'Residential Building Fee Estimator' — Planning handles zoning/land-use, not building or electrical. Kern County's own office-hours page also states that sites inside the City of Bakersfield go to the City of Bakersfield Building Department, 1715 Chester Ave, (661) 326-3720 — a separate AHJ, as briefed. Not 100 because the county has 11 incorporated cities and the county/city line must be confirmed per address.
https://www.kernpublicworks.com/services/development/building-inspection
- Permit required
- Yes — a permit is required for residential rooftop PV93%
- Permit cost
- $300 for systems 0 to ≤6 kW AC; $450 for >6 to ≤15 kW AC; $450 plus $15 per kW AC above 15 kW for >15 kW AC.88%
- Plan review
- Walk-in: plan review and issuance of all required permits within 1 business day 'when reasonable to do so'. Electronic submittal: 1 to 3 business days 'when reasonable to do so'.90%
- Portal
- Accela Citizen Access — https://accela.kerncounty.com/CitizenAccess (branded 'Citizen Portal'), with ePlanSoft ePlanCheck behind it for electronic plan review.92%
- Electrical code
- NEC 2023, as adopted in California via the 2025 California Electrical Code (CCR Title 24 Part 3).88%
- Own placard wording
- No — Kern County specifies no placard wording of its own. It requires the plan set to include 'a sheet showing the location and verbiage of the required labels' (i.e.72%
- Booking an inspection
- Portal or Phone. 'It is your responsibility to call the Building Inspection Department to schedule inspections. Inspections can be scheduled by phoning the number listed on your Job Card.88%
Labels & placards for this authority
Wording 72%
No — Kern County specifies no placard wording of its own. It requires the plan set to include 'a sheet showing the location and verbiage of the required labels' (i.e. the applicant states the wording, drawn from the adopted codes), and the fire department standard points to CFC sections rather than prescribing text.
Size, colour & material 78%
Not by the AHJ. Kern County specifies no letter height, colour or material. The serving utility does: in PG&E territory, 'Labels shall be permanent and suitable for the environment and shall be engraved phenolic or comply with ANSI Z535.4. Lettering shall be a minimum 3/8" high and in all capitals.'
Where they go 65%
Kern County itself does not specify label placement — only that placement be shown on the plans. Placement rules come from the fire department standard (a label within 3 feet of the rapid shutdown switch; the rapid-shutdown diagram at the labelled location) and from PG&E (signage on the front of the AC disconnect enclosure; a location map at the meter panel where the disconnect is not grouped with it).
What the utility wants on top 85%
Yes, in PG&E territory. PG&E Greenbook 060559 requires: 'Permanently attached signage on the front that explains this is the ac disconnect switch for the generation. Example: "UTILITY AC DISCONNECT SWITCH"'; labels permanent, environment-suitable, engraved phenolic or ANSI Z535.4 compliant, minimum 3/8" lettering in all capitals; a map showing location where the disconnect is not grouped with the meter panel; proper NGOM labelling plus a location map if not grouped; and where the disconnect is not accessible outside locked premises, signs with contact information plus a provider-approved locking device. The switch itself must carry marking clearly indicating open (off) and closed (on) positions. SCE's equivalent requirements were not obtained in this run.
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
