Mendocino County

State of California

Verified Aug. 5, 2026

Mendocino County is a county authority in the State of California, covering 19 regions, serving 91,601 residents. 1,577 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.

Permitting 5 steps · 28 questions

Whether a permit is needed — Yes -- a Building Permit is required for a residential rooftop PV system; the County's own Building Permit Application form has a dedicated 'Photovoltaic'… Q3 Electrical and building permits — Combined -- one Building Permit covers the structural and electrical (CEC 690/705) scope for a residential PV install; Q4 Plan review — Eligible/expedited rooftop PV (<=10kW, meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise 1-3 business days. Q18 Where you file — e-TRAKiT (etrakit.mendocinocounty.org) Q20

Permit required
Yes -- a Building Permit is required for a residential rooftop PV system; the County's own Building Permit Application form has a dedicated 'Photovoltaic' project-type checkbox.95% source
What it costs
Approximately $83 minimum, capped at $500 total, based on project valuation (per the department's own 2015 PV Toolkit handout);55% source
Plan review turnaround
Eligible/expedited rooftop PV (<=10kW, meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise 1-3 business days.85% source
Key document
department handout cited by 6 open the document
  1. Confirm who has a say over your address

    A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.

    • Is this authority the AHJ for residential solar at this address? Yes, for the unincorporated area of Mendocino County. By delegation the County Building Division ALSO issues building/electrical permits for the incorporated cities of Fort Bragg and Point Arena. It is NOT the AHJ for Ukiah or Willits, which are separate incorporated cities with their own building departments. 90% · department page
    • What does this authority permit itself, and what does it delegate? Both (Building and Electrical) -- the Building Division administers and issues a single building permit that covers structural, electrical (CEC), fire and energy review for residential PV; it does not delegate solar plan review or inspection to a separate agency, though four fire districts (Anderson Valley, Fort Bragg, Hopland, Little Lake/Willits, Ukiah) have review/approval authority alongside the County on new construction. 80% · department handout (PV Toolkit Doc #1, undated 2015 template, still linked from current site)
    • Is a permit required for a residential rooftop PV system? Yes -- a Building Permit is required for a residential rooftop PV system; the County's own Building Permit Application form has a dedicated 'Photovoltaic' project-type checkbox. 95% · department handout
    • Is there a separate electrical permit, or is it combined? Combined -- one Building Permit covers the structural and electrical (CEC 690/705) scope for a residential PV install; there is no separate stand-alone 'electrical permit' issued for the PV work itself. 75% · adopted department policy (Building Policy #14, effective 13 Mar 2026)
    • Is a HOA or architectural approval required first? No -- the County does not require HOA or architectural approval as part of its own building permit process. 55% · published checklist
    • Is there a historic-district review? No, for eligible systems -- Ordinance No. 4530 (adopted 19 Dec 2023) exempts eligible roof-mounted solar energy systems from 'all discretionary review' and from 'review by the Planning Division' in the Coastal Zone, which is where the County's Historic Review Board (Town of Mendocino) sits. 70% · department fact sheet, citing Ord. No. 4530 (19 Dec 2023)
    • Is a wind or windstorm certification required? No -- no windstorm/wind-zone certification requirement found (unlike Texas TDI-style programs). 60% · department handout (Structural Criteria, wind-uplift covered by anchor-spacing tables instead)
    • Is a Specific Use Permit or Council approval ever required? No, for qualifying systems -- 'Planning review IS NOT required for solar PV installations of this size' (<=10kW rooftop); Ordinance 4530 separately exempts eligible rooftop solar from discretionary Coastal Zone review. Larger/non-qualifying or ground-mount systems outside the expedited program could in principle require a use permit under general zoning, but no such case is documented. 75% · department handout
    • Is there a system-size cap on residential generation? No hard cap found on residential system size; 10kW AC is only the eligibility threshold for the expedited/over-the-counter review track -- larger systems go through standard (non-expedited) plan review rather than being prohibited. 65% · department handout (Eligibility Checklist)
  2. Check who is allowed to apply

    Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.

    • Who is allowed to pull the electrical permit? Either -- an owner-builder (property owner) or a California-licensed, bonded contractor (or an authorized agent of either) may pull the permit. 90% · department page
    • Must the contractor be registered with this authority before applying? No separate County contractor-registration step found beyond standard CSLB licensing. 55% · published checklist
    • Is a homeowner permitted to self-install and self-permit? Yes -- the Building Division explicitly accepts applications from the property owner as an owner-builder for self-install/self-permit. 90% · department page
  3. Build the submittal package

    Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.

    • What documents make up a complete submittal? Completed Eligibility Checklist; electrical plan or the Standard Electrical Plan (PV Toolkit Doc #3 or #4); roof/site plan showing panel layout, fire classification, access pathways and label locations; Structural Criteria (PV Toolkit Doc #5) or full engineer-stamped structural drawings if the project fails the criteria checklist; completed permit application. 90% · department handout
    • How many copies, and in what format? Over-the-counter: 1 completed permit application + 1 copy of an 8.5x11 plot/site plan. Non-OTC ('Other') projects: 3 copies of construction plans (printed or digital PDF), plus 2 copies each of Title 24 energy compliance and wet-stamped engineering calcs where applicable. 85% · published checklist
    • Is a site plan required, and what must it show? Yes -- a site/roof plan is required showing: panel/module layout, north arrow, lot dimensions, distance from property lines to structures, PV fire classification, code-compliant access pathways, and locations of all required labels/disconnects. 90% · department handout
    • Is a one-line / three-line diagram required? Yes -- a one-line electrical diagram of the complete system is required. 95% · adopted department policy
    • Are string and conductor calculations required? Yes -- module string counts, conductor type/size, conduit type/size and conductor counts per conduit run must be specified. 80% · adopted department policy
    • Is a structural PE stamp required, and at what threshold? Rooftop: a California-licensed structural/civil engineer's stamp is required only for systems that fail the Structural Criteria checklist (e.g., >4 psf array weight, roof covers >50% of area, anchor spacing exceeds Table 1, more than one roof covering, non-zero snow load, or Wind Exposure D/hillside/near-ocean siting). Ground-mount: an engineer's stamp is required whenever the array exceeds 7 feet in height. 90% · department handout (PV Toolkit Doc #5)
    • Is an electrical PE stamp required, and at what threshold? No separate electrical-PE-stamp threshold identified; non-standard electrical plans need only be prepared and signed by the installing C-10 contractor or a CA-licensed electrical contractor/engineer for large services (>200A), not a mandatory electrical PE stamp for PV itself. 60% · adopted department policy (Building Policy #2, eff. 10 Mar 2026)
  4. Apply and pay

    Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

    • Which permit portal does this authority use? e-TRAKiT (etrakit.mendocinocounty.org) 95% · portal landing page
    • Can the whole application be completed online? Largely yes -- applications, including PV, can be submitted electronically via e-TRAKiT and approved 'over the counter electronically,' and the County publishes a 'Guidelines for Online Permit Applications' handout, though that handout's full text could not be retrieved to confirm whether payment and inspection scheduling are fully self-service. 60% · department handout
    • What does a residential solar permit cost? Approximately $83 minimum, capped at $500 total, based on project valuation (per the department's own 2015 PV Toolkit handout); a newer, undated County handout for the same expedited program states only 'Fees: To be in compliance with CA State AB 1414' without restating a dollar figure. 55% · department handout (dated 2015, still linked live)
    • How is the fee calculated? Valuation-based (project cost), with square footage used for some structure types; per the Board of Supervisors' annually-adopted Master Fee Schedule. 70% · department procedure (image-only PDF, OCR'd)
    • Is there a separate plan-check fee? Yes -- a distinct Plan Check fee line exists separate from the Basic Construction fee. 80% · department procedure (image-only PDF, OCR'd)
  5. Plan review — and start the utility in parallel

    Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.

    • What is the stated plan-review turnaround? Eligible/expedited rooftop PV (<=10kW, meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise 1-3 business days. Non-expedited/standard building permits generally: 6-8 weeks plancheck. 85% · department handout
    • How long is an issued permit valid before it expires? Issued building permits (non-Class K) are valid 1 year from issuance; each approved inspection extends validity another 365 days; Class K permits are valid 3 years. 80% · adopted department policy (Building Policy #9, eff. 13 Mar 2026)
    • Which utility handles interconnection here? PG&E (Pacific Gas and Electric Company). Sonoma Clean Power (SCP) operates as a Community Choice Aggregator layered on PG&E's wires in parts of the county -- SCP is a generation-service provider, NOT the interconnecting/wires utility. 75% · county page
    • Where does the utility sit in the sequence? After permit -- PG&E interconnection/PTO ('activation') occurs after the County's final building inspection and approval. 65% · department handout

28 questions answered against Mendocino County’s own published documents

Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope

Yes, for the unincorporated area of Mendocino County. By delegation the County Building Division ALSO issues building/electrical permits for the incorporated cities of Fort Bragg and Point Arena. It is NOT the AHJ for Ukiah or Willits, which are separate incorporated cities with their own building departments.

Why the confidence is not higherBuilding Division's own overview page states its scope explicitly, naming Fort Bragg and Point Arena alongside the unincorporated area; MCC 18.08.010 confirms permit authority for the unincorporated area.

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope

Both (Building and Electrical) -- the Building Division administers and issues a single building permit that covers structural, electrical (CEC), fire and energy review for residential PV; it does not delegate solar plan review or inspection to a separate agency, though four fire districts (Anderson Valley, Fort Bragg, Hopland, Little Lake/Willits, Ukiah) have review/approval authority alongside the County on new construction.

Why the confidence is not higherBuilding Division page lists CBC/CEC/CFC/CRC among codes it enforces directly; PV Toolkit doc states Fire Department approval is required in addition for Redwood Valley and Ukiah fire district areas, showing a partial fire-district co-review rather than a full delegation.

department handout (PV Toolkit Doc #1, undated 2015 template, still linked from current site) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope

Yes -- a Building Permit is required for a residential rooftop PV system; the County's own Building Permit Application form has a dedicated 'Photovoltaic' project-type checkbox.

Why the confidence is not higherStated plainly in both the Expedited Rooftop PV handout and the PV Toolkit Application Guide, and confirmed by the checkbox on the official Building Permit Application form (OCR'd from image-only PDF).

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope

Combined -- one Building Permit covers the structural and electrical (CEC 690/705) scope for a residential PV install; there is no separate stand-alone 'electrical permit' issued for the PV work itself.

Why the confidence is not higherEvery PV-specific handout (expedited doc, PV Toolkit, Ground Mount Policy #1, Policy #14) describes a single 'Building Permit' submittal; the Building Division page lists 'Electrical' as its own over-the-counter permit category for general electrical work, but the solar-specific documents never describe a second, separate PV electrical permit.

adopted department policy (Building Policy #14, effective 13 Mar 2026) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q5 Who is allowed to pull the electrical permit? Core Who may apply

Either -- an owner-builder (property owner) or a California-licensed, bonded contractor (or an authorized agent of either) may pull the permit.

Why the confidence is not higherBuilding Division page states explicitly: 'The Building Division can ONLY accept permit applications from: the property owner as an owner-builder; a contractor licensed and bonded through the State of California; an authorized agent for either.'

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q6 Must the contractor be registered with this authority before applying? Core Who may apply

No separate County contractor-registration step found beyond standard CSLB licensing.

Why the confidence is not higherAbsence claim: reviewed the Building Permit Application form and application checklist (both current) and neither asks for anything beyond CSLB license number/class; no county contractor-registration program is referenced anywhere in the Building Division's own materials.

published checklist checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/45787/637674697261070000

Q7 Is a homeowner permitted to self-install and self-permit? Who may apply

Yes -- the Building Division explicitly accepts applications from the property owner as an owner-builder for self-install/self-permit.

Why the confidence is not higherSame department-page statement as q5; owner-builder is listed as one of only three accepted applicant categories.

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q8 What documents make up a complete submittal? Core Submittal package

Completed Eligibility Checklist; electrical plan or the Standard Electrical Plan (PV Toolkit Doc #3 or #4); roof/site plan showing panel layout, fire classification, access pathways and label locations; Structural Criteria (PV Toolkit Doc #5) or full engineer-stamped structural drawings if the project fails the criteria checklist; completed permit application.

Why the confidence is not higherConsolidated from the County's own 'Expedited Residential Rooftop Photovoltaic Systems' handout and Building Policy #14, both of which itemize the submittal package for PV.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q9 How many copies, and in what format? Submittal package

Over-the-counter: 1 completed permit application + 1 copy of an 8.5x11 plot/site plan. Non-OTC ('Other') projects: 3 copies of construction plans (printed or digital PDF), plus 2 copies each of Title 24 energy compliance and wet-stamped engineering calcs where applicable.

Why the confidence is not higherDirectly itemized on the current (last confirmed live 11 Jun 2026 capture) Building Permit Application Checklist.

published checklist checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/45787/637674697261070000

Q10 Is a site plan required, and what must it show? Core Submittal package

Yes -- a site/roof plan is required showing: panel/module layout, north arrow, lot dimensions, distance from property lines to structures, PV fire classification, code-compliant access pathways, and locations of all required labels/disconnects.

Why the confidence is not higherSpecified consistently across the Expedited PV handout, PV Toolkit Application Guide, and Ground Mount Policy #1/#14.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q11 Is a one-line / three-line diagram required? Core Drawings & calculations

Yes -- a one-line electrical diagram of the complete system is required.

Why the confidence is not higherExplicit line item in every PV submittal document reviewed (Expedited handout, PV Toolkit, Policy #14, Ground Mount Policy #1).

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q12 Are string and conductor calculations required? Drawings & calculations

Yes -- module string counts, conductor type/size, conduit type/size and conductor counts per conduit run must be specified.

Why the confidence is not higherRequired electrical-plan content items listed identically in the expedited handout, PV Toolkit and Policy #14.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps

Rooftop: a California-licensed structural/civil engineer's stamp is required only for systems that fail the Structural Criteria checklist (e.g., >4 psf array weight, roof covers >50% of area, anchor spacing exceeds Table 1, more than one roof covering, non-zero snow load, or Wind Exposure D/hillside/near-ocean siting). Ground-mount: an engineer's stamp is required whenever the array exceeds 7 feet in height.

Why the confidence is not higherStructural Criteria (PV Toolkit Doc #5) gives the rooftop pass/fail thresholds; Building Policy #14 (eff. 13 Mar 2026, supersedes the Feb 2023 Ground Mount Policy #1) states the 7-foot threshold in its own text.

department handout (PV Toolkit Doc #5) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4826/636241491930400000

Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps

No separate electrical-PE-stamp threshold identified; non-standard electrical plans need only be prepared and signed by the installing C-10 contractor or a CA-licensed electrical contractor/engineer for large services (>200A), not a mandatory electrical PE stamp for PV itself.

Why the confidence is not higherReviewed all PV-specific submittal documents (Toolkit, expedited handout, Policy #14) and Building Policy #2 (Utilities & Service Connections); none impose a PE-stamp threshold for electrical design of a PV system distinct from the structural one in q13. Policy #2 only requires an engineer/licensed electrical contractor for services >200A generally (not solar-specific).

adopted department policy (Building Policy #2, eff. 10 Mar 2026) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76595/639092661196030000

Q15 What does a residential solar permit cost? Core Fees

Approximately $83 minimum, capped at $500 total, based on project valuation (per the department's own 2015 PV Toolkit handout); a newer, undated County handout for the same expedited program states only 'Fees: To be in compliance with CA State AB 1414' without restating a dollar figure.

Why the confidence is not higherTension flagged rather than resolved: the $83/$500 figures come from a PV Toolkit document literally dated '2015' in its own footer, still linked from the current (2026) Building Division page; the newer expedited-PV handout that replaced much of its content omits specific numbers and just cites AB 1414 compliance. Could not locate a current numbered fee schedule (Master Fee Schedule PDF itself was not locatable/archived).

department handout (dated 2015, still linked live) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q16 How is the fee calculated? Core Fees

Valuation-based (project cost), with square footage used for some structure types; per the Board of Supervisors' annually-adopted Master Fee Schedule.

Why the confidence is not higherCounty's own 'Prepaid Plan Check' procedure (eff. 2 Sep 2022, OCR'd from an image-only PDF) states staff 'determine whether the fees should be based on square footage, valuation, or flat fees' per the Master Fee Schedule; the 2015 PV Toolkit doc confirms the PV fee itself is valuation-based ('minimum fee...is based on the project valuation').

department procedure (image-only PDF, OCR'd) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/53721/638023817169900000

Q17 Is there a separate plan-check fee? Fees

Yes -- a distinct Plan Check fee line exists separate from the Basic Construction fee.

Why the confidence is not higherThe Prepaid Plan Check procedure instructs staff to collect 'portions of the Basic Construction, Plan Check, Planning Review and Records Management fees' as separate line items totalling the permit cost.

department procedure (image-only PDF, OCR'd) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/53721/638023817169900000

Q18 What is the stated plan-review turnaround? Core Timeline & validity

Eligible/expedited rooftop PV (<=10kW, meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise 1-3 business days. Non-expedited/standard building permits generally: 6-8 weeks plancheck.

Why the confidence is not higher1-3 day figure is stated directly in the current Expedited Residential Rooftop PV handout; the 6-8 week figure is the department's general FAQ answer for standard plancheck (not solar-specific) and is included for contrast.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q19 How long is an issued permit valid before it expires? Timeline & validity

Issued building permits (non-Class K) are valid 1 year from issuance; each approved inspection extends validity another 365 days; Class K permits are valid 3 years.

Why the confidence is not higherTension flagged: this is per Building Policy #9 (Permit Status, Expiration & Reinstatement), effective 13 Mar 2026 -- the most current and authoritative statement found. The live Building Division web page (last captured 14 Aug 2026) still carries older wording saying an inspection approval must be obtained 'within 180 days from each previous inspection,' which conflicts with Policy #9's 365-day figure; the newer, dated, signed policy is treated as controlling.

adopted department policy (Building Policy #9, eff. 13 Mar 2026) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76605/639092661214530000

Q20 Which permit portal does this authority use? Core Portal & process

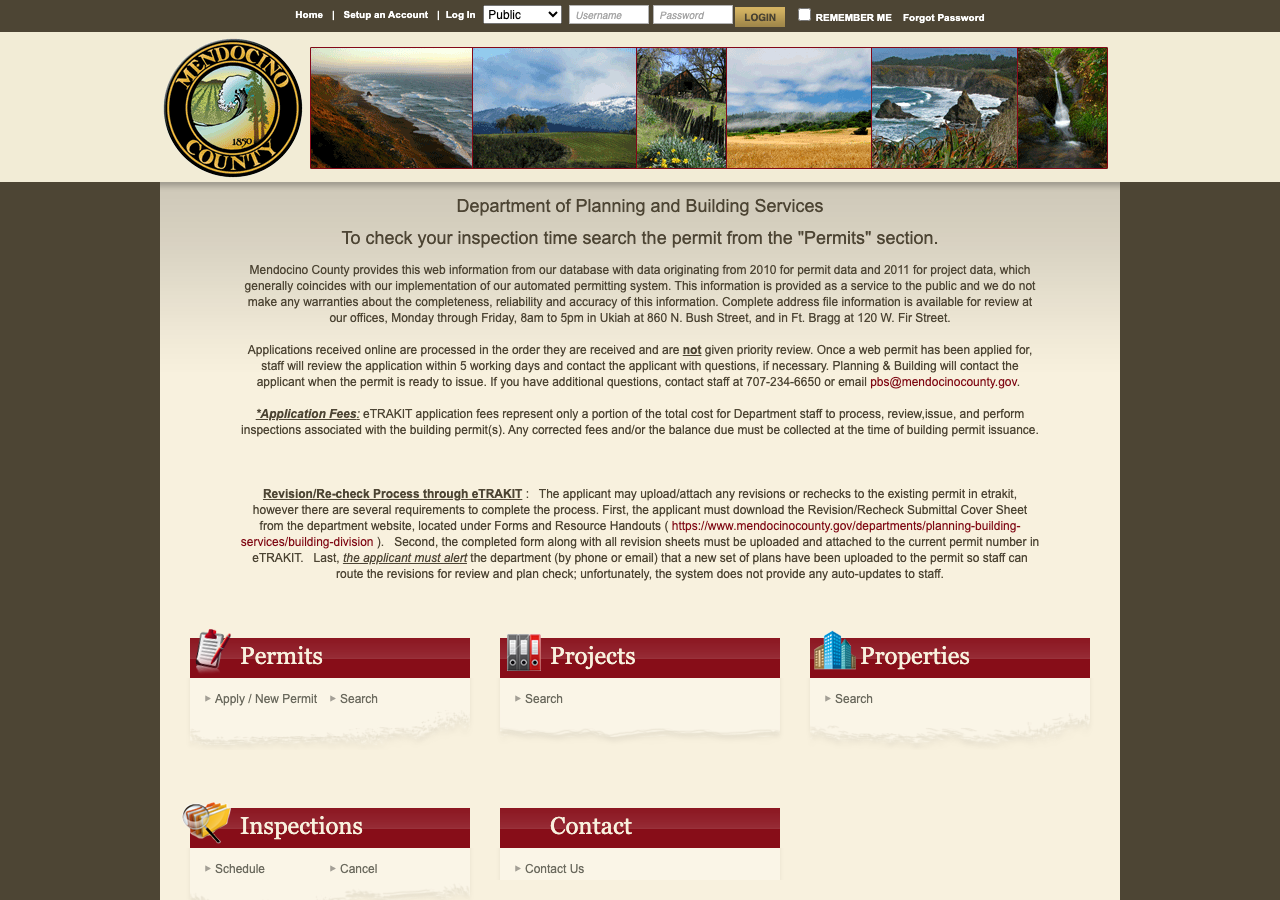

e-TRAKiT (etrakit.mendocinocounty.org)

Why the confidence is not higherLinked directly from the current Building Division page as the electronic submittal/scheduling system.

portal landing page checked 2026-08-30 https://etrakit.mendocinocounty.org/eTRAKiT3/

Q21 Can the whole application be completed online? Core Portal & process

Largely yes -- applications, including PV, can be submitted electronically via e-TRAKiT and approved 'over the counter electronically,' and the County publishes a 'Guidelines for Online Permit Applications' handout, though that handout's full text could not be retrieved to confirm whether payment and inspection scheduling are fully self-service.

Why the confidence is not higherBuilding Division page and the Expedited PV handout both state applications 'can be submitted in person or electronically' and may be approved 'over the counter electronically'; the dedicated guidance document (doc ID 78876) returned a 403 live and was not found in the Wayback CDX index under any ID tried.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q22 Which utility handles interconnection here? Core Utility interconnection

PG&E (Pacific Gas and Electric Company). Sonoma Clean Power (SCP) operates as a Community Choice Aggregator layered on PG&E's wires in parts of the county -- SCP is a generation-service provider, NOT the interconnecting/wires utility.

Why the confidence is not higherCounty's own Sustainable Practices page separately lists 'PG&E Expenditure Reports' (confirming the county itself is a PG&E ratepayer/wires customer) and describes Sonoma Clean Power only as a 100%-renewable generation program ('EverGreen') the county opted county facilities into in Jan 2022 -- the classic CCA-on-IOU-wires structure. Not sourced from a ZIP-code lookup tool.

county page checked 2026-08-30 https://www.mendocinocounty.gov/departments/general-services/facilities-and-fleet/planning-resources/sustainable-practices

Q23 Where does the utility sit in the sequence? Core Utility interconnection

After permit -- PG&E interconnection/PTO ('activation') occurs after the County's final building inspection and approval.

Why the confidence is not higherCounty's own Expedited PV handout states the system 'must be inspected before final approval and activation is granted,' implying utility activation follows AHJ sign-off; not an explicit sequence diagram from PG&E itself.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q24 Is a HOA or architectural approval required first? Overlays & special cases

No -- the County does not require HOA or architectural approval as part of its own building permit process.

Why the confidence is not higherAbsence claim: none of the current submittal checklists, the Building Permit Application form, or the PV-specific handouts list HOA/architectural approval as a submittal item. California Civil Code Section 714 separately limits HOA authority to block solar statewide, but that is state law, not a County requirement.

published checklist checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/45787/637674697261070000

Q25 Is there a historic-district review? Overlays & special cases

No, for eligible systems -- Ordinance No. 4530 (adopted 19 Dec 2023) exempts eligible roof-mounted solar energy systems from 'all discretionary review' and from 'review by the Planning Division' in the Coastal Zone, which is where the County's Historic Review Board (Town of Mendocino) sits.

Why the confidence is not higherOrdinance 4530 fact sheet is explicit about exemption from discretionary/Planning Division review; it does not name the Historic Review Board specifically, so the inference that this covers historic-district review is reasonable but not a verbatim statement.

department fact sheet, citing Ord. No. 4530 (19 Dec 2023) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73112/638896635879730000

Q26 Is a wind or windstorm certification required? Overlays & special cases

No -- no windstorm/wind-zone certification requirement found (unlike Texas TDI-style programs).

Why the confidence is not higherAbsence claim, controls run: searched the full text of every PV/structural document collected (14 files) for 'windstorm', 'wind certif', 'TDI' -- zero hits; a positive control term ('electrical') and a fabricated control term ('zzqqx') were run against the same corpus, returning 12 hits and 0 hits respectively, confirming the search was working. California has no statewide analog to a TDI windstorm certificate.

department handout (Structural Criteria, wind-uplift covered by anchor-spacing tables instead) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4826/636241491930400000

Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases

No, for qualifying systems -- 'Planning review IS NOT required for solar PV installations of this size' (<=10kW rooftop); Ordinance 4530 separately exempts eligible rooftop solar from discretionary Coastal Zone review. Larger/non-qualifying or ground-mount systems outside the expedited program could in principle require a use permit under general zoning, but no such case is documented.

Why the confidence is not higherDirect quote from the PV Toolkit Application Guide plus the Ordinance 4530 fact sheet.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q28 Is there a system-size cap on residential generation? Overlays & special cases

No hard cap found on residential system size; 10kW AC is only the eligibility threshold for the expedited/over-the-counter review track -- larger systems go through standard (non-expedited) plan review rather than being prohibited.

Why the confidence is not higherEligibility Checklist frames the 10kW figure as a condition for using the fast-track process, not a ceiling; no separate zoning-code size cap was located (Municode access blocked -- see note in q32).

department handout (Eligibility Checklist) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4820/636241491922600000

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Install 5 steps · 20 questions
  1. Build to the code editions actually in force here

    The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.

    • Which NEC edition is in force? California Electrical Code (statewide, based on the 2023 NEC as part of the 2025 Title 24 cycle, effective 1 Jan 2026). Mendocino's current Building Policy #14 (13 Mar 2026) cites 'California Electrical Code (CEC), including Sections 690 and 705' without stating the numeric cycle. 60% · adopted department policy
    • Which building code edition is in force? California Building Code and California Residential Code, 2025 edition (Title 24 Parts 2 & 2.5, statewide, effective 1 Jan 2026). Policy #14 cites 'CBC Chapter 15' and 'CRC Sections R329 & R330.' 60% · adopted department policy
    • Which fire code edition is in force? California Fire Code (2025 edition, Title 24 Part 9, statewide) plus the California Wildland-Urban Interface Code -- both cited by name in current Building Policies #5 and #14 (Mar 2026). 60% · adopted department policy (Building Policy #5, eff. 10 Mar 2026)
    • Are there local amendments to any of the above? Yes -- the County layers its own Building Policies (numbered #1-#19) on top of the state codes, e.g. the 7-foot ground-mount PE-stamp trigger, structural-criteria pass/fail tables, and the 100A/200A electrical-service rules in Policy #2, none of which are simple restatements of CBC/CEC text. 60% · adopted department policy
    • What is the installation judged against? The current California Building Code, Residential Code, Electrical Code and Fire Code as locally amended, plus County of Mendocino Building Policies #1/#2/#5/#14 and the PV Toolkit standard plans. 85% · adopted department policy
  2. Fire access, setbacks and pathways

    Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.

    • What ridge setback and access pathways are required? Access pathways are referenced to California Residential Code Section 324 (per the County's own Expedited Rooftop PV handout); the roof plan must show fire classification and code-compliant access pathway locations. Exact ridge-setback dimensions themselves live in the ICC-copyrighted CRC/CFC tables and are not independently republished in any County document found. 65% · department handout
  3. Rapid shutdown

    Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.

    • Is rapid shutdown required, and to which NEC edition? Rapid shutdown is required as a function of the statewide California Electrical Code (CEC 690.12), which Mendocino enforces as adopted; County documents cite 'CEC Sections 690 and 705' generally but do not separately quote 690.12 by number. 55% · adopted department policy
  4. Labels and placards

    The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.

    • Which placards does this authority require at the service equipment? At minimum: (1) sign identifying PV power-source system attributes at the DC disconnect, (2) sign identifying the AC point of connection, (3) sign identifying the switch for the alternative power system. The utility (PG&E) separately requires its own 'UTILITY AC DISCONNECT SWITCH' label at its disconnect (see q42). 90% · adopted department policy
    • Does the authority specify placard wording of its own? Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection, alternate power switch) but does not mandate verbatim wording of its own the way PG&E does for its utility disconnect label. 70% · adopted department policy
    • Does it specify letter height, colour or material? The County's PV Toolkit standard-plan document recommends (per ANSI Z535.4 guidance) a phenolic plaque with contrasting text/background colors and 'no type size specified, but 20-point (3/8") should be considered the minimum' -- framed as guidance, not a hard county mandate. PG&E separately mandates a hard minimum of 3/8" all-capital lettering, engraved phenolic or ANSI Z535.4-compliant, for its own utility disconnect label (utility-level, not AHJ). 70% · department handout (PV Toolkit Doc #4)
    • Is a site plan / facility map placard required, and what must it show? Yes -- a roof/site plan (facility-map equivalent) is required showing panel/module layout, north arrow, lot dimensions, distance to property lines/structures, PV fire classification, clear access pathways, and locations of all required labels/markings and electrical disconnects/roof access points. 80% · department handout
    • Does the UTILITY specify placards beyond the AHJ's? Yes -- PG&E's own Distribution Interconnection Handbook document (Greenbook doc 060559, 'Disconnect Switch Requirements for Distributed Generation Customers,' Rev. #07, approved 25 Mar 2022) requires a permanently attached label reading e.g. 'UTILITY AC DISCONNECT SWITCH,' engraved phenolic or ANSI Z535.4-compliant, minimum 3/8" all-capital lettering -- beyond and in addition to the AHJ's own three signs (q38). 90% · utility interconnection handbook (PG&E Greenbook doc 060559, Rev. #07, 3/25/2022)
    • Where must the labels be placed? AHJ level: at the DC disconnect, at the AC point of connection, and at the alternate-power-system switch. Utility (PG&E) level: the AC disconnect label must be on the front of the switch, and the switch itself must be within 10 feet and in line of sight of PG&E's meter, at the same grade level as the meter, mounted 48"-75" high if wall/pad-mounted, and never on a roof or a floor above grade; a location map is required if the disconnect is not co-located with the meter. 85% · utility interconnection handbook + department policy
  5. Disconnect, storage and listed equipment

    Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.

    • Where must the AC disconnect be, relative to the meter? Within 10 feet, in line of sight, of PG&E's electric meter; at the same grade level as the meter if outdoors; mounted 48"-75" high if wall- or pad-mounted; never on a roof, an upper floor, or inside a non-approved meter room. 95% · utility interconnection handbook
    • Must equipment be on a specific approved list? Yes -- equipment must be listed/labeled for its PV application per CEC 690.4(D) (equipment cut sheets for inverters, modules, disconnects and combiner boxes are a required submittal item); this is the statewide CEC listing requirement rather than a County-specific approved-products list. 80% · department handout
    • Are batteries permitted, and under what conditions? Yes, with conditions -- battery storage disqualifies a project from the expedited/over-the-counter PV track (the Eligibility Checklist requires the system be 'utility interactive and without battery storage' to qualify), but batteries are explicitly accommodated in the standard (non-expedited) submittal: they must be shown on the electrical diagram with their location and venting called out. 85% · department handout (Eligibility Checklist)
    • Is there a separate ESS permit or inspection? No standalone 'ESS permit' identified -- battery/ESS installation appears to be folded into the standard Building Permit/inspection process described in Policy #14, not a separately named permit type. 55% · adopted department policy
    • Is a ground mount treated as a structure? Yes -- a ground-mounted PV system is treated as a structure requiring foundation/footing plans and reinforcement details, with a California-licensed engineer's approval mandatory for arrays exceeding 7 feet in height. 90% · adopted department policy
    • Is there a local rule on service upgrades or busbar sizing? Yes -- Building Policy #2: a single-family residence must have a minimum 100A, 3-wire service (CEC 230.79(c)); an over-the-counter panel-replacement permit is allowed only for same-amperage replacement on an already-permitted structure; any new panel over 200A requires load calculations and line drawings from a CA-licensed electrical contractor or engineer; amperage must be justified from existing loads only, not projected/future loads. 90% · adopted department policy
    • Is a specific mounting system or attachment spacing required? Yes -- prescriptive anchor/attachment spacing tables (Structural Criteria, PV Toolkit Doc #5): e.g. up to 6'-0" horizontal anchor spacing at 24" rafter/truss spacing on flat-to-6:12 roofs, tightening to as little as 1'-4" on steep slopes; expedited-program truss rule requires 6' spacing generally, or 4' alternating spacing if truss spacing is 16" o.c. or splice locations near rail attachments cannot be confirmed. 90% · department handout (PV Toolkit Doc #5)

20 questions answered against Mendocino County’s own published documents

Q29 Which NEC edition is in force? Core Code editions in force

California Electrical Code (statewide, based on the 2023 NEC as part of the 2025 Title 24 cycle, effective 1 Jan 2026). Mendocino's current Building Policy #14 (13 Mar 2026) cites 'California Electrical Code (CEC), including Sections 690 and 705' without stating the numeric cycle.

Why the confidence is not higherCounty policy is current (dated after 1 Jan 2026 statewide effective date) and references CEC generically; the specific '2023 NEC / 2025 cycle' framing is the statewide default rather than something Mendocino's own document states in those words. Could not confirm via Mendocino County Code Chapter 18.04 directly because library.municode.com serves only its Angular JS shell to every fetch method tried (curl, Wayback raw capture of the same URLs also returned only the ~2-3KB app shell, never rendered content).

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q30 Which building code edition is in force? Core Code editions in force

California Building Code and California Residential Code, 2025 edition (Title 24 Parts 2 & 2.5, statewide, effective 1 Jan 2026). Policy #14 cites 'CBC Chapter 15' and 'CRC Sections R329 & R330.'

Why the confidence is not higherSame basis and same Municode-access limitation as q29 -- policy is dated within the 2025-cycle window but does not itself state '2025' as a cycle year.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q31 Which fire code edition is in force? Code editions in force

California Fire Code (2025 edition, Title 24 Part 9, statewide) plus the California Wildland-Urban Interface Code -- both cited by name in current Building Policies #5 and #14 (Mar 2026).

Why the confidence is not higherSame basis/limitation as q29/q30; Municode blocked for the exact MCC chapter citing the fire code adoption ordinance.

adopted department policy (Building Policy #5, eff. 10 Mar 2026) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76599/639092661203070000

Q32 Are there local amendments to any of the above? Core Code editions in force

Yes -- the County layers its own Building Policies (numbered #1-#19) on top of the state codes, e.g. the 7-foot ground-mount PE-stamp trigger, structural-criteria pass/fail tables, and the 100A/200A electrical-service rules in Policy #2, none of which are simple restatements of CBC/CEC text.

Why the confidence is not higherConfirmed via the department's own policy library; could not independently verify against the codified MCC Chapter 18.04 text itself because library.municode.com serves only an unrendered JS application shell to every access method attempted, live and via Wayback.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76595/639092661196030000

Q33 What is the installation judged against? Core Electrical

The current California Building Code, Residential Code, Electrical Code and Fire Code as locally amended, plus County of Mendocino Building Policies #1/#2/#5/#14 and the PV Toolkit standard plans.

Why the confidence is not higherDirectly stated authority sections in Building Policy #14.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q34 Is there a local rule on service upgrades or busbar sizing? Electrical

Yes -- Building Policy #2: a single-family residence must have a minimum 100A, 3-wire service (CEC 230.79(c)); an over-the-counter panel-replacement permit is allowed only for same-amperage replacement on an already-permitted structure; any new panel over 200A requires load calculations and line drawings from a CA-licensed electrical contractor or engineer; amperage must be justified from existing loads only, not projected/future loads.

Why the confidence is not higherDirectly and specifically stated in Building Policy #2 (Utilities & Service Connections), effective 10 Mar 2026.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76595/639092661196030000

Q35 Is a specific mounting system or attachment spacing required? Structural & mounting

Yes -- prescriptive anchor/attachment spacing tables (Structural Criteria, PV Toolkit Doc #5): e.g. up to 6'-0" horizontal anchor spacing at 24" rafter/truss spacing on flat-to-6:12 roofs, tightening to as little as 1'-4" on steep slopes; expedited-program truss rule requires 6' spacing generally, or 4' alternating spacing if truss spacing is 16" o.c. or splice locations near rail attachments cannot be confirmed.

Why the confidence is not higherExplicit tables in the Structural Criteria handout and matching language in the Expedited Rooftop PV handout.

department handout (PV Toolkit Doc #5) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4826/636241491930400000

Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks

Access pathways are referenced to California Residential Code Section 324 (per the County's own Expedited Rooftop PV handout); the roof plan must show fire classification and code-compliant access pathway locations. Exact ridge-setback dimensions themselves live in the ICC-copyrighted CRC/CFC tables and are not independently republished in any County document found.

Why the confidence is not higherCounty document points to CRC 324 rather than restating the dimensional table; consistent with the known limitation that ICC-copyrighted setback tables are not freely retrievable.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown

Rapid shutdown is required as a function of the statewide California Electrical Code (CEC 690.12), which Mendocino enforces as adopted; County documents cite 'CEC Sections 690 and 705' generally but do not separately quote 690.12 by number.

Why the confidence is not higherNo County document names '690.12' or 'rapid shutdown' verbatim in the corpus collected; the requirement is inferred from statewide CEC adoption plus the County's general CEC 690/705 citations, not from a Mendocino-specific rapid-shutdown statement.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling

At minimum: (1) sign identifying PV power-source system attributes at the DC disconnect, (2) sign identifying the AC point of connection, (3) sign identifying the switch for the alternative power system. The utility (PG&E) separately requires its own 'UTILITY AC DISCONNECT SWITCH' label at its disconnect (see q42).

Why the confidence is not higherIdentical three-sign requirement stated in the PV Toolkit, Ground Mount Policy #1, and current Building Policy #14 inspection checklists.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling

Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection, alternate power switch) but does not mandate verbatim wording of its own the way PG&E does for its utility disconnect label.

Why the confidence is not higherCounty documents describe sign function/content, not exact text strings; contrast with PG&E's Greenbook example wording 'UTILITY AC DISCONNECT SWITCH.'

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling

The County's PV Toolkit standard-plan document recommends (per ANSI Z535.4 guidance) a phenolic plaque with contrasting text/background colors and 'no type size specified, but 20-point (3/8") should be considered the minimum' -- framed as guidance, not a hard county mandate. PG&E separately mandates a hard minimum of 3/8" all-capital lettering, engraved phenolic or ANSI Z535.4-compliant, for its own utility disconnect label (utility-level, not AHJ).

Why the confidence is not higherCounty language ('should be considered') reads as a recommendation drawn from the statewide PV Toolkit template rather than an enforced county minimum; PG&E's figure in its own Greenbook document is a hard requirement.

department handout (PV Toolkit Doc #4) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4822/636241491925100000

Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling

Yes -- a roof/site plan (facility-map equivalent) is required showing panel/module layout, north arrow, lot dimensions, distance to property lines/structures, PV fire classification, clear access pathways, and locations of all required labels/markings and electrical disconnects/roof access points.

Why the confidence is not higherConsistent requirement across the Expedited PV handout, Eligibility Checklist and Building Policy #14.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling

Yes -- PG&E's own Distribution Interconnection Handbook document (Greenbook doc 060559, 'Disconnect Switch Requirements for Distributed Generation Customers,' Rev. #07, approved 25 Mar 2022) requires a permanently attached label reading e.g. 'UTILITY AC DISCONNECT SWITCH,' engraved phenolic or ANSI Z535.4-compliant, minimum 3/8" all-capital lettering -- beyond and in addition to the AHJ's own three signs (q38).

Why the confidence is not higherFetched live and cleanly from pge.com as a genuine text-layer PDF; revision stamp read directly from the document footer/header (Rev. #07, 3/25/2022) rather than assumed from the URL. This is a utility-level requirement, correctly attributed to PG&E and not to Mendocino County.

utility interconnection handbook (PG&E Greenbook doc 060559, Rev. #07, 3/25/2022) checked 2026-08-30 https://www.pge.com/assets/pge/docs/account/service-requests/060559.pdf

Q43 Where must the labels be placed? Core Labels Signage & labelling

AHJ level: at the DC disconnect, at the AC point of connection, and at the alternate-power-system switch. Utility (PG&E) level: the AC disconnect label must be on the front of the switch, and the switch itself must be within 10 feet and in line of sight of PG&E's meter, at the same grade level as the meter, mounted 48"-75" high if wall/pad-mounted, and never on a roof or a floor above grade; a location map is required if the disconnect is not co-located with the meter.

Why the confidence is not higherAHJ portion from Policy #14/PV Toolkit; utility portion read directly from PG&E Greenbook doc 060559 Rev. #07 (3/25/2022).

utility interconnection handbook + department policy checked 2026-08-30 https://www.pge.com/assets/pge/docs/account/service-requests/060559.pdf

Q44 Must equipment be on a specific approved list? Equipment listing

Yes -- equipment must be listed/labeled for its PV application per CEC 690.4(D) (equipment cut sheets for inverters, modules, disconnects and combiner boxes are a required submittal item); this is the statewide CEC listing requirement rather than a County-specific approved-products list.

Why the confidence is not higherCited directly in the PV Toolkit standard-plan documents.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4822/636241491925100000

Q45 Are batteries permitted, and under what conditions? Core Battery / ESS

Yes, with conditions -- battery storage disqualifies a project from the expedited/over-the-counter PV track (the Eligibility Checklist requires the system be 'utility interactive and without battery storage' to qualify), but batteries are explicitly accommodated in the standard (non-expedited) submittal: they must be shown on the electrical diagram with their location and venting called out.

Why the confidence is not higherEligibility Checklist item D excludes battery systems from the fast track; Building Policy #14 and the Ground Mount Policy #1 both explicitly instruct applicants to include 'battery storage details, if applicable, including location and venting' in the standard submittal.

department handout (Eligibility Checklist) checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4820/636241491922600000

Q46 Is there a separate ESS permit or inspection? Battery / ESS

No standalone 'ESS permit' identified -- battery/ESS installation appears to be folded into the standard Building Permit/inspection process described in Policy #14, not a separately named permit type.

Why the confidence is not higherAbsence claim: no ESS-specific permit type appears on the Building Permit Application form or in any policy document collected; Policy #14 addresses batteries as an item within the general solar submittal rather than as a distinct permit.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q47 Is a ground mount treated as a structure? Core Ground mount

Yes -- a ground-mounted PV system is treated as a structure requiring foundation/footing plans and reinforcement details, with a California-licensed engineer's approval mandatory for arrays exceeding 7 feet in height.

Why the confidence is not higherExplicit in both the superseded Ground Mount Policy #1 (16 Feb 2023) and its current replacement, Building Policy #14 (13 Mar 2026), which retained the same 7-foot/foundation requirements while broadening the policy's title.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment

Within 10 feet, in line of sight, of PG&E's electric meter; at the same grade level as the meter if outdoors; mounted 48"-75" high if wall- or pad-mounted; never on a roof, an upper floor, or inside a non-approved meter room.

Why the confidence is not higherRead directly from PG&E's own current interconnection document (Greenbook doc 060559, 'Disconnect Switch Requirements for Distributed Generation Customers,' Rev. #07, approved 25 Mar 2022), fetched live from pge.com as a clean text-layer PDF and confirmed by its own revision stamp.

utility interconnection handbook checked 2026-08-30 https://www.pge.com/assets/pge/docs/account/service-requests/060559.pdf

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Inspection 5 steps · 14 questions
  1. Book it

    Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.

    • How is an inspection booked? Phone (automated inspection request line, separate Ukiah/Fort Bragg numbers) or Portal (e-TRAKiT online scheduling). 90% · department page
    • How much notice is required? By 3:00 PM the business day before the requested inspection (effectively 1 business day's notice). 90% · department page
    • Are same-day or AM/PM windows offered? AM/PM windows are attempted but not guaranteed -- the department tries to meet morning or afternoon requests, verifiable by calling between 8:00-9:00 AM the day of inspection. 85% · department page
  2. Know who turns up

    Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.

    • Does this AHJ perform its own final solar inspection? Yes -- the County Building Division performs its own final solar inspections for the unincorporated area, Fort Bragg and Point Arena. 90% · department page
    • If delegated, to whom? Not delegated -- self-performed by the County Building Division's own inspectors within its jurisdiction (unincorporated area, Fort Bragg, Point Arena). Ukiah and Willits perform their own inspections independently and are not part of this delegation. 85% · department page
  3. Work the stages in order

    A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.

    • Which inspections are required, and in what order? At minimum a final inspection is required before activation. Ground-mount or larger installs also require a foundation/footing inspection (checked per Policy #14 Section 4.1) prior to final; re-roof work involving new plywood sheathing requires a roof-sheathing nailing inspection before the sheathing is covered. 70% · adopted department policy
    • Is a rough-in or mid-roof inspection required? Yes, in specific cases -- a roof-sheathing nailing inspection is required before covering new plywood sheathing (re-roof/reframe scenarios), and a foundation/footing inspection is required for ground-mount arrays; a simple rack-only rooftop retrofit with no new sheathing does not appear to require a distinct rough-in stage beyond final. 55% · adopted department policy
  4. Have the paperwork on site

    The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.

    • Is there a published inspection checklist? Yes -- inspection checklists are embedded directly in the PV Toolkit Application Guide, the Ground Mount Policy and Building Policy #14; a standalone 'Checklist for FINAL Inspection' PDF is also listed on the Building Division's forms page, though its full text could not be retrieved (not archived by Wayback under any document ID found; live site 403s). 75% · department handout
    • What must be on site at inspection? The approved job-copy plans and the permit itself must be on site for the inspector to review, and the property address must be posted in numbers 2.5"-4" high, visible from the road. 90% · department page
    • Does the inspector verify labels and listings? Yes -- the inspector explicitly verifies module/inverter make-model against plans and spec sheets, equipment listing/labeling, and that installed signage matches equipment ratings (inverter voltage rating vs. sign, OCPD ratings vs. sign, etc.). 90% · adopted department policy
  5. Sign-off, and permission to operate

    Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.

    • What is issued on pass? Final (final inspection approval / 'activation'), rather than a certificate of occupancy, green tag, or letter. 80% · department handout
    • Who notifies the utility for PTO? Installer -- consistent with standard California net-metering practice, the installer/customer submits the interconnection/PTO paperwork to PG&E once the County has granted final approval; this is not explicitly spelled out by Mendocino County itself. 55% · department handout
    • How are corrections issued and cleared? Corrections are issued via a written correction/revision notice from plan review or the field inspector; the applicant submits a completed Revision/Recheck form plus a cover/correction letter describing the changes. The permit status is changed to REVISION while under review, no inspections occur on the revised area until the revision is approved, and required plan revisions must be approved before work resumes. 80% · adopted department policy

14 questions answered against Mendocino County’s own published documents

Q49 How is an inspection booked? Core Booking & scheduling

Phone (automated inspection request line, separate Ukiah/Fort Bragg numbers) or Portal (e-TRAKiT online scheduling).

Why the confidence is not higherBoth methods described together on the Building Division page.

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q50 How much notice is required? Core Booking & scheduling

By 3:00 PM the business day before the requested inspection (effectively 1 business day's notice).

Why the confidence is not higherStated verbatim on the Building Division page: 'The deadline to call for an inspection is 3:00pm THE DAY BEFORE.'

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q51 Are same-day or AM/PM windows offered? Booking & scheduling

AM/PM windows are attempted but not guaranteed -- the department tries to meet morning or afternoon requests, verifiable by calling between 8:00-9:00 AM the day of inspection.

Why the confidence is not higherDirect quote from the Building Division page.

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q52 Does this AHJ perform its own final solar inspection? Core Who inspects

Yes -- the County Building Division performs its own final solar inspections for the unincorporated area, Fort Bragg and Point Arena.

Why the confidence is not higherConsistent with the Building Division's stated scope and the inspection scheduling instructions on the same page.

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q53 If delegated, to whom? Core Who inspects

Not delegated -- self-performed by the County Building Division's own inspectors within its jurisdiction (unincorporated area, Fort Bragg, Point Arena). Ukiah and Willits perform their own inspections independently and are not part of this delegation.

Why the confidence is not higherInference from the same Building Division scope statement plus the day-of-week inspection-route schedule the page publishes for inland/coastal areas.

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q54 Which inspections are required, and in what order? Core Stages & sequence

At minimum a final inspection is required before activation. Ground-mount or larger installs also require a foundation/footing inspection (checked per Policy #14 Section 4.1) prior to final; re-roof work involving new plywood sheathing requires a roof-sheathing nailing inspection before the sheathing is covered.

Why the confidence is not higherCombined from the Expedited PV handout ('must be inspected before final approval'), Building Policy #14 (foundation/footing checks) and Building Policy #5 (sheathing nailing inspection for re-roofs).

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q55 Is a rough-in or mid-roof inspection required? Stages & sequence

Yes, in specific cases -- a roof-sheathing nailing inspection is required before covering new plywood sheathing (re-roof/reframe scenarios), and a foundation/footing inspection is required for ground-mount arrays; a simple rack-only rooftop retrofit with no new sheathing does not appear to require a distinct rough-in stage beyond final.

Why the confidence is not higherPieced together from Building Policy #5 (roofing) and Building Policy #14 (ground mount structural checks); no single document states a universal mid-roof/rough-in rule for all PV installs.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76599/639092661203070000

Q56 Does the inspector verify labels and listings? Core What is checked

Yes -- the inspector explicitly verifies module/inverter make-model against plans and spec sheets, equipment listing/labeling, and that installed signage matches equipment ratings (inverter voltage rating vs. sign, OCPD ratings vs. sign, etc.).

Why the confidence is not higherDetailed, itemized inspection checklist embedded in the PV Toolkit Application Guide, Ground Mount Policy #1 and current Building Policy #14, all describing the same label/rating cross-checks.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76609/639092661222370000

Q57 Is there a published inspection checklist? Core What is checked

Yes -- inspection checklists are embedded directly in the PV Toolkit Application Guide, the Ground Mount Policy and Building Policy #14; a standalone 'Checklist for FINAL Inspection' PDF is also listed on the Building Division's forms page, though its full text could not be retrieved (not archived by Wayback under any document ID found; live site 403s).

Why the confidence is not higherEmbedded checklists were read in full; the standalone final-inspection checklist document's existence is confirmed by its title/link on the current site but its content is unverified.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/4818/636241491919930000

Q58 What must be on site at inspection? Core Documents on site

The approved job-copy plans and the permit itself must be on site for the inspector to review, and the property address must be posted in numbers 2.5"-4" high, visible from the road.

Why the confidence is not higherDirect quote from the Building Division page.

department page checked 2026-08-30 https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Q59 Is there a re-inspection fee? Corrections & re-inspection

Nothing published by this authority.

Where we lookedBuilding Policy #7 (Fee Calculations & Permit Issuance, eff. 8 Mar 2026), Building Policy #9 (Permit Status/Expiration/Reinstatement, eff. 13 Mar 2026), the Prepaid Plan Check procedure (OCR'd), and the Building Division FAQ page -- none state a specific re-inspection fee dollar amount (only a permit re-instatement fee for expired permits is mentioned, which is a different fee).

https://www.mendocinocounty.gov/home/showpublisheddocument/76601/639092661207230000

Q60 How are corrections issued and cleared? Corrections & re-inspection

Corrections are issued via a written correction/revision notice from plan review or the field inspector; the applicant submits a completed Revision/Recheck form plus a cover/correction letter describing the changes. The permit status is changed to REVISION while under review, no inspections occur on the revised area until the revision is approved, and required plan revisions must be approved before work resumes.

Why the confidence is not higherDirectly described in Building Policy #8 (Plan Review & Revision), effective 12 Mar 2026 -- the current, signed departmental procedure for handling corrections.

adopted department policy checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/76603/639092661210970000

Q61 What is issued on pass? Core Final sign-off & PTO

Final (final inspection approval / 'activation'), rather than a certificate of occupancy, green tag, or letter.

Why the confidence is not higherPV-specific documents consistently describe 'final approval' and 'activation' being granted on pass, without referencing a CO, green-tag or letter format.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Q62 Who notifies the utility for PTO? Core Final sign-off & PTO

Installer -- consistent with standard California net-metering practice, the installer/customer submits the interconnection/PTO paperwork to PG&E once the County has granted final approval; this is not explicitly spelled out by Mendocino County itself.

Why the confidence is not higherInferred from standard statewide practice and the County's own phrasing that 'final approval and activation' follow inspection; no Mendocino document names who specifically contacts PG&E for PTO.

department handout checked 2026-08-30 https://www.mendocinocounty.gov/home/showpublisheddocument/73010/638896571987430000

Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.

Jurisdiction & key facts

The standing 62-question set, answered for Mendocino County against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.

Mendocino County is the authority having jurisdiction 90% confidence
Holds
Building and Electrical (Both)
Overridden by
Coastal Commission retains authority over parcels with a pre-1992 CCC-issued permit (per Ordinance 4530 fact sheet); otherwise county building code (Title 18) governs
Why not higher
Mendocino County is a general-law county whose Planning & Building Services Building Division administers building permits (CBC/CRC/CEC/CFC) in the unincorporated area. The Building Division's own page states it also administers building code 'in the unincorporated areas of Mendocino County and the cities of Fort Bragg and Point Arena' -- i.e. those two incorporated cities have DELEGATED building/electrical permitting to the County, while Ukiah and Willits are separate incorporated cities NOT covered by the County (they run their own building departments). This corrects the brief's framing that all four cities are simply 'separate AHJs': two are, two have delegated to the County. MCC Title 18 Section 18.08.010 requires permits be issued/fees collected by Planning and Building Services for the unincorporated area.

https://www.mendocinocounty.gov/departments/planning-building-services/building-division

Permit required
Yes -- a Building Permit is required for a residential rooftop PV system; the County's own Building Permit Application form has a dedicated 'Photovoltaic' project-type checkbox.95%
Permit cost
Approximately $83 minimum, capped at $500 total, based on project valuation (per the department's own 2015 PV Toolkit handout);55%
Plan review
Eligible/expedited rooftop PV (<=10kW, meeting the Eligibility Checklist): over-the-counter same day when staff is available, otherwise 1-3 business days.85%
Portal
e-TRAKiT (etrakit.mendocinocounty.org)95%
Electrical code
California Electrical Code (statewide, based on the 2023 NEC as part of the 2025 Title 24 cycle, effective 1 Jan 2026).60%
Own placard wording
Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection,70%
Booking an inspection
Phone (automated inspection request line, separate Ukiah/Fort Bragg numbers) or Portal (e-TRAKiT online scheduling).90%
Labels & placards for this authority

Wording 70%

Partially -- the County specifies what each required sign must identify (DC disconnect attributes, AC point of connection, alternate power switch) but does not mandate verbatim wording of its own the way PG&E does for its utility disconnect label.

Size, colour & material 70%

The County's PV Toolkit standard-plan document recommends (per ANSI Z535.4 guidance) a phenolic plaque with contrasting text/background colors and 'no type size specified, but 20-point (3/8") should be considered the minimum' -- framed as guidance, not a hard county mandate. PG&E separately mandates a hard minimum of 3/8" all-capital lettering, engraved phenolic or ANSI Z535.4-compliant, for its own utility disconnect label (utility-level, not AHJ).

Where they go 85%

AHJ level: at the DC disconnect, at the AC point of connection, and at the alternate-power-system switch. Utility (PG&E) level: the AC disconnect label must be on the front of the switch, and the switch itself must be within 10 feet and in line of sight of PG&E's meter, at the same grade level as the meter, mounted 48"-75" high if wall/pad-mounted, and never on a roof or a floor above grade; a location map is required if the disconnect is not co-located with the meter.

What the utility wants on top 90%

Yes -- PG&E's own Distribution Interconnection Handbook document (Greenbook doc 060559, 'Disconnect Switch Requirements for Distributed Generation Customers,' Rev. #07, approved 25 Mar 2022) requires a permanently attached label reading e.g. 'UTILITY AC DISCONNECT SWITCH,' engraved phenolic or ANSI Z535.4-compliant, minimum 3/8" all-capital lettering -- beyond and in addition to the AHJ's own three signs (q38).

Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.

Their website
Average approval time — application to PTO

From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.

About this authority
Type
County
County
Mendocino County
Regions served
19
Regions covered
Albion · county
Anchor Bay · county
Boonville · county
Brooktrails · county
Calpella · county
Caspar · county
Cleone · county
Comptche · county
Covelo · county
Hopland · county
Laytonville · county
Leggett · county
Little River · county
Manchester · county
Mendocino County · county
Philo · county
Potter Valley · county
Redwood Valley · county
Talmage · county
Solar Requirements
Notes
Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division --- Fetch failed: HTTPError: 403 Client Error: Forbidden for url: https://www.mendocinocounty.gov/departments/planning-building-services/building-division
Authority Contact
Address
860 N. Bush St, Ukiah, CA 95482
Main Phone
(707) 234-6650
Building Department
Department
Planning & Building Services — Building Division
Direct Phone
(707) 234-6650
Portal Software
eTRAKiT
Booking & Scheduling
Preferred channel
online
Book in advance
next business day
Notes
Schedule final solar inspections online via the eTRAKiT portal (etrakit.mendocinocounty.org/etrakit3/) — use the "Schedule" function under the Inspections tab. Alternatively, call by 3:00 PM the day before: Ukiah/inland office (707) 234-6650 or Fort Bragg/coastal office (707) 961-2677. Have permit number and property address ready. Inspections are scheduled for the next business day. To check which days inspectors serve a specific area, use the Site Info tab in eTRAKiT. Two office locations: Ukiah (860 N. Bush St) and Fort Bragg (120 W. Fir St); both open Mon–Fri 8 AM–5 PM. Verify inspection timeframe by calling 8–9 AM the day of. County also offers CalApp Solar for online solar permit applications. (collected Jul 2026)
