Stanislaus County
State of California
Stanislaus County is a county authority in the State of California, covering 25 regions, serving 552,878 residents. 348 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined - one 'Solar Permit' record in the County's Accela portal covers both building and electrical aspects Q4 Plan review — Instant/automated for the SolarAPP+ track ('Stanislaus County Building Permit Services and SolarAPP+ provide instant PV Solar Plan review for Residential Rooftop… Q18 Where you file — Accela Citizen Access (ACA) Q20
- Permit required
- Yes95% source
- What it costs
- $500 base (0-15 kW) for a residential roof-mount system, plus $16.90 for each kW over 15 kW; $798 base for a residential ground-mount system, same per-kW add-on;78% source
- Plan review turnaround
- Instant/automated for the SolarAPP+ track ('Stanislaus County Building Permit Services and SolarAPP+ provide instant PV Solar Plan review for Residential Rooftop systems');70% source
- Key document
- utility/portal spec cited by 8 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes, for the unincorporated area of Stanislaus County only. Modesto, Turlock, Ceres, Waterford, Hughson, Oakdale, Riverbank, Ripon, Newman, Patterson are separate incorporated AHJs. 92% · department page
- What does this authority permit itself, and what does it delegate? Both 88% · department page
- Is a permit required for a residential rooftop PV system? Yes 95% · department page
- Is there a separate electrical permit, or is it combined? Combined - one 'Solar Permit' record in the County's Accela portal covers both building and electrical aspects 80% · department page
- Is a HOA or architectural approval required first? No - not required by the County itself for a building permit (private HOA CC&Rs are a separate matter and are pre-empted from blocking solar under state Civil Code §714, independent of County process) 68% · zoning ordinance
- Is there a historic-district review? No for the vast majority of the unincorporated county; Yes for parcels within the County's Historical Site (H-S) combining zoning district (limited to Knights Ferry and La Grange), where any use 'not listed' in the district's permitted-use sections - which would include solar - requires a Historical Site Permit and a public hearing before a 5-person Planning Commission subcommittee 65% · zoning ordinance
- Is a wind or windstorm certification required? No 68% · zoning ordinance
- Is a Specific Use Permit or Council approval ever required? Rarely - only within the Historical Site (H-S) combining district (Knights Ferry/La Grange) catch-all use permit process described in q25, or if a ground-mount system exceeds standard accessory-structure setback/height allowances elsewhere in the county and needs a variance/use permit 55% · zoning ordinance
- Is there a system-size cap on residential generation? No County zoning size cap found for residential PV; the applicable statewide cap comes from the Net Energy Metering program at the utility level (MID's handbook: 'systems...greater than 1-megawatt are subject to a capacity charge') 55% · zoning ordinance
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either - a licensed contractor (any class holding a CSLB license, not restricted to 'electrician') may pull the permit; SolarAPP+ track requires a licensed contractor, but the standard (non-SolarAPP+) track also allows an owner-builder per the general building-permit rule 65% · department page
- Must the contractor be registered with this authority before applying? No - no evidence of a separate County contractor-registration step; the permit application only asks for the state CSLB license number 55% · permit application form
- Is a homeowner permitted to self-install and self-permit? Yes, on the standard (non-SolarAPP+) track; No on the SolarAPP+ track 65% · department page
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Site/plot plan, single-line electrical diagram, equipment cut sheets (module/inverter/battery), and (for new construction contexts) the same structural/foundation/framing package as any SFR permit, with a 'Photovoltaic (Solar) if required' line item; via SolarAPP+: the NREL SolarAPP+ Approval Document plus County application 75% · published checklist
- How many copies, and in what format? Three sets of plans (paper, ¼" scale minimum on 11x17 or larger) plus two sets of supporting calculations for in-person/paper submittal; or a single bookmarked PDF (all plan sheets combined, each supporting document separate) for online submittal via Accela 80% · published checklist
- Is a site plan required, and what must it show? Yes - complete site/plot plan showing the entire parcel, dimensions, location of proposed work, easements, setbacks, all existing structures, driveway, well/septic locations and a north arrow; for solar specifically, MID's spec (used as the model for what county reviewers expect on the accompanying site diagram) calls for panel/inverter layout, metering, disconnects, placarding, and obstructions 70% · published checklist
- Is a one-line / three-line diagram required? Yes 75% · utility/portal spec
- Are string and conductor calculations required? Yes, implicitly - SolarAPP+'s automated compliance engine checks conductor/string sizing against NEC ampacity and voltage-drop rules as part of its code-compliance pass 55% · department page
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? Accela Citizen Access (ACA) 92% · portal landing page
- Can the whole application be completed online? Yes, largely - design submittal (SolarAPP+), application, document upload, fee payment and inspection scheduling are all done online via SolarAPP+ + Accela Citizen Access, though inspections may also be requested by phone 78% · department page
- What does a residential solar permit cost? $500 base (0-15 kW) for a residential roof-mount system, plus $16.90 for each kW over 15 kW; $798 base for a residential ground-mount system, same per-kW add-on; additional review fees from other departments may apply 78% · fee schedule
- How is the fee calculated? Per kW (flat base fee for 0-15 kW, then a fixed additional cost per kW above 15 kW) 78% · fee schedule
- Is there a separate plan-check fee? No separate plan-check line item for solar - the base/per-kW fee in the Solar Energy System Fees schedule appears to be all-in; the general Building Permit Fees schedule (July 2026) shows plan-review as a separate hourly-rate item but does not reference solar 55% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? Instant/automated for the SolarAPP+ track ('Stanislaus County Building Permit Services and SolarAPP+ provide instant PV Solar Plan review for Residential Rooftop systems'); no fixed business-day turnaround is published for the standard (non-SolarAPP+) plan-check track 70% · department page
- How long is an issued permit valid before it expires? Not confirmed as County-specific; California's adopted model code default (CBC/CRC Section 105.5) is 180 days, and no local amendment to permit-expiration was identified among the amendments discussed in the County's own 2025 Title 24 adoption staff report 50% · board agenda / staff report
- Which utility handles interconnection here? Varies by parcel location: Modesto Irrigation District (MID), Turlock Irrigation District (TID), or Pacific Gas & Electric (PG&E) - do not resolve to a single utility 72% · utility/LAFCO service-area document
- Where does the utility sit in the sequence? After permit - the utility's final interconnection inspection and Permission-to-Operate happen only after the County issues the final, signed-off building permit inspection 78% · utility DG manual
28 questions answered against Stanislaus County’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes, for the unincorporated area of Stanislaus County only. Modesto, Turlock, Ceres, Waterford, Hughson, Oakdale, Riverbank, Ripon, Newman, Patterson are separate incorporated AHJs.
Why the confidence is not higherCounty's own building permit page identifies Planning & Community Development as the issuing department; corroborated independently by MID's Electric Service Guide listing 'Stanislaus County Building Department' as a distinct governing authority alongside each incorporated city.
department page checked 2026-08-30 https://www.stancounty.com/planning/apply-bp.shtm
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherPlanning & Community Development's Building Permit Services Division issues both the building and electrical permit/inspection for solar (one combined 'Solar Permit' record type in Accela); no separate agency holds electrical.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherCounty states a permit is required for all new construction, additions, alterations, or upgrades; SolarAPP+ and standard building-permit tracks both require a permit for residential rooftop PV.
department page checked 2026-08-30 https://www.stancounty.com/planning/apply-bp.shtm
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined - one 'Solar Permit' record in the County's Accela portal covers both building and electrical aspects
Why the confidence is not higherSolarAPP+ workflow has the applicant select a single 'Solar Permit with SolarAPP+' record type; no separate electrical-only permit process is described for solar.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either - a licensed contractor (any class holding a CSLB license, not restricted to 'electrician') may pull the permit; SolarAPP+ track requires a licensed contractor, but the standard (non-SolarAPP+) track also allows an owner-builder per the general building-permit rule
Why the confidence is not higherapply-bp.shtm states 'the owner of a property or a licensed contractor' may obtain a permit generally; SolarAPP+ page states 'Licensed contractors only' for that specific expedited track and lists 'Homeowner/Builder installed PV solar systems' as not qualifying for SolarAPP+.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
No - no evidence of a separate County contractor-registration step; the permit application only asks for the state CSLB license number
Why the confidence is not higherNeither apply-bp.shtm nor the building permit application PDF describe a pre-registration step for contractors beyond providing license number/class on the application form; absence checked on the application form and department page, not on every County page.
permit application form checked 2026-08-30 https://www.stancounty.com/planning/forms/building-permit-app.pdf
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes, on the standard (non-SolarAPP+) track; No on the SolarAPP+ track
Why the confidence is not higherapply-bp.shtm: 'the owner of a property...may obtain a building permit' (no contractor requirement stated); SolarAPP+ page explicitly excludes 'Homeowner/Builder installed PV solar systems' from that specific expedited track.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q8 What documents make up a complete submittal? Core Submittal package
Site/plot plan, single-line electrical diagram, equipment cut sheets (module/inverter/battery), and (for new construction contexts) the same structural/foundation/framing package as any SFR permit, with a 'Photovoltaic (Solar) if required' line item; via SolarAPP+: the NREL SolarAPP+ Approval Document plus County application
Why the confidence is not higherCounty's 'Residential Paper Plan Submittal Checklist per AB 2234 and GC 65913.3' lists 'Photovoltaic (Solar) if required' within the standard site-plan submittal set; this checklist is written primarily for new SFR/ADU construction, so a stand-alone retrofit solar permit likely needs a subset (site plan + single-line + cut sheets) rather than the full structural package - the document does not separately break this out.
published checklist checked 2026-08-30 https://www.stancounty.com/planning/guidelines/Application-and-Plan-Submittal-Check-List.pdf
Q9 How many copies, and in what format? Submittal package
Three sets of plans (paper, ¼" scale minimum on 11x17 or larger) plus two sets of supporting calculations for in-person/paper submittal; or a single bookmarked PDF (all plan sheets combined, each supporting document separate) for online submittal via Accela
Why the confidence is not higherDirectly quoted from the County's own AB 2234/GC 65913.3 submittal checklist; this is the general residential rule, not confirmed as solar-specific.
published checklist checked 2026-08-30 https://www.stancounty.com/planning/guidelines/Application-and-Plan-Submittal-Check-List.pdf
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes - complete site/plot plan showing the entire parcel, dimensions, location of proposed work, easements, setbacks, all existing structures, driveway, well/septic locations and a north arrow; for solar specifically, MID's spec (used as the model for what county reviewers expect on the accompanying site diagram) calls for panel/inverter layout, metering, disconnects, placarding, and obstructions
Why the confidence is not higherSite-plan content quoted from the County's own submittal checklist (general residential rule); the solar-specific site-diagram detail comes from MID's Electric Service Guide, a neighboring document rather than the County's own solar-specific checklist, which does not exist as a separate document.
published checklist checked 2026-08-30 https://www.stancounty.com/planning/guidelines/Application-and-Plan-Submittal-Check-List.pdf
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherSolarAPP+'s automated review requires a single-line diagram as part of its eligibility/design package; MID and TID interconnection guides both independently require an approved single-line diagram before metering equipment is installed.
utility/portal spec checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q12 Are string and conductor calculations required? Drawings & calculations
Yes, implicitly - SolarAPP+'s automated compliance engine checks conductor/string sizing against NEC ampacity and voltage-drop rules as part of its code-compliance pass
Why the confidence is not higherInferred from SolarAPP+'s published purpose ('automated web-based design review system that checks to ensure proposed systems comply with current California building, electrical, and fire codes'); the County does not publish its own separate string-calculation requirement document.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Nothing published by this authority.
Where we lookedCounty's AB2234/GC 65913.3 submittal checklist (which requires structural calcs 'if applicable, stamped and signed by a registered design professional' but gives no numeric threshold), apply-bp.shtm, and SolarAPP+ eligibility page
https://www.stancounty.com/planning/guidelines/Application-and-Plan-Submittal-Check-List.pdf
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedSame submittal checklist and SolarAPP+ eligibility page as q13 - no electrical PE stamp threshold specific to solar was stated anywhere found
https://www.stancounty.com/planning/guidelines/Application-and-Plan-Submittal-Check-List.pdf
Q15 What does a residential solar permit cost? Core Fees
$500 base (0-15 kW) for a residential roof-mount system, plus $16.90 for each kW over 15 kW; $798 base for a residential ground-mount system, same per-kW add-on; additional review fees from other departments may apply
Why the confidence is not higherSolar Energy System Fees PDF is dated July 2024 and remains the live link off the current fees.shtm page; the County's separate July-2026 general Building Permit Fees schedule contains no 'solar' line items, so the 2024 solar-specific sheet is still the operative fee document as of this run, not superseded.
fee schedule checked 2026-08-30 https://www.stancounty.com/planning/documents/2024-solar-fee-estimates.pdf
Q16 How is the fee calculated? Core Fees
Per kW (flat base fee for 0-15 kW, then a fixed additional cost per kW above 15 kW)
Why the confidence is not higherDirectly read from the extracted PDF text (base + per-kW-over-15 structure), same source as q15.
fee schedule checked 2026-08-30 https://www.stancounty.com/planning/documents/2024-solar-fee-estimates.pdf
Q17 Is there a separate plan-check fee? Fees
No separate plan-check line item for solar - the base/per-kW fee in the Solar Energy System Fees schedule appears to be all-in; the general Building Permit Fees schedule (July 2026) shows plan-review as a separate hourly-rate item but does not reference solar
Why the confidence is not higherInference from the absence of a distinct plan-check line in the solar fee PDF and the absence of any 'solar' reference in the general fee schedule; not confirmed by a direct statement that solar plan review is bundled.
fee schedule checked 2026-08-30 https://www.stancounty.com/planning/documents/Building_Fees/building-fees-2026.pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Instant/automated for the SolarAPP+ track ('Stanislaus County Building Permit Services and SolarAPP+ provide instant PV Solar Plan review for Residential Rooftop systems'); no fixed business-day turnaround is published for the standard (non-SolarAPP+) plan-check track
Why the confidence is not higherDirect quote from the County's SolarAPP+ page for the instant-review claim; standard-track turnaround was looked for on apply-bp.shtm and the interactive permit guide and is not stated as a day count on either.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q19 How long is an issued permit valid before it expires? Timeline & validity
Not confirmed as County-specific; California's adopted model code default (CBC/CRC Section 105.5) is 180 days, and no local amendment to permit-expiration was identified among the amendments discussed in the County's own 2025 Title 24 adoption staff report
Why the confidence is not highereCode360 (which hosts Stanislaus County Code Title 16) 403'd on every route tried (direct curl with iccsafe.org Referer, WebFetch) so the local ordinance text itself could not be read; this figure is the statewide default the County adopted 2025 CCR Title 24 without amendment on this point, per its own board staff report, which lists only agricultural-building classification and Measure X sewage standards as substantive/administrative amendments.
board agenda / staff report checked 2026-08-30 https://www.stancounty.com/bos/agenda/2025/20251118/PH02.pdf

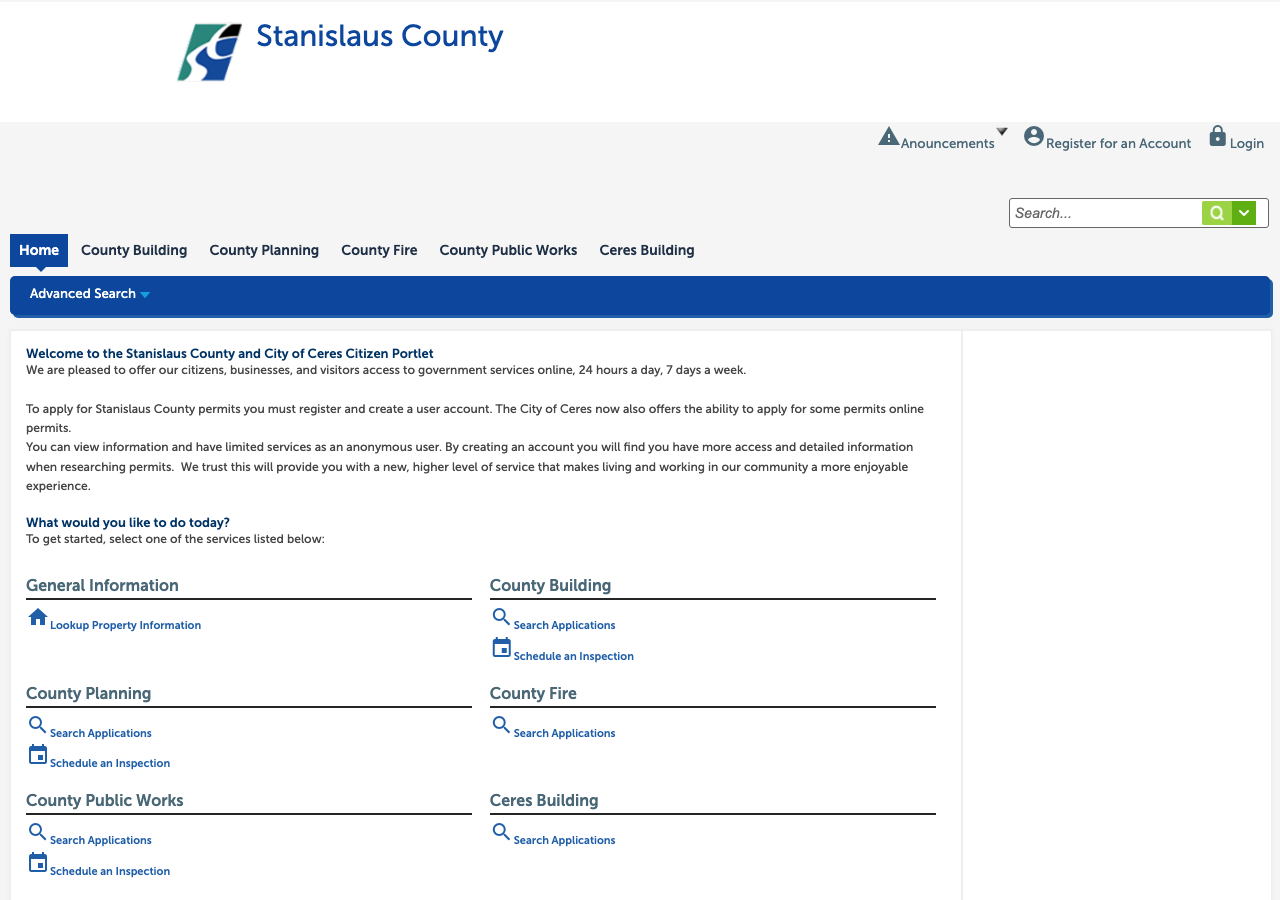

Q20 Which permit portal does this authority use? Core Portal & process
Accela Citizen Access (ACA)
Why the confidence is not higherPortal landing page directly linked from the department's permit pages and the SolarAPP+ workflow.
portal landing page checked 2026-08-30 https://aca-prod.accela.com/STANCO/Default.aspx
Q21 Can the whole application be completed online? Core Portal & process
Yes, largely - design submittal (SolarAPP+), application, document upload, fee payment and inspection scheduling are all done online via SolarAPP+ + Accela Citizen Access, though inspections may also be requested by phone
Why the confidence is not higherDirectly described step-by-step on the County's SolarAPP+ page: submit design to SolarAPP+, complete application and pay fee in Citizen Access Portal, schedule inspection via portal or phone (209-525-7550).
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q22 Which utility handles interconnection here? Core Utility interconnection
Varies by parcel location: Modesto Irrigation District (MID), Turlock Irrigation District (TID), or Pacific Gas & Electric (PG&E) - do not resolve to a single utility
Why the confidence is not higherMID's own Electric Service Guide lists 'Stanislaus County Building Department' as an AHJ within its territory (confirming unincorporated pockets served by MID); a Stanislaus LAFCO Municipal Service Review of TID states TID's service area includes the unincorporated communities of Crows Landing and Diablo Grande; the remainder of the unincorporated county (e.g. areas around Knights Ferry, Denair, Keyes) falls in PG&E's territory by elimination. No single county-wide utility map was found; this is triangulated from the two irrigation districts' own documents plus PG&E's residual coverage, not a ZIP-code lookup.
utility/LAFCO service-area document checked 2026-08-30 https://www.stanislauslafco.org/PDF/MSR/Districts/TID.pdf
Q23 Where does the utility sit in the sequence? Core Utility interconnection
After permit - the utility's final interconnection inspection and Permission-to-Operate happen only after the County issues the final, signed-off building permit inspection
Why the confidence is not higherMID's Electric Service Guide step 5: 'Once the project has been completed and inspected by the local governing authority...MID's receipt of the final, signed-off permit initiates the necessary MID Interconnection Inspection.' TID's guidelines similarly require the TID field inspection to pass before metering equipment is installed. Application to the utility can begin in parallel with the county permit, but the utility's own inspection/energization step is sequenced after the county's final sign-off.
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No - not required by the County itself for a building permit (private HOA CC&Rs are a separate matter and are pre-empted from blocking solar under state Civil Code §714, independent of County process)
Why the confidence is not higherNeither the zoning ordinance (Title 21, full-text searched with 'setback' as a working positive control and 'zzqqx' as a fabricated control that returned zero hits) nor apply-bp.shtm/solarapp.shtm mention an HOA or architectural-review step as a County permitting prerequisite.
zoning ordinance checked 2026-08-30 https://www.stancounty.com/planning/forms/stanislaus-county-code-title-21-zoning-ordinance.pdf
Q25 Is there a historic-district review? Overlays & special cases
No for the vast majority of the unincorporated county; Yes for parcels within the County's Historical Site (H-S) combining zoning district (limited to Knights Ferry and La Grange), where any use 'not listed' in the district's permitted-use sections - which would include solar - requires a Historical Site Permit and a public hearing before a 5-person Planning Commission subcommittee
Why the confidence is not higherRead directly from Title 21, Chapter 21.44 (Historical Site District), Sections 21.44.020-21.44.040; solar is not separately enumerated as a listed/exempt use in the sections read, so it would fall under the 21.44.040(A) catch-all requiring a Historical Site Permit within that narrow overlay district only.
zoning ordinance checked 2026-08-30 https://www.stancounty.com/planning/forms/stanislaus-county-code-title-21-zoning-ordinance.pdf
Q26 Is a wind or windstorm certification required? Overlays & special cases
No
Why the confidence is not higherTitle 21 was full-text searched for 'photovoltaic', 'renewable energy', and 'solar' (positive control 'setback' = 66 hits, fabricated control 'zzqqx' = 0 hits, confirming the search worked); the zoning ordinance addresses a 'Small Wind Energy System' as a distinct accessory use with its own siting rules, but there is no wind/windstorm certification requirement tied to solar PV, which is a Gulf Coast (e.g. Texas TDI) concept largely inapplicable in inland California.
zoning ordinance checked 2026-08-30 https://www.stancounty.com/planning/forms/stanislaus-county-code-title-21-zoning-ordinance.pdf
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Rarely - only within the Historical Site (H-S) combining district (Knights Ferry/La Grange) catch-all use permit process described in q25, or if a ground-mount system exceeds standard accessory-structure setback/height allowances elsewhere in the county and needs a variance/use permit
Why the confidence is not higherInferred from the H-S district text (21.44.040) and general accessory-structure standards in Title 21; no solar-specific Use Permit trigger was found elsewhere in the zoning ordinance.
zoning ordinance checked 2026-08-30 https://www.stancounty.com/planning/forms/stanislaus-county-code-title-21-zoning-ordinance.pdf
Q28 Is there a system-size cap on residential generation? Overlays & special cases
No County zoning size cap found for residential PV; the applicable statewide cap comes from the Net Energy Metering program at the utility level (MID's handbook: 'systems...greater than 1-megawatt are subject to a capacity charge')
Why the confidence is not higherTitle 21 full-text search (with working controls, see q26) found no residential-solar system-size cap; the 1 MW figure found is a utility/NEM program threshold from MID's handbook, not a County zoning limit, and is noted here only because no County-level cap exists to report instead.
zoning ordinance checked 2026-08-30 https://www.stancounty.com/planning/forms/stanislaus-county-code-title-21-zoning-ordinance.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC (adopted as Part 3 of the 2025 California Electrical Code, itself part of the 2025 CCR Title 24 cycle), effective statewide and in Stanislaus County from 1 Jan 2026 85% · adopting ordinance / board staff report
- Which building code edition is in force? 2025 California Building Code (CCR Title 24, Part 2), effective 1 Jan 2026, adopted by County ordinance amending Title 16 of the Stanislaus County Code 88% · adopting ordinance / board staff report
- Which fire code edition is in force? 2025 California Fire Code (CCR Title 24, Part 9), adopted separately by the County's Fire Warden's Office rather than by Planning & Community Development's Title 16 ordinance 55% · board agenda / secondary (eCode360 blocked)
- Are there local amendments to any of the above? Yes - carried-forward local amendments include Measure X primary/secondary sewage-treatment standards (in Chapter 16.10, substantive, requires a BSC findings filing) and agricultural building classifications (administrative); going forward, CA AB 130 (2025) bars the County from adopting any NEW more-restrictive residential amendment from 1 Oct 2025 to 1 Jun 2031 except a narrow grandfather for standards in effect on 30 Sep 2025 85% · board agenda / staff report
- What is the installation judged against? The adopted 2025 CCR Title 24 (California Building/Residential/Electrical/Energy/Fire Codes) as locally amended; for the SolarAPP+ track, judged by SolarAPP+'s automated compliance engine which is built to the same state code set 78% · department page
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? Governed by the adopted state Fire/Residential Code roof-access-pathway and ridge-setback provisions (e.g. CRC R324.6/CFC 605.11.3 series); no Stanislaus-specific amendment to these provisions was found 55% · inference from adopting ordinance (eCode360 blocked)
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Yes - rapid shutdown per NEC 690.12, as adopted via the 2023 NEC (2025 CEC) 80% · inference from adopted code edition
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Labeling required at the dedicated PV breaker, AC disconnect switch(es), solar circuit conduits, and main service panel per NEC 690.12/690.13/690.53/690.56 as adopted; MID/TID additionally require utility-specific placards (see q42) 75% · utility DG manual
- Does the authority specify placard wording of its own? No - the County itself does not publish its own placard wording beyond referencing the adopted NEC/CFC; MID and TID (utility level) do specify their own wording/sample placards 55% · department page (absence)
- Does it specify letter height, colour or material? Not specified by the County directly; within MID's territory, MID requires identifying markings 'impressed into or raised from a tag of Plastic Laminate, aluminum, brass or other non-ferrous metal with a minimum of 1/4" letters,' attached with 5-minute epoxy (not rivets/screws), deep/raised enough to survive repainting; TID's guidelines specify no letter-height/material of its own and instead defer to 'NEC rules' 68% · utility DG manual
- Is a site plan / facility map placard required, and what must it show? Yes, conditionally - MID requires an additional placard on the MSP indicating the location of the AC disconnect/generation meter whenever those are separated from the MSP by a gate/fence; TID requires a 'Site map placard on MSP' whenever its optional generation meter is not visible from the MSP 78% · utility DG manual
- Does the UTILITY specify placards beyond the AHJ's? Yes - MID requires 5 distinct placard types (Caution PV & Utility Power, Solar Array AC Disconnect, Utility Use Only AC Disconnect, Solar Production, Solar Breaker) plus a conditional MSP-location placard; TID requires labeling per NEC plus a conditional site-map placard 88% · utility DG manual
- Where must the labels be placed? At the main service panel, the dedicated PV breaker inside the MSP, the AC disconnect switch(es), and the solar-circuit conduits; additionally at the generation meter socket and (conditionally) an MSP-location placard if equipment is separated by a gate/fence (MID) or the generation meter isn't visible from the MSP (TID) 82% · utility DG manual
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Where must the AC disconnect be, relative to the meter? Utility-dependent: within MID territory, the first AC disconnect must be installed within 12 feet and within line of sight of the main service panel, on the same side of any gate/fence obstruction; within TID territory, within 10 feet and line of sight of the MSP, same side of any obstruction 90% · utility DG manual
- Must equipment be on a specific approved list? No County-specific approved-product list; equipment must be UL-listed/NRTL-listed and, for TID, 'all connectors and equipment used in the installation must be UL approved' - a generic listing requirement rather than a proprietary approved list 60% · utility DG manual
- Are batteries permitted, and under what conditions? Yes, conditionally - per the adopted 2025/2026 California Fire Code ESS provisions (fire-code adoption confirmed separately by the County Fire Warden's Office, q31); at the utility level, MID requires ESS to be 'configured to provide backup power for the customer in case of an outage or peak shaving only' with no export to the grid, and TID requires the battery to be operable and demonstrated non-backfeeding at the time of its field inspection, with a contractor representative present 75% · utility DG manual
- Is there a separate ESS permit or inspection? No separate County ESS permit identified - SolarAPP+'s 'PV+ST' eligibility track reviews PV and storage together in one permit; a stand-alone ESS addition to an existing PV system without a new PV component is explicitly excluded from SolarAPP+ and would need the standard (non-SolarAPP+) permit path, but no separate 'ESS permit' document was found 65% · department page
- Is a ground mount treated as a structure? Yes - ground-mount systems are explicitly excluded from the expedited SolarAPP+ track and must go through the standard building-permit/plan-check process, and the County's own fee schedule prices 'Residential Ground Mount System' as a separate, higher-base-fee category from roof-mount 85% · fee schedule / department page
20 questions answered against Stanislaus County’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC (adopted as Part 3 of the 2025 California Electrical Code, itself part of the 2025 CCR Title 24 cycle), effective statewide and in Stanislaus County from 1 Jan 2026
Why the confidence is not higherCounty's own Board of Supervisors agenda item (Nov 18, 2025) documents adoption by reference of the entire 2025 CCR Title 24 (all parts except 7 and 9) effective 1 Jan 2026, attaching the state Building Standards Commission's Information Bulletin confirming the same statewide effective date; the 2025 CEC (Part 3) is independently confirmed (via ICC/up.codes product pages) to be based on NFPA 70, the 2023 NEC.
adopting ordinance / board staff report checked 2026-08-30 https://www.stancounty.com/bos/agenda/2025/20251118/PH02.pdf
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (CCR Title 24, Part 2), effective 1 Jan 2026, adopted by County ordinance amending Title 16 of the Stanislaus County Code
Why the confidence is not higherDirectly quoted from the County's own Board of Supervisors public-hearing staff report (Nov 18, 2025) waiving second reading of the ordinance adopting 2025 CCR Title 24 by reference into Title 16.
adopting ordinance / board staff report checked 2026-08-30 https://www.stancounty.com/bos/agenda/2025/20251118/PH02.pdf
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code (CCR Title 24, Part 9), adopted separately by the County's Fire Warden's Office rather than by Planning & Community Development's Title 16 ordinance
Why the confidence is not higherThe County's own Nov 2025 staff report states Part 9 (Fire Code) and Part 7 (WUI Code) are carved out of the Planning Dept's Title 16 ordinance and 'will be presented for adoption by Stanislaus County Fire Warden's Office' - confirmed adoption text itself (Chapter 16.55 wording, appendix list) could only be read via a search-engine snippet, since eCode360 403'd on every route tried (curl with iccsafe.org Referer, WebFetch); confidence capped for that reason.
board agenda / secondary (eCode360 blocked) checked 2026-08-30 https://www.stancounty.com/bos/agenda/2025/20251118/PH02.pdf
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes - carried-forward local amendments include Measure X primary/secondary sewage-treatment standards (in Chapter 16.10, substantive, requires a BSC findings filing) and agricultural building classifications (administrative); going forward, CA AB 130 (2025) bars the County from adopting any NEW more-restrictive residential amendment from 1 Oct 2025 to 1 Jun 2031 except a narrow grandfather for standards in effect on 30 Sep 2025
Why the confidence is not higherDirectly quoted/read from the County's own Nov 2025 board staff report, which discusses both the carried-forward local amendments and the AB 130 moratorium by section number (H&SC §§17958, 17958.5, 17958.7).
board agenda / staff report checked 2026-08-30 https://www.stancounty.com/bos/agenda/2025/20251118/PH02.pdf
Q33 What is the installation judged against? Core Electrical
The adopted 2025 CCR Title 24 (California Building/Residential/Electrical/Energy/Fire Codes) as locally amended; for the SolarAPP+ track, judged by SolarAPP+'s automated compliance engine which is built to the same state code set
Why the confidence is not higherCombines the adoption confirmed in q29/q30 with SolarAPP+'s stated purpose of checking against 'current California building, electrical, and fire codes'.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedapply-bp.shtm, solarapp.shtm, and the County's Nov 2025 Title 24 adoption staff report (which lists its local amendments by topic and does not mention service-upgrade or busbar sizing); eCode360 (County Code Title 16, Chapter 16.05/16.15) 403'd on every route tried (curl with iccsafe.org Referer, WebFetch) so the ordinance text itself could not be checked directly
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedSame County documents as q34; no County-specific mounting/attachment-spacing rule beyond the adopted CBC/CRC was found, and eCode360 was inaccessible to confirm the absence directly in Chapter 16.05
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Governed by the adopted state Fire/Residential Code roof-access-pathway and ridge-setback provisions (e.g. CRC R324.6/CFC 605.11.3 series); no Stanislaus-specific amendment to these provisions was found
Why the confidence is not higherCould not confirm directly against County Code Chapter 16.55 text because eCode360 403'd on every route tried; this is the state-adopted default per q29-31, not a locally-verified figure.
inference from adopting ordinance (eCode360 blocked) checked 2026-08-30 https://www.stancounty.com/bos/agenda/2025/20251118/PH02.pdf
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Yes - rapid shutdown per NEC 690.12, as adopted via the 2023 NEC (2025 CEC)
Why the confidence is not higherFollows directly from the confirmed NEC edition in q29; no County amendment to 690.12 was found (and could not be checked directly due to eCode360 block).
inference from adopted code edition checked 2026-08-30 https://www.stancounty.com/bos/agenda/2025/20251118/PH02.pdf
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Labeling required at the dedicated PV breaker, AC disconnect switch(es), solar circuit conduits, and main service panel per NEC 690.12/690.13/690.53/690.56 as adopted; MID/TID additionally require utility-specific placards (see q42)
Why the confidence is not higherTID's Solar Installation Guidelines explicitly cross-reference 'NEC 690.14.C.2 and NEC 690.52' for required labeling at these exact locations; MID's Electric Service Guide independently lists the same set of required placards (Section G and Figures 1-5).
utility DG manual checked 2026-08-30 https://www.tid.org/wp-content/uploads/2023/solar-installation-guidelines.pdf
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No - the County itself does not publish its own placard wording beyond referencing the adopted NEC/CFC; MID and TID (utility level) do specify their own wording/sample placards
Why the confidence is not higherNo County-published solar placard-wording document was found (checked apply-bp.shtm, solarapp.shtm, handouts.shtm); MID's ESG (Figures 1-5) and TID's guidelines each specify exact wording at the utility level, answered separately at q42.
department page (absence) checked 2026-08-30 https://www.stancounty.com/planning/handouts.shtm
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Not specified by the County directly; within MID's territory, MID requires identifying markings 'impressed into or raised from a tag of Plastic Laminate, aluminum, brass or other non-ferrous metal with a minimum of 1/4" letters,' attached with 5-minute epoxy (not rivets/screws), deep/raised enough to survive repainting; TID's guidelines specify no letter-height/material of its own and instead defer to 'NEC rules'
Why the confidence is not higherDirectly quoted from MID's Electric Service Guide, Section G ('Solar Placarding Requirement'); confirmed the utility-level answer varies (MID has specific dimensions/material, TID does not) rather than flattening to one figure.
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes, conditionally - MID requires an additional placard on the MSP indicating the location of the AC disconnect/generation meter whenever those are separated from the MSP by a gate/fence; TID requires a 'Site map placard on MSP' whenever its optional generation meter is not visible from the MSP
Why the confidence is not higherDirectly quoted from both MID's ESG (Section H) and TID's Solar Installation Guidelines (Section 4.a.iv); ties to NEC 705.10 general placard/directory requirement referenced in both.
utility DG manual checked 2026-08-30 https://www.tid.org/wp-content/uploads/2023/solar-installation-guidelines.pdf
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Yes - MID requires 5 distinct placard types (Caution PV & Utility Power, Solar Array AC Disconnect, Utility Use Only AC Disconnect, Solar Production, Solar Breaker) plus a conditional MSP-location placard; TID requires labeling per NEC plus a conditional site-map placard
Why the confidence is not higherDirectly documented with figure numbers/sections in both MID's ESG and TID's Solar Installation Guidelines - both go beyond a generic NEC citation with utility-specific requirements.
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Q43 Where must the labels be placed? Core Labels Signage & labelling
At the main service panel, the dedicated PV breaker inside the MSP, the AC disconnect switch(es), and the solar-circuit conduits; additionally at the generation meter socket and (conditionally) an MSP-location placard if equipment is separated by a gate/fence (MID) or the generation meter isn't visible from the MSP (TID)
Why the confidence is not higherDirectly quoted/compiled from MID's ESG Section G and TID's Solar Installation Guidelines Section 4.
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Q44 Must equipment be on a specific approved list? Equipment listing
No County-specific approved-product list; equipment must be UL-listed/NRTL-listed and, for TID, 'all connectors and equipment used in the installation must be UL approved' - a generic listing requirement rather than a proprietary approved list
Why the confidence is not higherNo County document naming a specific approved-equipment list was found; TID's guidelines explicitly state the UL-listing requirement (Section 7.d), which is the closest analog found.
utility DG manual checked 2026-08-30 https://www.tid.org/wp-content/uploads/2023/solar-installation-guidelines.pdf
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, conditionally - per the adopted 2025/2026 California Fire Code ESS provisions (fire-code adoption confirmed separately by the County Fire Warden's Office, q31); at the utility level, MID requires ESS to be 'configured to provide backup power for the customer in case of an outage or peak shaving only' with no export to the grid, and TID requires the battery to be operable and demonstrated non-backfeeding at the time of its field inspection, with a contractor representative present
Why the confidence is not higherMID and TID conditions directly quoted from their respective PDFs; the underlying Fire Code ESS chapter itself could not be read directly due to the eCode360 block noted at q31.
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Q46 Is there a separate ESS permit or inspection? Battery / ESS
No separate County ESS permit identified - SolarAPP+'s 'PV+ST' eligibility track reviews PV and storage together in one permit; a stand-alone ESS addition to an existing PV system without a new PV component is explicitly excluded from SolarAPP+ and would need the standard (non-SolarAPP+) permit path, but no separate 'ESS permit' document was found
Why the confidence is not higherDirectly quoted from the County's SolarAPP+ eligibility list ('Energy storage system projects that do not include a new PV solar system' do not qualify for SolarAPP+); no separate County ESS-permit form or fee line was found in the fee schedule.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q47 Is a ground mount treated as a structure? Core Ground mount
Yes - ground-mount systems are explicitly excluded from the expedited SolarAPP+ track and must go through the standard building-permit/plan-check process, and the County's own fee schedule prices 'Residential Ground Mount System' as a separate, higher-base-fee category from roof-mount
Why the confidence is not higherDirectly quoted from the SolarAPP+ ineligibility list ('Ground mount PV solar systems') and the Solar Energy System Fees PDF, which lists ground-mount at a $798 base vs. $500 for roof-mount, consistent with treatment as a structure subject to standard accessory-structure setback review.
fee schedule / department page checked 2026-08-30 https://www.stancounty.com/planning/documents/2024-solar-fee-estimates.pdf
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Utility-dependent: within MID territory, the first AC disconnect must be installed within 12 feet and within line of sight of the main service panel, on the same side of any gate/fence obstruction; within TID territory, within 10 feet and line of sight of the MSP, same side of any obstruction
Why the confidence is not higherDirectly quoted from MID's Electric Service Guide (Section E) and TID's Solar Installation Guidelines (Section 2.b/c) - two different utilities, two different distances; do not flatten to one figure.
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone or Portal - call (209) 525-7550 or use the Citizen Access Portal 90% · department page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes - the County performs its own final solar inspection through Building Permit Services 82% · department page
- If delegated, to whom? N/A - not delegated; performed by County Building Permit Services staff 78% · department page
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? For a stand-alone retrofit residential PV system, a single final inspection (covering the electrical work, mounting/attachment, and required labeling) is called after installation is complete; where solar is integrated into new-home construction, it follows the standard rough/frame/final sequence in the County's general Building Inspection Information Form 62% · department page / inspection form
- Is a rough-in or mid-roof inspection required? No, not for a stand-alone retrofit system - the County's SolarAPP+ process describes a single inspection request after installation is complete, not a separate rough-in/mid-roof call 58% · department page
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes, for the SolarAPP+ track - 'Print out a hard copy of the submitted SolarAPP+ Approval Document and it will serve as an inspection checklist' 85% · department page
- What must be on site at inspection? The hard-copy SolarAPP+ Approval Document (for that track); for the standard track, the approved plan set/permit card, consistent with the County's general inspection guidance to 'pre-inspect their job and make corrections prior to any inspection requests' 75% · department page
- Does the inspector verify labels and listings? Yes, inferred - the SolarAPP+ Approval Document (which the applicant must print and have on-site) itself functions as an inspection checklist built to verify code-compliant labeling and listed equipment 60% · department page
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- What is issued on pass? Final (a passed final inspection / signed-off permit), which the contractor then forwards to the interconnecting utility to trigger its own interconnection inspection and PTO 75% · utility DG manual
- Who notifies the utility for PTO? Installer - the solar contractor submits the County's passed inspection results directly to the utility (e.g., emailed to pv@mid.org) to request the utility's interconnection inspection and PTO 88% · utility DG manual
- Is there a re-inspection fee? $125.50 for a first re-inspection (general building re-inspection fee, applies to all permit types including solar); $250.00 second re-inspection for the same item; $378.50 third re-inspection for the same item 78% · fee schedule
- How are corrections issued and cleared? For SolarAPP+ projects: the contractor revises the design in SolarAPP+, which reissues a new Approval Document/Inspection Checklist after a fresh automated compliance check, then resubmits it via the Citizen Access Portal (no charge for the first three revisions, $25 per revision after that); for standard-track corrections, the County's general practice is to require pre-inspection correction before calling for re-inspection 65% · department page
14 questions answered against Stanislaus County’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone or Portal - call (209) 525-7550 or use the Citizen Access Portal
Why the confidence is not higherDirectly quoted from the County's SolarAPP+ page, which describes both options for requesting a solar inspection.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedsolarapp.shtm and the County's general Inspection Request/Building Inspection Information Form (24 pages, no notice-lead-time language found)
https://www.stancounty.com/planning/guidelines/Inspection_Request.pdf
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Nothing published by this authority.
Where we lookedSame two documents as q50 - no mention of same-day or AM/PM inspection windows
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes - the County performs its own final solar inspection through Building Permit Services
Why the confidence is not higherInspection is requested directly of the County (phone 209-525-7550 or Citizen Access Portal) and the resulting County-issued 'passed inspection' document is what MID/TID then require to proceed with their own separate interconnection inspection - i.e. the County inspection is the County's own, not performed by or delegated to the utility.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q53 If delegated, to whom? Core Who inspects
N/A - not delegated; performed by County Building Permit Services staff
Why the confidence is not higherSame basis as q52; the utility (MID/TID) performs its own separate interconnection inspection afterward, but that is an additional utility-level inspection, not a delegation of the County's own final building/electrical inspection.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q54 Which inspections are required, and in what order? Core Stages & sequence
For a stand-alone retrofit residential PV system, a single final inspection (covering the electrical work, mounting/attachment, and required labeling) is called after installation is complete; where solar is integrated into new-home construction, it follows the standard rough/frame/final sequence in the County's general Building Inspection Information Form
Why the confidence is not higherInferred from the SolarAPP+ page describing one inspection request after installation, and from the County's general 24-page 'Building Inspection Information Form,' which lists standard new-construction stage codes (110 slab/rough-plumb, 120-123 foundation, 151-155 frame/top-out, etc.) but has no dedicated solar-specific stage code of its own.
department page / inspection form checked 2026-08-30 https://www.stancounty.com/planning/guidelines/Inspection_Request.pdf
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
No, not for a stand-alone retrofit system - the County's SolarAPP+ process describes a single inspection request after installation is complete, not a separate rough-in/mid-roof call
Why the confidence is not higherInferred from the single-inspection description on the SolarAPP+ page; the County's general Inspection Request form does include a mid-roof-adjacent 'Frame/Top Out' stage, but that applies to new construction, not retrofit PV.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q56 Does the inspector verify labels and listings? Core What is checked
Yes, inferred - the SolarAPP+ Approval Document (which the applicant must print and have on-site) itself functions as an inspection checklist built to verify code-compliant labeling and listed equipment
Why the confidence is not higherInferred from the stated purpose of the SolarAPP+ Approval Document/Inspection Checklist and from MID's separate confirmation that its own interconnection inspection checks 'installation of MID required signage (placarding)' - the County's own inspector-level practice was not independently documented beyond this.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q57 Is there a published inspection checklist? Core What is checked
Yes, for the SolarAPP+ track - 'Print out a hard copy of the submitted SolarAPP+ Approval Document and it will serve as an inspection checklist'
Why the confidence is not higherDirect quote from the County's SolarAPP+ Q&A page.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q58 What must be on site at inspection? Core Documents on site
The hard-copy SolarAPP+ Approval Document (for that track); for the standard track, the approved plan set/permit card, consistent with the County's general inspection guidance to 'pre-inspect their job and make corrections prior to any inspection requests'
Why the confidence is not higherSolarAPP+ requirement directly quoted; standard-track document requirement inferred from the County's general Building Inspection Information Form.
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q59 Is there a re-inspection fee? Corrections & re-inspection
$125.50 for a first re-inspection (general building re-inspection fee, applies to all permit types including solar); $250.00 second re-inspection for the same item; $378.50 third re-inspection for the same item
Why the confidence is not higherRead directly from the County's Building Permit Services Fee Schedule effective 18 Jul 2026 ('PROPOSED' column, which has taken effect as of this run's 30 Aug 2026 date); this is a general building re-inspection fee, not confirmed as solar-specific, and is separate from MID's own $250 utility re-inspection fee for a failed interconnection inspection.
fee schedule checked 2026-08-30 https://www.stancounty.com/planning/documents/Building_Fees/building-fees-2026.pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
For SolarAPP+ projects: the contractor revises the design in SolarAPP+, which reissues a new Approval Document/Inspection Checklist after a fresh automated compliance check, then resubmits it via the Citizen Access Portal (no charge for the first three revisions, $25 per revision after that); for standard-track corrections, the County's general practice is to require pre-inspection correction before calling for re-inspection
Why the confidence is not higherSolarAPP+ correction/revision workflow directly quoted from the County's SolarAPP+ page; the standard-track correction process is inferred from general language on the County's Building Inspection Information Form ('Responsibility of the Builder/Homeowner: Pre-inspect their job and make corrections prior to any inspection requests').
department page checked 2026-08-30 https://www.stancounty.com/planning/solarapp.shtm
Q61 What is issued on pass? Core Final sign-off & PTO
Final (a passed final inspection / signed-off permit), which the contractor then forwards to the interconnecting utility to trigger its own interconnection inspection and PTO
Why the confidence is not higherInferred from MID's ESG describing receipt of the County's 'final, signed-off permit' as the trigger for its own next step; no evidence of a separate 'green tag' or CO document specific to solar.
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Installer - the solar contractor submits the County's passed inspection results directly to the utility (e.g., emailed to pv@mid.org) to request the utility's interconnection inspection and PTO
Why the confidence is not higherDirect quote from MID's Electric Service Guide: 'the solar contractor will need to submit the copy of the City/County passed inspection results to pv@mid.org.'
utility DG manual checked 2026-08-30 https://www.mid.org/documents/pv/solar_esg.pdf
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for Stanislaus County against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
Stanislaus County is the authority having jurisdiction 92% confidence
- Holds
- Building and Electrical
- Overridden by
- CA AB 130 (Stats. 2025, Ch. 22) freezes the County's ability to adopt residential amendments more restrictive than the 2025 CCR Title 24 from 1 Oct 2025 to 1 Jun 2031 (grandfathering only its pre-existing Measure X sewage standards); final Permission-to-Operate sits with whichever utility serves the parcel (MID, TID, or PG&E), not the County; the County's Fire Warden's Office (not Planning & Community Development) separately adopts and administers the Fire Code (Title 24 Part 9) for the unincorporated area and county fire districts.
- Why not higher
- The County's Planning & Community Development Department, Building Permit Services Division (1010 10th St, Suite 3400, Modesto), issues the building permit and performs the electrical/structural inspections for solar in the unincorporated area; this is confirmed both on the County's own apply-bp.shtm page and independently in MID's Electric Service Guide, which lists 'Stanislaus County Building Department' (same phone 209-525-6557) alongside separate entries for the City of Modesto, City of Waterford, City of Oakdale, City of Escalon, City of Riverbank and City of Ripon as distinct local governing authorities in its territory -- confirming those incorporated cities (plus Turlock, Ceres, Hughson, Newman, Patterson) are separate AHJs with their own permitting records, and the County's authority is limited to the unincorporated area. The brief's caution about a wrong department did not apply here: building and electrical are not split off to a separate Public Works-style agency in this county.
- Permit required
- Yes95%
- Permit cost
- $500 base (0-15 kW) for a residential roof-mount system, plus $16.90 for each kW over 15 kW; $798 base for a residential ground-mount system, same per-kW add-on;78%
- Plan review
- Instant/automated for the SolarAPP+ track ('Stanislaus County Building Permit Services and SolarAPP+ provide instant PV Solar Plan review for Residential Rooftop systems');70%
- Portal
- Accela Citizen Access (ACA)92%
- Electrical code
- 2023 NEC (adopted as Part 3 of the 2025 California Electrical Code, itself part of the 2025 CCR Title 24 cycle), effective statewide and in Stanislaus County from 1 Jan 202685%
- Own placard wording
- No - the County itself does not publish its own placard wording beyond referencing the adopted NEC/CFC; MID and TID (utility level) do specify their own wording/sample placards55%
- Booking an inspection
- Phone or Portal - call (209) 525-7550 or use the Citizen Access Portal90%
Labels & placards for this authority
Wording 55%
No - the County itself does not publish its own placard wording beyond referencing the adopted NEC/CFC; MID and TID (utility level) do specify their own wording/sample placards
Size, colour & material 68%
Not specified by the County directly; within MID's territory, MID requires identifying markings 'impressed into or raised from a tag of Plastic Laminate, aluminum, brass or other non-ferrous metal with a minimum of 1/4" letters,' attached with 5-minute epoxy (not rivets/screws), deep/raised enough to survive repainting; TID's guidelines specify no letter-height/material of its own and instead defer to 'NEC rules'
Where they go 82%
At the main service panel, the dedicated PV breaker inside the MSP, the AC disconnect switch(es), and the solar-circuit conduits; additionally at the generation meter socket and (conditionally) an MSP-location placard if equipment is separated by a gate/fence (MID) or the generation meter isn't visible from the MSP (TID)
What the utility wants on top 88%
Yes - MID requires 5 distinct placard types (Caution PV & Utility Power, Solar Array AC Disconnect, Utility Use Only AC Disconnect, Solar Production, Solar Breaker) plus a conditional MSP-location placard; TID requires labeling per NEC plus a conditional site-map placard
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
