Town of Hillsborough
San Mateo County
Town of Hillsborough is a city authority in the State of California, serving 11,387 residents. 928 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — 1 to 3 business days for standard-plan submittals Q18 Where you file — eTRAKiT (hills-trk.aspgov.com/eTRAKiT) for standard/traditional plan check; a Symbium-powered automated code-check and permitting pathway under SB 379 for eligible… Q20
- Permit required
- Yes95% source
- What it costs
- $905 flat (Adopted FY 2026-27), line item 'Solar Energy Storage Permit – w/ or w/o BESS'85% source
- Plan review turnaround
- 1 to 3 business days for standard-plan submittals82% source
- Key document
- published checklist cited by 8 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · department page
- What does this authority permit itself, and what does it delegate? Both 90% · adopting ordinance (municipal code, Title 15)
- Is a permit required for a residential rooftop PV system? Yes 95% · published checklist
- Is there a separate electrical permit, or is it combined? Combined 85% · published checklist
- Is a HOA or architectural approval required first? No 88% · state statute
- Is a Specific Use Permit or Council approval ever required? No, not for a standard compliant residential rooftop system 62% · published checklist
- Is there a system-size cap on residential generation? 10 kW AC (CEC rating) or less for the Town's expedited/standard-plan residential solar pathway; larger systems are not barred outright but must go through full engineered plan check rather than the simplified checklist/standard-plan route 85% · published checklist
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 82% · department page
- Must the contractor be registered with this authority before applying? Yes 90% · department page
- Is a homeowner permitted to self-install and self-permit? Yes 85% · department page
-

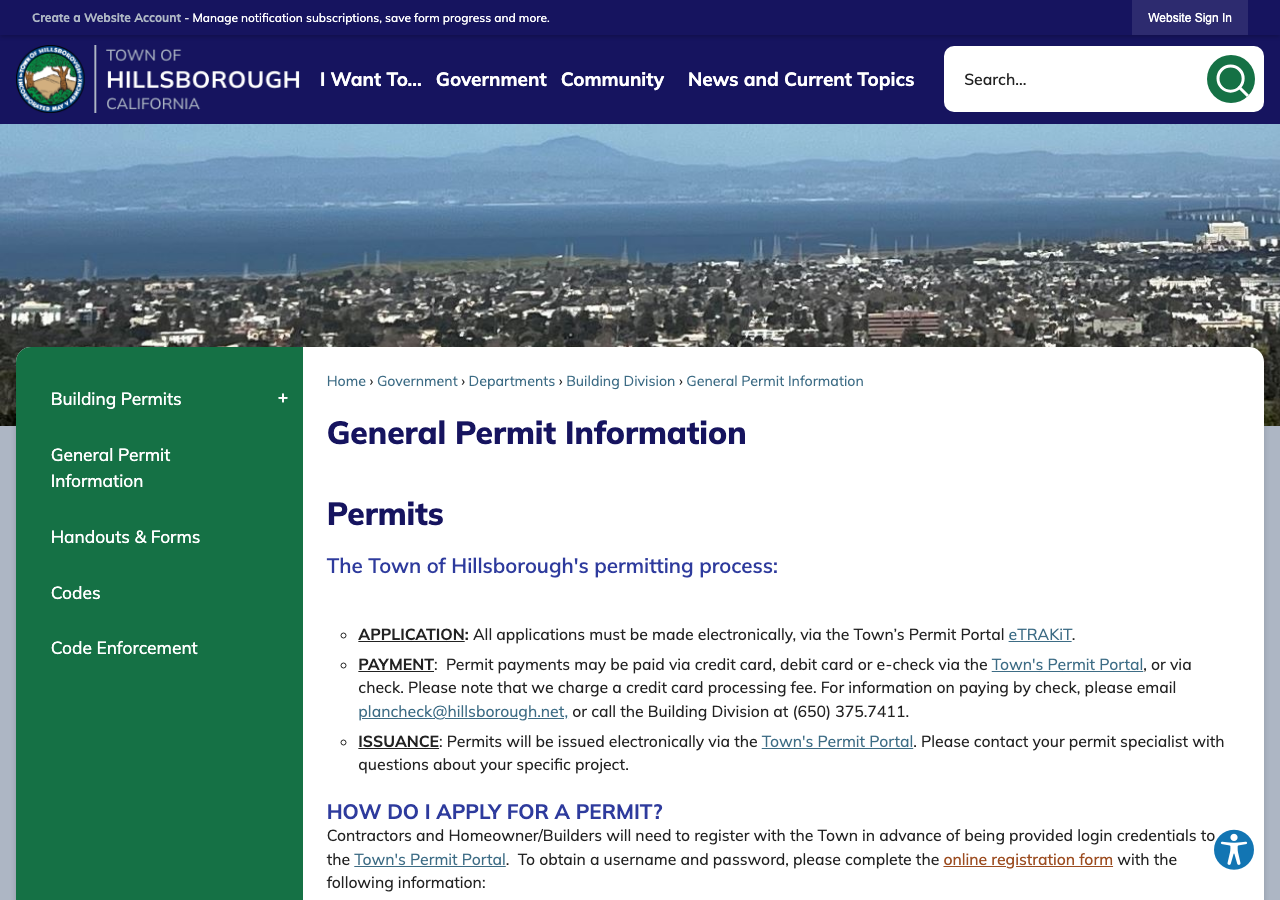

Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Completed building permit application; demonstrated compliance with the Town's solar eligibility checklist; a completed Standard Electrical Plan (or a full electrical plan with one-line diagram, module/string counts, inverter/combiner make-model, grounding/bonding and conductor sizing, and equipment cut sheets if the standard plan isn't used); a roof/site plan showing panel layout, plumbing/mechanical vent clearances, roof access point, code-compliant access pathways, PV fire classification and label locations; and completed expedited Structural Criteria with structural drawings/calculations stamped by a CA-licensed Civil or Structural Engineer 90% · published checklist
- How many copies, and in what format? Applications are now electronic-only via the eTRAKiT permit portal (the Town states it 'remain[s] paperless' and accepts online permits); the older (2015) Solar Check List item H still references '3 sets of plans if hard copies,' which appears superseded by the current all-electronic posture 68% · department page
- Is a site plan required, and what must it show? Yes — a site/roof diagram showing arrangement of panels on the roof, north arrow, lot dimensions, distance from property lines to adjacent buildings/structures, plumbing/mechanical vent clearances, roof access point, access pathways, PV fire classification, and label/marking locations 92% · published checklist
- Is a one-line / three-line diagram required? Yes 95% · published checklist
- Are string and conductor calculations required? Yes 90% · checklist / standard plan template
- Is a structural PE stamp required, and at what threshold? Yes, a structural PE/SE stamp is required — the Town's own submittal requirements call for 'structural drawings and calculations stamped and signed by a California-licensed Civil or Structural Engineer' with no stated kW exemption threshold (required as part of the 'expedited Structural Criteria' package for the same 10 kW pathway that otherwise uses simplified standard plans) 78% · published checklist
- Is an electrical PE stamp required, and at what threshold? No separate electrical PE stamp requirement is stated for solar — the Standard Plan (10 kW or less, one/two-family dwelling) can be completed and signed by the 'Contractor/Engineer' interchangeably; a licensed engineer's stamp is only implicated if the installation falls outside the Standard Plan's scope and requires the 'Comprehensive Standard Plan' or a fully engineered submittal 55% · checklist / standard plan template
-
Apply and pay

Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.
- Which permit portal does this authority use? eTRAKiT (hills-trk.aspgov.com/eTRAKiT) for standard/traditional plan check; a Symbium-powered automated code-check and permitting pathway under SB 379 for eligible solar/ESS systems 85% · department page
- Can the whole application be completed online? Yes, for the Symbium/SB 379 automated pathway; the standard eTRAKiT path also supports full electronic submittal, review, payment and issuance 72% · department page
- What does a residential solar permit cost? $905 flat (Adopted FY 2026-27), line item 'Solar Energy Storage Permit – w/ or w/o BESS' 85% · fee schedule
- How is the fee calculated? Flat 85% · fee schedule
- Is there a separate plan-check fee? No separate plan-check line found for the solar permit specifically — the $905 flat fee appears to be all-inclusive (the schedule's general 'Plan Check' percentage-of-permit-fee line sits only under the valuation-based 'Building & Combination of Trade Scope' table, not under the flat-rate solar line) 60% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? 1 to 3 business days for standard-plan submittals 82% · published checklist
- Which utility handles interconnection here? Pacific Gas & Electric (PG&E) 78% · department page
28 questions answered against Town of Hillsborough’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes
Why the confidence is not higherTown's own Building Division page states the Town issues residential solar permits directly (traditional plan check or Symbium automated pathway); confirmed against HMC Title 15's own building/electrical adoption chapters.

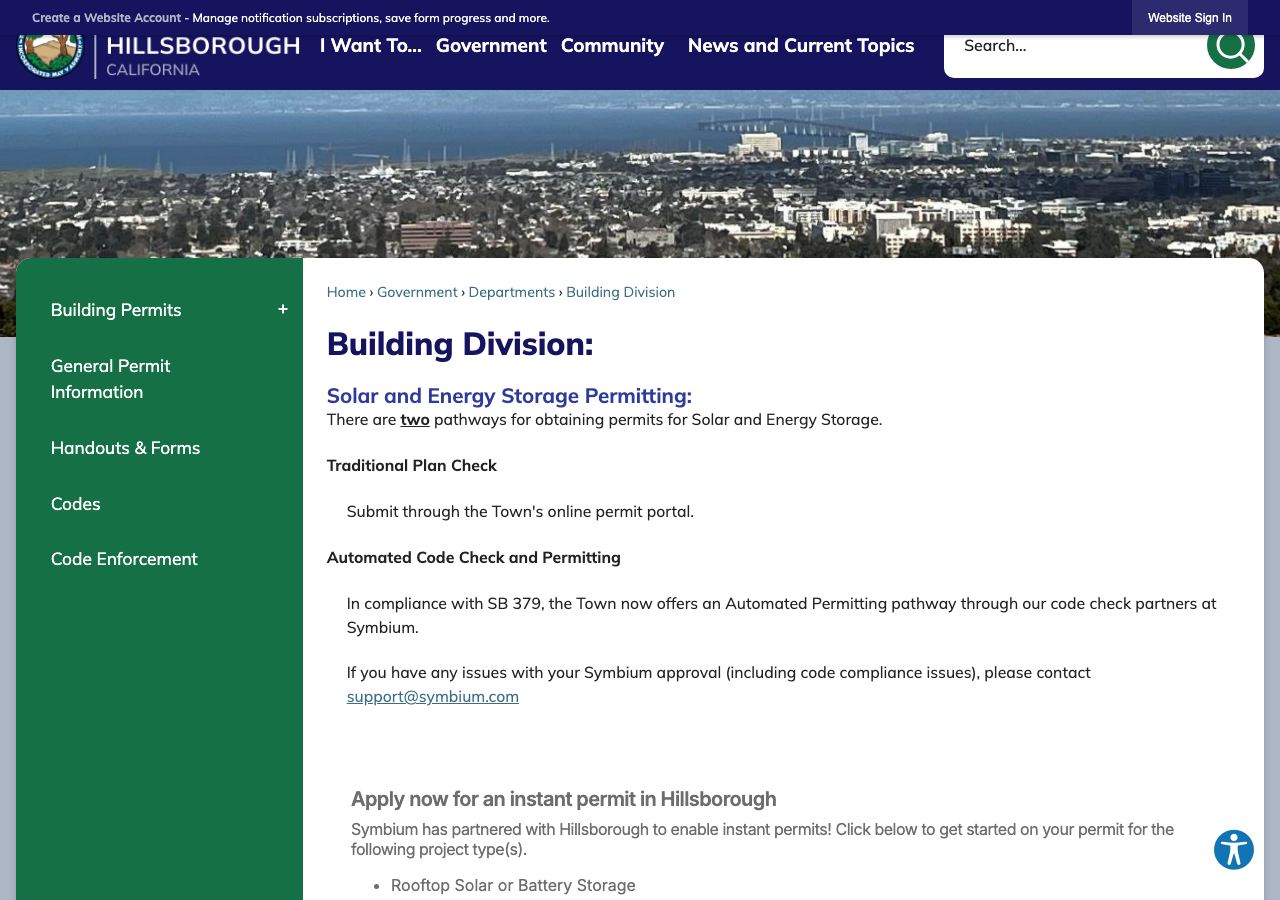

department page checked 2026-08-31 https://www.hillsborough.net/130/Building-Division
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherHMC Chapters 15.02 (Administrative), 15.04 (Building), 15.08 (Electrical) are all adopted and enforced by the Town's own Building & Planning Department; no delegation to San Mateo County found for building/electrical. Fire is separately held by CCFD, a JPA the Town co-governs (see jurisdiction block) rather than 'delegated' to an outside agency.
adopting ordinance (municipal code, Title 15) checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/6427
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherThe Town's own Solar PV System Requirements handout states plainly that a Building and Electrical Permit is required for solar PV installation; consistent with HMC 15.02/15.04/15.08 adoption of Title 24.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe Town's own Solar PV System Requirements handout states a solar PV system needs 'a) Building and Electrical Permit' (i.e., one combined permit) and separately notes 'b) Separate Electrical Permit required for new or upgraded electrical panels' — so the base system permit is combined, and only a panel upgrade triggers an additional separate electrical permit (the Master Fee Schedule's distinct 'Electrical Service Permit' $942 line corroborates this split).
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherThe Town's Obtaining-a-Permit page describes standard licensed-contractor permitting and separately links 'Owner-Builder Permit Requirements' with CSLB's owner-builder limitations, meaning a homeowner may pull the permit under strict conditions in addition to a licensed contractor/electrician.
department page checked 2026-08-31 https://www.hillsborough.net/256/Obtaining-a-Permit
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherBoth the Building Division and General Permit Information pages state explicitly: 'Contractors and Homeowner/Builders will need to register with the Town in advance of being provided login credentials to the Town's Permit Portal,' and that contractors must supply their current CSLB license number and proof of insurance before a permit account is issued.
department page checked 2026-08-31 https://www.hillsborough.net/139/General-Permit-Information
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Yes
Why the confidence is not higherThe Town's Obtaining-a-Permit page links a dedicated 'Owner-Builder Permit Requirements' handout and 'Owner-Builder Notice,' confirming property owners may self-permit under CSLB's owner-builder limitations (only the actual owner-occupant, not a business tenant, qualifies).
department page checked 2026-08-31 https://www.hillsborough.net/256/Obtaining-a-Permit
Q8 What documents make up a complete submittal? Core Submittal package
Completed building permit application; demonstrated compliance with the Town's solar eligibility checklist; a completed Standard Electrical Plan (or a full electrical plan with one-line diagram, module/string counts, inverter/combiner make-model, grounding/bonding and conductor sizing, and equipment cut sheets if the standard plan isn't used); a roof/site plan showing panel layout, plumbing/mechanical vent clearances, roof access point, code-compliant access pathways, PV fire classification and label locations; and completed expedited Structural Criteria with structural drawings/calculations stamped by a CA-licensed Civil or Structural Engineer
Why the confidence is not higherDirectly enumerated in the Town's own 'Solar PV System Requirements' handout, Sections 1-2, and cross-checked against the companion 'Solar Check List' PDF (both Building & Planning Department documents).
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q9 How many copies, and in what format? Submittal package
Applications are now electronic-only via the eTRAKiT permit portal (the Town states it 'remain[s] paperless' and accepts online permits); the older (2015) Solar Check List item H still references '3 sets of plans if hard copies,' which appears superseded by the current all-electronic posture
Why the confidence is not higherGeneral Permit Information page states 'All applications must be made electronically, via the Town's Permit Portal eTRAKiT' and the Building Division page separately states 'We remain paperless we are accepting online permits' — but the only copy-count figure found (3 sets) comes from a 2015 checklist that predates this stated electronic-only posture, so I report both rather than picking one with high confidence.
department page checked 2026-08-31 https://www.hillsborough.net/139/General-Permit-Information
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes — a site/roof diagram showing arrangement of panels on the roof, north arrow, lot dimensions, distance from property lines to adjacent buildings/structures, plumbing/mechanical vent clearances, roof access point, access pathways, PV fire classification, and label/marking locations
Why the confidence is not higherVerbatim requirement list in the Town's own Solar PV System Requirements handout, Section 2(c)-(d).
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherExplicitly required: 'One-line diagram of system' under electrical plan requirements, and the Town's Solar PV Standard Plan itself is built around single-line diagrams.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q12 Are string and conductor calculations required? Drawings & calculations
Yes
Why the confidence is not higherThe Town's Solar PV Standard Plan (dated internally 15 Dec 2025, current cycle) requires detailed source-circuit/conductor sizing calculations (module Voc/Isc, series-string voltage per CEC 690.7, source-circuit and output-circuit conductor sizing per CEC 310, and OCPD sizing per CEC 705.12(D)(2)); the Requirements handout requires the same for non-standard-plan submittals.
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
Yes, a structural PE/SE stamp is required — the Town's own submittal requirements call for 'structural drawings and calculations stamped and signed by a California-licensed Civil or Structural Engineer' with no stated kW exemption threshold (required as part of the 'expedited Structural Criteria' package for the same 10 kW pathway that otherwise uses simplified standard plans)
Why the confidence is not higherStated in Section 2(e) of the Town's Solar PV System Requirements handout; confidence is not higher because the document does not state whether any smaller/lighter installations are exempt from the stamp requirement — it reads as universal for the 10 kW residential program described.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
No separate electrical PE stamp requirement is stated for solar — the Standard Plan (10 kW or less, one/two-family dwelling) can be completed and signed by the 'Contractor/Engineer' interchangeably; a licensed engineer's stamp is only implicated if the installation falls outside the Standard Plan's scope and requires the 'Comprehensive Standard Plan' or a fully engineered submittal
Why the confidence is not higherInferred from the Standard Plan's signature block ('Contractor/Engineer Name... License # and Class') and repeated instructions to use the 'Comprehensive Standard Plan' for out-of-scope cases, rather than a document that states an electrical-stamp threshold explicitly.
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q15 What does a residential solar permit cost? Core Fees
$905 flat (Adopted FY 2026-27), line item 'Solar Energy Storage Permit – w/ or w/o BESS'
Why the confidence is not higherCurrent Town Master Fee Schedule (internally dated 15 May 2026, listing 'Adopted FY 25-26' at $233 and 'Adopted FY 26-27' at $905 for this line); FY26-27 (Jul 2026-Jun 2027) is the fee currently in effect as of this Aug 2026 check. Confidence is not higher because the line's title bundles 'w/ or w/o BESS' rather than separating a bare-PV figure, so it is possible a smaller PV-only system without any battery discussion at intake is billed differently at counter discretion.
fee schedule checked 2026-08-31 https://www.hillsborough.net/Archive.aspx?AMID=41&Type=Recent
Q16 How is the fee calculated? Core Fees
Flat
Why the confidence is not higherThe Solar Energy Storage Permit line sits under the Master Fee Schedule's own 'Single Trade & Scope Specific Flat Rate Permit Fees' heading (defined in the schedule's own 'Definitions of Fees' section as a flat rate 'based on typical number of staff hours,' distinct from the separate valuation-based building-permit table used for general construction).
fee schedule checked 2026-08-31 https://www.hillsborough.net/Archive.aspx?AMID=41&Type=Recent
Q17 Is there a separate plan-check fee? Fees
No separate plan-check line found for the solar permit specifically — the $905 flat fee appears to be all-inclusive (the schedule's general 'Plan Check' percentage-of-permit-fee line sits only under the valuation-based 'Building & Combination of Trade Scope' table, not under the flat-rate solar line)
Why the confidence is not higherInference from the fee schedule's structure rather than an explicit statement that solar plan check is bundled; the Definitions section describes flat-rate fees generally as covering 'typical staff hours spent on that particular project scope,' which by its own logic would include plan review, but this is not stated for solar by name.
fee schedule checked 2026-08-31 https://www.hillsborough.net/Archive.aspx?AMID=41&Type=Recent
Q18 What is the stated plan-review turnaround? Core Timeline & validity
1 to 3 business days for standard-plan submittals
Why the confidence is not higherTown's own Solar PV System Requirements handout: 'Permit applications utilizing the standard plan should be reviewed in one to three business days.' Not stated for non-standard-plan (fully engineered) submittals.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q19 How long is an issued permit valid before it expires? Timeline & validity
Nothing published by this authority.
Where we lookedHMC Title 15 Chapters 15.03 (Residential Code amendments, §§15.03.040-15.03.060 Reserved), 15.04 (Building Code amendments, §§15.04.040-15.04.060 Reserved) — no local amendment to the base CBC/CRC permit-expiration provision (§105.5) was found, meaning the unamended 180-day base-code rule likely governs, but no Town document states this explicitly for solar or otherwise
Q20 Which permit portal does this authority use? Core Portal & process
eTRAKiT (hills-trk.aspgov.com/eTRAKiT) for standard/traditional plan check; a Symbium-powered automated code-check and permitting pathway under SB 379 for eligible solar/ESS systems
Why the confidence is not higherBoth named explicitly on the Town's Building Division page. Confidence held at 85 rather than higher because the Symbium portal's own linked URL on that page (permits.hillsborough.net) is currently dead in DNS (confirmed NXDOMAIN in this run; a Jun 2024 Wayback capture shows it was live then), so the automated pathway's exact current entry point could not be independently verified.
department page checked 2026-08-31 https://www.hillsborough.net/130/Building-Division
Q21 Can the whole application be completed online? Core Portal & process
Yes, for the Symbium/SB 379 automated pathway; the standard eTRAKiT path also supports full electronic submittal, review, payment and issuance
Why the confidence is not higherGeneral Permit Information page states application, payment and issuance are all done 'electronically via the Town's Permit Portal.' Confidence is not higher because the Symbium portal link itself is currently unreachable (see Q20), so the fully-online claim for that specific pathway could not be directly re-verified today.
department page checked 2026-08-31 https://www.hillsborough.net/139/General-Permit-Information
Q22 Which utility handles interconnection here? Core Utility interconnection
Pacific Gas & Electric (PG&E)
Why the confidence is not higherThe Town has no municipal utility; its own General Permit Information page directs PG&E-related project questions to PG&E's 'Report It' mobile app, and its own Certification & Sign-offs for Final handout lists named PG&E interconnection contacts (@pge.com) at PG&E's San Carlos office. Not cross-checked against PG&E's own formal territory map in this run.
department page checked 2026-08-31 https://www.hillsborough.net/139/General-Permit-Information
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedPG&E's residential solar interconnection and Rule 21/DG process pages — both attempted URLs (pge.com/en/save-energy-and-money/... and pge.com/en/about/doing-business-with-pge/interconnection-services/...) returned 404 in this run; no Town document states the utility/permit sequencing relationship
Q24 Is a HOA or architectural approval required first? Overlays & special cases
No
Why the confidence is not higherState law (Gov. Code §65850.5) bars a city or town from conditioning approval of a compliant residential solar system on HOA/architectural approval; this overrides any local practice statewide. The Town's own solar documents do not list HOA sign-off among submittal requirements, consistent with the statute.
state statute checked 2026-08-31 https://leginfo.legislature.ca.gov/faces/codes_displaySection.xhtml?sectionNum=65850.5.&lawCode=GOV
Q25 Is there a historic-district review? Overlays & special cases
Nothing published by this authority.
Where we lookedArchitecture and Design Review Board 'Application Procedures' page and the Town's Planning main pages — no historic-district-specific review process was found (Hillsborough's design-review regime is ADRB-based rather than a named historic overlay district), and no solar-specific carve-out or trigger for it was found
Q26 Is a wind or windstorm certification required? Overlays & special cases
Nothing published by this authority.
Where we lookedBuilding Division, Codes, and Handouts & Forms pages — no windstorm certification process (California does not use a TDI-style windstorm certification scheme) or Town-specific wind-certification requirement was found for solar
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
No, not for a standard compliant residential rooftop system
Why the confidence is not higherGov. Code §65850.5 requires ministerial/administrative approval and forecloses routine discretionary review (SUP, Council hearing) for qualifying residential solar. The Town's Solar PV System Requirements handout does state 'Planning review is required for solar PV installations,' which I read as the Town's administrative/staff-level Planning check (consistent with state law) rather than a public hearing before the Architecture and Design Review Board — but the Town's own ADRB pages do not explicitly exempt solar, so this is partly inferred from the overriding state statute rather than a Town document stating it outright.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q28 Is there a system-size cap on residential generation? Overlays & special cases
10 kW AC (CEC rating) or less for the Town's expedited/standard-plan residential solar pathway; larger systems are not barred outright but must go through full engineered plan check rather than the simplified checklist/standard-plan route
Why the confidence is not higherBoth the Town's Solar Check List ('System size is 10 kW AC CEC rating or less') and Solar PV System Requirements and Solar PV Standard Plan (capped at 10 kW AC inverter output) state this ceiling for the simplified pathway; no separate citywide hard cap on residential generation size was found.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2581
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 85% · adopting ordinance (municipal code, Title 15)
- Which building code edition is in force? 2025 California Building Code (Title 24, Part 2), effective town-wide 1 Jan 2026 92% · department page
- Which fire code edition is in force? 2025 California Fire Code, plus 2024 International Fire Code Appendices 90% · adopting ordinance (municipal code, Title 15)
- Are there local amendments to any of the above? Yes 92% · adopting ordinance (municipal code, Title 15)
- What is the installation judged against? The 2025 California Electrical Code (Title 24, Part 3) as adopted and amended by HMC Chapter 15.08, together with the Town's own Solar PV Standard Plan/Requirements documents which implement CEC Articles 690 and 705 for residential PV 88% · checklist / standard plan template
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
- What ridge setback and access pathways are required? No town-specific numeric ridge-setback/pathway amendment was found in HMC Title 15's fire chapters; the Town's own submittal handout instead requires a roof plan showing 'code-compliant access pathways' and refers applicants to the State Fire Marshal's Solar PV Installation Guideline for examples, meaning the base 2025 CFC pathway/setback tables govern unamended. Separately, HMC §15.04.130/.131/.132 mandates Class A roof covering town-wide for all zones (stricter than the state's WUI-only default), which bears on PV fire classification even though it isn't a setback rule 60% · published checklist
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
- Is rapid shutdown required, and to which NEC edition? Rapid shutdown is required under the adopted 2023-NEC-based 2025 California Electrical Code (CEC §690.12), which applies statewide with no local exception found — but the Town's own current 'Solar PV Standard Plan' (internally dated 15 Dec 2025, i.e., prepared for the current code cycle) cites CEC §§690.3, 690.4, 690.5, 690.7, 690.11, 690.17, 690.35, 690.53, 690.54 and 705.12 in detail and never once cites §690.12 by number 68% · checklist / standard plan template
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Inverter-output-connection warning ('DO NOT RELOCATE THIS OVERCURRENT DEVICE'), DC-conductors-ungrounded warning (if applicable), PV system AC disconnect sign, dual-power-sources warning at the main service, ground-fault shock-hazard warning, 'WARNING: PHOTOVOLTAIC POWER SOURCE' marking on junction/combiner boxes and conduit, PV system DC disconnect sign, and a CEC 705.12-required permanent power-source directory/plaque 90% · checklist / standard plan template
- Does the authority specify placard wording of its own? Yes 90% · checklist / standard plan template
- Does it specify letter height, colour or material? Letter height: an informational note recommends '20 point (3/8 inch) should be considered the minimum,' citing ANSI Z535.4 guidelines for safety-sign design; material: a 'phenolic plaque with contrasting colors between text and background' is cited as meeting the intent of the code for permanency; no single mandatory color scheme beyond standard warning-label convention is specified by the Town itself 78% · checklist / standard plan template
- Is a site plan / facility map placard required, and what must it show? Yes — a roof plan/site diagram is required showing the roof layout, PV panel/module locations, clearances to plumbing and mechanical vents, approximate roof access point, code-compliant access pathways, PV system fire classification, and locations of all required labels and markings; CEC §705.12 additionally requires a permanent plaque/directory denoting all electric power sources on the premises 85% · published checklist
- Where must the labels be placed? At the main service/utility disconnect, the PV system AC and DC disconnects, and on junction/combiner boxes and along conduit runs (marked at intervals not exceeding every 10 feet, per CRC R331.2/CFC 605.11.1) 88% · checklist / standard plan template
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes — rooftop PV modules must be tested, listed and identified with a fire classification per UL 1703, meeting at minimum Class A (since HMC §15.04.130/.131 mandates Class A roof coverings town-wide); the Town's own handout set includes a State Fire Marshal bulletin specifically on this UL 1703 Class A/B/C classification requirement 75% · state bulletin, linked as a Town handout
- Are batteries permitted, and under what conditions? Yes, conditionally — the Town's simplified/expedited 10 kW pathway explicitly requires the system be 'utility interactive and without battery storage' (Solar Check List item D) to qualify for that streamlined route; systems that include a battery are not barred but must go through full/comprehensive review outside the simplified checklist, and the Master Fee Schedule carries a dedicated 'Solar Energy Storage Permit – w/ or w/o BESS' line confirming combined PV+battery systems are permitted 80% · published checklist
- Is there a separate ESS permit or inspection? Yes 85% · fee schedule
- Is there a local rule on service upgrades or busbar sizing? No local amendment adding a service-upgrade or busbar-sizing rule beyond the standard CEC 705.12(D)(2) 120%/100% bus-bar rule; the Town's own Standard Plan implements that CEC formula (Table 4) rather than a Hillsborough-specific rule, and a separate 'Electrical Service Permit' fee line exists for panel upgrades without an accompanying busbar-sizing amendment in Title 15 65% · checklist / standard plan template
- Is a specific mounting system or attachment spacing required? Yes — the Town requires racking/attachment documentation: type and number of roof coverings, roof framing type/size/spacing, panel weight and support locations/attachment method, and (where a pre-approved racking system is used) manufacturer documentation of maximum allowable weight, attachment method and product evaluation/structural design 85% · published checklist
20 questions answered against Town of Hillsborough’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023
Why the confidence is not higherHMC §15.08.020 adopts the '2025 California Electrical Code, Title 24, Part 3'; the 2025 CBSC triennial cycle (effective statewide 1 Jan 2026, and confirmed by the Town's own Codes page as the code now in force) is based on the 2023 NEC. The Town's own documents name the CEC edition, not the underlying NEC year, so the NEC-year mapping is a well-established statewide fact rather than something quoted verbatim from a Hillsborough document.
adopting ordinance (municipal code, Title 15) checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/6427
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code (Title 24, Part 2), effective town-wide 1 Jan 2026
Why the confidence is not higherHMC §15.04.020 adopts the '2025 California Building Code Volumes 1 and 2'; the Town's own Codes page states 'Starting January 1, 2026 all projects that are submitted for building, plumbing, electrical and mechanical permits will be required to comply with the 2025 California Code of Regulations Title 24.'
department page checked 2026-08-31 https://www.hillsborough.net/132/Codes
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code, plus 2024 International Fire Code Appendices
Why the confidence is not higherHMC §15.20.010: 'Adoption of the 2025 California Fire Code, 2024 International Fire Code Appendices, and Public...' (Chapter 15.20 heading), enforced by the fire chief/CCFD.
adopting ordinance (municipal code, Title 15) checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/6427
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherHMC Title 15 codifies extensive local amendments beyond the base Title 24 codes — e.g., §15.04.130/.131/.132 mandate a Class A roof covering town-wide (stricter than the base code's WUI-only requirement), §15.04.112/.113/.115 substantially rewrite CFC/CBC automatic-sprinkler trigger sections, §15.04.100 sets specific address-numbering dimensions, and each chapter (15.02/15.03/15.04/15.08/etc.) replaces the fee-schedule section (89.3.3(B), 109.2, R108.2) in its entirety. Extracted and read directly from the Town's own consolidated Title 15 ordinance PDF, positive control 'electrical' = 29 hits, fabricated control 'zzqqx' = 0 hits.
adopting ordinance (municipal code, Title 15) checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/6427
Q33 What is the installation judged against? Core Electrical
The 2025 California Electrical Code (Title 24, Part 3) as adopted and amended by HMC Chapter 15.08, together with the Town's own Solar PV Standard Plan/Requirements documents which implement CEC Articles 690 and 705 for residential PV
Why the confidence is not higherHMC §15.08.020 adoption clause plus the Town's own Standard Plan citing CEC 690.3/690.4/690.7/690.11/690.17/690.35/690.53/690.54/705.12 extensively.
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
No local amendment adding a service-upgrade or busbar-sizing rule beyond the standard CEC 705.12(D)(2) 120%/100% bus-bar rule; the Town's own Standard Plan implements that CEC formula (Table 4) rather than a Hillsborough-specific rule, and a separate 'Electrical Service Permit' fee line exists for panel upgrades without an accompanying busbar-sizing amendment in Title 15
Why the confidence is not higherChapter 15.08 (Electrical Code amendments) contains only fee-schedule sections (15.08.040-.140 largely reserved or fee-related); no busbar/service-upgrade amendment section found in the extracted Title 15 text, and the Standard Plan's busbar table cites CEC 705.12(D)(2) by number rather than a local rule.
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Yes — the Town requires racking/attachment documentation: type and number of roof coverings, roof framing type/size/spacing, panel weight and support locations/attachment method, and (where a pre-approved racking system is used) manufacturer documentation of maximum allowable weight, attachment method and product evaluation/structural design
Why the confidence is not higherVerbatim in Section 2(e) of the Town's Solar PV System Requirements handout, under the expedited Structural Criteria submittal.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
No town-specific numeric ridge-setback/pathway amendment was found in HMC Title 15's fire chapters; the Town's own submittal handout instead requires a roof plan showing 'code-compliant access pathways' and refers applicants to the State Fire Marshal's Solar PV Installation Guideline for examples, meaning the base 2025 CFC pathway/setback tables govern unamended. Separately, HMC §15.04.130/.131/.132 mandates Class A roof covering town-wide for all zones (stricter than the state's WUI-only default), which bears on PV fire classification even though it isn't a setback rule
Why the confidence is not higherChapter 15.20 (CFC amendments) contains sections on permits/fees, storage, premises ID, hydrant clearance and sprinkler-trigger calculations, but no PV-specific setback/pathway section; grep of the extracted Title 15 PDF found zero hits for 'setback' near 'solar/photovoltaic'. Confidence held at 60 because the amendment-compilation PDF only reprints chapters that were changed in the latest ordinance and could be incomplete for older, unamended pathway provisions.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Rapid shutdown is required under the adopted 2023-NEC-based 2025 California Electrical Code (CEC §690.12), which applies statewide with no local exception found — but the Town's own current 'Solar PV Standard Plan' (internally dated 15 Dec 2025, i.e., prepared for the current code cycle) cites CEC §§690.3, 690.4, 690.5, 690.7, 690.11, 690.17, 690.35, 690.53, 690.54 and 705.12 in detail and never once cites §690.12 by number
Why the confidence is not higherConfirmed by direct text search of the Town's own current Standard Plan PDF (extracted with pdftotext -layout): zero hits for '690.12' or 'rapid shutdown' despite extensive, precise citation of the surrounding 690-series sections. This is a real gap in the AHJ's own guidance document rather than evidence the requirement doesn't apply — §690.12 is a mandatory NEC/CEC provision statewide and no exemption for Hillsborough was found.
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Inverter-output-connection warning ('DO NOT RELOCATE THIS OVERCURRENT DEVICE'), DC-conductors-ungrounded warning (if applicable), PV system AC disconnect sign, dual-power-sources warning at the main service, ground-fault shock-hazard warning, 'WARNING: PHOTOVOLTAIC POWER SOURCE' marking on junction/combiner boxes and conduit, PV system DC disconnect sign, and a CEC 705.12-required permanent power-source directory/plaque
Why the confidence is not higherFull verbatim label set given on page 4 of the Town's own current Solar PV Standard Plan, each tied to its CEC citation (690.35(F), 690.5(C), 690.17, 690.53, 690.54, 705.12(D)(4)/(7), CRC R331.2/CFC 605.11.1).
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
Yes
Why the confidence is not higherThe Standard Plan gives the exact required wording for every placard (e.g., 'WARNING ELECTRIC SHOCK HAZARD. THE DC CONDUCTORS OF THIS PHOTOVOLTAIC SYSTEM ARE UNGROUNDED AND MAY BE ENERGIZED — CEC 690.35(F)').
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Letter height: an informational note recommends '20 point (3/8 inch) should be considered the minimum,' citing ANSI Z535.4 guidelines for safety-sign design; material: a 'phenolic plaque with contrasting colors between text and background' is cited as meeting the intent of the code for permanency; no single mandatory color scheme beyond standard warning-label convention is specified by the Town itself
Why the confidence is not higherDirect quote from the Standard Plan's markings page, presented as an informational note rather than a hard mandate ('No type size is specified, but... should be considered the minimum'), which is why this isn't scored higher.
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Yes — a roof plan/site diagram is required showing the roof layout, PV panel/module locations, clearances to plumbing and mechanical vents, approximate roof access point, code-compliant access pathways, PV system fire classification, and locations of all required labels and markings; CEC §705.12 additionally requires a permanent plaque/directory denoting all electric power sources on the premises
Why the confidence is not higherCombined from the Town's Solar PV System Requirements handout (roof plan requirement) and the Standard Plan's explicit citation of CEC 705.12's directory requirement.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedPG&E's DG/NEM interconnection and documents pages — attempted URLs 404'd in this run, so no utility-specific placard requirement beyond the AHJ's own (Q38-41) could be confirmed
Q43 Where must the labels be placed? Core Labels Signage & labelling
At the main service/utility disconnect, the PV system AC and DC disconnects, and on junction/combiner boxes and along conduit runs (marked at intervals not exceeding every 10 feet, per CRC R331.2/CFC 605.11.1)
Why the confidence is not higherStated directly on the Standard Plan's markings page ('[Marked on junction/combiner boxes and conduit every 10']) alongside the disconnect-sign locations described in the same document.
checklist / standard plan template checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2124
Q44 Must equipment be on a specific approved list? Equipment listing
Yes — rooftop PV modules must be tested, listed and identified with a fire classification per UL 1703, meeting at minimum Class A (since HMC §15.04.130/.131 mandates Class A roof coverings town-wide); the Town's own handout set includes a State Fire Marshal bulletin specifically on this UL 1703 Class A/B/C classification requirement
Why the confidence is not higherInferred by combining the Town's own 'Fire Rated Solar Panels - Class A' handout (a California State Fire Marshal Information Bulletin on CBC §1505.9/CRC §R902.4 UL 1703 fire classification, OCR-extracted since it is an image-only scan) with HMC's town-wide Class A roof-covering amendment; the Town does not appear to have its own separate 'approved equipment list' beyond this fire-classification requirement.
state bulletin, linked as a Town handout checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/1385
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes, conditionally — the Town's simplified/expedited 10 kW pathway explicitly requires the system be 'utility interactive and without battery storage' (Solar Check List item D) to qualify for that streamlined route; systems that include a battery are not barred but must go through full/comprehensive review outside the simplified checklist, and the Master Fee Schedule carries a dedicated 'Solar Energy Storage Permit – w/ or w/o BESS' line confirming combined PV+battery systems are permitted
Why the confidence is not higherDirect checklist requirement in the Town's Solar Check List (OCR-extracted from an image-only PDF) plus the Master Fee Schedule's own fee-line wording.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2581
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Yes
Why the confidence is not higherThe current Master Fee Schedule lists a distinct 'Battery Energy Storage System (BESS) Permit' line ($789, Adopted FY26-27), separate from the 'Solar Energy Storage Permit – w/ or w/o BESS' line ($905), indicating BESS can be its own permit apart from a solar permit.
fee schedule checked 2026-08-31 https://www.hillsborough.net/Archive.aspx?AMID=41&Type=Recent
Q47 Is a ground mount treated as a structure? Core Ground mount
Nothing published by this authority.
Where we lookedHMC Title 15's consolidated ordinance-update PDF marks 'Chapter 15.6 TOWERS, AERIALS, ANTENNAE, WINDMILLS AND SOLAR PANELS' as 'NO CHANGES - CHAPTER RETAINED' without reprinting its text (this document only reprints chapters amended in the latest ordinance cycle); Municode's hosted copy of the Town's code (library.municode.com/ca/hillsborough) and a 2021 Wayback capture of the same URL both return an Angular JS shell with no server-rendered chapter text to a plain fetch
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedPG&E's interconnection/DG manual — attempted URLs 404'd in this run; no Town document specifies AC-disconnect-to-meter placement (this is typically governed by the interconnecting utility's own manual, not the AHJ's)
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Phone (primary — call the Building Division at 650-375-7411); limited online submission is available specifically for after-hours inspection requests 82% · department page
- How much notice is required? 48 hours / next business day, per General Permit Information and the Town's Solar PV System Requirements handout ('Inspection requests should be made at least 48 hours in advance'; 'typically scheduled for the next business day... within a 48 hour window'); note the separate Building Division static page instead states a 'three-day lead time,' an internal inconsistency across the Town's own pages that I could not resolve 62% · department page
- Are same-day or AM/PM windows offered? No same-day or next-day inspections are accommodated; specific AM/PM time windows are not published in any Town document reviewed 70% · department page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes 90% · published checklist
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
- Which inspections are required, and in what order? At minimum, one final inspection after the system is fully installed ('Once all permits to construct the solar installation have been issued and the system has been installed, it must be inspected before final approval is granted'); the document does not describe a separate rough-in stage for the simplified 10 kW pathway 68% · published checklist
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- Is there a published inspection checklist? Yes 88% · published checklist
- What must be on site at inspection? The stamped, approved plans and permit card must remain on the job site at all times, with all attached documents intact; the installation must be ready in the field to demonstrate conformance with 'all technical requirements' and the approved plans 80% · department page
- Does the inspector verify labels and listings? Yes 92% · published checklist
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- Is there a re-inspection fee? $248 (Building Reinspection fee, Adopted FY 2026-27) — the Town's general reinspection fee; no solar-specific reinspection line was found 70% · fee schedule
- How are corrections issued and cleared? The inspector notes deficiencies at the time of inspection; for issued permits needing revision/resubmittal, the applicant logs into the eTRAKiT web portal, attaches the corrected complete plan set (individual pages are not accepted — only complete plan sets), and then calls the assigned permit technician to flag the resubmittal for review 68% · department page
14 questions answered against Town of Hillsborough’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Phone (primary — call the Building Division at 650-375-7411); limited online submission is available specifically for after-hours inspection requests
Why the confidence is not higherBuilding Division page: 'To Schedule an Inspection please call the Building Department at (650) 375-7411... For after-hours inspection requests, you may submit online.'
department page checked 2026-08-31 https://www.hillsborough.net/130/Building-Division
Q50 How much notice is required? Core Booking & scheduling
48 hours / next business day, per General Permit Information and the Town's Solar PV System Requirements handout ('Inspection requests should be made at least 48 hours in advance'; 'typically scheduled for the next business day... within a 48 hour window'); note the separate Building Division static page instead states a 'three-day lead time,' an internal inconsistency across the Town's own pages that I could not resolve
Why the confidence is not higherTwo of the Town's own documents (General Permit Information and the solar-specific Requirements handout) agree on 48 hours/next business day, while the Building Division page states three days — flagging the conflict rather than silently picking one.
department page checked 2026-08-31 https://www.hillsborough.net/139/General-Permit-Information
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
No same-day or next-day inspections are accommodated; specific AM/PM time windows are not published in any Town document reviewed
Why the confidence is not higherBuilding Division page states plainly: 'Same-day or next day inspection requests cannot be accommodated.' No AM/PM window language found on any inspection-related page.
department page checked 2026-08-31 https://www.hillsborough.net/130/Building-Division
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes
Why the confidence is not higherThe Town's own Building Inspection Division performs solar inspections directly ('On-site inspections can be scheduled by contacting the Town of Hillsborough Building Inspection Division'); no delegation to the county or a third party found for building/electrical inspection.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q53 If delegated, to whom? Core Who inspects
Nothing published by this authority.
Where we lookedNot applicable — Q52 established that the Town's own Building Inspection Division performs the final solar inspection directly (not delegated), so there is no delegate to name
Q54 Which inspections are required, and in what order? Core Stages & sequence
At minimum, one final inspection after the system is fully installed ('Once all permits to construct the solar installation have been issued and the system has been installed, it must be inspected before final approval is granted'); the document does not describe a separate rough-in stage for the simplified 10 kW pathway
Why the confidence is not higherPhrasing in the Town's own Solar PV System Requirements handout implies a single post-installation final inspection for the standard 10 kW pathway; larger/fully-engineered systems requiring a separate electrical service permit (panel upgrade) would presumably need that permit's own inspection as well, but this isn't stated explicitly for solar.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedThe Town's Solar PV System Requirements handout, Section 5 (Inspections) — describes only a single post-installation inspection for the standard 10 kW pathway and does not state whether a separate rough-in or mid-roof inspection is ever required
Q56 Does the inspector verify labels and listings? Core What is checked
Yes
Why the confidence is not higherThe Town's own inspection checklist (Section 5 of the Solar PV System Requirements handout) explicitly lists verifying that 'Appropriate signs are property[sic] constructed, installed and displayed' and that 'Equipment ratings are consistent with application and installed signs on the installation,' including inverter, OCPD and switch ratings against nameplate/listing labels.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q57 Is there a published inspection checklist? Core What is checked
Yes
Why the confidence is not higherSection 5 of the Town's Solar PV System Requirements handout is itself a published inspection checklist ('The inspection checklist provides an overview of common points of inspection that the applicant should be prepared to show compliance at the time of inspection'), listing module/model matching, grounding, conductor sizing, bus rating, and signage checks.
published checklist checked 2026-08-31 https://www.hillsborough.net/DocumentCenter/View/2123
Q58 What must be on site at inspection? Core Documents on site
The stamped, approved plans and permit card must remain on the job site at all times, with all attached documents intact; the installation must be ready in the field to demonstrate conformance with 'all technical requirements' and the approved plans
Why the confidence is not higherCombined from General Permit Information ('The stamped, approved plans must remain on the job site at all times') and the Solar PV System Requirements handout ('Permit holders must be prepared to show conformance with all technical requirements in the field at the time of inspection').
department page checked 2026-08-31 https://www.hillsborough.net/139/General-Permit-Information
Q59 Is there a re-inspection fee? Corrections & re-inspection
$248 (Building Reinspection fee, Adopted FY 2026-27) — the Town's general reinspection fee; no solar-specific reinspection line was found
Why the confidence is not higherCurrent Master Fee Schedule lists 'Building Reinspection... Each... $206 [FY25-26] / $248 [FY26-27]' under Administrative Fees & Penalties; this is not a solar-specific line, so it is applied by inference as the general fee that would govern a failed solar inspection.
fee schedule checked 2026-08-31 https://www.hillsborough.net/Archive.aspx?AMID=41&Type=Recent
Q60 How are corrections issued and cleared? Corrections & re-inspection
The inspector notes deficiencies at the time of inspection; for issued permits needing revision/resubmittal, the applicant logs into the eTRAKiT web portal, attaches the corrected complete plan set (individual pages are not accepted — only complete plan sets), and then calls the assigned permit technician to flag the resubmittal for review
Why the confidence is not higherDrawn from the Building Division page's description of the revision/resubmittal process; the page frames this as the general permit-revision workflow rather than a solar-specific 'corrections' procedure, so it is applied by inference to solar corrections as well.
department page checked 2026-08-31 https://www.hillsborough.net/130/Building-Division
Q61 What is issued on pass? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedGeneral Permit Information, Building Division pages, and the 'Certification & Sign-offs for a Final Inspection' handout (DocumentCenter/View/2917, revised 1-1-22) — none names the specific artifact/tag (CO, Final, Green Tag, Letter) issued on a passed solar-permit final; the 2917 handout addresses sign-offs for larger construction projects (grading, structural, landscape) rather than a routine solar-only permit
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedPG&E's NEM/interconnection and PTO process pages — attempted URLs 404'd in this run, so it could not be confirmed whether the installer, the Town, or PG&E itself initiates the PTO notification
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for Town of Hillsborough against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
Town of Hillsborough is the authority having jurisdiction 90% confidence
- Holds
- Building and Electrical (Town's own Building & Planning Department, HMC Title 15 Chs. 15.02-15.21); Fire code adoption and enforcement held by Central County Fire Department (CCFD), a Joint Powers Authority the Town co-created with the City of Burlingame in 2004 (also serving Millbrae) — not the county, and not a contracted firm
- Overridden by
- CA Gov. Code §65850.5/§65850.52 (mandates ministerial approval, bars HOA conditioning, and requires automated online permitting for qualifying residential solar, which the Town implements via a Symbium SB 379 pathway) and the AB 130 residential-amendment freeze (Stats. 2025, Ch. 22), which Hillsborough's own code cites verbatim at HMC §15.08.150/15.04.240
- Why not higher
- The Town's own Building & Planning Department (HMC Title 15) adopts the CBC/CRC/CEC/CFC by ordinance and issues its own residential building and electrical permits directly via eTRAKiT — confirmed on its own Building Division, Obtaining-a-Permit and General-Permit-Information pages. Fire is NOT county fire: the Town's own '/266/Fire' page states verbatim that fire service is provided by Central County Fire Department (CCFD), formed 20 Apr 2004 by a JPA between Hillsborough and Burlingame (governed by 2 councilmembers from each city), also serving Millbrae — confirmed independently on CCFD's own site at ccfd.org. San Mateo County has no permitting role for incorporated Hillsborough. Confidence is 90 rather than higher only because I could not retrieve the full codified text of HMC Chapter 15.6 ('Towers, Aerials, Antennae, Windmills and Solar Panels') to confirm there is no zoning-side carve-out; the Town's own ordinance-update PDF marks that chapter 'NO CHANGES - CHAPTER RETAINED' without reprinting it.
- Permit required
- Yes95%
- Permit cost
- $905 flat (Adopted FY 2026-27), line item 'Solar Energy Storage Permit – w/ or w/o BESS'85%
- Plan review
- 1 to 3 business days for standard-plan submittals82%
- Portal
- eTRAKiT (hills-trk.aspgov.com/eTRAKiT) for standard/traditional plan check; a Symbium-powered automated code-check and permitting pathway under SB 379 for eligible solar/ESS systems85%
- Electrical code
- 202385%
- Own placard wording
- Yes90%
- Booking an inspection
- Phone (primary — call the Building Division at 650-375-7411); limited online submission is available specifically for after-hours inspection requests82%
Labels & placards for this authority
Town of Hillsborough writes its own placard wording. A standard NEC label set will not satisfy it — the exact text, and in most cases the size, colour and font, are specified below.
Wording 90%
Yes
Size, colour & material 78%
Letter height: an informational note recommends '20 point (3/8 inch) should be considered the minimum,' citing ANSI Z535.4 guidelines for safety-sign design; material: a 'phenolic plaque with contrasting colors between text and background' is cited as meeting the intent of the code for permanency; no single mandatory color scheme beyond standard warning-label convention is specified by the Town itself
Where they go 88%
At the main service/utility disconnect, the PV system AC and DC disconnects, and on junction/combiner boxes and along conduit runs (marked at intervals not exceeding every 10 feet, per CRC R331.2/CFC 605.11.1)
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
