Town of San Anselmo
Marin County
Town of San Anselmo is a city authority in the State of California, serving 12,830 residents. 1,147 residential solar installs are on record here. This page is the permit route for that jurisdiction: the fifteen steps from working out who has a say over an address through to permission to operate, the documents this authority publishes, and 62 answers taken from those documents and dated.
Permitting 5 steps · 28 questions
Whether a permit is needed — Yes Q3 Electrical and building permits — Combined Q4 Plan review — Instantaneous for SB 379/Symbium-eligible residential PV and ESS applications; approximately 1-3 business days for PV/PV+ESS/ESS-only applications submitted… Q18 Where you file — eTrakit (https://sanan-trk.aspgov.com/eTRAKiT/) for permit application and inspection scheduling generally, Q20
- Permit required
- Yes95% source
- What it costs
- $450 flat ('Photo-voltaic System Permit and EV charging'), unchanged between the Current FY25-26 and Proposed FY26-27 columns of the fee schedule effective 1 Jul 2026.88% source
- Plan review turnaround
- Instantaneous for SB 379/Symbium-eligible residential PV and ESS applications; approximately 1-3 business days for PV/PV+ESS/ESS-only applications submitted electronically via eTrakit outside the…90% source
- Key document
- authority checklist + authority page (two documents, two different scopes) cited by 8 open the document
-
Confirm who has a say over your address
A city address is usually permitted by the city, not the county — but not always, and some authorities keep building and hand electrical to someone else. Getting this wrong costs the whole submittal, because every requirement below belongs to whoever actually holds jurisdiction. Check the overlays in the same pass: an HOA, a historic district, a windstorm certification or a system-size cap can reshape the design, and all of them are cheaper to find now than after the array is laid out.
- Is this authority the AHJ for residential solar at this address? Yes 95% · authority department page
- What does this authority permit itself, and what does it delegate? Both 88% · authority department page + fire district fee schedule
- Is a permit required for a residential rooftop PV system? Yes 95% · fee schedule
- Is there a separate electrical permit, or is it combined? Combined 82% · fee schedule
- Is there a historic-district review? Yes -- projects in a historical district require additional review beyond the standard PV checklist path. 78% · authority checklist
- Is there a system-size cap on residential generation? The Town's standardized (non-Symbium) PV Checklist scopes itself to 'residential (one and two family dwellings) roof mounted PV systems of up to 10 KW' -- the AB 2188-era figure. The Town's separate Symbium/SB 379 automated-permitting page does not itself state a kW ceiling for the platform's eligible systems. 65% · authority checklist + authority page (two documents, two different scopes)
-
Check who is allowed to apply
Several authorities require the electrical permit to be pulled by a licensed electrician, or require the contractor to be registered with them BEFORE applying. Registration is not same-day. This is second on the list rather than fourth because it is the step most likely to stop the job before the drawings matter.
- Who is allowed to pull the electrical permit? Either 55% · authority page (inference)
- Must the contractor be registered with this authority before applying? Yes 92% · authority page
-
Build the submittal package
Almost everywhere wants a site plan, a one-line or three-line electrical diagram, equipment cut sheets with listings, and a structural attachment detail. Build it against the published checklist rather than the last jurisdiction you worked in — the checklist is what the reviewer marks against.
- What documents make up a complete submittal? Per the Town's PV Permit Requirements & Checklist: a PV System Plan Set (site plan showing all PV components; single-line electrical diagram showing main/sub panel and PV equipment sizing; conductor wiring methods, insulation rating, grounding methods and DC/AC disconnects; signage plan; equipment placement and access pathways; equipment type/listing/testing-agency approvals; panel attachment details); the completed PV Checklist form itself; and manufacturer spec sheets (module, inverter, mounting/racking, grounding). 78% · authority checklist (PDF, extracted, dated 2015/rev. 2020)
- How many copies, and in what format? Minimum of 3 sets, wet-signed by the designer (per the PV Checklist's plan-check items: 'Has every plan sheet been wet signed by the designer (min. 3 sets)?') 50% · authority checklist (PDF, dated, possibly superseded by digital workflow)
- Is a site plan required, and what must it show? Yes -- a site plan clearly showing the location of all PV system components relative to the structure is required (general building-permit site plans must also show property lines, setbacks, drainage direction, streets/driveways and existing structures). 85% · authority checklist
- Is a one-line / three-line diagram required? Yes 90% · authority checklist
- Are string and conductor calculations required? Yes 80% · authority checklist
- Is a structural PE stamp required, and at what threshold? A licensed-professional structural design/stamp 'may be required' if roof rafters/trusses are over-spanned, or if the PV array load exceeds 5 lbs per square foot. 82% · authority checklist
-
Apply and pay
Most authorities now take the whole application through a portal, and several states cap or constrain what a residential solar permit may cost. Check whether plan check is billed separately before you quote the job.

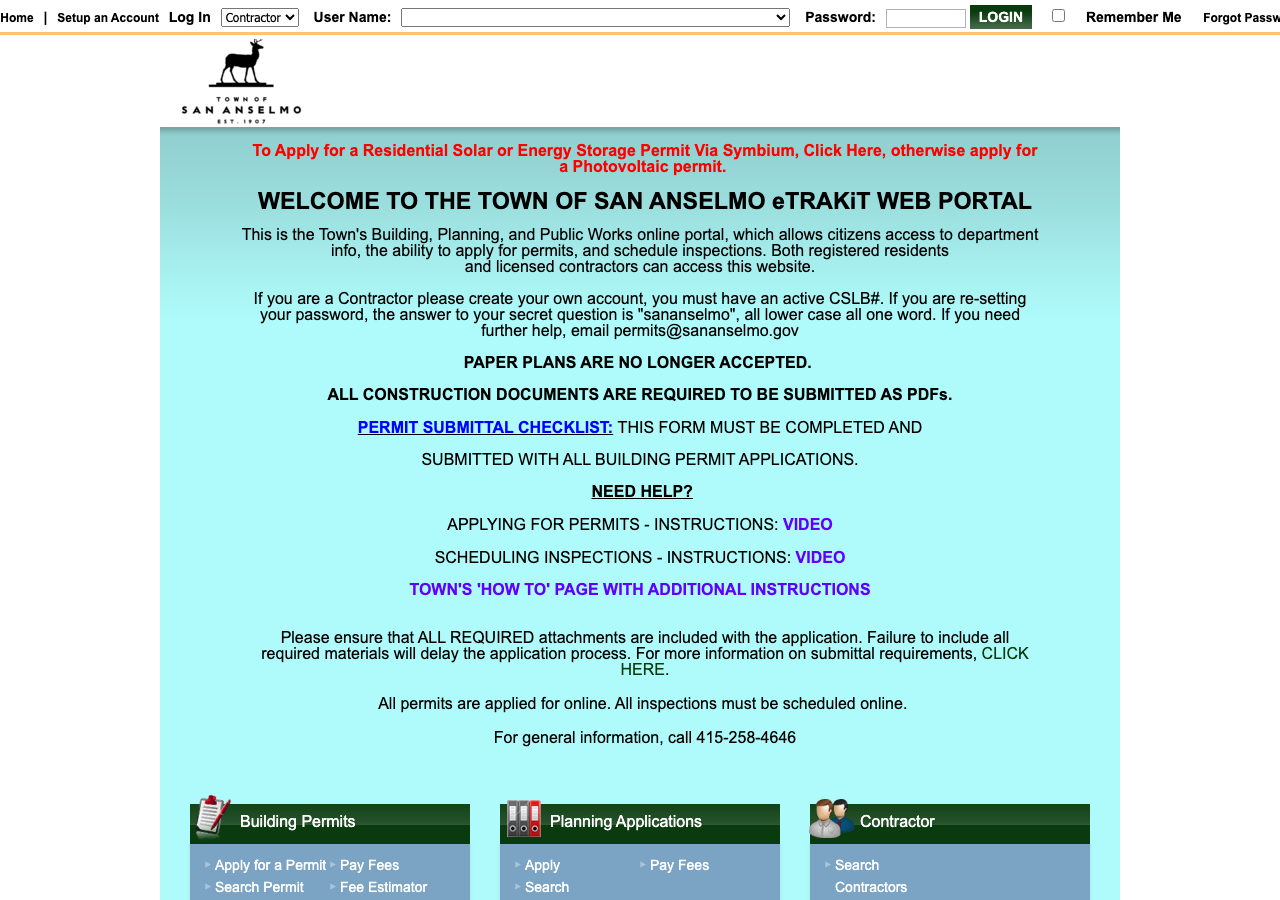

- Which permit portal does this authority use? eTrakit (https://sanan-trk.aspgov.com/eTRAKiT/) for permit application and inspection scheduling generally, combined with Symbium for SB 379-eligible automated residential PV/ESS plan review and permit issuance. 95% · authority page
- Can the whole application be completed online? Yes 82% · authority page
- What does a residential solar permit cost? $450 flat ('Photo-voltaic System Permit and EV charging'), unchanged between the Current FY25-26 and Proposed FY26-27 columns of the fee schedule effective 1 Jul 2026. Percentage-based surcharges (Technology Fee 3%, Training Fee 3%, General Plan Maintenance Fee 10% of Bldg Permit fees) may also apply on top per the schedule's general Building-fee notes. 88% · fee schedule (PDF, extracted; effective 1 Jul 2026)
- How is the fee calculated? Flat (per project) 82% · fee schedule
-
Plan review — and start the utility in parallel
Interconnection is a separate process from the permit and usually the longer pole. Where the utility does not depend on the permit being issued, running both at once is the single biggest saving available on a residential job.
- What is the stated plan-review turnaround? Instantaneous for SB 379/Symbium-eligible residential PV and ESS applications; approximately 1-3 business days for PV/PV+ESS/ESS-only applications submitted electronically via eTrakit outside the Symbium platform. 90% · authority page
- Which utility handles interconnection here? Pacific Gas & Electric (PG&E) 75% · CCA's own page (secondary confirmation of incumbent utility)
28 questions answered against Town of San Anselmo’s own published documents
Q1 Is this authority the AHJ for residential solar at this address? Core Jurisdiction & scope
Yes

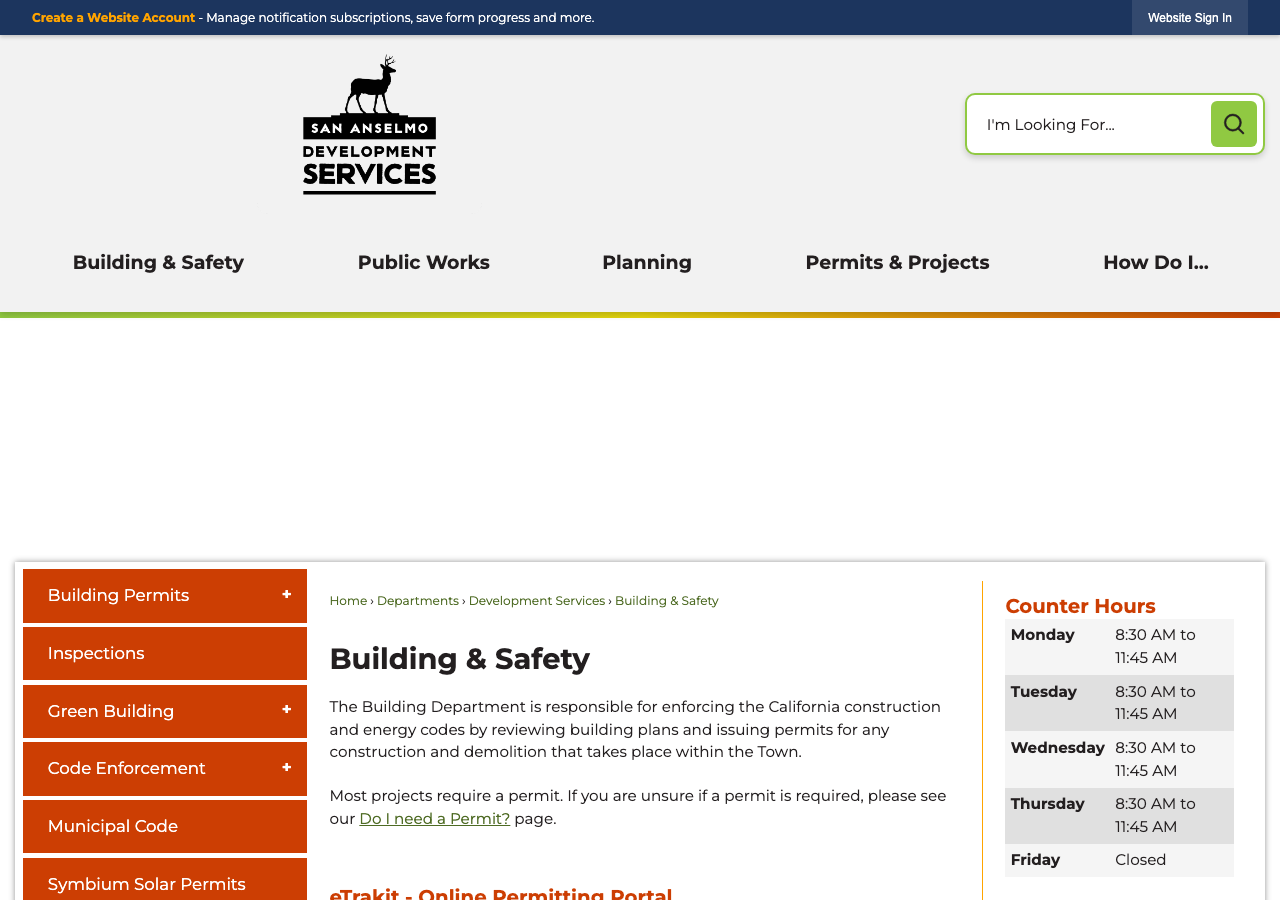

Why the confidence is not higherTown of San Anselmo Building & Safety Division (Development Services Dept.) issues residential PV/electrical permits directly, confirmed by its own Building page and its Symbium/SB 379 automated-permitting page.

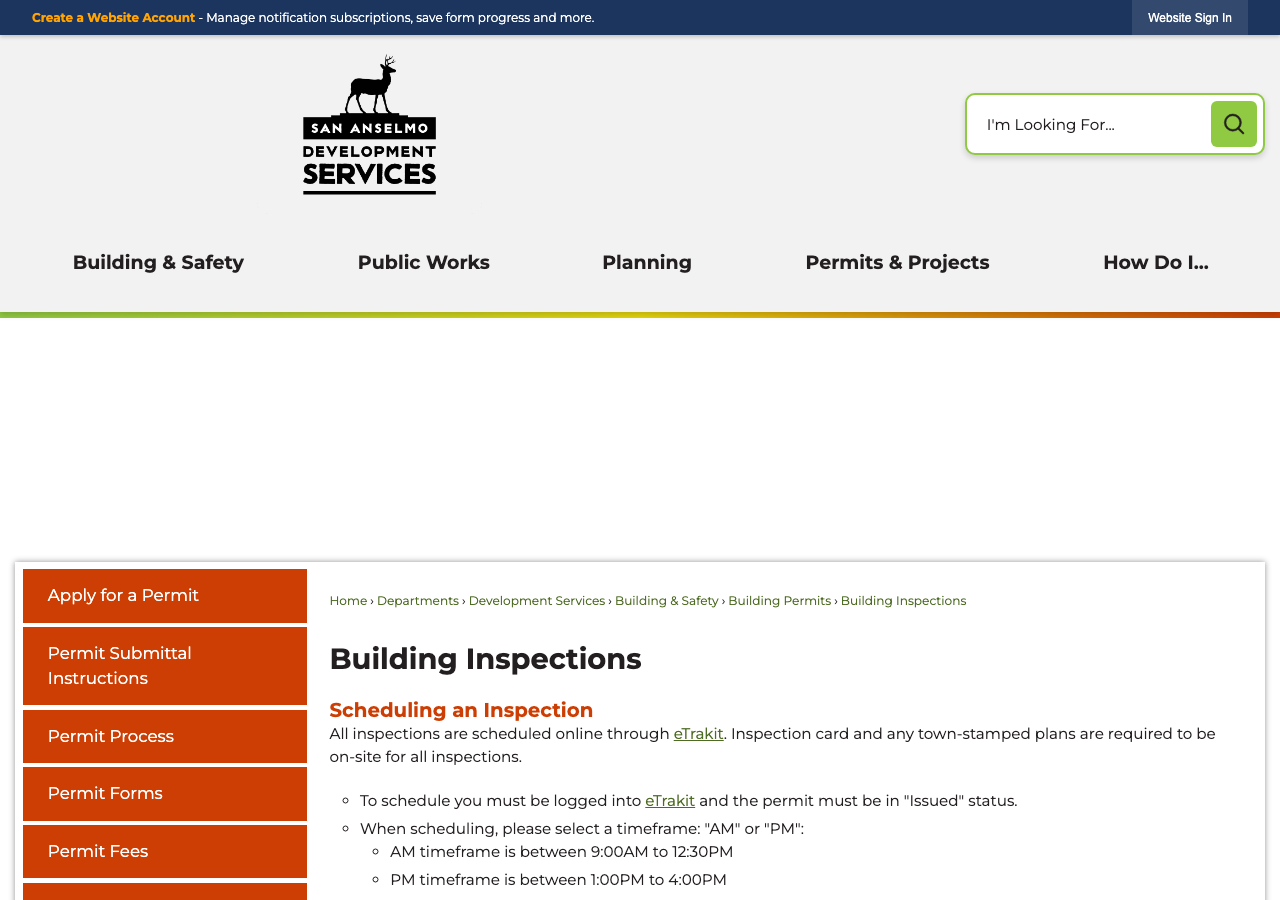

authority department page checked 2026-08-31 https://www.sananselmo.gov/929/Building
Q2 What does this authority permit itself, and what does it delegate? Core Jurisdiction & scope
Both
Why the confidence is not higherBuilding & Safety self-performs building and electrical permitting/plan check/inspection for residential PV. However, fire-code review, permitting and inspection for PV and battery/ESS is a genuinely separate function performed by Ross Valley Fire Department (a JPA), which prices and permits 'Photovoltaic Power System' and 'Battery Systems' on its own fee schedule -- so the honest answer is 'Both' for Building/Electrical plus a real fire-side delegation, not a clean single value.
authority department page + fire district fee schedule checked 2026-08-31 https://www.rossvalleyfire.gov/fee-schedule-prevention-services
Q3 Is a permit required for a residential rooftop PV system? Core Jurisdiction & scope
Yes
Why the confidence is not higherTown's own Building Fee Schedule lists 'Photo-voltaic System Permit and EV charging' as a priced permit item, and the Town's PV Permit Requirements & Checklist states the standardized submittal 'must be completed and submitted with all PV permit applications.'
fee schedule checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/30079/San-Anselmo-Fee-Schedule-2024pdf
Q4 Is there a separate electrical permit, or is it combined? Core Jurisdiction & scope
Combined
Why the confidence is not higherThe Building Fee Schedule prices one flat 'Photo-voltaic System Permit and EV charging' line ($450) and separately notes the general 'Electrical Permit' line (15% of Bldg Permit fee or $168) is 'Fee waived for local EV charging, roof top solar, and tankless water heater' -- i.e. the electrical scope of PV is folded into the single PV permit fee rather than billed as a separate electrical permit.
fee schedule checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/30079/San-Anselmo-Fee-Schedule-2024pdf
Q5 Who is allowed to pull the electrical permit? Core Who may apply
Either
Why the confidence is not higherNo Town document states an explicit licensed-electrician-only rule for solar. The Symbium page points applicants to CSLB's Solar Smart consumer page (implying licensed-contractor best practice) but does not bar an owner-builder or other contractor type from pulling the permit.
authority page (inference) checked 2026-08-31 https://www.sananselmo.gov/1979/Symbium-Solar-Permits
Q6 Must the contractor be registered with this authority before applying? Core Who may apply
Yes
Why the confidence is not higherTown's 'Apply for a Permit' page states plainly: 'Contractors must have an active business license with the Town' before applying, and provides for a distinct 'Contractor Account' in eTrakit.
authority page checked 2026-08-31 https://www.sananselmo.gov/1824/Apply-for-a-Permit
Q7 Is a homeowner permitted to self-install and self-permit? Who may apply
Nothing published by this authority.
Where we lookedSymbium Solar Permits page and Apply-for-a-Permit page -- neither states whether a homeowner may self-install/self-permit a PV system; both describe 'Public Account' vs 'Contractor Account' options without addressing solar-specific self-installation.
Q8 What documents make up a complete submittal? Core Submittal package
Per the Town's PV Permit Requirements & Checklist: a PV System Plan Set (site plan showing all PV components; single-line electrical diagram showing main/sub panel and PV equipment sizing; conductor wiring methods, insulation rating, grounding methods and DC/AC disconnects; signage plan; equipment placement and access pathways; equipment type/listing/testing-agency approvals; panel attachment details); the completed PV Checklist form itself; and manufacturer spec sheets (module, inverter, mounting/racking, grounding).
Why the confidence is not higherDirect text of the Town's own 'Residential Photovoltaic Systems Permit Requirements & Checklist' PDF, extracted with pdftotext -layout. Document is dated (created 2015, last modified 2020) and scoped to roof-mount systems up to 10 kW; it is still the linked, live document for non-Symbium PV/ESS submittals as of this run, but may not reflect any newer digital-submittal-only practice.
authority checklist (PDF, extracted, dated 2015/rev. 2020) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q9 How many copies, and in what format? Submittal package
Minimum of 3 sets, wet-signed by the designer (per the PV Checklist's plan-check items: 'Has every plan sheet been wet signed by the designer (min. 3 sets)?')
Why the confidence is not higherThis figure comes from the 2015/2020 PV Checklist PDF. It sits in tension with the Town's current digital-only eTrakit submittal convention described on the Permit Submittal Instructions page ('Street Number Street Name_Permit Number_Document Type_Submittal#.pdf'), which implies electronic upload rather than physical wet-signed paper sets. Flagged as possibly stale rather than resolved.
authority checklist (PDF, dated, possibly superseded by digital workflow) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q10 Is a site plan required, and what must it show? Core Submittal package
Yes -- a site plan clearly showing the location of all PV system components relative to the structure is required (general building-permit site plans must also show property lines, setbacks, drainage direction, streets/driveways and existing structures).
Why the confidence is not higherDirect text from both the PV Checklist ('Site plan clearly showing location of all components of the PV system') and the Town's general Permit Submittal Checklist ('Site Plan - Is the site plan fully dimensioned, showing property lines and site contour lines, setbacks... locations of all structures...').
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q11 Is a one-line / three-line diagram required? Core Drawings & calculations
Yes
Why the confidence is not higherPV Checklist requires: 'Single line diagram of electrical equipment clearly showing size of main panel, sub panels, PV system equipment, including make, model, size of units, and disconnects.'
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q12 Are string and conductor calculations required? Drawings & calculations
Yes
Why the confidence is not higherPV Checklist requires 'Conductor wiring methods and insulation rating, system and solar panel grounding methods... PV system DC and AC disconnects' in the plan set, plus a worksheet field for 'DC Grounding Electrode Conductor ___AWG' and 'AC Grounding Electrode Conductor ___AWG' citing CEC Sec 690.47(c)(2).
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q13 Is a structural PE stamp required, and at what threshold? Core Engineering & stamps
A licensed-professional structural design/stamp 'may be required' if roof rafters/trusses are over-spanned, or if the PV array load exceeds 5 lbs per square foot.
Why the confidence is not higherDirect text of the PV Checklist's Roof Design worksheet: 'If Truss/Rafters are over-spanned, or if the array is over 5 lbs. psf, design by a licensed professional may be required.' This is the only PV-specific structural threshold found; the Town's general Permit Submittal Checklist only asks generically whether stamped structural calcs are included when 'applicable.'
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q14 Is an electrical PE stamp required, and at what threshold? Engineering & stamps
Nothing published by this authority.
Where we lookedPV Checklist and Permit Submittal Checklist -- both require a design professional's stamp generally ('if applicable') but neither states a specific electrical-PE-stamp threshold (e.g. service size or system kW) distinct from the structural threshold in Q13.
https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q15 What does a residential solar permit cost? Core Fees
$450 flat ('Photo-voltaic System Permit and EV charging'), unchanged between the Current FY25-26 and Proposed FY26-27 columns of the fee schedule effective 1 Jul 2026. Percentage-based surcharges (Technology Fee 3%, Training Fee 3%, General Plan Maintenance Fee 10% of Bldg Permit fees) may also apply on top per the schedule's general Building-fee notes.
Why the confidence is not higherVerified directly from the Town's Schedule of User Fees PDF (pdftotext -layout extraction, not a summary). PDF metadata confirms Title 'Schedule of User Fees Effective July 1, 2026', ModDate 25 Jun 2026 -- i.e. this is the current, live-adopted fee schedule despite the URL slug still reading '...Fee-Schedule-2024pdf' (the file is updated in place under the old filename).
fee schedule (PDF, extracted; effective 1 Jul 2026) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/30079/San-Anselmo-Fee-Schedule-2024pdf
Q16 How is the fee calculated? Core Fees
Flat (per project)
Why the confidence is not higherThe PV permit line is priced as a single flat $450 'Per project' fee in the Building Fee Schedule, unlike Fairfield's kW-tiered structure. Percentage add-ons (Technology/Training/General Plan Maintenance fees) stack on top of the base as a share of 'Bldg Permit fees' generally.
fee schedule checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/30079/San-Anselmo-Fee-Schedule-2024pdf
Q17 Is there a separate plan-check fee? Fees
Nothing published by this authority.
Where we lookedBuilding Fee Schedule -- the PV permit line ($450) is a single flat figure with no plan-check sub-line broken out (unlike, e.g., Fairfield's separate plan-check/inspection split); the schedule's general 65%-of-permit-fee plan-check line applies to valuation-based building permits, and it is unclear whether/how it layers onto the flat PV fee.
https://www.townofsananselmo.org/DocumentCenter/View/30079/San-Anselmo-Fee-Schedule-2024pdf
Q18 What is the stated plan-review turnaround? Core Timeline & validity
Instantaneous for SB 379/Symbium-eligible residential PV and ESS applications; approximately 1-3 business days for PV/PV+ESS/ESS-only applications submitted electronically via eTrakit outside the Symbium platform.
Why the confidence is not higherDirect text of the Town's Symbium Solar Permits page: systems outside the automated platform 'can still submit electronically via e-TRAKiT... Please note that permit processing will take approximately 1-3 business days, depending on staff availability.' Symbium itself is described as providing 'instantaneous plan review' per SB 379.
authority page checked 2026-08-31 https://www.sananselmo.gov/1979/Symbium-Solar-Permits
Q19 How long is an issued permit valid before it expires? Timeline & validity
Nothing published by this authority.
Where we lookedBuilding-Inspections and Permit-Process pages -- found only that a passing inspection 'will extend the permit for 180 days from the date of the inspection,' which is not the same as an initial permit validity/expiration period; no general or solar-specific expiration duration was stated.
Q20 Which permit portal does this authority use? Core Portal & process
eTrakit (https://sanan-trk.aspgov.com/eTRAKiT/) for permit application and inspection scheduling generally, combined with Symbium for SB 379-eligible automated residential PV/ESS plan review and permit issuance.
Why the confidence is not higherConfirmed directly on the Town's own Symbium Solar Permits page and Building/Permits & Projects pages.
authority page checked 2026-08-31 https://www.sananselmo.gov/1979/Symbium-Solar-Permits
Q21 Can the whole application be completed online? Core Portal & process
Yes
Why the confidence is not higherEligible systems get instantaneous plan review and permit approval entirely through the Symbium portal after address verification; systems outside the platform are still submitted 'electronically via e-TRAKiT.' No in-person step is described for either path on this page.
authority page checked 2026-08-31 https://www.sananselmo.gov/1979/Symbium-Solar-Permits
Q22 Which utility handles interconnection here? Core Utility interconnection
Pacific Gas & Electric (PG&E)
Why the confidence is not higherMarin County, including San Anselmo, has no municipal electric utility; Marin Clean Energy (MCE) is the local Community Choice Aggregator but its own 'About Us' page states PG&E 'delivers the electricity through power lines that they own' and, under 'How MCE Works,' that PG&E 'Delivers energy, maintains lines, and sends bills' while MCE only 'Buys and builds clean and renewable energy.' PG&E's own service-area map page returned a 404 during this run, so this is confirmed via MCE's own statement plus general Marin territory knowledge rather than PG&E's own map directly -- lower confidence for that reason.
CCA's own page (secondary confirmation of incumbent utility) checked 2026-08-31 https://www.mcecleanenergy.org/about-us/
Q23 Where does the utility sit in the sequence? Core Utility interconnection
Nothing published by this authority.
Where we lookedSymbium page, Permit-Process page and general Building pages -- none state where PG&E interconnection/PTO sits relative to Town permit issuance for residential PV.
Q24 Is a HOA or architectural approval required first? Overlays & special cases
Nothing published by this authority.
Where we lookedPermit Submittal Checklist mentions Town Planning 'Design Review' for some projects generally, but this is municipal design review, not a private HOA/architectural-committee requirement; no HOA-specific statement was found (the Town does not enforce private CC&Rs).
https://www.townofsananselmo.org/DocumentCenter/View/25539/Plan-Submittal-Checklist
Q25 Is there a historic-district review? Overlays & special cases
Yes -- projects in a historical district require additional review beyond the standard PV checklist path.
Why the confidence is not higherPV Checklist states: 'If the project is located in a historical district, or is a ground mount system, additional requirements for review may be required.'
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q26 Is a wind or windstorm certification required? Overlays & special cases
Nothing published by this authority.
Where we lookedPV Checklist, Permit Submittal Checklist and Building Fee Schedule -- no wind/windstorm certification requirement (Florida/Texas TDI-style) is mentioned anywhere; California does not typically use such a regime, but no explicit Town statement to that effect was found either.
https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q27 Is a Specific Use Permit or Council approval ever required? Overlays & special cases
Nothing published by this authority.
Where we lookedPV Checklist and Symbium page -- neither mentions a Specific Use Permit or Council approval requirement for standard residential rooftop or ground-mount PV; the only Planning Commission trigger found (grading over 100 cubic yards, per the Permit Submittal Checklist) is unrelated to solar specifically.
https://www.townofsananselmo.org/DocumentCenter/View/25539/Plan-Submittal-Checklist
Q28 Is there a system-size cap on residential generation? Overlays & special cases
The Town's standardized (non-Symbium) PV Checklist scopes itself to 'residential (one and two family dwellings) roof mounted PV systems of up to 10 KW' -- the AB 2188-era figure. The Town's separate Symbium/SB 379 automated-permitting page does not itself state a kW ceiling for the platform's eligible systems.
Why the confidence is not higherDirect quote from the PV Checklist's Purpose section for the codified/standard cap; the Symbium page (fetched and read in full via curl, not summarized) contains no size figure at all, confirmed by direct text search of the page body.
authority checklist + authority page (two documents, two different scopes) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Install 5 steps · 20 questions
-
Build to the code editions actually in force here
The NEC edition a jurisdiction enforces is often a cycle behind the newest one published, and local amendments sit on top of it. Rapid shutdown, conductor sizing and labelling all change between editions, so the edition in force is the first thing to establish, not the last.
- Which NEC edition is in force? 2023 NEC (via the 2025 California Electrical Code) 90% · authority checklist (PDF, extracted; dated May 2025, rev. Jan 2026)
- Which building code edition is in force? 2025 California Building Code / 2025 California Residential Code 92% · authority checklist
- Which fire code edition is in force? 2025 California Fire Code 85% · fire district's own page
- Are there local amendments to any of the above? Yes 72% · inference from fire district page + Town Green Building page
- What is the installation judged against? 2025 California Building Code / Residential Code, 2025 California Plumbing Code, 2025 California Mechanical Code, 2025 California Electrical Code, 2025 California Green Building Standards Code, 2025 California Energy Code, and the San Anselmo Municipal Code. 90% · authority checklist
-
Fire access, setbacks and pathways
Ridge setbacks and roof access pathways are fire-service requirements and they constrain the array layout. They are the most common cause of a redesign after the fire department comments on a plan set.
Nothing recorded for Town of San Anselmo on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Rapid shutdown
Which rapid-shutdown rule applies follows directly from the NEC edition in force, and the initiation device has to be at a location the fire service can reach and identify. This is inspected, and it is labelled.
Nothing recorded for Town of San Anselmo on this step yet — 1 question checked and found unpublished. The guidance above is general.
-
Labels and placards
The NEC sets a baseline for permanent markings at the service equipment and the disconnecting means. On top of that, an authority may specify its own wording, and the utility may specify more again. Where any of them writes its own text, a generic off-the-shelf label set will not pass — this is the detail most often fixed on a return visit.
- Which placards does this authority require at the service equipment? Three forms of signage are required for solar PV systems: labels on the panel(s), on the disconnect(s), and on the transmission line conductors. 82% · authority checklist
- Does the authority specify placard wording of its own? No -- the Town specifies appearance/material standards for the placards but no specific wording text of its own. 62% · authority checklist
- Does it specify letter height, colour or material? Colour and material are specified: red background with white lettering; printed material must resist fading per UL 969. No letter-height figure is given. 80% · authority checklist
- Where must the labels be placed? On the PV panel(s), on the disconnect(s), and on the transmission line conductors. 80% · authority checklist
-
Disconnect, storage and listed equipment
Where the AC disconnect must sit relative to the meter is usually the utility's rule, not the building department's. Battery storage frequently carries its own permit, its own inspection and its own fire conditions.
- Must equipment be on a specific approved list? Yes (implied) 68% · authority checklist (inference)
- Are batteries permitted, and under what conditions? Yes -- residential battery/ESS systems are permitted, both as a distinct Town permit type ('ESS ONLY RESIDENTIAL', 'PV WITH ESS RESIDENTIAL') via Symbium/eTrakit, and as a separately-fee'd Ross Valley Fire Department 'Battery Systems' permit ($465). 78% · authority page + fire district fee schedule
- Is there a separate ESS permit or inspection? Yes 82% · fire district fee schedule
- Is a ground mount treated as a structure? Yes (treated distinctly, requiring additional review) 68% · authority checklist (inference)
20 questions answered against Town of San Anselmo’s own published documents
Q29 Which NEC edition is in force? Core Code editions in force
2023 NEC (via the 2025 California Electrical Code)
Why the confidence is not higherTown's own Permit Submittal Checklist mandates a cover-sheet statement: 'All Construction... shall comply with either the 2025 California Building Code or 2025 California Residential Code, 2025 California Plumbing Code, 2025 California Mechanical Code, 2025 California Electrical Code, 2025 Green Building Standards Code, 2025 California Energy Code, and the San Anselmo Municipal Code.' The 2025 CEC is based on the 2023 NEC per the standard CA code-cycle mapping.
authority checklist (PDF, extracted; dated May 2025, rev. Jan 2026) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25539/Plan-Submittal-Checklist
Q30 Which building code edition is in force? Core Code editions in force
2025 California Building Code / 2025 California Residential Code
Why the confidence is not higherSame cover-sheet compliance statement, direct text extraction from the Town's own Plan Submittal Checklist PDF (not a summary).
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25539/Plan-Submittal-Checklist
Q31 Which fire code edition is in force? Code editions in force
2025 California Fire Code
Why the confidence is not higherRoss Valley Fire Department's own Fire Code page (which serves as San Anselmo's fire AHJ) states outright: '2025 California Fire Code' with each member jurisdiction's own local chapter listed by name -- 'Town of San Anselmo: Article 8 San Anselmo Fire Code.' Confirmed by direct curl + text extraction of the live page, not a WebFetch summary.
fire district's own page checked 2026-08-31 https://www.rossvalleyfire.gov/fire-code
Q32 Are there local amendments to any of the above? Core Code editions in force
Yes
Why the confidence is not higherThe Town maintains its own locally-numbered fire chapter (Article 8 San Anselmo Fire Code, per RVFD's own listing) and its own Green Building Ordinance (SAMC Ch. 19-19.010, adopted Sept. 2023, enforcement from March 2024) layered onto the state model codes -- both are local amendments/additions by definition. The underlying Municode chapter text itself could not be read directly in this run (see jurisdiction.why), so this is inferred from the existence of named local chapters rather than a read of their content.
inference from fire district page + Town Green Building page checked 2026-08-31 https://www.rossvalleyfire.gov/fire-code
Q33 What is the installation judged against? Core Electrical
2025 California Building Code / Residential Code, 2025 California Plumbing Code, 2025 California Mechanical Code, 2025 California Electrical Code, 2025 California Green Building Standards Code, 2025 California Energy Code, and the San Anselmo Municipal Code.
Why the confidence is not higherVerbatim mandatory cover-sheet statement required on every plan set, per the Town's own Plan Submittal Checklist PDF.
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25539/Plan-Submittal-Checklist
Q34 Is there a local rule on service upgrades or busbar sizing? Electrical
Nothing published by this authority.
Where we lookedPV Checklist and Plan Submittal Checklist -- neither addresses service-panel upgrade sizing or busbar/120%-rule requirements specific to solar backfeed; RVFD's Fire Code and Permit-and-Plan-Submittals pages were also checked (control-passed on 'battery'/'photovoltaic' terms) with no busbar content found.
https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q35 Is a specific mounting system or attachment spacing required? Structural & mounting
Nothing published by this authority.
Where we lookedPV Checklist requires 'panel attachment details' be shown in the plan set and requires a roof-structural worksheet (rafter size/spacing, array weight, 5 lb/sq ft threshold -- see Q13) but gives no numeric attachment-spacing table or specific mounting-system standard of its own; Plan Submittal Checklist likewise has no PV-specific mounting spec.
https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q36 What ridge setback and access pathways are required? Core Fire pathways & setbacks
Nothing published by this authority.
Where we lookedRoss Valley Fire Department's own Fire Code and Permit-and-Plan-Submittals pages were fetched and text-searched (control terms 'sprinkler'/'battery'/'photovoltaic' present, confirming the page content is real and searchable) for 'ridge', 'setback', 'pathway' -- all genuinely absent from those two pages' visible content. However, the actual codified 'Article 8 San Anselmo Fire Code' amendment text itself (on Municode) could not be retrieved in this run -- Municode's library.municode.com is an Angular SPA that returns only an empty app shell to non-JS fetches, and a rendered-browser tool was not available -- so this is recorded as not_found rather than a proven absence of any local ridge-setback/pathway rule.
Q37 Is rapid shutdown required, and to which NEC edition? Core Rapid shutdown
Nothing published by this authority.
Where we lookedThe Town's live 2025 CEC/2023 NEC code-edition adoption (Q29) implies rapid shutdown per NEC 690.12 applies by default, but the Town's own dated PV Checklist (2015, rev. 2020) cites CEC 690.47(c)(2) repeatedly and never cites 690.12 anywhere in its 4 pages (checked via full-text pdftotext extraction) -- a real gap between the AHJ's still-linked guidance document and the current code cycle it is nominally subordinate to, not a search failure.
https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q38 Which placards does this authority require at the service equipment? Core Labels Signage & labelling
Three forms of signage are required for solar PV systems: labels on the panel(s), on the disconnect(s), and on the transmission line conductors.
Why the confidence is not higherPV Checklist, Design and Review section item 1(d) ('Signage (on panel(s), disconnects and transmission line conductors)') and closing note: 'Note: Three forms of signage are required for solar PV systems.'
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q39 Does the authority specify placard wording of its own? Core Labels Signage & labelling
No -- the Town specifies appearance/material standards for the placards but no specific wording text of its own.
Why the confidence is not higherThe PV Checklist specifies colour and material ('red background with white lettering... resistant to fading per UL 969, and CEC Article 690') but does not give verbatim placard text, unlike e.g. LACoFD's or Hollister's documented wording.
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q40 Does it specify letter height, colour or material? Core Labels Signage & labelling
Colour and material are specified: red background with white lettering; printed material must resist fading per UL 969. No letter-height figure is given.
Why the confidence is not higherDirect quote: 'Permanently affixed labels shall have a red background with white lettering. Printed material shall be resistant to fading per UL 969, and CEC Article 690.'
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q41 Is a site plan / facility map placard required, and what must it show? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedPV Checklist -- describes a general 'site plan' but does not separately call out a dedicated NEC 705.10 site-plan/facility-map placard requirement.
https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q42 Does the UTILITY specify placards beyond the AHJ's? Core Labels Signage & labelling
Nothing published by this authority.
Where we lookedPG&E's Rule 21/DG interconnection Greenbook documentation was out of scope for this city-side run and was not opened; no Town page cross-references utility-specific placard specs.
Q43 Where must the labels be placed? Core Labels Signage & labelling
On the PV panel(s), on the disconnect(s), and on the transmission line conductors.
Why the confidence is not higherSame PV Checklist signage clause, item 1(d).
authority checklist checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q44 Must equipment be on a specific approved list? Equipment listing
Yes (implied)
Why the confidence is not higherPV Checklist requires the plan set to show 'Equipment type, listing, testing agency approvals, etc.' and requires manufacturer spec sheets with 'Listing information including mounting, conductor type, method of grounding' -- a de facto listed-equipment requirement, though no separate 'approved equipment list' document was found.
authority checklist (inference) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q45 Are batteries permitted, and under what conditions? Core Battery / ESS
Yes -- residential battery/ESS systems are permitted, both as a distinct Town permit type ('ESS ONLY RESIDENTIAL', 'PV WITH ESS RESIDENTIAL') via Symbium/eTrakit, and as a separately-fee'd Ross Valley Fire Department 'Battery Systems' permit ($465).
Why the confidence is not higherTown's Symbium page lists 'PV WITH ESS RESIDENTIAL' and 'ESS ONLY RESIDENTIAL' as corresponding permit types for applications outside the automated platform. RVFD's own Fee Schedule prices 'Battery Systems' at $465, separate from 'Photovoltaic Power System' at $328. No document specifying detailed technical conditions (clearance, enclosure, etc.) for ESS was located in this run.
authority page + fire district fee schedule checked 2026-08-31 https://www.sananselmo.gov/1979/Symbium-Solar-Permits
Q46 Is there a separate ESS permit or inspection? Battery / ESS
Yes
Why the confidence is not higherRoss Valley Fire Department's Prevention Services Fee Schedule prices 'Battery Systems' ($465) as its own distinct line, separate from the 'Photovoltaic Power System' line ($328); the Town's Symbium page likewise lists 'ESS ONLY RESIDENTIAL' as a separate permit type from 'PV ONLY RESIDENTIAL.'
fire district fee schedule checked 2026-08-31 https://www.rossvalleyfire.gov/fee-schedule-prevention-services
Q47 Is a ground mount treated as a structure? Core Ground mount
Yes (treated distinctly, requiring additional review)
Why the confidence is not higherPV Checklist: 'If the project... is a ground mount system, additional requirements for review may be required' -- grouped with the historic-district carve-out as needing extra scrutiny beyond the standard roof-mount PV pathway, though the ordinance text itself was not directly read (Municode inaccessible in this run).
authority checklist (inference) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q48 Where must the AC disconnect be, relative to the meter? Core Utility equipment
Nothing published by this authority.
Where we lookedSame as Q42 -- PG&E's Greenbook/interconnection manual was not opened in this run; no Town-side document addresses AC-disconnect placement relative to the utility meter.
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Inspection 5 steps · 14 questions
-
Book it
Booking is a portal, a phone call or an email depending on the authority, and the notice required is rarely zero. Book before the work is finished rather than after — the lead time, not the work, is usually what sets the date.
- How is an inspection booked? Portal 92% · authority page
- Are same-day or AM/PM windows offered? Yes -- AM (9:00 AM-12:30 PM) or PM (1:00 PM-4:00 PM) windows are offered. 88% · authority page
-
Know who turns up
Some authorities inspect their own solar work; some delegate it, and a few do not inspect the PV equipment itself at all. Who is coming determines what they will look at.
- Does this AHJ perform its own final solar inspection? Yes (for the Building scope) 70% · authority page + fire district fee schedule (cross-checked)
- If delegated, to whom? Ross Valley Fire Department (JPA) -- for the fire-code component of PV and battery/ESS installations only; Building/electrical inspection stays with the Town. 70% · fire district fee schedule (inference)
-
Work the stages in order
A rough-in or mid-roof inspection, where one is required, has to happen before the work it covers is closed up. Missing a stage means opening something back up, and it is the most expensive kind of correction.
Nothing recorded for Town of San Anselmo on this step yet — 2 questions checked and found unpublished. The guidance above is general.
-
Have the paperwork on site
The approved plan set, the permit, and the equipment listings should be on site and reachable. Inspectors routinely verify that installed equipment matches what was approved, and that the labels are the ones the plan set promised.
- What must be on site at inspection? Inspection card and Town-stamped plans must be available on site, and someone must be present throughout the entire inspection window. 72% · authority page (general, not solar-specific)
-
Sign-off, and permission to operate
Passing gives you a final or an equivalent sign-off. That is not the same as permission to operate: PTO comes from the utility, and who tells the utility the inspection passed varies. A system left switched off for weeks is usually waiting on this handover.
- Is there a re-inspection fee? No re-inspection fee line found in the Town's current (effective 1 Jul 2026) Master Fee Schedule. 70% · fee schedule (control-proven absence)
- How are corrections issued and cleared? Corrections are handled through eTrakit; the Town's Permit Process page states general resubmittal reviews take 2-3 weeks (vs. 6-8 weeks for the initial departmental review of large projects). 55% · authority page (general, not solar-specific)
14 questions answered against Town of San Anselmo’s own published documents
Q49 How is an inspection booked? Core Booking & scheduling
Portal
Why the confidence is not higherTown's Inspections page: inspections are scheduled exclusively through eTRAKiT; the permit must have 'Issued' status and the applicant must be logged into their account.
authority page checked 2026-08-31 https://www.sananselmo.gov/1292/Inspections
Q50 How much notice is required? Core Booking & scheduling
Nothing published by this authority.
Where we lookedTown's Inspections page describes booking method and AM/PM windows but does not state a minimum advance-notice period for scheduling.
Q51 Are same-day or AM/PM windows offered? Booking & scheduling
Yes -- AM (9:00 AM-12:30 PM) or PM (1:00 PM-4:00 PM) windows are offered.
Why the confidence is not higherDirect text of the Inspections page listing the two scheduling windows.
authority page checked 2026-08-31 https://www.sananselmo.gov/1292/Inspections
Q52 Does this AHJ perform its own final solar inspection? Core Who inspects
Yes (for the Building scope)
Why the confidence is not higherThe Town's own Building Division inspects the building/electrical scope of PV work via eTrakit-scheduled inspections. However, Ross Valley Fire Department's own fee schedule describes itself as covering 'plan review, inspections, and permits' for its priced PV/battery lines, implying RVFD performs a genuinely separate fire-side inspection rather than the Town's inspection covering everything -- so this is not a clean single-agency 'Yes.'
authority page + fire district fee schedule (cross-checked) checked 2026-08-31 https://www.sananselmo.gov/1292/Inspections
Q53 If delegated, to whom? Core Who inspects
Ross Valley Fire Department (JPA) -- for the fire-code component of PV and battery/ESS installations only; Building/electrical inspection stays with the Town.
Why the confidence is not higherInferred from RVFD's fee schedule pricing PV/battery lines as covering 'plan review, inspections, and permits,' and its Permit & Plan Submittal page routing solar/battery plan submittals to Prevention. No single Town document states the split explicitly in one place.
fire district fee schedule (inference) checked 2026-08-31 https://www.rossvalleyfire.gov/fee-schedule-prevention-services
Q54 Which inspections are required, and in what order? Core Stages & sequence
Nothing published by this authority.
Where we lookedBuilding-Inspections and Inspections pages describe general scheduling/pass-fail mechanics but do not lay out a solar-specific inspection sequence (e.g. rough vs. final); PV Checklist is a plan-check document, not a field-inspection-sequence document.
Q55 Is a rough-in or mid-roof inspection required? Stages & sequence
Nothing published by this authority.
Where we lookedSame Building-Inspections/Inspections pages -- no mention of a rough-in or mid-roof inspection requirement, solar or otherwise.
Q56 Does the inspector verify labels and listings? Core What is checked
Nothing published by this authority.
Where we lookedPV Checklist's 'Checklist for PV System Plan Check' section verifies listing/cut-sheet documentation is submitted at plan-check stage, but no Town document confirms the field inspector re-verifies labels/listings physically at the on-site inspection.
https://www.townofsananselmo.org/DocumentCenter/View/25968/PV-Checklist
Q57 Is there a published inspection checklist? Core What is checked
Nothing published by this authority.
Where we lookedThe PV Checklist's own 'Checklist for PV System Plan Check' section functions as a plan-check checklist (title says so explicitly), not a published field-inspection checklist; no separate solar field-inspection checklist document was found on the Inspections or Building pages.
Q58 What must be on site at inspection? Core Documents on site
Inspection card and Town-stamped plans must be available on site, and someone must be present throughout the entire inspection window.
Why the confidence is not higherGeneral Inspections page requirement, not solar-specific: 'The following items must be available on-site at the time of inspection: Inspection card, Town-stamped plans.'
authority page (general, not solar-specific) checked 2026-08-31 https://www.sananselmo.gov/1292/Inspections
Q59 Is there a re-inspection fee? Corrections & re-inspection
No re-inspection fee line found in the Town's current (effective 1 Jul 2026) Master Fee Schedule.
Why the confidence is not higherFull-text search of the extracted fee schedule PDF for 're-inspection', 'reinspect', 'additional inspection', 'second inspection' returned zero hits. Positive control ('electrical') returned 3 hits and fabricated control ('zzqqx') returned 0 hits in the same document, confirming the search itself worked. This is a proven absence in the Town's own current fee schedule, not a failed lookup. (Ross Valley Fire's separate 2016-dated prevention fee schedule was also checked and shows no clearly-labeled re-inspection line, though one ambiguous concatenated text fragment -- 'Fire Second + Inspection $190' -- could not be reliably parsed from the rendered page and was not relied upon.)
fee schedule (control-proven absence) checked 2026-08-31 https://www.townofsananselmo.org/DocumentCenter/View/30079/San-Anselmo-Fee-Schedule-2024pdf
Q60 How are corrections issued and cleared? Corrections & re-inspection
Corrections are handled through eTrakit; the Town's Permit Process page states general resubmittal reviews take 2-3 weeks (vs. 6-8 weeks for the initial departmental review of large projects).
Why the confidence is not higherGeneral timeline language from the Permit Process page, not solar-specific and not describing the correction-notice mechanism itself (e.g. whether a formal written correction letter is issued).
authority page (general, not solar-specific) checked 2026-08-31 https://www.sananselmo.gov/1803/Permit-Process
Q61 What is issued on pass? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedBuilding-Inspections page states only that a passing inspection 'extend[s] the permit for 180 days from the date of the inspection'; it does not name what document/tag (CO, Final, Green Tag, Letter) is actually issued on a passing final inspection.
Q62 Who notifies the utility for PTO? Core Final sign-off & PTO
Nothing published by this authority.
Where we lookedSymbium page, Permit-Process page and Inspections page -- none state whether the Town, the installer, or the utility itself is responsible for notifying PG&E to grant Permission to Operate after final sign-off.
Lines marked with a percentage were read off this authority’s own published documents. Unmarked guidance is general good practice, not this jurisdiction’s rule — always confirm against the authority before you submit.
Jurisdiction & key facts
The standing 62-question set, answered for Town of San Anselmo against this authority’s own published documents. Every answer carries the confidence it was recorded at and the document it came from. Where nothing is published we say so and show where we looked — a blank here is a finding, not a gap.
Town of San Anselmo is the authority having jurisdiction 90% confidence
- Holds
- Building and Electrical (Development Services Dept. / Building & Safety Division)
- Delegated to
- Ross Valley Fire Department (a Joint Powers Authority governing Fire Station 19) for the fire-code component of residential PV and battery/ESS installations
- Overridden by
- State-mandated automated permitting (Gov. Code §65850.52 / SB 379) via the Town's Symbium portal for eligible residential PV/ESS systems
- Why not higher
- The Town's own site places Building & Safety under 'Development Services' (sananselmo.gov/929/Building) and issues residential building/electrical permits itself via eTrakit and, for SB 379-eligible systems, Symbium. But San Anselmo is one of four member jurisdictions (Town of Ross, Town of Fairfax, Sleepy Hollow FPD, and San Anselmo) of Ross Valley Fire Department, explicitly governed as a 'Joint Powers Authority (JPA)' per rossvalleyfire.gov's own Governance page. RVFD's own Fire Code page names 'Town of San Anselmo Article 8 San Anselmo Fire Code' as the locally-adopted fire chapter, and RVFD's Prevention Services Fee Schedule carries its own priced permit lines for 'Photovoltaic Power System' ($328) and 'Battery Systems' ($465), separate from and in addition to the Town's own Building permit fee -- confirmed independently by the Town's own Master Fee Schedule (item 1, PreApplication Meeting) which notes 'Plus applicant pays $100 to Ross Valley Fire Department.' Municode (library.municode.com/ca/san_anselmo) is the codifier of record per the Town's own Planning page, but it is an Angular SPA that returns only an empty app shell to non-JS retrieval and could not be read directly in this run -- so the Town's own PDF handouts and RVFD's own site were used as the primary sources for code-edition and fire-delegation facts instead.
- Permit required
- Yes95%
- Permit cost
- $450 flat ('Photo-voltaic System Permit and EV charging'), unchanged between the Current FY25-26 and Proposed FY26-27 columns of the fee schedule effective 1 Jul 2026.88%
- Plan review
- Instantaneous for SB 379/Symbium-eligible residential PV and ESS applications; approximately 1-3 business days for PV/PV+ESS/ESS-only applications submitted electronically via eTrakit…90%
- Portal
- eTrakit (https://sanan-trk.aspgov.com/eTRAKiT/) for permit application and inspection scheduling generally,95%
- Electrical code
- 2023 NEC (via the 2025 California Electrical Code)90%
- Own placard wording
- No -- the Town specifies appearance/material standards for the placards but no specific wording text of its own.62%
- Booking an inspection
- Portal92%
Labels & placards for this authority
Wording 62%
No -- the Town specifies appearance/material standards for the placards but no specific wording text of its own.
Size, colour & material 80%
Colour and material are specified: red background with white lettering; printed material must resist fading per UL 969. No letter-height figure is given.
Where they go 80%
On the PV panel(s), on the disconnect(s), and on the transmission line conductors.
What the utility wants on top None%
Each figure above is sourced and dated in the full answer set below (questions 38–43). Where an authority’s own published sheet is older than the code it has adopted, the answer says so.
Their website
Average approval time — application to PTO
From the CPUC interconnection record. Bars show the average days taken each year; a year with no recorded projects is left blank rather than drawn as zero.
